1 © Nokia Siemens Networks
Nokia KPI & Core Optimization
2 © Nokia Siemens Networks /

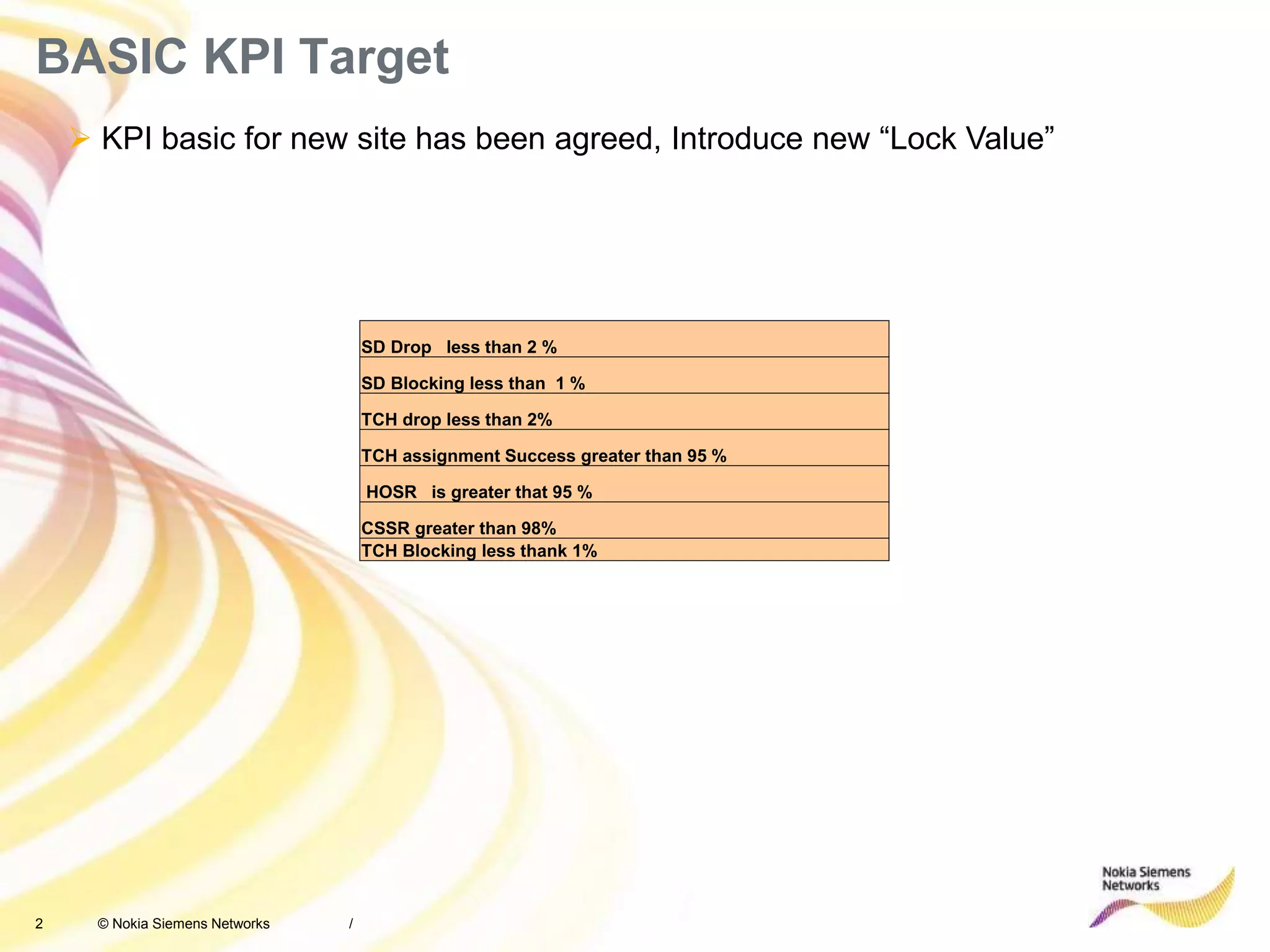

BASIC KPI Target
 KPI basic for new site has been agreed, Introduce new “Lock Value”
SD Drop less than 2 %
SD Blocking less than 1 %
TCH drop less than 2%
TCH assignment Success greater than 95 %
HOSR is greater that 95 %
CSSR greater than 98%
TCH Blocking less thank 1%
3 © Nokia Siemens Networks

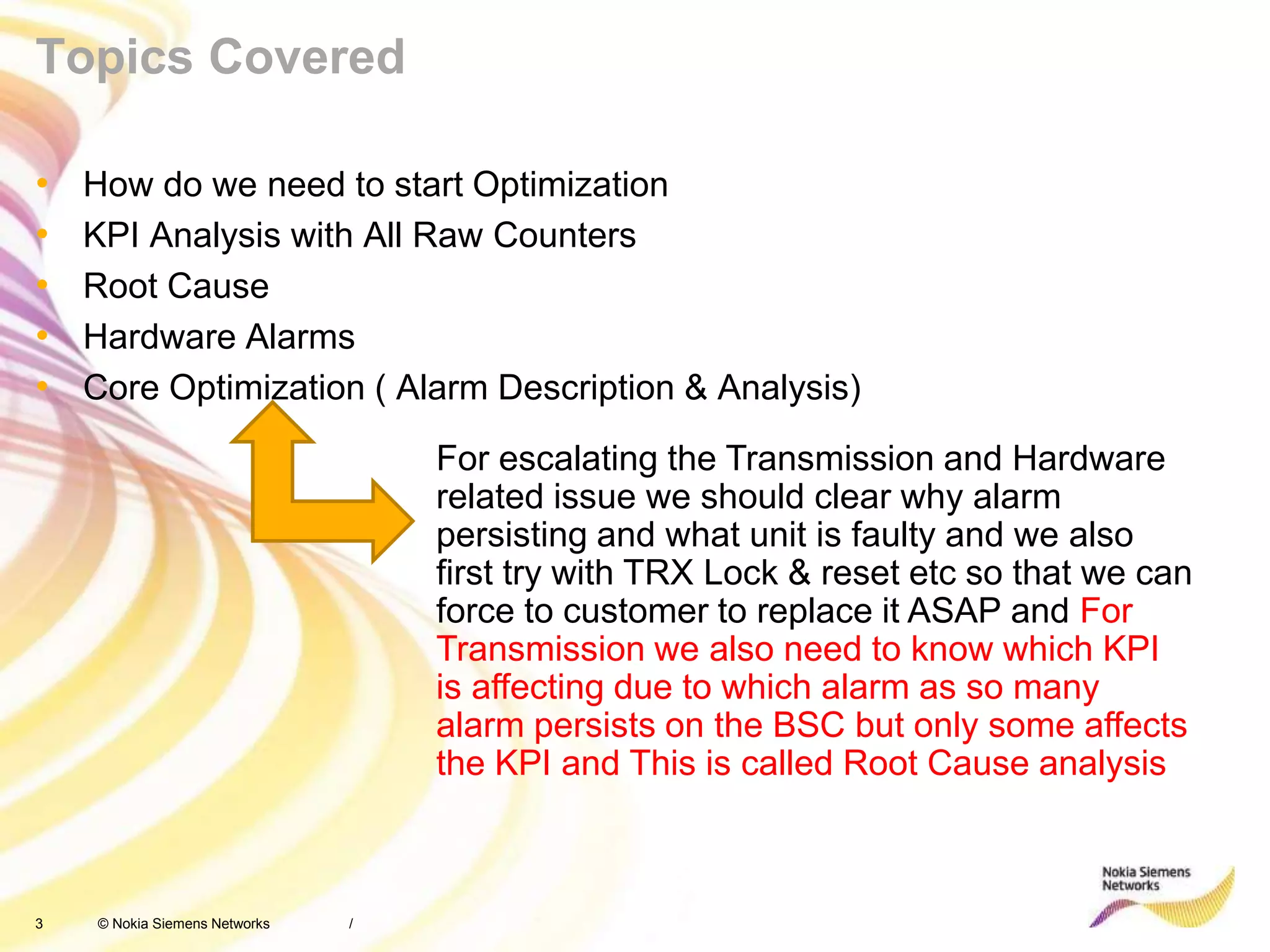

Topics Covered
• How do we need to start Optimization
• KPI Analysis with All Raw Counters
• Root Cause
• Hardware Alarms
• Core Optimization ( Alarm Description & Analysis)
/
For escalating the Transmission and Hardware
related issue we should clear why alarm
persisting and what unit is faulty and we also
first try with TRX Lock & reset etc so that we can
force to customer to replace it ASAP and For
Transmission we also need to know which KPI
is affecting due to which alarm as so many
alarm persists on the BSC but only some affects
the KPI and This is called Root Cause analysis
4 © Nokia Siemens Networks

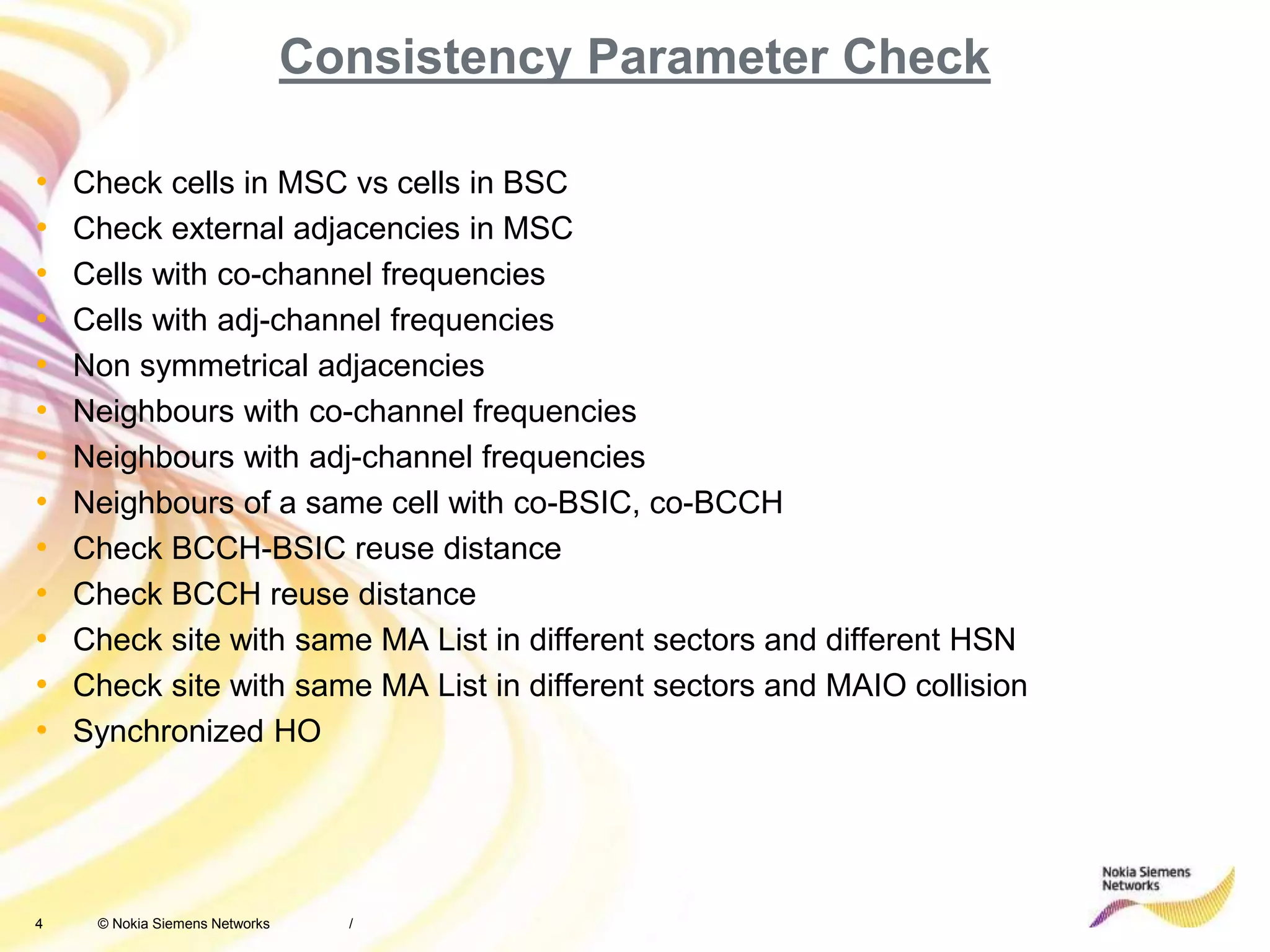

Consistency Parameter Check
• Check cells in MSC vs cells in BSC
• Check external adjacencies in MSC
• Cells with co-channel frequencies
• Cells with adj-channel frequencies
• Non symmetrical adjacencies
• Neighbours with co-channel frequencies
• Neighbours with adj-channel frequencies
• Neighbours of a same cell with co-BSIC, co-BCCH
• Check BCCH-BSIC reuse distance
• Check BCCH reuse distance
• Check site with same MA List in different sectors and different HSN
• Check site with same MA List in different sectors and MAIO collision
• Synchronized HO
/
5 © Nokia Siemens Networks

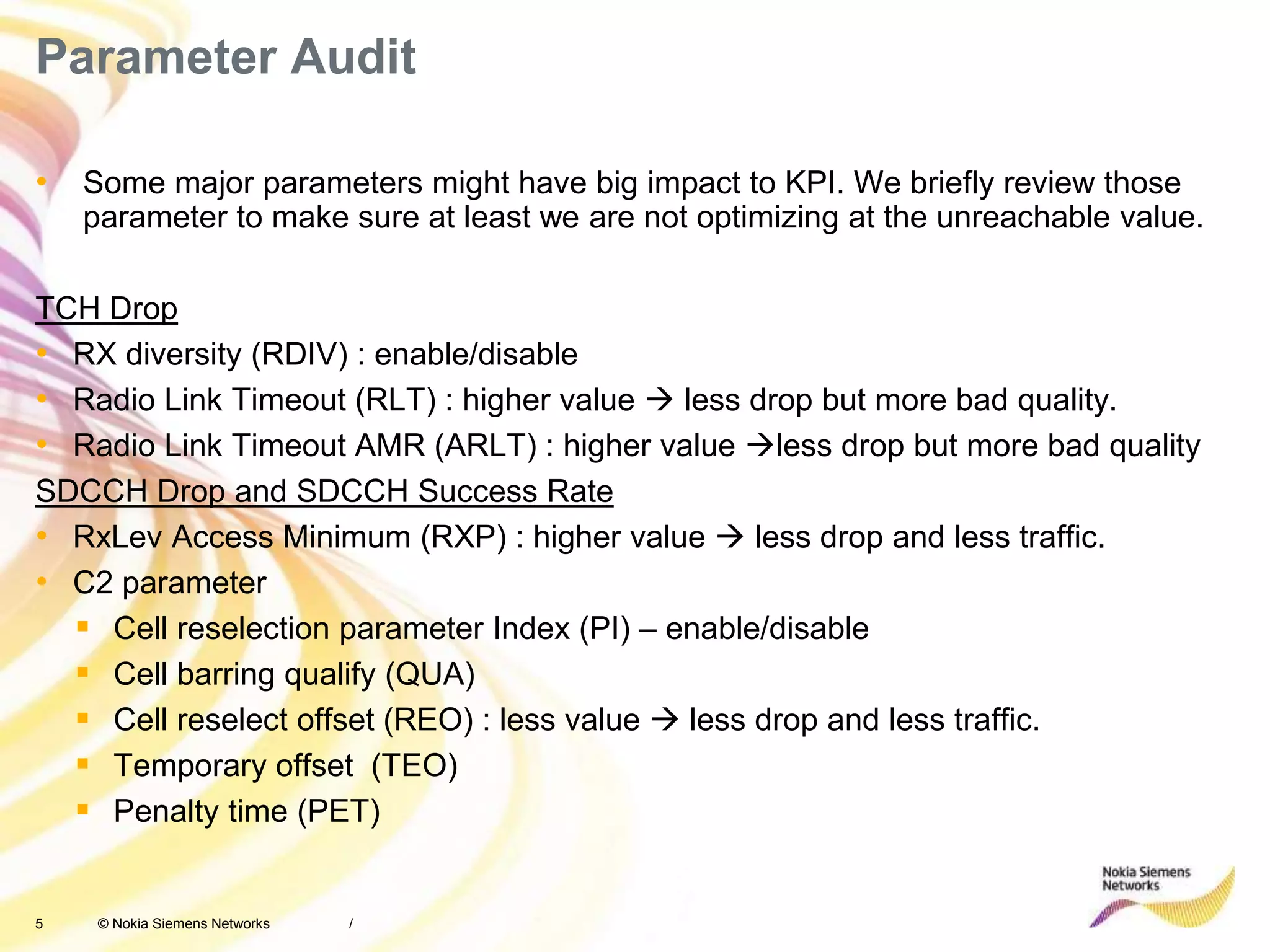

Parameter Audit
• Some major parameters might have big impact to KPI. We briefly review those
parameter to make sure at least we are not optimizing at the unreachable value.
TCH Drop
• RX diversity (RDIV) : enable/disable
• Radio Link Timeout (RLT) : higher value  less drop but more bad quality.
• Radio Link Timeout AMR (ARLT) : higher value less drop but more bad quality
SDCCH Drop and SDCCH Success Rate
• RxLev Access Minimum (RXP) : higher value  less drop and less traffic.
• C2 parameter
 Cell reselection parameter Index (PI) – enable/disable
 Cell barring qualify (QUA)
 Cell reselect offset (REO) : less value  less drop and less traffic.
 Temporary offset (TEO)
 Penalty time (PET)
/

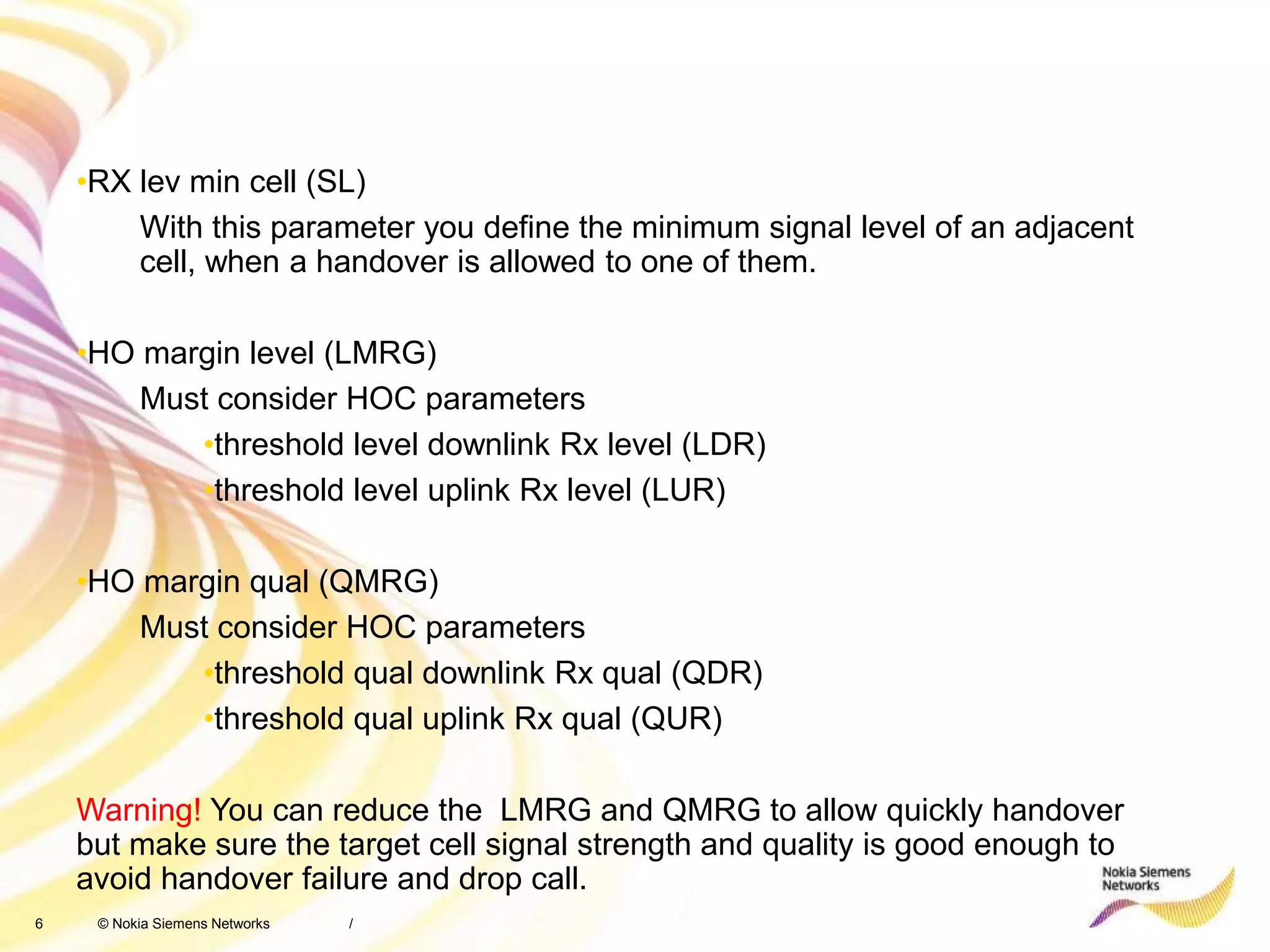

6 © Nokia Siemens Networks /
•RX lev min cell (SL)
With this parameter you define the minimum signal level of an adjacent
cell, when a handover is allowed to one of them.
•HO margin level (LMRG)
Must consider HOC parameters
•threshold level downlink Rx level (LDR)
•threshold level uplink Rx level (LUR)
•HO margin qual (QMRG)
Must consider HOC parameters
•threshold qual downlink Rx qual (QDR)
•threshold qual uplink Rx qual (QUR)
Warning! You can reduce the LMRG and QMRG to allow quickly handover
but make sure the target cell signal strength and quality is good enough to
avoid handover failure and drop call.
7 © Nokia Siemens Networks /

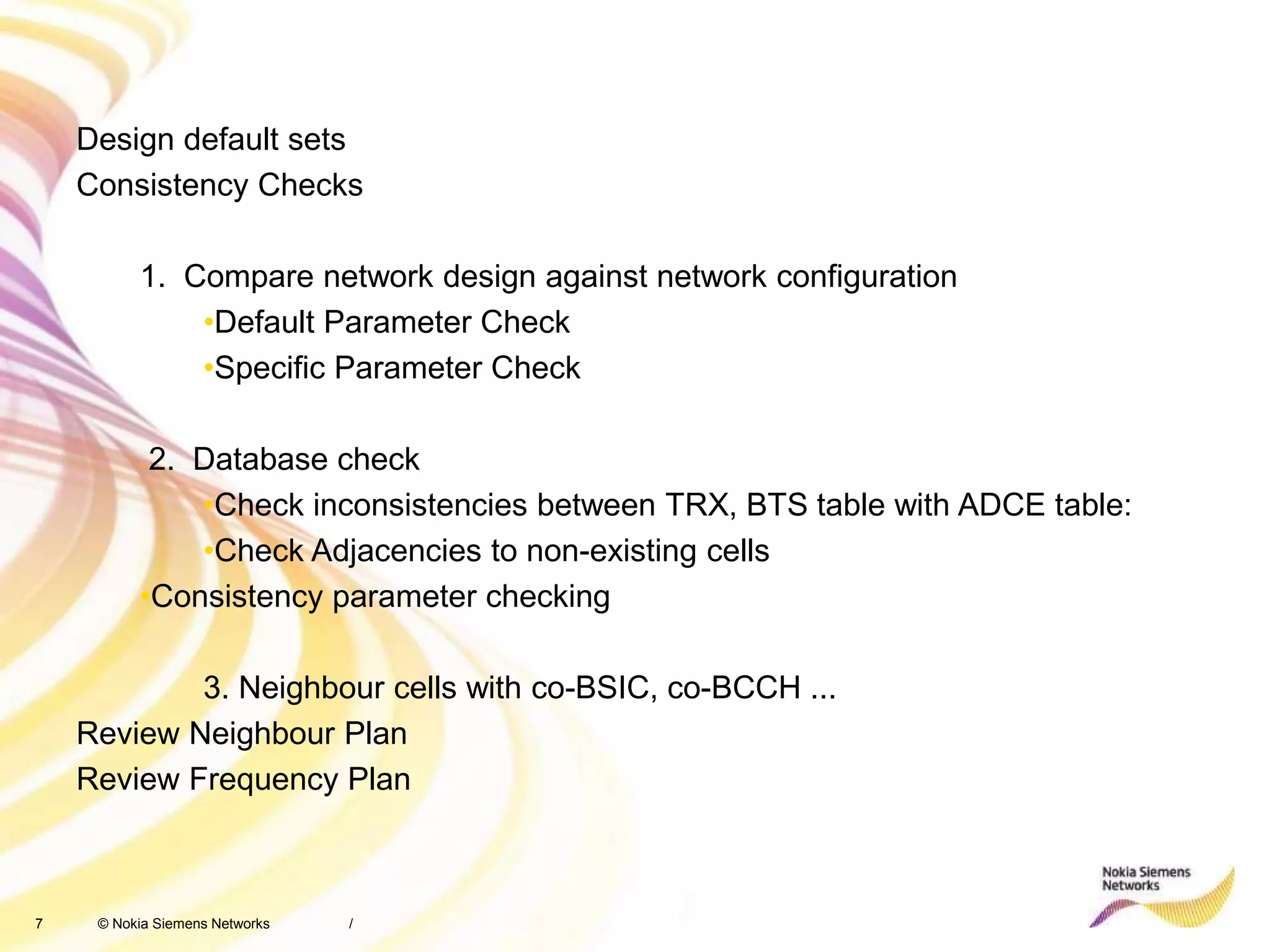

Design default sets
Consistency Checks
1. Compare network design against network configuration
•Default Parameter Check
•Specific Parameter Check
2. Database check
•Check inconsistencies between TRX, BTS table with ADCE table:
•Check Adjacencies to non-existing cells
•Consistency parameter checking
3. Neighbour cells with co-BSIC, co-BCCH ...
Review Neighbour Plan
Review Frequency Plan
8 © Nokia Siemens Networks

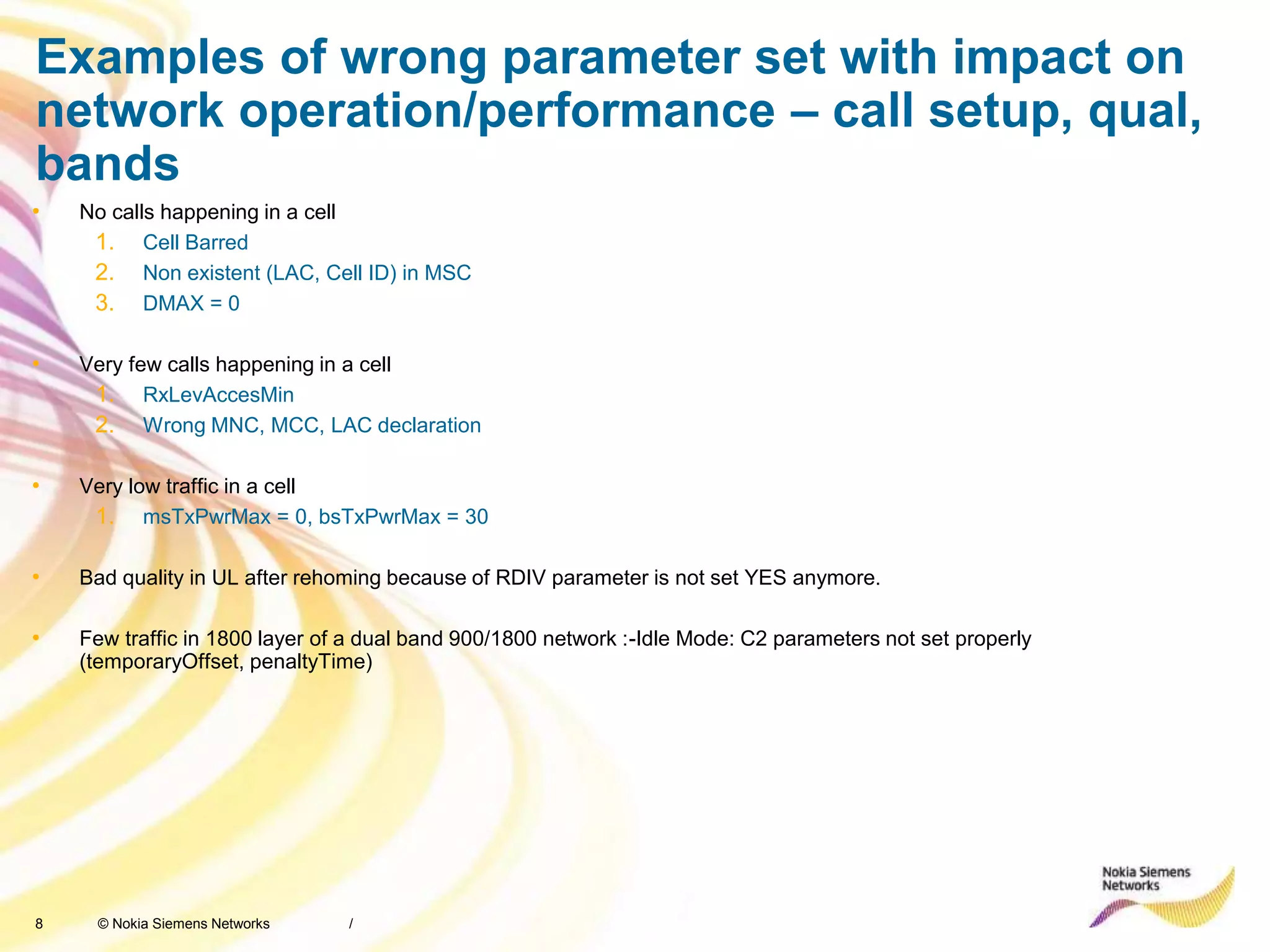

Examples of wrong parameter set with impact on
network operation/performance – call setup, qual,
bands
• No calls happening in a cell
1. Cell Barred
2. Non existent (LAC, Cell ID) in MSC
3. DMAX = 0
• Very few calls happening in a cell
1. RxLevAccesMin
2. Wrong MNC, MCC, LAC declaration
• Very low traffic in a cell
1. msTxPwrMax = 0, bsTxPwrMax = 30
• Bad quality in UL after rehoming because of RDIV parameter is not set YES anymore.
• Few traffic in 1800 layer of a dual band 900/1800 network :-Idle Mode: C2 parameters not set properly
(temporaryOffset, penaltyTime)
/
9 © Nokia Siemens Networks

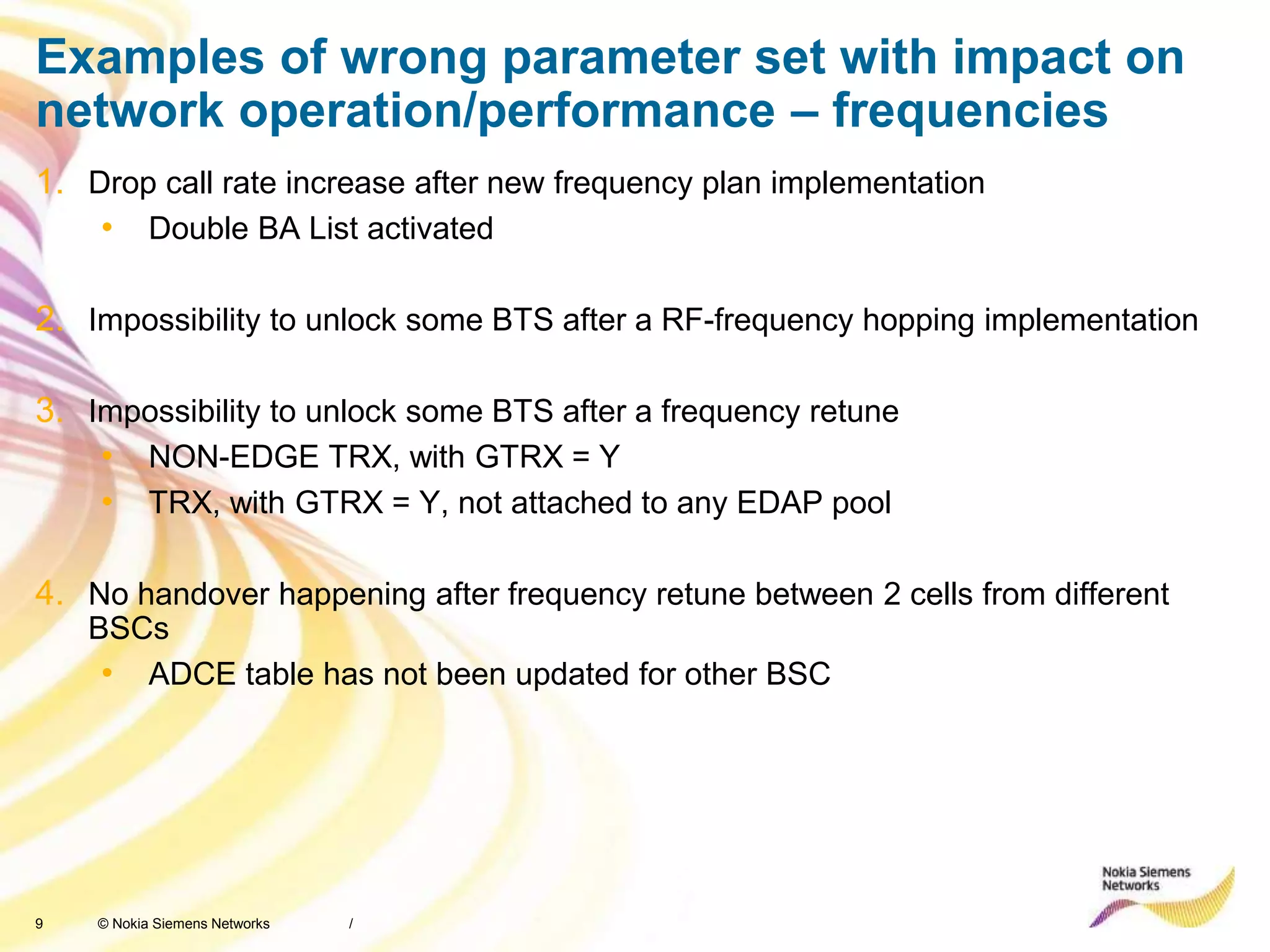

Examples of wrong parameter set with impact on
network operation/performance – frequencies
1. Drop call rate increase after new frequency plan implementation
• Double BA List activated
2. Impossibility to unlock some BTS after a RF-frequency hopping implementation
3. Impossibility to unlock some BTS after a frequency retune
• NON-EDGE TRX, with GTRX = Y
• TRX, with GTRX = Y, not attached to any EDAP pool
4. No handover happening after frequency retune between 2 cells from different
BSCs
• ADCE table has not been updated for other BSC
/

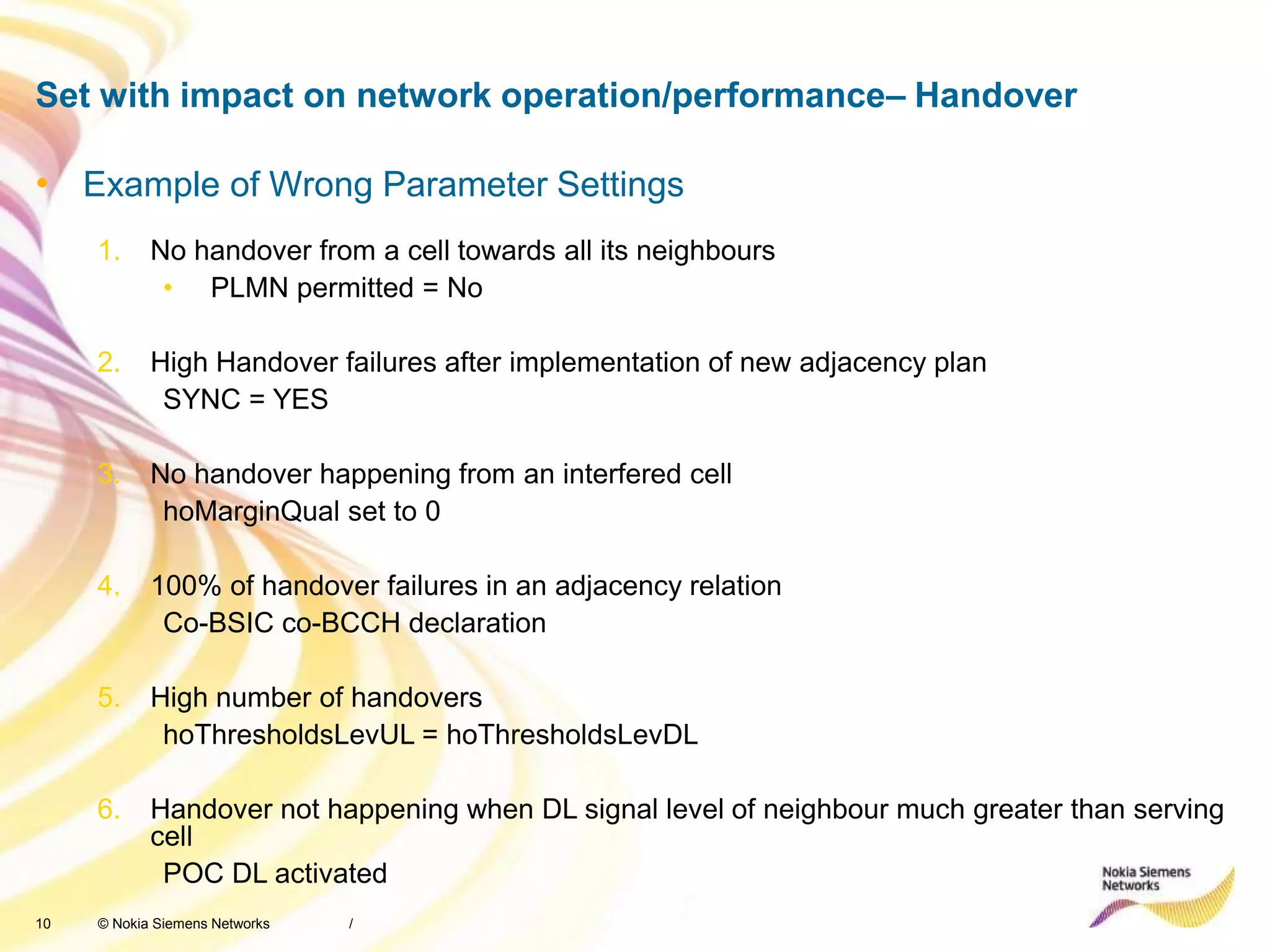

10 © Nokia Siemens Networks
Set with impact on network operation/performance– Handover
/
• Example of Wrong Parameter Settings
1. No handover from a cell towards all its neighbours
• PLMN permitted = No
2. High Handover failures after implementation of new adjacency plan
SYNC = YES
3. No handover happening from an interfered cell
hoMarginQual set to 0
4. 100% of handover failures in an adjacency relation
Co-BSIC co-BCCH declaration
5. High number of handovers
hoThresholdsLevUL = hoThresholdsLevDL
6. Handover not happening when DL signal level of neighbour much greater than serving
cell
POC DL activated

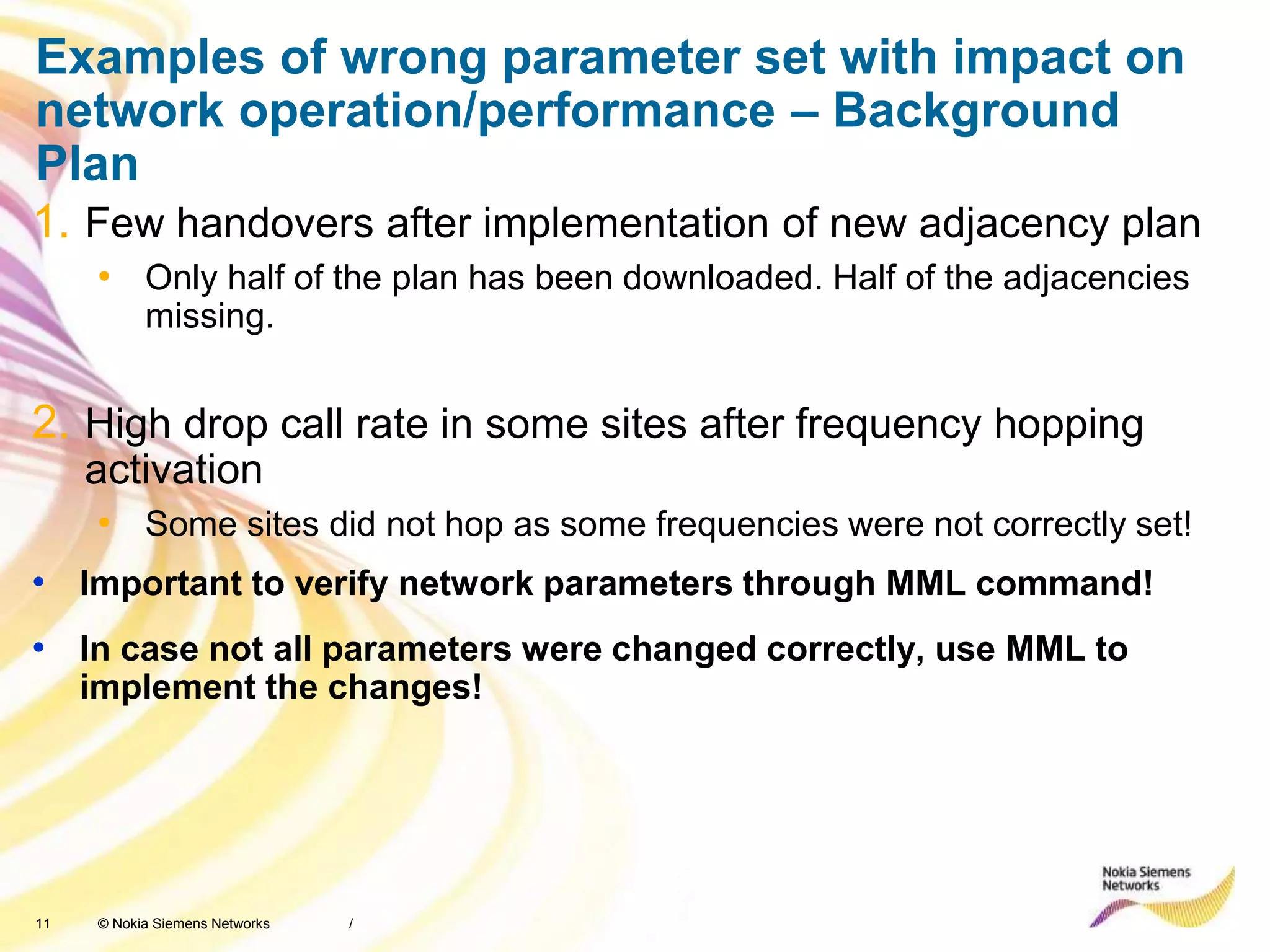

11 © Nokia Siemens Networks
Examples of wrong parameter set with impact on
network operation/performance – Background
Plan
1. Few handovers after implementation of new adjacency plan
• Only half of the plan has been downloaded. Half of the adjacencies
missing.
2. High drop call rate in some sites after frequency hopping
activation
• Some sites did not hop as some frequencies were not correctly set!
• Important to verify network parameters through MML command!
• In case not all parameters were changed correctly, use MML to
implement the changes!
/

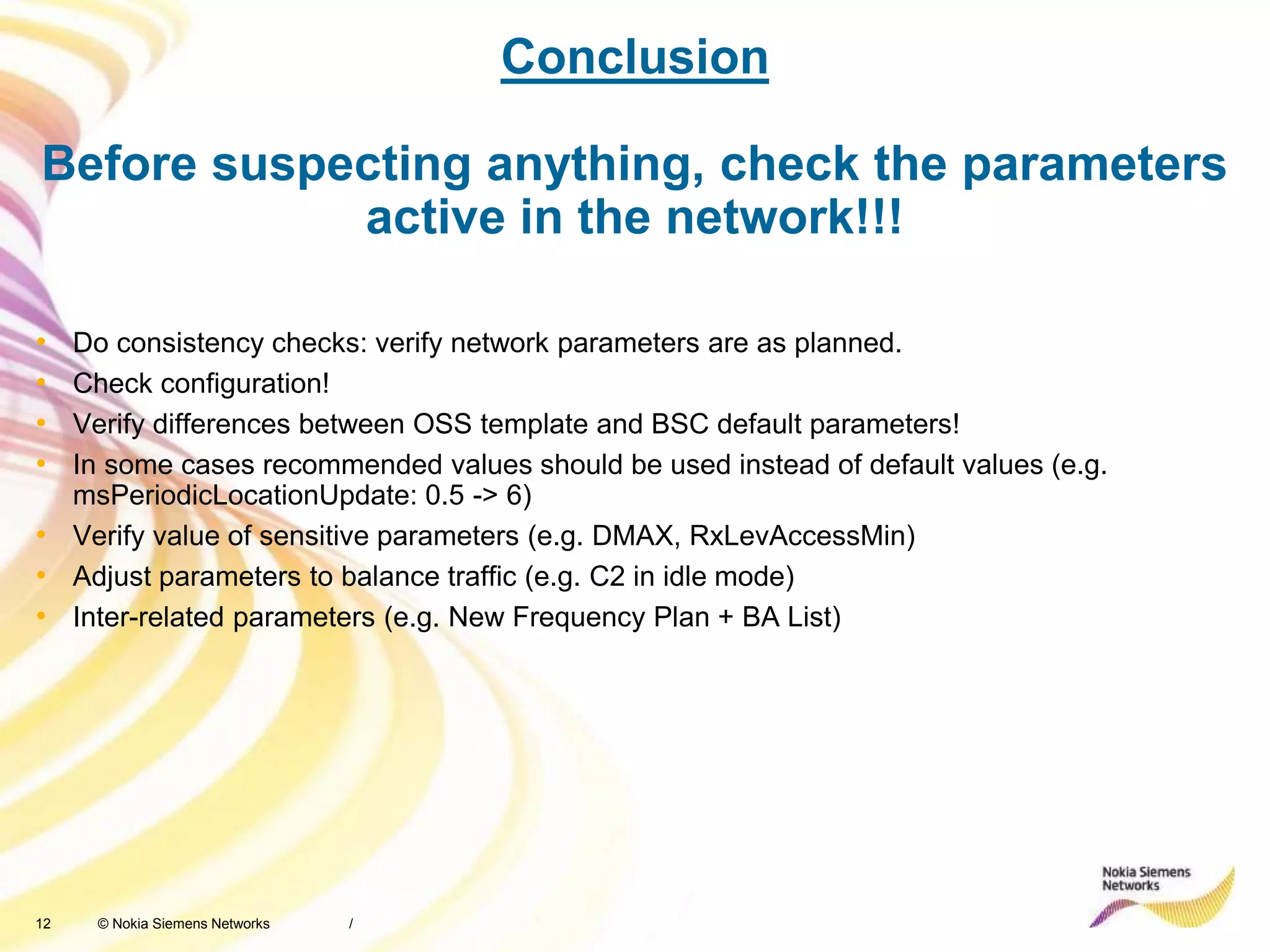

12 © Nokia Siemens Networks
Conclusion
Before suspecting anything, check the parameters
active in the network!!!
• Do consistency checks: verify network parameters are as planned.
• Check configuration!
• Verify differences between OSS template and BSC default parameters!
• In some cases recommended values should be used instead of default values (e.g.
msPeriodicLocationUpdate: 0.5 -> 6)
• Verify value of sensitive parameters (e.g. DMAX, RxLevAccessMin)
• Adjust parameters to balance traffic (e.g. C2 in idle mode)
• Inter-related parameters (e.g. New Frequency Plan + BA List)
/
13 © Nokia Siemens Networks /
KPI Evaluation Process
14 © Nokia Siemens Networks

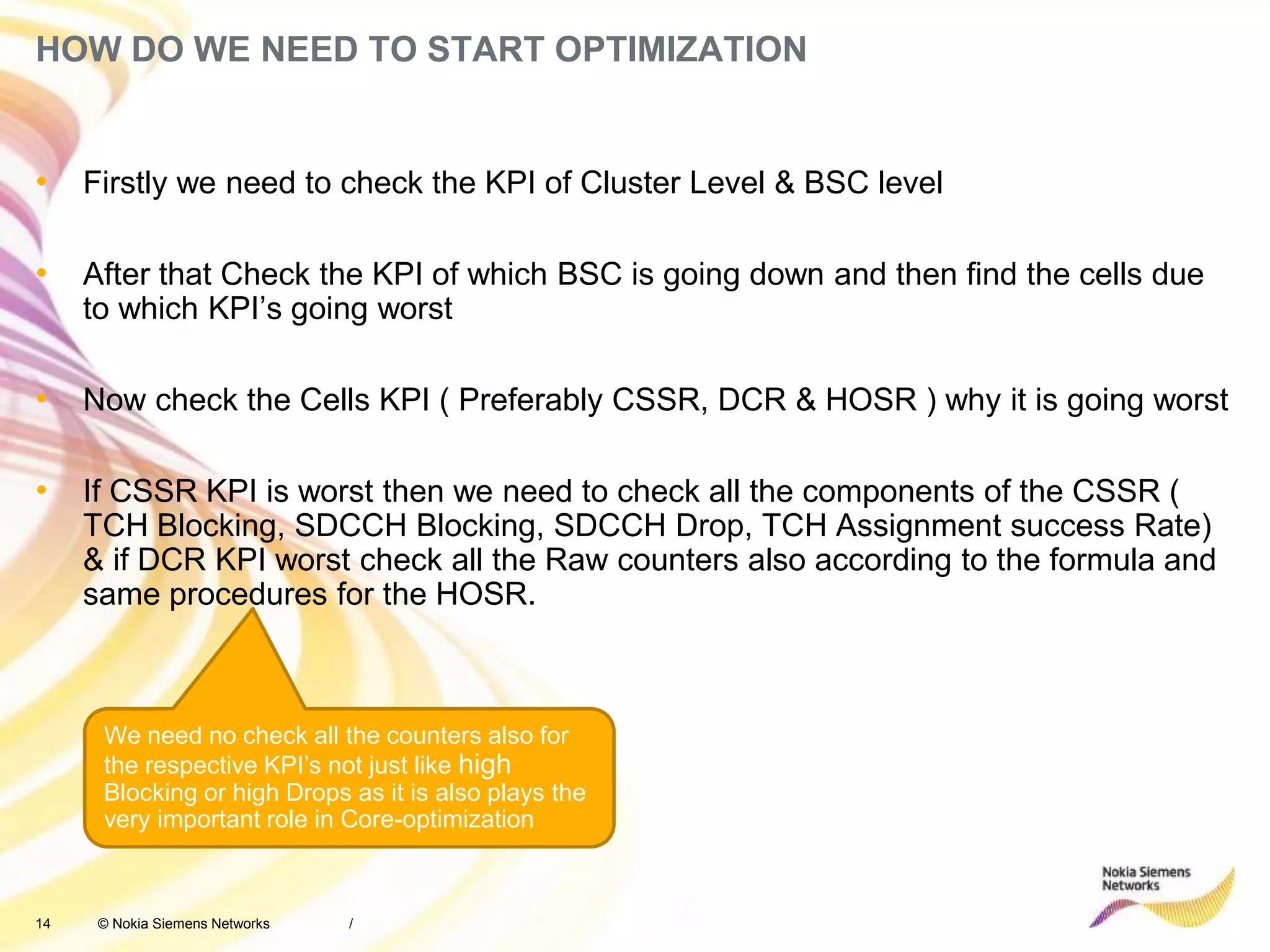

HOW DO WE NEED TO START OPTIMIZATION
• Firstly we need to check the KPI of Cluster Level & BSC level
• After that Check the KPI of which BSC is going down and then find the cells due
to which KPI’s going worst
• Now check the Cells KPI ( Preferably CSSR, DCR & HOSR ) why it is going worst
• If CSSR KPI is worst then we need to check all the components of the CSSR (
TCH Blocking, SDCCH Blocking, SDCCH Drop, TCH Assignment success Rate)
& if DCR KPI worst check all the Raw counters also according to the formula and
same procedures for the HOSR.
/
We need no check all the counters also for
the respective KPI’s not just like high
Blocking or high Drops as it is also plays the
very important role in Core-optimization
15 © Nokia Siemens Networks

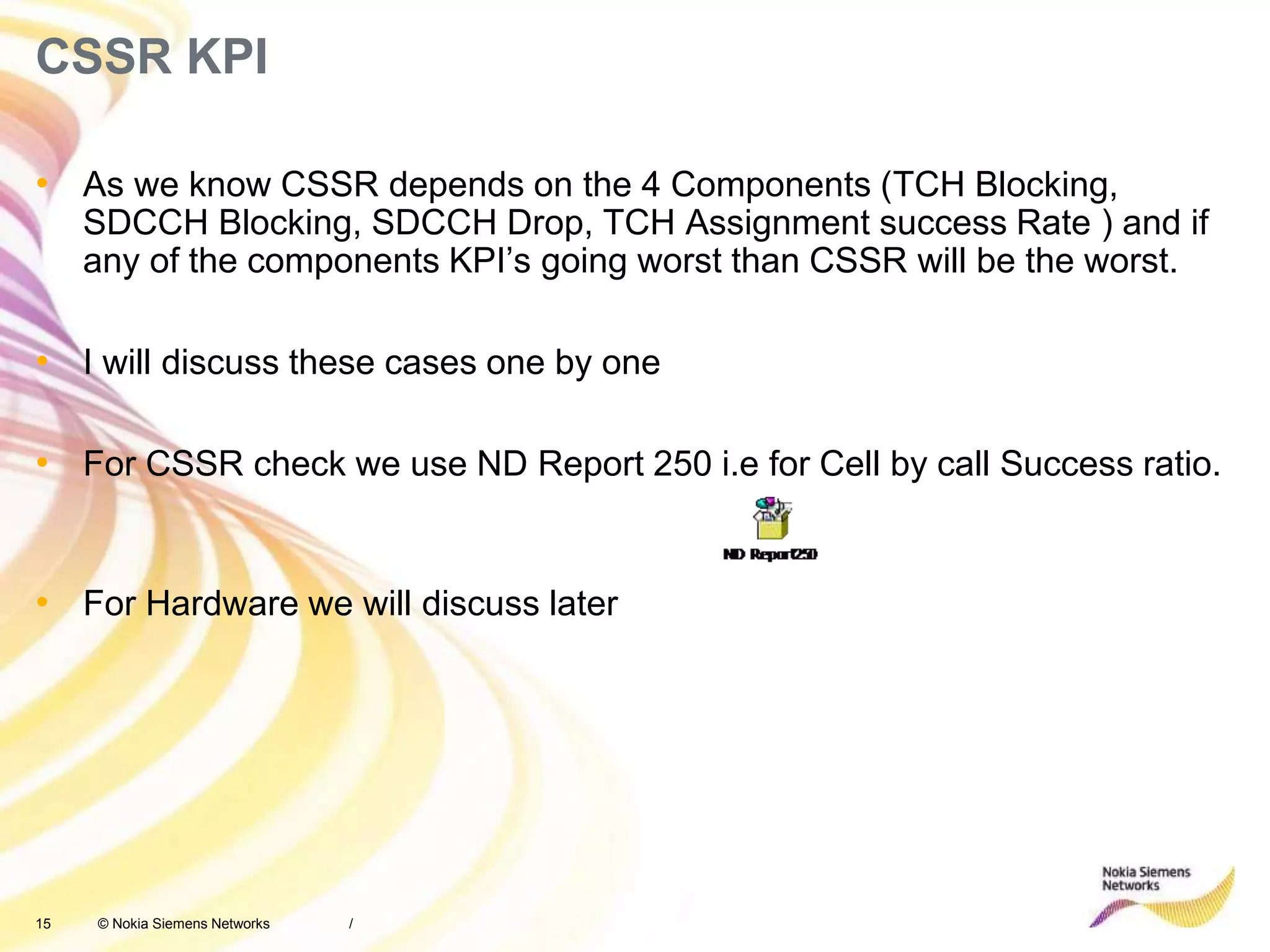

CSSR KPI
• As we know CSSR depends on the 4 Components (TCH Blocking,
SDCCH Blocking, SDCCH Drop, TCH Assignment success Rate ) and if
any of the components KPI’s going worst than CSSR will be the worst.
• I will discuss these cases one by one
• For CSSR check we use ND Report 250 i.e for Cell by call Success ratio.
• For Hardware we will discuss later
/
16 © Nokia Siemens Networks

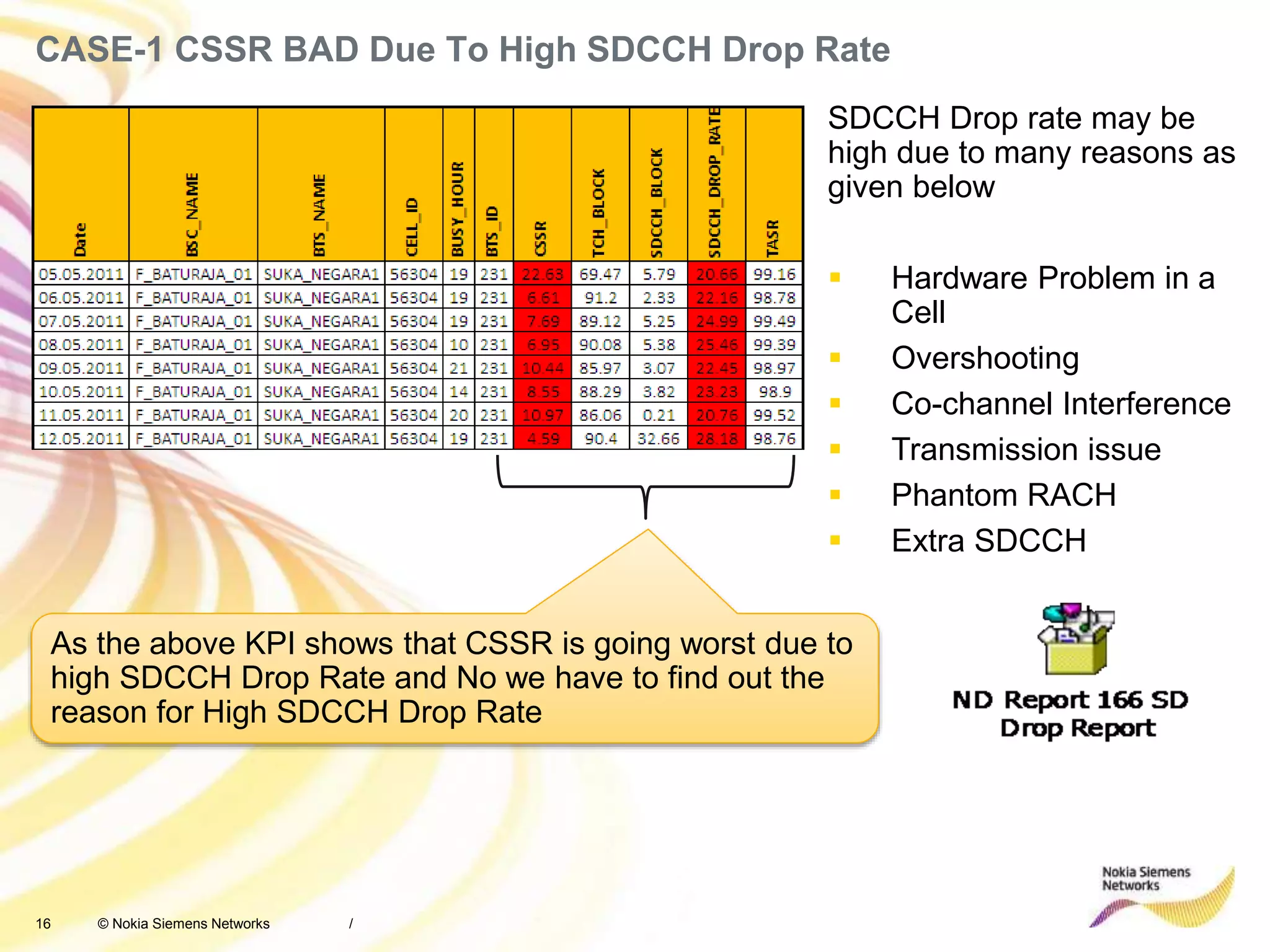

CASE-1 CSSR BAD Due To High SDCCH Drop Rate
/
As the above KPI shows that CSSR is going worst due to
high SDCCH Drop Rate and No we have to find out the
reason for High SDCCH Drop Rate
SDCCH Drop rate may be
high due to many reasons as
given below
 Hardware Problem in a
Cell
 Overshooting
 Co-channel Interference
 Transmission issue
 Phantom RACH
 Extra SDCCH
17 © Nokia Siemens Networks

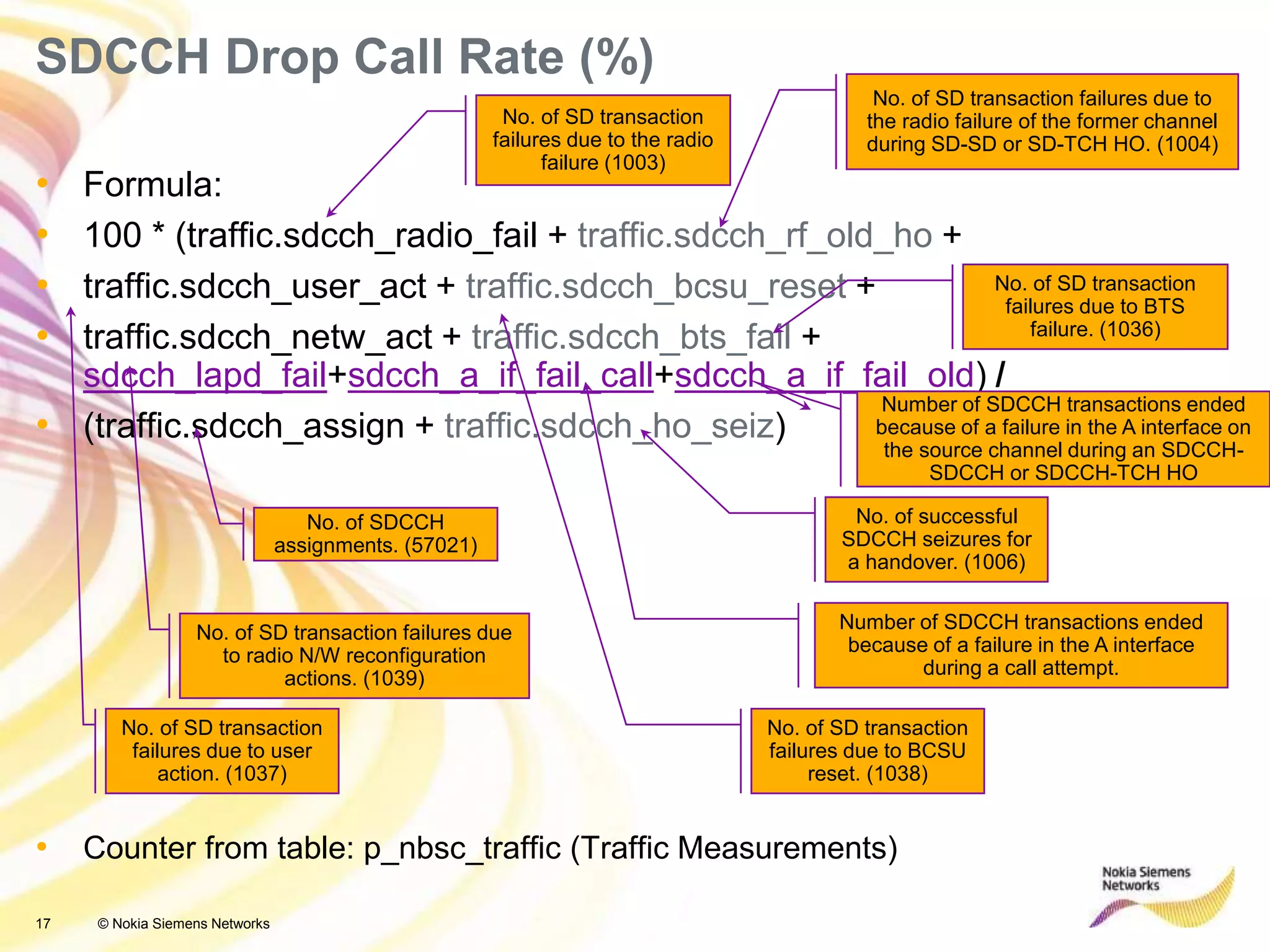

• Formula:
• 100 * (traffic.sdcch_radio_fail + traffic.sdcch_rf_old_ho +
• traffic.sdcch_user_act + traffic.sdcch_bcsu_reset +
• traffic.sdcch_netw_act + traffic.sdcch_bts_fail +
sdcch_lapd_fail+sdcch_a_if_fail_call+sdcch_a_if_fail_old) /
• (traffic.sdcch_assign + traffic.sdcch_ho_seiz)
• Counter from table: p_nbsc_traffic (Traffic Measurements)
SDCCH Drop Call Rate (%)
No. of SD transaction
failures due to the radio
failure (1003)
No. of SD transaction failures due to
the radio failure of the former channel
during SD-SD or SD-TCH HO. (1004)
No. of SD transaction
failures due to user
action. (1037)
No. of SD transaction failures due
to radio N/W reconfiguration
actions. (1039)
No. of SD transaction
failures due to BCSU
reset. (1038)
No. of SD transaction
failures due to BTS
failure. (1036)
No. of SDCCH
assignments. (57021)
No. of successful
SDCCH seizures for
a handover. (1006)
Number of SDCCH transactions ended
because of a failure in the A interface
during a call attempt.
Number of SDCCH transactions ended
because of a failure in the A interface on
the source channel during an SDCCH-
SDCCH or SDCCH-TCH HO
18 © Nokia Siemens Networks

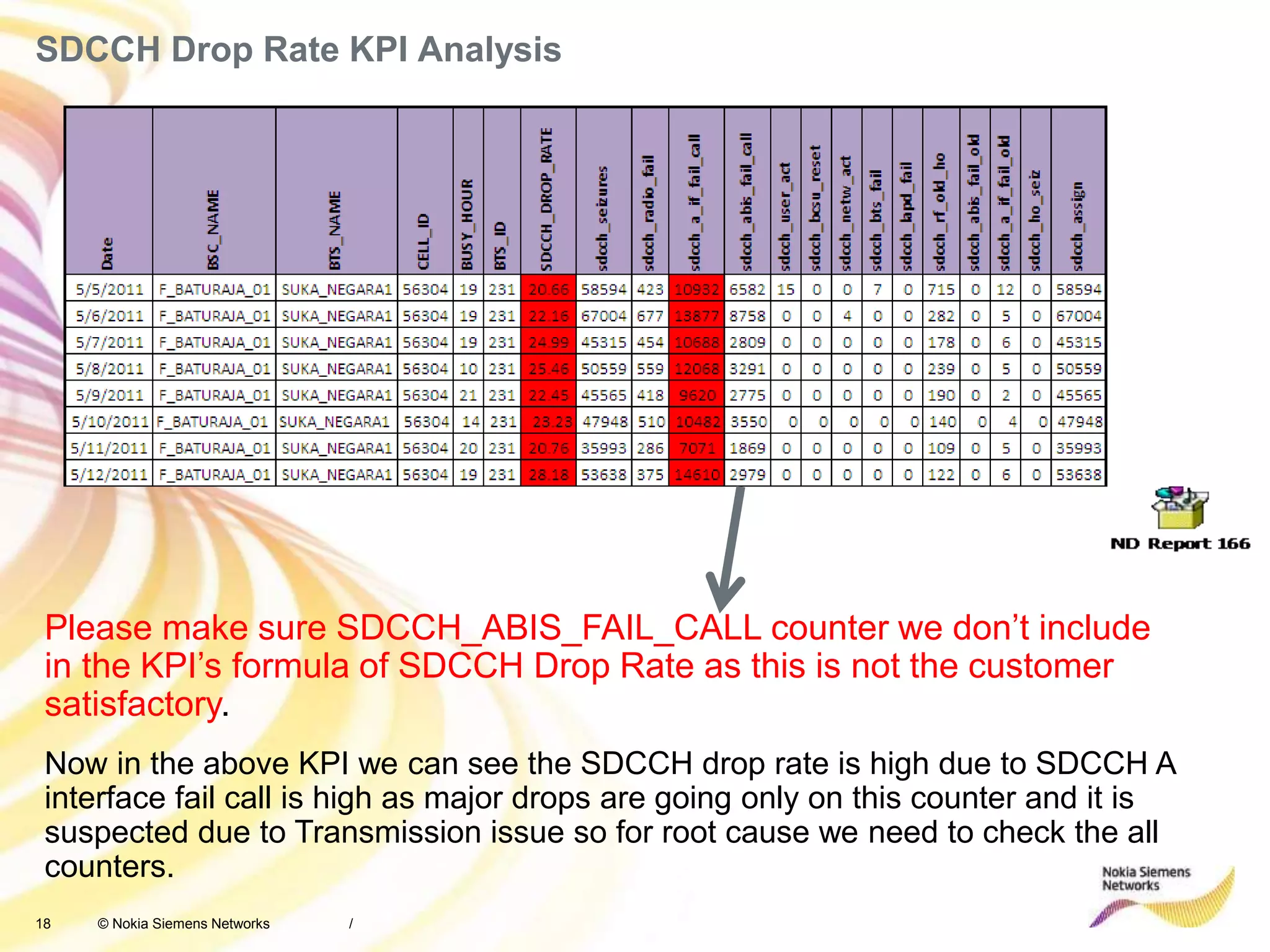

SDCCH Drop Rate KPI Analysis
/
Please make sure SDCCH_ABIS_FAIL_CALL counter we don’t include
in the KPI’s formula of SDCCH Drop Rate as this is not the customer
satisfactory.
Now in the above KPI we can see the SDCCH drop rate is high due to SDCCH A
interface fail call is high as major drops are going only on this counter and it is
suspected due to Transmission issue so for root cause we need to check the all
counters.
19 © Nokia Siemens Networks

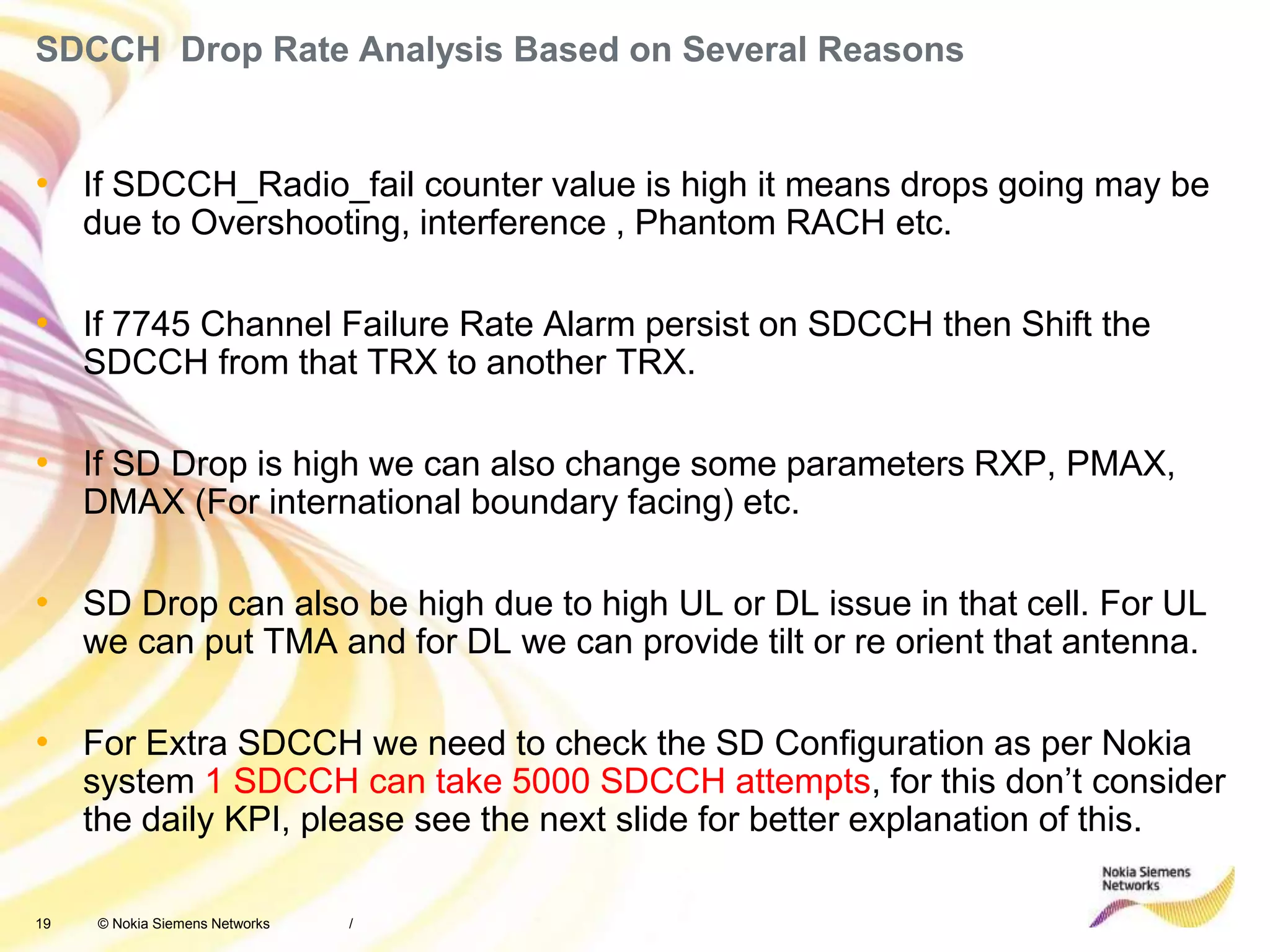

SDCCH Drop Rate Analysis Based on Several Reasons
• If SDCCH_Radio_fail counter value is high it means drops going may be
due to Overshooting, interference , Phantom RACH etc.
• If 7745 Channel Failure Rate Alarm persist on SDCCH then Shift the
SDCCH from that TRX to another TRX.
• If SD Drop is high we can also change some parameters RXP, PMAX,
DMAX (For international boundary facing) etc.
• SD Drop can also be high due to high UL or DL issue in that cell. For UL
we can put TMA and for DL we can provide tilt or re orient that antenna.
• For Extra SDCCH we need to check the SD Configuration as per Nokia
system 1 SDCCH can take 5000 SDCCH attempts, for this don’t consider
the daily KPI, please see the next slide for better explanation of this.
/
20 © Nokia Siemens Networks

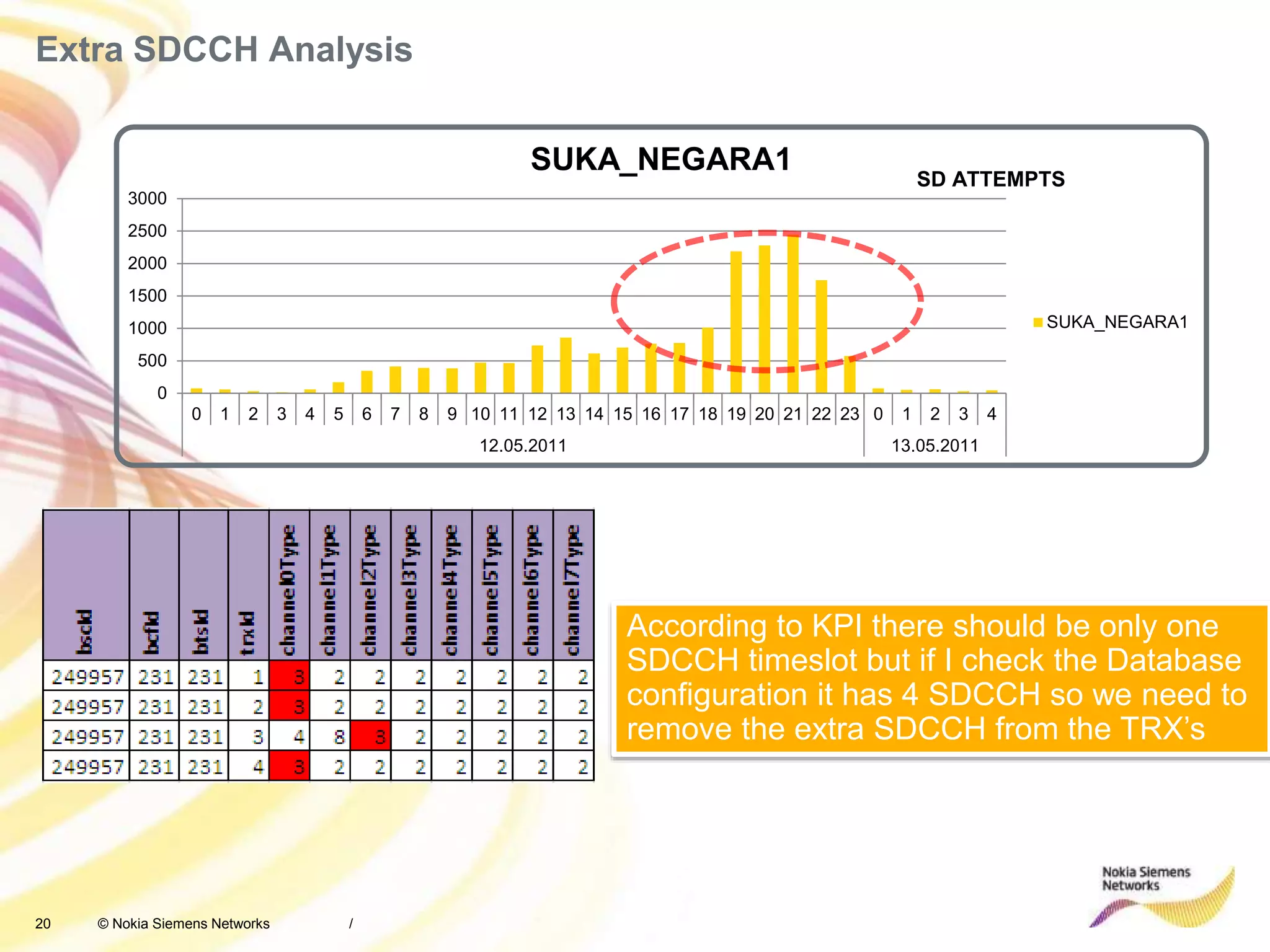

Extra SDCCH Analysis
/
0
500
1000
1500
2000
2500
3000
0 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 0 1 2 3 4
12.05.2011 13.05.2011
SUKA_NEGARA1
SUKA_NEGARA1
SD ATTEMPTS
According to KPI there should be only one
SDCCH timeslot but if I check the Database
configuration it has 4 SDCCH so we need to
remove the extra SDCCH from the TRX’s
21 © Nokia Siemens Networks

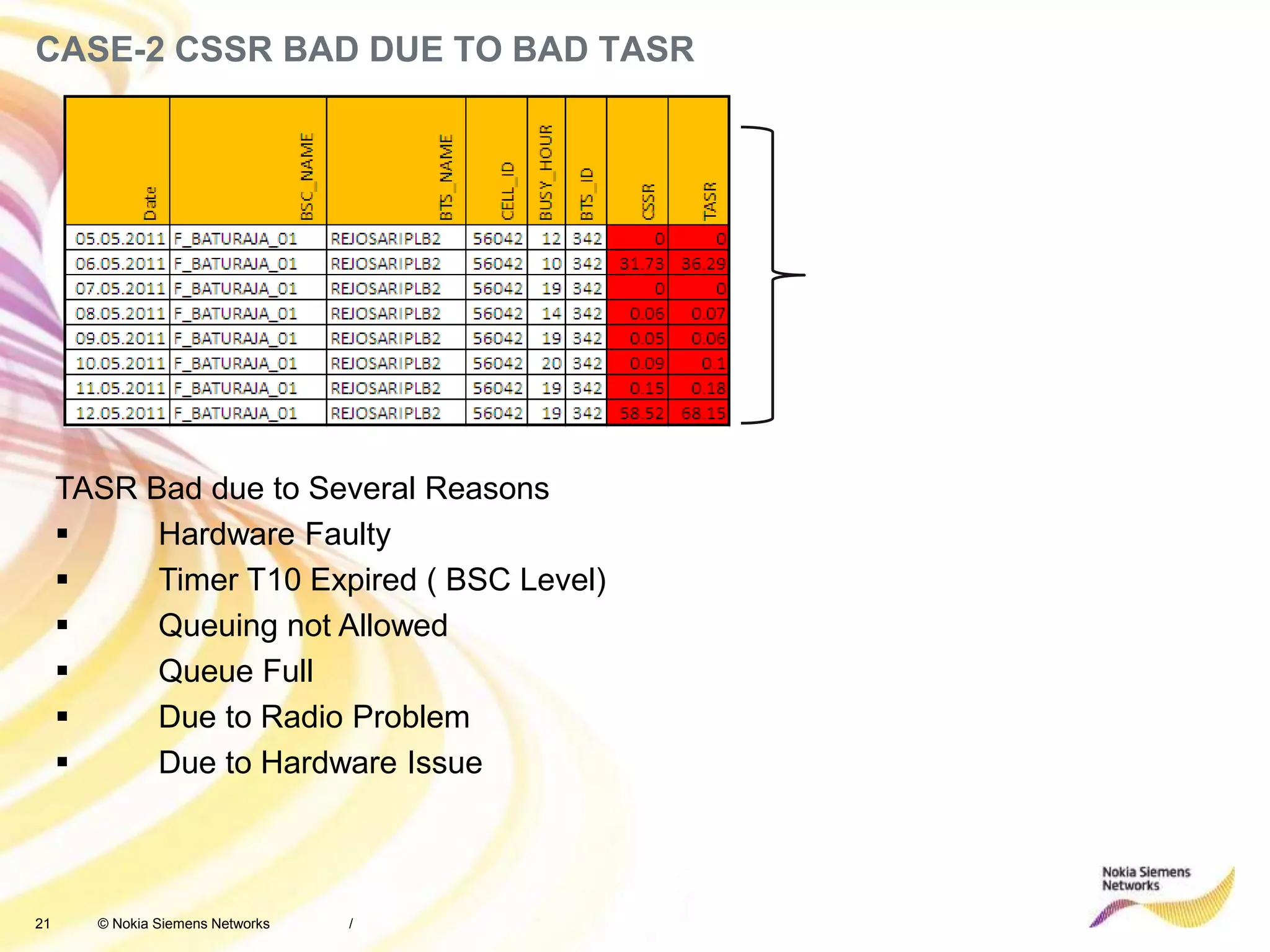

CASE-2 CSSR BAD DUE TO BAD TASR
/
TASR Bad due to Several Reasons
 Hardware Faulty
 Timer T10 Expired ( BSC Level)
 Queuing not Allowed
 Queue Full
 Due to Radio Problem
 Due to Hardware Issue
22 © Nokia Siemens Networks

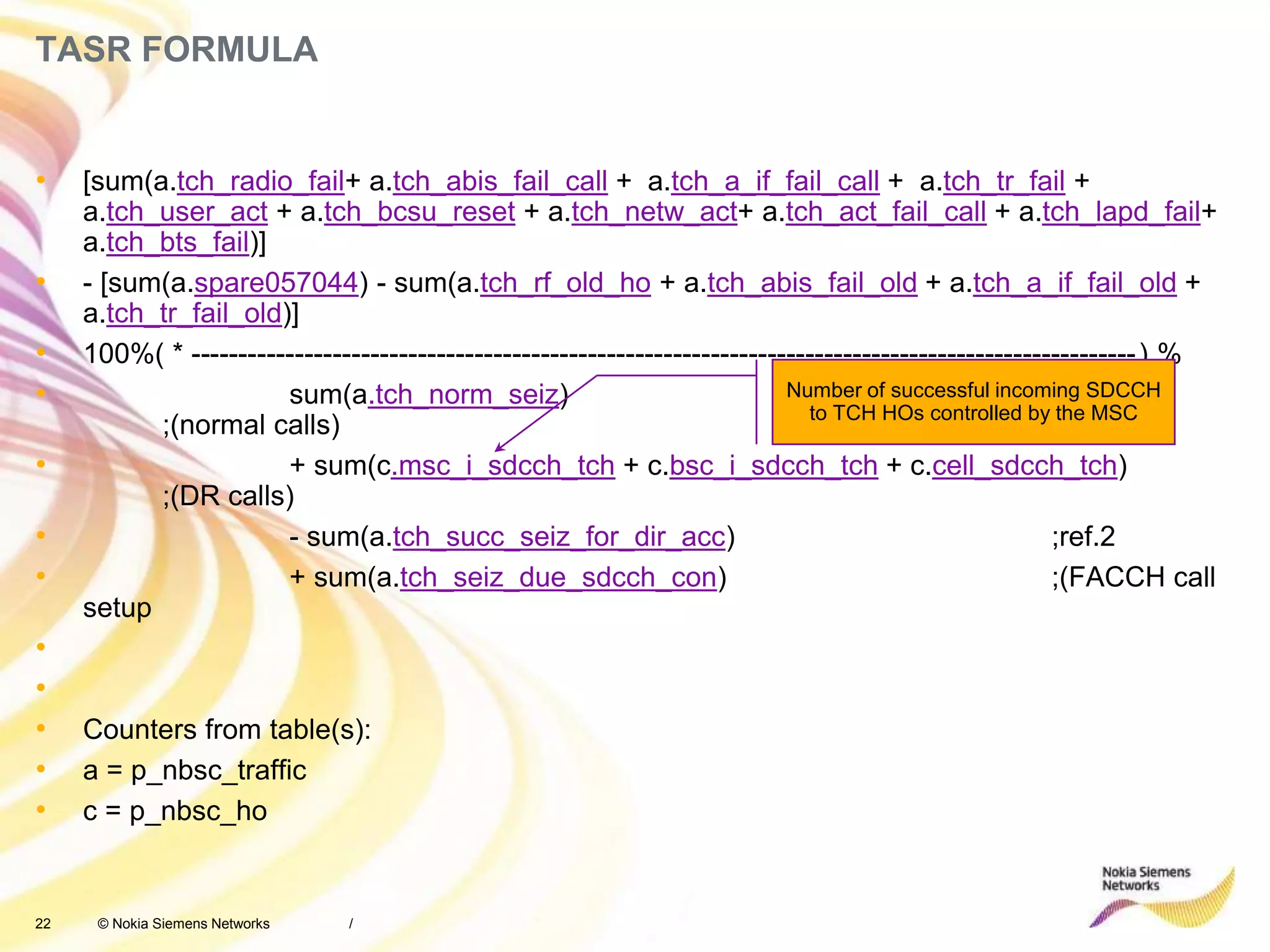

TASR FORMULA
• [sum(a.tch_radio_fail+ a.tch_abis_fail_call + a.tch_a_if_fail_call + a.tch_tr_fail +
a.tch_user_act + a.tch_bcsu_reset + a.tch_netw_act+ a.tch_act_fail_call + a.tch_lapd_fail+
a.tch_bts_fail)]
• - [sum(a.spare057044) - sum(a.tch_rf_old_ho + a.tch_abis_fail_old + a.tch_a_if_fail_old +
a.tch_tr_fail_old)]
• 100%( * ----------------------------------------------------------------------------------------------------) %
• sum(a.tch_norm_seiz)
;(normal calls)
• + sum(c.msc_i_sdcch_tch + c.bsc_i_sdcch_tch + c.cell_sdcch_tch)
;(DR calls)
• - sum(a.tch_succ_seiz_for_dir_acc) ;ref.2
• + sum(a.tch_seiz_due_sdcch_con) ;(FACCH call
setup
•
•
• Counters from table(s):
• a = p_nbsc_traffic
• c = p_nbsc_ho
/
Number of successful incoming SDCCH
to TCH HOs controlled by the MSC
23 © Nokia Siemens Networks

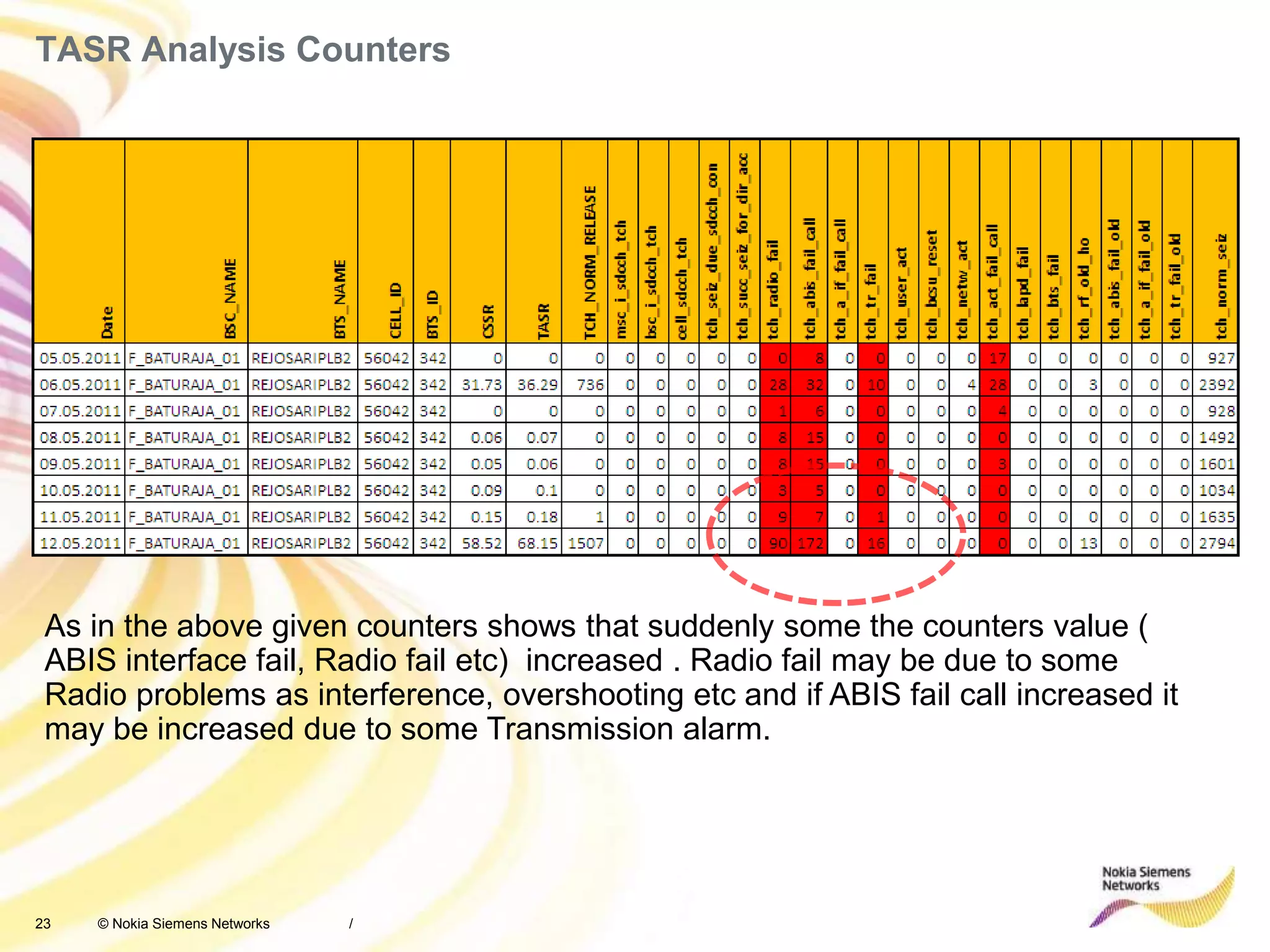

TASR Analysis Counters
/
As in the above given counters shows that suddenly some the counters value (
ABIS interface fail, Radio fail etc) increased . Radio fail may be due to some
Radio problems as interference, overshooting etc and if ABIS fail call increased it
may be increased due to some Transmission alarm.
24 © Nokia Siemens Networks

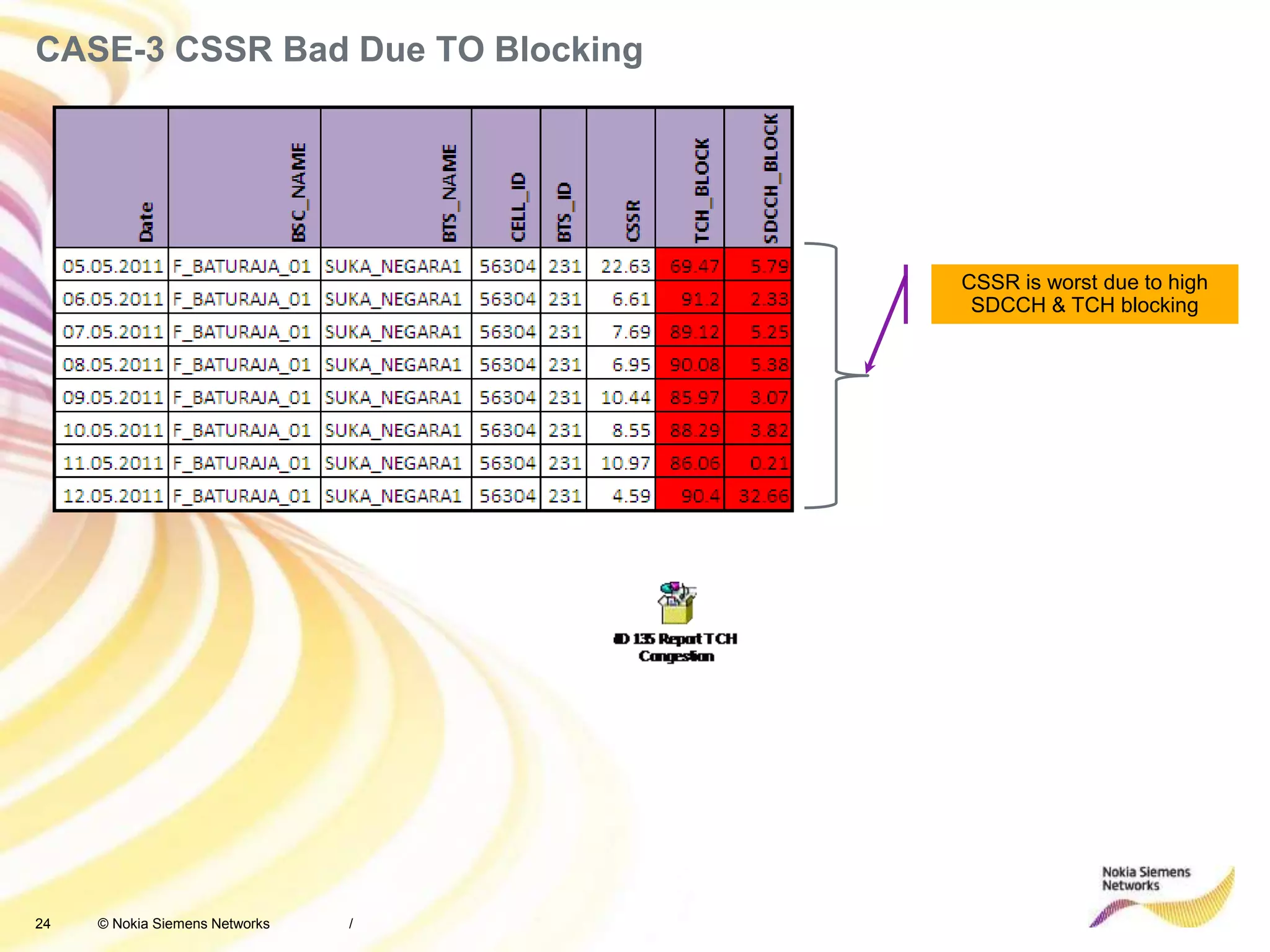

CASE-3 CSSR Bad Due TO Blocking
/
CSSR is worst due to high
SDCCH & TCH blocking
25 © Nokia Siemens Networks

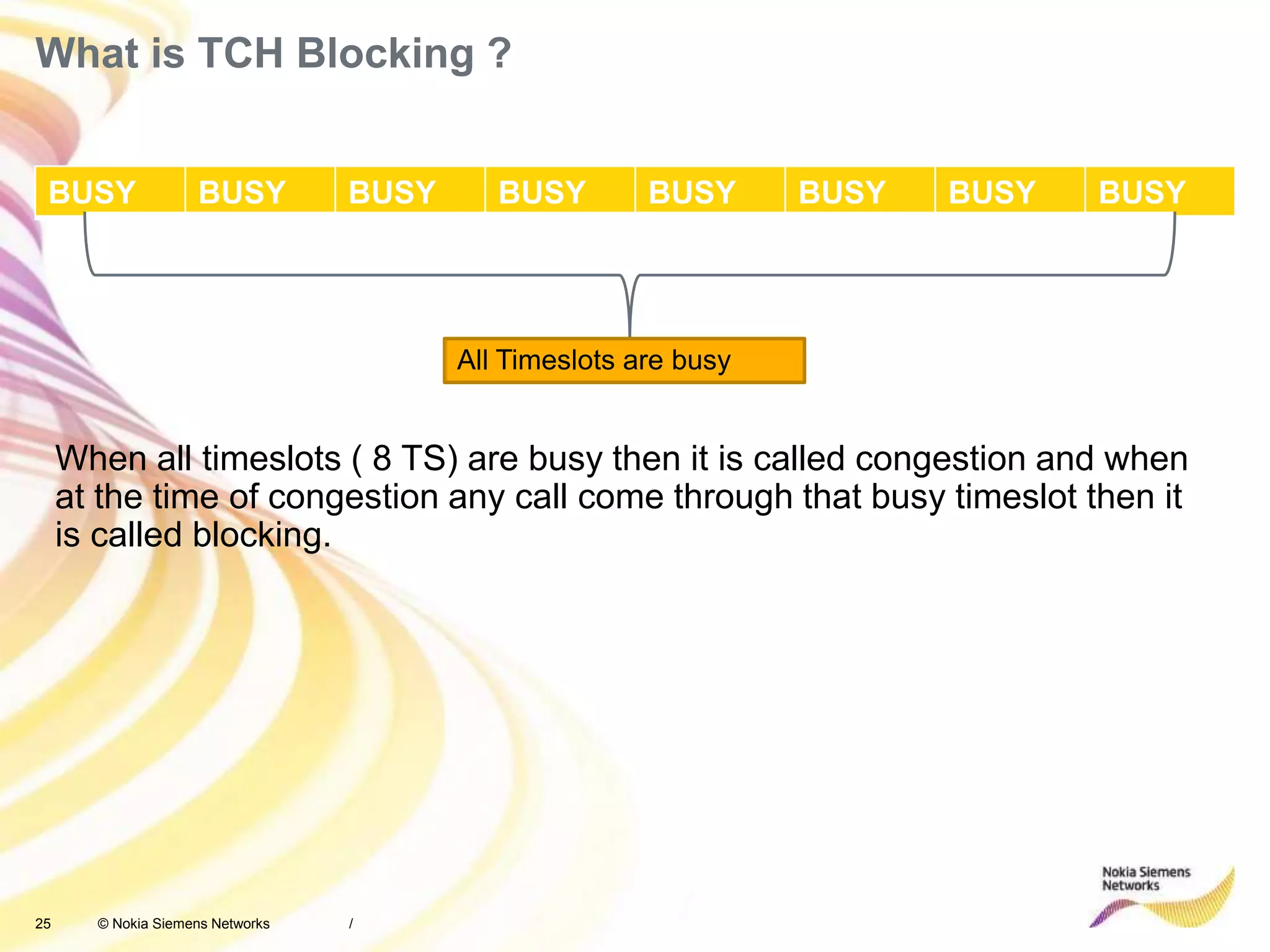

What is TCH Blocking ?
BUSY BUSY BUSY BUSY BUSY BUSY BUSY BUSY
/
All Timeslots are busy
When all timeslots ( 8 TS) are busy then it is called congestion and when
at the time of congestion any call come through that busy timeslot then it
is called blocking.
26 © Nokia Siemens Networks

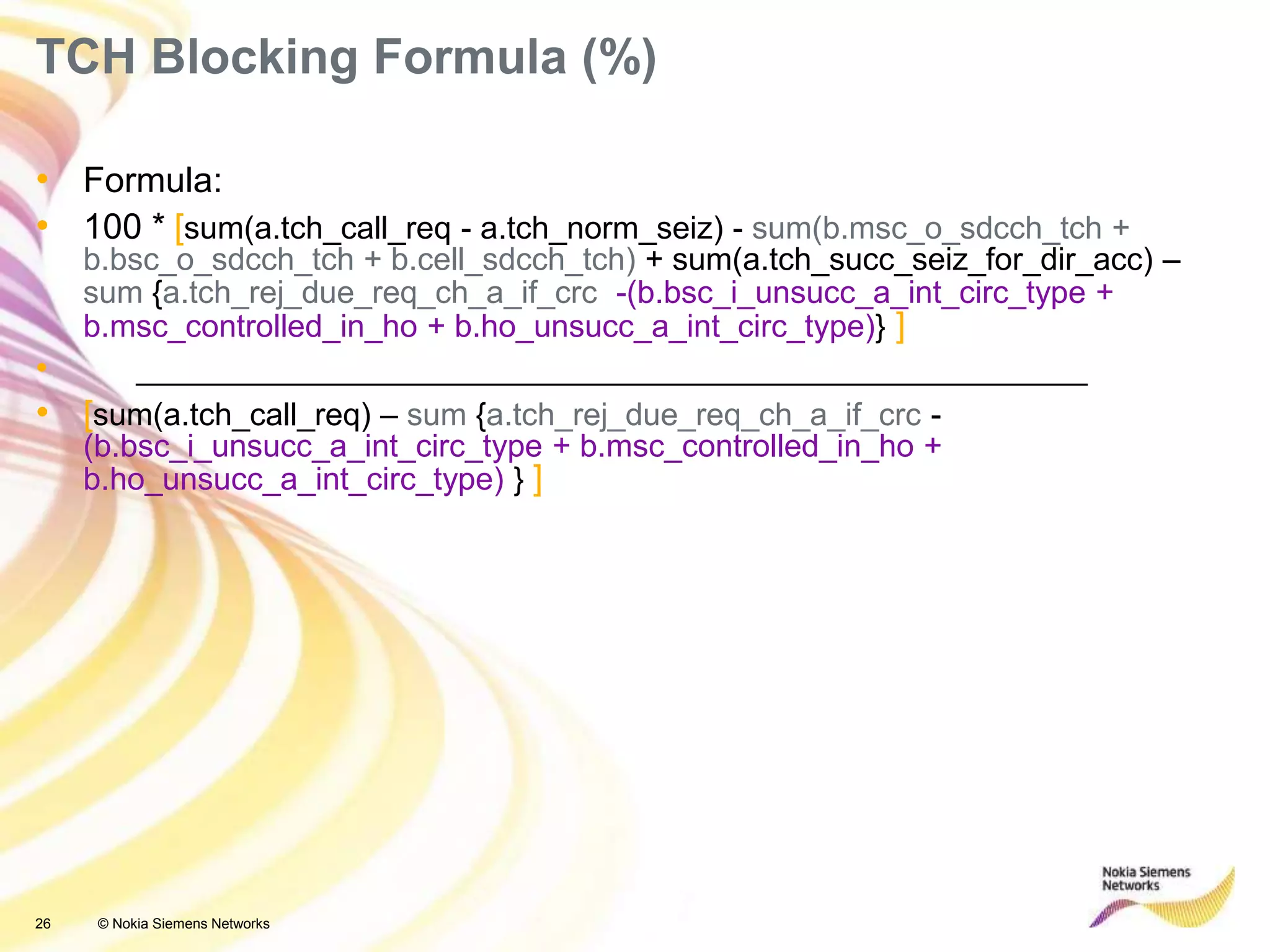

• Formula:
• 100 * [sum(a.tch_call_req - a.tch_norm_seiz) - sum(b.msc_o_sdcch_tch +
b.bsc_o_sdcch_tch + b.cell_sdcch_tch) + sum(a.tch_succ_seiz_for_dir_acc) –
sum {a.tch_rej_due_req_ch_a_if_crc -(b.bsc_i_unsucc_a_int_circ_type +
b.msc_controlled_in_ho + b.ho_unsucc_a_int_circ_type)} ]
• ______________________________________________________
• [sum(a.tch_call_req) – sum {a.tch_rej_due_req_ch_a_if_crc -
(b.bsc_i_unsucc_a_int_circ_type + b.msc_controlled_in_ho +
b.ho_unsucc_a_int_circ_type) } ]
TCH Blocking Formula (%)
27 © Nokia Siemens Networks

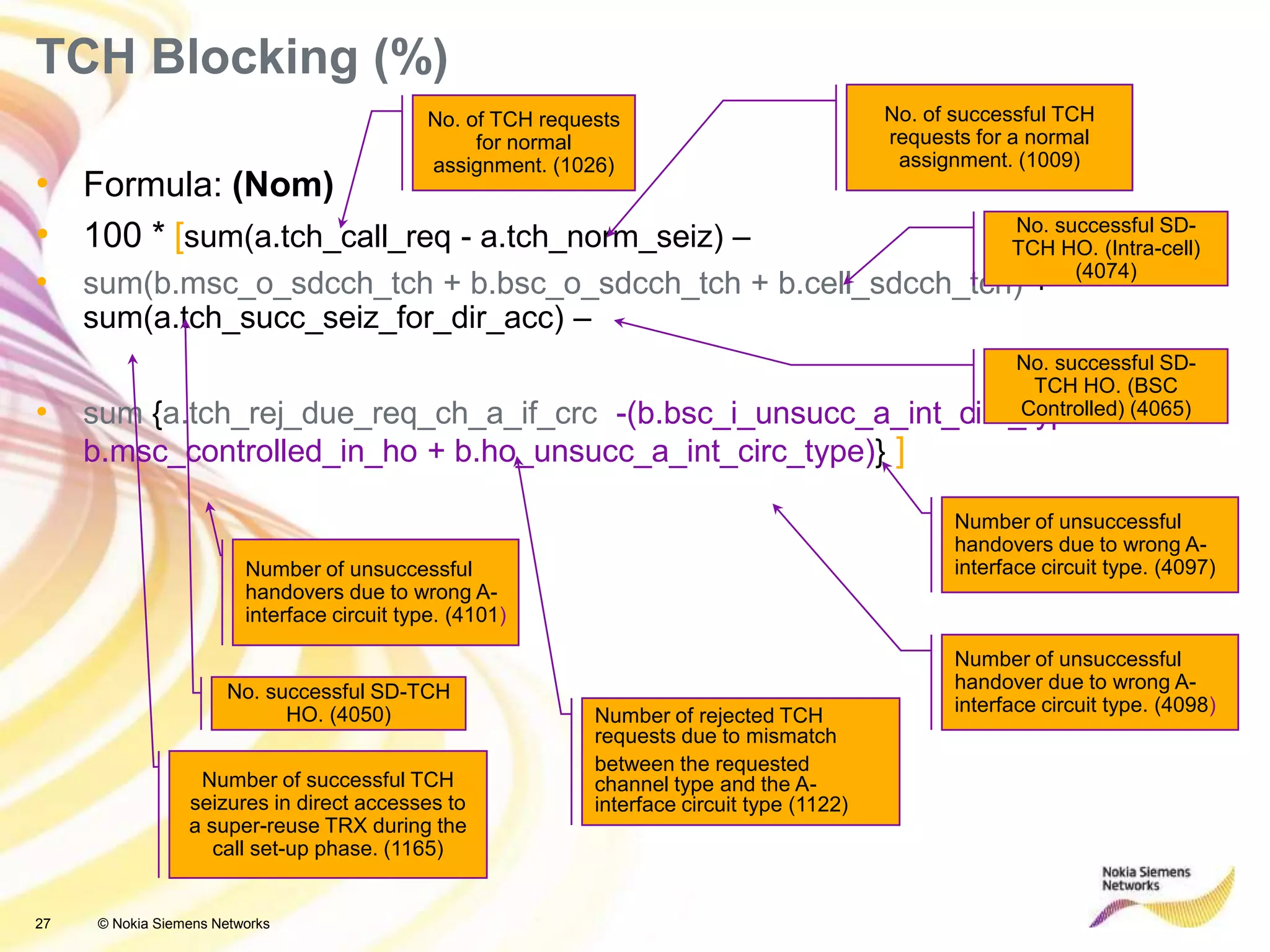

• Formula: (Nom)
• 100 * [sum(a.tch_call_req - a.tch_norm_seiz) –
• sum(b.msc_o_sdcch_tch + b.bsc_o_sdcch_tch + b.cell_sdcch_tch) +
sum(a.tch_succ_seiz_for_dir_acc) –
• sum {a.tch_rej_due_req_ch_a_if_crc -(b.bsc_i_unsucc_a_int_circ_type +
b.msc_controlled_in_ho + b.ho_unsucc_a_int_circ_type)} ]
TCH Blocking (%)
No. of TCH requests
for normal
assignment. (1026)
No. of successful TCH
requests for a normal
assignment. (1009)
No. successful SD-TCH
HO. (4050)
No. successful SD-
TCH HO. (BSC
Controlled) (4065)
No. successful SD-
TCH HO. (Intra-cell)
(4074)
Number of successful TCH
seizures in direct accesses to
a super-reuse TRX during the
call set-up phase. (1165)
Number of rejected TCH
requests due to mismatch
between the requested
channel type and the A-
interface circuit type (1122)
Number of unsuccessful
handovers due to wrong A-
interface circuit type. (4097)
Number of unsuccessful
handover due to wrong A-
interface circuit type. (4098)
Number of unsuccessful
handovers due to wrong A-
interface circuit type. (4101)
28 © Nokia Siemens Networks

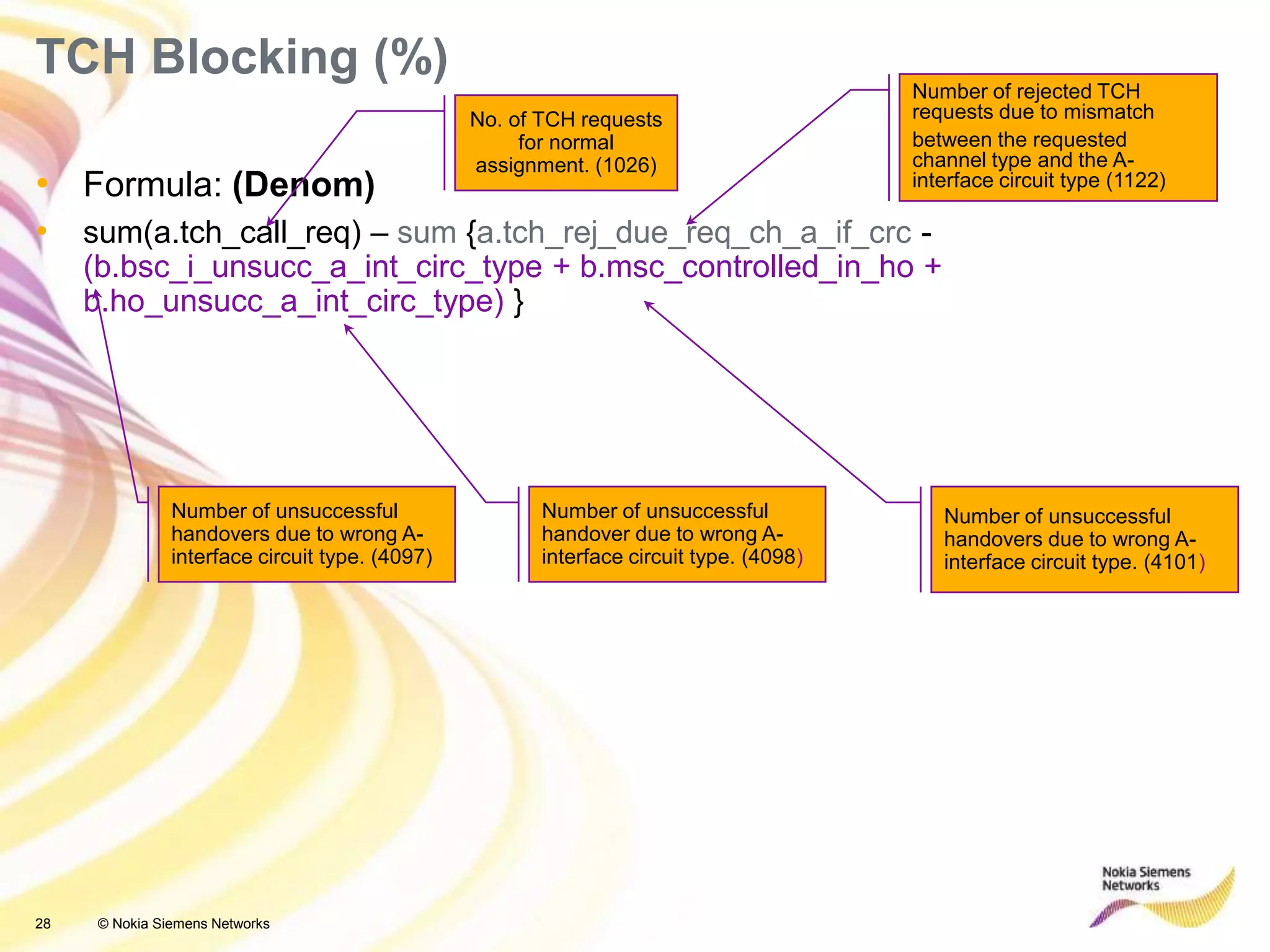

• Formula: (Denom)
• sum(a.tch_call_req) – sum {a.tch_rej_due_req_ch_a_if_crc -
(b.bsc_i_unsucc_a_int_circ_type + b.msc_controlled_in_ho +
b.ho_unsucc_a_int_circ_type) }
TCH Blocking (%)
No. of TCH requests
for normal
assignment. (1026)
Number of rejected TCH
requests due to mismatch
between the requested
channel type and the A-
interface circuit type (1122)
Number of unsuccessful
handovers due to wrong A-
interface circuit type. (4097)
Number of unsuccessful
handovers due to wrong A-
interface circuit type. (4101)
Number of unsuccessful
handover due to wrong A-
interface circuit type. (4098)
29 © Nokia Siemens Networks
TCH Blocking Reasons
• TCH availability
Check alarms (are TRXs & TSLs in Working State? ), check availability
report and RxQuality report to verify whether there is a badly functioning
TRX. Make Loop Tests on TRX. Fix hardware problem.
• TCH capacity
Bad TCH capacity dimensioning. Check number of TRXs.
/
30 © Nokia Siemens Networks

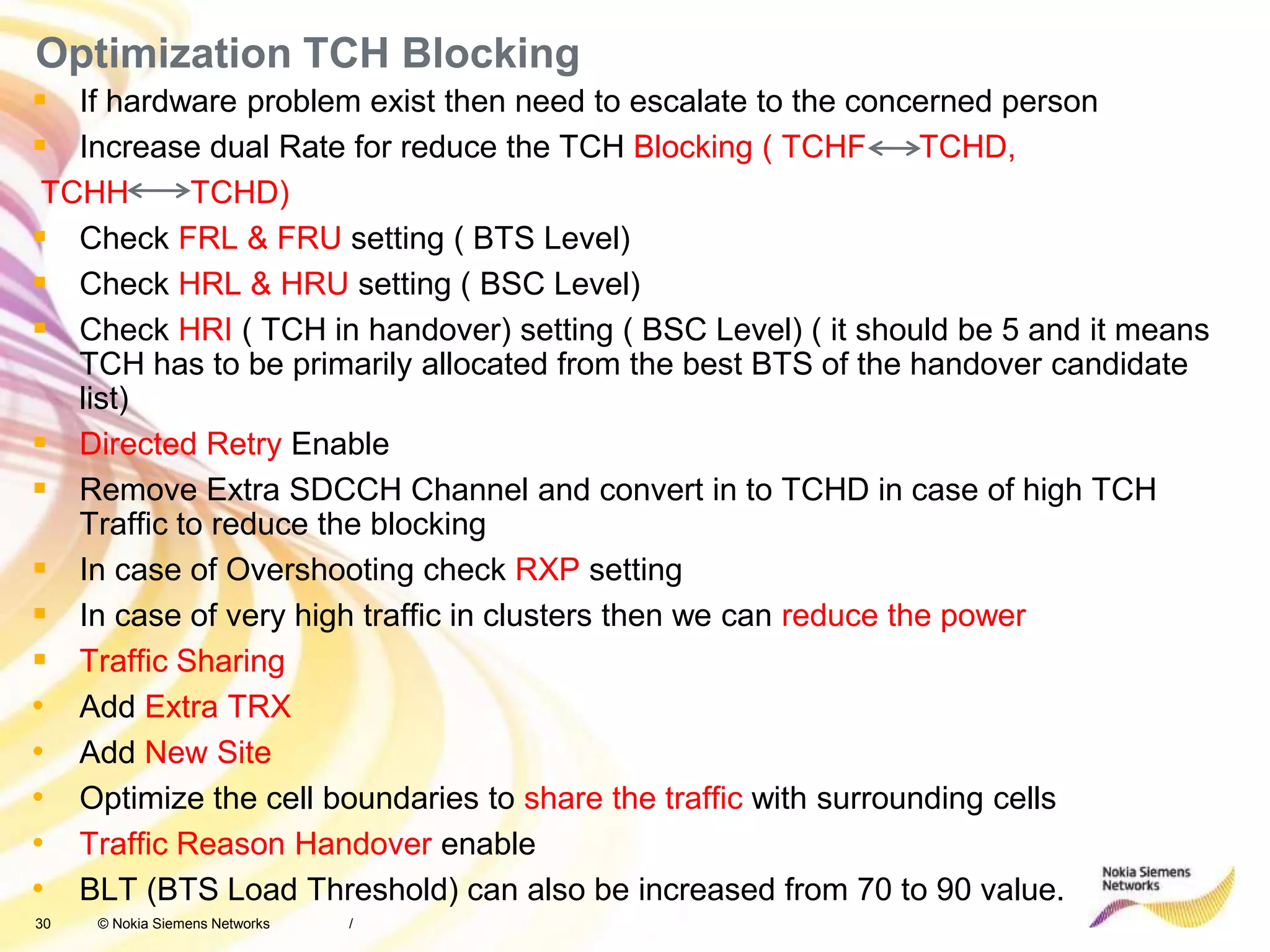

Optimization TCH Blocking
 If hardware problem exist then need to escalate to the concerned person
 Increase dual Rate for reduce the TCH Blocking ( TCHF TCHD,
TCHH TCHD)
 Check FRL & FRU setting ( BTS Level)
 Check HRL & HRU setting ( BSC Level)
 Check HRI ( TCH in handover) setting ( BSC Level) ( it should be 5 and it means
TCH has to be primarily allocated from the best BTS of the handover candidate
list)
 Directed Retry Enable
 Remove Extra SDCCH Channel and convert in to TCHD in case of high TCH
Traffic to reduce the blocking
 In case of Overshooting check RXP setting
 In case of very high traffic in clusters then we can reduce the power
 Traffic Sharing
• Add Extra TRX
• Add New Site
• Optimize the cell boundaries to share the traffic with surrounding cells
• Traffic Reason Handover enable
• BLT (BTS Load Threshold) can also be increased from 70 to 90 value.
/
31 © Nokia Siemens Networks

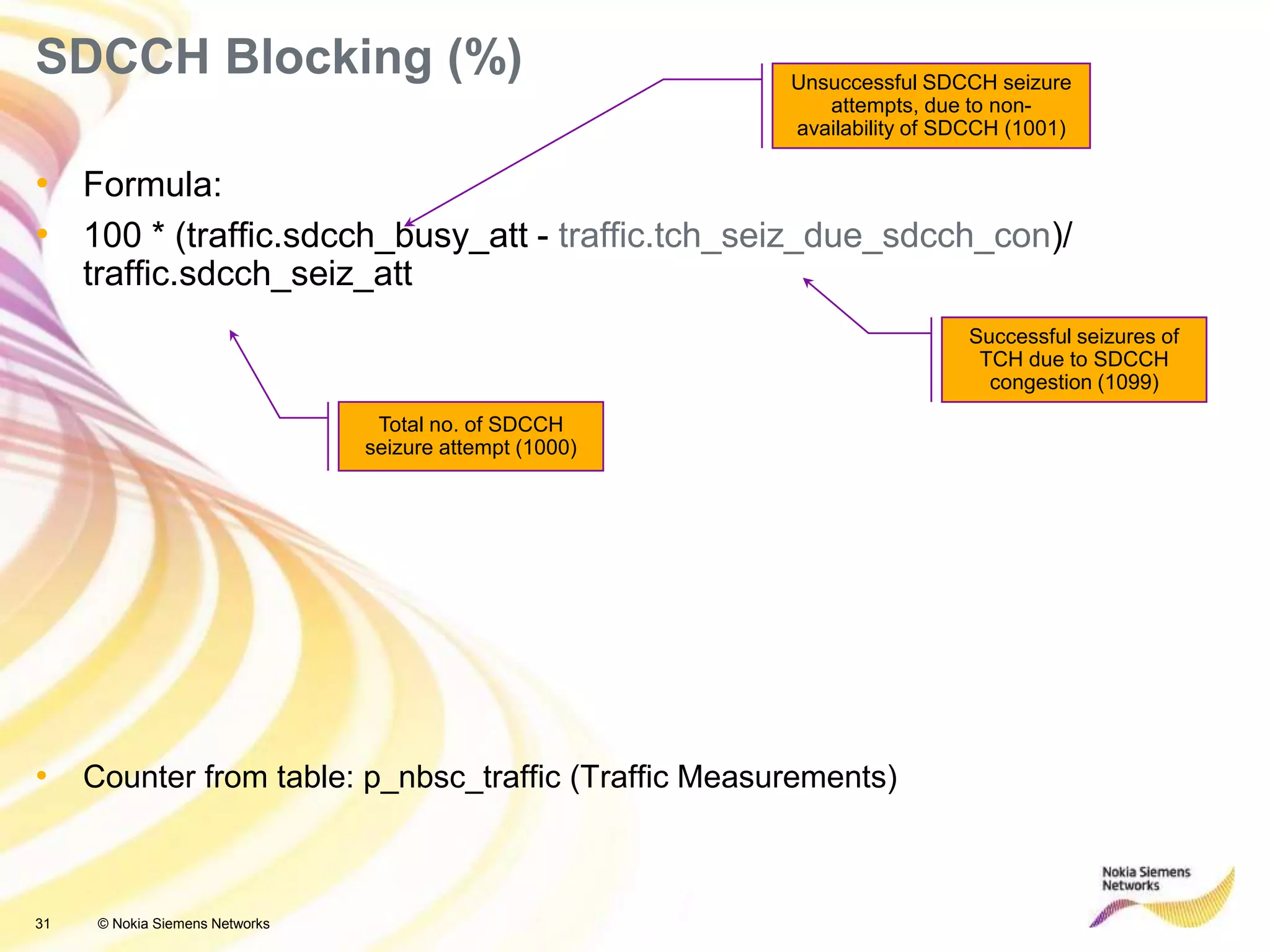

• Formula:
• 100 * (traffic.sdcch_busy_att - traffic.tch_seiz_due_sdcch_con)/
traffic.sdcch_seiz_att
• Counter from table: p_nbsc_traffic (Traffic Measurements)
SDCCH Blocking (%) Unsuccessful SDCCH seizure
attempts, due to non-
availability of SDCCH (1001)
Successful seizures of
TCH due to SDCCH
congestion (1099)
Total no. of SDCCH
seizure attempt (1000)
32 © Nokia Siemens Networks
SDCCH BLOCKING REASONS
/
 Too much SDCCH “normal” traffic for cell SDCCH design
- Logical cell design, extra TRX, new site
 LA border at crowded area ( Check HYS Setting)
 Abnormal SDCCH traffic
- “phantom” channel requests
- Inadequate LAC design, causing too much LU
- Redesign LAC
- Problem with neighbor cells belong to other LAC
33 © Nokia Siemens Networks

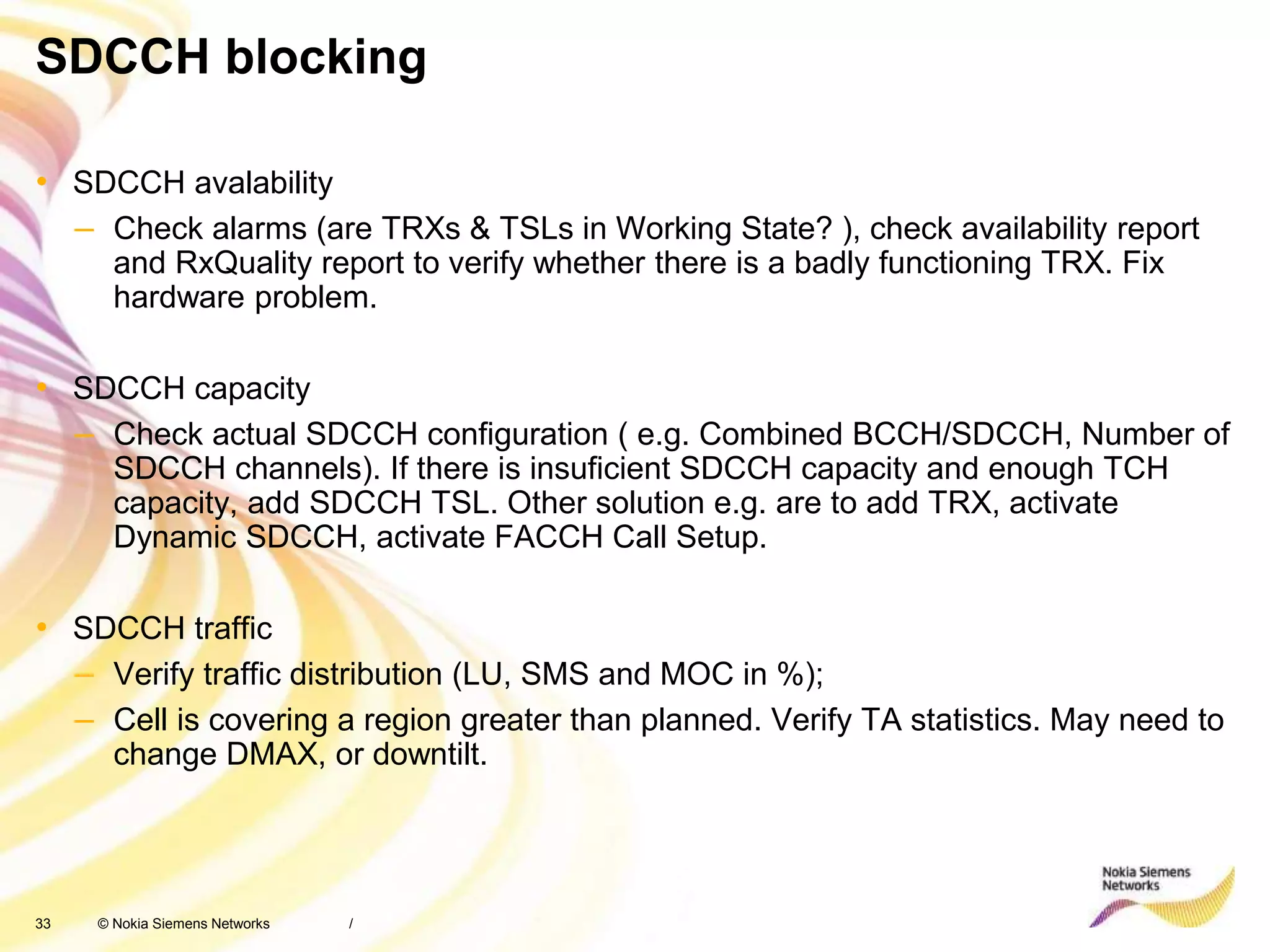

SDCCH blocking
• SDCCH avalability
– Check alarms (are TRXs & TSLs in Working State? ), check availability report
and RxQuality report to verify whether there is a badly functioning TRX. Fix
hardware problem.
• SDCCH capacity
– Check actual SDCCH configuration ( e.g. Combined BCCH/SDCCH, Number of
SDCCH channels). If there is insuficient SDCCH capacity and enough TCH
capacity, add SDCCH TSL. Other solution e.g. are to add TRX, activate
Dynamic SDCCH, activate FACCH Call Setup.
• SDCCH traffic
– Verify traffic distribution (LU, SMS and MOC in %);
– Cell is covering a region greater than planned. Verify TA statistics. May need to
change DMAX, or downtilt.
/

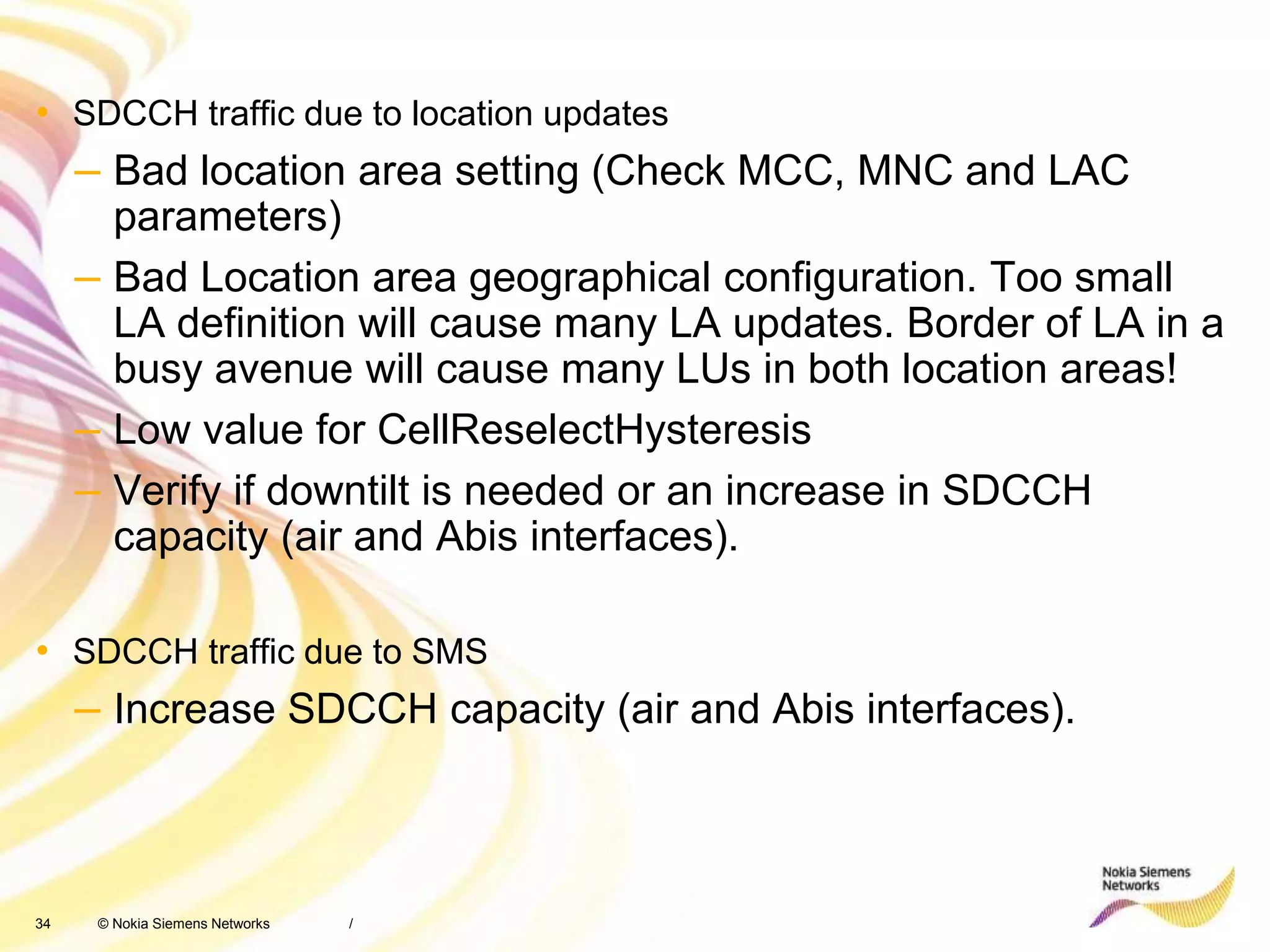

34 © Nokia Siemens Networks
• SDCCH traffic due to location updates
– Bad location area setting (Check MCC, MNC and LAC
parameters)
– Bad Location area geographical configuration. Too small
LA definition will cause many LA updates. Border of LA in a
busy avenue will cause many LUs in both location areas!
– Low value for CellReselectHysteresis
– Verify if downtilt is needed or an increase in SDCCH
capacity (air and Abis interfaces).
• SDCCH traffic due to SMS
– Increase SDCCH capacity (air and Abis interfaces).
/
35 © Nokia Siemens Networks

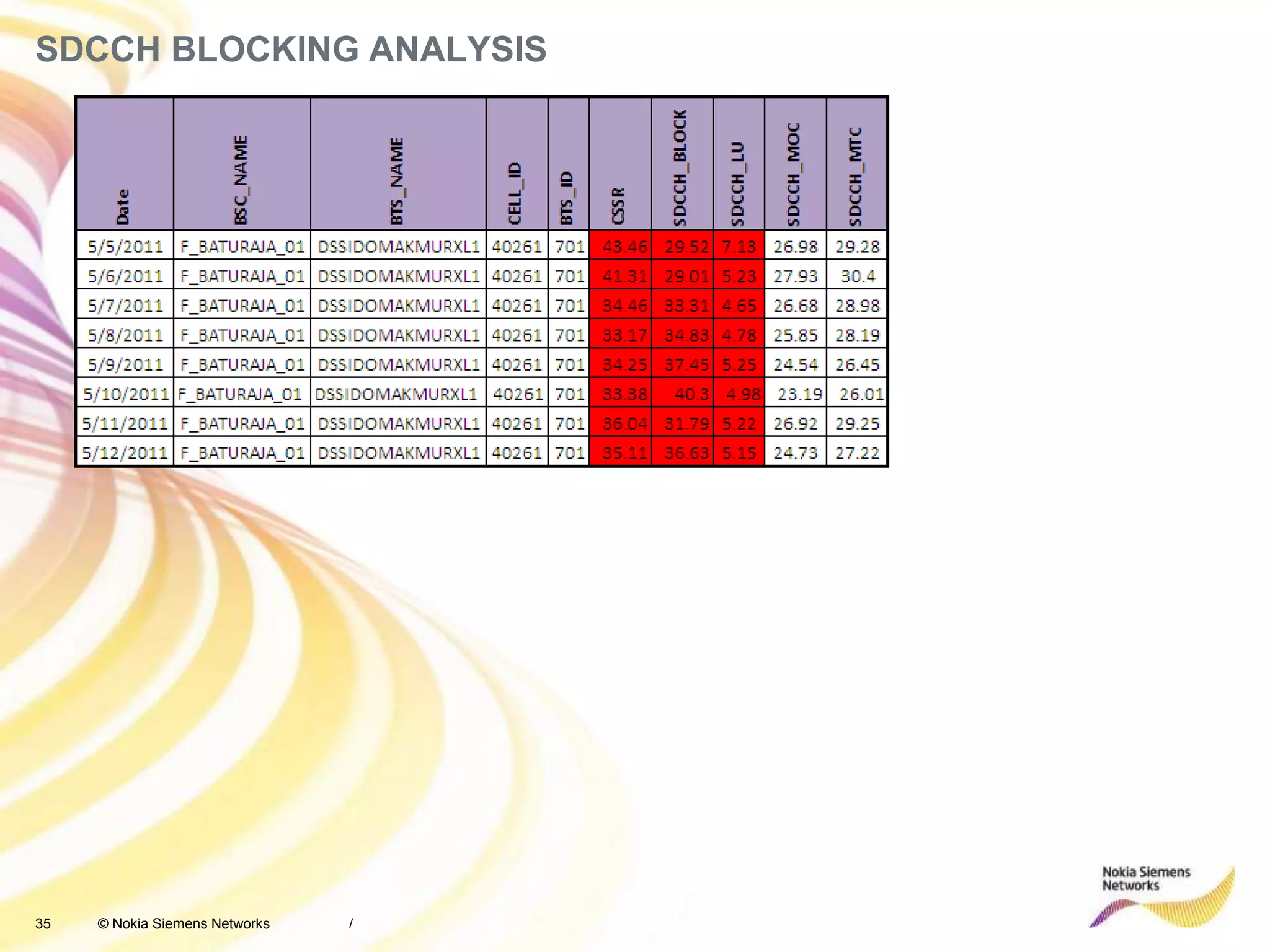

SDCCH BLOCKING ANALYSIS
/
36 © Nokia Siemens Networks
DCR FORMULA
• sum(tch_radio_fail+ tch_rf_old_ho+ tch_abis_fail_call+ tch_abis_fail_old+
tch_a_if_fail_call+ tch_a_if_fail_old+ tch_tr_fail+ tch_tr_fail_old+ tch_lapd_fail
+ tch_bts_fail+ tch_user_act+ tch_bcsu_reset+ tch_netw_act+ tch_act_fail_call)
100 * ------------------------------------------------------------------- %
sum(a.tch_norm_seiz) ;(normal calls) + sum(c.msc_i_sdcch_tch +
c.bsc_i_sdcch_tch) ;(calls started via DR) + sum(a.tch_seiz_due_sdcch_con)
;calls started as FACCH call setup
• Counters from table(s):
• a = p_nbsc_traffic
• b = p_nbsc_res_access
/
37 © Nokia Siemens Networks

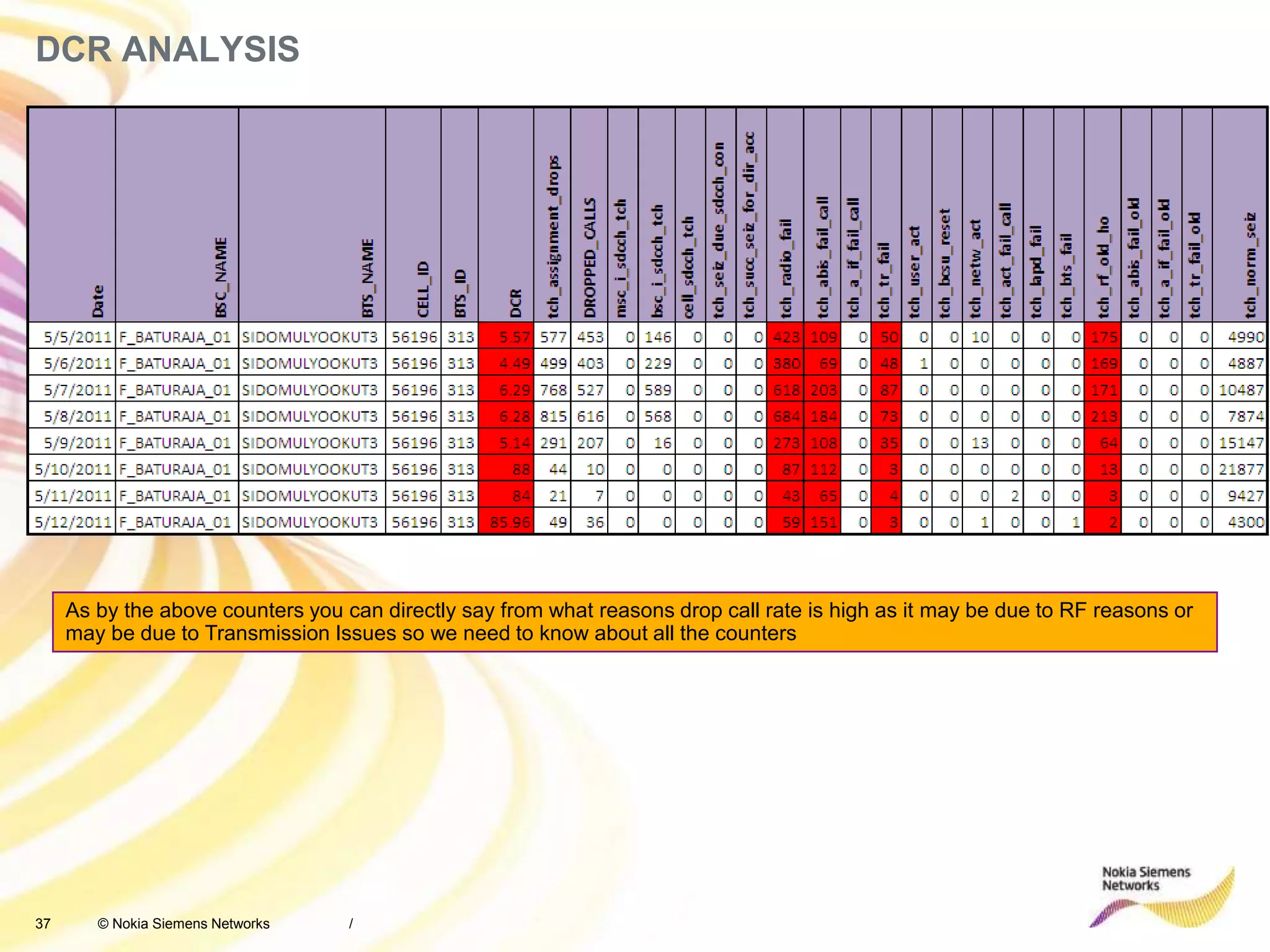

DCR ANALYSIS
/
As by the above counters you can directly say from what reasons drop call rate is high as it may be due to RF reasons or
may be due to Transmission Issues so we need to know about all the counters
38 © Nokia Siemens Networks

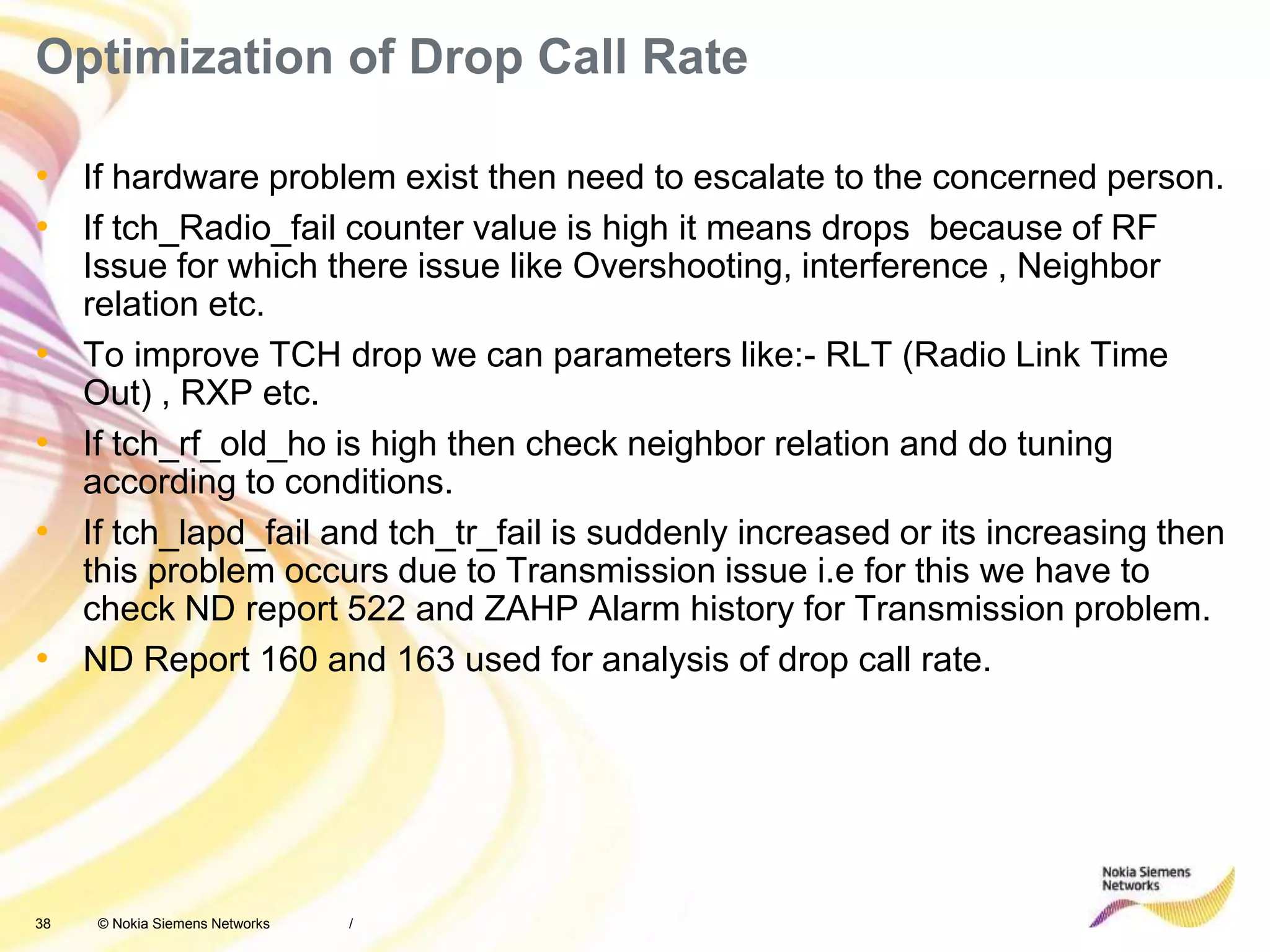

Optimization of Drop Call Rate
• If hardware problem exist then need to escalate to the concerned person.
• If tch_Radio_fail counter value is high it means drops because of RF
Issue for which there issue like Overshooting, interference , Neighbor
relation etc.
• To improve TCH drop we can parameters like:- RLT (Radio Link Time
Out) , RXP etc.
• If tch_rf_old_ho is high then check neighbor relation and do tuning
according to conditions.
• If tch_lapd_fail and tch_tr_fail is suddenly increased or its increasing then
this problem occurs due to Transmission issue i.e for this we have to
check ND report 522 and ZAHP Alarm history for Transmission problem.
• ND Report 160 and 163 used for analysis of drop call rate.
/
39 © Nokia Siemens Networks
TCH Drop
/
Radio Fails
Check alarms and RxQuality report to verify whether there is a badly functioning TRX.
Fix hardware problem. Check antenna line.
Coverage. Verify TA report and planning tool.
Interference. Check Frequency Plan. Solution e.g. add sites, downtilt antennas, increase
RxLevAccessMin.
Lack of neighbours
Bad neighbour declaration
Transcoder Failure
Due to synchronisation problem. Synchronisation source set in BTS clock. Change to
BSC.
AIF Failure:
Interface failures: problem with ET cards. Solution: block the circuits connected to this
card and then change ET card when available.
40 © Nokia Siemens Networks

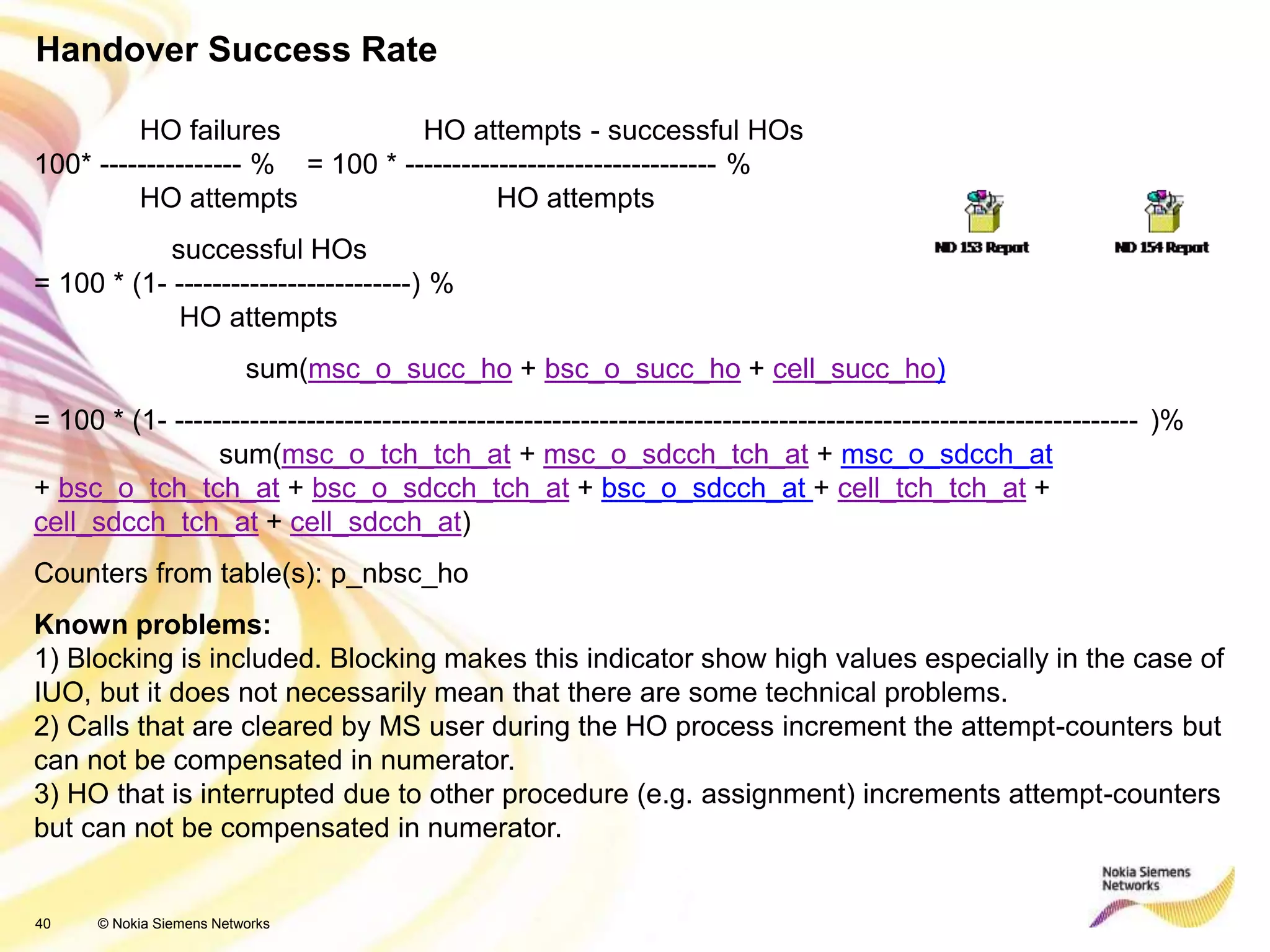

Handover Success Rate
HO failures HO attempts - successful HOs
100* --------------- % = 100 * --------------------------------- %
HO attempts HO attempts
successful HOs
= 100 * (1- -------------------------) %
HO attempts
sum(msc_o_succ_ho + bsc_o_succ_ho + cell_succ_ho)
= 100 * (1- ------------------------------------------------------------------------------------------------------ )%
sum(msc_o_tch_tch_at + msc_o_sdcch_tch_at + msc_o_sdcch_at
+ bsc_o_tch_tch_at + bsc_o_sdcch_tch_at + bsc_o_sdcch_at + cell_tch_tch_at +
cell_sdcch_tch_at + cell_sdcch_at)
Counters from table(s): p_nbsc_ho
Known problems:
1) Blocking is included. Blocking makes this indicator show high values especially in the case of
IUO, but it does not necessarily mean that there are some technical problems.
2) Calls that are cleared by MS user during the HO process increment the attempt-counters but
can not be compensated in numerator.
3) HO that is interrupted due to other procedure (e.g. assignment) increments attempt-counters
but can not be compensated in numerator.
41 © Nokia Siemens Networks 41 © 2005 Nokia V1-Filename.ppt / yyyy-mm-dd / Initials
Worse Hand over Cell
Is Blocking High?
Hardware issue
suspected
No
RF Issues suspected
Check 154 HO Report to find out UL and DL quality, UL interference band
Check Alarm
Check 153 HO report to find out majority failures
towards which cells?
Yes
Possible reasons: Target cell has co-channel/Adj channel interference, coverage gaps, neighbor BCCH/BSIC
frequency not updated, wrong CGI format in MSC, wrong HO number in MSC, Non-symmetric HO relations, synchronization
problem, excessive UL interference, site too high, Direct Retry traffic cause high HO Failures.
.
Check TRX
Configuration
No
Check LAC in the case of Inter BSC and MSC HO
42 © Nokia Siemens Networks

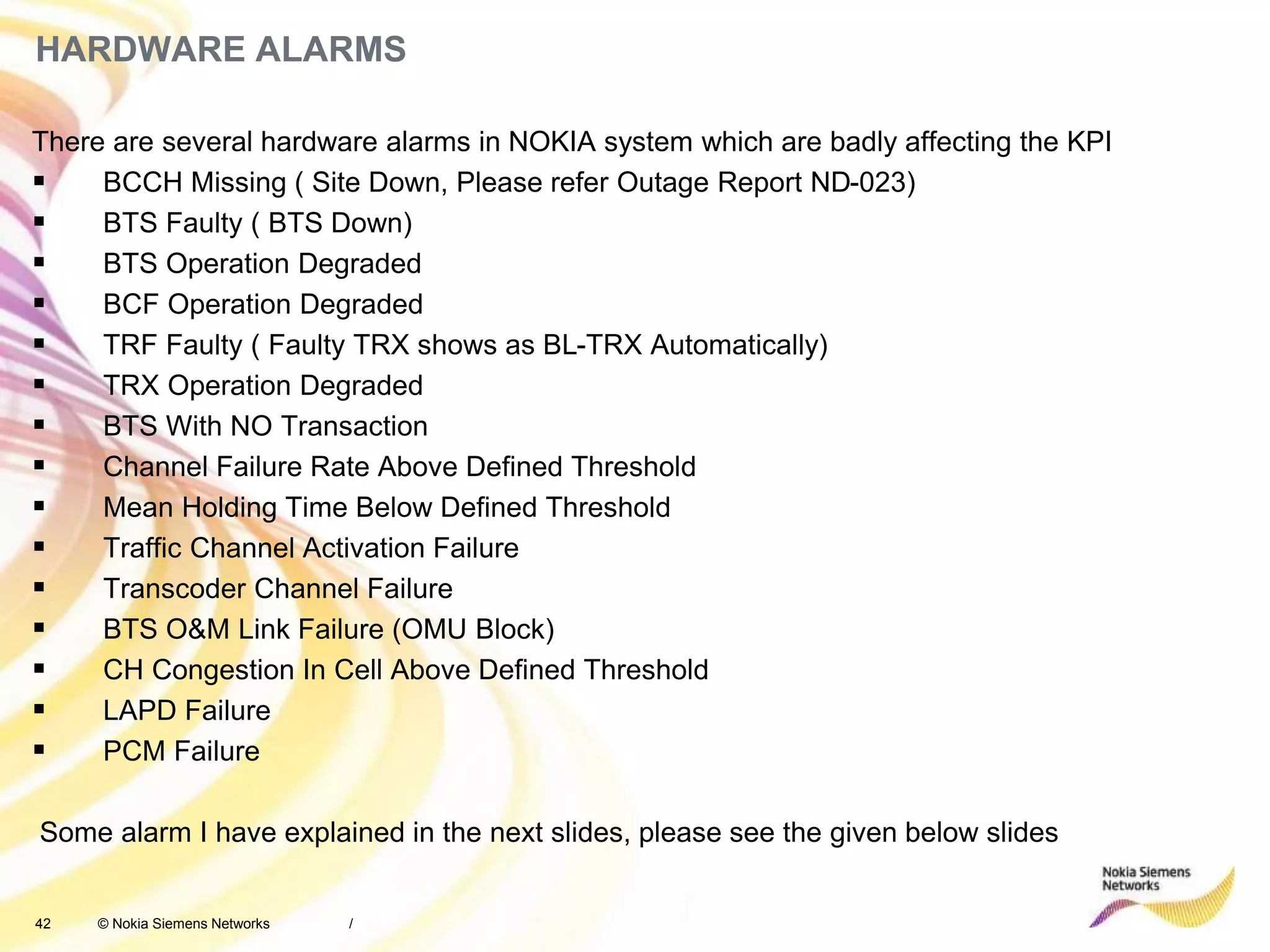

HARDWARE ALARMS
There are several hardware alarms in NOKIA system which are badly affecting the KPI
 BCCH Missing ( Site Down, Please refer Outage Report ND-023)
 BTS Faulty ( BTS Down)
 BTS Operation Degraded
 BCF Operation Degraded
 TRF Faulty ( Faulty TRX shows as BL-TRX Automatically)
 TRX Operation Degraded
 BTS With NO Transaction
 Channel Failure Rate Above Defined Threshold
 Mean Holding Time Below Defined Threshold
 Traffic Channel Activation Failure
 Transcoder Channel Failure
 BTS O&M Link Failure (OMU Block)
 CH Congestion In Cell Above Defined Threshold
 LAPD Failure
 PCM Failure
Some alarm I have explained in the next slides, please see the given below slides
/
43 © Nokia Siemens Networks

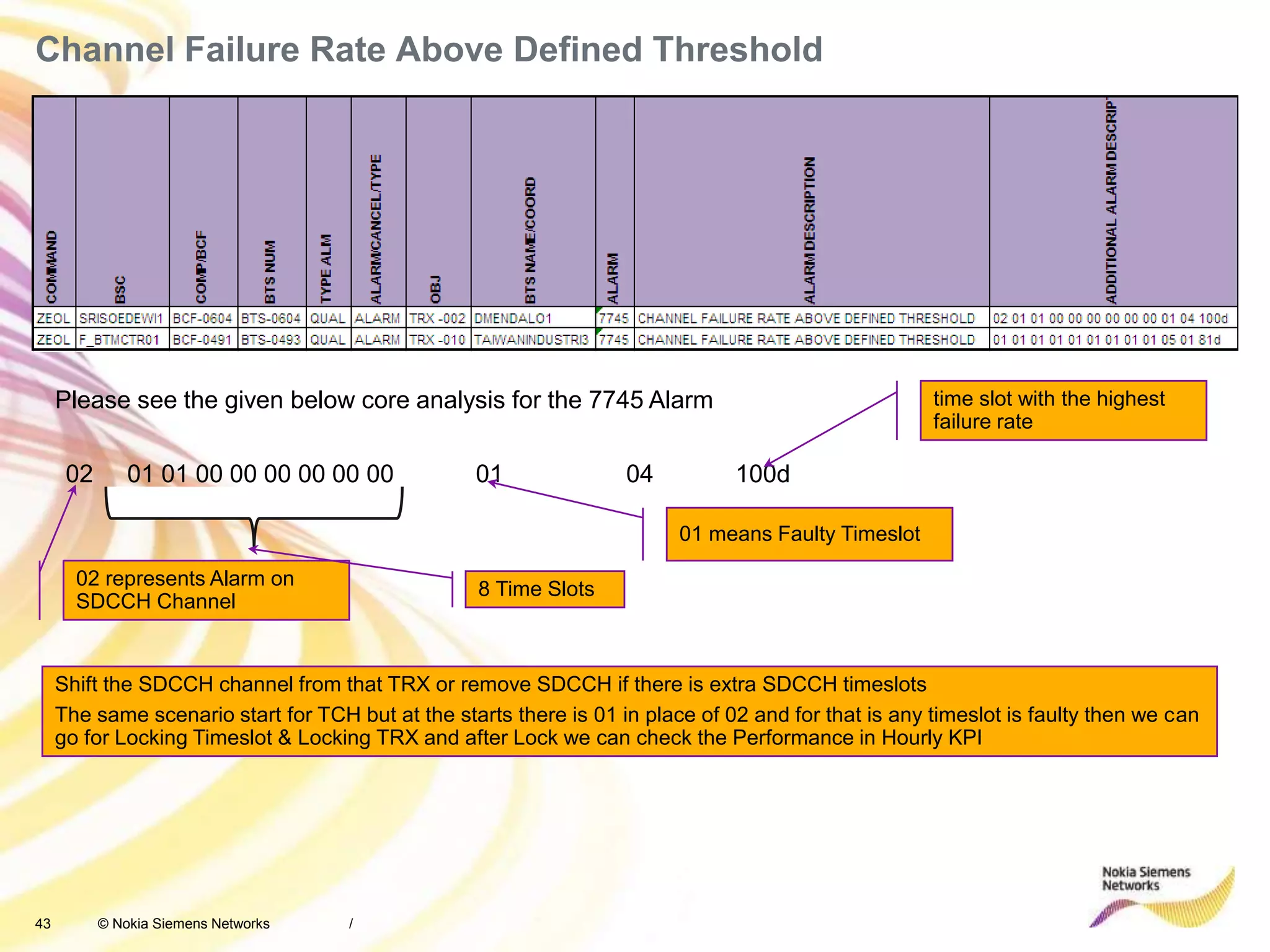

Channel Failure Rate Above Defined Threshold
/
Please see the given below core analysis for the 7745 Alarm
02 01 01 00 00 00 00 00 00 01 04 100d
02 represents Alarm on
SDCCH Channel
8 Time Slots
01 means Faulty Timeslot
time slot with the highest
failure rate
Shift the SDCCH channel from that TRX or remove SDCCH if there is extra SDCCH timeslots
The same scenario start for TCH but at the starts there is 01 in place of 02 and for that is any timeslot is faulty then we can
go for Locking Timeslot & Locking TRX and after Lock we can check the Performance in Hourly KPI
44 © Nokia Siemens Networks

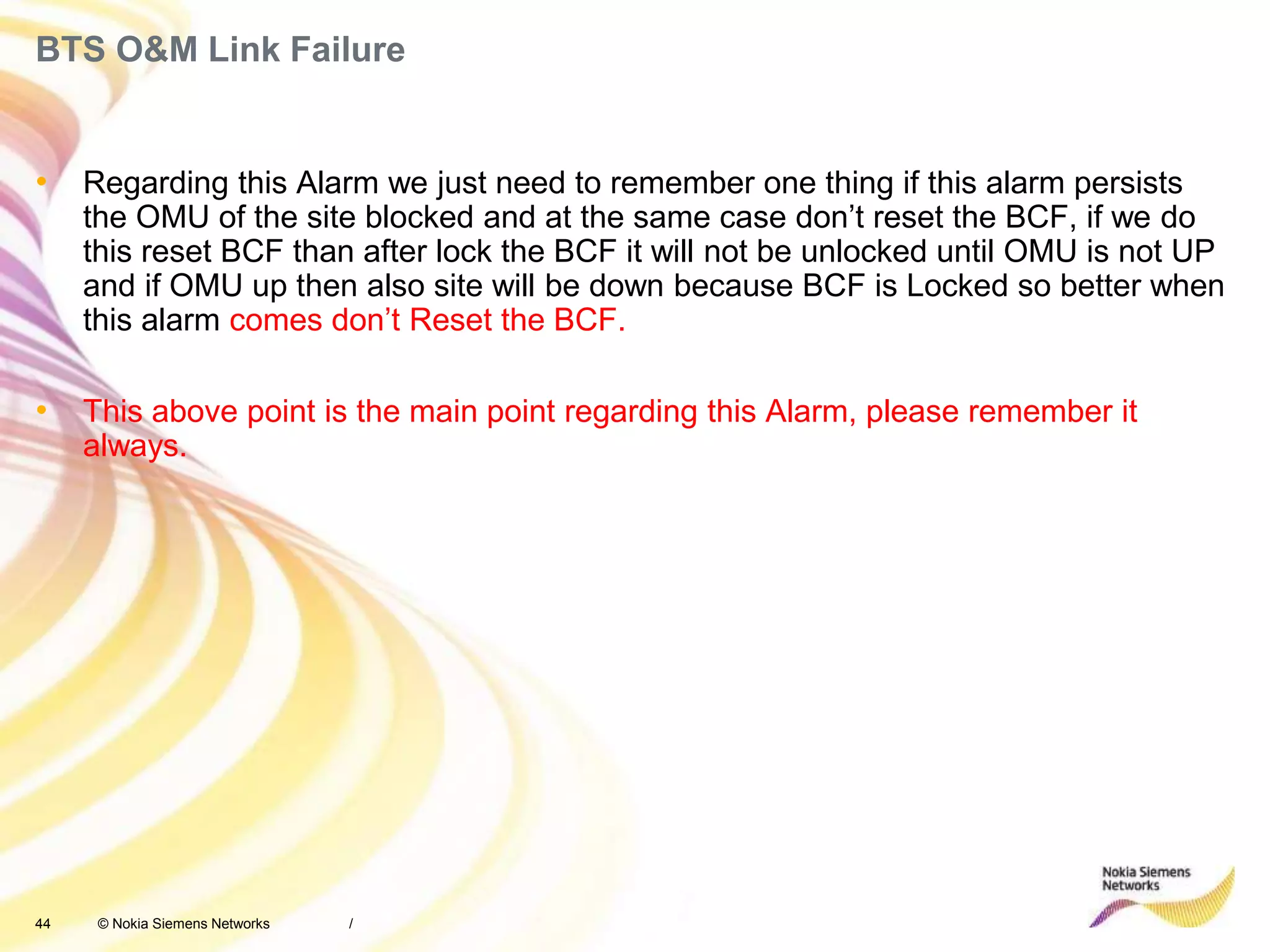

BTS O&M Link Failure
/
• Regarding this Alarm we just need to remember one thing if this alarm persists
the OMU of the site blocked and at the same case don’t reset the BCF, if we do
this reset BCF than after lock the BCF it will not be unlocked until OMU is not UP
and if OMU up then also site will be down because BCF is Locked so better when
this alarm comes don’t Reset the BCF.
• This above point is the main point regarding this Alarm, please remember it
always.
45 © Nokia Siemens Networks

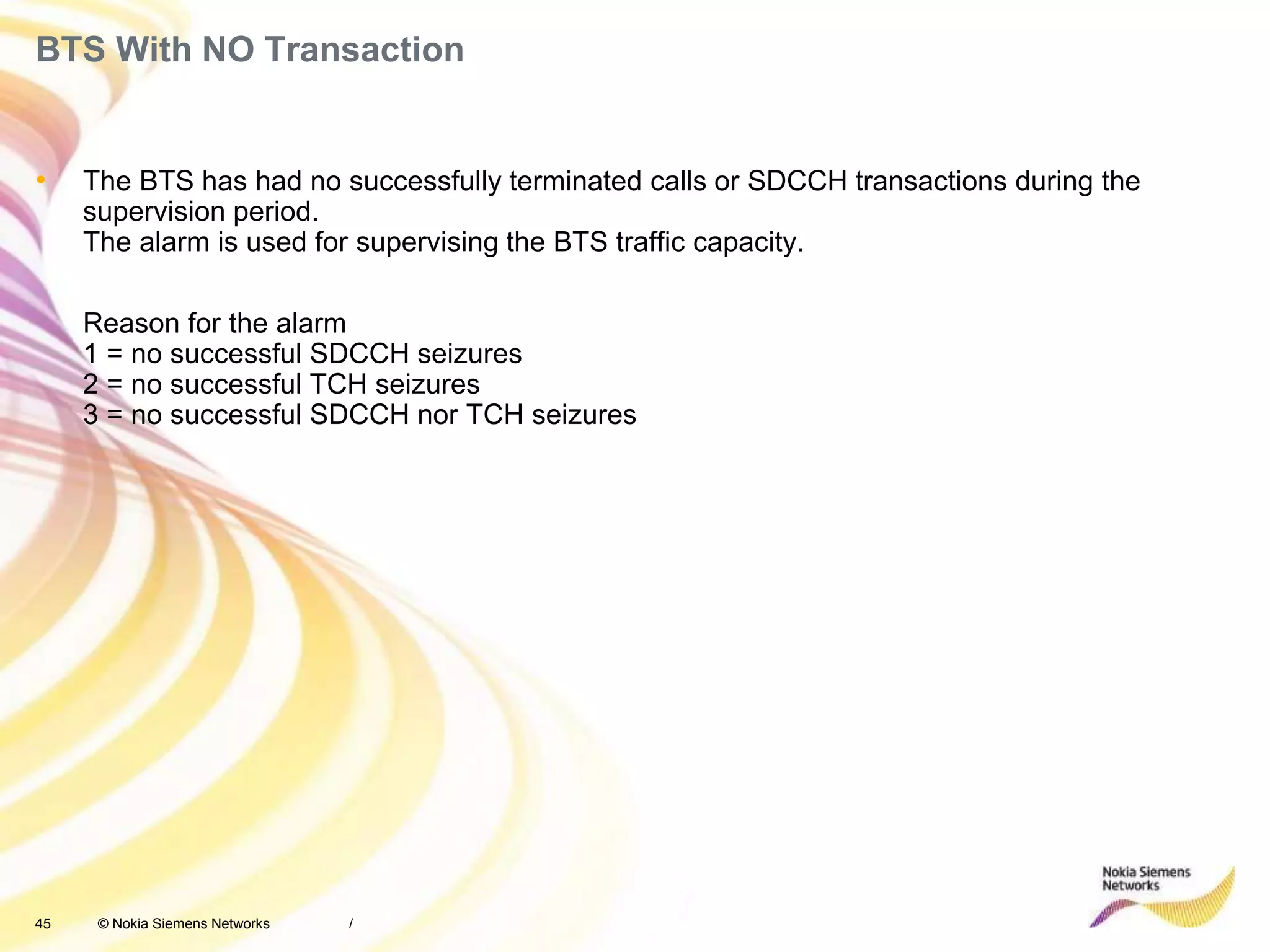

BTS With NO Transaction
• The BTS has had no successfully terminated calls or SDCCH transactions during the
supervision period.
The alarm is used for supervising the BTS traffic capacity.
Reason for the alarm
1 = no successful SDCCH seizures
2 = no successful TCH seizures
3 = no successful SDCCH nor TCH seizures
/
46 © Nokia Siemens Networks
PCM Failure
• Alarm 7704 is BCF-specific. It is used by the RNW recovery part of the BSS system. This alarm (and
cancel) will cause radio network recovery actions concerning objects connected through the faulty
PCM (ET). Alarm 7704 does not occur alone. There are always some other alarms ( 7767, 2900, 2915,
7706, 7704) active at the same time.
• 7767 : BCCH Missing
• 2900: Incoming Signal Missing
• 2915: Fault Rate Monitoring ( the trunk network circuit supervision clears the calls that come through the
ET(S) in question and directs new calls through trunk circuits which are in order )
• 7706: BTS O&M LINK FAILURE
/
47 © Nokia Siemens Networks /

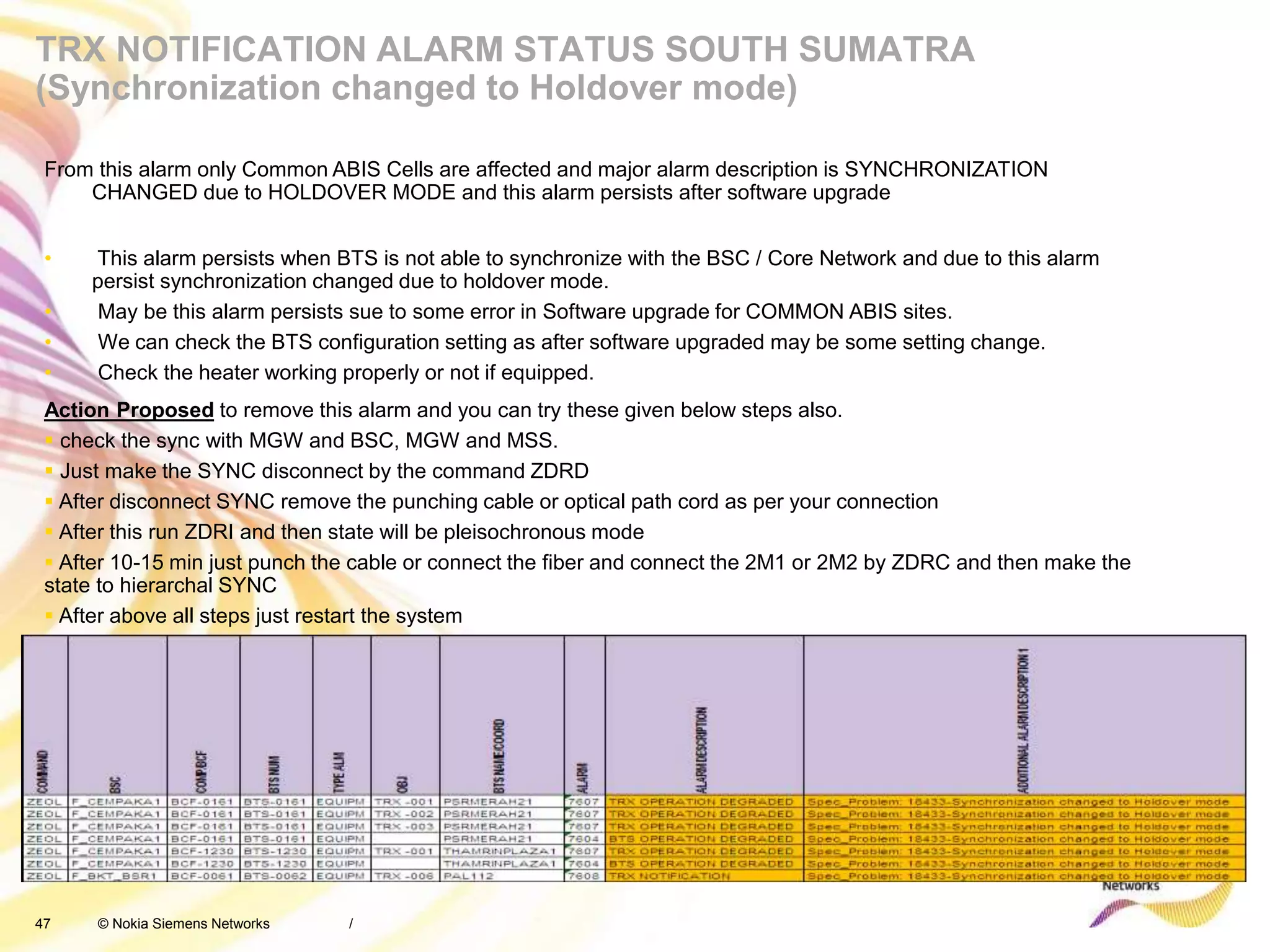

TRX NOTIFICATION ALARM STATUS SOUTH SUMATRA
(Synchronization changed to Holdover mode)
From this alarm only Common ABIS Cells are affected and major alarm description is SYNCHRONIZATION
CHANGED due to HOLDOVER MODE and this alarm persists after software upgrade
• This alarm persists when BTS is not able to synchronize with the BSC / Core Network and due to this alarm
persist synchronization changed due to holdover mode.
• May be this alarm persists sue to some error in Software upgrade for COMMON ABIS sites.
• We can check the BTS configuration setting as after software upgraded may be some setting change.
• Check the heater working properly or not if equipped.
Action Proposed to remove this alarm and you can try these given below steps also.
 check the sync with MGW and BSC, MGW and MSS.
 Just make the SYNC disconnect by the command ZDRD
 After disconnect SYNC remove the punching cable or optical path cord as per your connection
 After this run ZDRI and then state will be pleisochronous mode
 After 10-15 min just punch the cable or connect the fiber and connect the 2M1 or 2M2 by ZDRC and then make the
state to hierarchal SYNC
 After above all steps just restart the system
48 © Nokia Siemens Networks

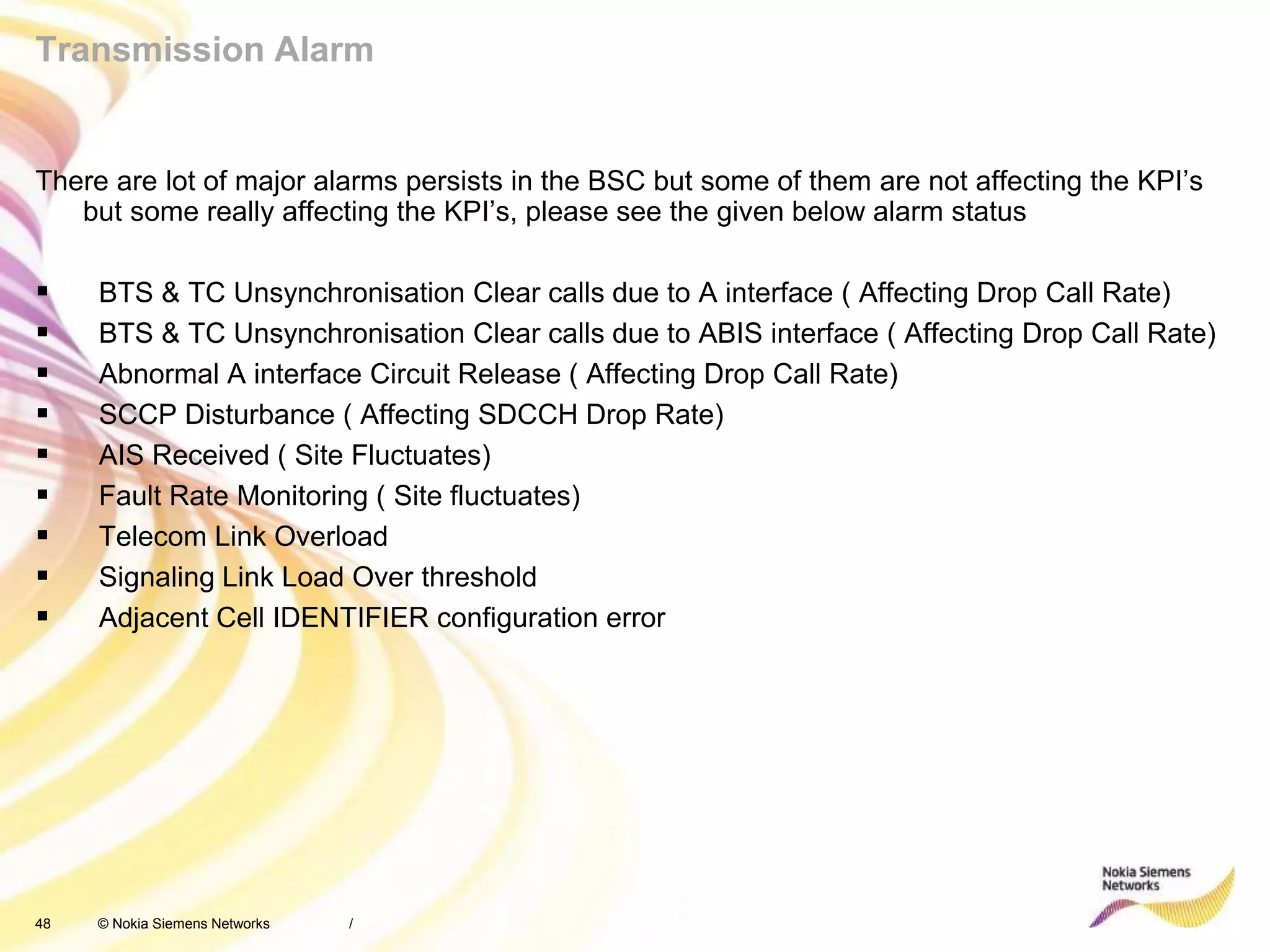

Transmission Alarm
There are lot of major alarms persists in the BSC but some of them are not affecting the KPI’s
but some really affecting the KPI’s, please see the given below alarm status
 BTS & TC Unsynchronisation Clear calls due to A interface ( Affecting Drop Call Rate)
 BTS & TC Unsynchronisation Clear calls due to ABIS interface ( Affecting Drop Call Rate)
 Abnormal A interface Circuit Release ( Affecting Drop Call Rate)
 SCCP Disturbance ( Affecting SDCCH Drop Rate)
 AIS Received ( Site Fluctuates)
 Fault Rate Monitoring ( Site fluctuates)
 Telecom Link Overload
 Signaling Link Load Over threshold
 Adjacent Cell IDENTIFIER configuration error
/
49 © Nokia Siemens Networks

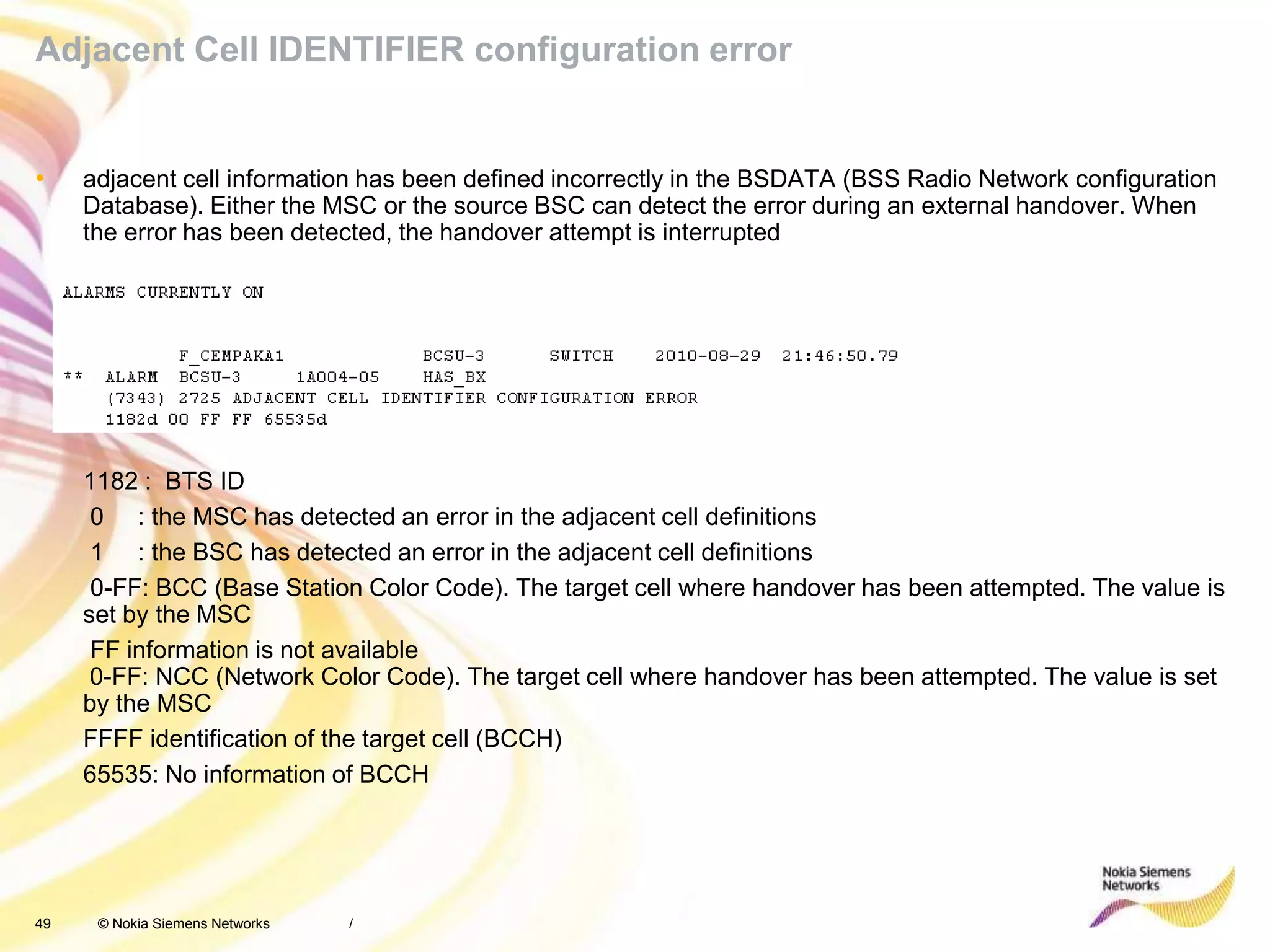

Adjacent Cell IDENTIFIER configuration error
• adjacent cell information has been defined incorrectly in the BSDATA (BSS Radio Network configuration
Database). Either the MSC or the source BSC can detect the error during an external handover. When
the error has been detected, the handover attempt is interrupted
1182 : BTS ID
0 : the MSC has detected an error in the adjacent cell definitions
1 : the BSC has detected an error in the adjacent cell definitions
0-FF: BCC (Base Station Color Code). The target cell where handover has been attempted. The value is
set by the MSC
FF information is not available
0-FF: NCC (Network Color Code). The target cell where handover has been attempted. The value is set
by the MSC
FFFF identification of the target cell (BCCH)
65535: No information of BCCH
/
50 © Nokia Siemens Networks
SDCCH Drop Analysis With Respect To Transmission
/
51 © Nokia Siemens Networks

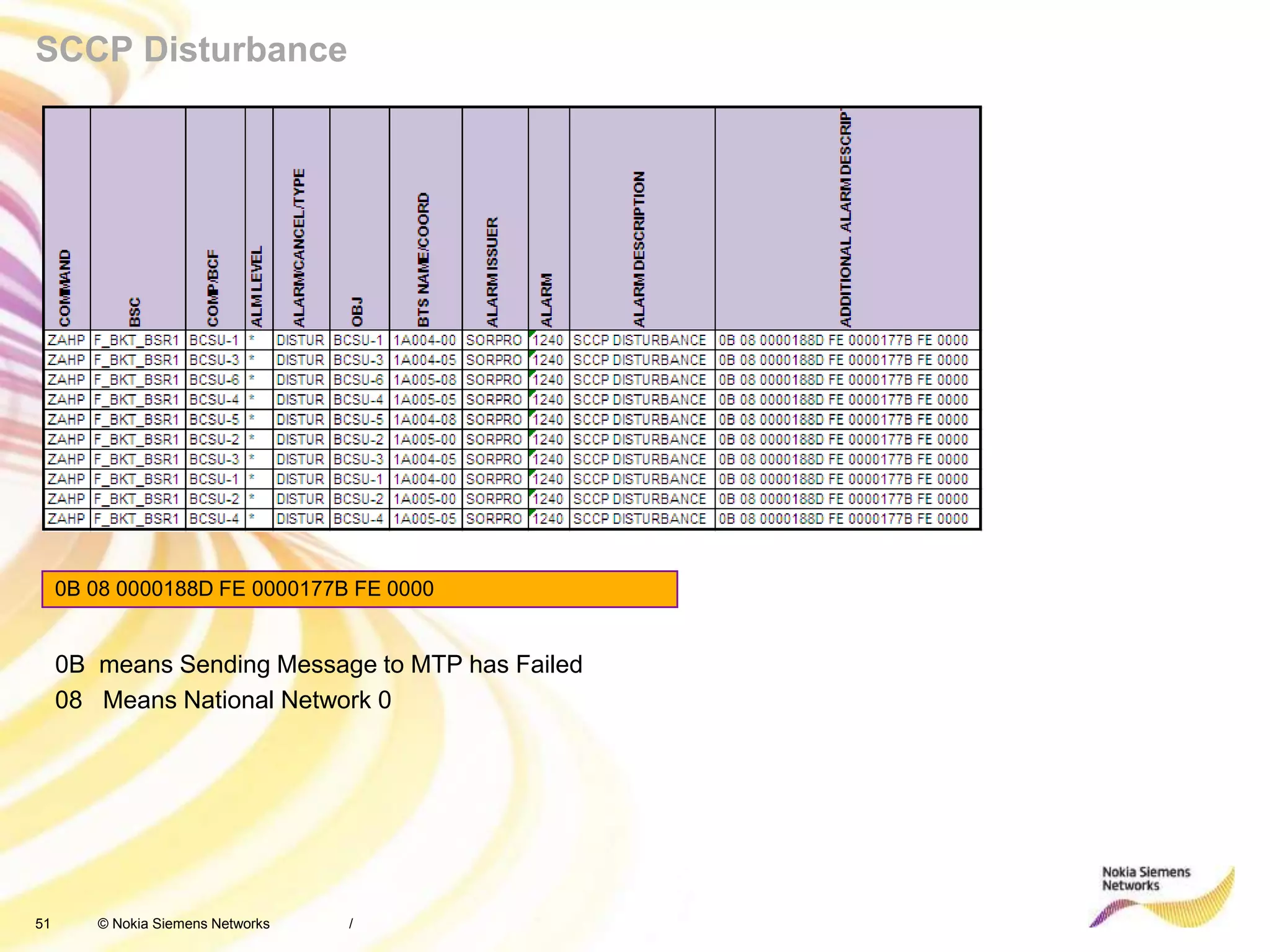

SCCP Disturbance
/
0B 08 0000188D FE 0000177B FE 0000
0B means Sending Message to MTP has Failed
08 Means National Network 0
52 © Nokia Siemens Networks

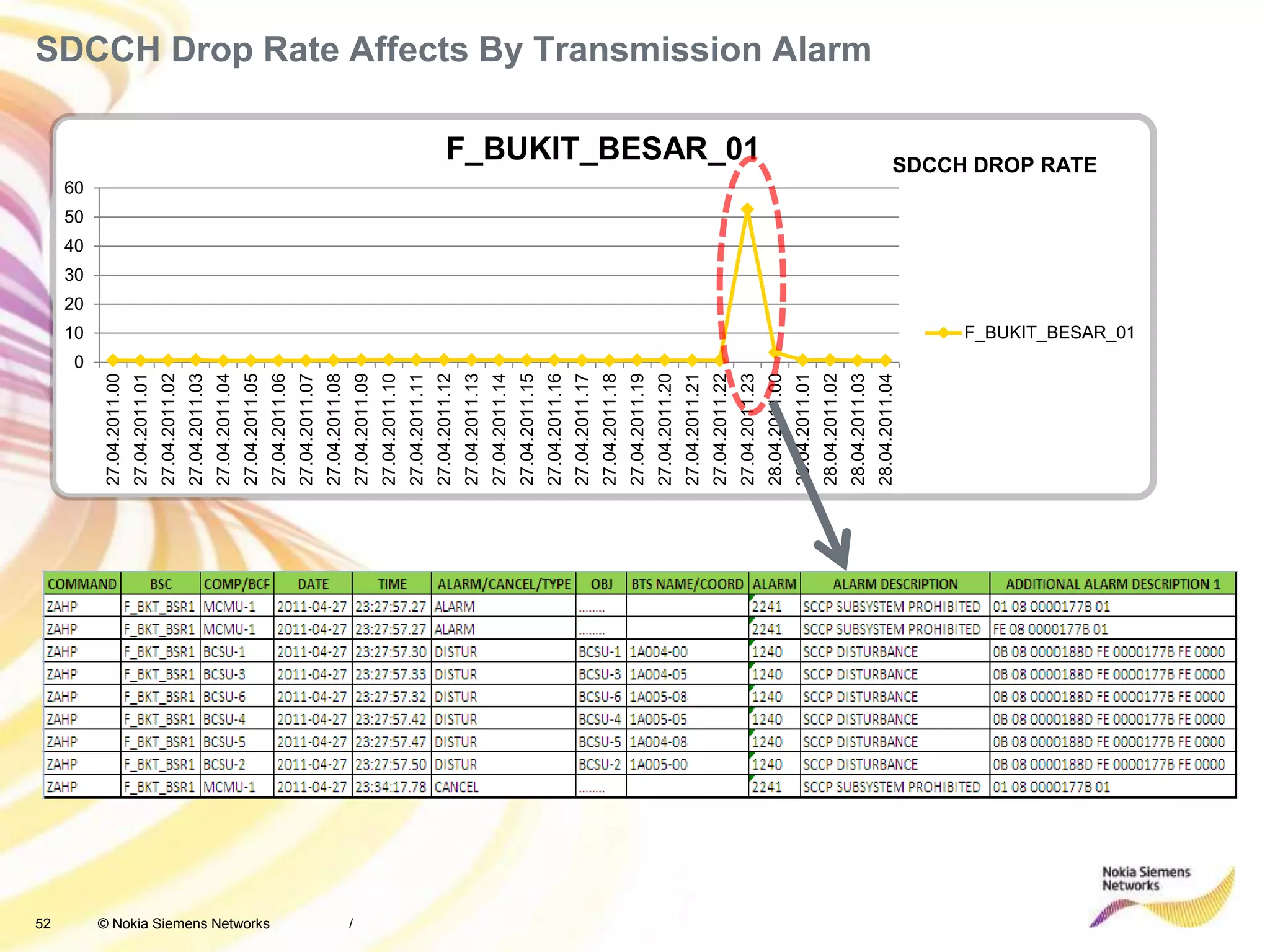

SDCCH Drop Rate Affects By Transmission Alarm
/
0
10
20
30
40
50
60
27.04.2011.00
27.04.2011.01
27.04.2011.02
27.04.2011.03
27.04.2011.04
27.04.2011.05
27.04.2011.06
27.04.2011.07
27.04.2011.08
27.04.2011.09
27.04.2011.10
27.04.2011.11
27.04.2011.12
27.04.2011.13
27.04.2011.14
27.04.2011.15
27.04.2011.16
27.04.2011.17
27.04.2011.18
27.04.2011.19
27.04.2011.20
27.04.2011.21
27.04.2011.22
27.04.2011.23
28.04.2011.00
28.04.2011.01
28.04.2011.02
28.04.2011.03
28.04.2011.04
F_BUKIT_BESAR_01
F_BUKIT_BESAR_01
SDCCH DROP RATE
53 © Nokia Siemens Networks

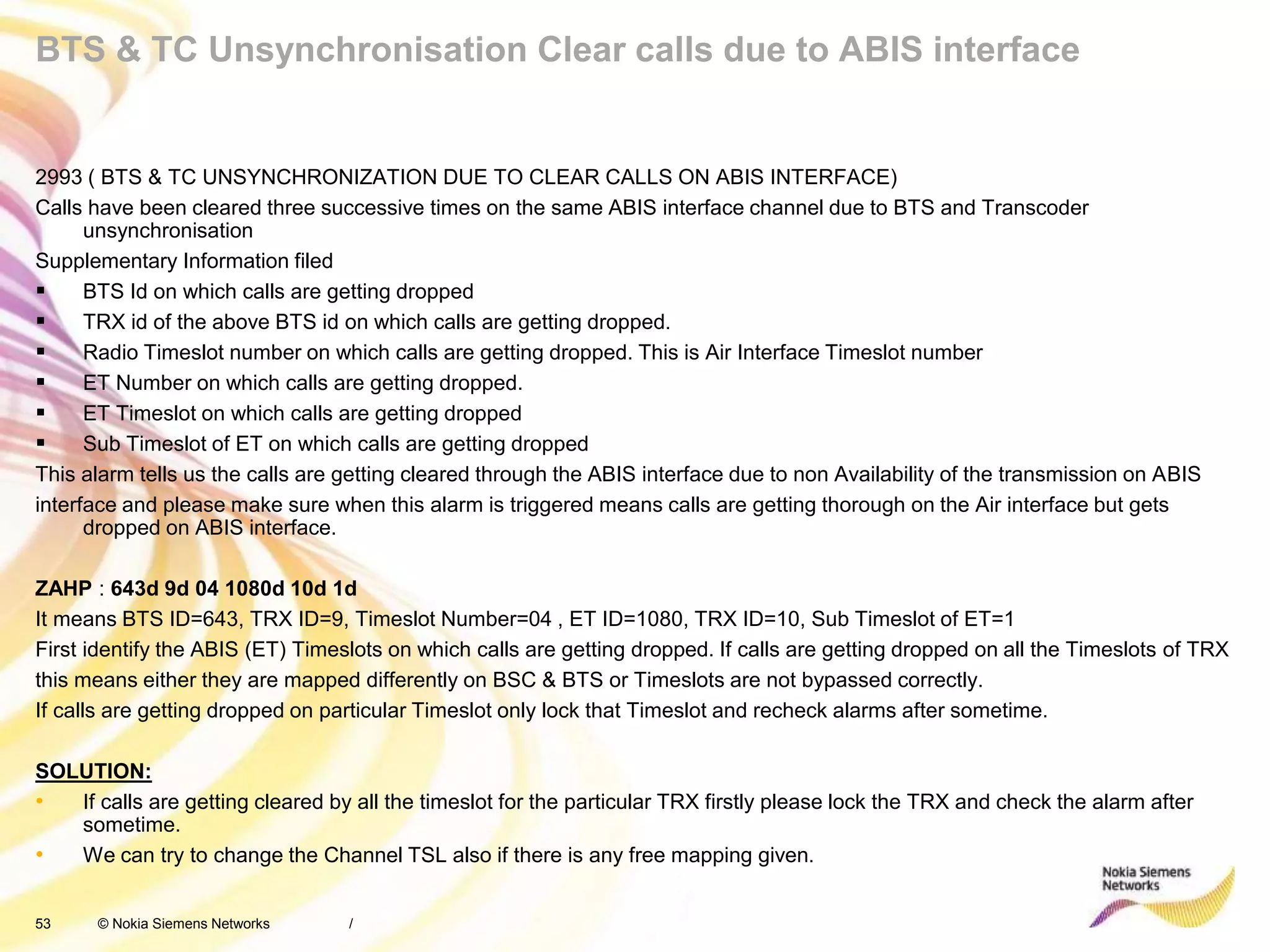

BTS & TC Unsynchronisation Clear calls due to ABIS interface
2993 ( BTS & TC UNSYNCHRONIZATION DUE TO CLEAR CALLS ON ABIS INTERFACE)
Calls have been cleared three successive times on the same ABIS interface channel due to BTS and Transcoder
unsynchronisation
Supplementary Information filed
 BTS Id on which calls are getting dropped
 TRX id of the above BTS id on which calls are getting dropped.
 Radio Timeslot number on which calls are getting dropped. This is Air Interface Timeslot number
 ET Number on which calls are getting dropped.
 ET Timeslot on which calls are getting dropped
 Sub Timeslot of ET on which calls are getting dropped
This alarm tells us the calls are getting cleared through the ABIS interface due to non Availability of the transmission on ABIS
interface and please make sure when this alarm is triggered means calls are getting thorough on the Air interface but gets
dropped on ABIS interface.
ZAHP : 643d 9d 04 1080d 10d 1d
It means BTS ID=643, TRX ID=9, Timeslot Number=04 , ET ID=1080, TRX ID=10, Sub Timeslot of ET=1
First identify the ABIS (ET) Timeslots on which calls are getting dropped. If calls are getting dropped on all the Timeslots of TRX
this means either they are mapped differently on BSC & BTS or Timeslots are not bypassed correctly.
If calls are getting dropped on particular Timeslot only lock that Timeslot and recheck alarms after sometime.
SOLUTION:
• If calls are getting cleared by all the timeslot for the particular TRX firstly please lock the TRX and check the alarm after
sometime.
• We can try to change the Channel TSL also if there is any free mapping given.
/
54 © Nokia Siemens Networks

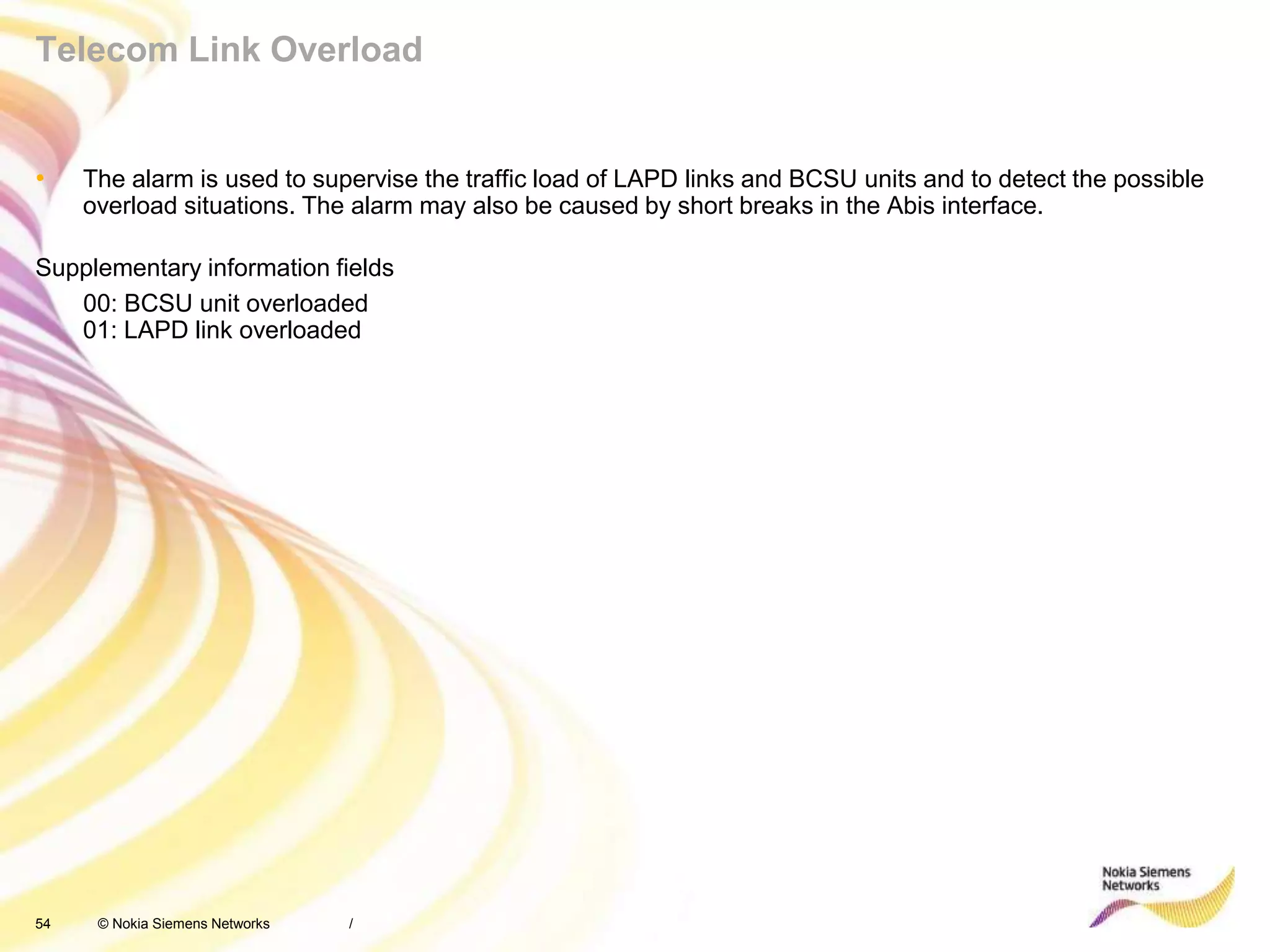

Telecom Link Overload
• The alarm is used to supervise the traffic load of LAPD links and BCSU units and to detect the possible
overload situations. The alarm may also be caused by short breaks in the Abis interface.
Supplementary information fields
00: BCSU unit overloaded
01: LAPD link overloaded
/
55 © Nokia Siemens Networks

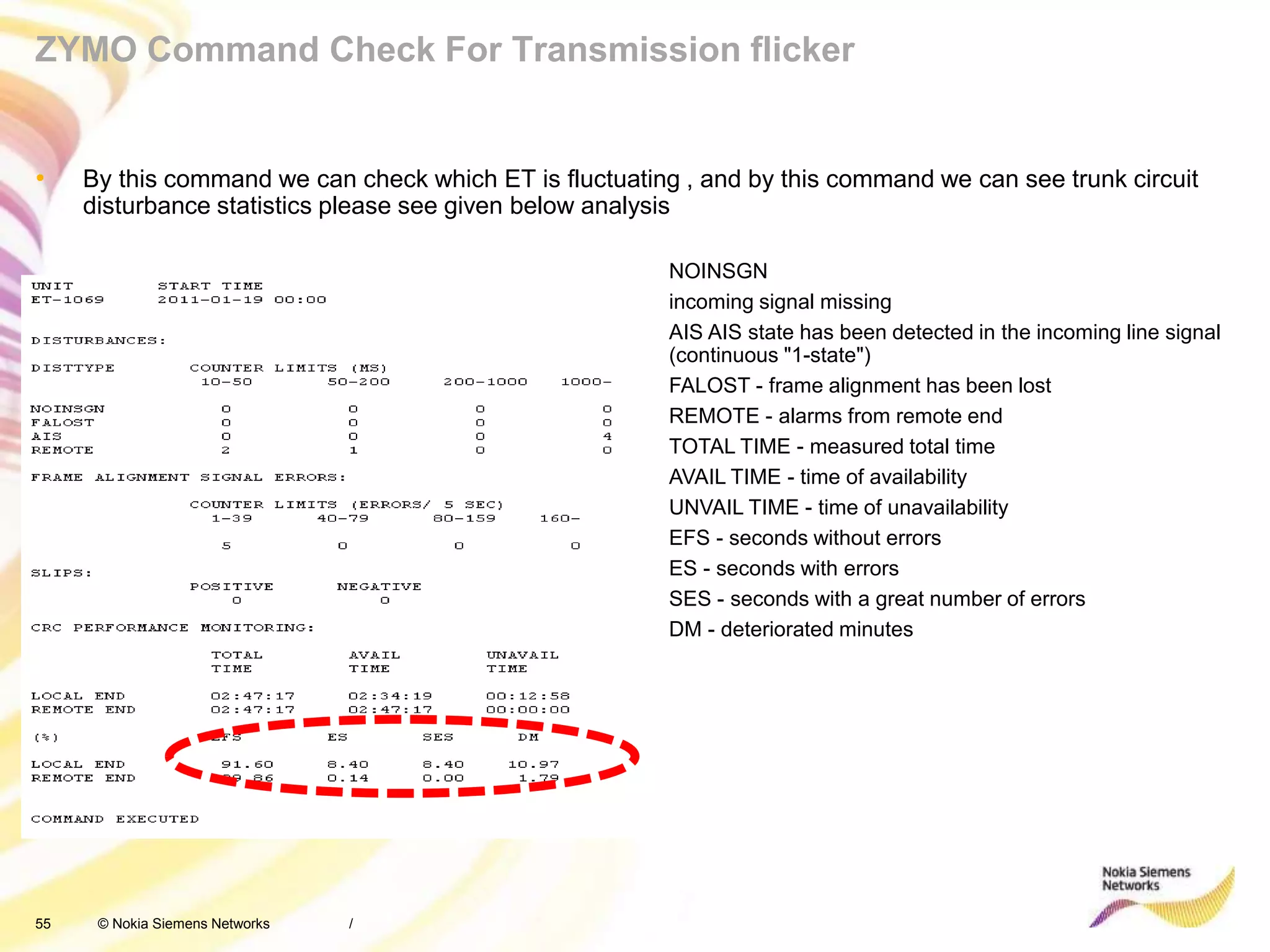

ZYMO Command Check For Transmission flicker
• By this command we can check which ET is fluctuating , and by this command we can see trunk circuit
disturbance statistics please see given below analysis
/
NOINSGN
incoming signal missing
AIS AIS state has been detected in the incoming line signal
(continuous "1-state")
FALOST - frame alignment has been lost
REMOTE - alarms from remote end
TOTAL TIME - measured total time
AVAIL TIME - time of availability
UNVAIL TIME - time of unavailability
EFS - seconds without errors
ES - seconds with errors
SES - seconds with a great number of errors
DM - deteriorated minutes
56 © Nokia Siemens Networks

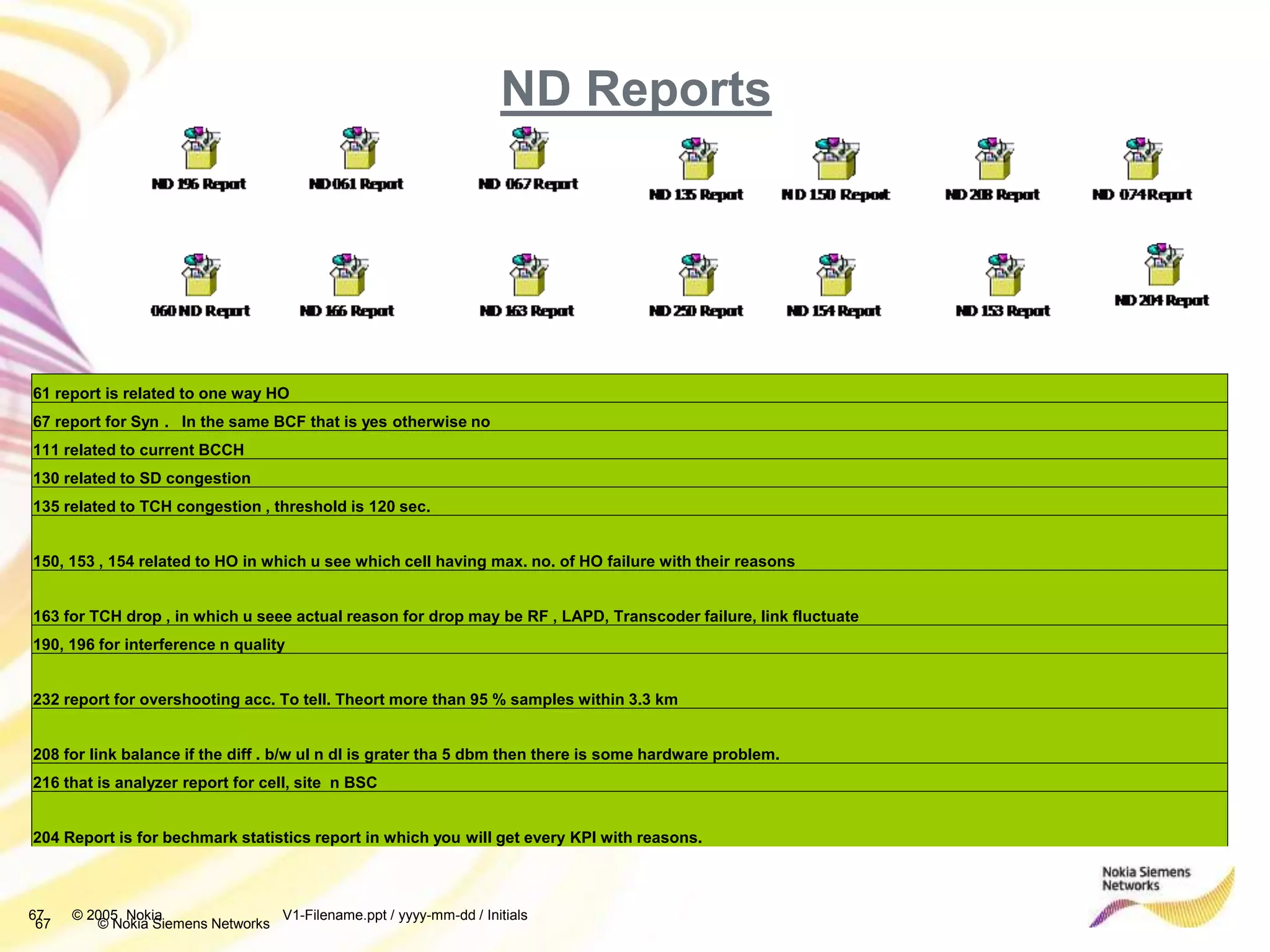

ND Report Analysis
/
57 © Nokia Siemens Networks

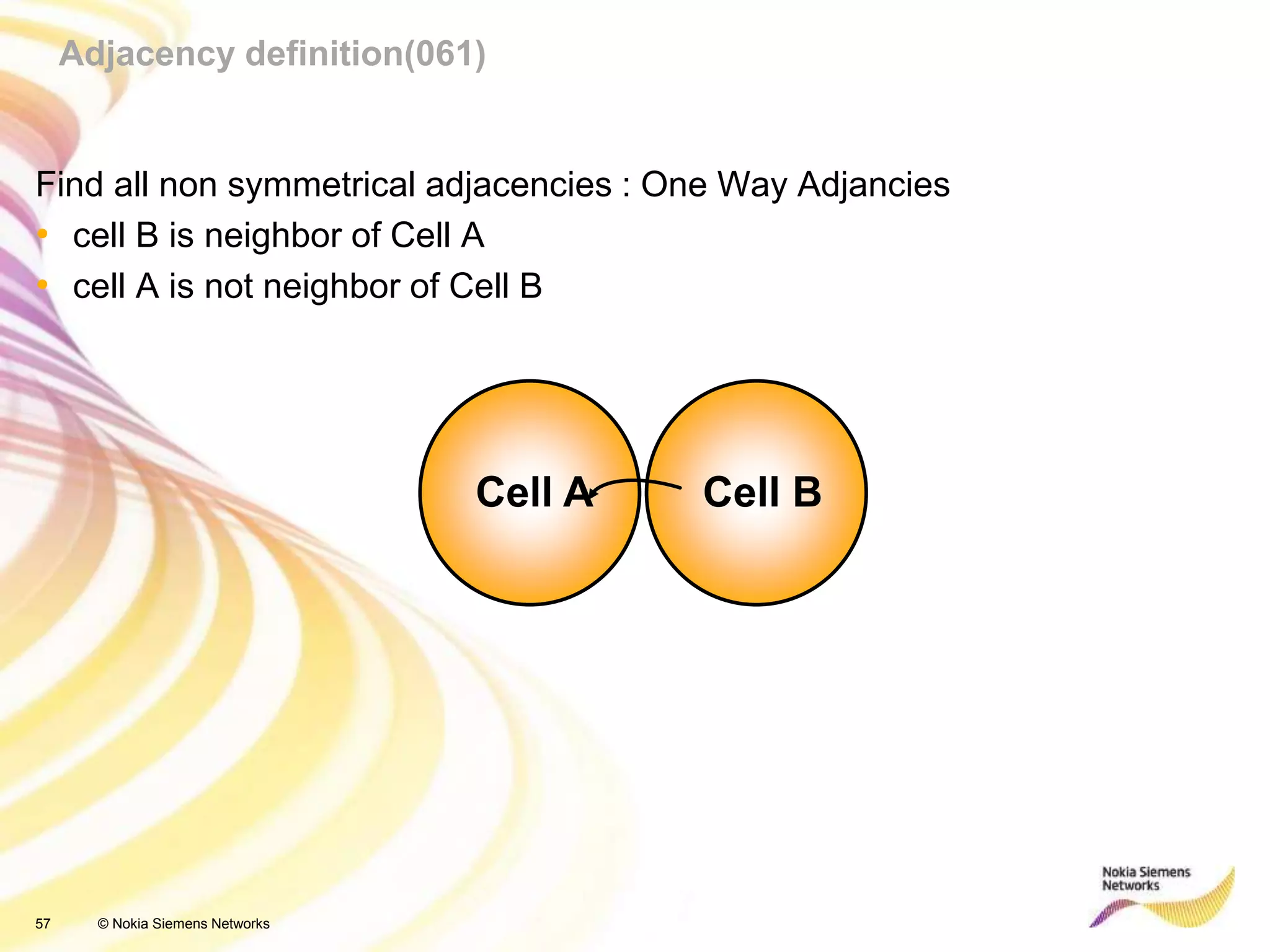

Cell A Cell B
Adjacency definition(061)
Find all non symmetrical adjacencies : One Way Adjancies
• cell B is neighbor of Cell A
• cell A is not neighbor of Cell B
58 © Nokia Siemens Networks
ZEAT Check
/
Co channel discrepancies
Co channel discrepancies , or
LAC discrepancies etc
59 © Nokia Siemens Networks
Adjacency Discrepancies (060) – Example
=================================================================================
= ADJACENCY DISCREPANCIES
= Network: PLMN
= Area: All BTSs selected
= Sorting key: source BSC name, source BTS ID
=================================================================================
This report lists the discrepancies of various parameters between the source cell adjacency parameters and target cell
parameters.
Impact of discrepancies:
Any difference between two identical parameters of the target BTS and the same parameter of adjacency usually results in
handover failures between the source and the target BTSs.
The first of each pair of lines indicates the adjacency of a source cell.
The second line indicates the target cell.
Parameters in the first line show the values in the adjacency (ADJ) of a source cell defined in c_adjacent_cell table.
Parameters in the second line (TGT) show the values of the target cell in c_bts table.
The checked parameters are: Location Area Code (LAC), Cell Identity (CI),Frequency (FREQ), Maximum power of MS (PMAX),
Network Colour Code (NCC) and Base Station Colour Code (BCC). These should be the same in the adjacency and in the
target cell.
In case there is any kind of discrepancy indicated by the report, do the following:
1) Upload adjacency data from the network for the claimed BTSs.
2) Run this check again.
3) If discrepancies are still found, check and correct them via MML.
================================================================================
Adjacency discrepancies in PLMN network
LAC CI FREQ PMAX NCC BCC
=== === === ==== === ===
Source BSC (BTSid) Source BCF/BTS ADJ ADJ ADJ ADJ ADJ ADJ
Target BSC (BTSid) Target BCF/BTS TGT TGT TGT TGT TGT TGT
------------------ ---------------------------- ------ ------ ---- ---- --- ---
BSC1KUTOJA(6) SUOSAA004 / SUOSAA1006 1 10010 600 30 7 2
BSC1KUTOJA(10) LAAJAL010 /LAAJAL1010 1 10010 773 30 7 2
BSC1KUTOJA(7) SUOSAA004 / SUOSAA1007 1 10010 600 30 7 2
BSC1KUTOJA(10) LAAJAL010 /LAAJAL1010 1 10010 773 30 7 2
BSC1KUTOJA(9) LAAJAL009 / LAAJAL1009 1 10010 600 30 7 2
BSC1KUTOJA(10) LAAJAL010 /LAAJAL1010 1 10010 773 30 7 2
BSC1KUTOJA(9) LAAJAL009 / LAAJAL1009 2 20003 594 30 7 7
BSC2UPS1(3) 3UPS001 /3UPSULTRA2003 2 20003 764 30 7 7
BSC1KUTOJA(9) LAAJAL009 / LAAJAL1009 2 20002 600 30 7 7
BSC2UPS1(2) 3UPS001 /3UPSULTRA2002 2 20002 762 30 7 7
BSC2UPS1(1) 3UPS001 /3UPSULTRA2001 2 20001 776 30 7 7
BSC2UPS1(10) 5KOM005 / 5KOM2010 1 10009 605 30 7 2
60 © Nokia Siemens Networks

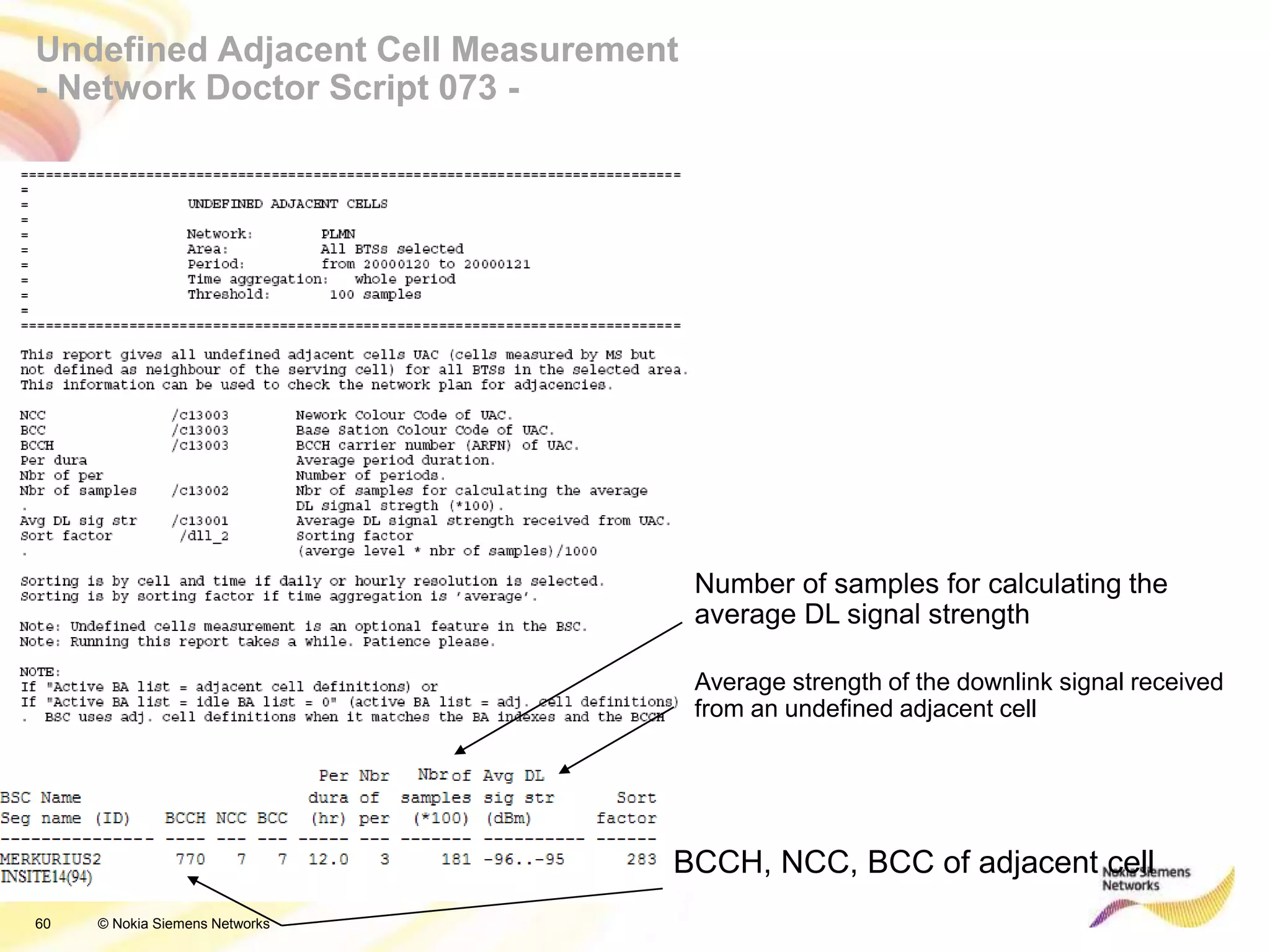

Undefined Adjacent Cell Measurement
- Network Doctor Script 073 -
Average strength of the downlink signal received
from an undefined adjacent cell
Number of samples for calculating the
average DL signal strength
BCCH, NCC, BCC of adjacent cell
61 © Nokia Siemens Networks

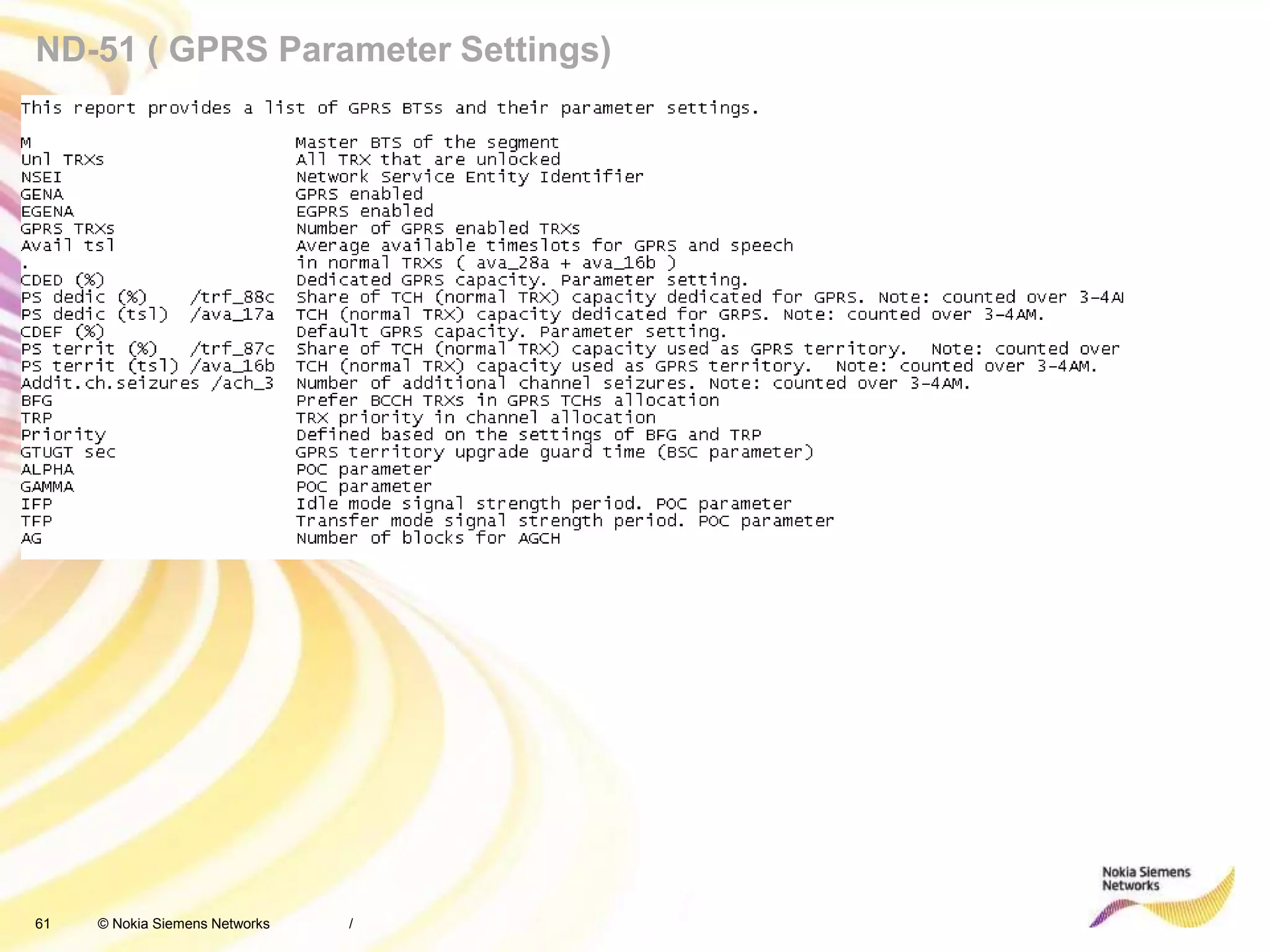

ND-51 ( GPRS Parameter Settings)
/

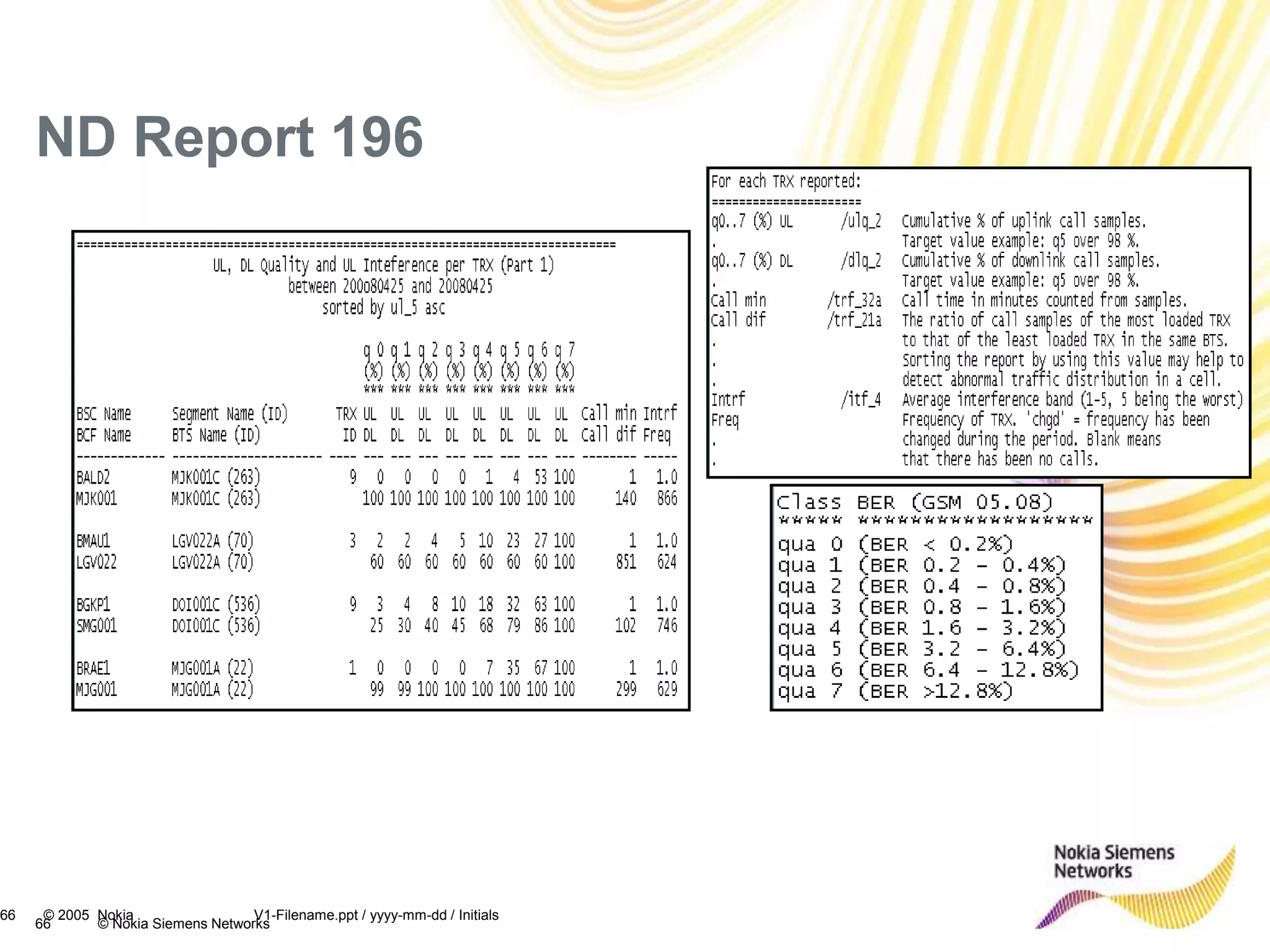

62 © Nokia Siemens Networks

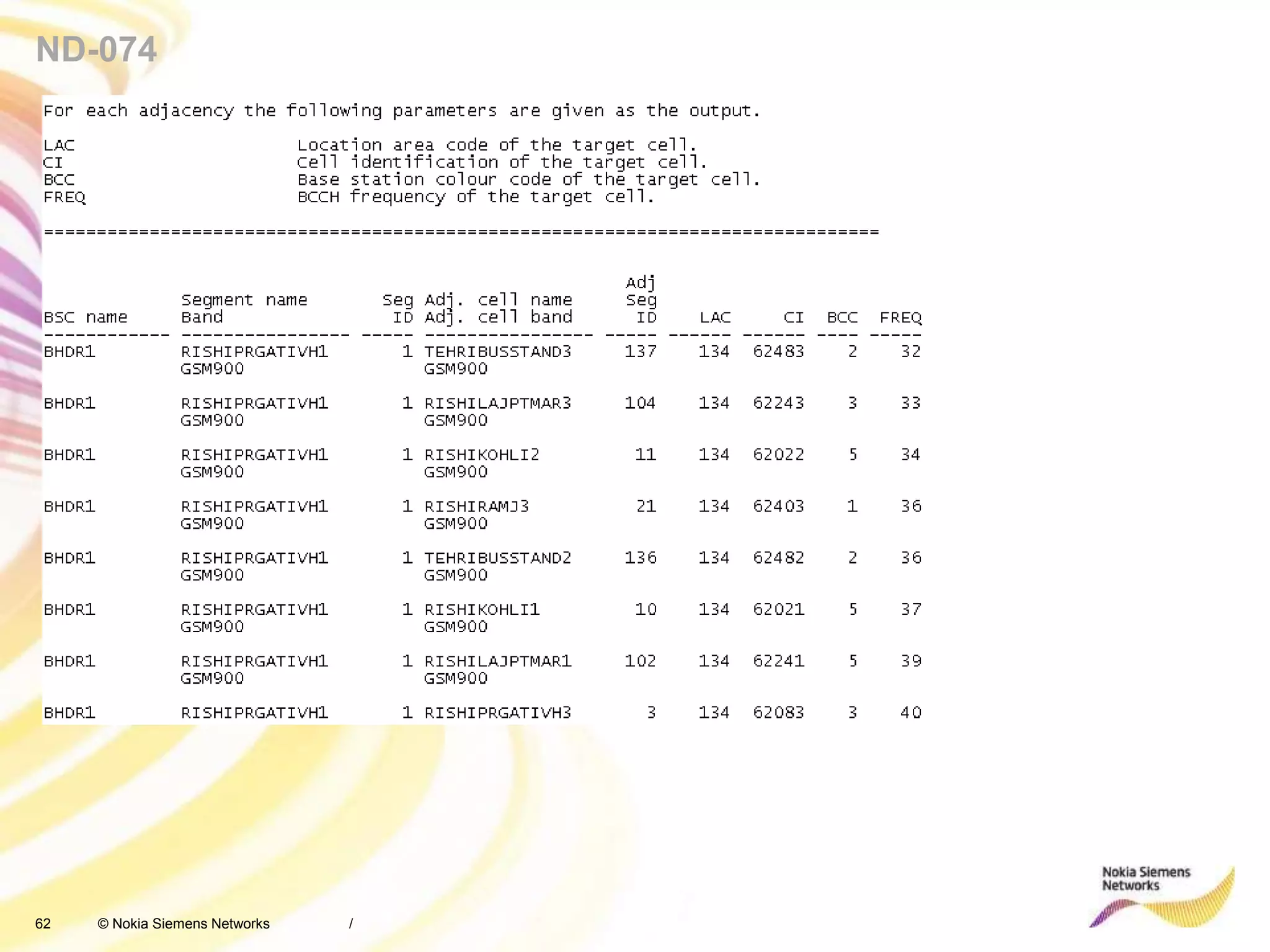

ND-074
/
63 © Nokia Siemens Networks

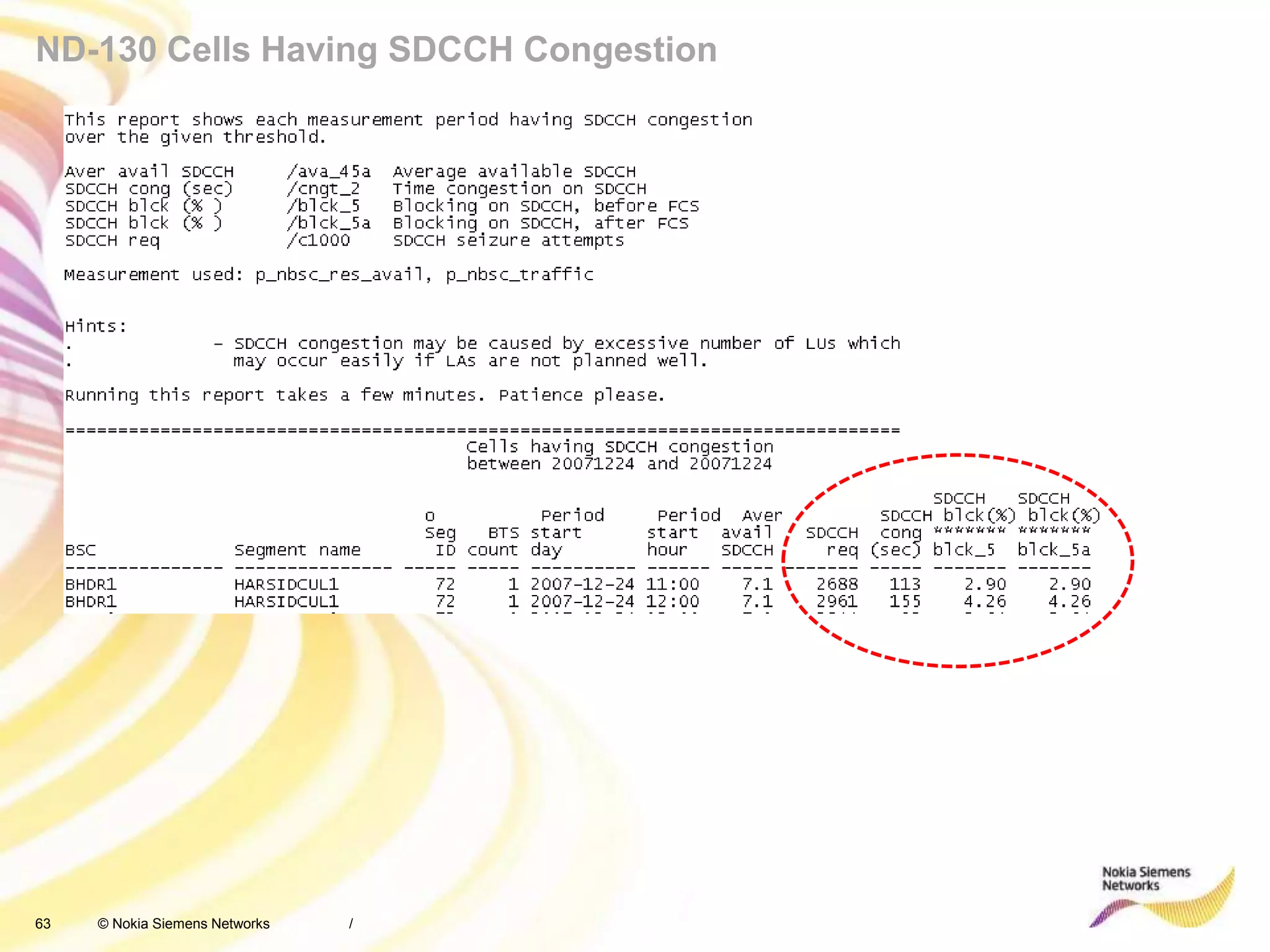

ND-130 Cells Having SDCCH Congestion
/
64 © Nokia Siemens Networks /

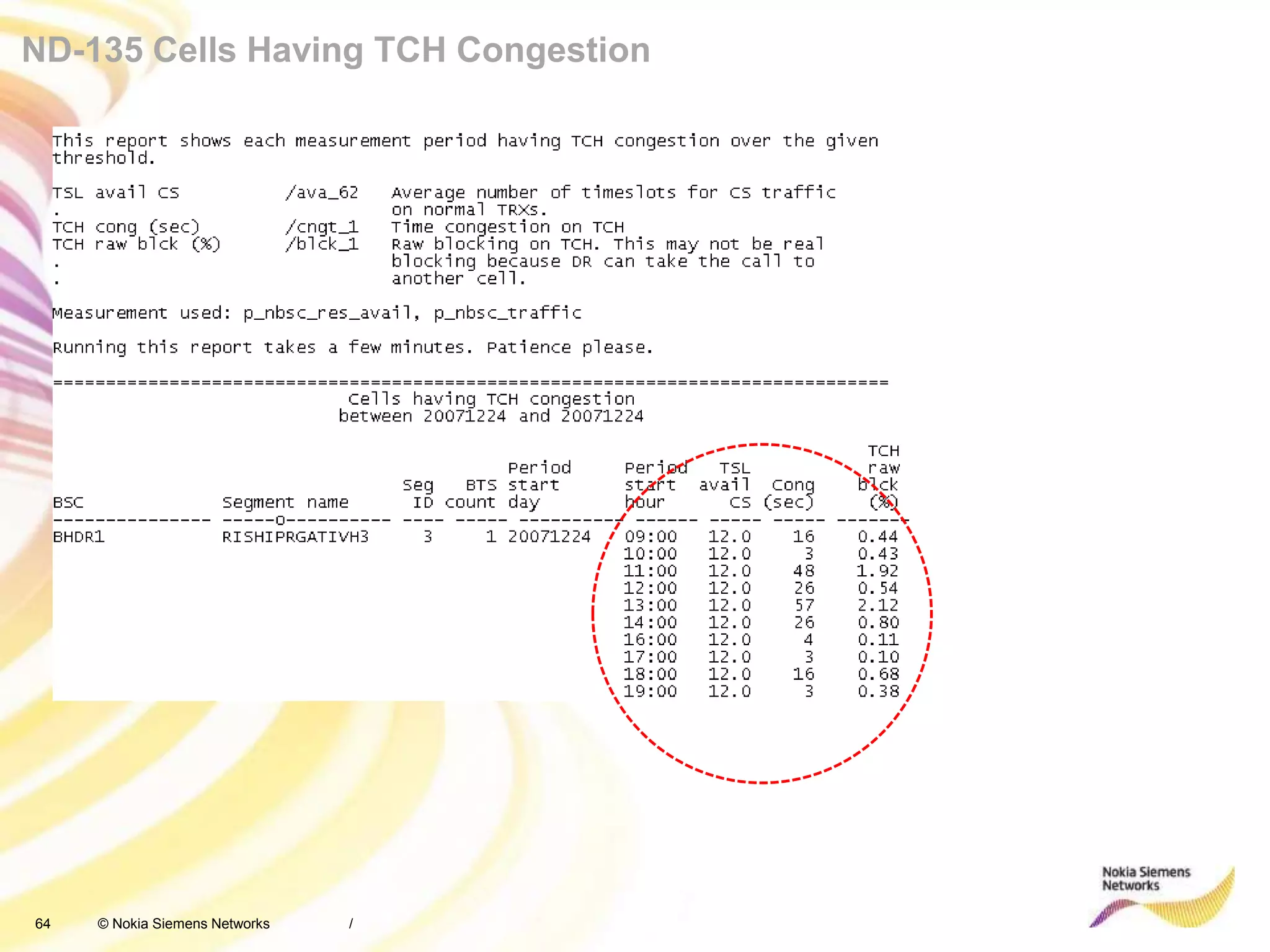

ND-135 Cells Having TCH Congestion
65 © Nokia Siemens Networks
65 © 2005 Nokia V1-Filename.ppt / yyyy-mm-dd / Initials

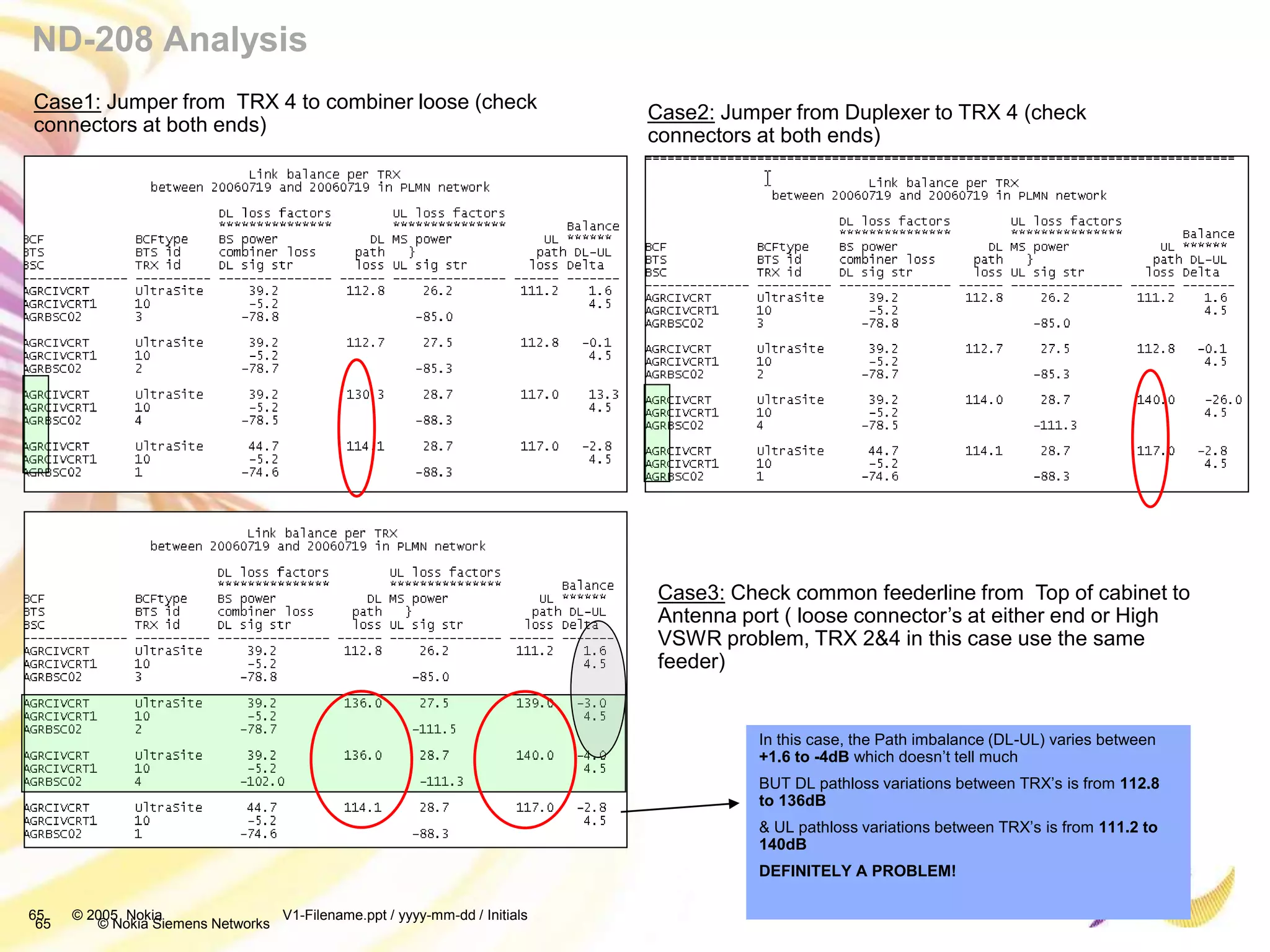

Case1: Jumper from TRX 4 to combiner loose (check
connectors at both ends)
Case2: Jumper from Duplexer to TRX 4 (check
connectors at both ends)
Case3: Check common feederline from Top of cabinet to
Antenna port ( loose connector’s at either end or High
VSWR problem, TRX 2&4 in this case use the same
feeder)
In this case, the Path imbalance (DL-UL) varies between
+1.6 to -4dB which doesn’t tell much
BUT DL pathloss variations between TRX’s is from 112.8
to 136dB
& UL pathloss variations between TRX’s is from 111.2 to
140dB
DEFINITELY A PROBLEM!
ND-208 Analysis
66 © Nokia Siemens Networks
ND Report 196
66 © 2005 Nokia V1-Filename.ppt / yyyy-mm-dd / Initials
67 © Nokia Siemens Networks
ND Reports
67 © 2005 Nokia V1-Filename.ppt / yyyy-mm-dd / Initials
61 report is related to one way HO
67 report for Syn . In the same BCF that is yes otherwise no
111 related to current BCCH
130 related to SD congestion
135 related to TCH congestion , threshold is 120 sec.
150, 153 , 154 related to HO in which u see which cell having max. no. of HO failure with their reasons
163 for TCH drop , in which u seee actual reason for drop may be RF , LAPD, Transcoder failure, link fluctuate
190, 196 for interference n quality
232 report for overshooting acc. To tell. Theort more than 95 % samples within 3.3 km
208 for link balance if the diff . b/w ul n dl is grater tha 5 dbm then there is some hardware problem.
216 that is analyzer report for cell, site n BSC
204 Report is for bechmark statistics report in which you will get every KPI with reasons.
68 © Nokia Siemens Networks
Alarm Description
68 © 2005 Nokia V1-Filename.ppt / yyyy-mm-dd / Initials
69 © Nokia Siemens Networks
THANKS
/

Nokia kpi and_core_optimization

  • 1.
    1 © NokiaSiemens Networks Nokia KPI & Core Optimization
  • 2.
    2 © NokiaSiemens Networks / BASIC KPI Target  KPI basic for new site has been agreed, Introduce new “Lock Value” SD Drop less than 2 % SD Blocking less than 1 % TCH drop less than 2% TCH assignment Success greater than 95 % HOSR is greater that 95 % CSSR greater than 98% TCH Blocking less thank 1%
  • 3.
    3 © NokiaSiemens Networks Topics Covered • How do we need to start Optimization • KPI Analysis with All Raw Counters • Root Cause • Hardware Alarms • Core Optimization ( Alarm Description & Analysis) / For escalating the Transmission and Hardware related issue we should clear why alarm persisting and what unit is faulty and we also first try with TRX Lock & reset etc so that we can force to customer to replace it ASAP and For Transmission we also need to know which KPI is affecting due to which alarm as so many alarm persists on the BSC but only some affects the KPI and This is called Root Cause analysis
  • 4.
    4 © NokiaSiemens Networks Consistency Parameter Check • Check cells in MSC vs cells in BSC • Check external adjacencies in MSC • Cells with co-channel frequencies • Cells with adj-channel frequencies • Non symmetrical adjacencies • Neighbours with co-channel frequencies • Neighbours with adj-channel frequencies • Neighbours of a same cell with co-BSIC, co-BCCH • Check BCCH-BSIC reuse distance • Check BCCH reuse distance • Check site with same MA List in different sectors and different HSN • Check site with same MA List in different sectors and MAIO collision • Synchronized HO /
  • 5.
    5 © NokiaSiemens Networks Parameter Audit • Some major parameters might have big impact to KPI. We briefly review those parameter to make sure at least we are not optimizing at the unreachable value. TCH Drop • RX diversity (RDIV) : enable/disable • Radio Link Timeout (RLT) : higher value  less drop but more bad quality. • Radio Link Timeout AMR (ARLT) : higher value less drop but more bad quality SDCCH Drop and SDCCH Success Rate • RxLev Access Minimum (RXP) : higher value  less drop and less traffic. • C2 parameter  Cell reselection parameter Index (PI) – enable/disable  Cell barring qualify (QUA)  Cell reselect offset (REO) : less value  less drop and less traffic.  Temporary offset (TEO)  Penalty time (PET) /
  • 6.
    6 © NokiaSiemens Networks / •RX lev min cell (SL) With this parameter you define the minimum signal level of an adjacent cell, when a handover is allowed to one of them. •HO margin level (LMRG) Must consider HOC parameters •threshold level downlink Rx level (LDR) •threshold level uplink Rx level (LUR) •HO margin qual (QMRG) Must consider HOC parameters •threshold qual downlink Rx qual (QDR) •threshold qual uplink Rx qual (QUR) Warning! You can reduce the LMRG and QMRG to allow quickly handover but make sure the target cell signal strength and quality is good enough to avoid handover failure and drop call.
  • 7.
    7 © NokiaSiemens Networks / Design default sets Consistency Checks 1. Compare network design against network configuration •Default Parameter Check •Specific Parameter Check 2. Database check •Check inconsistencies between TRX, BTS table with ADCE table: •Check Adjacencies to non-existing cells •Consistency parameter checking 3. Neighbour cells with co-BSIC, co-BCCH ... Review Neighbour Plan Review Frequency Plan
  • 8.
    8 © NokiaSiemens Networks Examples of wrong parameter set with impact on network operation/performance – call setup, qual, bands • No calls happening in a cell 1. Cell Barred 2. Non existent (LAC, Cell ID) in MSC 3. DMAX = 0 • Very few calls happening in a cell 1. RxLevAccesMin 2. Wrong MNC, MCC, LAC declaration • Very low traffic in a cell 1. msTxPwrMax = 0, bsTxPwrMax = 30 • Bad quality in UL after rehoming because of RDIV parameter is not set YES anymore. • Few traffic in 1800 layer of a dual band 900/1800 network :-Idle Mode: C2 parameters not set properly (temporaryOffset, penaltyTime) /
  • 9.
    9 © NokiaSiemens Networks Examples of wrong parameter set with impact on network operation/performance – frequencies 1. Drop call rate increase after new frequency plan implementation • Double BA List activated 2. Impossibility to unlock some BTS after a RF-frequency hopping implementation 3. Impossibility to unlock some BTS after a frequency retune • NON-EDGE TRX, with GTRX = Y • TRX, with GTRX = Y, not attached to any EDAP pool 4. No handover happening after frequency retune between 2 cells from different BSCs • ADCE table has not been updated for other BSC /
  • 10.
    10 © NokiaSiemens Networks Set with impact on network operation/performance– Handover / • Example of Wrong Parameter Settings 1. No handover from a cell towards all its neighbours • PLMN permitted = No 2. High Handover failures after implementation of new adjacency plan SYNC = YES 3. No handover happening from an interfered cell hoMarginQual set to 0 4. 100% of handover failures in an adjacency relation Co-BSIC co-BCCH declaration 5. High number of handovers hoThresholdsLevUL = hoThresholdsLevDL 6. Handover not happening when DL signal level of neighbour much greater than serving cell POC DL activated
  • 11.
    11 © NokiaSiemens Networks Examples of wrong parameter set with impact on network operation/performance – Background Plan 1. Few handovers after implementation of new adjacency plan • Only half of the plan has been downloaded. Half of the adjacencies missing. 2. High drop call rate in some sites after frequency hopping activation • Some sites did not hop as some frequencies were not correctly set! • Important to verify network parameters through MML command! • In case not all parameters were changed correctly, use MML to implement the changes! /
  • 12.
    12 © NokiaSiemens Networks Conclusion Before suspecting anything, check the parameters active in the network!!! • Do consistency checks: verify network parameters are as planned. • Check configuration! • Verify differences between OSS template and BSC default parameters! • In some cases recommended values should be used instead of default values (e.g. msPeriodicLocationUpdate: 0.5 -> 6) • Verify value of sensitive parameters (e.g. DMAX, RxLevAccessMin) • Adjust parameters to balance traffic (e.g. C2 in idle mode) • Inter-related parameters (e.g. New Frequency Plan + BA List) /
  • 13.
    13 © NokiaSiemens Networks / KPI Evaluation Process
  • 14.
    14 © NokiaSiemens Networks HOW DO WE NEED TO START OPTIMIZATION • Firstly we need to check the KPI of Cluster Level & BSC level • After that Check the KPI of which BSC is going down and then find the cells due to which KPI’s going worst • Now check the Cells KPI ( Preferably CSSR, DCR & HOSR ) why it is going worst • If CSSR KPI is worst then we need to check all the components of the CSSR ( TCH Blocking, SDCCH Blocking, SDCCH Drop, TCH Assignment success Rate) & if DCR KPI worst check all the Raw counters also according to the formula and same procedures for the HOSR. / We need no check all the counters also for the respective KPI’s not just like high Blocking or high Drops as it is also plays the very important role in Core-optimization
  • 15.
    15 © NokiaSiemens Networks CSSR KPI • As we know CSSR depends on the 4 Components (TCH Blocking, SDCCH Blocking, SDCCH Drop, TCH Assignment success Rate ) and if any of the components KPI’s going worst than CSSR will be the worst. • I will discuss these cases one by one • For CSSR check we use ND Report 250 i.e for Cell by call Success ratio. • For Hardware we will discuss later /
  • 16.
    16 © NokiaSiemens Networks CASE-1 CSSR BAD Due To High SDCCH Drop Rate / As the above KPI shows that CSSR is going worst due to high SDCCH Drop Rate and No we have to find out the reason for High SDCCH Drop Rate SDCCH Drop rate may be high due to many reasons as given below  Hardware Problem in a Cell  Overshooting  Co-channel Interference  Transmission issue  Phantom RACH  Extra SDCCH
  • 17.
    17 © NokiaSiemens Networks • Formula: • 100 * (traffic.sdcch_radio_fail + traffic.sdcch_rf_old_ho + • traffic.sdcch_user_act + traffic.sdcch_bcsu_reset + • traffic.sdcch_netw_act + traffic.sdcch_bts_fail + sdcch_lapd_fail+sdcch_a_if_fail_call+sdcch_a_if_fail_old) / • (traffic.sdcch_assign + traffic.sdcch_ho_seiz) • Counter from table: p_nbsc_traffic (Traffic Measurements) SDCCH Drop Call Rate (%) No. of SD transaction failures due to the radio failure (1003) No. of SD transaction failures due to the radio failure of the former channel during SD-SD or SD-TCH HO. (1004) No. of SD transaction failures due to user action. (1037) No. of SD transaction failures due to radio N/W reconfiguration actions. (1039) No. of SD transaction failures due to BCSU reset. (1038) No. of SD transaction failures due to BTS failure. (1036) No. of SDCCH assignments. (57021) No. of successful SDCCH seizures for a handover. (1006) Number of SDCCH transactions ended because of a failure in the A interface during a call attempt. Number of SDCCH transactions ended because of a failure in the A interface on the source channel during an SDCCH- SDCCH or SDCCH-TCH HO
  • 18.
    18 © NokiaSiemens Networks SDCCH Drop Rate KPI Analysis / Please make sure SDCCH_ABIS_FAIL_CALL counter we don’t include in the KPI’s formula of SDCCH Drop Rate as this is not the customer satisfactory. Now in the above KPI we can see the SDCCH drop rate is high due to SDCCH A interface fail call is high as major drops are going only on this counter and it is suspected due to Transmission issue so for root cause we need to check the all counters.
  • 19.
    19 © NokiaSiemens Networks SDCCH Drop Rate Analysis Based on Several Reasons • If SDCCH_Radio_fail counter value is high it means drops going may be due to Overshooting, interference , Phantom RACH etc. • If 7745 Channel Failure Rate Alarm persist on SDCCH then Shift the SDCCH from that TRX to another TRX. • If SD Drop is high we can also change some parameters RXP, PMAX, DMAX (For international boundary facing) etc. • SD Drop can also be high due to high UL or DL issue in that cell. For UL we can put TMA and for DL we can provide tilt or re orient that antenna. • For Extra SDCCH we need to check the SD Configuration as per Nokia system 1 SDCCH can take 5000 SDCCH attempts, for this don’t consider the daily KPI, please see the next slide for better explanation of this. /
  • 20.
    20 © NokiaSiemens Networks Extra SDCCH Analysis / 0 500 1000 1500 2000 2500 3000 0 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 0 1 2 3 4 12.05.2011 13.05.2011 SUKA_NEGARA1 SUKA_NEGARA1 SD ATTEMPTS According to KPI there should be only one SDCCH timeslot but if I check the Database configuration it has 4 SDCCH so we need to remove the extra SDCCH from the TRX’s
  • 21.
    21 © NokiaSiemens Networks CASE-2 CSSR BAD DUE TO BAD TASR / TASR Bad due to Several Reasons  Hardware Faulty  Timer T10 Expired ( BSC Level)  Queuing not Allowed  Queue Full  Due to Radio Problem  Due to Hardware Issue
  • 22.
    22 © NokiaSiemens Networks TASR FORMULA • [sum(a.tch_radio_fail+ a.tch_abis_fail_call + a.tch_a_if_fail_call + a.tch_tr_fail + a.tch_user_act + a.tch_bcsu_reset + a.tch_netw_act+ a.tch_act_fail_call + a.tch_lapd_fail+ a.tch_bts_fail)] • - [sum(a.spare057044) - sum(a.tch_rf_old_ho + a.tch_abis_fail_old + a.tch_a_if_fail_old + a.tch_tr_fail_old)] • 100%( * ----------------------------------------------------------------------------------------------------) % • sum(a.tch_norm_seiz) ;(normal calls) • + sum(c.msc_i_sdcch_tch + c.bsc_i_sdcch_tch + c.cell_sdcch_tch) ;(DR calls) • - sum(a.tch_succ_seiz_for_dir_acc) ;ref.2 • + sum(a.tch_seiz_due_sdcch_con) ;(FACCH call setup • • • Counters from table(s): • a = p_nbsc_traffic • c = p_nbsc_ho / Number of successful incoming SDCCH to TCH HOs controlled by the MSC
  • 23.
    23 © NokiaSiemens Networks TASR Analysis Counters / As in the above given counters shows that suddenly some the counters value ( ABIS interface fail, Radio fail etc) increased . Radio fail may be due to some Radio problems as interference, overshooting etc and if ABIS fail call increased it may be increased due to some Transmission alarm.
  • 24.
    24 © NokiaSiemens Networks CASE-3 CSSR Bad Due TO Blocking / CSSR is worst due to high SDCCH & TCH blocking
  • 25.
    25 © NokiaSiemens Networks What is TCH Blocking ? BUSY BUSY BUSY BUSY BUSY BUSY BUSY BUSY / All Timeslots are busy When all timeslots ( 8 TS) are busy then it is called congestion and when at the time of congestion any call come through that busy timeslot then it is called blocking.
  • 26.
    26 © NokiaSiemens Networks • Formula: • 100 * [sum(a.tch_call_req - a.tch_norm_seiz) - sum(b.msc_o_sdcch_tch + b.bsc_o_sdcch_tch + b.cell_sdcch_tch) + sum(a.tch_succ_seiz_for_dir_acc) – sum {a.tch_rej_due_req_ch_a_if_crc -(b.bsc_i_unsucc_a_int_circ_type + b.msc_controlled_in_ho + b.ho_unsucc_a_int_circ_type)} ] • ______________________________________________________ • [sum(a.tch_call_req) – sum {a.tch_rej_due_req_ch_a_if_crc - (b.bsc_i_unsucc_a_int_circ_type + b.msc_controlled_in_ho + b.ho_unsucc_a_int_circ_type) } ] TCH Blocking Formula (%)
  • 27.
    27 © NokiaSiemens Networks • Formula: (Nom) • 100 * [sum(a.tch_call_req - a.tch_norm_seiz) – • sum(b.msc_o_sdcch_tch + b.bsc_o_sdcch_tch + b.cell_sdcch_tch) + sum(a.tch_succ_seiz_for_dir_acc) – • sum {a.tch_rej_due_req_ch_a_if_crc -(b.bsc_i_unsucc_a_int_circ_type + b.msc_controlled_in_ho + b.ho_unsucc_a_int_circ_type)} ] TCH Blocking (%) No. of TCH requests for normal assignment. (1026) No. of successful TCH requests for a normal assignment. (1009) No. successful SD-TCH HO. (4050) No. successful SD- TCH HO. (BSC Controlled) (4065) No. successful SD- TCH HO. (Intra-cell) (4074) Number of successful TCH seizures in direct accesses to a super-reuse TRX during the call set-up phase. (1165) Number of rejected TCH requests due to mismatch between the requested channel type and the A- interface circuit type (1122) Number of unsuccessful handovers due to wrong A- interface circuit type. (4097) Number of unsuccessful handover due to wrong A- interface circuit type. (4098) Number of unsuccessful handovers due to wrong A- interface circuit type. (4101)
  • 28.
    28 © NokiaSiemens Networks • Formula: (Denom) • sum(a.tch_call_req) – sum {a.tch_rej_due_req_ch_a_if_crc - (b.bsc_i_unsucc_a_int_circ_type + b.msc_controlled_in_ho + b.ho_unsucc_a_int_circ_type) } TCH Blocking (%) No. of TCH requests for normal assignment. (1026) Number of rejected TCH requests due to mismatch between the requested channel type and the A- interface circuit type (1122) Number of unsuccessful handovers due to wrong A- interface circuit type. (4097) Number of unsuccessful handovers due to wrong A- interface circuit type. (4101) Number of unsuccessful handover due to wrong A- interface circuit type. (4098)
  • 29.
    29 © NokiaSiemens Networks TCH Blocking Reasons • TCH availability Check alarms (are TRXs & TSLs in Working State? ), check availability report and RxQuality report to verify whether there is a badly functioning TRX. Make Loop Tests on TRX. Fix hardware problem. • TCH capacity Bad TCH capacity dimensioning. Check number of TRXs. /
  • 30.
    30 © NokiaSiemens Networks Optimization TCH Blocking  If hardware problem exist then need to escalate to the concerned person  Increase dual Rate for reduce the TCH Blocking ( TCHF TCHD, TCHH TCHD)  Check FRL & FRU setting ( BTS Level)  Check HRL & HRU setting ( BSC Level)  Check HRI ( TCH in handover) setting ( BSC Level) ( it should be 5 and it means TCH has to be primarily allocated from the best BTS of the handover candidate list)  Directed Retry Enable  Remove Extra SDCCH Channel and convert in to TCHD in case of high TCH Traffic to reduce the blocking  In case of Overshooting check RXP setting  In case of very high traffic in clusters then we can reduce the power  Traffic Sharing • Add Extra TRX • Add New Site • Optimize the cell boundaries to share the traffic with surrounding cells • Traffic Reason Handover enable • BLT (BTS Load Threshold) can also be increased from 70 to 90 value. /
  • 31.
    31 © NokiaSiemens Networks • Formula: • 100 * (traffic.sdcch_busy_att - traffic.tch_seiz_due_sdcch_con)/ traffic.sdcch_seiz_att • Counter from table: p_nbsc_traffic (Traffic Measurements) SDCCH Blocking (%) Unsuccessful SDCCH seizure attempts, due to non- availability of SDCCH (1001) Successful seizures of TCH due to SDCCH congestion (1099) Total no. of SDCCH seizure attempt (1000)
  • 32.
    32 © NokiaSiemens Networks SDCCH BLOCKING REASONS /  Too much SDCCH “normal” traffic for cell SDCCH design - Logical cell design, extra TRX, new site  LA border at crowded area ( Check HYS Setting)  Abnormal SDCCH traffic - “phantom” channel requests - Inadequate LAC design, causing too much LU - Redesign LAC - Problem with neighbor cells belong to other LAC
  • 33.
    33 © NokiaSiemens Networks SDCCH blocking • SDCCH avalability – Check alarms (are TRXs & TSLs in Working State? ), check availability report and RxQuality report to verify whether there is a badly functioning TRX. Fix hardware problem. • SDCCH capacity – Check actual SDCCH configuration ( e.g. Combined BCCH/SDCCH, Number of SDCCH channels). If there is insuficient SDCCH capacity and enough TCH capacity, add SDCCH TSL. Other solution e.g. are to add TRX, activate Dynamic SDCCH, activate FACCH Call Setup. • SDCCH traffic – Verify traffic distribution (LU, SMS and MOC in %); – Cell is covering a region greater than planned. Verify TA statistics. May need to change DMAX, or downtilt. /
  • 34.
    34 © NokiaSiemens Networks • SDCCH traffic due to location updates – Bad location area setting (Check MCC, MNC and LAC parameters) – Bad Location area geographical configuration. Too small LA definition will cause many LA updates. Border of LA in a busy avenue will cause many LUs in both location areas! – Low value for CellReselectHysteresis – Verify if downtilt is needed or an increase in SDCCH capacity (air and Abis interfaces). • SDCCH traffic due to SMS – Increase SDCCH capacity (air and Abis interfaces). /
  • 35.
    35 © NokiaSiemens Networks SDCCH BLOCKING ANALYSIS /
  • 36.
    36 © NokiaSiemens Networks DCR FORMULA • sum(tch_radio_fail+ tch_rf_old_ho+ tch_abis_fail_call+ tch_abis_fail_old+ tch_a_if_fail_call+ tch_a_if_fail_old+ tch_tr_fail+ tch_tr_fail_old+ tch_lapd_fail + tch_bts_fail+ tch_user_act+ tch_bcsu_reset+ tch_netw_act+ tch_act_fail_call) 100 * ------------------------------------------------------------------- % sum(a.tch_norm_seiz) ;(normal calls) + sum(c.msc_i_sdcch_tch + c.bsc_i_sdcch_tch) ;(calls started via DR) + sum(a.tch_seiz_due_sdcch_con) ;calls started as FACCH call setup • Counters from table(s): • a = p_nbsc_traffic • b = p_nbsc_res_access /
  • 37.
    37 © NokiaSiemens Networks DCR ANALYSIS / As by the above counters you can directly say from what reasons drop call rate is high as it may be due to RF reasons or may be due to Transmission Issues so we need to know about all the counters
  • 38.
    38 © NokiaSiemens Networks Optimization of Drop Call Rate • If hardware problem exist then need to escalate to the concerned person. • If tch_Radio_fail counter value is high it means drops because of RF Issue for which there issue like Overshooting, interference , Neighbor relation etc. • To improve TCH drop we can parameters like:- RLT (Radio Link Time Out) , RXP etc. • If tch_rf_old_ho is high then check neighbor relation and do tuning according to conditions. • If tch_lapd_fail and tch_tr_fail is suddenly increased or its increasing then this problem occurs due to Transmission issue i.e for this we have to check ND report 522 and ZAHP Alarm history for Transmission problem. • ND Report 160 and 163 used for analysis of drop call rate. /
  • 39.
    39 © NokiaSiemens Networks TCH Drop / Radio Fails Check alarms and RxQuality report to verify whether there is a badly functioning TRX. Fix hardware problem. Check antenna line. Coverage. Verify TA report and planning tool. Interference. Check Frequency Plan. Solution e.g. add sites, downtilt antennas, increase RxLevAccessMin. Lack of neighbours Bad neighbour declaration Transcoder Failure Due to synchronisation problem. Synchronisation source set in BTS clock. Change to BSC. AIF Failure: Interface failures: problem with ET cards. Solution: block the circuits connected to this card and then change ET card when available.
  • 40.
    40 © NokiaSiemens Networks Handover Success Rate HO failures HO attempts - successful HOs 100* --------------- % = 100 * --------------------------------- % HO attempts HO attempts successful HOs = 100 * (1- -------------------------) % HO attempts sum(msc_o_succ_ho + bsc_o_succ_ho + cell_succ_ho) = 100 * (1- ------------------------------------------------------------------------------------------------------ )% sum(msc_o_tch_tch_at + msc_o_sdcch_tch_at + msc_o_sdcch_at + bsc_o_tch_tch_at + bsc_o_sdcch_tch_at + bsc_o_sdcch_at + cell_tch_tch_at + cell_sdcch_tch_at + cell_sdcch_at) Counters from table(s): p_nbsc_ho Known problems: 1) Blocking is included. Blocking makes this indicator show high values especially in the case of IUO, but it does not necessarily mean that there are some technical problems. 2) Calls that are cleared by MS user during the HO process increment the attempt-counters but can not be compensated in numerator. 3) HO that is interrupted due to other procedure (e.g. assignment) increments attempt-counters but can not be compensated in numerator.
  • 41.
    41 © NokiaSiemens Networks 41 © 2005 Nokia V1-Filename.ppt / yyyy-mm-dd / Initials Worse Hand over Cell Is Blocking High? Hardware issue suspected No RF Issues suspected Check 154 HO Report to find out UL and DL quality, UL interference band Check Alarm Check 153 HO report to find out majority failures towards which cells? Yes Possible reasons: Target cell has co-channel/Adj channel interference, coverage gaps, neighbor BCCH/BSIC frequency not updated, wrong CGI format in MSC, wrong HO number in MSC, Non-symmetric HO relations, synchronization problem, excessive UL interference, site too high, Direct Retry traffic cause high HO Failures. . Check TRX Configuration No Check LAC in the case of Inter BSC and MSC HO
  • 42.
    42 © NokiaSiemens Networks HARDWARE ALARMS There are several hardware alarms in NOKIA system which are badly affecting the KPI  BCCH Missing ( Site Down, Please refer Outage Report ND-023)  BTS Faulty ( BTS Down)  BTS Operation Degraded  BCF Operation Degraded  TRF Faulty ( Faulty TRX shows as BL-TRX Automatically)  TRX Operation Degraded  BTS With NO Transaction  Channel Failure Rate Above Defined Threshold  Mean Holding Time Below Defined Threshold  Traffic Channel Activation Failure  Transcoder Channel Failure  BTS O&M Link Failure (OMU Block)  CH Congestion In Cell Above Defined Threshold  LAPD Failure  PCM Failure Some alarm I have explained in the next slides, please see the given below slides /
  • 43.
    43 © NokiaSiemens Networks Channel Failure Rate Above Defined Threshold / Please see the given below core analysis for the 7745 Alarm 02 01 01 00 00 00 00 00 00 01 04 100d 02 represents Alarm on SDCCH Channel 8 Time Slots 01 means Faulty Timeslot time slot with the highest failure rate Shift the SDCCH channel from that TRX or remove SDCCH if there is extra SDCCH timeslots The same scenario start for TCH but at the starts there is 01 in place of 02 and for that is any timeslot is faulty then we can go for Locking Timeslot & Locking TRX and after Lock we can check the Performance in Hourly KPI
  • 44.
    44 © NokiaSiemens Networks BTS O&M Link Failure / • Regarding this Alarm we just need to remember one thing if this alarm persists the OMU of the site blocked and at the same case don’t reset the BCF, if we do this reset BCF than after lock the BCF it will not be unlocked until OMU is not UP and if OMU up then also site will be down because BCF is Locked so better when this alarm comes don’t Reset the BCF. • This above point is the main point regarding this Alarm, please remember it always.
  • 45.
    45 © NokiaSiemens Networks BTS With NO Transaction • The BTS has had no successfully terminated calls or SDCCH transactions during the supervision period. The alarm is used for supervising the BTS traffic capacity. Reason for the alarm 1 = no successful SDCCH seizures 2 = no successful TCH seizures 3 = no successful SDCCH nor TCH seizures /
  • 46.
    46 © NokiaSiemens Networks PCM Failure • Alarm 7704 is BCF-specific. It is used by the RNW recovery part of the BSS system. This alarm (and cancel) will cause radio network recovery actions concerning objects connected through the faulty PCM (ET). Alarm 7704 does not occur alone. There are always some other alarms ( 7767, 2900, 2915, 7706, 7704) active at the same time. • 7767 : BCCH Missing • 2900: Incoming Signal Missing • 2915: Fault Rate Monitoring ( the trunk network circuit supervision clears the calls that come through the ET(S) in question and directs new calls through trunk circuits which are in order ) • 7706: BTS O&M LINK FAILURE /
  • 47.
    47 © NokiaSiemens Networks / TRX NOTIFICATION ALARM STATUS SOUTH SUMATRA (Synchronization changed to Holdover mode) From this alarm only Common ABIS Cells are affected and major alarm description is SYNCHRONIZATION CHANGED due to HOLDOVER MODE and this alarm persists after software upgrade • This alarm persists when BTS is not able to synchronize with the BSC / Core Network and due to this alarm persist synchronization changed due to holdover mode. • May be this alarm persists sue to some error in Software upgrade for COMMON ABIS sites. • We can check the BTS configuration setting as after software upgraded may be some setting change. • Check the heater working properly or not if equipped. Action Proposed to remove this alarm and you can try these given below steps also.  check the sync with MGW and BSC, MGW and MSS.  Just make the SYNC disconnect by the command ZDRD  After disconnect SYNC remove the punching cable or optical path cord as per your connection  After this run ZDRI and then state will be pleisochronous mode  After 10-15 min just punch the cable or connect the fiber and connect the 2M1 or 2M2 by ZDRC and then make the state to hierarchal SYNC  After above all steps just restart the system
  • 48.
    48 © NokiaSiemens Networks Transmission Alarm There are lot of major alarms persists in the BSC but some of them are not affecting the KPI’s but some really affecting the KPI’s, please see the given below alarm status  BTS & TC Unsynchronisation Clear calls due to A interface ( Affecting Drop Call Rate)  BTS & TC Unsynchronisation Clear calls due to ABIS interface ( Affecting Drop Call Rate)  Abnormal A interface Circuit Release ( Affecting Drop Call Rate)  SCCP Disturbance ( Affecting SDCCH Drop Rate)  AIS Received ( Site Fluctuates)  Fault Rate Monitoring ( Site fluctuates)  Telecom Link Overload  Signaling Link Load Over threshold  Adjacent Cell IDENTIFIER configuration error /
  • 49.
    49 © NokiaSiemens Networks Adjacent Cell IDENTIFIER configuration error • adjacent cell information has been defined incorrectly in the BSDATA (BSS Radio Network configuration Database). Either the MSC or the source BSC can detect the error during an external handover. When the error has been detected, the handover attempt is interrupted 1182 : BTS ID 0 : the MSC has detected an error in the adjacent cell definitions 1 : the BSC has detected an error in the adjacent cell definitions 0-FF: BCC (Base Station Color Code). The target cell where handover has been attempted. The value is set by the MSC FF information is not available 0-FF: NCC (Network Color Code). The target cell where handover has been attempted. The value is set by the MSC FFFF identification of the target cell (BCCH) 65535: No information of BCCH /
  • 50.
    50 © NokiaSiemens Networks SDCCH Drop Analysis With Respect To Transmission /
  • 51.
    51 © NokiaSiemens Networks SCCP Disturbance / 0B 08 0000188D FE 0000177B FE 0000 0B means Sending Message to MTP has Failed 08 Means National Network 0
  • 52.
    52 © NokiaSiemens Networks SDCCH Drop Rate Affects By Transmission Alarm / 0 10 20 30 40 50 60 27.04.2011.00 27.04.2011.01 27.04.2011.02 27.04.2011.03 27.04.2011.04 27.04.2011.05 27.04.2011.06 27.04.2011.07 27.04.2011.08 27.04.2011.09 27.04.2011.10 27.04.2011.11 27.04.2011.12 27.04.2011.13 27.04.2011.14 27.04.2011.15 27.04.2011.16 27.04.2011.17 27.04.2011.18 27.04.2011.19 27.04.2011.20 27.04.2011.21 27.04.2011.22 27.04.2011.23 28.04.2011.00 28.04.2011.01 28.04.2011.02 28.04.2011.03 28.04.2011.04 F_BUKIT_BESAR_01 F_BUKIT_BESAR_01 SDCCH DROP RATE
  • 53.
    53 © NokiaSiemens Networks BTS & TC Unsynchronisation Clear calls due to ABIS interface 2993 ( BTS & TC UNSYNCHRONIZATION DUE TO CLEAR CALLS ON ABIS INTERFACE) Calls have been cleared three successive times on the same ABIS interface channel due to BTS and Transcoder unsynchronisation Supplementary Information filed  BTS Id on which calls are getting dropped  TRX id of the above BTS id on which calls are getting dropped.  Radio Timeslot number on which calls are getting dropped. This is Air Interface Timeslot number  ET Number on which calls are getting dropped.  ET Timeslot on which calls are getting dropped  Sub Timeslot of ET on which calls are getting dropped This alarm tells us the calls are getting cleared through the ABIS interface due to non Availability of the transmission on ABIS interface and please make sure when this alarm is triggered means calls are getting thorough on the Air interface but gets dropped on ABIS interface. ZAHP : 643d 9d 04 1080d 10d 1d It means BTS ID=643, TRX ID=9, Timeslot Number=04 , ET ID=1080, TRX ID=10, Sub Timeslot of ET=1 First identify the ABIS (ET) Timeslots on which calls are getting dropped. If calls are getting dropped on all the Timeslots of TRX this means either they are mapped differently on BSC & BTS or Timeslots are not bypassed correctly. If calls are getting dropped on particular Timeslot only lock that Timeslot and recheck alarms after sometime. SOLUTION: • If calls are getting cleared by all the timeslot for the particular TRX firstly please lock the TRX and check the alarm after sometime. • We can try to change the Channel TSL also if there is any free mapping given. /
  • 54.
    54 © NokiaSiemens Networks Telecom Link Overload • The alarm is used to supervise the traffic load of LAPD links and BCSU units and to detect the possible overload situations. The alarm may also be caused by short breaks in the Abis interface. Supplementary information fields 00: BCSU unit overloaded 01: LAPD link overloaded /
  • 55.
    55 © NokiaSiemens Networks ZYMO Command Check For Transmission flicker • By this command we can check which ET is fluctuating , and by this command we can see trunk circuit disturbance statistics please see given below analysis / NOINSGN incoming signal missing AIS AIS state has been detected in the incoming line signal (continuous "1-state") FALOST - frame alignment has been lost REMOTE - alarms from remote end TOTAL TIME - measured total time AVAIL TIME - time of availability UNVAIL TIME - time of unavailability EFS - seconds without errors ES - seconds with errors SES - seconds with a great number of errors DM - deteriorated minutes
  • 56.
    56 © NokiaSiemens Networks ND Report Analysis /
  • 57.
    57 © NokiaSiemens Networks Cell A Cell B Adjacency definition(061) Find all non symmetrical adjacencies : One Way Adjancies • cell B is neighbor of Cell A • cell A is not neighbor of Cell B
  • 58.
    58 © NokiaSiemens Networks ZEAT Check / Co channel discrepancies Co channel discrepancies , or LAC discrepancies etc
  • 59.
    59 © NokiaSiemens Networks Adjacency Discrepancies (060) – Example ================================================================================= = ADJACENCY DISCREPANCIES = Network: PLMN = Area: All BTSs selected = Sorting key: source BSC name, source BTS ID ================================================================================= This report lists the discrepancies of various parameters between the source cell adjacency parameters and target cell parameters. Impact of discrepancies: Any difference between two identical parameters of the target BTS and the same parameter of adjacency usually results in handover failures between the source and the target BTSs. The first of each pair of lines indicates the adjacency of a source cell. The second line indicates the target cell. Parameters in the first line show the values in the adjacency (ADJ) of a source cell defined in c_adjacent_cell table. Parameters in the second line (TGT) show the values of the target cell in c_bts table. The checked parameters are: Location Area Code (LAC), Cell Identity (CI),Frequency (FREQ), Maximum power of MS (PMAX), Network Colour Code (NCC) and Base Station Colour Code (BCC). These should be the same in the adjacency and in the target cell. In case there is any kind of discrepancy indicated by the report, do the following: 1) Upload adjacency data from the network for the claimed BTSs. 2) Run this check again. 3) If discrepancies are still found, check and correct them via MML. ================================================================================ Adjacency discrepancies in PLMN network LAC CI FREQ PMAX NCC BCC === === === ==== === === Source BSC (BTSid) Source BCF/BTS ADJ ADJ ADJ ADJ ADJ ADJ Target BSC (BTSid) Target BCF/BTS TGT TGT TGT TGT TGT TGT ------------------ ---------------------------- ------ ------ ---- ---- --- --- BSC1KUTOJA(6) SUOSAA004 / SUOSAA1006 1 10010 600 30 7 2 BSC1KUTOJA(10) LAAJAL010 /LAAJAL1010 1 10010 773 30 7 2 BSC1KUTOJA(7) SUOSAA004 / SUOSAA1007 1 10010 600 30 7 2 BSC1KUTOJA(10) LAAJAL010 /LAAJAL1010 1 10010 773 30 7 2 BSC1KUTOJA(9) LAAJAL009 / LAAJAL1009 1 10010 600 30 7 2 BSC1KUTOJA(10) LAAJAL010 /LAAJAL1010 1 10010 773 30 7 2 BSC1KUTOJA(9) LAAJAL009 / LAAJAL1009 2 20003 594 30 7 7 BSC2UPS1(3) 3UPS001 /3UPSULTRA2003 2 20003 764 30 7 7 BSC1KUTOJA(9) LAAJAL009 / LAAJAL1009 2 20002 600 30 7 7 BSC2UPS1(2) 3UPS001 /3UPSULTRA2002 2 20002 762 30 7 7 BSC2UPS1(1) 3UPS001 /3UPSULTRA2001 2 20001 776 30 7 7 BSC2UPS1(10) 5KOM005 / 5KOM2010 1 10009 605 30 7 2
  • 60.
    60 © NokiaSiemens Networks Undefined Adjacent Cell Measurement - Network Doctor Script 073 - Average strength of the downlink signal received from an undefined adjacent cell Number of samples for calculating the average DL signal strength BCCH, NCC, BCC of adjacent cell
  • 61.
    61 © NokiaSiemens Networks ND-51 ( GPRS Parameter Settings) /
  • 62.
    62 © NokiaSiemens Networks ND-074 /
  • 63.
    63 © NokiaSiemens Networks ND-130 Cells Having SDCCH Congestion /
  • 64.
    64 © NokiaSiemens Networks / ND-135 Cells Having TCH Congestion
  • 65.
    65 © NokiaSiemens Networks 65 © 2005 Nokia V1-Filename.ppt / yyyy-mm-dd / Initials Case1: Jumper from TRX 4 to combiner loose (check connectors at both ends) Case2: Jumper from Duplexer to TRX 4 (check connectors at both ends) Case3: Check common feederline from Top of cabinet to Antenna port ( loose connector’s at either end or High VSWR problem, TRX 2&4 in this case use the same feeder) In this case, the Path imbalance (DL-UL) varies between +1.6 to -4dB which doesn’t tell much BUT DL pathloss variations between TRX’s is from 112.8 to 136dB & UL pathloss variations between TRX’s is from 111.2 to 140dB DEFINITELY A PROBLEM! ND-208 Analysis
  • 66.
    66 © NokiaSiemens Networks ND Report 196 66 © 2005 Nokia V1-Filename.ppt / yyyy-mm-dd / Initials
  • 67.
    67 © NokiaSiemens Networks ND Reports 67 © 2005 Nokia V1-Filename.ppt / yyyy-mm-dd / Initials 61 report is related to one way HO 67 report for Syn . In the same BCF that is yes otherwise no 111 related to current BCCH 130 related to SD congestion 135 related to TCH congestion , threshold is 120 sec. 150, 153 , 154 related to HO in which u see which cell having max. no. of HO failure with their reasons 163 for TCH drop , in which u seee actual reason for drop may be RF , LAPD, Transcoder failure, link fluctuate 190, 196 for interference n quality 232 report for overshooting acc. To tell. Theort more than 95 % samples within 3.3 km 208 for link balance if the diff . b/w ul n dl is grater tha 5 dbm then there is some hardware problem. 216 that is analyzer report for cell, site n BSC 204 Report is for bechmark statistics report in which you will get every KPI with reasons.
  • 68.
    68 © NokiaSiemens Networks Alarm Description 68 © 2005 Nokia V1-Filename.ppt / yyyy-mm-dd / Initials
  • 69.
    69 © NokiaSiemens Networks THANKS /
