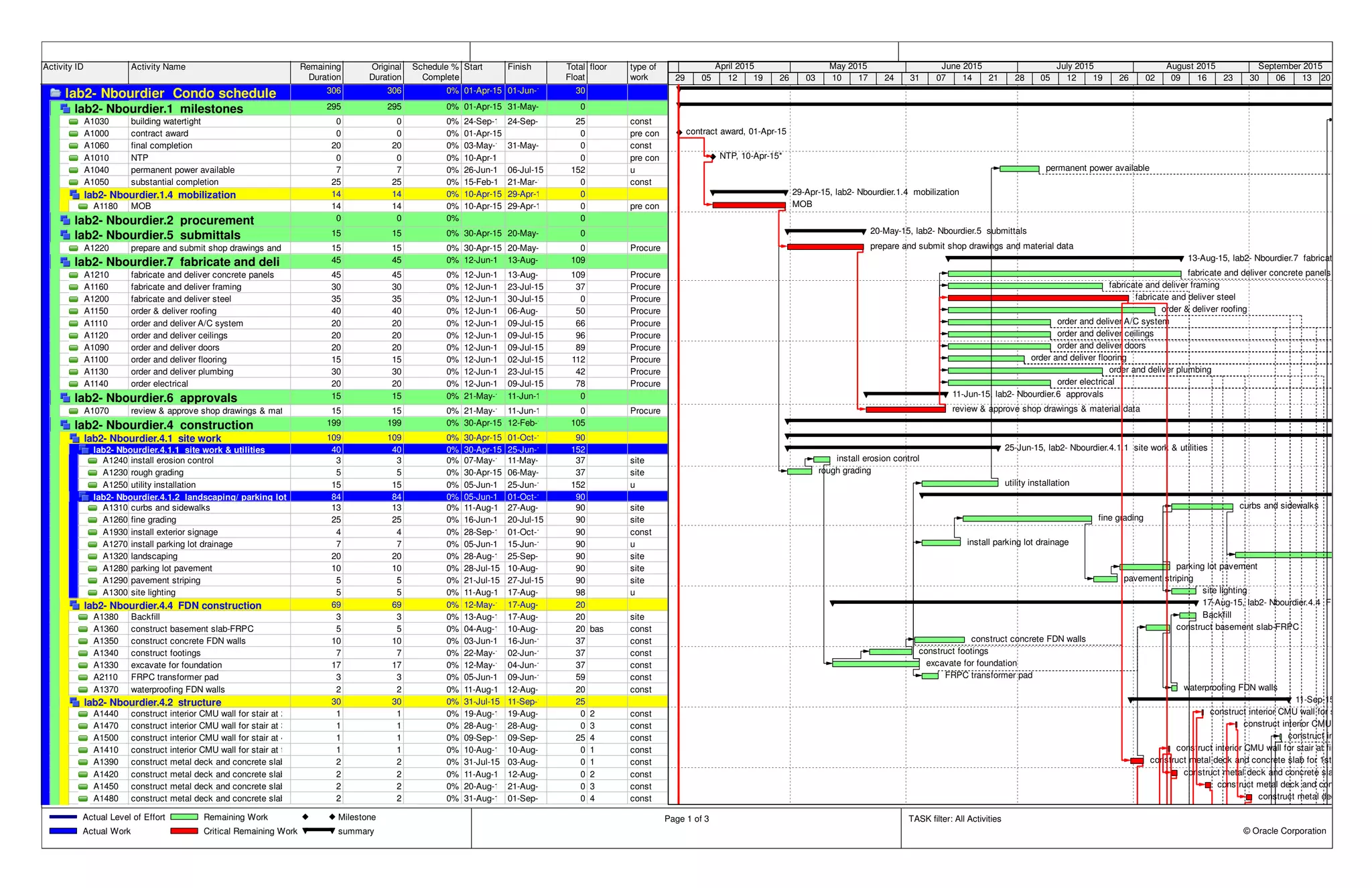

This document contains a schedule for the lab2- Nbourdier Condo project. It lists activities with details like duration, start and finish dates, and type of work. Key activities include mobilization starting April 10th, site work from April 30th to October 1st including utilities installation and landscaping, foundation construction from May 12th to August 17th, and interior construction from August 13th to February 12th including mechanical, electrical and plumbing work, ceilings, flooring and other finishes. The schedule shows the critical path for completing the project by the final completion milestone of May 31st, 2016.
