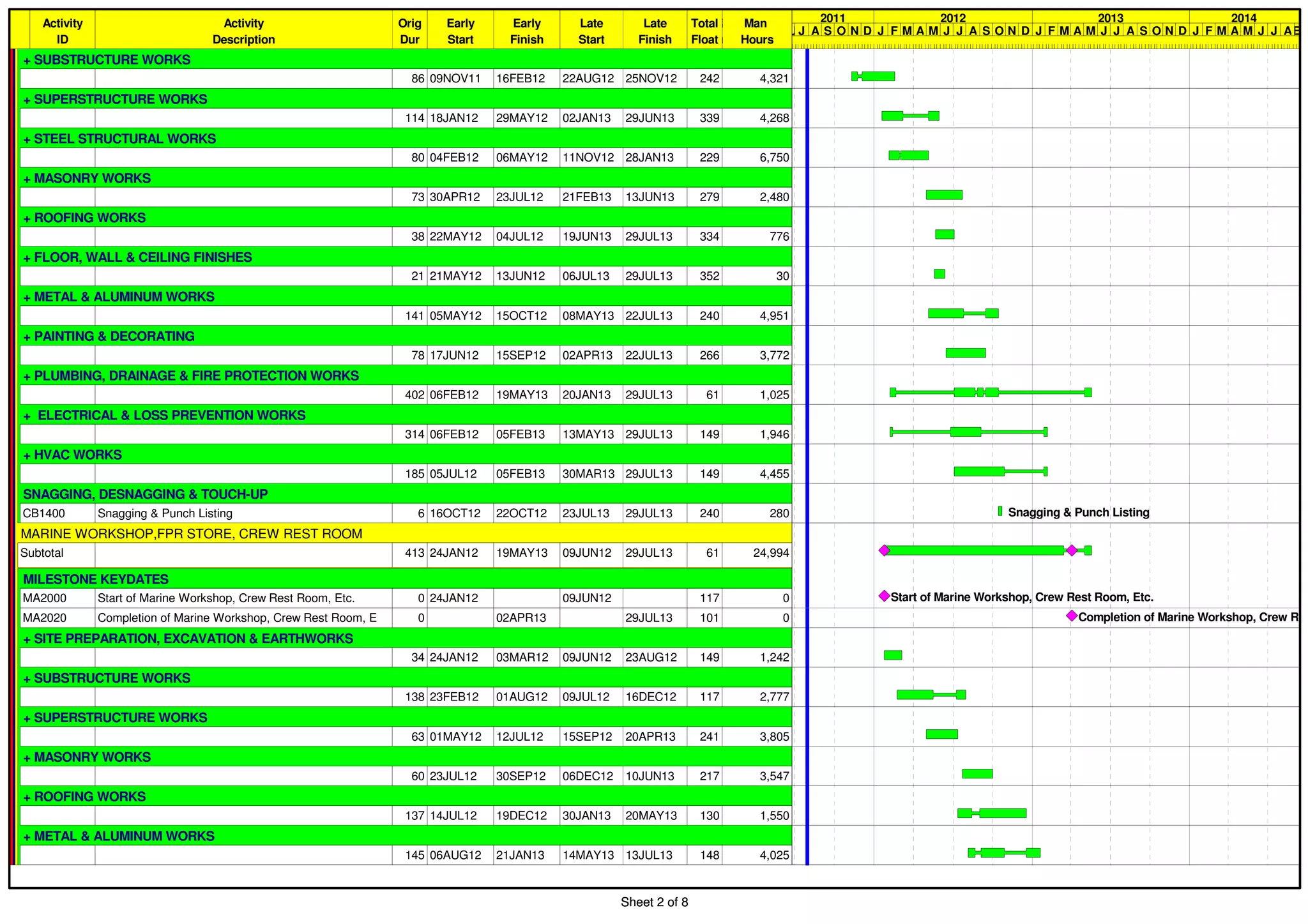

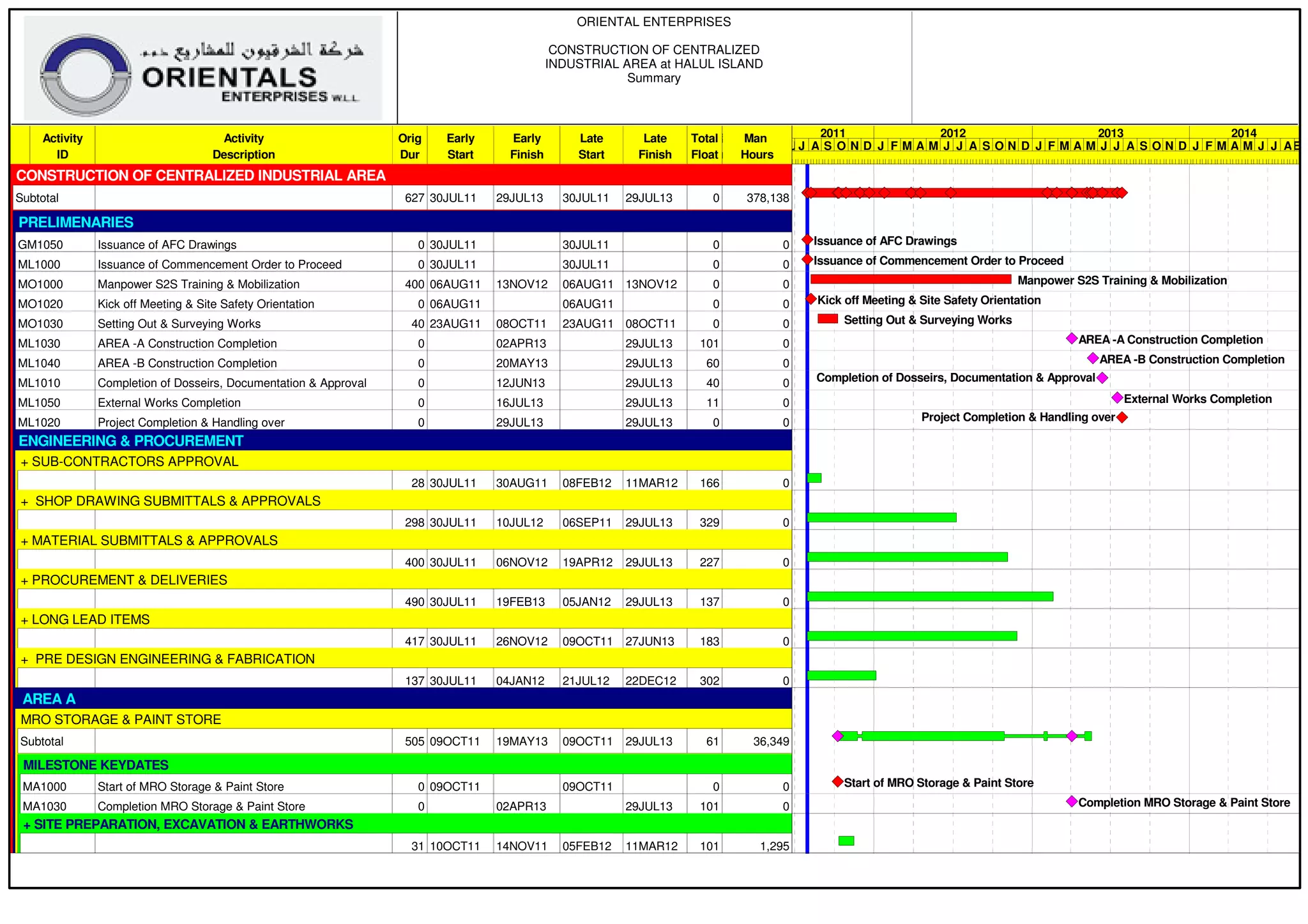

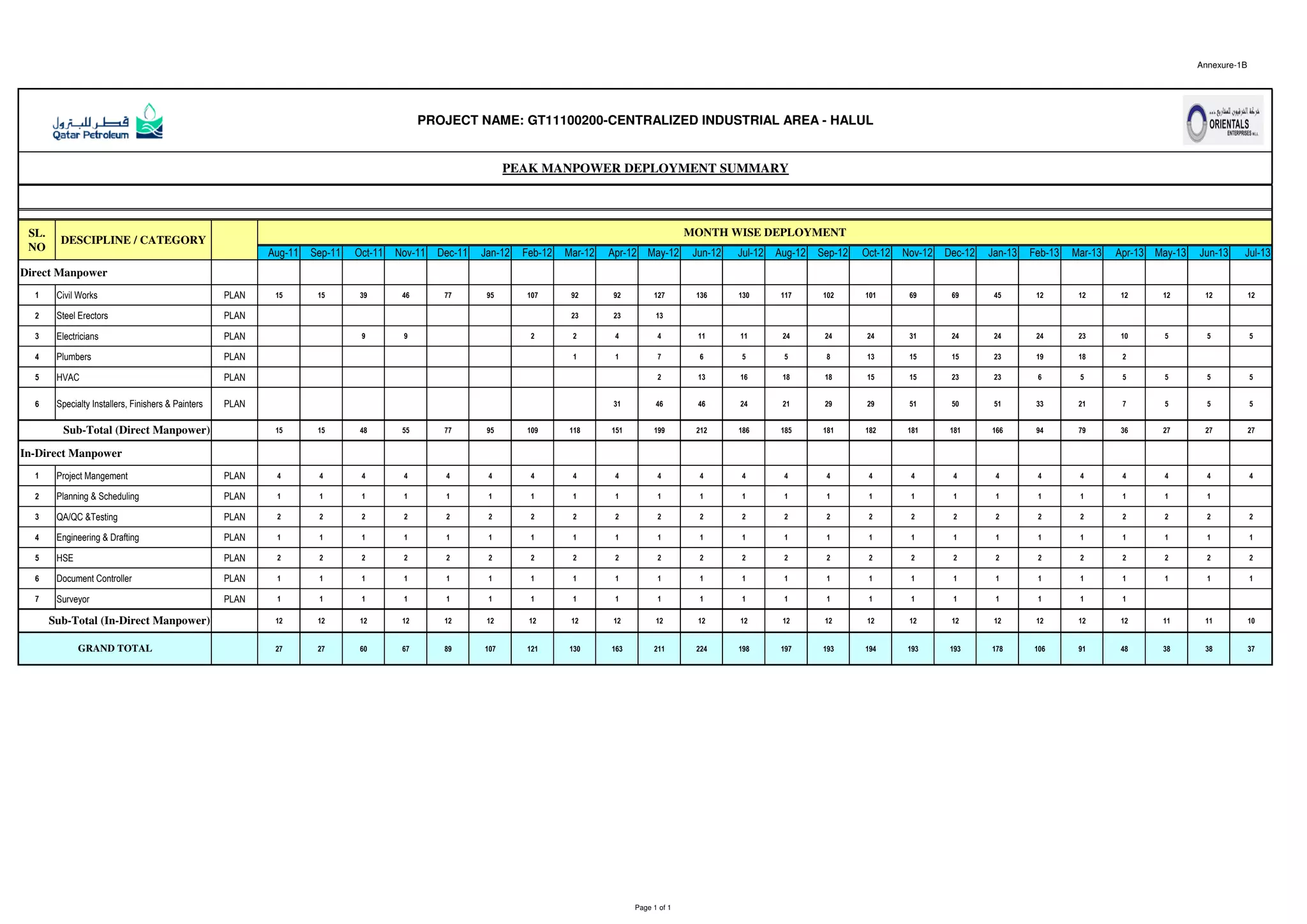

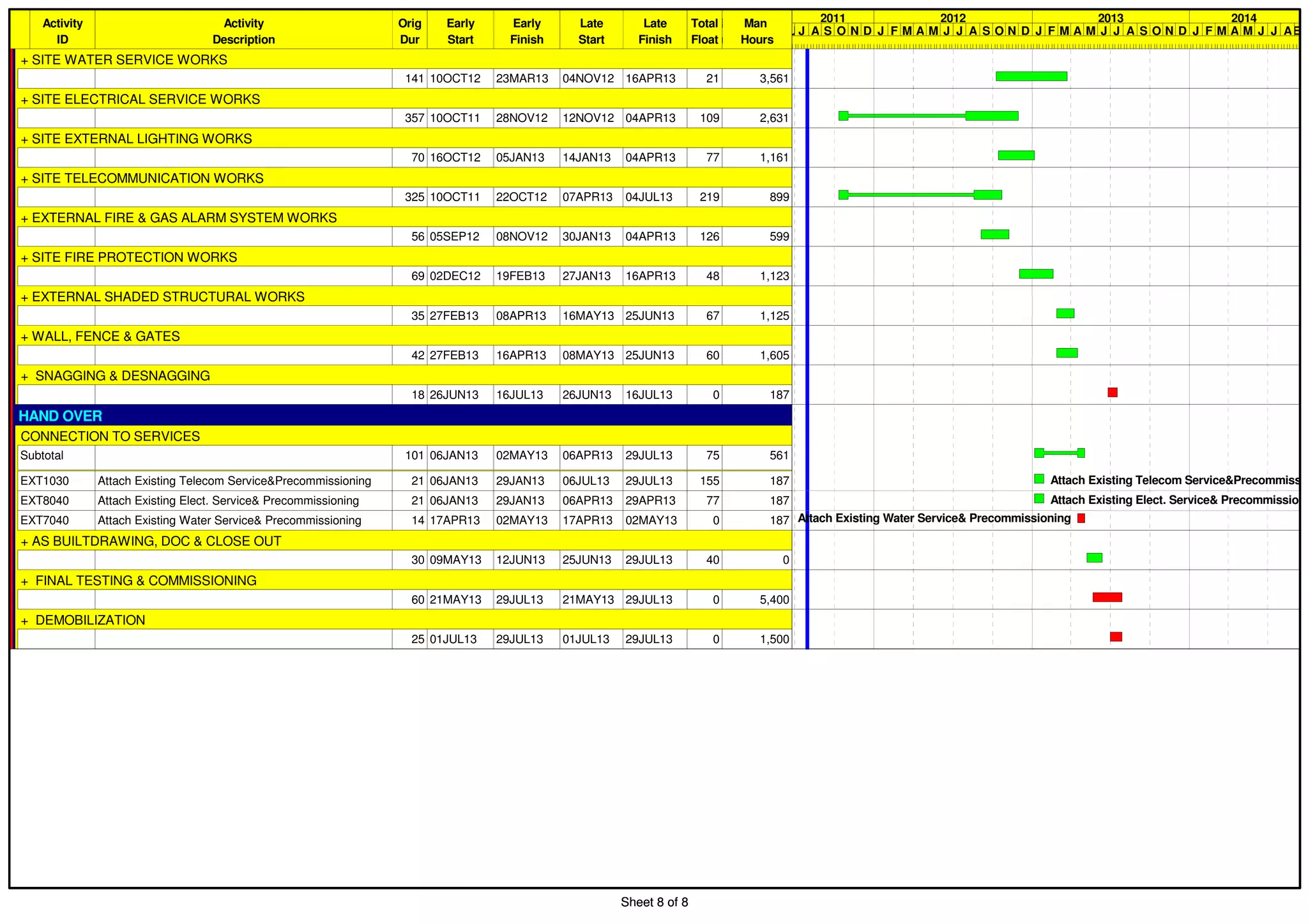

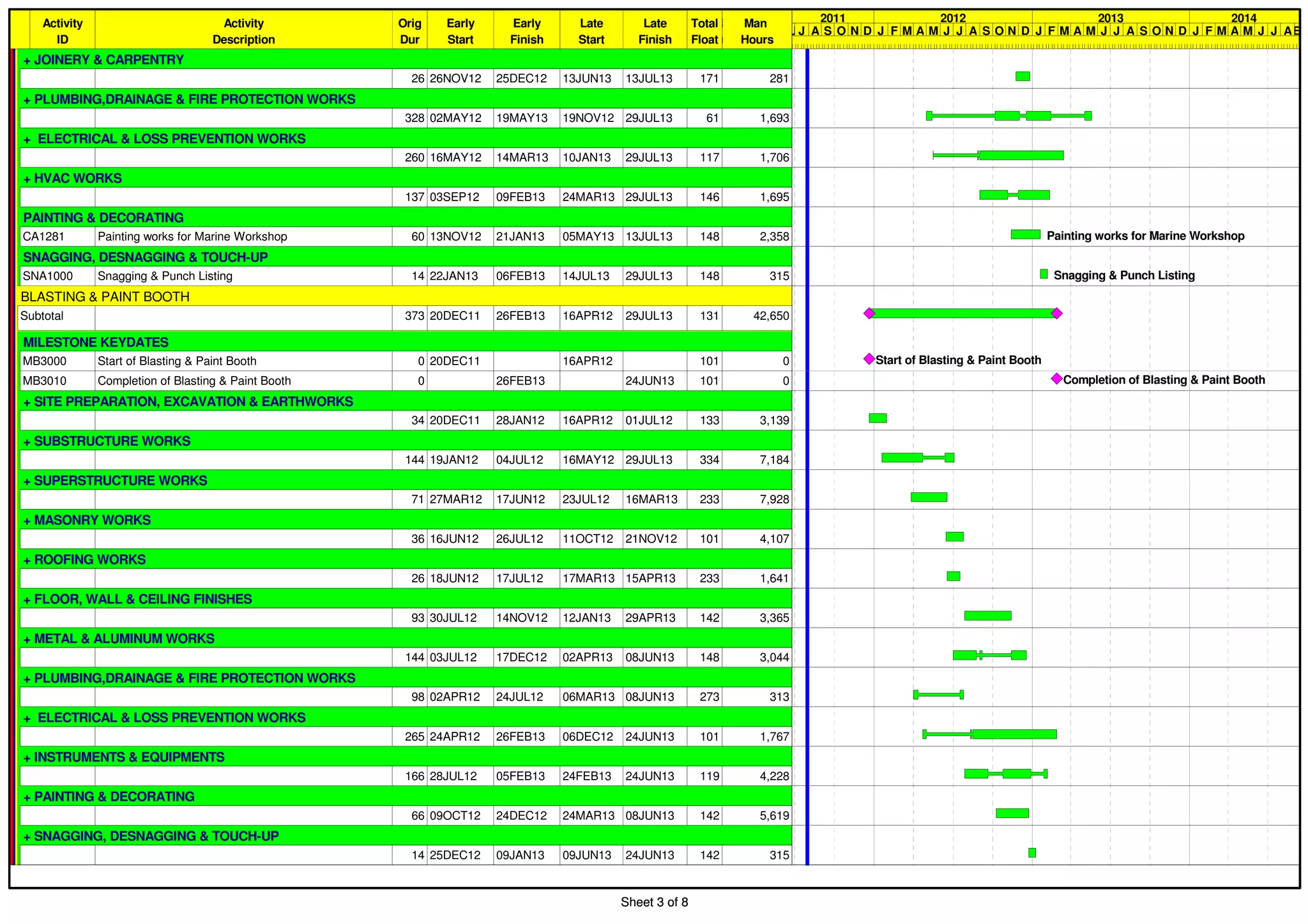

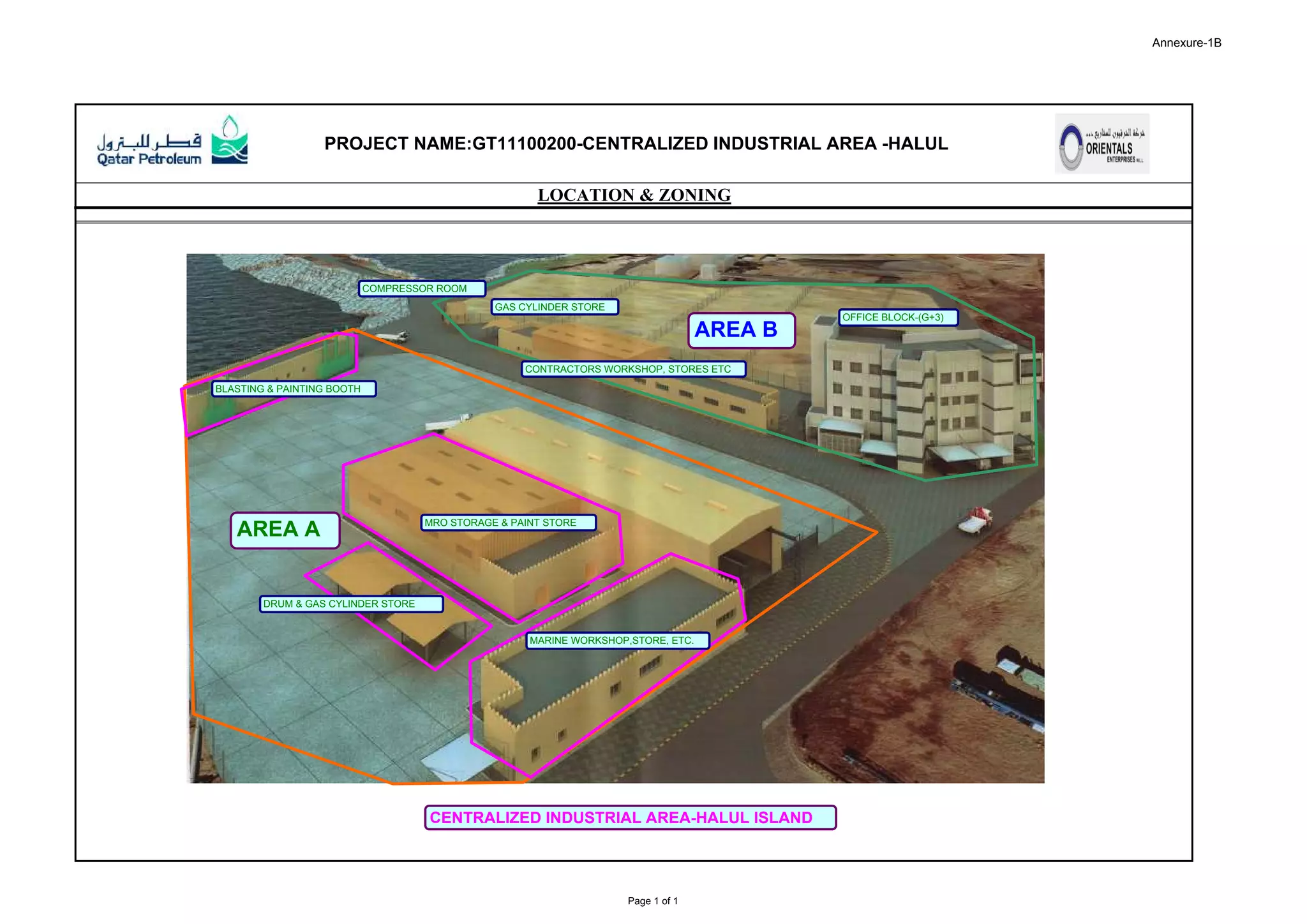

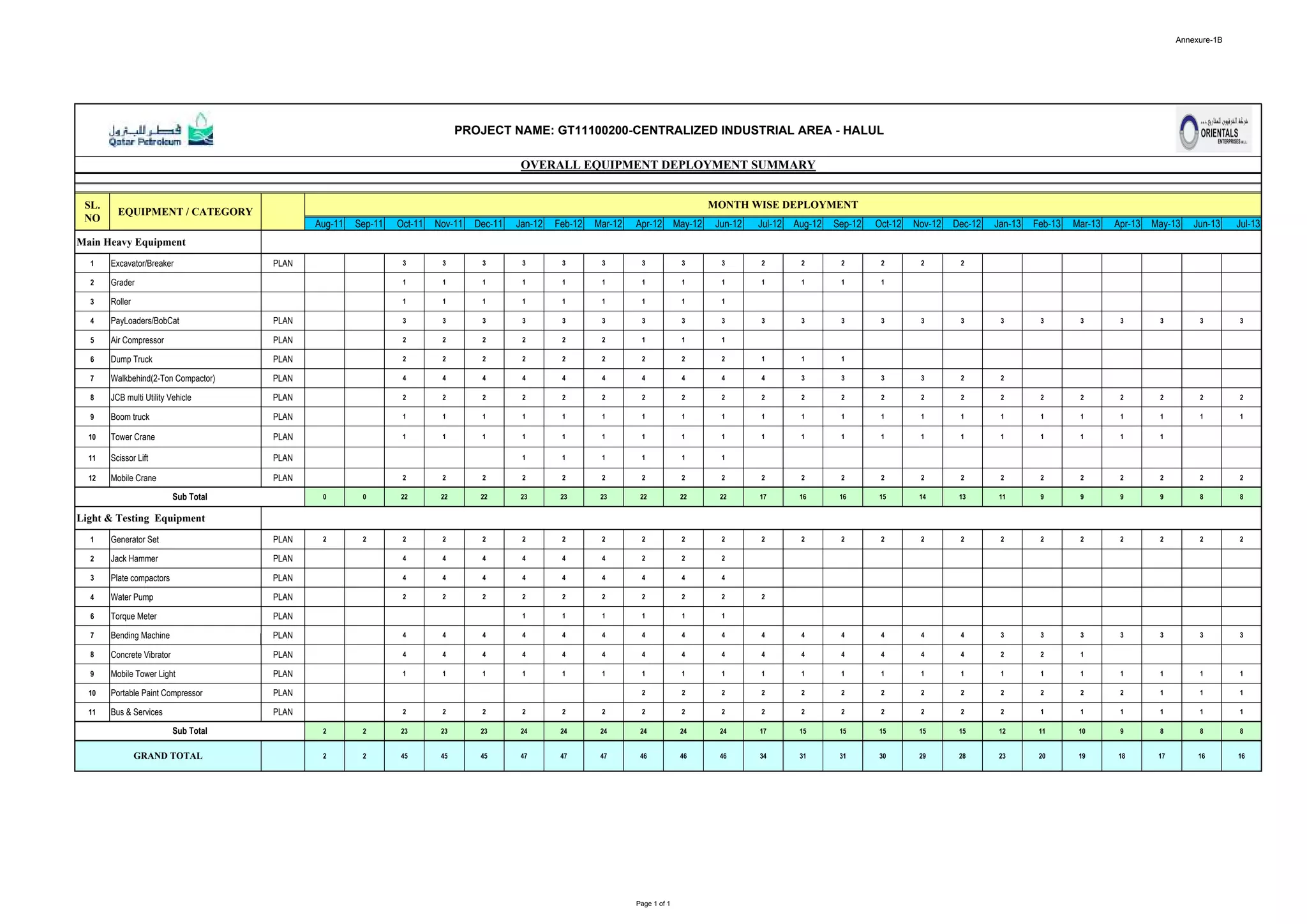

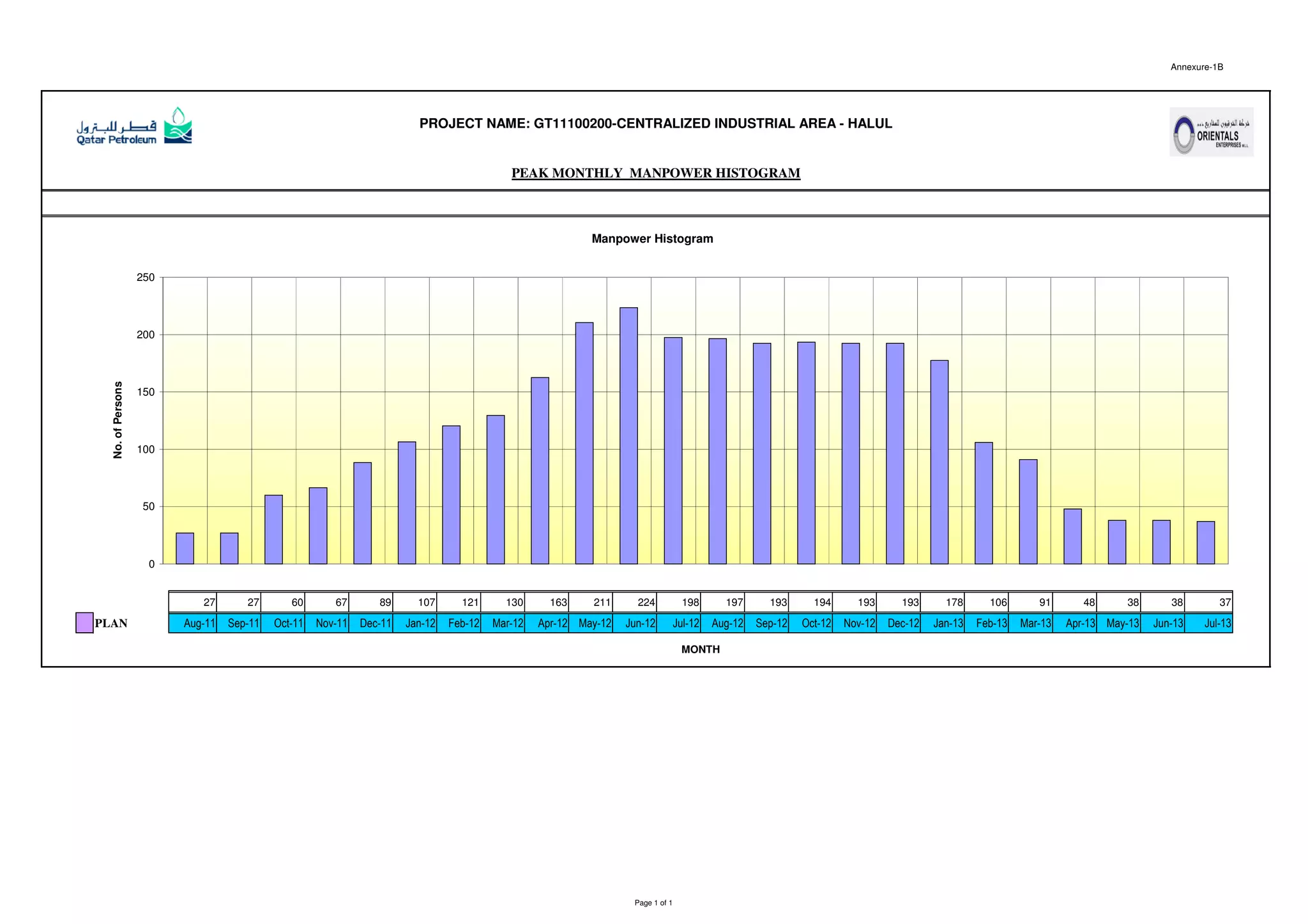

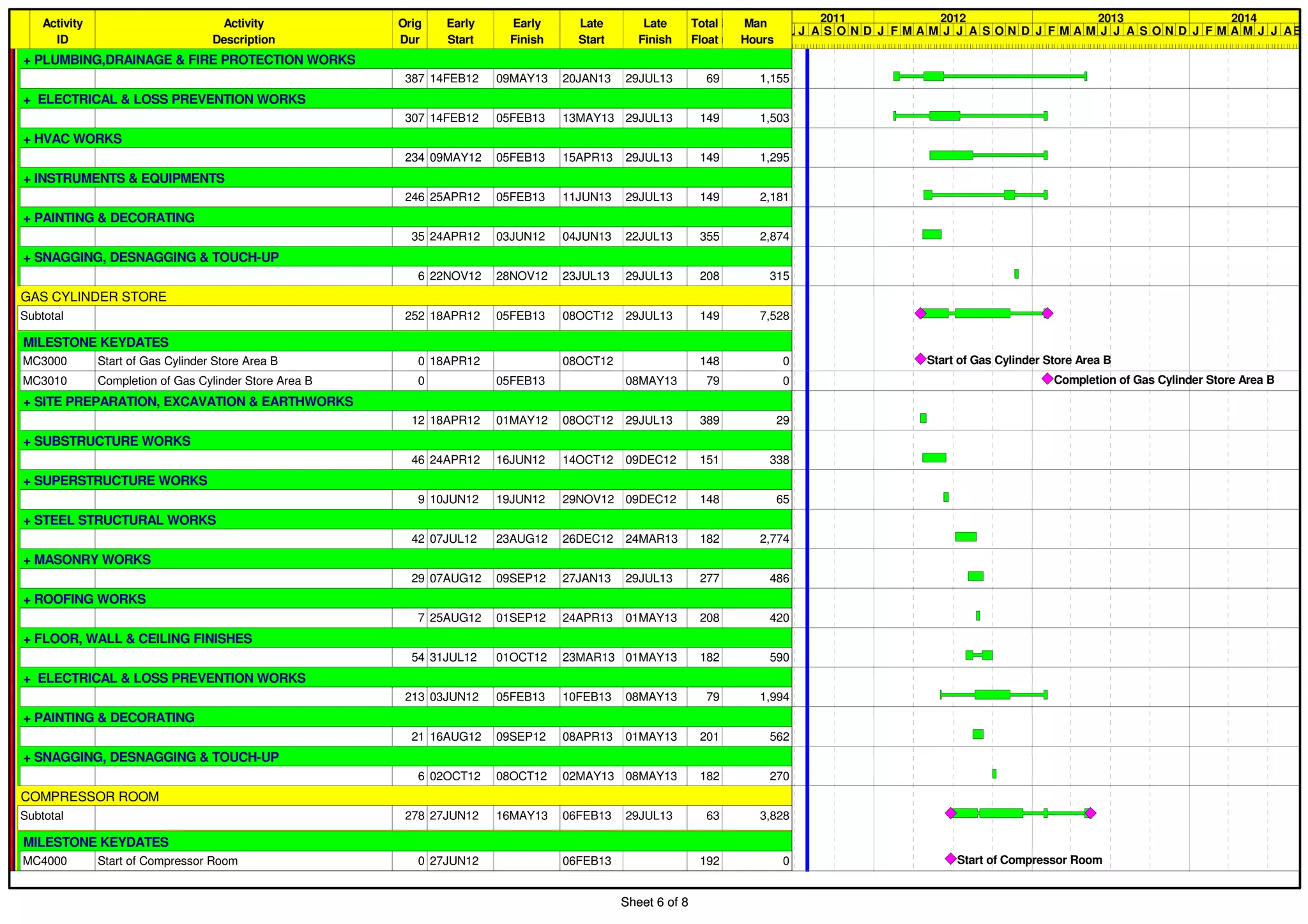

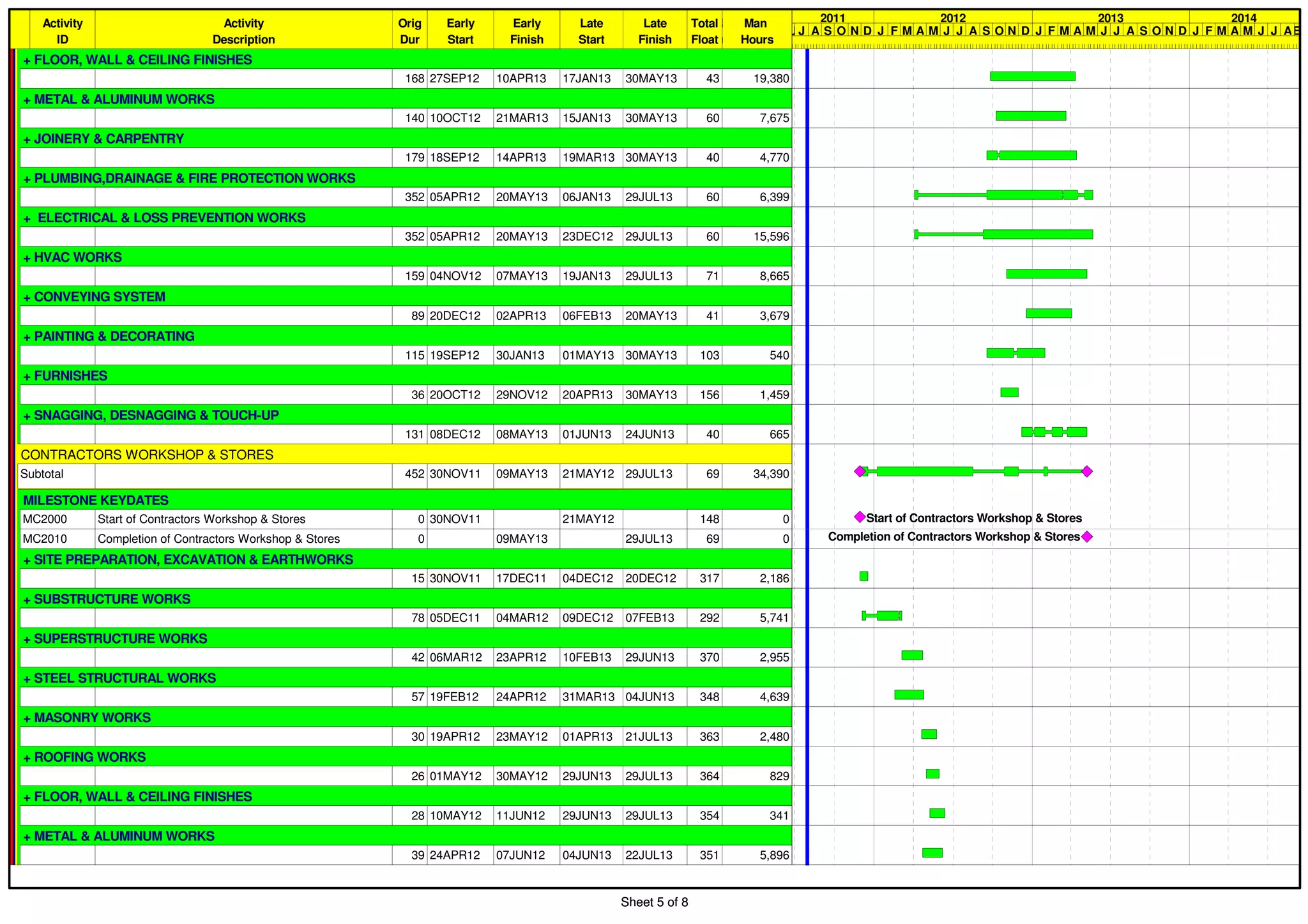

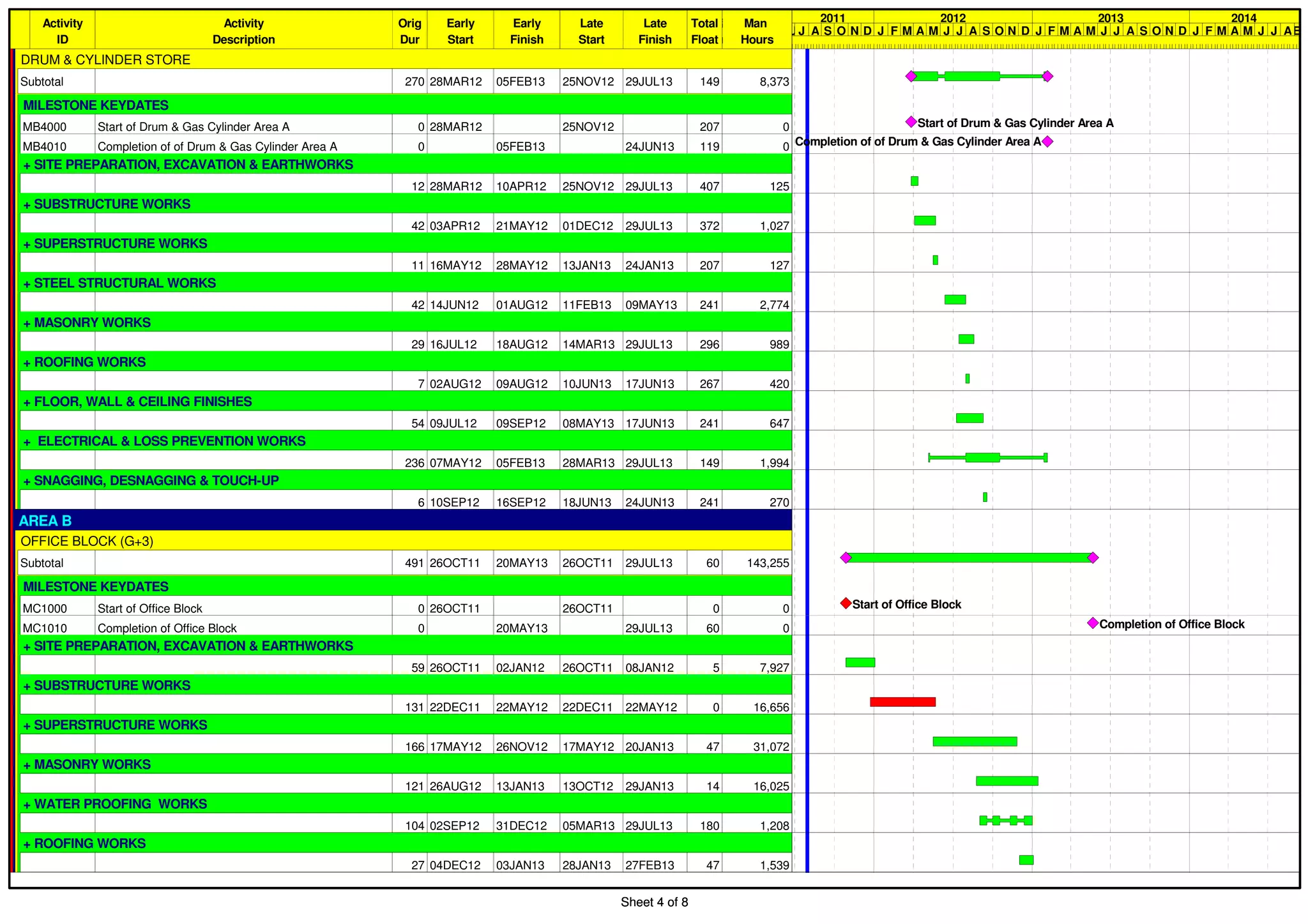

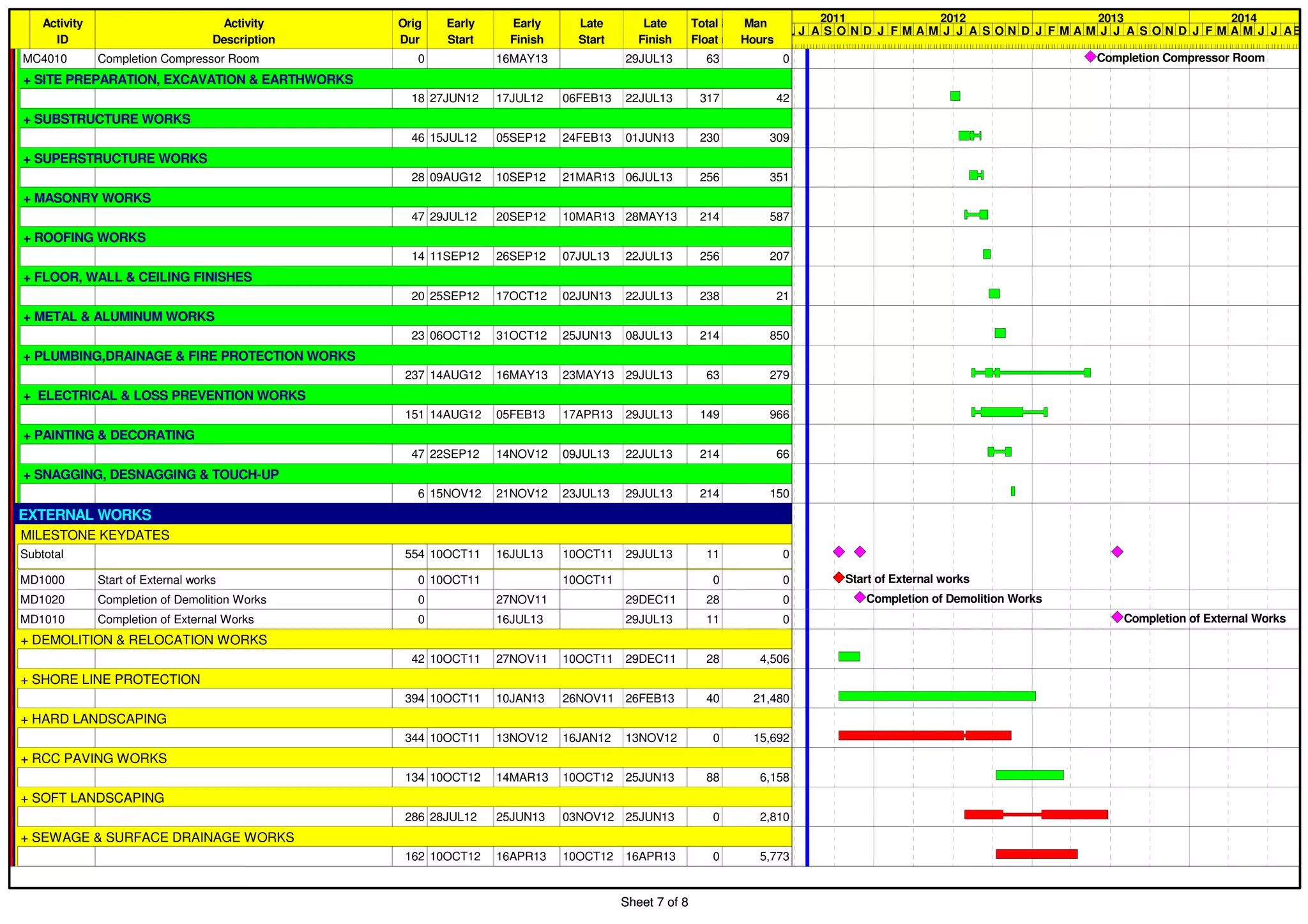

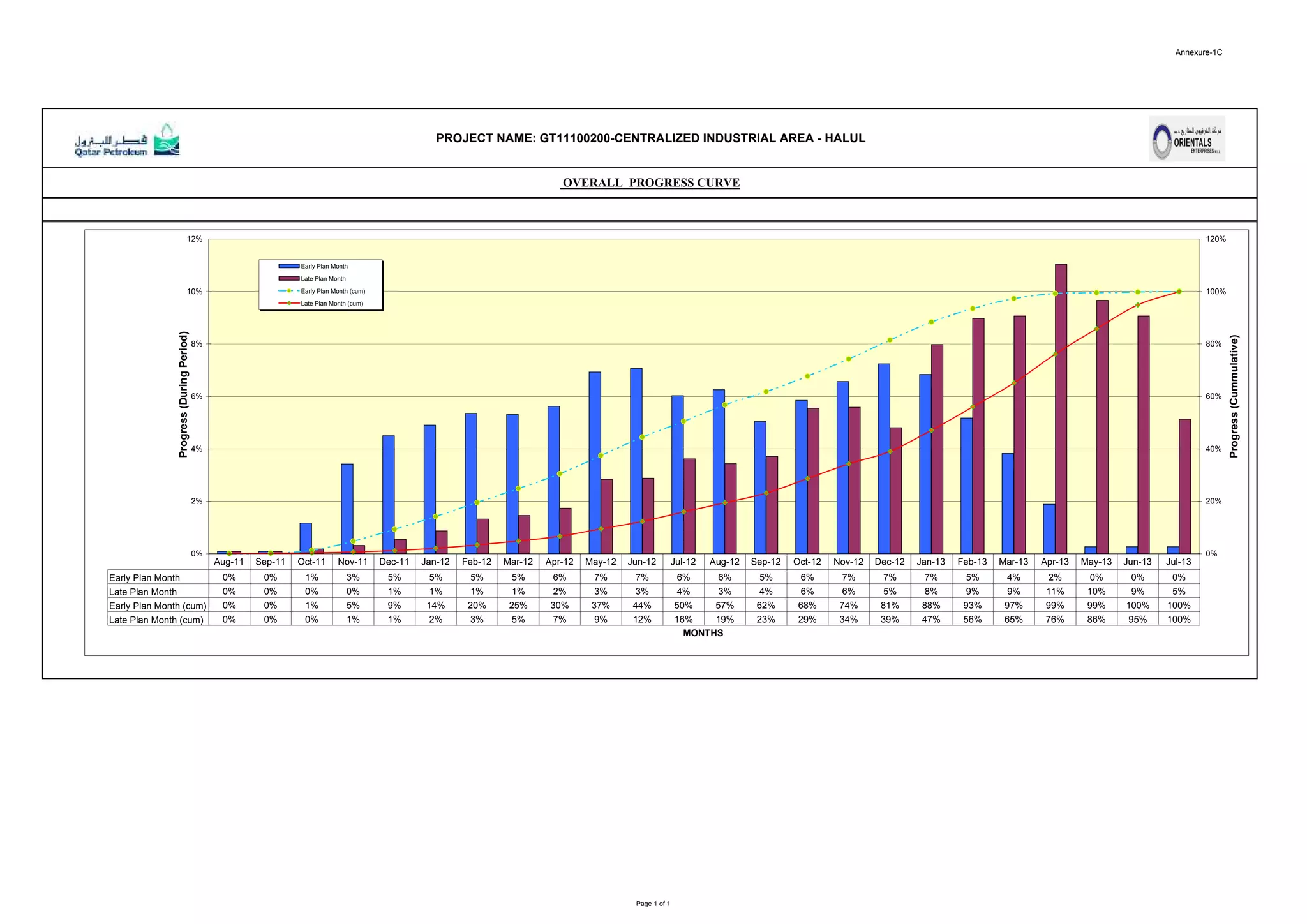

This document provides a schedule for the construction of a centralized industrial area at Halul Island. It lists activities with descriptions, durations, start and finish dates, and other details. The schedule outlines preliminary activities like training and site surveying. It then provides schedules for specific areas including an MRO storage and paint store, marine workshop, blasting and paint booth, drum and cylinder store, and an office block. Milestone dates are included. The level of detail in the schedule indicates it is intended for project planning and tracking progress of the industrial area construction.
