MS Project
Project structuring - Project
management H. Van de Vyver
Project structuring
 Introduction
 Project management
 MS Project
 Structuring the project
 Tasks
 Resources
 Assignment
 Timing
 18.30 – 20:00
 20:30 - 21.30
Project management
 Time
 Duration
 Deadline
 Cost
 Resources
 People
 budget
 Scope
 Managing product constraints
 Communication and information
Excel
Visio
Project
Access
From brainstorming to mature project
Time
Complexity
Mindmanager
Outlook
Powerpoint
MS Project
Mind manager: brainstorming
Project 1
Start Date of project : 1/06/2016
Standard Calendar
 Analyse existing treaty
 Study period 3 weeks
 negotiation period 1 month
 publication period 5 days
 Propose first draft of treaty
 negotiation with countries 2 months
 publication of drafts 9 days
 translation of the documents 2 weeks
 Final version
 discussion with the EU Council 1,5 months
 discussion at the Parliament 2 months
 discussion at the Commission 0,5 months
 Public signature of the Treaty ?
 Publication
 print en/fr 3 days
 web publication 2 days
 Translation 2 weeks
Exercise – New country
 End Date of project : 15/12/2016
 Standard Calendar
 prepare and discuss
 analyse demands 2 w
 select countries to accept 5 d
 define requests 8 d
 negotiate
 With legal authorities 1 mo
 With political authorities 1 mo
 With financial authorities 0,5 mo
 accept an publish
 finalize agreement 2w
 publicize externally 8 d
 publicize internally 5 d
 publicize on the web 1 d
 country follow up
 Schedule 5 w
 Timing 2w
Exercise – New country (update)
 The three tasks of negotiate
 With legal authorities
 With political authorities
 With financial authorities
Are in a parallel sequence (started together)
 accept an publish
 publicize internally lag time of 3 days
 country follow up
 Schedule : split three weeks (wherever)
 Recurring task: meeting first Wednesday
of each third month
Exercise – New country (resources)
 Political negotiator
 100 % available
 Never works on Friday
 3000 eur / month – 30 eur/h
overtime rate
 Legal negotiator
 10 hours a day – never goes on
holiday (except Weekends)
 3000 eur / month – 30 eur/h
overtime rate
 Financial negotiator
 Goes on holiday for three
weeks in July
 3000 eur / month – 30 eur/h
overtime rate
 Head of negotiators
 85 % on the project
 Standard calendar
 5000 eur / month – 50
eur/h overtime rate
 Translator
 3000 eur / month – 30
eur/h overtime rate
 Works all mornings from 7
to 13 hrs
 Publisher
 Standard calendar
 3000 eur / month – 30
eur/h overtime rate
Exercise – New country
(resource allocation)
 prepare and discuss
 analyse demands – political negotiator – 100 %
 select countries to accept – head of negotiators – 100%
 define requests - political negotiator – 50 % / legal negotiator – 50 %
 negotiate
 With legal authorities - legal negotiator – 100 %
 With political authorities - political negotiator – 100 %
 With financial authorities - financial negotiator – 100 %
 accept an publish
 finalize agreement political negotiator / head of the negotiators (keep duration)
 publicize externally – publisher 100 %
 publicize internally – publisher 100 %
 publicize on the web – publisher 100 %
 country follow up
 Schedule - political negotiator / legal negotiator / financial negotiator (keep
duration)
 Timing - political negotiator / legal negotiator / financial negotiator (keep
duration)
 Meeting
 everyone
Project follow up (Day 2)
Recap exercise
Follow up
Baseline
Actual data
Communication
View and print
Reports
Global projects
Group projects
Resource pool
 Timing
 9.00 – 12.30
10.30 (1/2 h cb)
 14.00 – 16.30
15.30 (1/4 h cb)
Recap exercise – New country
 Add two tasks in « prepare and discuss »
 feedback on requests 2 wks
 follow up on requests 2 wks
 Both tasks for the political negociator at 100 % and parallel after « define
requests »
 Add three tasks in « country follow up »
 financial follow up 5 mo (financial negotiator)
 legal follow up 1 mo (legal negotiator)
 political follow up 0,5 mo (political negotiator)
 All tasks parallel after « timing » but with 3 wks of lag time for each task
 Add a lag time of 3 days to « finalise agreement » and a lead time of
2 days to « define request »
 Change the availability of the head of the negociators to 100 %
 Remove all exceptional calendars, all participants work like the
standard project calendar from 8.30 h to 12 and from 14.30 h to 18
hrs
 Add a new ressource, head of publishers, working 25 % on the
project and costing 35 €/hr (normal hours). This ressource will help
the publisher on all his tasks
Exercise 1
Create a new baseline in new country and look to
 Baseline
 Variance
In the statistics of your project
Or in the table Baseline and in the table Variance (View menu)
What do you see ?
Exercise 2
Update your project (new country)
 All tasks of « Prepare and discuss » are 100 % ok
according to plan on 23 october
 « Negotiation period » is 100 % ok according to
plan on 1/11
 « publication period» is 25 % ok
 Finalize agreement had a workload of 26 hrs
 « schedule » actually started three weeks after
plan
 « timing » actually started two weeks after plan
Exercise 3
In the project New country
 Insert a column to show the status indicators
 Put two progress lines, one on 15/02/11 and another in
15/03/11 than switch of the lines (but keep the dates)
 Include a summary task to your project
Exercise 4
 Find and look at the following reports (new country)
 Completed task report
 Overbudgeted task
 Who does what
 Make your own report based on who does what when but
limit it to the second year
Exercise 5
 Create two subprojects
 Prepare and discuss
 Negotiate
 Make a new consolidated projects out of this two
subprojects
 Add a project summary task
Exercise 6
 Create a new ressource pool with john the negociator, paul
the translator, peter the publisher and mary the head of
translators; get rid of the allocation and the ressources of
your two projects and share this new ressources

MS Project training

  • 1.
    MS Project Project structuring- Project management H. Van de Vyver
  • 2.
    Project structuring  Introduction Project management  MS Project  Structuring the project  Tasks  Resources  Assignment  Timing  18.30 – 20:00  20:30 - 21.30
  • 3.
    Project management  Time Duration  Deadline  Cost  Resources  People  budget  Scope  Managing product constraints  Communication and information
  • 4.
  • 5.

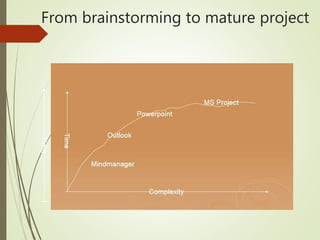

    From brainstorming tomature project Time Complexity Mindmanager Outlook Powerpoint MS Project
  • 6.
  • 7.
    Project 1 Start Dateof project : 1/06/2016 Standard Calendar  Analyse existing treaty  Study period 3 weeks  negotiation period 1 month  publication period 5 days  Propose first draft of treaty  negotiation with countries 2 months  publication of drafts 9 days  translation of the documents 2 weeks  Final version  discussion with the EU Council 1,5 months  discussion at the Parliament 2 months  discussion at the Commission 0,5 months  Public signature of the Treaty ?  Publication  print en/fr 3 days  web publication 2 days  Translation 2 weeks
  • 8.
    Exercise – Newcountry  End Date of project : 15/12/2016  Standard Calendar  prepare and discuss  analyse demands 2 w  select countries to accept 5 d  define requests 8 d  negotiate  With legal authorities 1 mo  With political authorities 1 mo  With financial authorities 0,5 mo  accept an publish  finalize agreement 2w  publicize externally 8 d  publicize internally 5 d  publicize on the web 1 d  country follow up  Schedule 5 w  Timing 2w
  • 9.
    Exercise – Newcountry (update)  The three tasks of negotiate  With legal authorities  With political authorities  With financial authorities Are in a parallel sequence (started together)  accept an publish  publicize internally lag time of 3 days  country follow up  Schedule : split three weeks (wherever)  Recurring task: meeting first Wednesday of each third month
  • 10.
    Exercise – Newcountry (resources)  Political negotiator  100 % available  Never works on Friday  3000 eur / month – 30 eur/h overtime rate  Legal negotiator  10 hours a day – never goes on holiday (except Weekends)  3000 eur / month – 30 eur/h overtime rate  Financial negotiator  Goes on holiday for three weeks in July  3000 eur / month – 30 eur/h overtime rate  Head of negotiators  85 % on the project  Standard calendar  5000 eur / month – 50 eur/h overtime rate  Translator  3000 eur / month – 30 eur/h overtime rate  Works all mornings from 7 to 13 hrs  Publisher  Standard calendar  3000 eur / month – 30 eur/h overtime rate
  • 11.
    Exercise – Newcountry (resource allocation)  prepare and discuss  analyse demands – political negotiator – 100 %  select countries to accept – head of negotiators – 100%  define requests - political negotiator – 50 % / legal negotiator – 50 %  negotiate  With legal authorities - legal negotiator – 100 %  With political authorities - political negotiator – 100 %  With financial authorities - financial negotiator – 100 %  accept an publish  finalize agreement political negotiator / head of the negotiators (keep duration)  publicize externally – publisher 100 %  publicize internally – publisher 100 %  publicize on the web – publisher 100 %  country follow up  Schedule - political negotiator / legal negotiator / financial negotiator (keep duration)  Timing - political negotiator / legal negotiator / financial negotiator (keep duration)  Meeting  everyone
  • 12.
    Project follow up(Day 2) Recap exercise Follow up Baseline Actual data Communication View and print Reports Global projects Group projects Resource pool  Timing  9.00 – 12.30 10.30 (1/2 h cb)  14.00 – 16.30 15.30 (1/4 h cb)
  • 13.
    Recap exercise –New country  Add two tasks in « prepare and discuss »  feedback on requests 2 wks  follow up on requests 2 wks  Both tasks for the political negociator at 100 % and parallel after « define requests »  Add three tasks in « country follow up »  financial follow up 5 mo (financial negotiator)  legal follow up 1 mo (legal negotiator)  political follow up 0,5 mo (political negotiator)  All tasks parallel after « timing » but with 3 wks of lag time for each task  Add a lag time of 3 days to « finalise agreement » and a lead time of 2 days to « define request »  Change the availability of the head of the negociators to 100 %  Remove all exceptional calendars, all participants work like the standard project calendar from 8.30 h to 12 and from 14.30 h to 18 hrs  Add a new ressource, head of publishers, working 25 % on the project and costing 35 €/hr (normal hours). This ressource will help the publisher on all his tasks
  • 14.
    Exercise 1 Create anew baseline in new country and look to  Baseline  Variance In the statistics of your project Or in the table Baseline and in the table Variance (View menu) What do you see ?
  • 15.
    Exercise 2 Update yourproject (new country)  All tasks of « Prepare and discuss » are 100 % ok according to plan on 23 october  « Negotiation period » is 100 % ok according to plan on 1/11  « publication period» is 25 % ok  Finalize agreement had a workload of 26 hrs  « schedule » actually started three weeks after plan  « timing » actually started two weeks after plan
  • 16.
    Exercise 3 In theproject New country  Insert a column to show the status indicators  Put two progress lines, one on 15/02/11 and another in 15/03/11 than switch of the lines (but keep the dates)  Include a summary task to your project
  • 17.
    Exercise 4  Findand look at the following reports (new country)  Completed task report  Overbudgeted task  Who does what  Make your own report based on who does what when but limit it to the second year
  • 18.
    Exercise 5  Createtwo subprojects  Prepare and discuss  Negotiate  Make a new consolidated projects out of this two subprojects  Add a project summary task
  • 19.
    Exercise 6  Createa new ressource pool with john the negociator, paul the translator, peter the publisher and mary the head of translators; get rid of the allocation and the ressources of your two projects and share this new ressources
