© 2017 MapR Technologies
Spark Machine Learning
Carol McDonald
@caroljmcdonald
© 2017 MapR Technologies

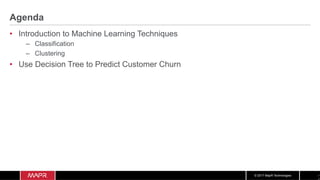

Agenda
•  Introduction to Machine Learning Techniques
–  Classification
–  Clustering
•  Use Decision Tree to Predict Customer Churn
© 2017 MapR Technologies
What is Machine Learning?
Data Build ModelTrain Algorithm
Finds patterns
New Data Use Model
(prediction function)
Predictions
Contains patterns Recognizes patterns
© 2017 MapR Technologies

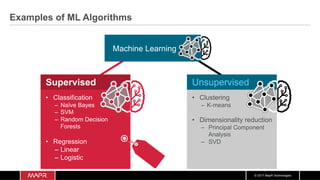

Examples of ML Algorithms
Supervised
•  Classification
–  Naïve Bayes
–  SVM
–  Random Decision
Forests
•  Regression
–  Linear
–  Logistic
Machine Learning
Unsupervised
•  Clustering
–  K-means
•  Dimensionality reduction
–  Principal Component
Analysis
–  SVD
© 2017 MapR Technologies

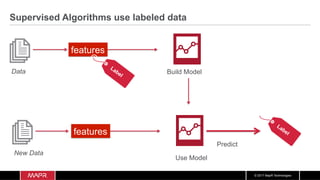

Supervised Algorithms use labeled data
Data
features
Build Model
New Data
features
Predict
Use Model
© 2017 MapR Technologies

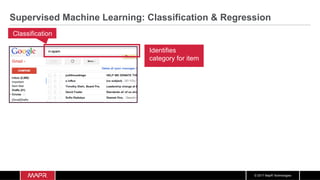

Supervised Machine Learning: Classification & Regression
Classification
Identifies
category for item
© 2017 MapR Technologies
Classification: Definition
Form of ML that:
•  Identifies which category an item belongs to
•  Uses supervised learning algorithms
–  Data is labeled
Sentiment
© 2017 MapR Technologies

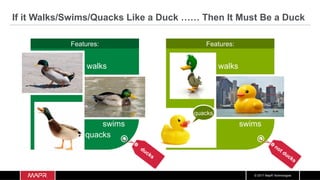

If it Walks/Swims/Quacks Like a Duck …… Then It Must Be a Duck
swims
walks
quacks
Features:
walks
quacks
swims
Features:
© 2017 MapR Technologies
Car Insurance Fraud Example
•  What are we trying to predict?
–  This is the Label or Target outcome:
–  The amount of Fraud
•  What are the “if questions” or properties we can use to predict?
–  These are the Features:
–  The claim Amount
© 2017 MapR Technologies
Label:
Amount of Fraud
Y
X
Feature: claimed amount
Data point: fraud amount,
claimed amount
AmntFraud = intercept + coeff * claimedAmnt

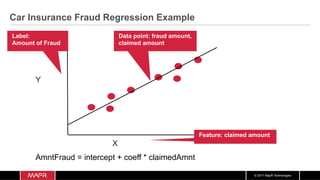

Car Insurance Fraud Regression Example
© 2017 MapR Technologies

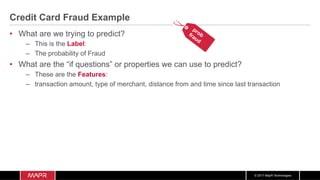

Credit Card Fraud Example
•  What are we trying to predict?
–  This is the Label:
–  The probability of Fraud
•  What are the “if questions” or properties we can use to predict?
–  These are the Features:
–  transaction amount, type of merchant, distance from and time since last transaction
© 2017 MapR Technologies

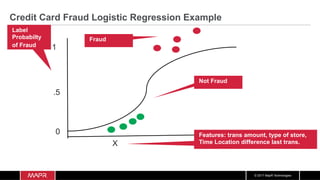

Label
Probabilty
of Fraud 1
X
Features: trans amount, type of store,
Time Location difference last trans.
Fraud
0
Not Fraud
.5
Credit Card Fraud Logistic Regression Example
© 2017 MapR Technologies

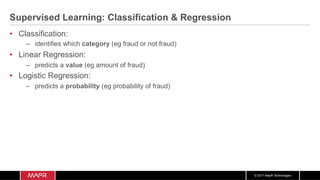

Supervised Learning: Classification & Regression
•  Classification:
–  identifies which category (eg fraud or not fraud)
•  Linear Regression:
–  predicts a value (eg amount of fraud)
•  Logistic Regression:
–  predicts a probability (eg probability of fraud)
© 2017 MapR Technologies

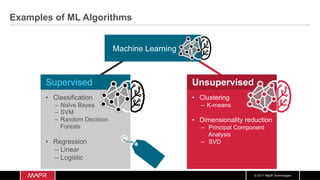

Examples of ML Algorithms
Machine Learning
Unsupervised
•  Clustering
–  K-means
•  Dimensionality reduction
–  Principal Component
Analysis
–  SVD
Supervised
•  Classification
–  Naïve Bayes
–  SVM
–  Random Decision
Forests
•  Regression
–  Linear
–  Logistic
© 2017 MapR Technologies
Unsupervised Algorithms use Unlabeled data
Customer GroupsBuild ModelTrain Algorithm
Finds patterns
New Customer
Purchase Data
Use Model
(prediction function) Predict Group
Contains patterns Recognizes patterns
Customer purchase
data
© 2017 MapR Technologies

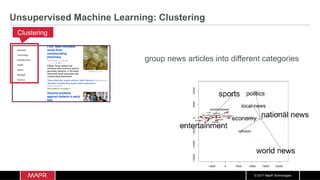

Unsupervised Machine Learning: Clustering
Clustering
group news articles into different categories
© 2017 MapR Technologies
Clustering: Definition
•  Unsupervised learning task
•  Groups objects into clusters of high similarity
© 2017 MapR Technologies

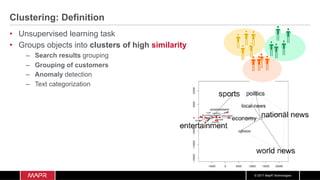

Clustering: Definition
•  Unsupervised learning task
•  Groups objects into clusters of high similarity
–  Search results grouping
–  Grouping of customers
–  Anomaly detection
–  Text categorization
© 2017 MapR Technologies

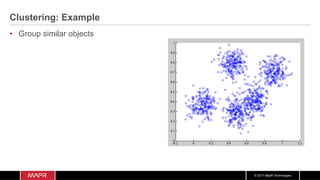

Clustering: Example
•  Group similar objects
© 2017 MapR Technologies
Clustering: Example
•  Group similar objects
•  Use MLlib K-means algorithm
1.  Initialize coordinates to center
of clusters (centroid)
x
x
x
x
x
© 2017 MapR Technologies
Clustering: Example
•  Group similar objects
•  Use MLlib K-means algorithm
1.  Initialize coordinates to center
of clusters (centroid)
2.  Assign all points to nearest
centroid
x
x
x
x
x
© 2017 MapR Technologies

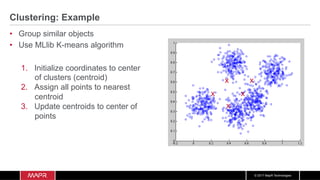

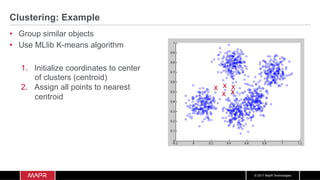

Clustering: Example
•  Group similar objects
•  Use MLlib K-means algorithm
1.  Initialize coordinates to center
of clusters (centroid)
2.  Assign all points to nearest
centroid
3.  Update centroids to center of
points
x
x
x
x
x
© 2017 MapR Technologies
Clustering: Example
•  Group similar objects
•  Use MLlib K-means algorithm
1.  Initialize coordinates to center
of clusters (centroid)
2.  Assign all points to nearest
centroid
3.  Update centroids to center of
points
4.  Repeat until conditions met
x
x
x
x
x
© 2017 MapR Technologies
Predict Churn
© 2017 MapR Technologies

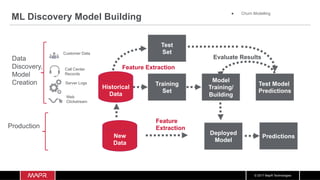

ML Discovery Model Building
Model
Training/
Building
Training
Set
Test Model
Predictions
Test
Set
Evaluate Results
Historical
Data
Deployed
Model
Predictions
Data
Discovery,
Model
Creation
Production
Feature Extraction
Feature
Extraction
New
Data
Customer Data
Call Center
Records
Web
Clickstream
Server Logs
●  Churn Modelling
© 2017 MapR Technologies

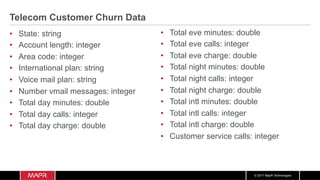

Telecom Customer Churn Data
•  State: string
•  Account length: integer
•  Area code: integer
•  International plan: string
•  Voice mail plan: string
•  Number vmail messages: integer
•  Total day minutes: double
•  Total day calls: integer
•  Total day charge: double
•  Total eve minutes: double
•  Total eve calls: integer
•  Total eve charge: double
•  Total night minutes: double
•  Total night calls: integer
•  Total night charge: double
•  Total intl minutes: double
•  Total intl calls: integer
•  Total intl charge: double
•  Customer service calls: integer
© 2017 MapR Technologies

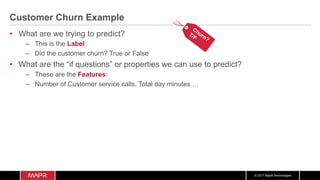

Customer Churn Example
•  What are we trying to predict?
–  This is the Label:
–  Did the customer churn? True or False
•  What are the “if questions” or properties we can use to predict?
–  These are the Features:
–  Number of Customer service calls, Total day minutes …
© 2017 MapR Technologies

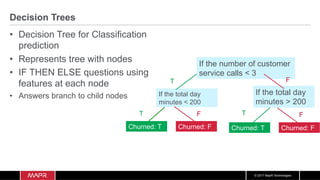

Decision Trees
•  Decision Tree for Classification
prediction
•  Represents tree with nodes
•  IF THEN ELSE questions using
features at each node
•  Answers branch to child nodes
If the number of customer
service calls < 3
If the total day
minutes > 200
Churned: T
If the total day
minutes < 200
Churned: F
T
Churned: T Churned: F
F
FF TT
© 2017 MapR Technologies

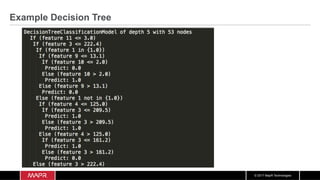

Example Decision Tree
© 2017 MapR Technologies
Spark ML workflow
© 2017 MapR Technologies

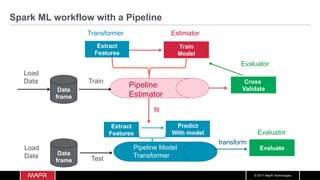

Spark ML workflow with a Pipeline
Pipeline
Estimator
Extract
Features
Load
Data
Train
Model
Estimator
Data
frame
Transformer
Cross
Validate
Pipeline Model
TransformerTest
Data
frame
Evaluate
fit
Train
Load
Data
Evaluator
Predict
With model
Extract
Features Evaluator
transform
© 2017 MapR Technologies

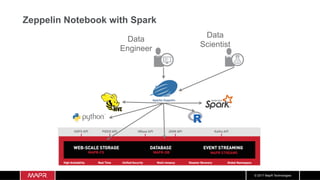

Zeppelin Notebook with Spark
Data
Engineer
Data
Scientist
© 2017 MapR Technologies

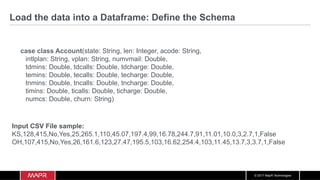

Load the data into a Dataframe: Define the Schema
case class Account(state: String, len: Integer, acode: String,
intlplan: String, vplan: String, numvmail: Double,
tdmins: Double, tdcalls: Double, tdcharge: Double,
temins: Double, tecalls: Double, techarge: Double,
tnmins: Double, tncalls: Double, tncharge: Double,
timins: Double, ticalls: Double, ticharge: Double,
numcs: Double, churn: String)
Input CSV File sample:
KS,128,415,No,Yes,25,265.1,110,45.07,197.4,99,16.78,244.7,91,11.01,10.0,3,2.7,1,False
OH,107,415,No,Yes,26,161.6,123,27.47,195.5,103,16.62,254.4,103,11.45,13.7,3,3.7,1,False
© 2017 MapR Technologies
Data
Frame
Load data
Load the data into a Dataset
val train: Dataset[Account] = spark.read.option("inferSchema", "false")
.schema(schema).csv("/user/user01/data/churn-bigml-80.csv").as[Account]
© 2017 MapR Technologies

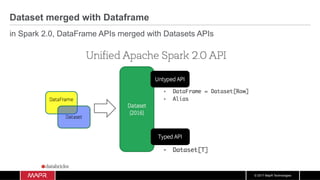

Dataset merged with Dataframe
in Spark 2.0, DataFrame APIs merged with Datasets APIs
© 2017 MapR Technologies

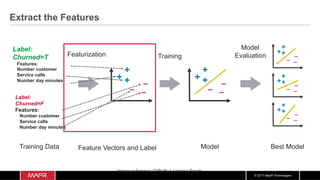

Extract the Features
Image reference O’Reilly Learning Spark
+
+
̶+
̶ ̶
Feature Vectors and Label Model
Featurization Training
Model
Evaluation
Best Model
Label:
Churned=T
Features:
Number customer
Service calls
Number day minutes
Training Data
Label:
Churned=F
Features:
Number customer
Service calls
Number day minutes
+
+
̶+
̶ ̶
+
+
̶+
̶ ̶
+
+
̶+
̶ ̶
+
+
̶+
̶ ̶
© 2017 MapR Technologies
Data
Frame
Add column

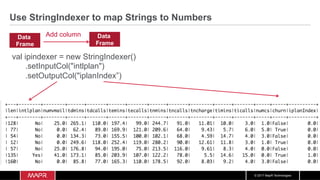

Use StringIndexer to map Strings to Numbers
val ipindexer = new StringIndexer()
.setInputCol("intlplan")
.setOutputCol("iplanIndex”)
Data
Frame
© 2017 MapR Technologies

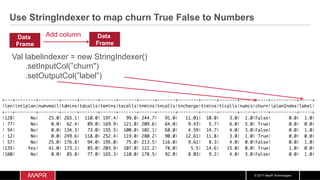

Data
Frame
Add column
Use StringIndexer to map churn True False to Numbers
Val labelindexer = new StringIndexer()
.setInputCol(”churn")
.setOutputCol(”label”)
Data
Frame
© 2017 MapR Technologies
Data
Frame
Load data Add column DataFrame +
Features
Use VectorAssembler to put features in vector column
val featureCols = Array(”temins", "iplanIndex", "tdmins", "tdcalls”…)
val assembler = new VectorAssembler()
.setInputCols(featureCols)
.setOutputCol("features")
© 2017 MapR Technologies
Data
Frame
Load data transform
Estimator
val dTree = new DecisionTreeClassifier()
.setLabelCol("label")
.setFeaturesCol("features")
Create DecisionTree Estimator, Set Label and Features
DataFrame +
Features
© 2017 MapR Technologies
val pipeline = new Pipeline()
.setStages(Array(ipindexer, labelindexer, assembler, dTree))
Put Feature Transformers and Estimator in Pipeline
Pipeline
ipIndexer
feature
transform
assembler
Dtree
estimatorlabelindexer
feature
transform
assemble
Features
Produce
model
© 2017 MapR Technologies

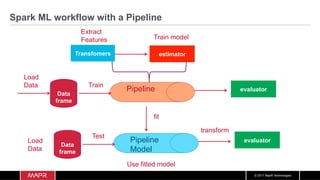

Spark ML workflow with a Pipeline
Pipeline
Transfomers
Load
Data
estimator
Train model
Data
frame
Extract
Features
evaluator
Pipeline
Model
Test
Data
frame
evaluator
Use fitted model
Train
Load
Data
fit
transform
© 2017 MapR Technologies

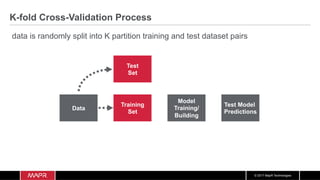

K-fold Cross-Validation Process
Data
Model
Training/
Building
Training
Set
Test Model
Predictions
Test
Set
data is randomly split into K partition training and test dataset pairs
© 2017 MapR Technologies

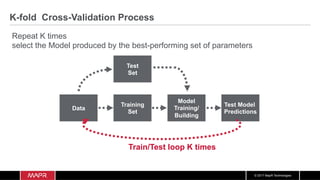

K-fold Cross-Validation Process
Data
Model
Training
Training
Set
Test Model
Predictions
Test
Set
Train algorithm with training dataset
© 2017 MapR Technologies

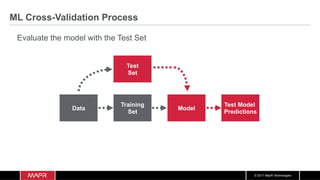

ML Cross-Validation Process
Data Model
Training
Set
Test Model
Predictions
Test
Set
Evaluate the model with the Test Set
© 2017 MapR Technologies
K-fold Cross-Validation Process
Data
Model
Training/
Building
Training
Set
Test Model
Predictions
Test
Set
Train/Test loop K times
Repeat K times
select the Model produced by the best-performing set of parameters
© 2017 MapR Technologies

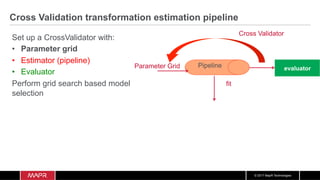

Cross Validation transformation estimation pipeline
Pipeline
Cross Validator
evaluatorParameter Grid
fit
Set up a CrossValidator with:
•  Parameter grid
•  Estimator (pipeline)
•  Evaluator
Perform grid search based model
selection
© 2017 MapR Technologies

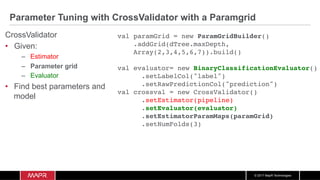

Parameter Tuning with CrossValidator with a Paramgrid
CrossValidator
•  Given:
–  Estimator
–  Parameter grid
–  Evaluator
•  Find best parameters and
model
val paramGrid = new ParamGridBuilder()
.addGrid(dTree.maxDepth,
Array(2,3,4,5,6,7)).build()
val evaluator= new BinaryClassificationEvaluator()
.setLabelCol("label")
.setRawPredictionCol("prediction")
val crossval = new CrossValidator()
.setEstimator(pipeline)
.setEvaluator(evaluator)
.setEstimatorParamMaps(paramGrid)
.setNumFolds(3)
© 2017 MapR Technologies
val cvModel = crossval.fit(ntrain)
Cross Validator fit a model to the data
Pipeline
Cross Validator
evaluatorParameter Grid
fit
Pipeline
Model
fit a model to the data
with provided parameter grid
© 2017 MapR Technologies
Evaluate the fitted model
Pipeline
Transfomers
Load
Data
estimator
Train model
Data
frame
Extract
Features
evaluator
Pipeline
Model
Test
Data
frame
evaluator
transform
Train
Load
Data
Predict
With model
Extract
Features
fit
© 2017 MapR Technologies
fitted
model

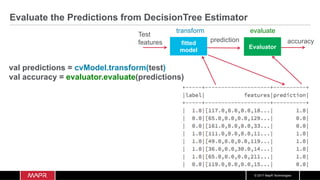

Evaluate the Predictions from DecisionTree Estimator
Evaluator
transform
Test
features
val predictions = cvModel.transform(test)
val accuracy = evaluator.evaluate(predictions)
evaluate
prediction accuracy
© 2017 MapR Technologies

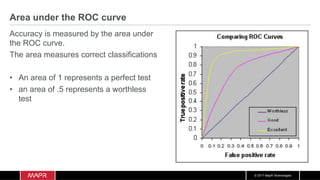

Area under the ROC curve
Accuracy is measured by the area under
the ROC curve.
The area measures correct classifications
•  An area of 1 represents a perfect test
•  an area of .5 represents a worthless
test
© 2017 MapR Technologies
To Learn More:
•  Read about and download example code
•  https://mapr.com/blog/churn-prediction-sparkml/
© 2017 MapR Technologies
To Learn More:
•  End to End Application for Monitoring Uber Data using Spark ML
•  https://mapr.com/blog/monitoring-real-time-uber-data-using-spark-machine-
learning-streaming-and-kafka-api-part-1/
© 2017 MapR Technologies
To Learn More:
•  MapR Free ODT http://learn.mapr.com/
© 2017 MapR Technologies
For Q&A :
•  https://community.mapr.com/
•  https://community.mapr.com/community/answers/pages/qa
© 2017 MapR Technologies
Open Source Engines & Tools Commercial Engines & Applications
Enterprise-Grade Platform Services
DataProcessing
Web-Scale Storage
MapR-XD MapR-DB
Search
and
Others
Real Time Unified Security Multi-tenancy Disaster
Recovery
Global NamespaceHigh Availability
MapR Streams
Cloud
and
Managed
Services
Search and
Others
UnifiedManagementandMonitoring
Search
and
Others
Event StreamingDatabase
Custom
Apps
MapR Converged Data Platform
HDFS API POSIX, NFS Kakfa APIHBase API OJAI API
© 2017 MapR Technologies
Q&A
ENGAGE WITH US

Live Machine Learning Tutorial: Churn Prediction

  • 1.
    © 2017 MapRTechnologies Spark Machine Learning Carol McDonald @caroljmcdonald
  • 2.
    © 2017 MapRTechnologies Agenda •  Introduction to Machine Learning Techniques –  Classification –  Clustering •  Use Decision Tree to Predict Customer Churn
  • 3.
    © 2017 MapRTechnologies What is Machine Learning? Data Build ModelTrain Algorithm Finds patterns New Data Use Model (prediction function) Predictions Contains patterns Recognizes patterns
  • 4.
    © 2017 MapRTechnologies Examples of ML Algorithms Supervised •  Classification –  Naïve Bayes –  SVM –  Random Decision Forests •  Regression –  Linear –  Logistic Machine Learning Unsupervised •  Clustering –  K-means •  Dimensionality reduction –  Principal Component Analysis –  SVD
  • 5.
    © 2017 MapRTechnologies Supervised Algorithms use labeled data Data features Build Model New Data features Predict Use Model
  • 6.
    © 2017 MapRTechnologies Supervised Machine Learning: Classification & Regression Classification Identifies category for item
  • 7.
    © 2017 MapRTechnologies Classification: Definition Form of ML that: •  Identifies which category an item belongs to •  Uses supervised learning algorithms –  Data is labeled Sentiment
  • 8.
    © 2017 MapRTechnologies If it Walks/Swims/Quacks Like a Duck …… Then It Must Be a Duck swims walks quacks Features: walks quacks swims Features:
  • 9.
    © 2017 MapRTechnologies Car Insurance Fraud Example •  What are we trying to predict? –  This is the Label or Target outcome: –  The amount of Fraud •  What are the “if questions” or properties we can use to predict? –  These are the Features: –  The claim Amount
  • 10.
    © 2017 MapRTechnologies Label: Amount of Fraud Y X Feature: claimed amount Data point: fraud amount, claimed amount AmntFraud = intercept + coeff * claimedAmnt Car Insurance Fraud Regression Example
  • 11.
    © 2017 MapRTechnologies Credit Card Fraud Example •  What are we trying to predict? –  This is the Label: –  The probability of Fraud •  What are the “if questions” or properties we can use to predict? –  These are the Features: –  transaction amount, type of merchant, distance from and time since last transaction
  • 12.
    © 2017 MapRTechnologies Label Probabilty of Fraud 1 X Features: trans amount, type of store, Time Location difference last trans. Fraud 0 Not Fraud .5 Credit Card Fraud Logistic Regression Example
  • 13.
    © 2017 MapRTechnologies Supervised Learning: Classification & Regression •  Classification: –  identifies which category (eg fraud or not fraud) •  Linear Regression: –  predicts a value (eg amount of fraud) •  Logistic Regression: –  predicts a probability (eg probability of fraud)
  • 14.
    © 2017 MapRTechnologies Examples of ML Algorithms Machine Learning Unsupervised •  Clustering –  K-means •  Dimensionality reduction –  Principal Component Analysis –  SVD Supervised •  Classification –  Naïve Bayes –  SVM –  Random Decision Forests •  Regression –  Linear –  Logistic
  • 15.
    © 2017 MapRTechnologies Unsupervised Algorithms use Unlabeled data Customer GroupsBuild ModelTrain Algorithm Finds patterns New Customer Purchase Data Use Model (prediction function) Predict Group Contains patterns Recognizes patterns Customer purchase data
  • 16.
    © 2017 MapRTechnologies Unsupervised Machine Learning: Clustering Clustering group news articles into different categories
  • 17.
    © 2017 MapRTechnologies Clustering: Definition •  Unsupervised learning task •  Groups objects into clusters of high similarity
  • 18.
    © 2017 MapRTechnologies Clustering: Definition •  Unsupervised learning task •  Groups objects into clusters of high similarity –  Search results grouping –  Grouping of customers –  Anomaly detection –  Text categorization
  • 19.
    © 2017 MapRTechnologies Clustering: Example •  Group similar objects
  • 20.
    © 2017 MapRTechnologies Clustering: Example •  Group similar objects •  Use MLlib K-means algorithm 1.  Initialize coordinates to center of clusters (centroid) x x x x x
  • 21.
    © 2017 MapRTechnologies Clustering: Example •  Group similar objects •  Use MLlib K-means algorithm 1.  Initialize coordinates to center of clusters (centroid) 2.  Assign all points to nearest centroid x x x x x
  • 22.
    © 2017 MapRTechnologies Clustering: Example •  Group similar objects •  Use MLlib K-means algorithm 1.  Initialize coordinates to center of clusters (centroid) 2.  Assign all points to nearest centroid 3.  Update centroids to center of points x x x x x
  • 23.
    © 2017 MapRTechnologies Clustering: Example •  Group similar objects •  Use MLlib K-means algorithm 1.  Initialize coordinates to center of clusters (centroid) 2.  Assign all points to nearest centroid 3.  Update centroids to center of points 4.  Repeat until conditions met x x x x x
  • 24.
    © 2017 MapRTechnologies Predict Churn
  • 25.
    © 2017 MapRTechnologies ML Discovery Model Building Model Training/ Building Training Set Test Model Predictions Test Set Evaluate Results Historical Data Deployed Model Predictions Data Discovery, Model Creation Production Feature Extraction Feature Extraction New Data Customer Data Call Center Records Web Clickstream Server Logs ●  Churn Modelling
  • 26.
    © 2017 MapRTechnologies Telecom Customer Churn Data •  State: string •  Account length: integer •  Area code: integer •  International plan: string •  Voice mail plan: string •  Number vmail messages: integer •  Total day minutes: double •  Total day calls: integer •  Total day charge: double •  Total eve minutes: double •  Total eve calls: integer •  Total eve charge: double •  Total night minutes: double •  Total night calls: integer •  Total night charge: double •  Total intl minutes: double •  Total intl calls: integer •  Total intl charge: double •  Customer service calls: integer
  • 27.
    © 2017 MapRTechnologies Customer Churn Example •  What are we trying to predict? –  This is the Label: –  Did the customer churn? True or False •  What are the “if questions” or properties we can use to predict? –  These are the Features: –  Number of Customer service calls, Total day minutes …
  • 28.
    © 2017 MapRTechnologies Decision Trees •  Decision Tree for Classification prediction •  Represents tree with nodes •  IF THEN ELSE questions using features at each node •  Answers branch to child nodes If the number of customer service calls < 3 If the total day minutes > 200 Churned: T If the total day minutes < 200 Churned: F T Churned: T Churned: F F FF TT
  • 29.
    © 2017 MapRTechnologies Example Decision Tree
  • 30.
    © 2017 MapRTechnologies Spark ML workflow
  • 31.
    © 2017 MapRTechnologies Spark ML workflow with a Pipeline Pipeline Estimator Extract Features Load Data Train Model Estimator Data frame Transformer Cross Validate Pipeline Model TransformerTest Data frame Evaluate fit Train Load Data Evaluator Predict With model Extract Features Evaluator transform
  • 32.
    © 2017 MapRTechnologies Zeppelin Notebook with Spark Data Engineer Data Scientist
  • 33.
    © 2017 MapRTechnologies Load the data into a Dataframe: Define the Schema case class Account(state: String, len: Integer, acode: String, intlplan: String, vplan: String, numvmail: Double, tdmins: Double, tdcalls: Double, tdcharge: Double, temins: Double, tecalls: Double, techarge: Double, tnmins: Double, tncalls: Double, tncharge: Double, timins: Double, ticalls: Double, ticharge: Double, numcs: Double, churn: String) Input CSV File sample: KS,128,415,No,Yes,25,265.1,110,45.07,197.4,99,16.78,244.7,91,11.01,10.0,3,2.7,1,False OH,107,415,No,Yes,26,161.6,123,27.47,195.5,103,16.62,254.4,103,11.45,13.7,3,3.7,1,False
  • 34.
    © 2017 MapRTechnologies Data Frame Load data Load the data into a Dataset val train: Dataset[Account] = spark.read.option("inferSchema", "false") .schema(schema).csv("/user/user01/data/churn-bigml-80.csv").as[Account]
  • 35.
    © 2017 MapRTechnologies Dataset merged with Dataframe in Spark 2.0, DataFrame APIs merged with Datasets APIs
  • 36.
    © 2017 MapRTechnologies Extract the Features Image reference O’Reilly Learning Spark + + ̶+ ̶ ̶ Feature Vectors and Label Model Featurization Training Model Evaluation Best Model Label: Churned=T Features: Number customer Service calls Number day minutes Training Data Label: Churned=F Features: Number customer Service calls Number day minutes + + ̶+ ̶ ̶ + + ̶+ ̶ ̶ + + ̶+ ̶ ̶ + + ̶+ ̶ ̶
  • 37.
    © 2017 MapRTechnologies Data Frame Add column Use StringIndexer to map Strings to Numbers val ipindexer = new StringIndexer() .setInputCol("intlplan") .setOutputCol("iplanIndex”) Data Frame
  • 38.
    © 2017 MapRTechnologies Data Frame Add column Use StringIndexer to map churn True False to Numbers Val labelindexer = new StringIndexer() .setInputCol(”churn") .setOutputCol(”label”) Data Frame
  • 39.
    © 2017 MapRTechnologies Data Frame Load data Add column DataFrame + Features Use VectorAssembler to put features in vector column val featureCols = Array(”temins", "iplanIndex", "tdmins", "tdcalls”…) val assembler = new VectorAssembler() .setInputCols(featureCols) .setOutputCol("features")
  • 40.
    © 2017 MapRTechnologies Data Frame Load data transform Estimator val dTree = new DecisionTreeClassifier() .setLabelCol("label") .setFeaturesCol("features") Create DecisionTree Estimator, Set Label and Features DataFrame + Features
  • 41.
    © 2017 MapRTechnologies val pipeline = new Pipeline() .setStages(Array(ipindexer, labelindexer, assembler, dTree)) Put Feature Transformers and Estimator in Pipeline Pipeline ipIndexer feature transform assembler Dtree estimatorlabelindexer feature transform assemble Features Produce model
  • 42.
    © 2017 MapRTechnologies Spark ML workflow with a Pipeline Pipeline Transfomers Load Data estimator Train model Data frame Extract Features evaluator Pipeline Model Test Data frame evaluator Use fitted model Train Load Data fit transform
  • 43.
    © 2017 MapRTechnologies K-fold Cross-Validation Process Data Model Training/ Building Training Set Test Model Predictions Test Set data is randomly split into K partition training and test dataset pairs
  • 44.
    © 2017 MapRTechnologies K-fold Cross-Validation Process Data Model Training Training Set Test Model Predictions Test Set Train algorithm with training dataset
  • 45.
    © 2017 MapRTechnologies ML Cross-Validation Process Data Model Training Set Test Model Predictions Test Set Evaluate the model with the Test Set
  • 46.
    © 2017 MapRTechnologies K-fold Cross-Validation Process Data Model Training/ Building Training Set Test Model Predictions Test Set Train/Test loop K times Repeat K times select the Model produced by the best-performing set of parameters
  • 47.
    © 2017 MapRTechnologies Cross Validation transformation estimation pipeline Pipeline Cross Validator evaluatorParameter Grid fit Set up a CrossValidator with: •  Parameter grid •  Estimator (pipeline) •  Evaluator Perform grid search based model selection
  • 48.
    © 2017 MapRTechnologies Parameter Tuning with CrossValidator with a Paramgrid CrossValidator •  Given: –  Estimator –  Parameter grid –  Evaluator •  Find best parameters and model val paramGrid = new ParamGridBuilder() .addGrid(dTree.maxDepth, Array(2,3,4,5,6,7)).build() val evaluator= new BinaryClassificationEvaluator() .setLabelCol("label") .setRawPredictionCol("prediction") val crossval = new CrossValidator() .setEstimator(pipeline) .setEvaluator(evaluator) .setEstimatorParamMaps(paramGrid) .setNumFolds(3)
  • 49.
    © 2017 MapRTechnologies val cvModel = crossval.fit(ntrain) Cross Validator fit a model to the data Pipeline Cross Validator evaluatorParameter Grid fit Pipeline Model fit a model to the data with provided parameter grid
  • 50.
    © 2017 MapRTechnologies Evaluate the fitted model Pipeline Transfomers Load Data estimator Train model Data frame Extract Features evaluator Pipeline Model Test Data frame evaluator transform Train Load Data Predict With model Extract Features fit
  • 51.
    © 2017 MapRTechnologies fitted model Evaluate the Predictions from DecisionTree Estimator Evaluator transform Test features val predictions = cvModel.transform(test) val accuracy = evaluator.evaluate(predictions) evaluate prediction accuracy
  • 52.
    © 2017 MapRTechnologies Area under the ROC curve Accuracy is measured by the area under the ROC curve. The area measures correct classifications •  An area of 1 represents a perfect test •  an area of .5 represents a worthless test
  • 53.
    © 2017 MapRTechnologies To Learn More: •  Read about and download example code •  https://mapr.com/blog/churn-prediction-sparkml/
  • 54.
    © 2017 MapRTechnologies To Learn More: •  End to End Application for Monitoring Uber Data using Spark ML •  https://mapr.com/blog/monitoring-real-time-uber-data-using-spark-machine- learning-streaming-and-kafka-api-part-1/
  • 55.
    © 2017 MapRTechnologies To Learn More: •  MapR Free ODT http://learn.mapr.com/
  • 56.
    © 2017 MapRTechnologies For Q&A : •  https://community.mapr.com/ •  https://community.mapr.com/community/answers/pages/qa
  • 57.
    © 2017 MapRTechnologies Open Source Engines & Tools Commercial Engines & Applications Enterprise-Grade Platform Services DataProcessing Web-Scale Storage MapR-XD MapR-DB Search and Others Real Time Unified Security Multi-tenancy Disaster Recovery Global NamespaceHigh Availability MapR Streams Cloud and Managed Services Search and Others UnifiedManagementandMonitoring Search and Others Event StreamingDatabase Custom Apps MapR Converged Data Platform HDFS API POSIX, NFS Kakfa APIHBase API OJAI API
  • 58.
    © 2017 MapRTechnologies Q&A ENGAGE WITH US
