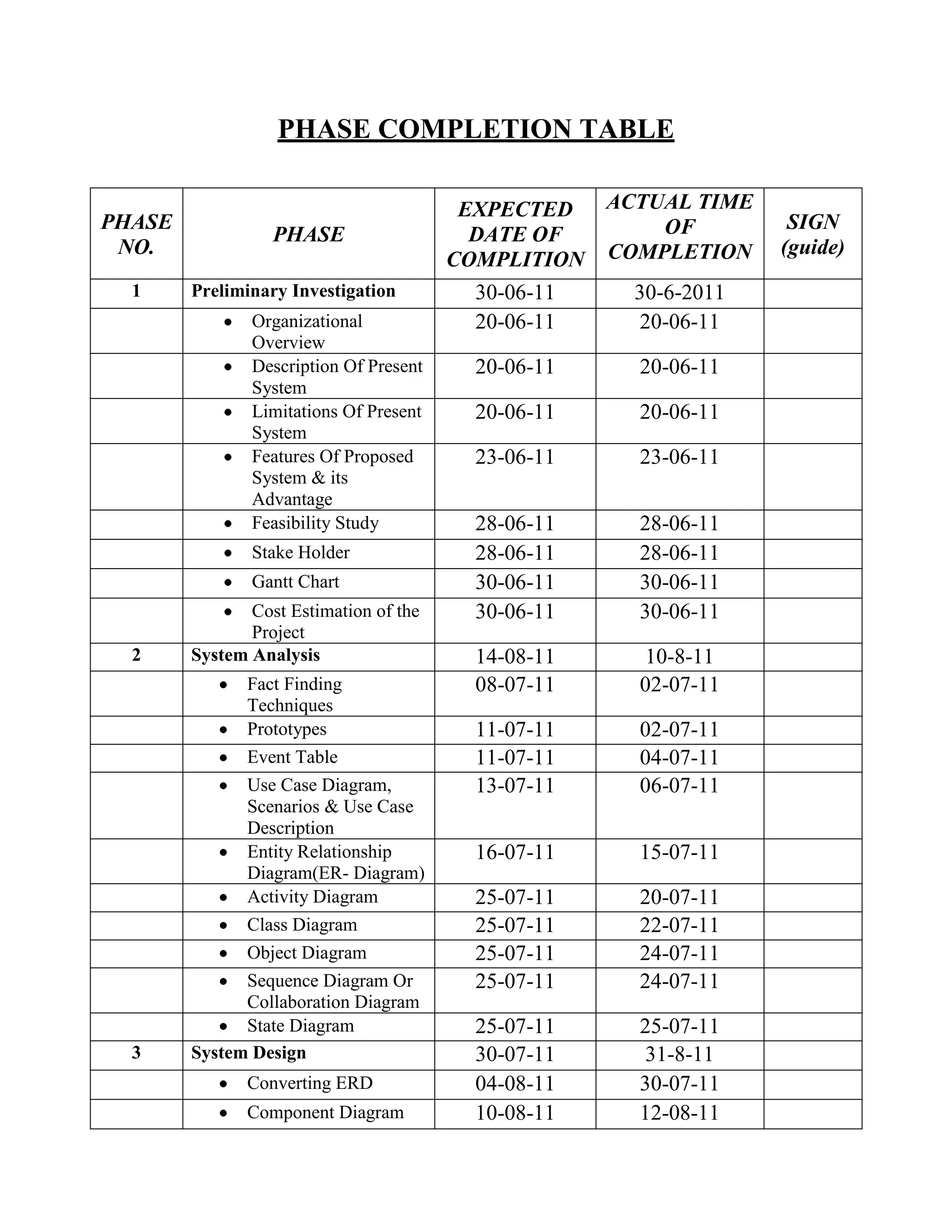

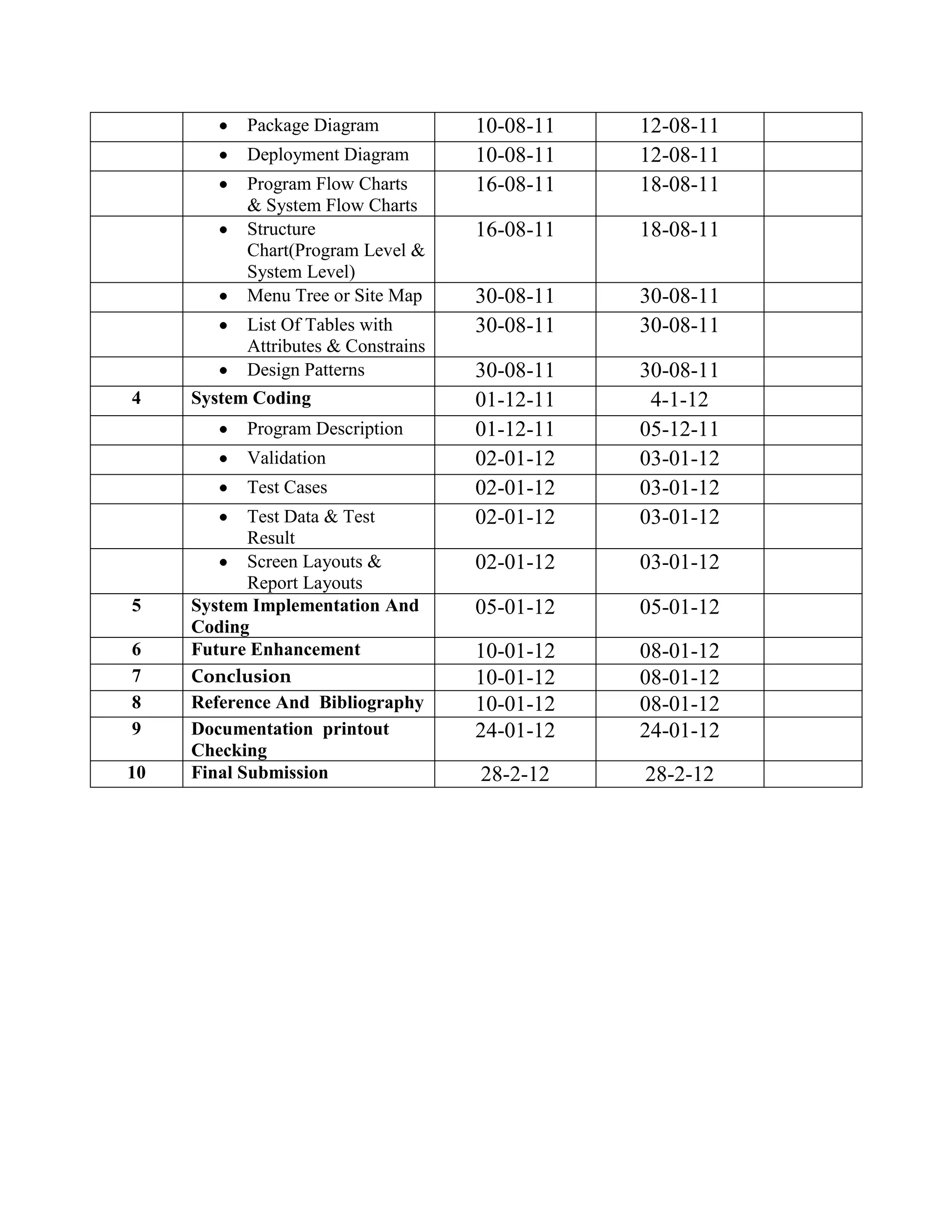

The document outlines a 10 phase project completion table detailing the expected and actual dates of completion for each phase of a project. Phase 1 involved preliminary investigation and was completed as expected by June 30, 2011. Phase 2 was system analysis and was completed earlier than the August 14, 2011 expected date. Phase 3 was system design and ran over the expected July 30, 2011 completion date, finishing on August 31, 2011. Phases 4 through 10 involved system coding, implementation, enhancements, documentation, and final submission, with most phases completing close to or on expected dates.
