Implementing a cloud-based library
management and search system –
the WMS and WCL case at Tilburg
University
Jola G.B. Prinsen, project manager Library & IT Services
Before we start…

• Lecture about implementation project
    • No WMS/WCL demo
    • No focus on the WMS/WCL systems
• Tilburg University Library is an early adopter, no comparable WMS
  libraries yet
• Tilburg University Library is not a standard library
    • Tradition of innovation
    • Many in-house developed, customized systems
    • Local databases




                                                                      2
Contents

• Cloud computing
• Selection process
• Implementation project
   • Analysis phase
   • WCL implementation phase
• Lessons learned
• Recommended reading




                                3
Cloud computing




Ticer summer school   22 August 2012   4

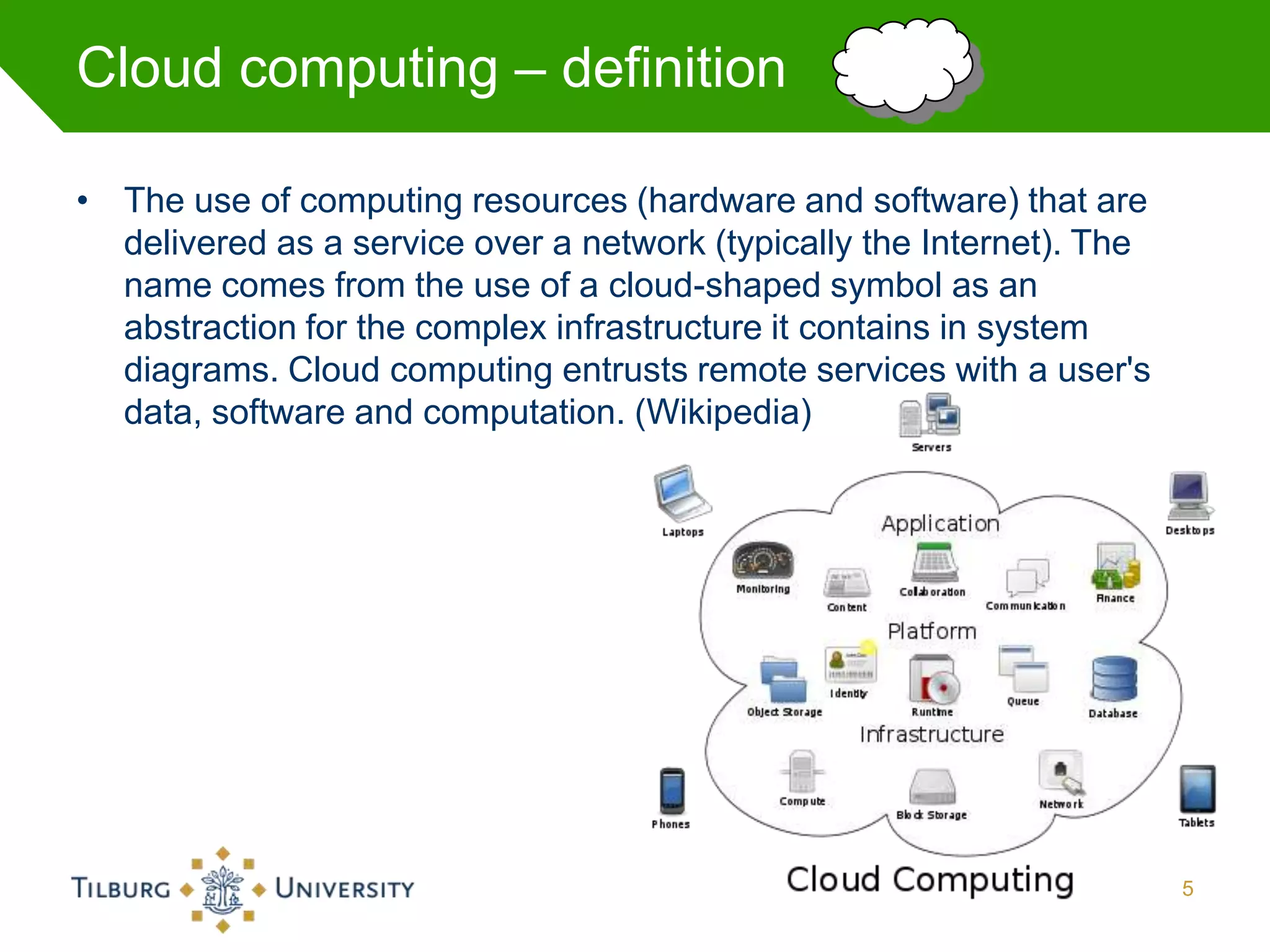

Cloud computing – definition

• The use of computing resources (hardware and software) that are
  delivered as a service over a network (typically the Internet). The
  name comes from the use of a cloud-shaped symbol as an
  abstraction for the complex infrastructure it contains in system
  diagrams. Cloud computing entrusts remote services with a user's
  data, software and computation. (Wikipedia)




                                                                        5
Examples – End-user/discovery services

• Union catalogues




                            GGC


• Discovery services




                                         6

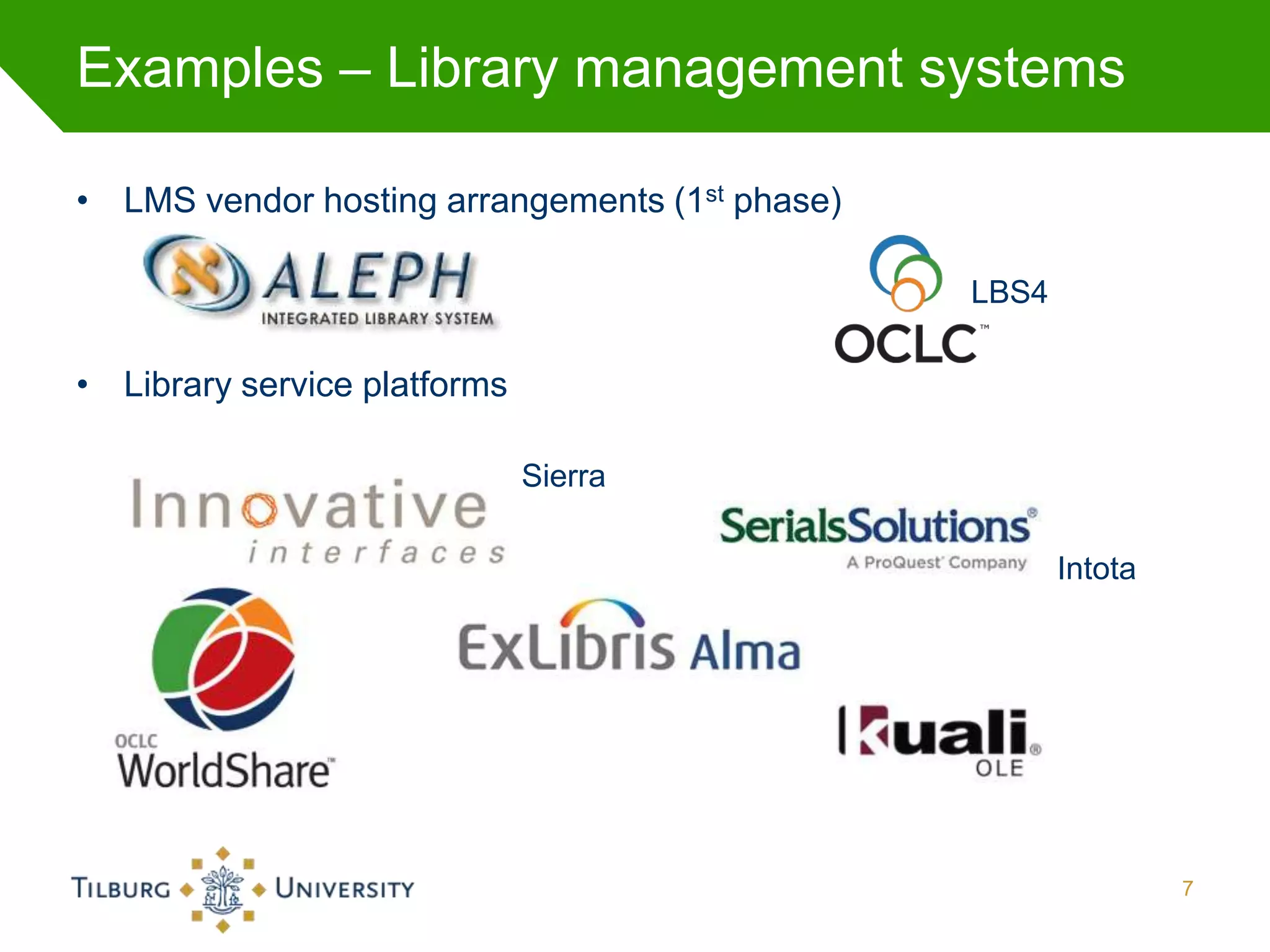

Examples – Library management systems

• LMS vendor hosting arrangements (1st phase)

                                                LBS4

• Library service platforms

                              Sierra

                                                       Intota




                                                                7
Do you use / consider
 a cloud-based LMS?




                   8

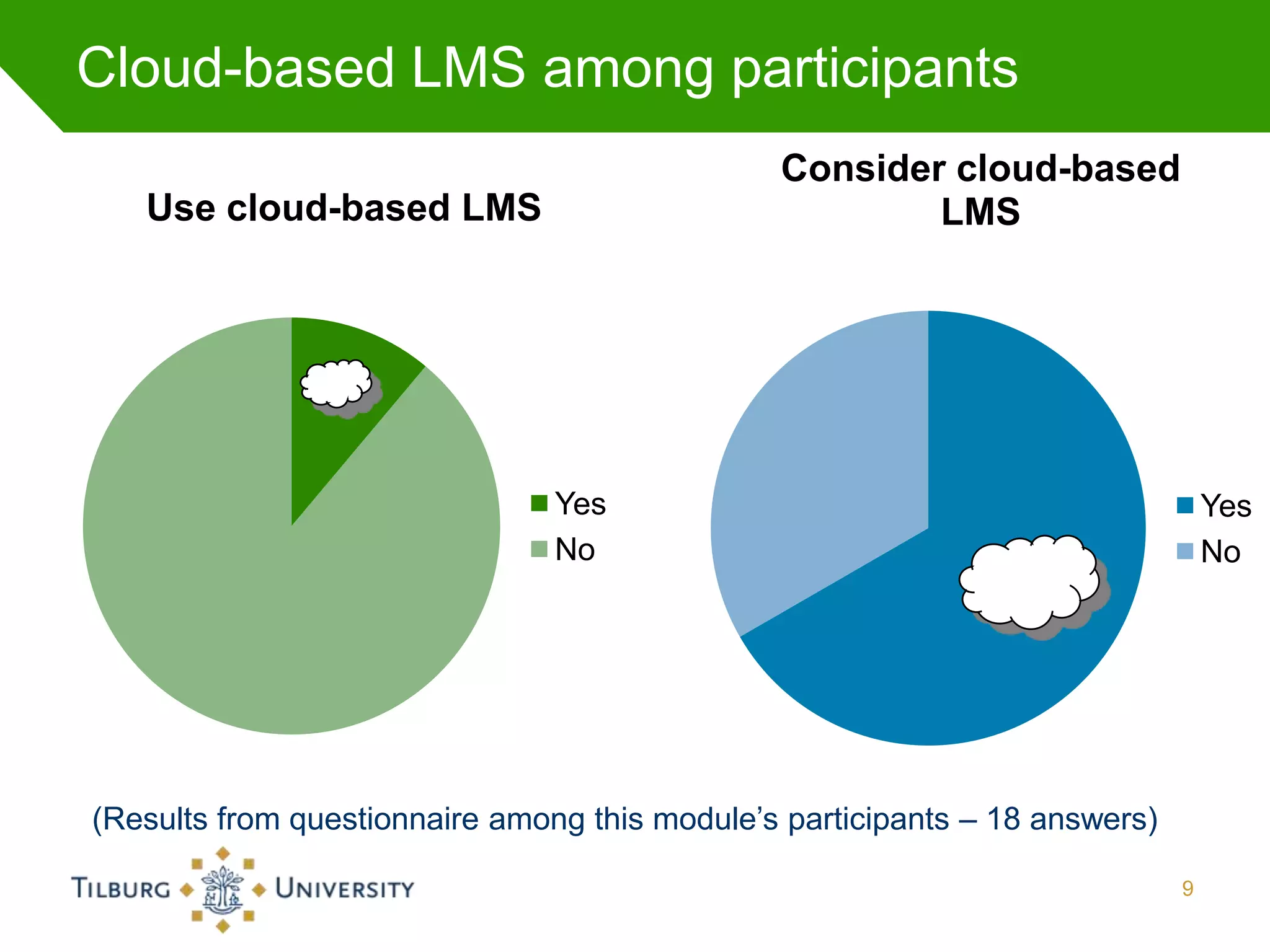

Cloud-based LMS among participants
                                               Consider cloud-based
   Use cloud-based LMS                                 LMS




                                Yes                                              Yes
                                No                                               No




(Results from questionnaire among this module’s participants – 18 answers)

                                                                             9
What worries you about
 cloud computing?




                   10

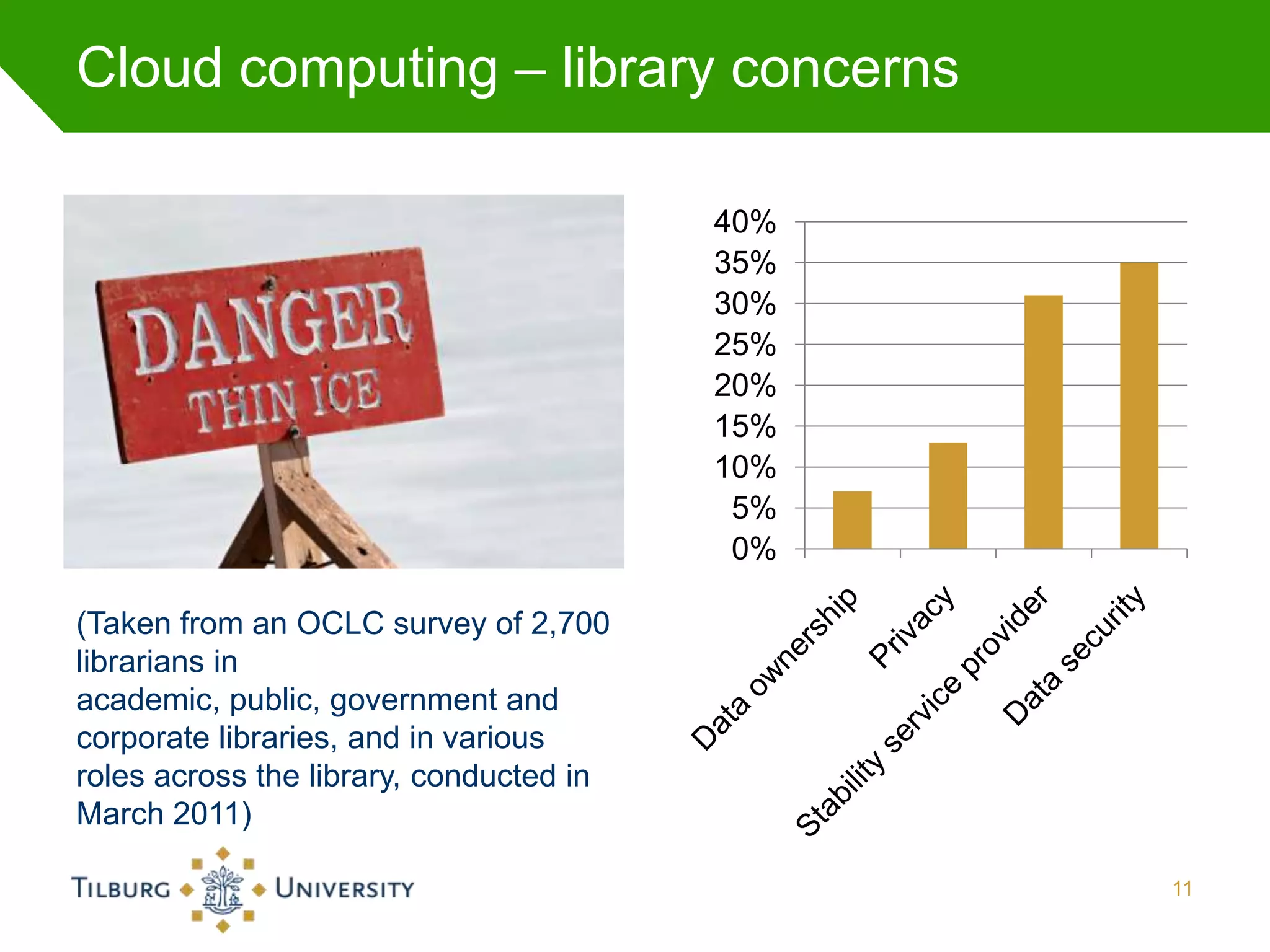

Cloud computing – library concerns

                                         40%
                                         35%
                                         30%
                                         25%
                                         20%
                                         15%
                                         10%
                                          5%
                                          0%

(Taken from an OCLC survey of 2,700
librarians in
academic, public, government and
corporate libraries, and in various
roles across the library, conducted in
March 2011)

                                               11
How TiU covered risks (1)

• Bibliographic data
   • Ownership (also after
     termination of contract)
     arranged in contract
   • GGC and local databases
     are backup
• Personal data
   • No staff or end-user data to
     be stored in the US
   • Contract
   • Encryption and security
     requirements

                                    12
How TiU covered risks (2)

• Reliability and stability
    • Trustworthy provider
    • Service Level Agreement
• Openness
    • APIs on Open Platform
• Changes to service
    • Roadmap, fixed release
      dates, release notes
    • Take the service as it is




                                  13
What advantages do
 you see?




                 14

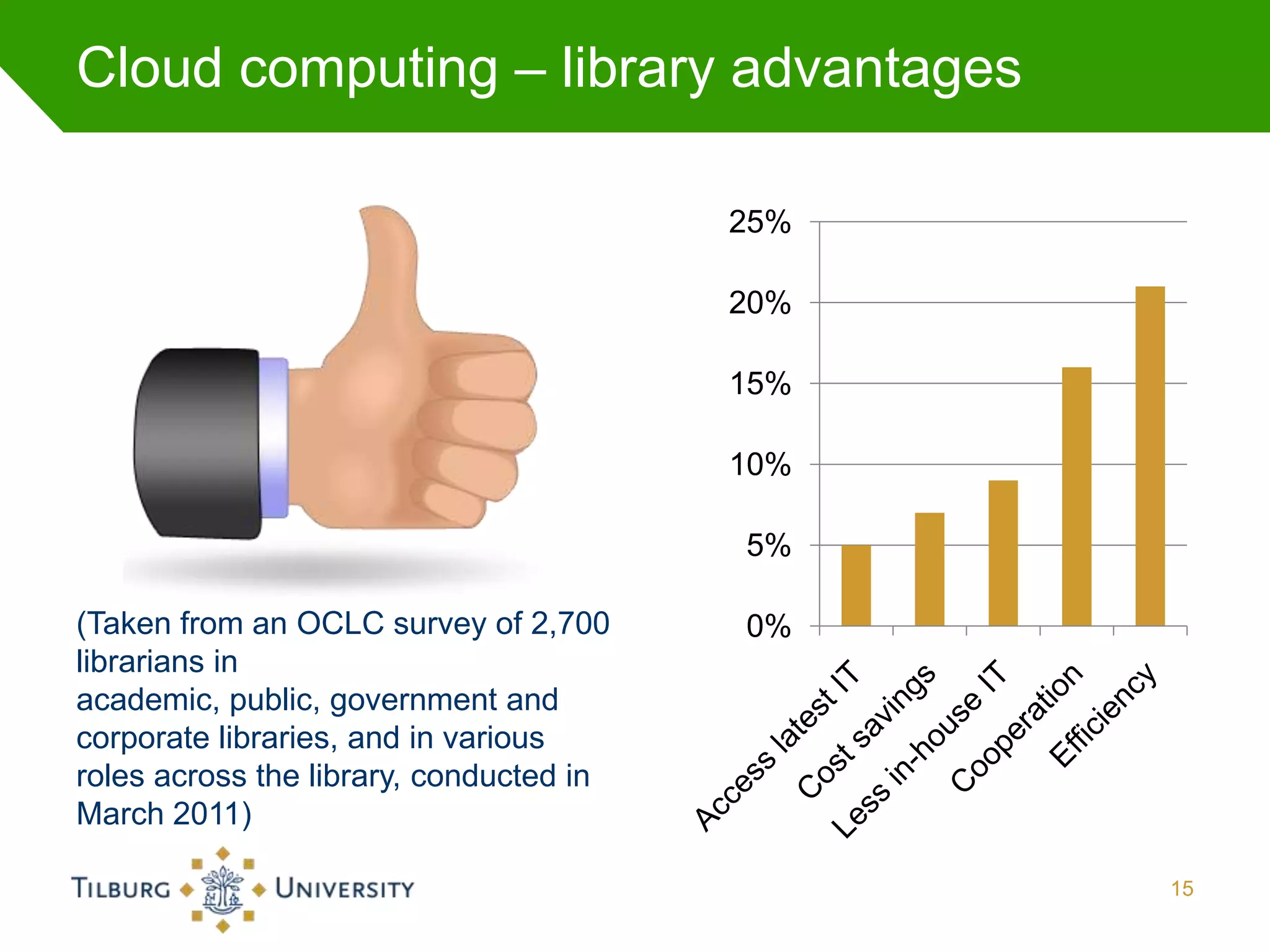

Cloud computing – library advantages

                                         25%

                                         20%

                                         15%

                                         10%

                                         5%

(Taken from an OCLC survey of 2,700      0%
librarians in
academic, public, government and
corporate libraries, and in various
roles across the library, conducted in
March 2011)

                                               15
Selection process




Ticer summer school   22 August 2012   16

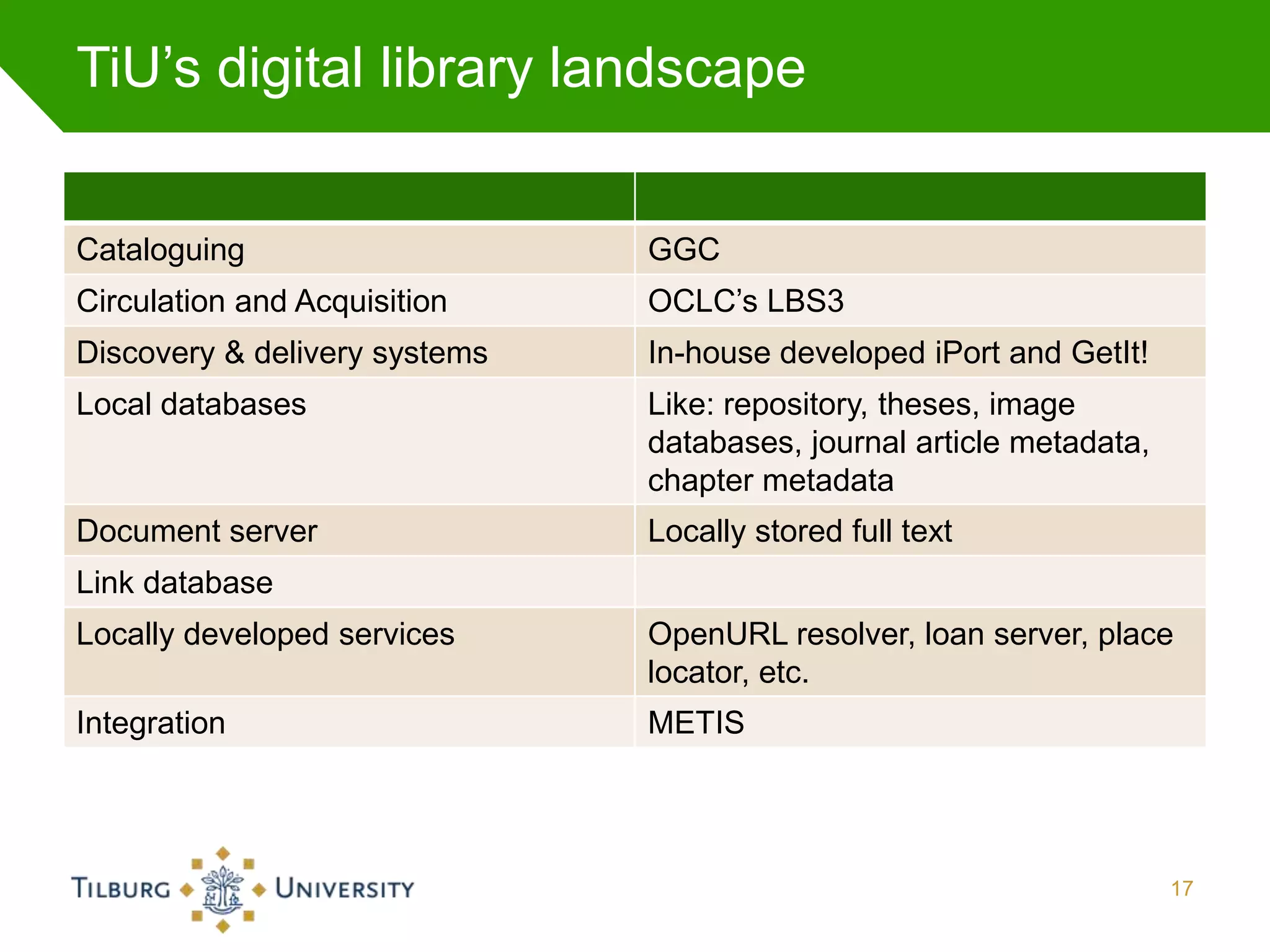

TiU’s digital library landscape


Cataloguing                    GGC
Circulation and Acquisition    OCLC’s LBS3
Discovery & delivery systems   In-house developed iPort and GetIt!
Local databases                Like: repository, theses, image
                               databases, journal article metadata,
                               chapter metadata
Document server                Locally stored full text
Link database
Locally developed services     OpenURL resolver, loan server, place
                               locator, etc.
Integration                    METIS




                                                                      17
Complex landscape…




                     22-8-2012   18
Rationale for new LMS / discovery service

• Hardware – outdated, unstable and no longer supported
• Library system – outdated and no longer supported as from
  1/1/2013 onwards
• In-house developed discovery & delivery system – unable to keep
  up with developments
• Digital library landscape – complex
• Maintaining same service level – with less IT staff
• Increasing pressure to reduce costs



                     Off-the-shelf           Innovation



                                                                    19

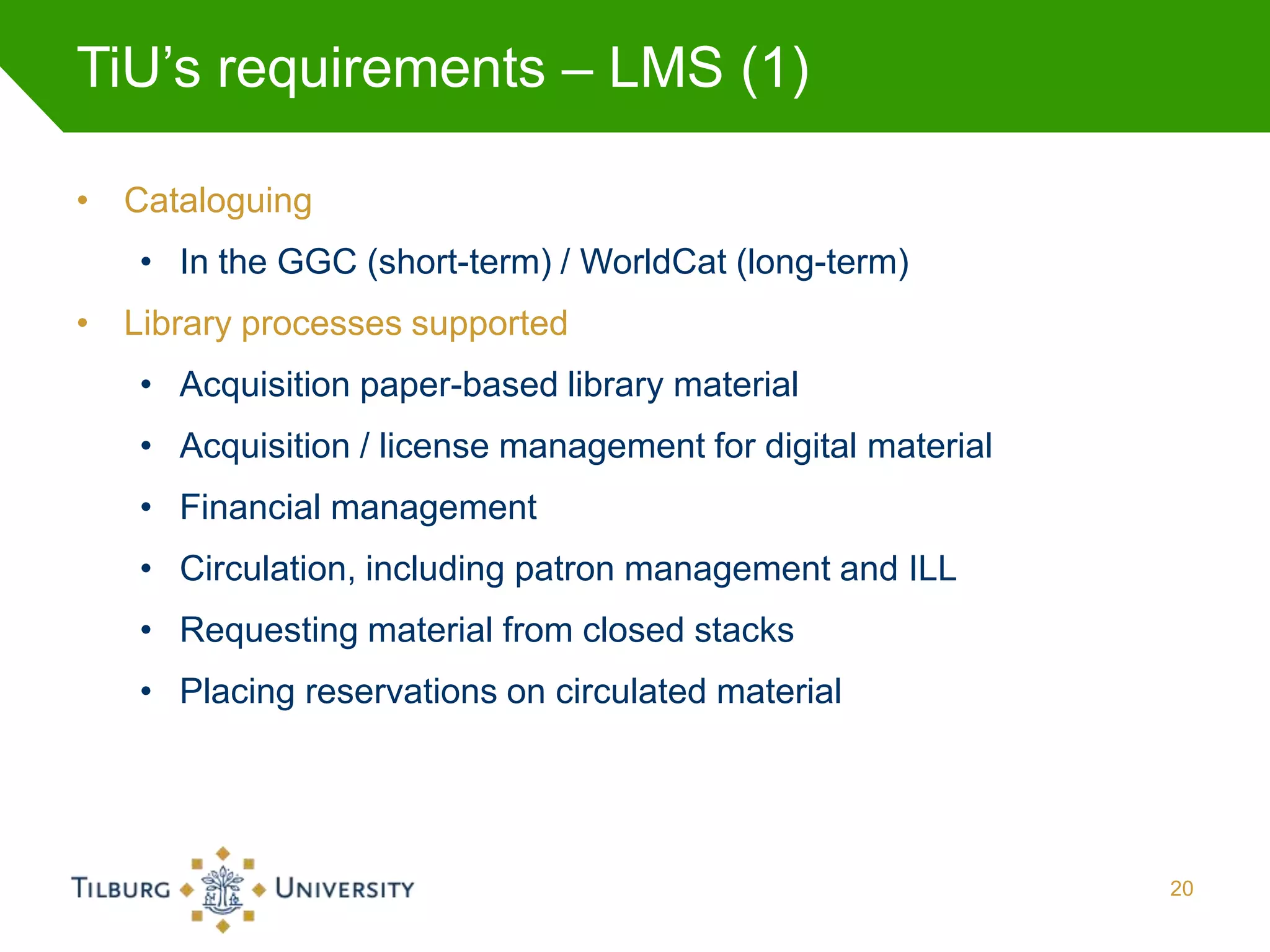

TiU’s requirements – LMS (1)

• Cataloguing
   • In the GGC (short-term) / WorldCat (long-term)
• Library processes supported
   • Acquisition paper-based library material
   • Acquisition / license management for digital material
   • Financial management
   • Circulation, including patron management and ILL
   • Requesting material from closed stacks
   • Placing reservations on circulated material




                                                             20

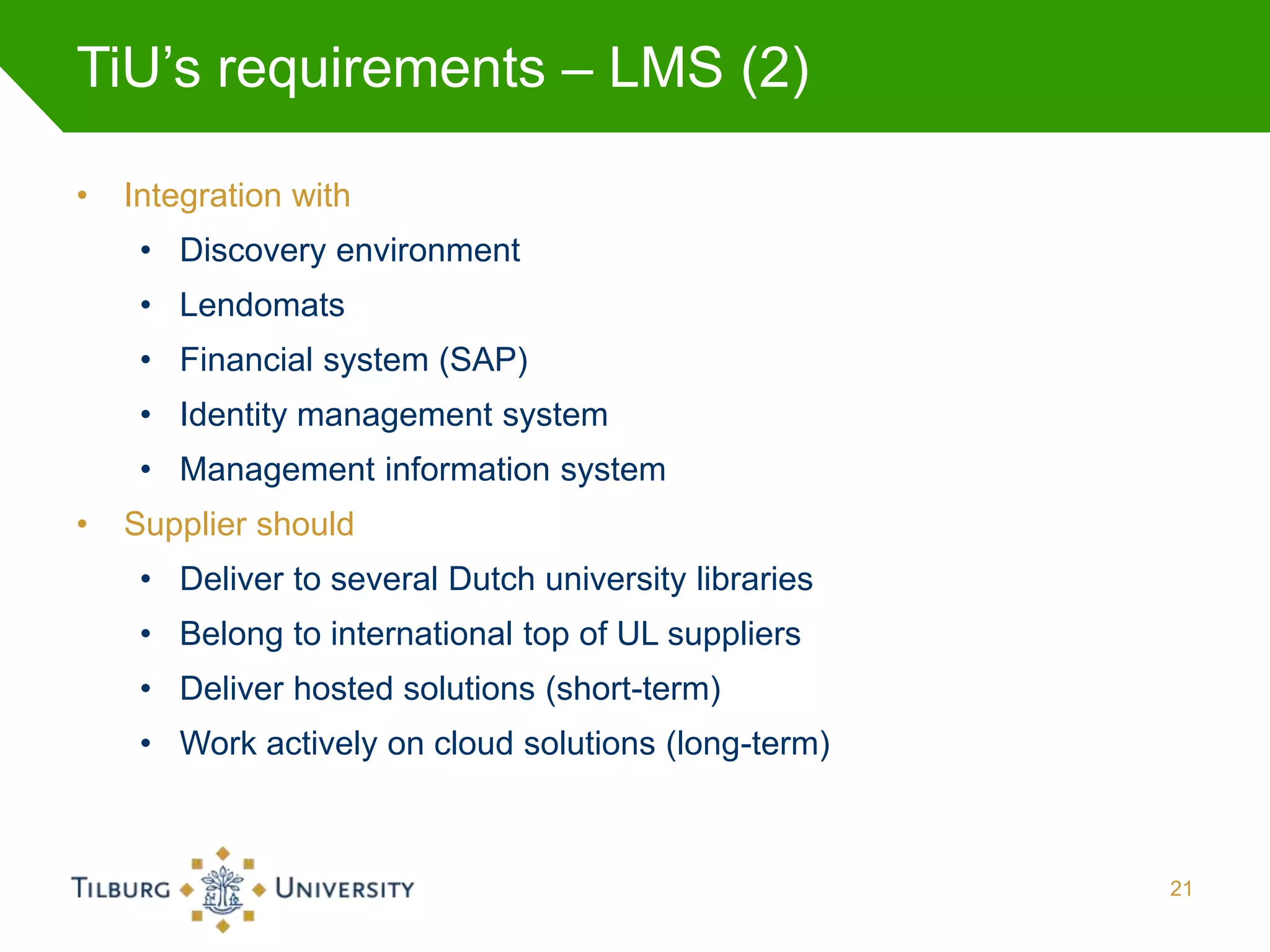

TiU’s requirements – LMS (2)

•   Integration with
     • Discovery environment
     • Lendomats
     • Financial system (SAP)
     • Identity management system
     • Management information system
•   Supplier should
     • Deliver to several Dutch university libraries
     • Belong to international top of UL suppliers
     • Deliver hosted solutions (short-term)
     • Work actively on cloud solutions (long-term)



                                                       21
TiU’s requirements – Discovery service

• Most important
   • Excellent integration with LMS
• Besides that
   • Integration of local content
   • Discovery service open for all
   • Public content available to all; licensed material after log in
   • Well-developed API service for integration with local services
   • Good coverage and continued effort to improve
   • Service also used by other Dutch university libraries




                                                                       22

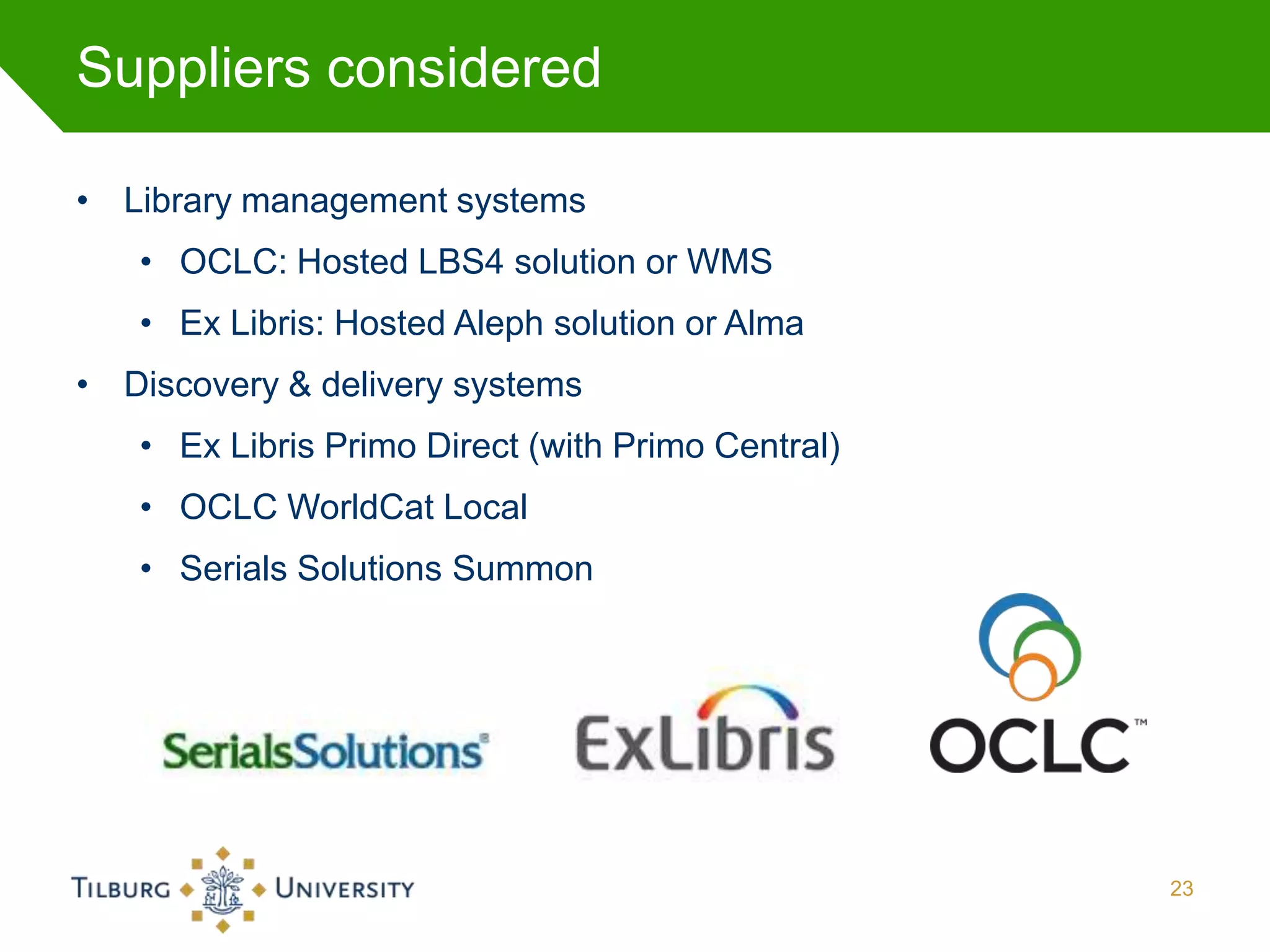

Suppliers considered

• Library management systems
   • OCLC: Hosted LBS4 solution or WMS
   • Ex Libris: Hosted Aleph solution or Alma
• Discovery & delivery systems
   • Ex Libris Primo Direct (with Primo Central)
   • OCLC WorldCat Local
   • Serials Solutions Summon




                                                   23

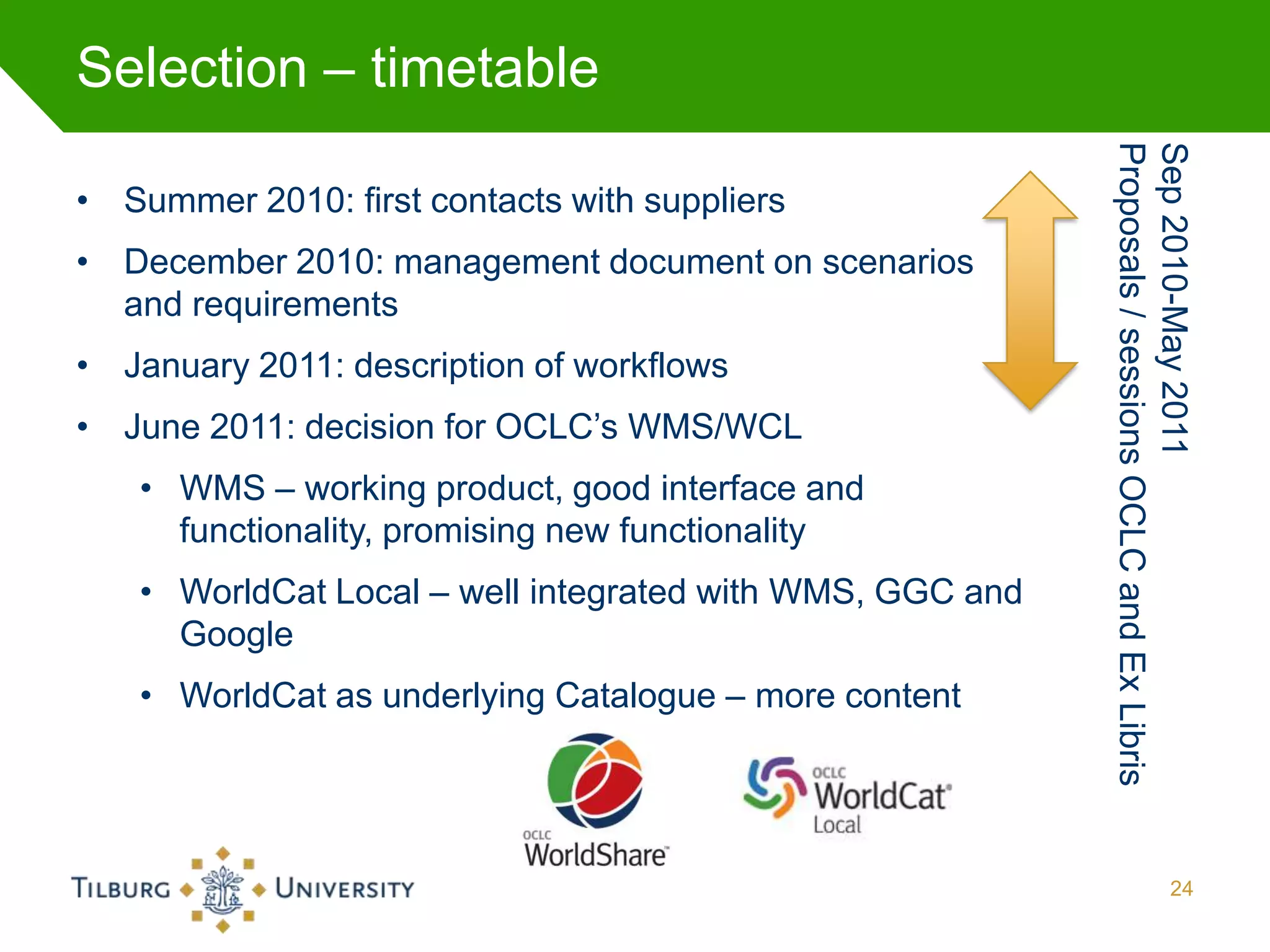

Selection – timetable




                                                          Proposals / sessions OCLC and Ex Libris
                                                          Sep 2010-May 2011
• Summer 2010: first contacts with suppliers
• December 2010: management document on scenarios
  and requirements
• January 2011: description of workflows
• June 2011: decision for OCLC’s WMS/WCL
   • WMS – working product, good interface and
     functionality, promising new functionality
   • WorldCat Local – well integrated with WMS, GGC and
     Google
   • WorldCat as underlying Catalogue – more content




                                                                                       24
Implementation project




Ticer summer school   22 August 2012   25

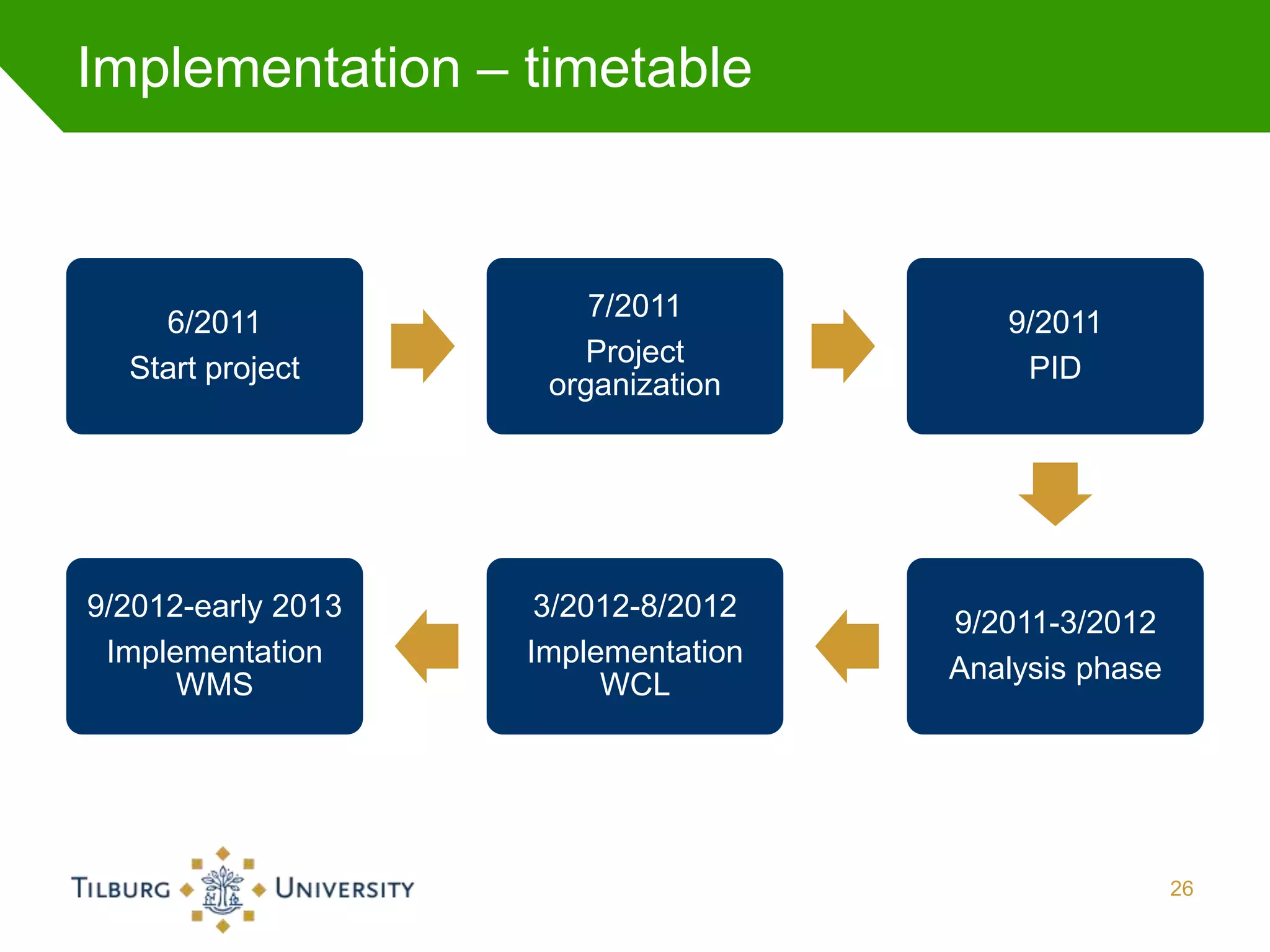

Implementation – timetable



                        7/2011
    6/2011                              9/2011
                       Project
  Start project                          PID
                     organization




9/2012-early 2013    3/2012-8/2012
                                     9/2011-3/2012
 Implementation     Implementation
                                     Analysis phase
      WMS                WCL




                                                      26
Business case

• LBS3: end-of-life, too costly, too much of a risk
• GetIt!: cannot keep up with developments
• Simplify our library systems landscape for unchanged service fee
• Saving costs and no future costs for mandatory upgrades and
  migrations
• Functionality for TiU’s customers will grow
• Functionality for our library staff will grow




                                                                     27
Project aims




                                      Functional
               Implementation       requirements
                    WCL




                      Implementation WMS




                                                   28

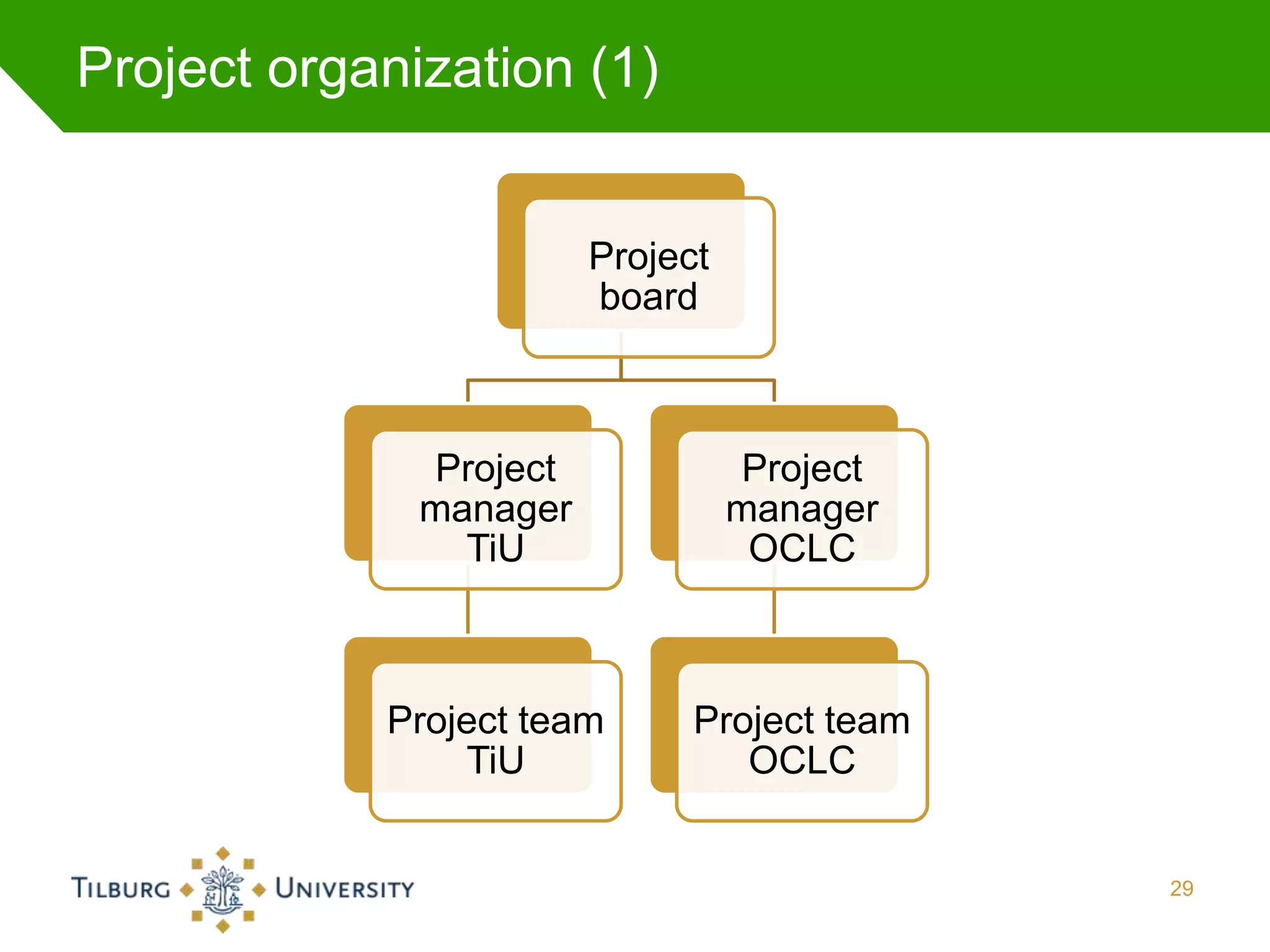

Project organization (1)


                        Project
                        board



              Project             Project
              manager             manager
                TiU                OCLC



            Project team      Project team
                TiU              OCLC


                                             29
Project organization (2)

•   Project board
     • Director TiU LIS
     • Director OCLC Leiden
     • Manager TiU LIS, Academic
       Support
•   TiU project team
     • Head acquisition and
       cataloguing
     • Head circulation
     • IT specialist LBS3
     • IT specialist local databases
     • Future functional managers
       WMS/WCL
     • Technical project manager (IDM
       matters)


                                        30
Analysis phase




Ticer summer school   22 August 2012   31

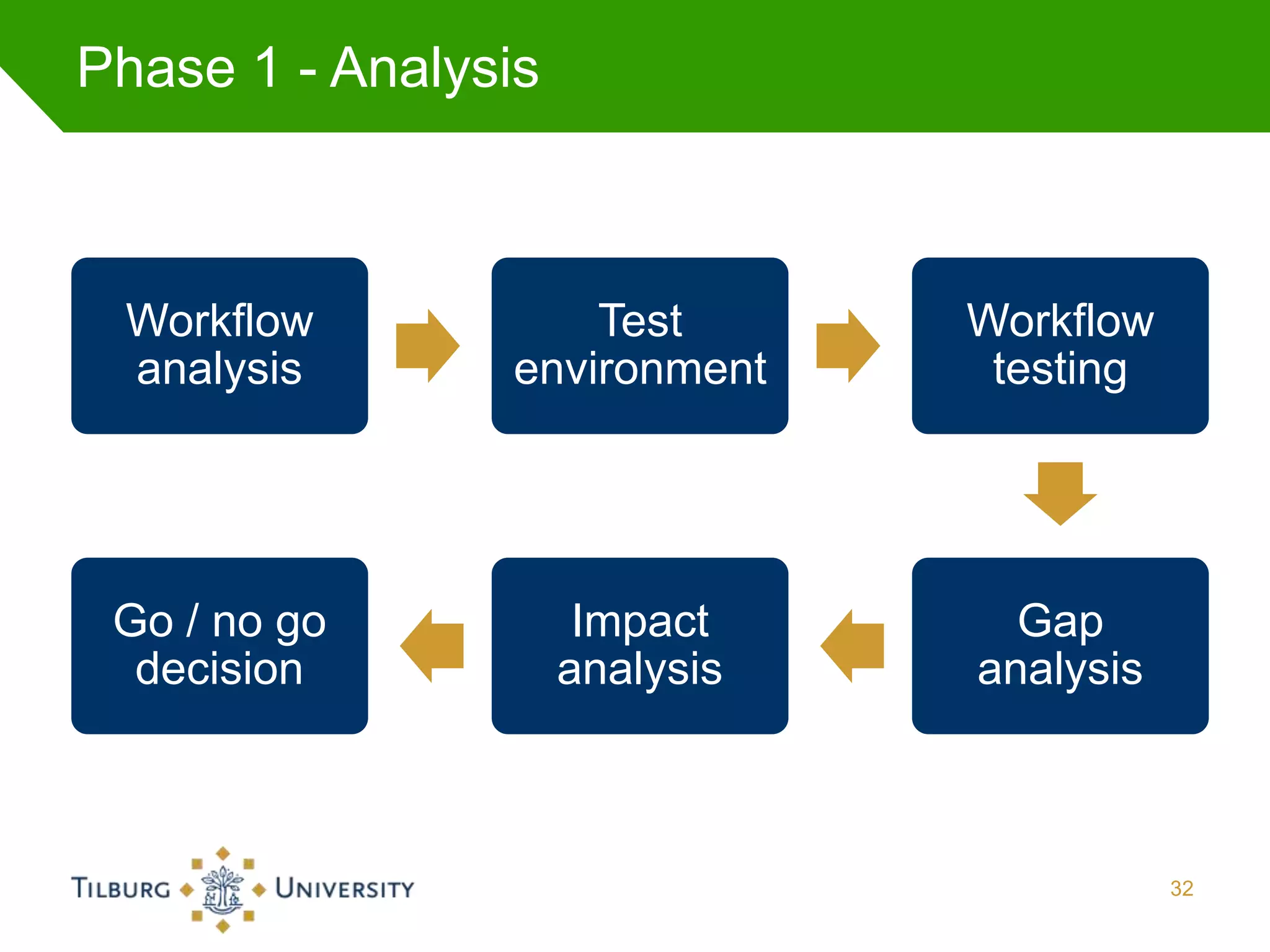

Phase 1 - Analysis



 Workflow           Test        Workflow
 analysis       environment      testing




 Go / no go           Impact      Gap
  decision           analysis   analysis



                                           32
Workflow analysis

• Acquisition
• Circulation
• Discovery & delivery
• Management information
• 3rd party integration
    • Financial information (SAP)
    • Lendomats (SIP2)
    • Identity management (TiU’s IDM)




                                        33

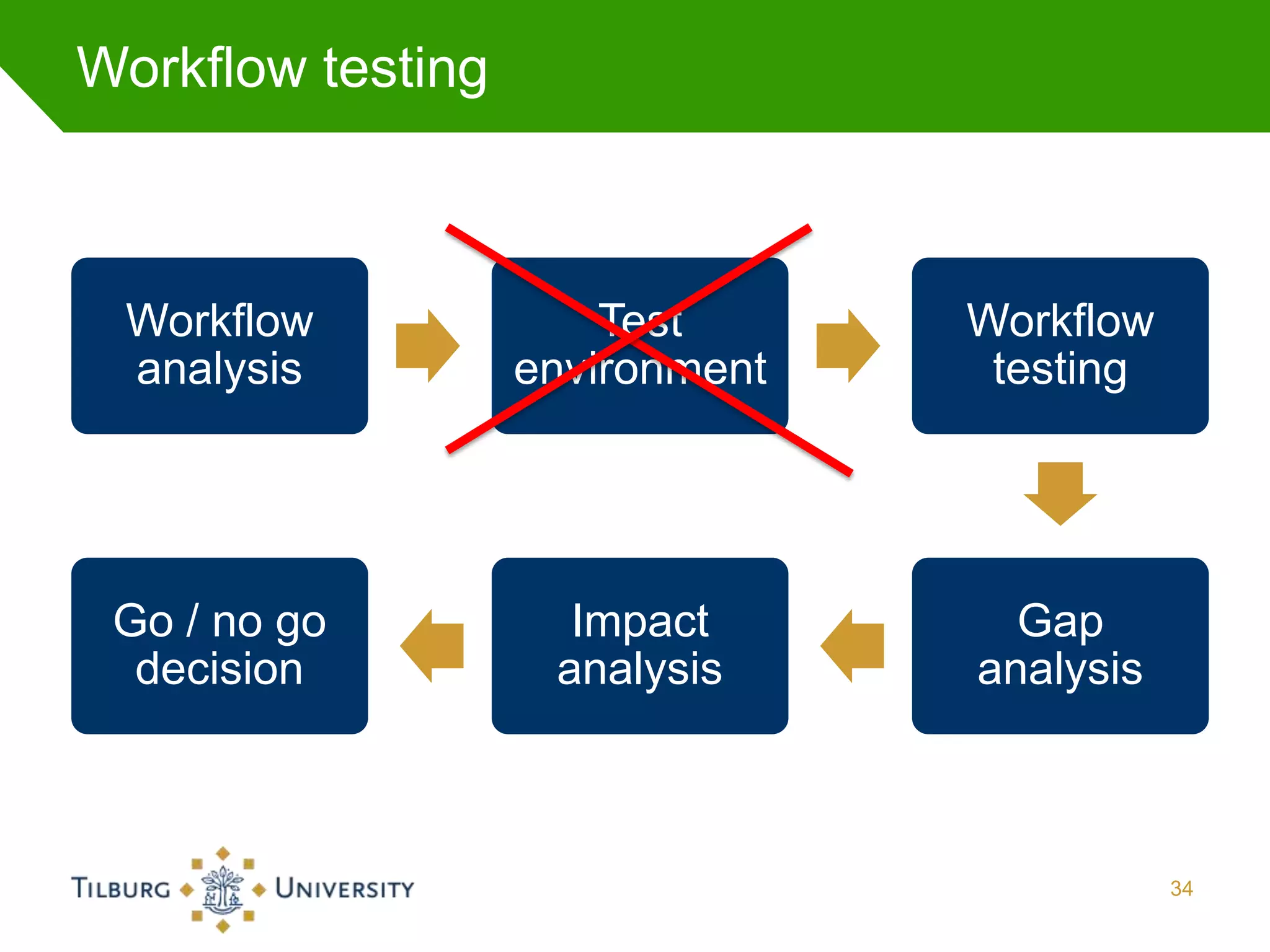

Workflow testing



 Workflow              Test      Workflow
 analysis          environment    testing




 Go / no go          Impact        Gap
  decision          analysis     analysis



                                            34

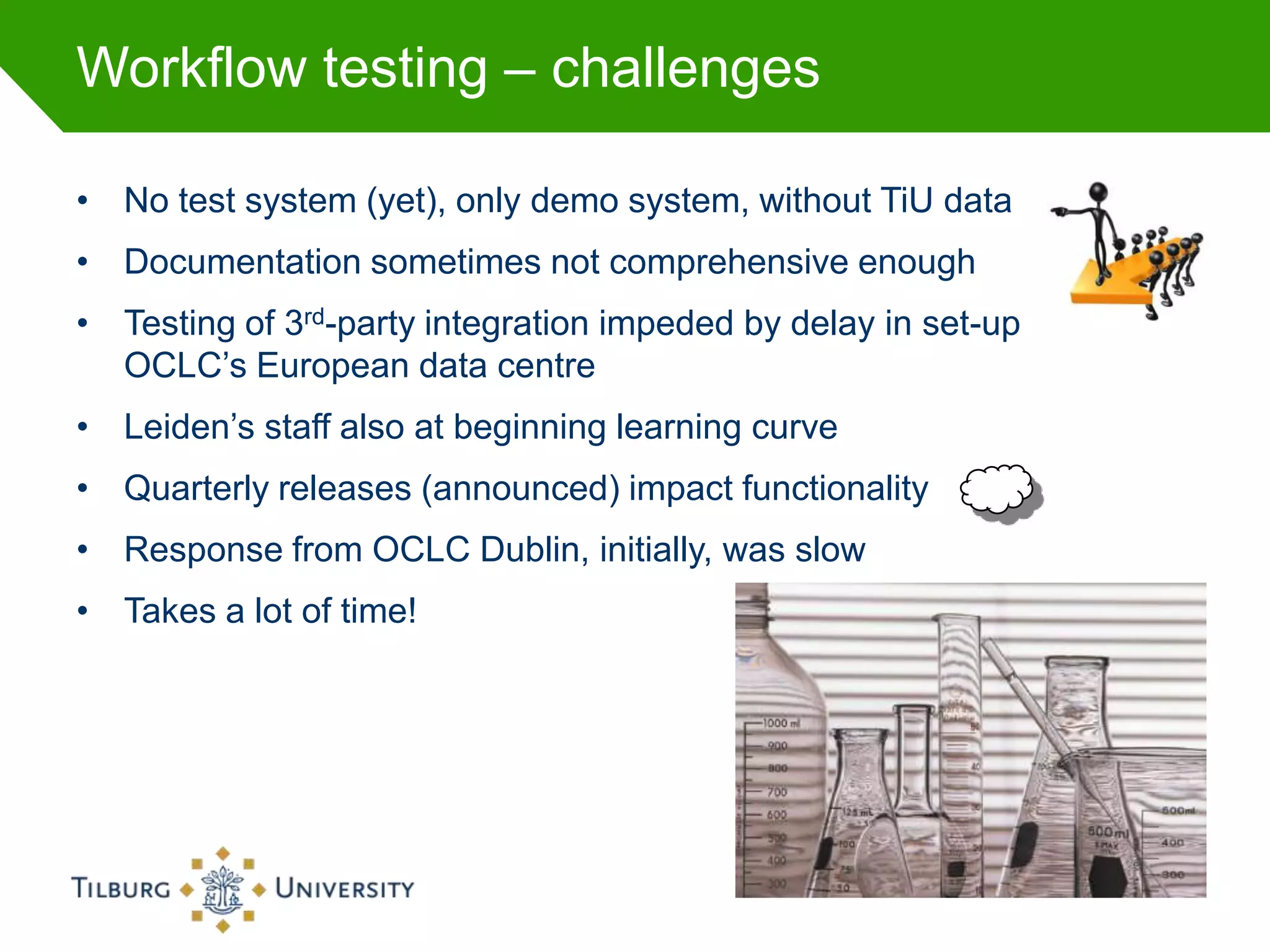

Workflow testing – challenges

• No test system (yet), only demo system, without TiU data
• Documentation sometimes not comprehensive enough
• Testing of 3rd-party integration impeded by delay in set-up
  OCLC’s European data centre
• Leiden’s staff also at beginning learning curve
• Quarterly releases (announced) impact functionality
• Response from OCLC Dublin, initially, was slow
• Takes a lot of time!
Gap and impact analysis

• Gap analysis
   • Gaps between current functionality and WMS/WCL functionality
• Impact analysis
   • Impact on stakeholders (where possible quantified)
   • Workaround? Effort involved
   • Priority (must have, need to have, nice to have)
   • Solution on OCLC’s roadmap?




                                                                    36

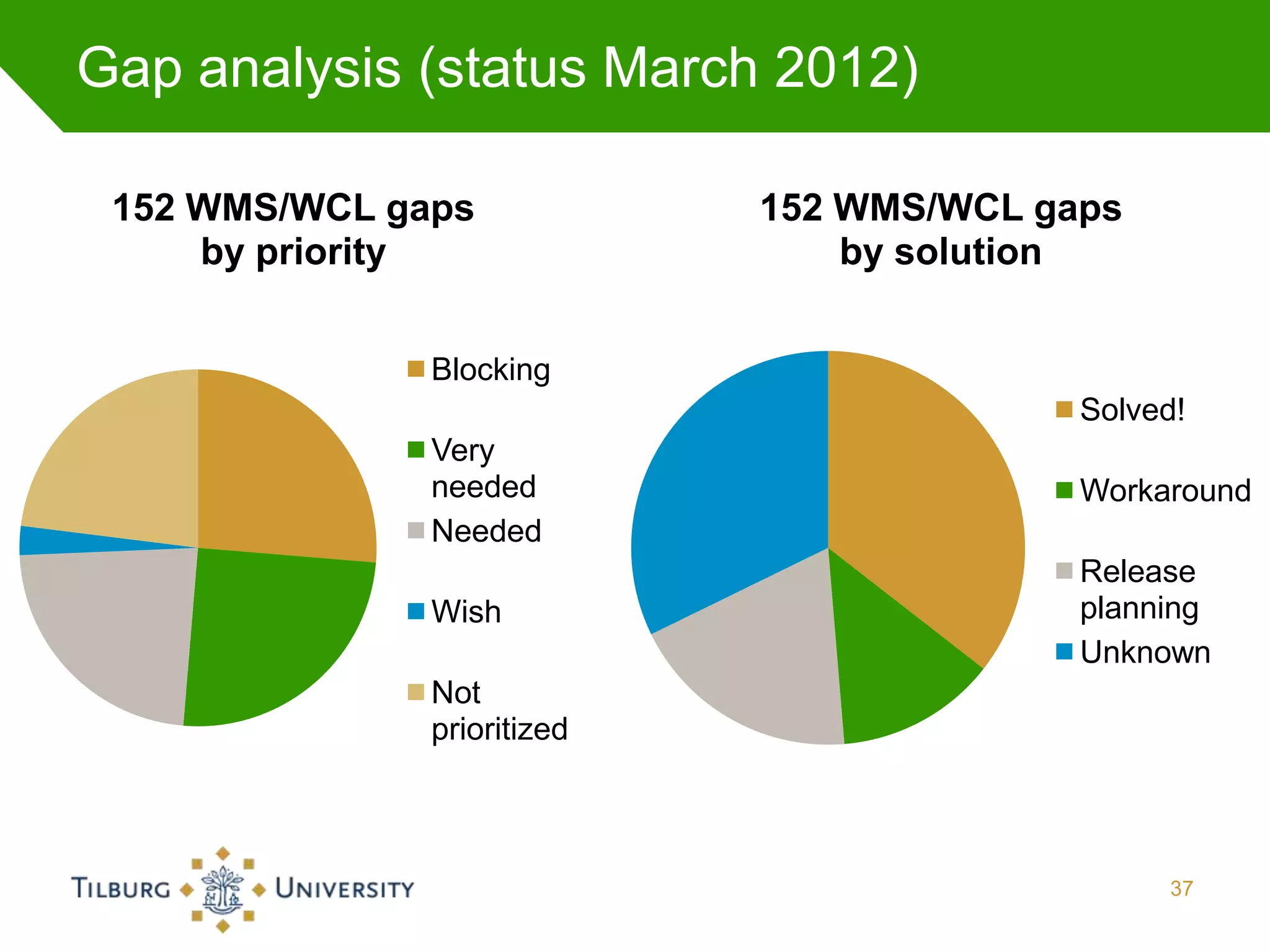

Gap analysis (status March 2012)

 152 WMS/WCL gaps            152 WMS/WCL gaps
     by priority                 by solution


               Blocking
                                           Solved!
               Very
               needed                      Workaround
               Needed
                                           Release
               Wish                        planning
                                           Unknown
               Not
               prioritized



                                                37
Also benefits

• WMS
  • Circulation: more intuitive and user-friendly interface
  • Acquisition: potential improvement of financial process
• WCL
  • More content
  • Social media functionality
  • Lists functionality
  • Integration with Google Books / Google Scholar
  • Exporting titles
  • Mobile platform
  • Chinese interface
                          http://www.tilburguniversity.edu/about-tilburg-university/library/wcl/

                                                                                                   38
Reaction

• Early adopter
   • Discovering gaps was
     part of the project
• Knew we had to adapt
   • Off-the-shelf system
     replaces in-house
     developed customized
     system




                            39
WMS  No go

• Business case not (yet) valid
   • Hosting of TiU’s LBS3
   • Visit OCLC Dublin, OH
   • Await new releases
• Confidence in OCLC
• Back-office system
   • Go live possible throughout
     academic year


 Remain in analysis phase



                                   40
WMS analysis continued – visit Dublin

• All gaps discussed
• More effective
  communication
• Increased understanding
• Jointly thinking about
  possible solutions
• Changes in release
  planning
• TiU’s requirements match
  those of comparable other
  WMS libraries

                                        41
WCL  Go!

• End-user service
    • Go live only possible at
      beginning academic year
• Condition: availability info
  (from LBS3) can be made
  available in WCL




 Start of implementation phase




                                  42
WCL implementation
                phase




Ticer summer school   22 August 2012   43

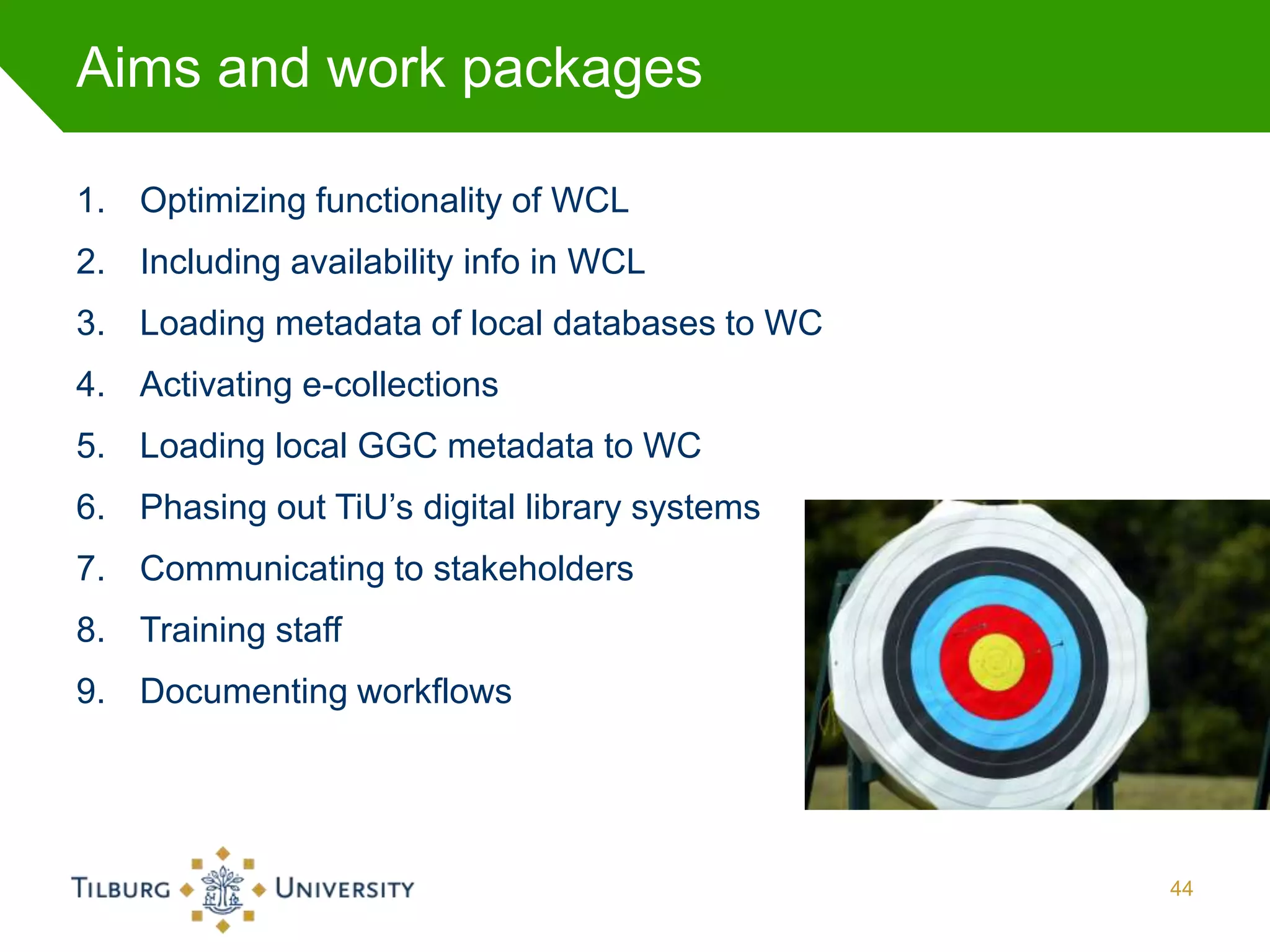

Aims and work packages

1. Optimizing functionality of WCL
2. Including availability info in WCL
3. Loading metadata of local databases to WC
4. Activating e-collections
5. Loading local GGC metadata to WC
6. Phasing out TiU’s digital library systems
7. Communicating to stakeholders
8. Training staff
9. Documenting workflows




                                               44

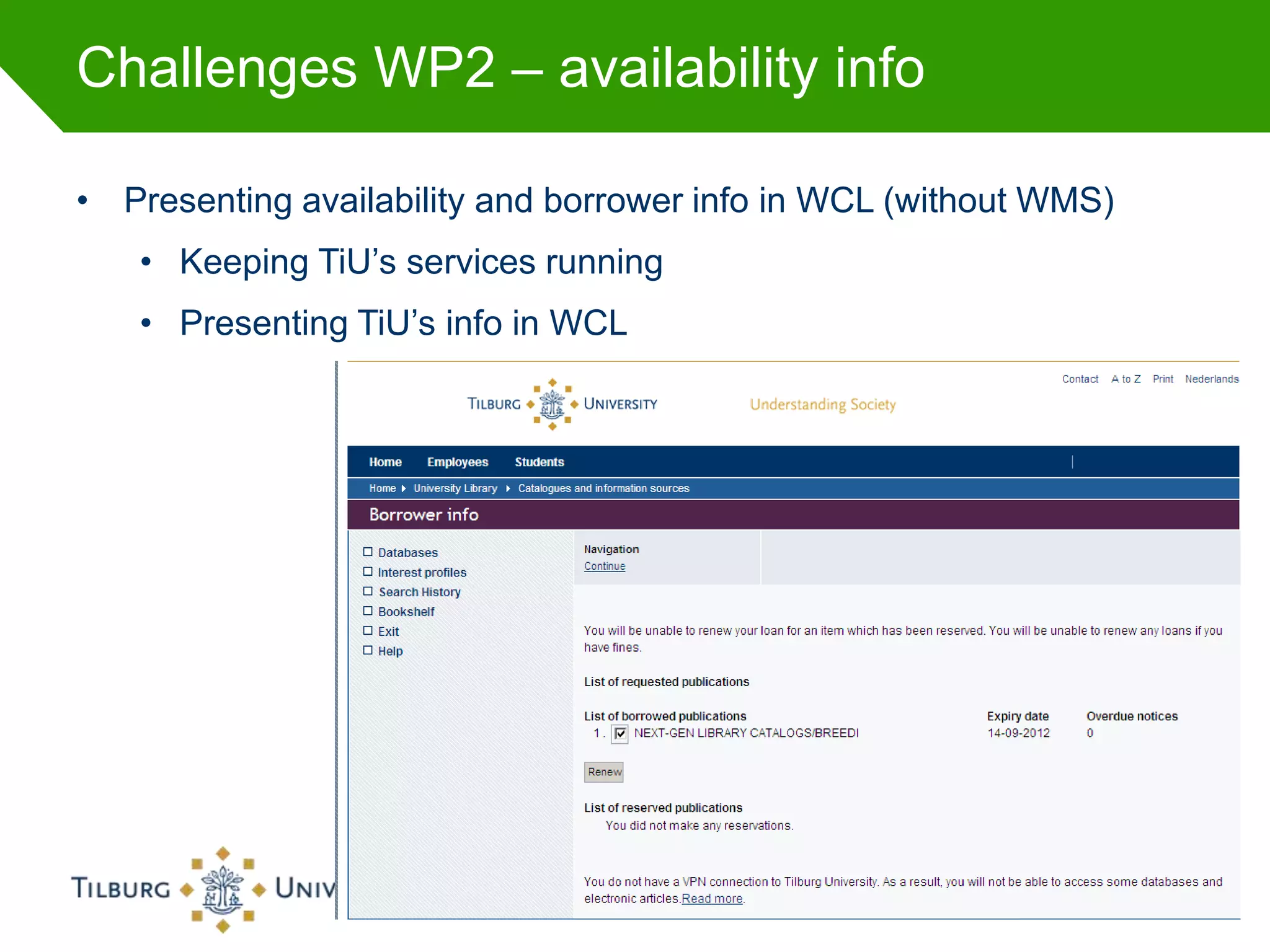

Challenges WP2 – availability info

• Presenting availability and borrower info in WCL (without WMS)
   • Keeping TiU’s services running
   • Presenting TiU’s info in WCL




                        Titelpresentatie in Footer   22-8-2012     45

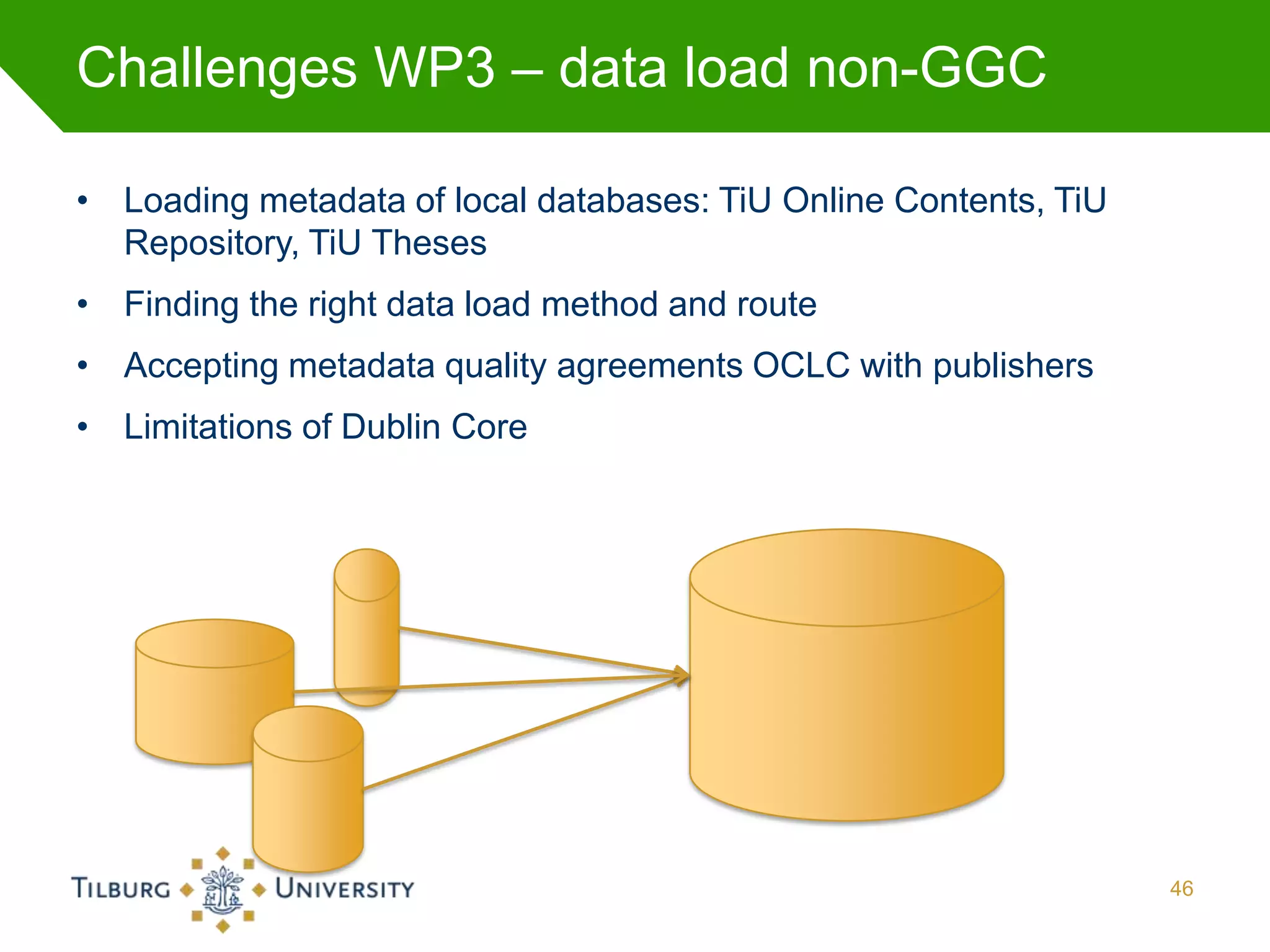

Challenges WP3 – data load non-GGC

• Loading metadata of local databases: TiU Online Contents, TiU
  Repository, TiU Theses
• Finding the right data load method and route
• Accepting metadata quality agreements OCLC with publishers
• Limitations of Dublin Core




                                                                  46
Challenges WP4 – replacing link database

• No analysis tools to compare TiU link database to OCLC WCKBase
• Collections PubGet/WCKBase not always identical to TiU’s licenses
• Accept linking quality agreements OCLC with publishers
• E-books must also be activated (no go live WMS)




                                                                  47
Challenges WP6 – transition

• Phasing out TiU’s digital library services, where possible
• Keeping TiU’s institutional repository also as a
  separate, innovative, service
• Stopping services WCL cannot (yet) offer and finding alternatives
  (CAS, book shelves)
• Inventory of all functional changes for library (instruction) staff




                           Titelpresentatie in Footer   22-8-2012       48

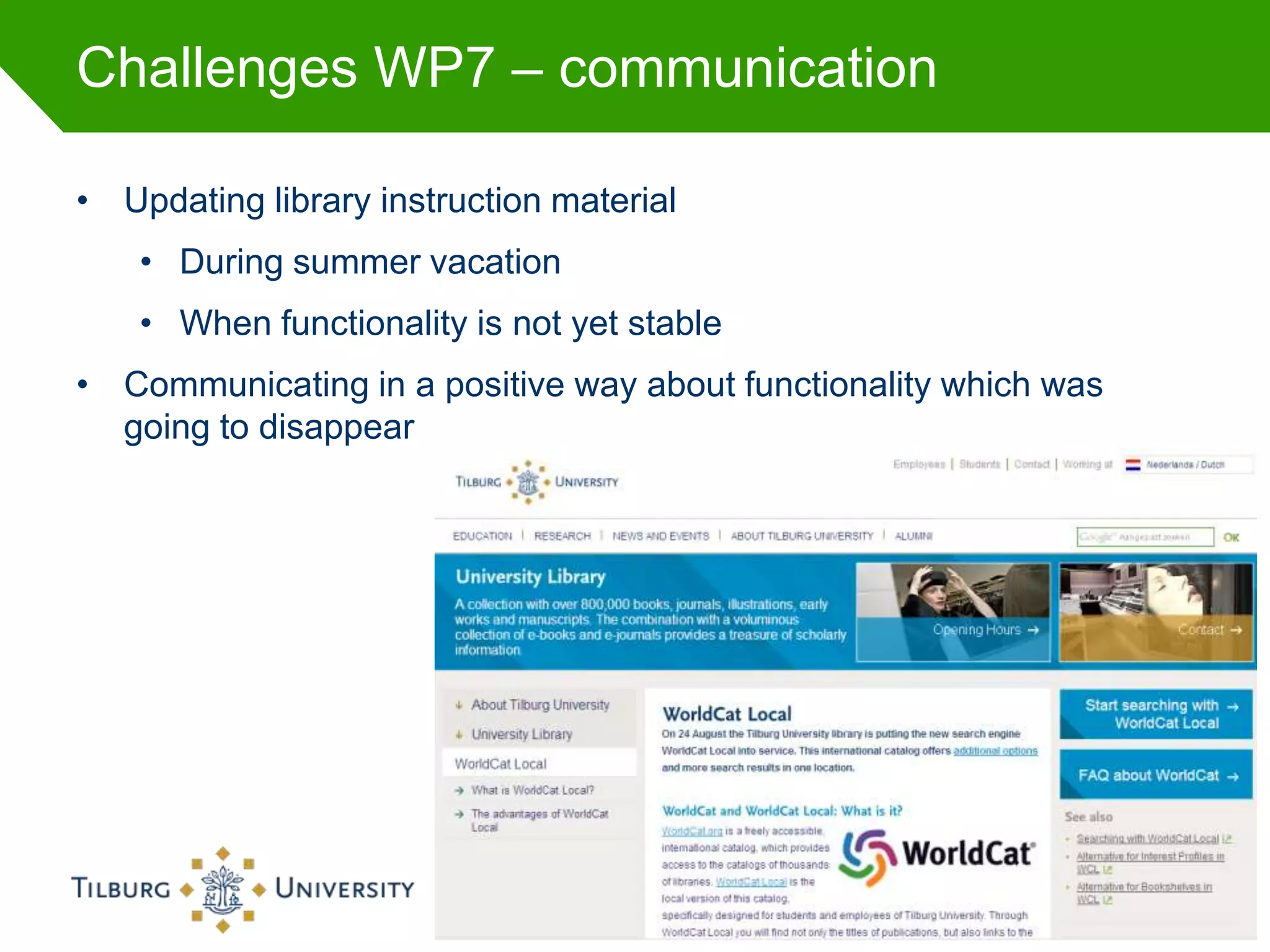

Challenges WP7 – communication

• Updating library instruction material
    • During summer vacation
    • When functionality is not yet stable
• Communicating in a positive way about functionality which was
  going to disappear




                                                                  49
Challenges WP8 – staff training

• Adapting training method to library staff needs (show & tell
  sessions, personal training, self-study, by team leader)
•   Based on expected questions/problems by end-users




                                                                 50
Consequences of the cloud

• Two Go Live moments
   • 26 June - TiU Library & IT Services
   • 24 August - End-users




• Procedures
   • No library instruction on / shortly after release dates
   • Library (instruction) staff should study release notes
   • Functional management must regularly check support site, no
     personal mail messages if systems go down



                                                                   51
Lessons learned




Ticer summer school   22 August 2012   52
53
How to create support

• Make sure staff understands rationale / business case
• Make sure staff understands priority of the project
• Place key staff (advocates) in project team
• Involve workfloor staff where possible
• Regularly communicate about the project
• Listen to the project team’s complaints and worries




                                                          54
Other lessons learned (1)

• Human resources plan should
  have been made, in spite of
  project’s priority
• Library director should
  communicate about
  project, project’s
  priority, rationale behind choice
  for the system, business case
  in kick-off meeting for all library
  staff
• Analyzing your workflow is
  useful




                                        55
Other lessons learned (2)

• It is difficult to quantify impact
  of gaps
• TiU staff should be involved
  when discussing gaps
  between OCLC Leiden and
  OCLC Dublin
• Measurable acceptance
  criteria should be the basis of a
  project plan in its
  implementation stage




                            Titelpresentatie in Footer   22-8-2012   56
Other lessons learned (3)

• Do not underestimate:
   • Load of local metadata
   • 3rd party integration
   • Activation of e-collection
   • Impact of not combining go
     live WCL/WMS
• With innovative products, the
  consequences of decisions are
  difficult to oversee
• You cannot spend enough time
  on internal communication



                          Titelpresentatie in Footer   22-8-2012   57
Questions? More information?

• Jola Prinsen, project
  manager, Tilburg
  University, Library & IT
  Services
  jola.prinsen@tilburguniversity.
  edu
• Annette Dortmund, product
  manager WMS EMEA, OCLC
  annette.dortmund@oclc.org




                         Titelpresentatie in Footer   22-8-2012   58
Recommended reading (1)

•   Introductions on cloud computing in libraries
     • Breeding, Marshall (2012). ALA Tech Source 2012
     • Breeding, Marshall (2012). A Cloudy Forecast for Libraries. In:
       Computers in Libraries, Vol. 31, No. 7, September 2011
       (http://www.infotoday.com/cilmag/sep11/Breeding.shtml)
     • Breeding, Marshall (2012). Advance of Computing from the Ground
       to the Cloud – Basic Concepts and Library Applications
       (presentation at Computers in Libraries 2012)
       (www.librarytechnology.org/docs/16681.ppt)
     • Breeding, Marshall (2012). Cloud Computing for Libraries. Chicago :
       ALA TechSource, an imprint of the American Library
       Association, ISBN 978-1-55570-785-9
       (http://www.scribd.com/doc/90008387/Cloud-Computing-for-
       Libraries for table of
       contents, http://monographer.wordpress.com/2012/06/28/cloud-
       computing-for-libraries-review/ for review)



                                                                         59

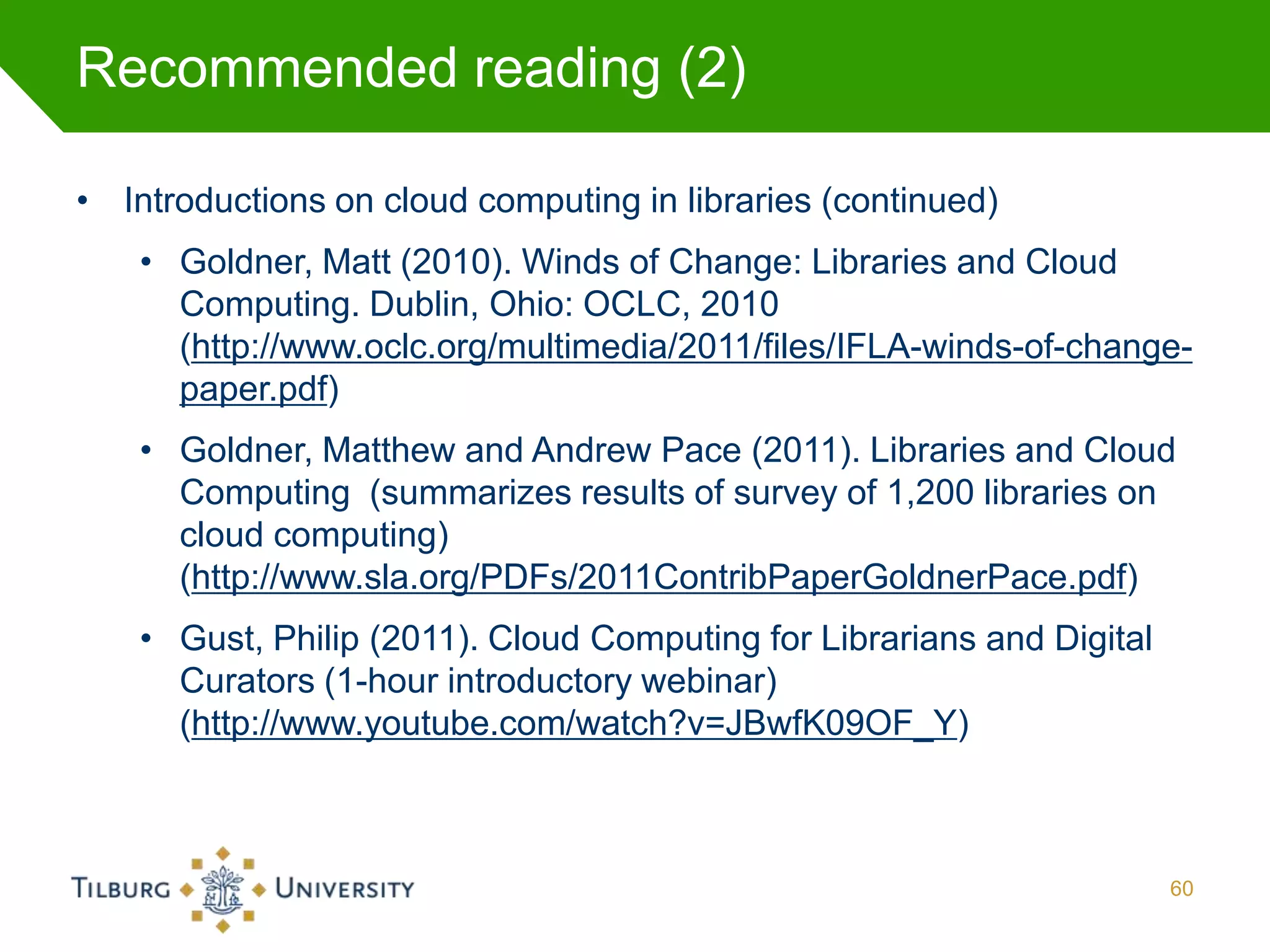

Recommended reading (2)

• Introductions on cloud computing in libraries (continued)
    • Goldner, Matt (2010). Winds of Change: Libraries and Cloud
      Computing. Dublin, Ohio: OCLC, 2010
      (http://www.oclc.org/multimedia/2011/files/IFLA-winds-of-change-
      paper.pdf)
    • Goldner, Matthew and Andrew Pace (2011). Libraries and Cloud
      Computing (summarizes results of survey of 1,200 libraries on
      cloud computing)
      (http://www.sla.org/PDFs/2011ContribPaperGoldnerPace.pdf)
    • Gust, Philip (2011). Cloud Computing for Librarians and Digital
      Curators (1-hour introductory webinar)
      (http://www.youtube.com/watch?v=JBwfK09OF_Y)



                                                                        60
Recommended reading (3)

•   OCLC’s WMS/WCL
    • Berg, Marc van den (2011). Tilburg University's Road to WMS.
      UKSG Conference, 16 November 2011 (15-minute presentation on
      TiU’s WMS project)
      (http://www.youtube.com/watch?v=_CtSHMrMsMk&feature=youtu.b
      e)
    • Pace, Andrew, Robin Hartman and Larry Haight (2011). Web
      Services. Libraries in the Cloud (PowerPoint on OCLC’s WMS, and
      experiences at two libraries)
      (http://conferences.infotoday.com/documents/125/C304_Pace.pdf)
    • TiU’s implementation of WCL can be found at
      http://tilburguniversity.worldcat.org/ and
      http://tilburguniversity.worldcat.org/m/ (mobile site)
    • Various OCLC member stories about the implementation of WMS
      (http://www.oclc.org/webscale/success.htm)


                                                                    61

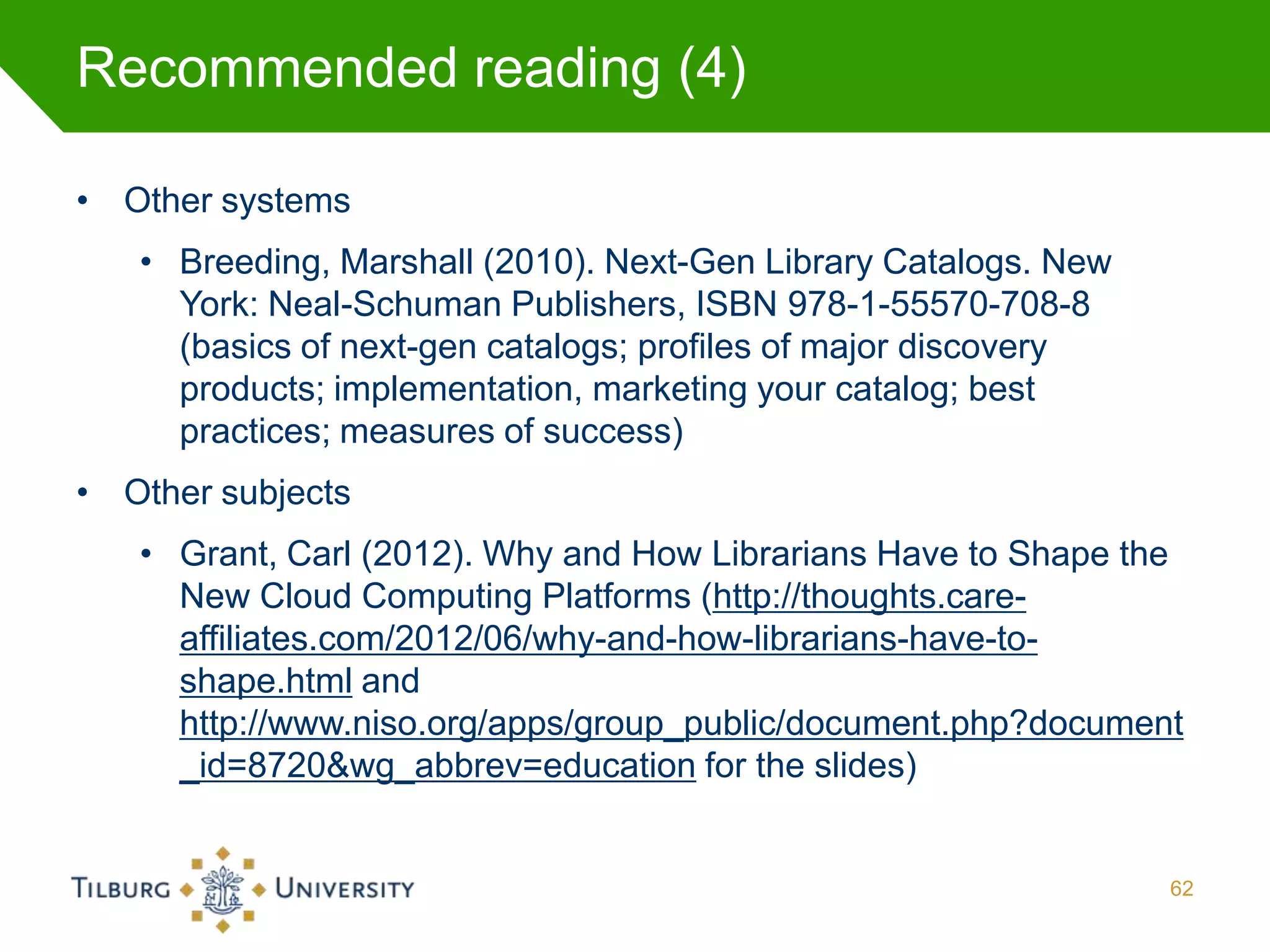

Recommended reading (4)

• Other systems
   • Breeding, Marshall (2010). Next-Gen Library Catalogs. New
     York: Neal-Schuman Publishers, ISBN 978-1-55570-708-8
     (basics of next-gen catalogs; profiles of major discovery
     products; implementation, marketing your catalog; best
     practices; measures of success)
• Other subjects
   • Grant, Carl (2012). Why and How Librarians Have to Shape the
     New Cloud Computing Platforms (http://thoughts.care-
     affiliates.com/2012/06/why-and-how-librarians-have-to-
     shape.html and
     http://www.niso.org/apps/group_public/document.php?document
     _id=8720&wg_abbrev=education for the slides)


                                                                 62

Jola G.B. Prinsen - Implementing a cloud-based library management and search system - the WMS and WCL case study at Tilburg University

  • 1.
    Implementing a cloud-basedlibrary management and search system – the WMS and WCL case at Tilburg University Jola G.B. Prinsen, project manager Library & IT Services
  • 2.
    Before we start… •Lecture about implementation project • No WMS/WCL demo • No focus on the WMS/WCL systems • Tilburg University Library is an early adopter, no comparable WMS libraries yet • Tilburg University Library is not a standard library • Tradition of innovation • Many in-house developed, customized systems • Local databases 2
  • 3.
    Contents • Cloud computing •Selection process • Implementation project • Analysis phase • WCL implementation phase • Lessons learned • Recommended reading 3
  • 4.
    Cloud computing Ticer summerschool 22 August 2012 4
  • 5.
    Cloud computing –definition • The use of computing resources (hardware and software) that are delivered as a service over a network (typically the Internet). The name comes from the use of a cloud-shaped symbol as an abstraction for the complex infrastructure it contains in system diagrams. Cloud computing entrusts remote services with a user's data, software and computation. (Wikipedia) 5
  • 6.
    Examples – End-user/discoveryservices • Union catalogues GGC • Discovery services 6
  • 7.
    Examples – Librarymanagement systems • LMS vendor hosting arrangements (1st phase) LBS4 • Library service platforms Sierra Intota 7
  • 8.
    Do you use/ consider a cloud-based LMS? 8
  • 9.
    Cloud-based LMS amongparticipants Consider cloud-based Use cloud-based LMS LMS Yes Yes No No (Results from questionnaire among this module’s participants – 18 answers) 9
  • 10.
    What worries youabout cloud computing? 10
  • 11.
    Cloud computing –library concerns 40% 35% 30% 25% 20% 15% 10% 5% 0% (Taken from an OCLC survey of 2,700 librarians in academic, public, government and corporate libraries, and in various roles across the library, conducted in March 2011) 11
  • 12.
    How TiU coveredrisks (1) • Bibliographic data • Ownership (also after termination of contract) arranged in contract • GGC and local databases are backup • Personal data • No staff or end-user data to be stored in the US • Contract • Encryption and security requirements 12
  • 13.
    How TiU coveredrisks (2) • Reliability and stability • Trustworthy provider • Service Level Agreement • Openness • APIs on Open Platform • Changes to service • Roadmap, fixed release dates, release notes • Take the service as it is 13
  • 14.
  • 15.
    Cloud computing –library advantages 25% 20% 15% 10% 5% (Taken from an OCLC survey of 2,700 0% librarians in academic, public, government and corporate libraries, and in various roles across the library, conducted in March 2011) 15
  • 16.
    Selection process Ticer summerschool 22 August 2012 16
  • 17.
    TiU’s digital librarylandscape Cataloguing GGC Circulation and Acquisition OCLC’s LBS3 Discovery & delivery systems In-house developed iPort and GetIt! Local databases Like: repository, theses, image databases, journal article metadata, chapter metadata Document server Locally stored full text Link database Locally developed services OpenURL resolver, loan server, place locator, etc. Integration METIS 17
  • 18.
  • 19.
    Rationale for newLMS / discovery service • Hardware – outdated, unstable and no longer supported • Library system – outdated and no longer supported as from 1/1/2013 onwards • In-house developed discovery & delivery system – unable to keep up with developments • Digital library landscape – complex • Maintaining same service level – with less IT staff • Increasing pressure to reduce costs Off-the-shelf Innovation 19
  • 20.
    TiU’s requirements –LMS (1) • Cataloguing • In the GGC (short-term) / WorldCat (long-term) • Library processes supported • Acquisition paper-based library material • Acquisition / license management for digital material • Financial management • Circulation, including patron management and ILL • Requesting material from closed stacks • Placing reservations on circulated material 20
  • 21.
    TiU’s requirements –LMS (2) • Integration with • Discovery environment • Lendomats • Financial system (SAP) • Identity management system • Management information system • Supplier should • Deliver to several Dutch university libraries • Belong to international top of UL suppliers • Deliver hosted solutions (short-term) • Work actively on cloud solutions (long-term) 21
  • 22.
    TiU’s requirements –Discovery service • Most important • Excellent integration with LMS • Besides that • Integration of local content • Discovery service open for all • Public content available to all; licensed material after log in • Well-developed API service for integration with local services • Good coverage and continued effort to improve • Service also used by other Dutch university libraries 22
  • 23.
    Suppliers considered • Librarymanagement systems • OCLC: Hosted LBS4 solution or WMS • Ex Libris: Hosted Aleph solution or Alma • Discovery & delivery systems • Ex Libris Primo Direct (with Primo Central) • OCLC WorldCat Local • Serials Solutions Summon 23
  • 24.
    Selection – timetable Proposals / sessions OCLC and Ex Libris Sep 2010-May 2011 • Summer 2010: first contacts with suppliers • December 2010: management document on scenarios and requirements • January 2011: description of workflows • June 2011: decision for OCLC’s WMS/WCL • WMS – working product, good interface and functionality, promising new functionality • WorldCat Local – well integrated with WMS, GGC and Google • WorldCat as underlying Catalogue – more content 24
  • 25.
    Implementation project Ticer summerschool 22 August 2012 25
  • 26.
    Implementation – timetable 7/2011 6/2011 9/2011 Project Start project PID organization 9/2012-early 2013 3/2012-8/2012 9/2011-3/2012 Implementation Implementation Analysis phase WMS WCL 26
  • 27.
    Business case • LBS3:end-of-life, too costly, too much of a risk • GetIt!: cannot keep up with developments • Simplify our library systems landscape for unchanged service fee • Saving costs and no future costs for mandatory upgrades and migrations • Functionality for TiU’s customers will grow • Functionality for our library staff will grow 27
  • 28.
    Project aims Functional Implementation requirements WCL Implementation WMS 28
  • 29.
    Project organization (1) Project board Project Project manager manager TiU OCLC Project team Project team TiU OCLC 29
  • 30.
    Project organization (2) • Project board • Director TiU LIS • Director OCLC Leiden • Manager TiU LIS, Academic Support • TiU project team • Head acquisition and cataloguing • Head circulation • IT specialist LBS3 • IT specialist local databases • Future functional managers WMS/WCL • Technical project manager (IDM matters) 30
  • 31.
    Analysis phase Ticer summerschool 22 August 2012 31
  • 32.
    Phase 1 -Analysis Workflow Test Workflow analysis environment testing Go / no go Impact Gap decision analysis analysis 32
  • 33.
    Workflow analysis • Acquisition •Circulation • Discovery & delivery • Management information • 3rd party integration • Financial information (SAP) • Lendomats (SIP2) • Identity management (TiU’s IDM) 33
  • 34.
    Workflow testing Workflow Test Workflow analysis environment testing Go / no go Impact Gap decision analysis analysis 34
  • 35.
    Workflow testing –challenges • No test system (yet), only demo system, without TiU data • Documentation sometimes not comprehensive enough • Testing of 3rd-party integration impeded by delay in set-up OCLC’s European data centre • Leiden’s staff also at beginning learning curve • Quarterly releases (announced) impact functionality • Response from OCLC Dublin, initially, was slow • Takes a lot of time!
  • 36.
    Gap and impactanalysis • Gap analysis • Gaps between current functionality and WMS/WCL functionality • Impact analysis • Impact on stakeholders (where possible quantified) • Workaround? Effort involved • Priority (must have, need to have, nice to have) • Solution on OCLC’s roadmap? 36
  • 37.
    Gap analysis (statusMarch 2012) 152 WMS/WCL gaps 152 WMS/WCL gaps by priority by solution Blocking Solved! Very needed Workaround Needed Release Wish planning Unknown Not prioritized 37
  • 38.
    Also benefits • WMS • Circulation: more intuitive and user-friendly interface • Acquisition: potential improvement of financial process • WCL • More content • Social media functionality • Lists functionality • Integration with Google Books / Google Scholar • Exporting titles • Mobile platform • Chinese interface http://www.tilburguniversity.edu/about-tilburg-university/library/wcl/ 38
  • 39.
    Reaction • Early adopter • Discovering gaps was part of the project • Knew we had to adapt • Off-the-shelf system replaces in-house developed customized system 39
  • 40.
    WMS  Nogo • Business case not (yet) valid • Hosting of TiU’s LBS3 • Visit OCLC Dublin, OH • Await new releases • Confidence in OCLC • Back-office system • Go live possible throughout academic year  Remain in analysis phase 40
  • 41.
    WMS analysis continued– visit Dublin • All gaps discussed • More effective communication • Increased understanding • Jointly thinking about possible solutions • Changes in release planning • TiU’s requirements match those of comparable other WMS libraries 41
  • 42.
    WCL  Go! •End-user service • Go live only possible at beginning academic year • Condition: availability info (from LBS3) can be made available in WCL  Start of implementation phase 42
  • 43.
    WCL implementation phase Ticer summer school 22 August 2012 43
  • 44.
    Aims and workpackages 1. Optimizing functionality of WCL 2. Including availability info in WCL 3. Loading metadata of local databases to WC 4. Activating e-collections 5. Loading local GGC metadata to WC 6. Phasing out TiU’s digital library systems 7. Communicating to stakeholders 8. Training staff 9. Documenting workflows 44
  • 45.
    Challenges WP2 –availability info • Presenting availability and borrower info in WCL (without WMS) • Keeping TiU’s services running • Presenting TiU’s info in WCL Titelpresentatie in Footer 22-8-2012 45
  • 46.
    Challenges WP3 –data load non-GGC • Loading metadata of local databases: TiU Online Contents, TiU Repository, TiU Theses • Finding the right data load method and route • Accepting metadata quality agreements OCLC with publishers • Limitations of Dublin Core 46
  • 47.
    Challenges WP4 –replacing link database • No analysis tools to compare TiU link database to OCLC WCKBase • Collections PubGet/WCKBase not always identical to TiU’s licenses • Accept linking quality agreements OCLC with publishers • E-books must also be activated (no go live WMS) 47
  • 48.
    Challenges WP6 –transition • Phasing out TiU’s digital library services, where possible • Keeping TiU’s institutional repository also as a separate, innovative, service • Stopping services WCL cannot (yet) offer and finding alternatives (CAS, book shelves) • Inventory of all functional changes for library (instruction) staff Titelpresentatie in Footer 22-8-2012 48
  • 49.
    Challenges WP7 –communication • Updating library instruction material • During summer vacation • When functionality is not yet stable • Communicating in a positive way about functionality which was going to disappear 49
  • 50.
    Challenges WP8 –staff training • Adapting training method to library staff needs (show & tell sessions, personal training, self-study, by team leader) • Based on expected questions/problems by end-users 50
  • 51.
    Consequences of thecloud • Two Go Live moments • 26 June - TiU Library & IT Services • 24 August - End-users • Procedures • No library instruction on / shortly after release dates • Library (instruction) staff should study release notes • Functional management must regularly check support site, no personal mail messages if systems go down 51
  • 52.
    Lessons learned Ticer summerschool 22 August 2012 52
  • 53.
  • 54.
    How to createsupport • Make sure staff understands rationale / business case • Make sure staff understands priority of the project • Place key staff (advocates) in project team • Involve workfloor staff where possible • Regularly communicate about the project • Listen to the project team’s complaints and worries 54
  • 55.
    Other lessons learned(1) • Human resources plan should have been made, in spite of project’s priority • Library director should communicate about project, project’s priority, rationale behind choice for the system, business case in kick-off meeting for all library staff • Analyzing your workflow is useful 55
  • 56.
    Other lessons learned(2) • It is difficult to quantify impact of gaps • TiU staff should be involved when discussing gaps between OCLC Leiden and OCLC Dublin • Measurable acceptance criteria should be the basis of a project plan in its implementation stage Titelpresentatie in Footer 22-8-2012 56
  • 57.
    Other lessons learned(3) • Do not underestimate: • Load of local metadata • 3rd party integration • Activation of e-collection • Impact of not combining go live WCL/WMS • With innovative products, the consequences of decisions are difficult to oversee • You cannot spend enough time on internal communication Titelpresentatie in Footer 22-8-2012 57
  • 58.
    Questions? More information? •Jola Prinsen, project manager, Tilburg University, Library & IT Services jola.prinsen@tilburguniversity. edu • Annette Dortmund, product manager WMS EMEA, OCLC annette.dortmund@oclc.org Titelpresentatie in Footer 22-8-2012 58
  • 59.
    Recommended reading (1) • Introductions on cloud computing in libraries • Breeding, Marshall (2012). ALA Tech Source 2012 • Breeding, Marshall (2012). A Cloudy Forecast for Libraries. In: Computers in Libraries, Vol. 31, No. 7, September 2011 (http://www.infotoday.com/cilmag/sep11/Breeding.shtml) • Breeding, Marshall (2012). Advance of Computing from the Ground to the Cloud – Basic Concepts and Library Applications (presentation at Computers in Libraries 2012) (www.librarytechnology.org/docs/16681.ppt) • Breeding, Marshall (2012). Cloud Computing for Libraries. Chicago : ALA TechSource, an imprint of the American Library Association, ISBN 978-1-55570-785-9 (http://www.scribd.com/doc/90008387/Cloud-Computing-for- Libraries for table of contents, http://monographer.wordpress.com/2012/06/28/cloud- computing-for-libraries-review/ for review) 59
  • 60.
    Recommended reading (2) •Introductions on cloud computing in libraries (continued) • Goldner, Matt (2010). Winds of Change: Libraries and Cloud Computing. Dublin, Ohio: OCLC, 2010 (http://www.oclc.org/multimedia/2011/files/IFLA-winds-of-change- paper.pdf) • Goldner, Matthew and Andrew Pace (2011). Libraries and Cloud Computing (summarizes results of survey of 1,200 libraries on cloud computing) (http://www.sla.org/PDFs/2011ContribPaperGoldnerPace.pdf) • Gust, Philip (2011). Cloud Computing for Librarians and Digital Curators (1-hour introductory webinar) (http://www.youtube.com/watch?v=JBwfK09OF_Y) 60
  • 61.
    Recommended reading (3) • OCLC’s WMS/WCL • Berg, Marc van den (2011). Tilburg University's Road to WMS. UKSG Conference, 16 November 2011 (15-minute presentation on TiU’s WMS project) (http://www.youtube.com/watch?v=_CtSHMrMsMk&feature=youtu.b e) • Pace, Andrew, Robin Hartman and Larry Haight (2011). Web Services. Libraries in the Cloud (PowerPoint on OCLC’s WMS, and experiences at two libraries) (http://conferences.infotoday.com/documents/125/C304_Pace.pdf) • TiU’s implementation of WCL can be found at http://tilburguniversity.worldcat.org/ and http://tilburguniversity.worldcat.org/m/ (mobile site) • Various OCLC member stories about the implementation of WMS (http://www.oclc.org/webscale/success.htm) 61
  • 62.
    Recommended reading (4) •Other systems • Breeding, Marshall (2010). Next-Gen Library Catalogs. New York: Neal-Schuman Publishers, ISBN 978-1-55570-708-8 (basics of next-gen catalogs; profiles of major discovery products; implementation, marketing your catalog; best practices; measures of success) • Other subjects • Grant, Carl (2012). Why and How Librarians Have to Shape the New Cloud Computing Platforms (http://thoughts.care- affiliates.com/2012/06/why-and-how-librarians-have-to- shape.html and http://www.niso.org/apps/group_public/document.php?document _id=8720&wg_abbrev=education for the slides) 62
