Priority
  Poker

Introduction and Example
SwissQ, June 2012
Page 2
Herausforderung
Approach
Priority Poker in Detail
Relative Estimates
Example
1
2
3
4
5
Summary6
Next Steps7
Challenge
Prioritization

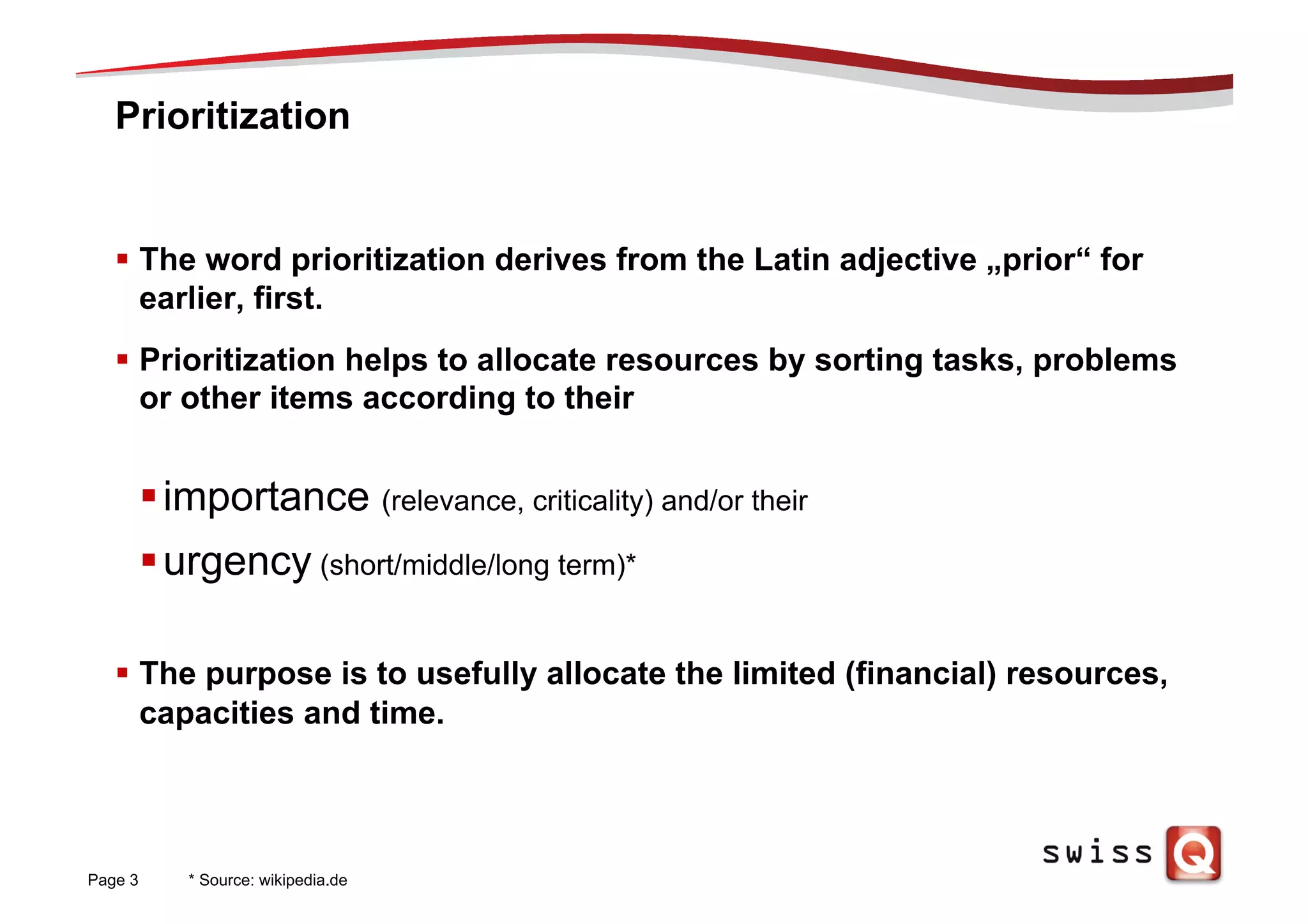

§  The word prioritization derives from the Latin adjective „prior“ for
earlier, first.
§  Prioritization helps to allocate resources by sorting tasks, problems
or other items according to their
§ importance (relevance, criticality) and/or their
§ urgency (short/middle/long term)*
§  The purpose is to usefully allocate the limited (financial) resources,
capacities and time.
Page 3 * Source: wikipedia.de

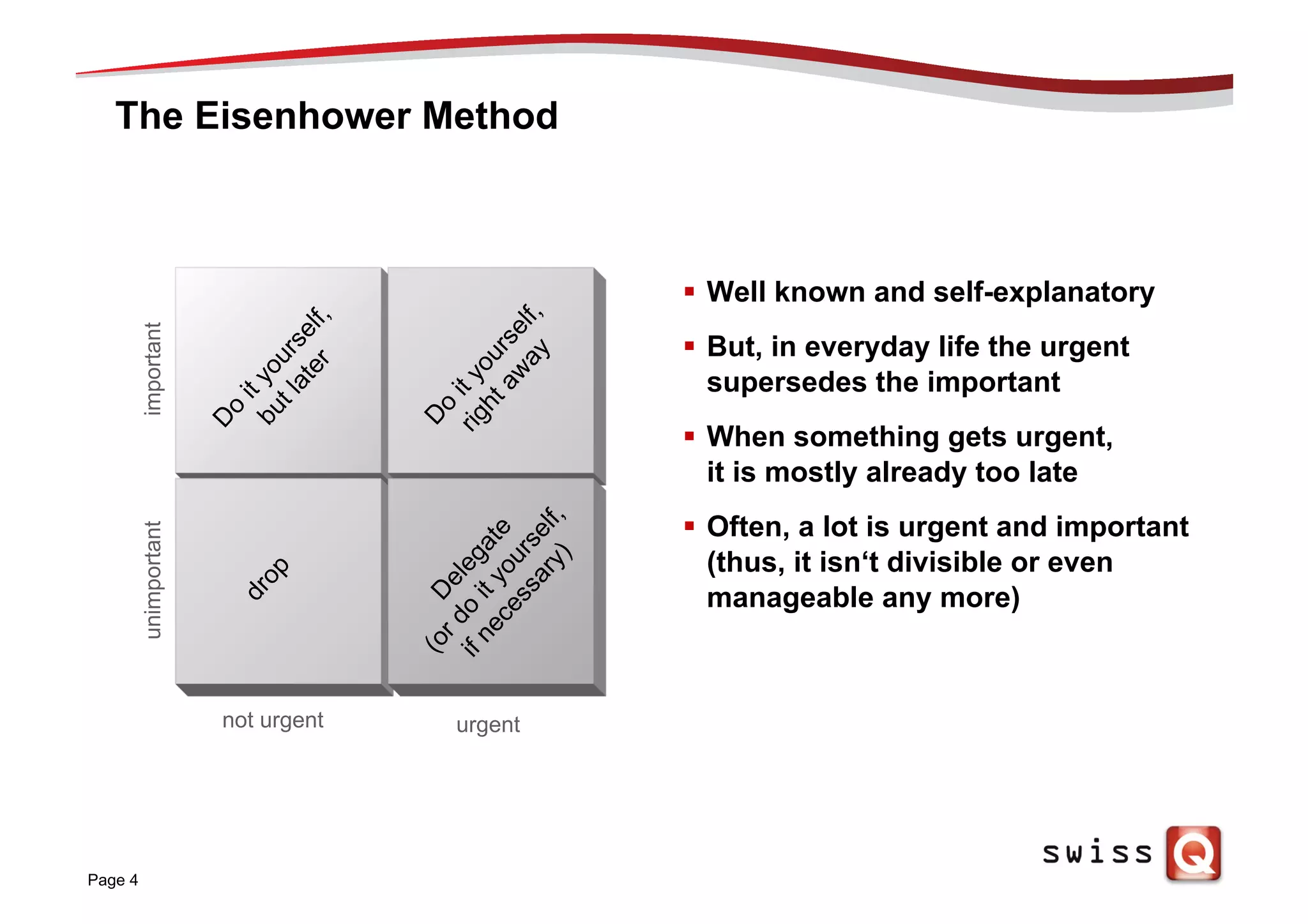

The Eisenhower Method
Page 4
§  Well known and self-explanatory
§  But, in everyday life the urgent
supersedes the important
§  When something gets urgent,
it is mostly already too late
§  Often, a lot is urgent and important
(thus, it isn‘t divisible or even
manageable any more)
not urgent urgent
importantunimportant

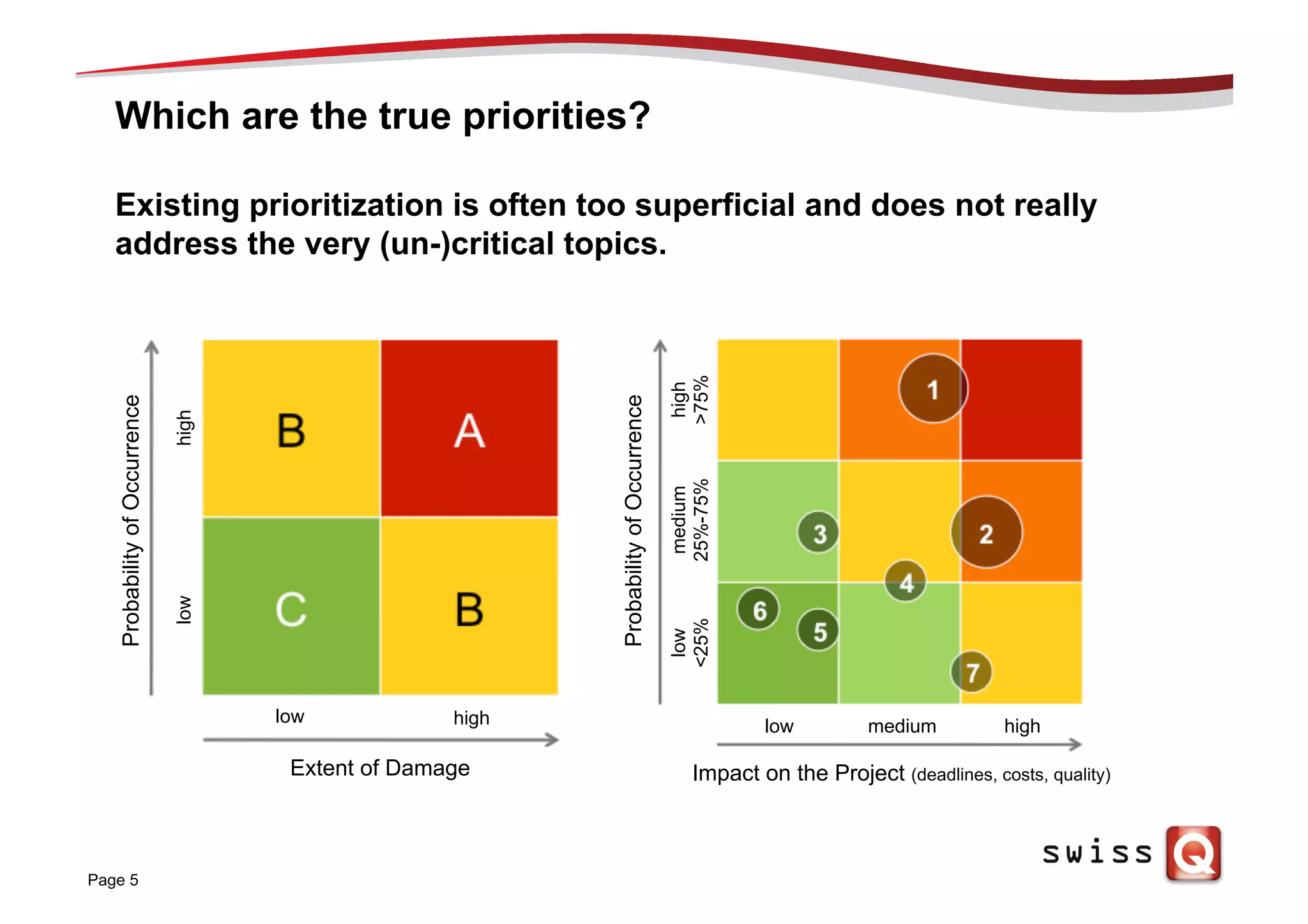

Which are the true priorities?
Page 5
Existing prioritization is often too superficial and does not really
address the very (un-)critical topics.
ProbabilityofOccurrence
Extent of Damage
ProbabilityofOccurrence
Impact on the Project (deadlines, costs, quality)
low high low medium high
lowhigh
low
<25%
medium
25%-75%
high
>75%
Different Views!

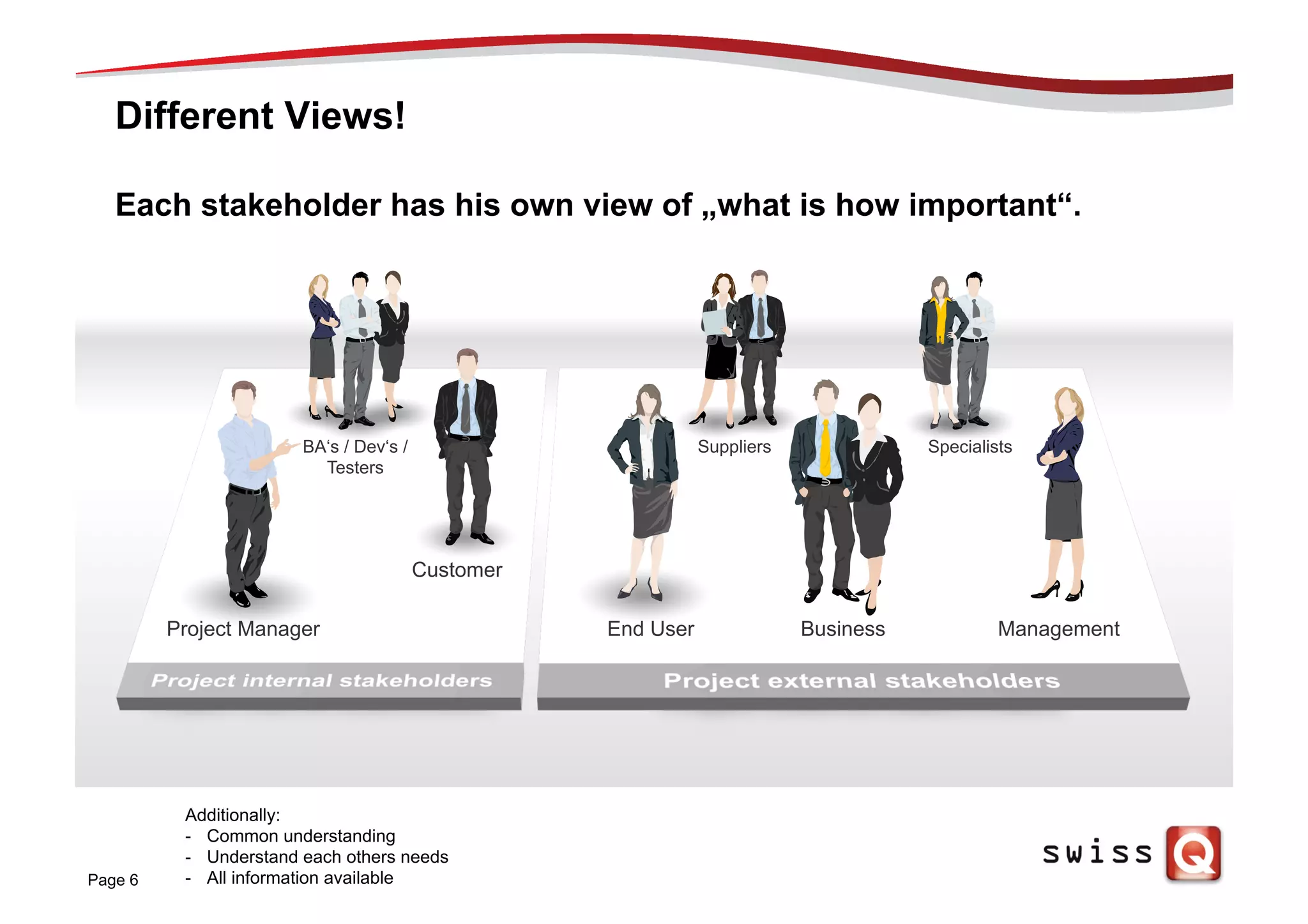

Page 6
Each stakeholder has his own view of „what is how important“.
Project Manager
BA‘s / Dev‘s /
Testers
Customer
End User
Suppliers Specialists
ManagementBusiness
Additionally:
-  Common understanding
-  Understand each others needs
-  All information available

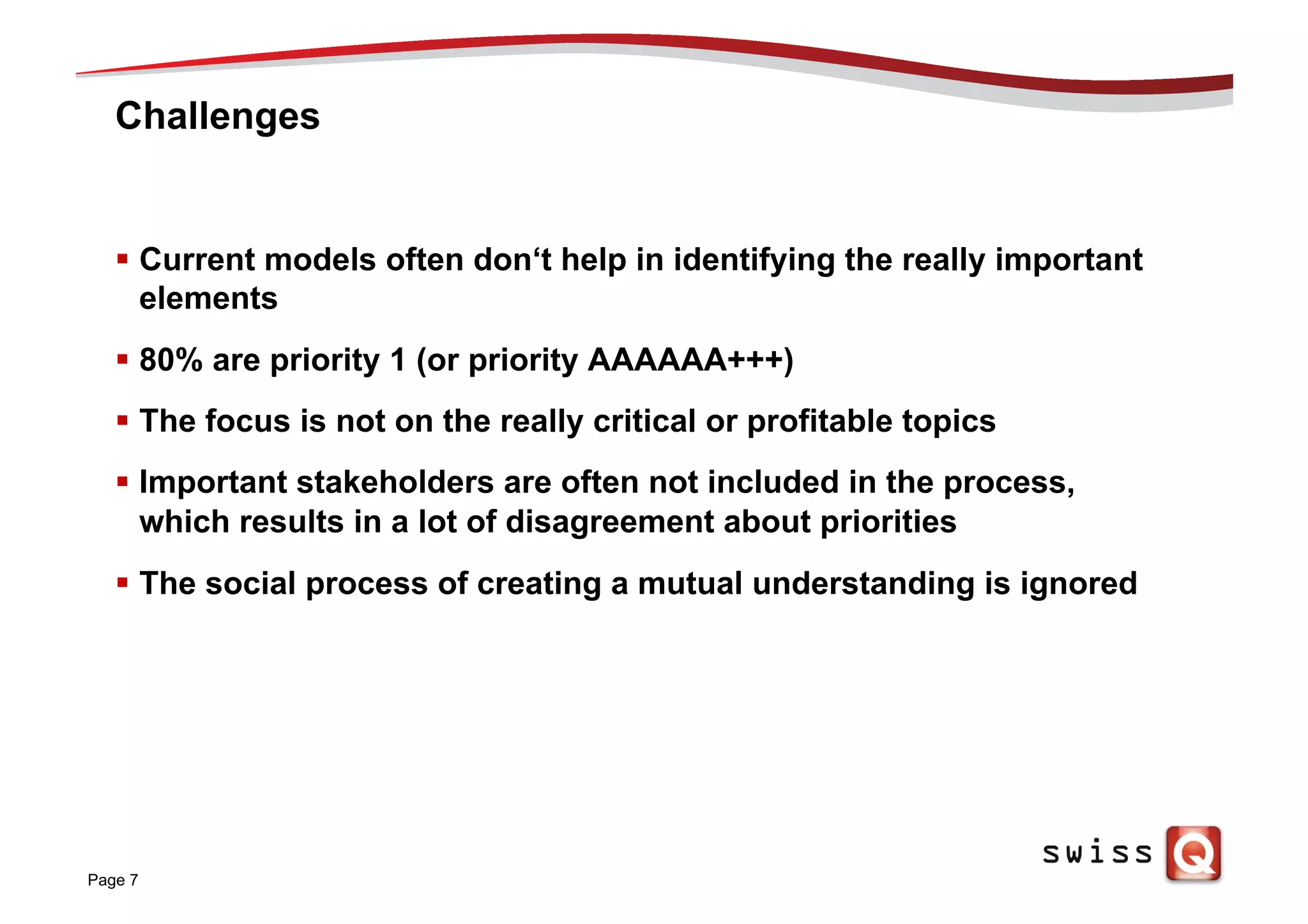

Challenges
§  Current models often don‘t help in identifying the really important
elements
§  80% are priority 1 (or priority AAAAAA+++)
§  The focus is not on the really critical or profitable topics
§  Important stakeholders are often not included in the process,
which results in a lot of disagreement about priorities
§  The social process of creating a mutual understanding is ignored
Page 7
Page 8
Challenge
Approach
Priority Poker in Detail
Relative Estimates
Example
1
2
3
4
5
Summary6
Next Steps7

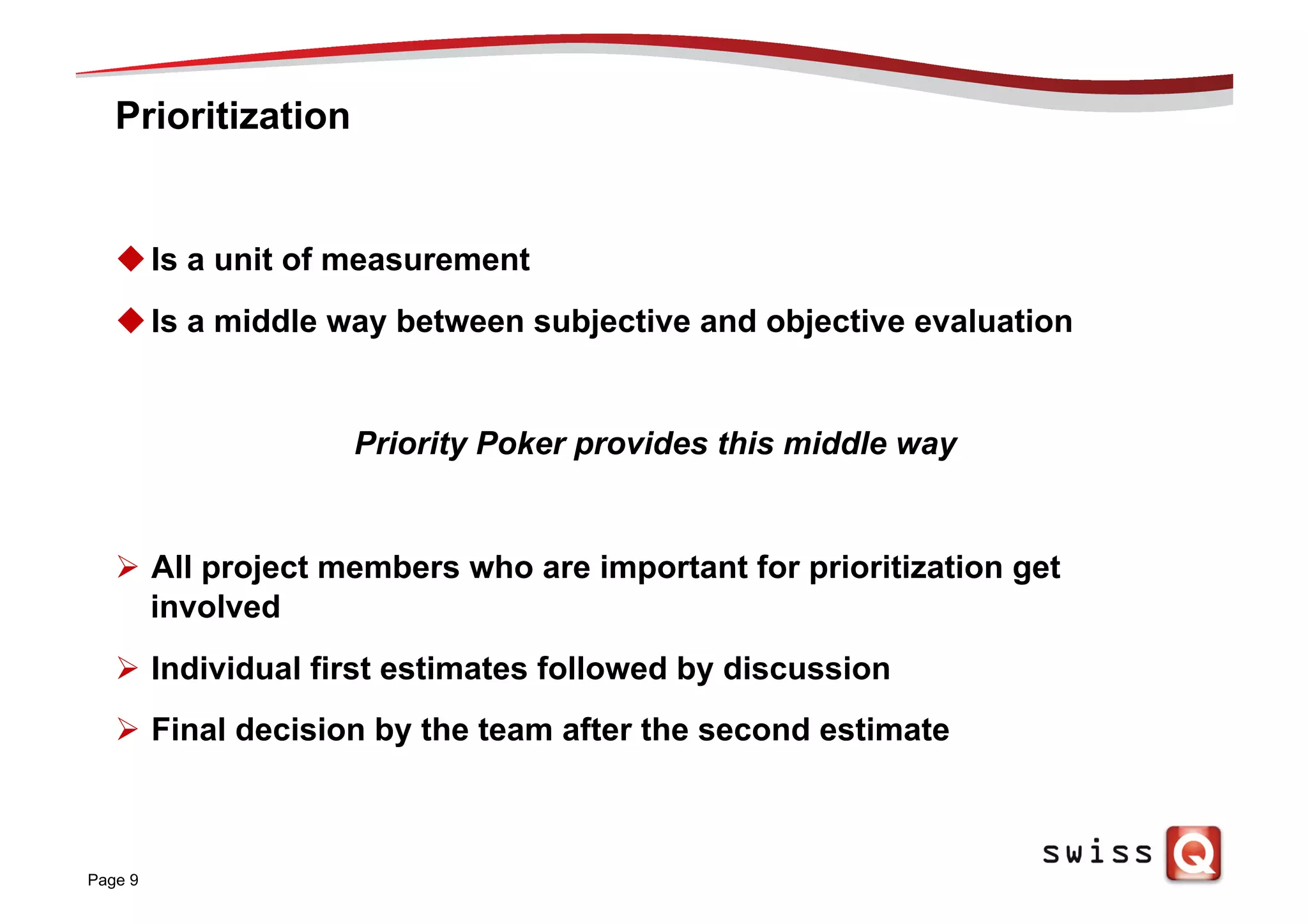

Prioritization
u Is a unit of measurement
u Is a middle way between subjective and objective evaluation
Priority Poker provides this middle way
Ø  All project members who are important for prioritization get
involved
Ø  Individual first estimates followed by discussion
Ø  Final decision by the team after the second estimate
Page 9
Use of Relations
Page 10
Not important Extremely important
The relative evaluation reveals their importance in relation to each
other.

Evaluation with Fibonacci Numbers
Page 11
100
100
200
300
800
500
1300
2100
3400

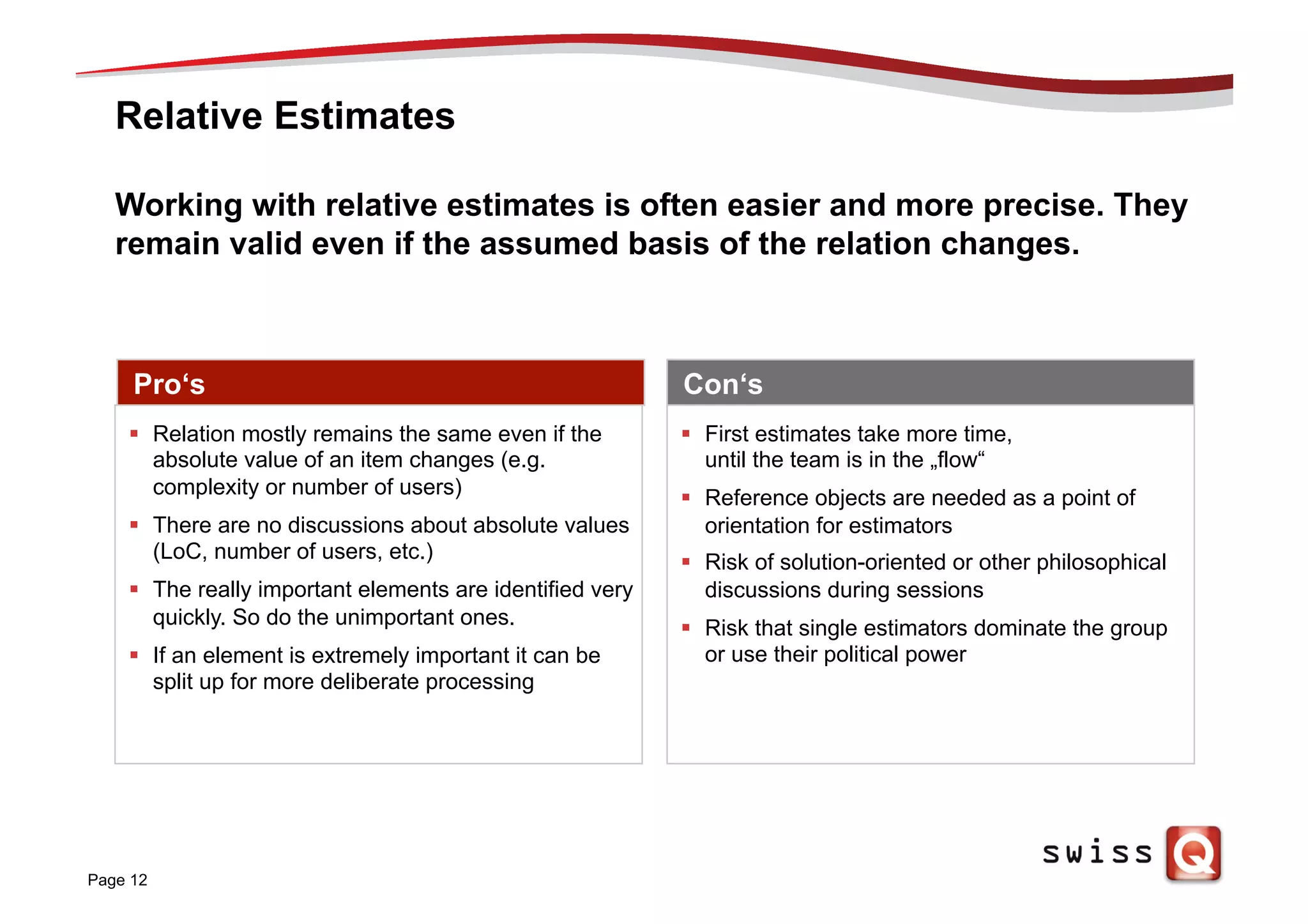

Relative Estimates
Page 12
Working with relative estimates is often easier and more precise. They
remain valid even if the assumed basis of the relation changes.
Pro‘s Con‘s
§  First estimates take more time,
until the team is in the „flow“
§  Reference objects are needed as a point of
orientation for estimators
§  Risk of solution-oriented or other philosophical
discussions during sessions
§  Risk that single estimators dominate the group
or use their political power
§  Relation mostly remains the same even if the
absolute value of an item changes (e.g.
complexity or number of users)
§  There are no discussions about absolute values
(LoC, number of users, etc.)
§  The really important elements are identified very
quickly. So do the unimportant ones.
§  If an element is extremely important it can be
split up for more deliberate processing
The Social Process
Page 13
The social process leads to a common view of priorities and risks.
Project Manager
Business
Analysts
Management
UsersDevelopers
Business

The Procedure also includes...
§  Estimate of Experts
§  Knowledge is at hand
§  Open questions can be answered
§  Team estimate doesn’t put too much focus on experts
§  Analogies
§  Comparison of / relation to other items during estimation
§  Disaggregation (maturity / dissolution)
§  Splitting up elements because of too high complexity, risk, etc.
§  Revealing and closing information gaps
§  etc.
Page 14

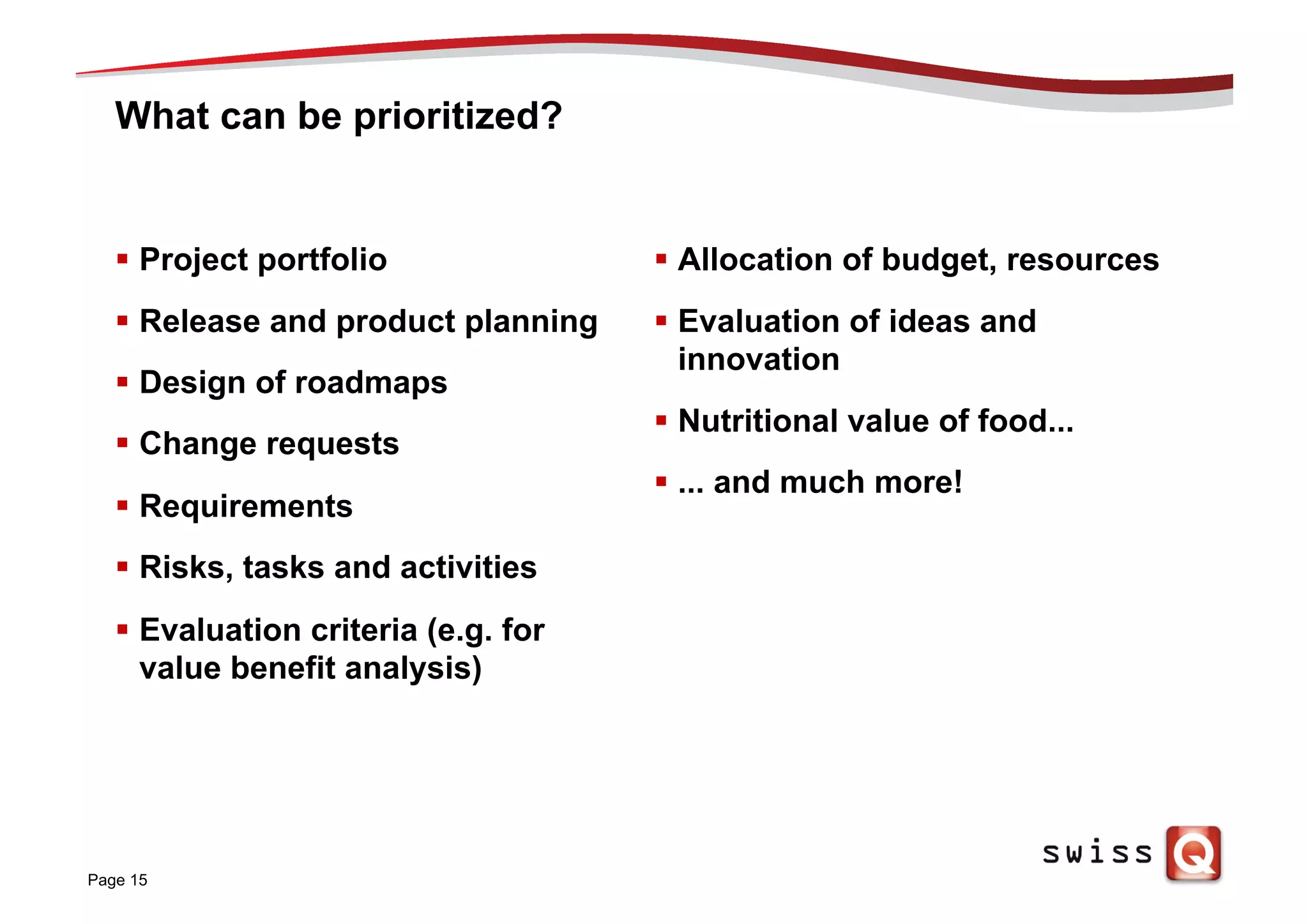

What can be prioritized?
§  Project portfolio
§  Release and product planning
§  Design of roadmaps
§  Change requests
§  Requirements
§  Risks, tasks and activities
§  Evaluation criteria (e.g. for
value benefit analysis)
§  Allocation of budget, resources
§  Evaluation of ideas and
innovation
§  Nutritional value of food...
§  ... and much more!
Page 15
Page 16
Challenge
Approach
Priority Poker in Detail
Relative Estimates
Example
1
2
3
4
5
Summary6
Next Steps7
Setting Priorities Right
Page 17
Priority Poker

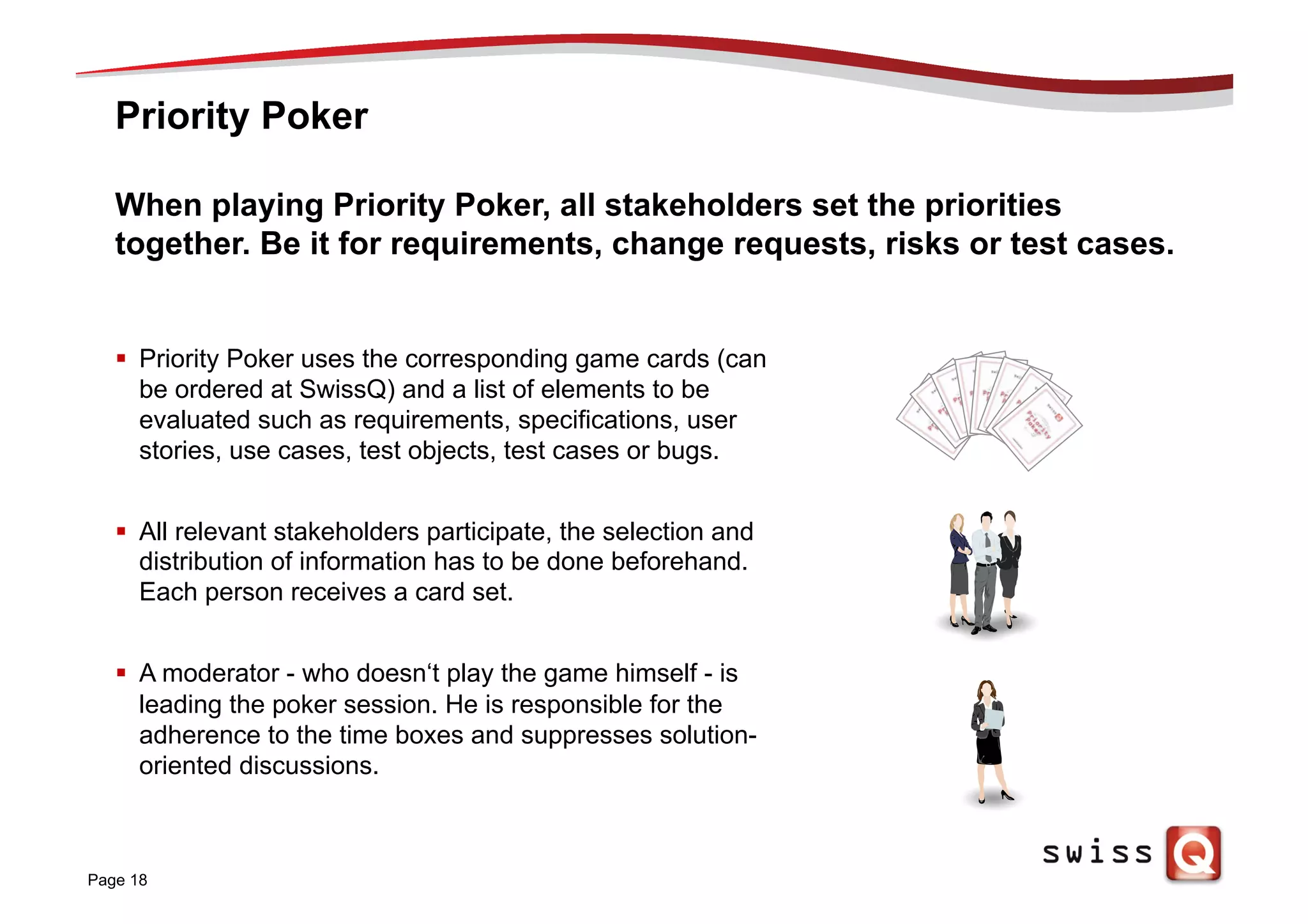

Page 18
When playing Priority Poker, all stakeholders set the priorities
together. Be it for requirements, change requests, risks or test cases.
§  Priority Poker uses the corresponding game cards (can
be ordered at SwissQ) and a list of elements to be
evaluated such as requirements, specifications, user
stories, use cases, test objects, test cases or bugs.
§  All relevant stakeholders participate, the selection and
distribution of information has to be done beforehand.
Each person receives a card set.
§  A moderator - who doesn‘t play the game himself - is
leading the poker session. He is responsible for the
adherence to the time boxes and suppresses solution-
oriented discussions.

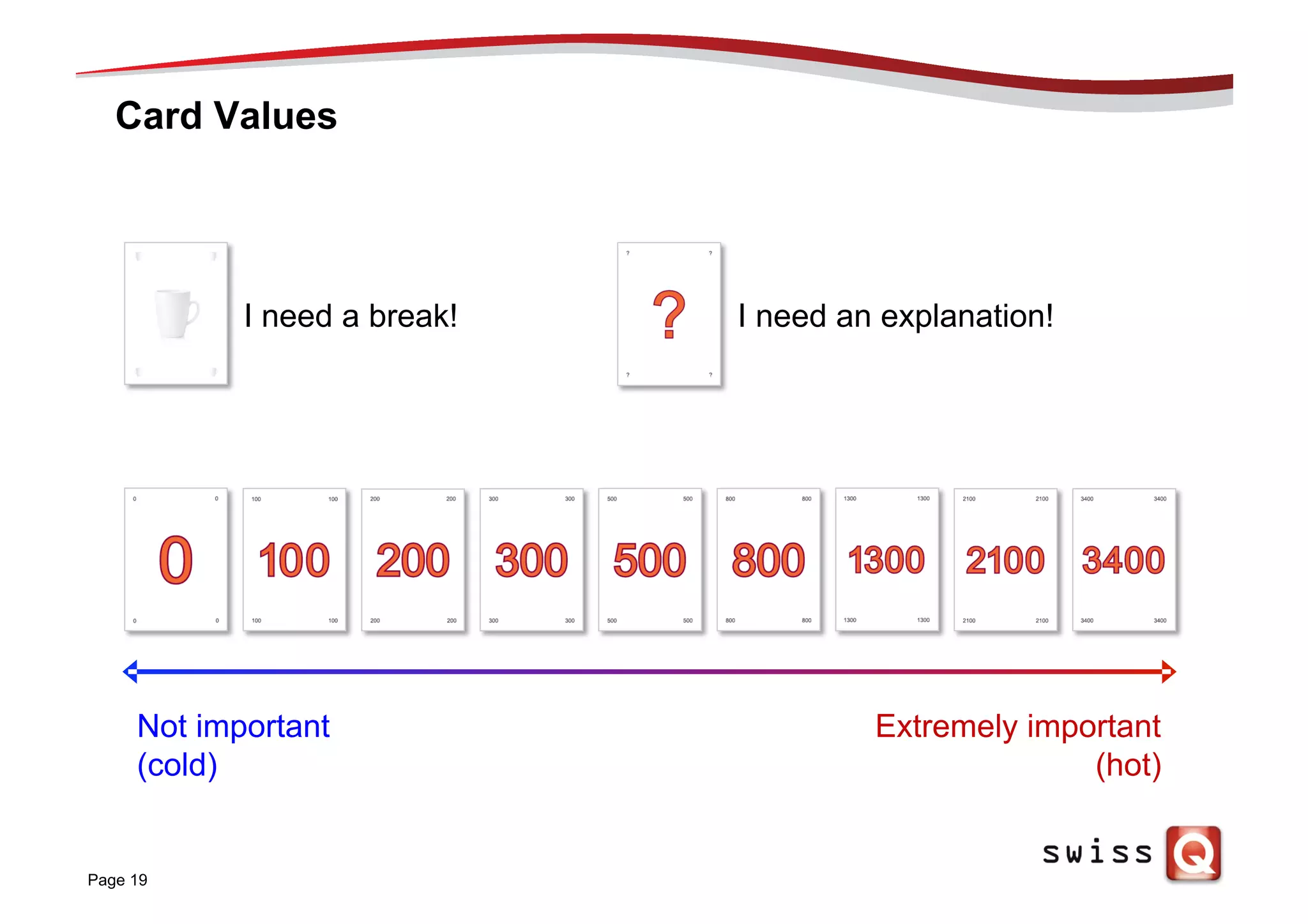

Card Values
Page 19
I need a break! I need an explanation!
Not important
(cold)
Extremely important
(hot)
Estimate

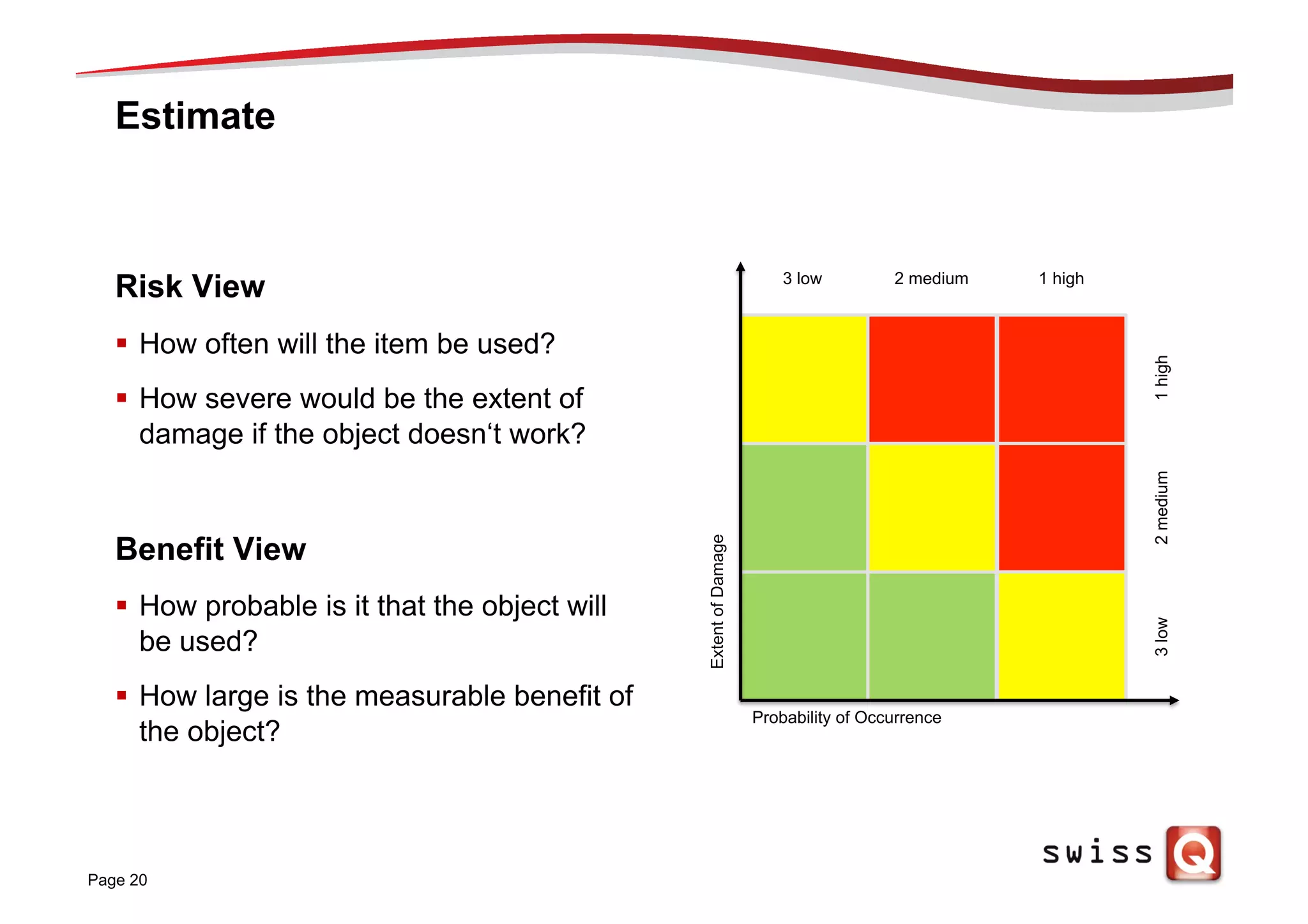

Page 20
Risk View
§  How often will the item be used?
§  How severe would be the extent of
damage if the object doesn‘t work?
Benefit View
§  How probable is it that the object will
be used?
§  How large is the measurable benefit of
the object?
1 high2 medium3 low
Probability of Occurrence
1high2medium3low
ExtentofDamage

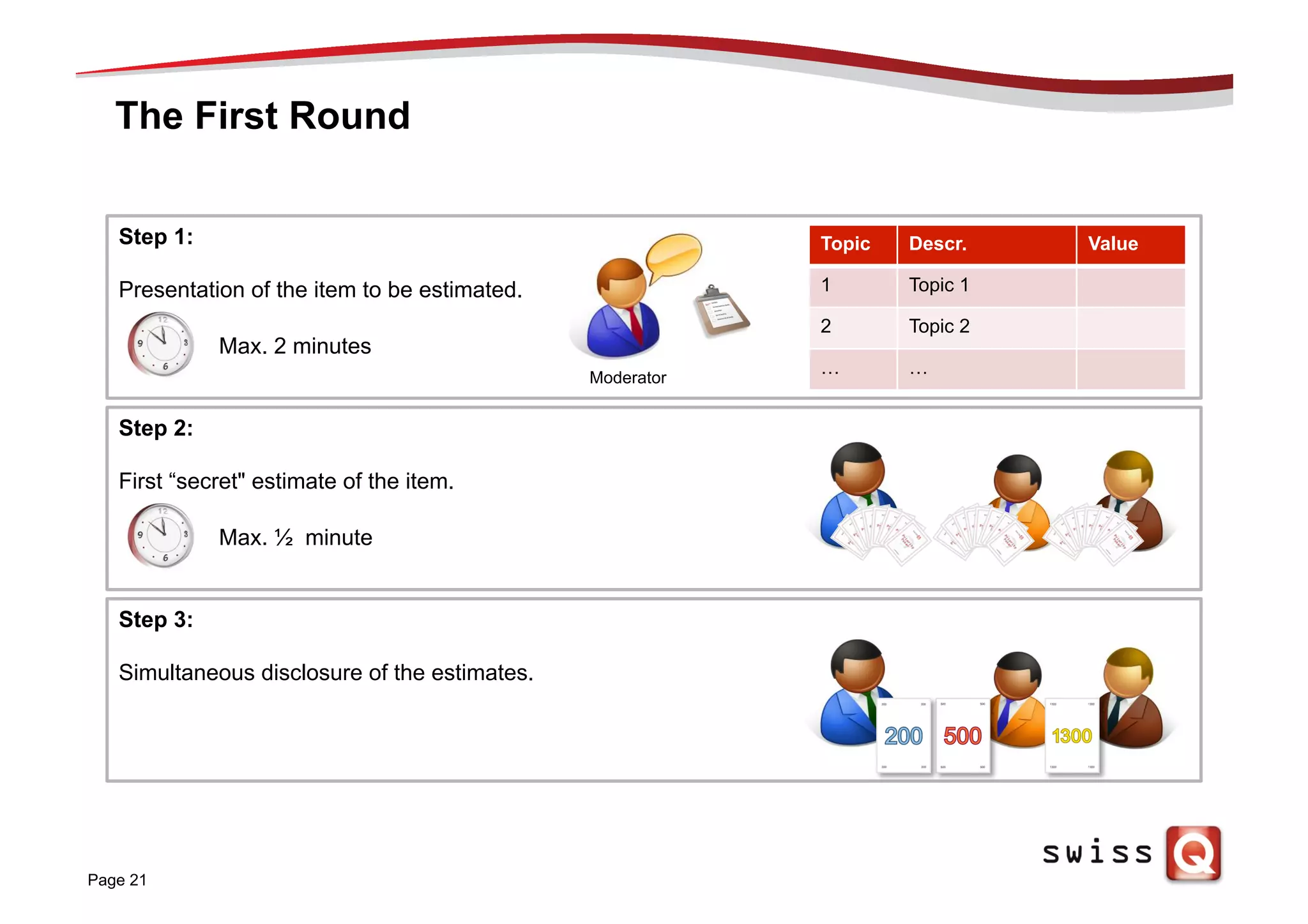

The First Round
Page 21
Step 1:
Presentation of the item to be estimated.
Moderator
Step 2:
First “secret" estimate of the item.
Step 3:
Simultaneous disclosure of the estimates.
Max. 2 minutes
Max. ½ minute
Topic Descr. Value
1 Topic 1
2 Topic 2
… …

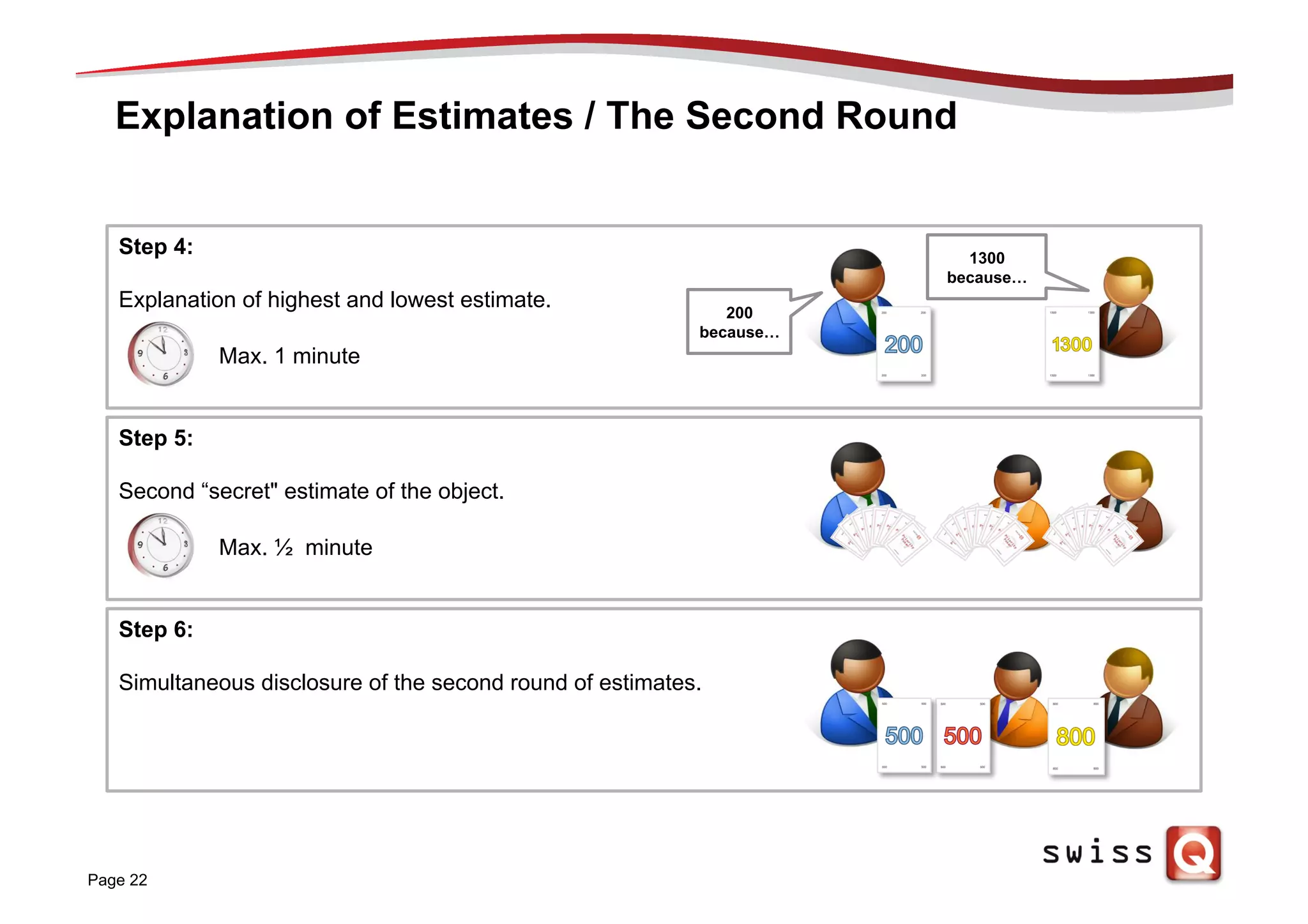

Explanation of Estimates / The Second Round
Page 22
Step 4:
Explanation of highest and lowest estimate.
Max. 1 minute
200
because…
1300
because…
Step 5:
Second “secret" estimate of the object.
Step 6:
Simultaneous disclosure of the second round of estimates.
Max. ½ minute

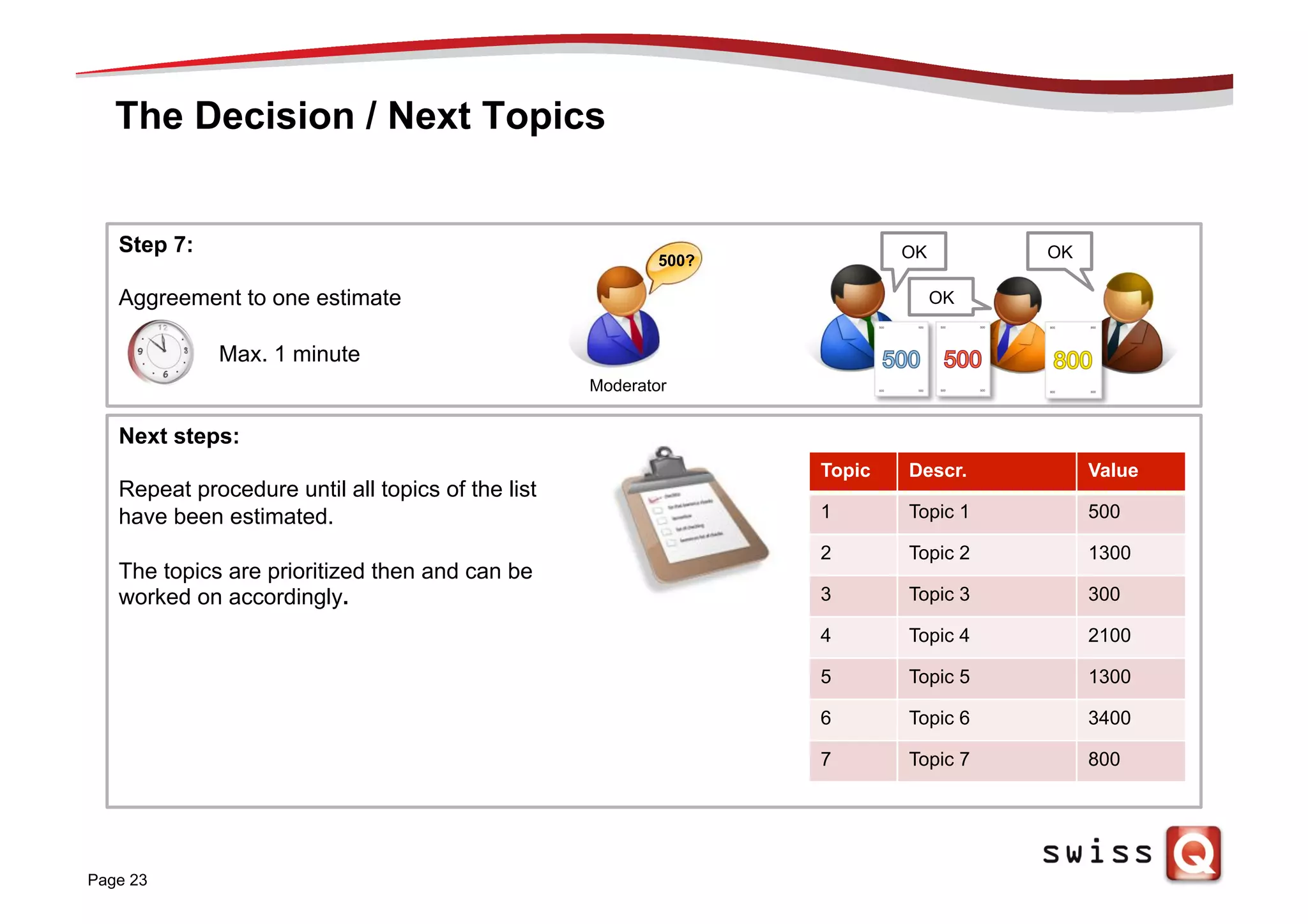

The Decision / Next Topics
Page 23
Next steps:
Repeat procedure until all topics of the list
have been estimated.
The topics are prioritized then and can be
worked on accordingly.
Step 7:
Aggreement to one estimate
Moderator
Max. 1 minute
500? OK
OK
OK
Topic Descr. Value
1 Topic 1 500
2 Topic 2 1300
3 Topic 3 300
4 Topic 4 2100
5 Topic 5 1300
6 Topic 6 3400
7 Topic 7 800

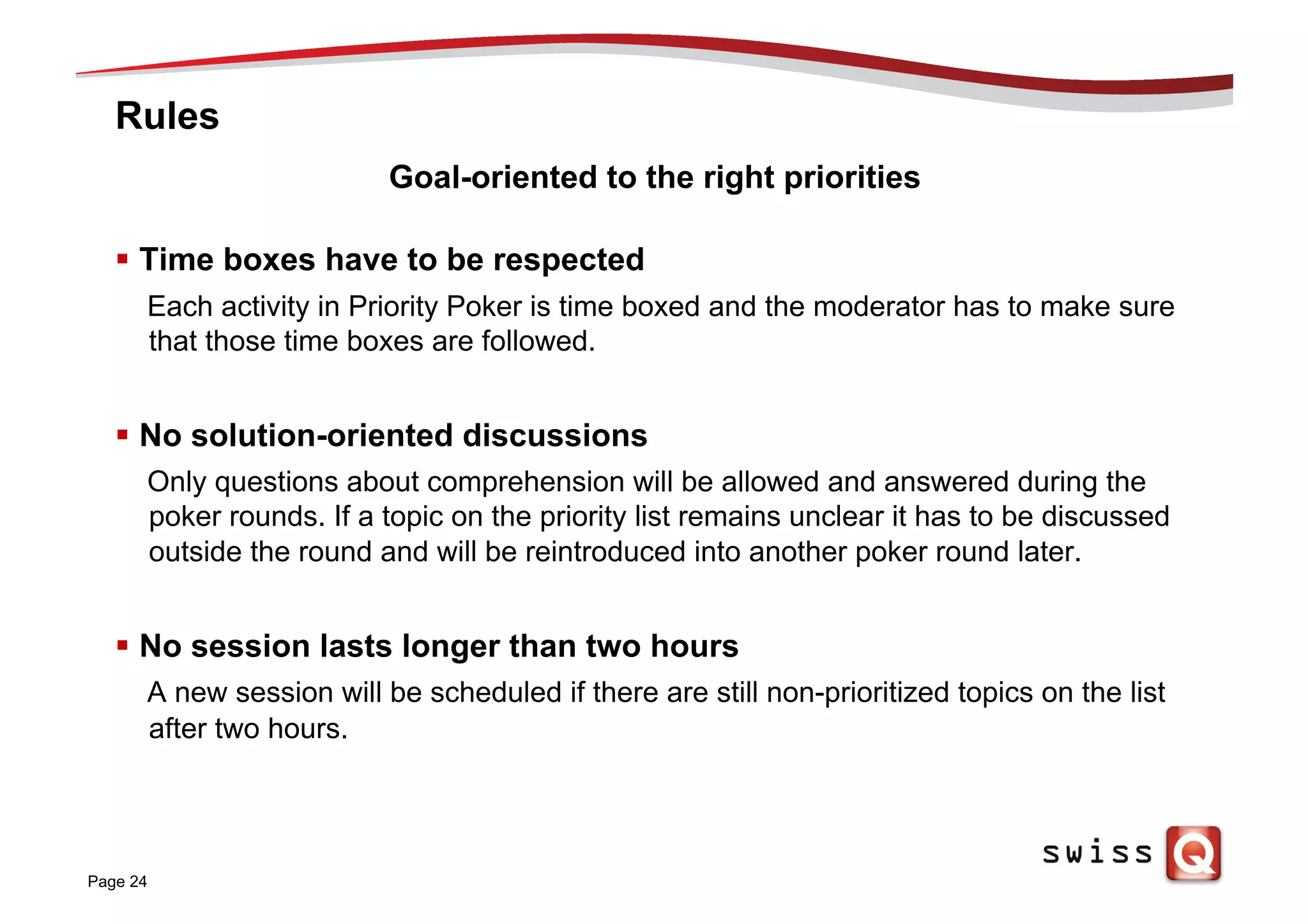

Rules
§  Time boxes have to be respected
Each activity in Priority Poker is time boxed and the moderator has to make sure
that those time boxes are followed.
§  No solution-oriented discussions
Only questions about comprehension will be allowed and answered during the
poker rounds. If a topic on the priority list remains unclear it has to be discussed
outside the round and will be reintroduced into another poker round later.
§  No session lasts longer than two hours
A new session will be scheduled if there are still non-prioritized topics on the list
after two hours.
Page 24
Goal-oriented to the right priorities
Page 25
Challenge
Approach
Priority Poker in Detail
Relative Estimates
Example
1
2
3
4
5
Summary6
Next Steps7
Relative Estimate of Country Size
Page 26

Country Estimate
Belgium 200*
Germany
France
Italy
Liechtenstein
The Netherlands
Norway
Sweden
Switzerland
Spain
* = serves as a reference value for the other estimates
Relative Estimate of Country Size

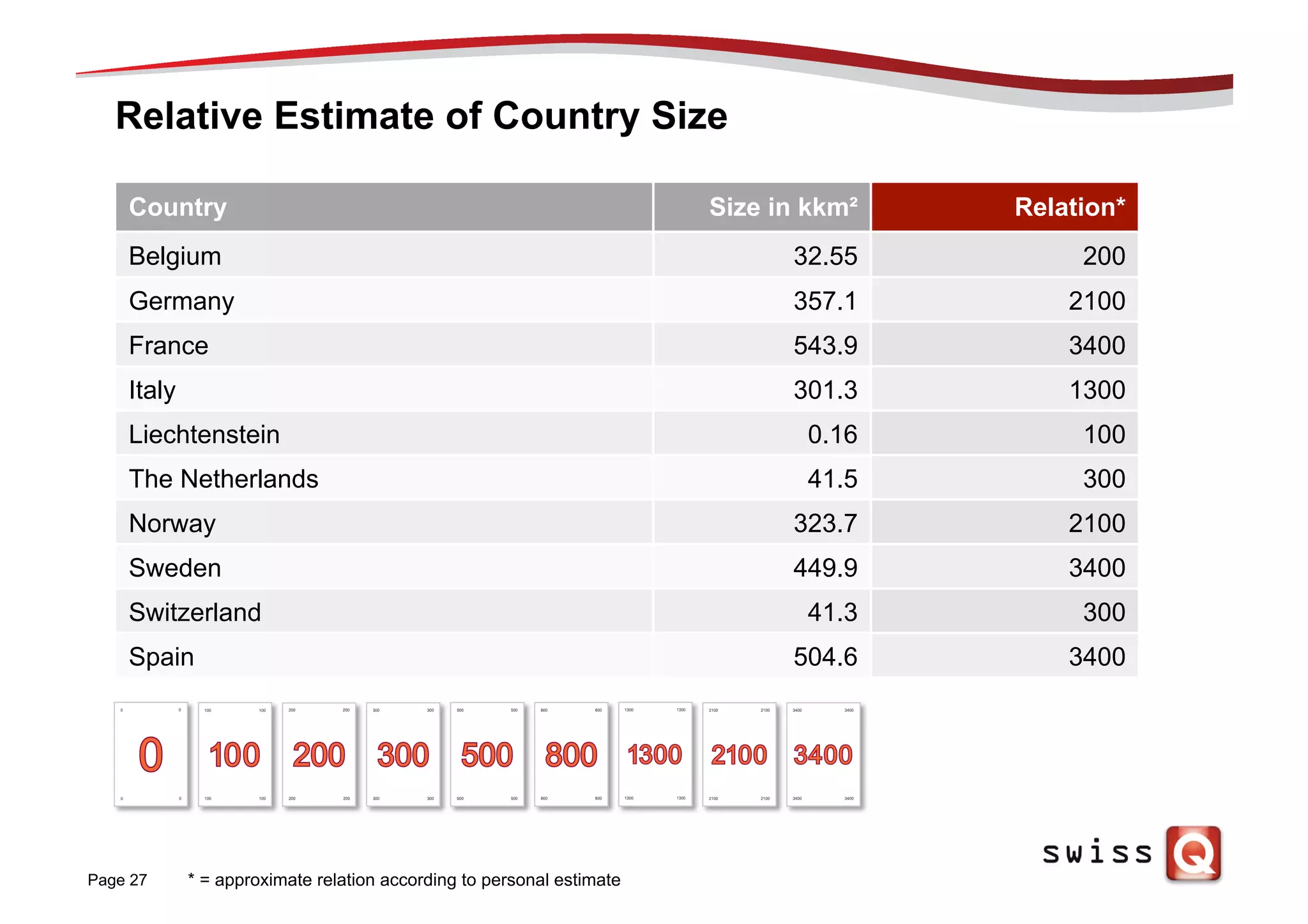

Page 27
Country Size in kkm² Relation*
Belgium 32.55 200
Germany 357.1 2100
France 543.9 3400
Italy 301.3 1300
Liechtenstein 0.16 100
The Netherlands 41.5 300
Norway 323.7 2100
Sweden 449.9 3400
Switzerland 41.3 300
Spain 504.6 3400
* = approximate relation according to personal estimate
Page 28
Challenge
Approach
Priority Poker in Detail
Relative Estimates
Example
1
2
3
4
5
Summary6
Next Steps7
Exercise: How Big is the Dog?
§  Bernese mountain dog
§  Chihuahua
§  Alsatian
§  Dachshund
§  Mastino
§  Collie
§  Greyhound
Page 29
Additional Information
Page 30

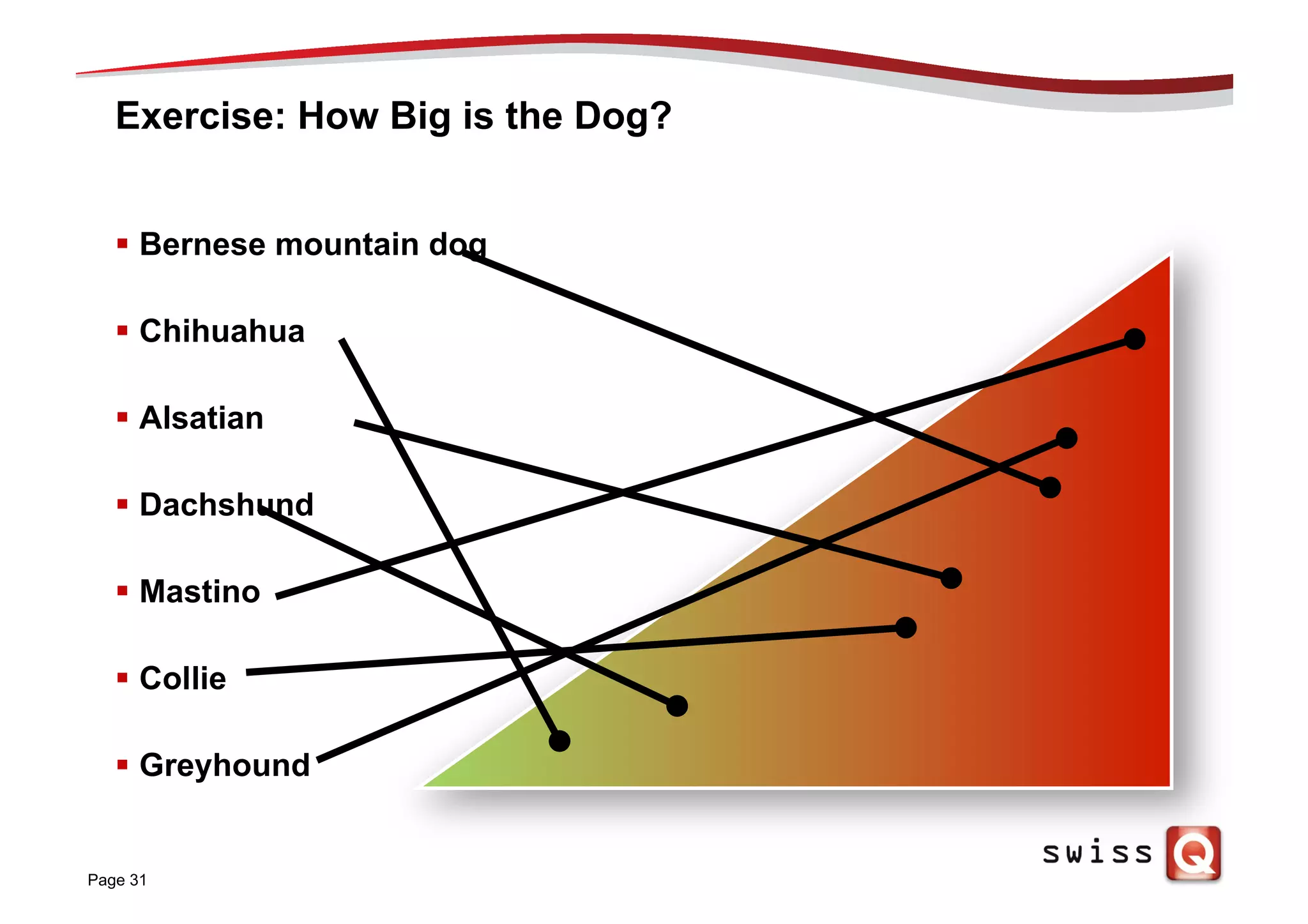

Exercise: How Big is the Dog?
§  Bernese mountain dog
§  Chihuahua
§  Alsatian
§  Dachshund
§  Mastino
§  Collie
§  Greyhound
Page 31
Page 32
Challenge
Approach
Priority Poker in Detail
Relative Estimates
Example
1
2
3
4
5
Summary6
Next Steps7
Priority Poker works because...
§  Priority Poker brings together different experts and decision makers.
These experts make up a „cross-functional“ team uniting all
important disciplines, and therefore constitute the best team to set
the priorities.
§  The active exchange during the Priority Poker session ensures the
information flow between those experts and thus leads to a common
view of the priorities which is supported by all parties.
§  And it‘s fun!
Page 33
Priority Poker can be used for (practically) anything!
§  Project plans and activities
§  Design of roadmaps
§  Release and product planning
§  User stories
§  Evaluation of ideas and innovation
§  Nutritional value of food...
§  ... and much more!
Page 34
Page 35
Challenge
Approach
Priority Poker in Detail
Relative Estimates
Example
1
2
3
4
5
Summary6
Next Steps7

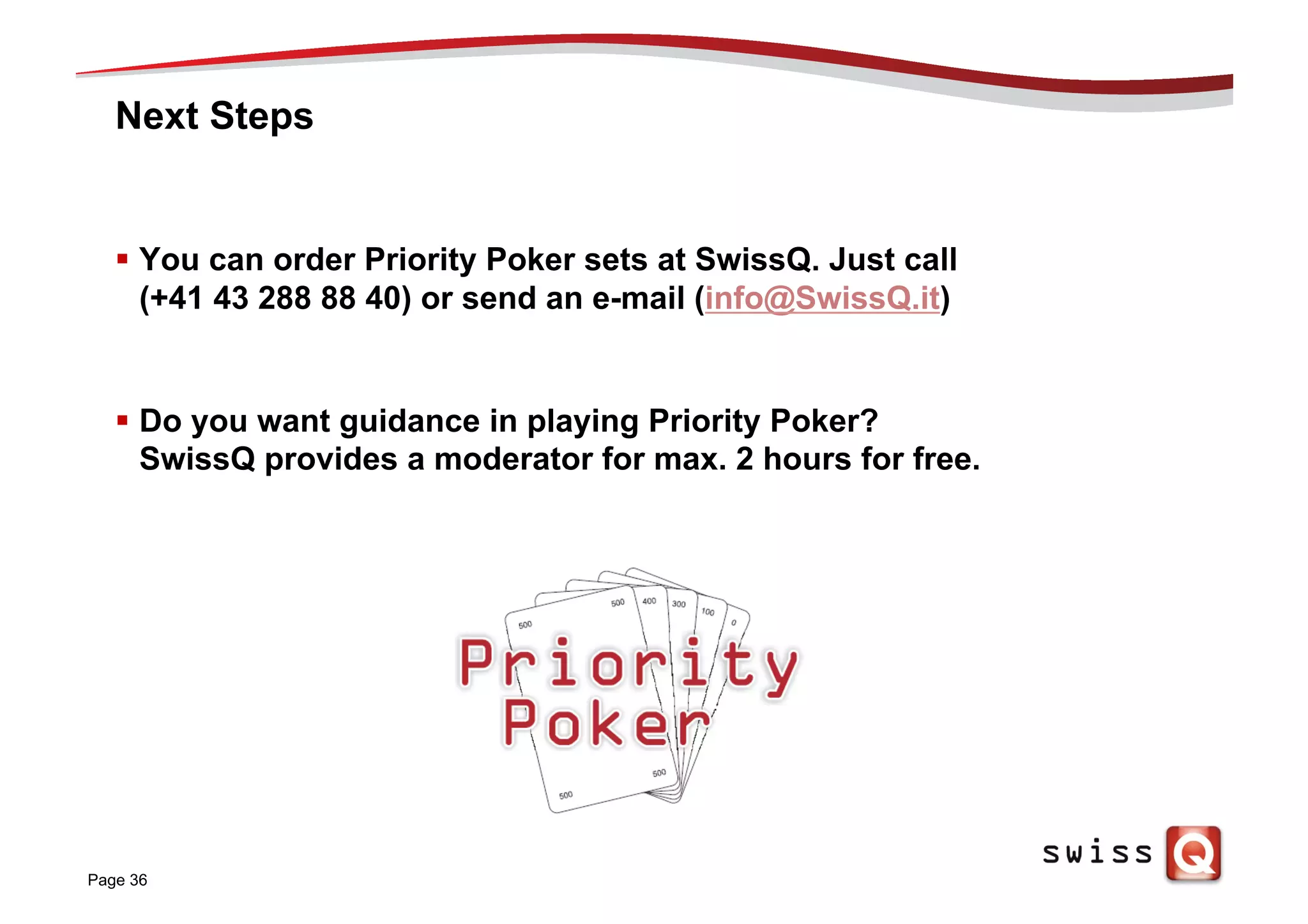

Next Steps
§  You can order Priority Poker sets at SwissQ. Just call
(+41 43 288 88 40) or send an e-mail (info@SwissQ.it)
§  Do you want guidance in playing Priority Poker?
SwissQ provides a moderator for max. 2 hours for free.
Page 36

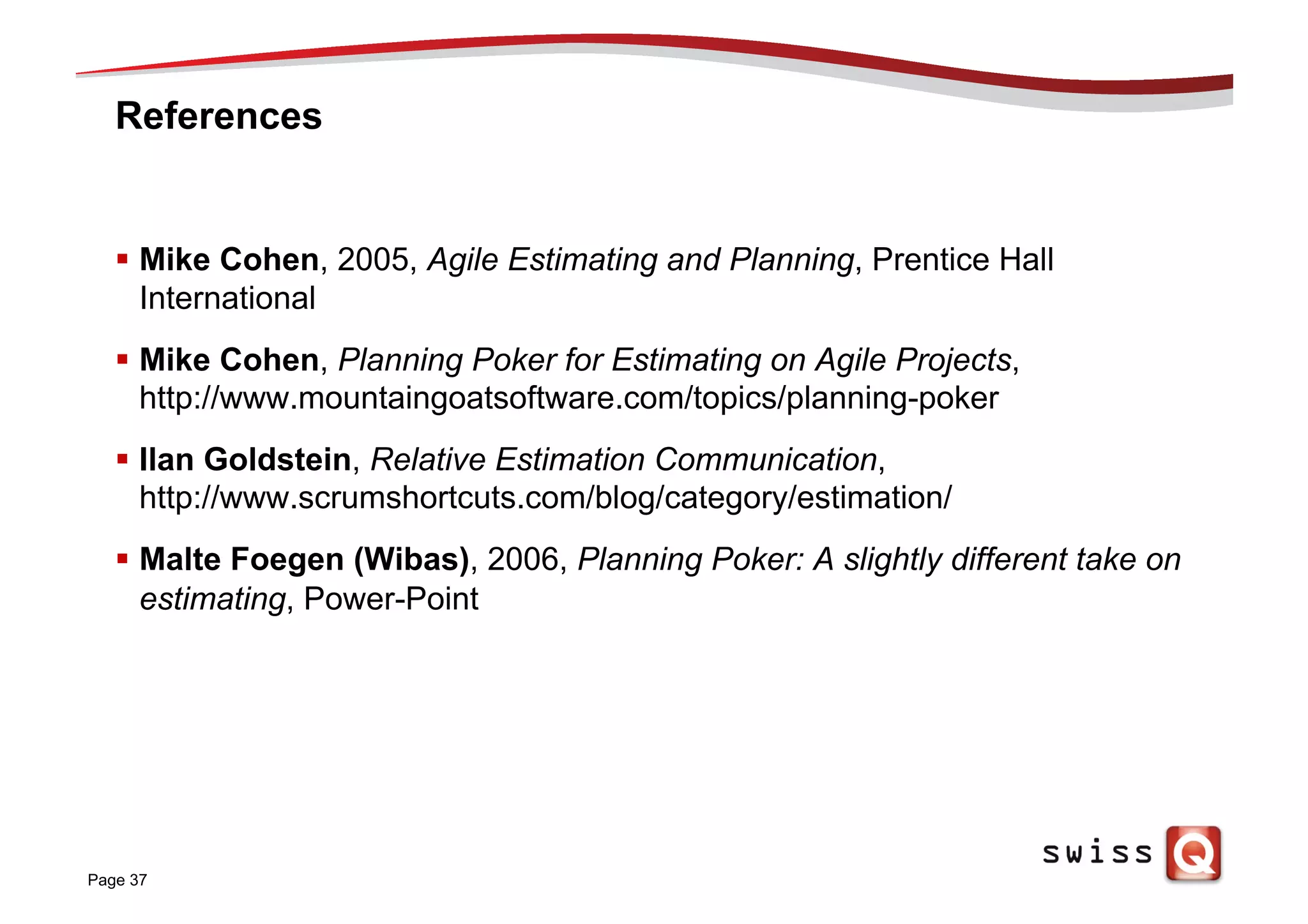

References
§  Mike Cohen, 2005, Agile Estimating and Planning, Prentice Hall
International
§  Mike Cohen, Planning Poker for Estimating on Agile Projects,
http://www.mountaingoatsoftware.com/topics/planning-poker
§  Ilan Goldstein, Relative Estimation Communication,
http://www.scrumshortcuts.com/blog/category/estimation/
§  Malte Foegen (Wibas), 2006, Planning Poker: A slightly different take on
estimating, Power-Point
Page 37

Introduction Priority Poker (En)

  • 1.
    Priority  Poker   Introductionand Example SwissQ, June 2012
  • 2.
    Page 2 Herausforderung Approach Priority Pokerin Detail Relative Estimates Example 1 2 3 4 5 Summary6 Next Steps7 Challenge
  • 3.
    Prioritization §  The wordprioritization derives from the Latin adjective „prior“ for earlier, first. §  Prioritization helps to allocate resources by sorting tasks, problems or other items according to their § importance (relevance, criticality) and/or their § urgency (short/middle/long term)* §  The purpose is to usefully allocate the limited (financial) resources, capacities and time. Page 3 * Source: wikipedia.de
  • 4.
    The Eisenhower Method Page4 §  Well known and self-explanatory §  But, in everyday life the urgent supersedes the important §  When something gets urgent, it is mostly already too late §  Often, a lot is urgent and important (thus, it isn‘t divisible or even manageable any more) not urgent urgent importantunimportant
  • 5.
    Which are thetrue priorities? Page 5 Existing prioritization is often too superficial and does not really address the very (un-)critical topics. ProbabilityofOccurrence Extent of Damage ProbabilityofOccurrence Impact on the Project (deadlines, costs, quality) low high low medium high lowhigh low <25% medium 25%-75% high >75%
  • 6.
    Different Views! Page 6 Eachstakeholder has his own view of „what is how important“. Project Manager BA‘s / Dev‘s / Testers Customer End User Suppliers Specialists ManagementBusiness Additionally: -  Common understanding -  Understand each others needs -  All information available
  • 7.
    Challenges §  Current modelsoften don‘t help in identifying the really important elements §  80% are priority 1 (or priority AAAAAA+++) §  The focus is not on the really critical or profitable topics §  Important stakeholders are often not included in the process, which results in a lot of disagreement about priorities §  The social process of creating a mutual understanding is ignored Page 7
  • 8.
    Page 8 Challenge Approach Priority Pokerin Detail Relative Estimates Example 1 2 3 4 5 Summary6 Next Steps7
  • 9.
    Prioritization u Is a unitof measurement u Is a middle way between subjective and objective evaluation Priority Poker provides this middle way Ø  All project members who are important for prioritization get involved Ø  Individual first estimates followed by discussion Ø  Final decision by the team after the second estimate Page 9
  • 10.
    Use of Relations Page10 Not important Extremely important The relative evaluation reveals their importance in relation to each other.
  • 11.
    Evaluation with FibonacciNumbers Page 11 100 100 200 300 800 500 1300 2100 3400
  • 12.
    Relative Estimates Page 12 Workingwith relative estimates is often easier and more precise. They remain valid even if the assumed basis of the relation changes. Pro‘s Con‘s §  First estimates take more time, until the team is in the „flow“ §  Reference objects are needed as a point of orientation for estimators §  Risk of solution-oriented or other philosophical discussions during sessions §  Risk that single estimators dominate the group or use their political power §  Relation mostly remains the same even if the absolute value of an item changes (e.g. complexity or number of users) §  There are no discussions about absolute values (LoC, number of users, etc.) §  The really important elements are identified very quickly. So do the unimportant ones. §  If an element is extremely important it can be split up for more deliberate processing
  • 13.
    The Social Process Page13 The social process leads to a common view of priorities and risks. Project Manager Business Analysts Management UsersDevelopers Business
  • 14.
    The Procedure alsoincludes... §  Estimate of Experts §  Knowledge is at hand §  Open questions can be answered §  Team estimate doesn’t put too much focus on experts §  Analogies §  Comparison of / relation to other items during estimation §  Disaggregation (maturity / dissolution) §  Splitting up elements because of too high complexity, risk, etc. §  Revealing and closing information gaps §  etc. Page 14
  • 15.
    What can beprioritized? §  Project portfolio §  Release and product planning §  Design of roadmaps §  Change requests §  Requirements §  Risks, tasks and activities §  Evaluation criteria (e.g. for value benefit analysis) §  Allocation of budget, resources §  Evaluation of ideas and innovation §  Nutritional value of food... §  ... and much more! Page 15
  • 16.
    Page 16 Challenge Approach Priority Pokerin Detail Relative Estimates Example 1 2 3 4 5 Summary6 Next Steps7
  • 17.
  • 18.
    Priority Poker Page 18 Whenplaying Priority Poker, all stakeholders set the priorities together. Be it for requirements, change requests, risks or test cases. §  Priority Poker uses the corresponding game cards (can be ordered at SwissQ) and a list of elements to be evaluated such as requirements, specifications, user stories, use cases, test objects, test cases or bugs. §  All relevant stakeholders participate, the selection and distribution of information has to be done beforehand. Each person receives a card set. §  A moderator - who doesn‘t play the game himself - is leading the poker session. He is responsible for the adherence to the time boxes and suppresses solution- oriented discussions.
  • 19.
    Card Values Page 19 Ineed a break! I need an explanation! Not important (cold) Extremely important (hot)
  • 20.
    Estimate Page 20 Risk View § How often will the item be used? §  How severe would be the extent of damage if the object doesn‘t work? Benefit View §  How probable is it that the object will be used? §  How large is the measurable benefit of the object? 1 high2 medium3 low Probability of Occurrence 1high2medium3low ExtentofDamage
  • 21.
    The First Round Page21 Step 1: Presentation of the item to be estimated. Moderator Step 2: First “secret" estimate of the item. Step 3: Simultaneous disclosure of the estimates. Max. 2 minutes Max. ½ minute Topic Descr. Value 1 Topic 1 2 Topic 2 … …
  • 22.
    Explanation of Estimates/ The Second Round Page 22 Step 4: Explanation of highest and lowest estimate. Max. 1 minute 200 because… 1300 because… Step 5: Second “secret" estimate of the object. Step 6: Simultaneous disclosure of the second round of estimates. Max. ½ minute
  • 23.
    The Decision /Next Topics Page 23 Next steps: Repeat procedure until all topics of the list have been estimated. The topics are prioritized then and can be worked on accordingly. Step 7: Aggreement to one estimate Moderator Max. 1 minute 500? OK OK OK Topic Descr. Value 1 Topic 1 500 2 Topic 2 1300 3 Topic 3 300 4 Topic 4 2100 5 Topic 5 1300 6 Topic 6 3400 7 Topic 7 800
  • 24.
    Rules §  Time boxeshave to be respected Each activity in Priority Poker is time boxed and the moderator has to make sure that those time boxes are followed. §  No solution-oriented discussions Only questions about comprehension will be allowed and answered during the poker rounds. If a topic on the priority list remains unclear it has to be discussed outside the round and will be reintroduced into another poker round later. §  No session lasts longer than two hours A new session will be scheduled if there are still non-prioritized topics on the list after two hours. Page 24 Goal-oriented to the right priorities
  • 25.
    Page 25 Challenge Approach Priority Pokerin Detail Relative Estimates Example 1 2 3 4 5 Summary6 Next Steps7
  • 26.
    Relative Estimate ofCountry Size Page 26 Country Estimate Belgium 200* Germany France Italy Liechtenstein The Netherlands Norway Sweden Switzerland Spain * = serves as a reference value for the other estimates
  • 27.
    Relative Estimate ofCountry Size Page 27 Country Size in kkm² Relation* Belgium 32.55 200 Germany 357.1 2100 France 543.9 3400 Italy 301.3 1300 Liechtenstein 0.16 100 The Netherlands 41.5 300 Norway 323.7 2100 Sweden 449.9 3400 Switzerland 41.3 300 Spain 504.6 3400 * = approximate relation according to personal estimate
  • 28.
    Page 28 Challenge Approach Priority Pokerin Detail Relative Estimates Example 1 2 3 4 5 Summary6 Next Steps7
  • 29.
    Exercise: How Bigis the Dog? §  Bernese mountain dog §  Chihuahua §  Alsatian §  Dachshund §  Mastino §  Collie §  Greyhound Page 29
  • 30.
  • 31.
    Exercise: How Bigis the Dog? §  Bernese mountain dog §  Chihuahua §  Alsatian §  Dachshund §  Mastino §  Collie §  Greyhound Page 31
  • 32.
    Page 32 Challenge Approach Priority Pokerin Detail Relative Estimates Example 1 2 3 4 5 Summary6 Next Steps7
  • 33.
    Priority Poker worksbecause... §  Priority Poker brings together different experts and decision makers. These experts make up a „cross-functional“ team uniting all important disciplines, and therefore constitute the best team to set the priorities. §  The active exchange during the Priority Poker session ensures the information flow between those experts and thus leads to a common view of the priorities which is supported by all parties. §  And it‘s fun! Page 33
  • 34.
    Priority Poker canbe used for (practically) anything! §  Project plans and activities §  Design of roadmaps §  Release and product planning §  User stories §  Evaluation of ideas and innovation §  Nutritional value of food... §  ... and much more! Page 34
  • 35.
    Page 35 Challenge Approach Priority Pokerin Detail Relative Estimates Example 1 2 3 4 5 Summary6 Next Steps7
  • 36.
    Next Steps §  Youcan order Priority Poker sets at SwissQ. Just call (+41 43 288 88 40) or send an e-mail (info@SwissQ.it) §  Do you want guidance in playing Priority Poker? SwissQ provides a moderator for max. 2 hours for free. Page 36
  • 37.
    References §  Mike Cohen,2005, Agile Estimating and Planning, Prentice Hall International §  Mike Cohen, Planning Poker for Estimating on Agile Projects, http://www.mountaingoatsoftware.com/topics/planning-poker §  Ilan Goldstein, Relative Estimation Communication, http://www.scrumshortcuts.com/blog/category/estimation/ §  Malte Foegen (Wibas), 2006, Planning Poker: A slightly different take on estimating, Power-Point Page 37
