Hydro Power

      Presented by :
      Prof. Javed Taili

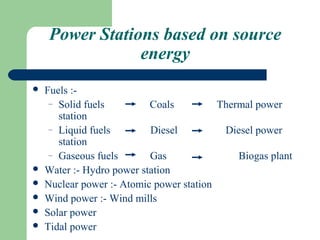

Power Stations based on source
                 energy
   Fuels :-
     – Solid fuels         Coals          Thermal power
       station
     – Liquid fuels        Diesel          Diesel power
       station
     – Gaseous fuels       Gas                Biogas plant
   Water :- Hydro power station
   Nuclear power :- Atomic power station
   Wind power :- Wind mills
   Solar power
   Tidal power
Advantages of Hydro power
   Once the dam is built, the energy is virtually free
   A clean source of renewable energy
   Has the capacity to provide base and peak-load
   Has the capacity to follow demand fluctuations almost
    instantly
   Offers a quick response to failings in power grids
   No waste or pollution produced
   Much more reliable than wind, solar or wave power

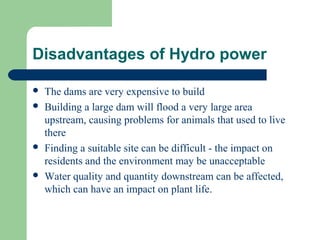

Disadvantages of Hydro power

   The dams are very expensive to build
   Building a large dam will flood a very large area
    upstream, causing problems for animals that used to live
    there
   Finding a suitable site can be difficult - the impact on
    residents and the environment may be unacceptable
   Water quality and quantity downstream can be affected,
    which can have an impact on plant life.
How Hydropower Works!
   Hydrologic cycle

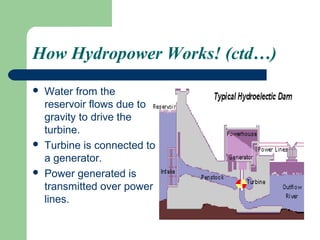

How Hydropower Works! (ctd…)
   Water from the
    reservoir flows due to
    gravity to drive the
    turbine.
   Turbine is connected to
    a generator.
   Power generated is
    transmitted over power
    lines.
POTENTIAL

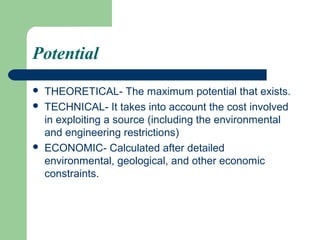

Potential
   THEORETICAL- The maximum potential that exists.
   TECHNICAL- It takes into account the cost involved
    in exploiting a source (including the environmental
    and engineering restrictions)
   ECONOMIC- Calculated after detailed
    environmental, geological, and other economic
    constraints.
UNDP estimates
   Theoretical potential is about 40,500 TWh per year.
   The technical potential is about 14,300 TWh per year.
   The economic potential is about 8100 TWh per year.
   The world installed hydro capacity currently stands at 694
    GW.
   In the 1980s the percentage of contribution by
    hydroelectric power was about 8 to 9%.
   Currently the percentage of contribution by hydroelectric
    power is close to 20% of the total energy generation.

Global Installed Capacity
Under Construction…

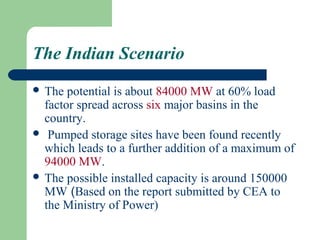

The Indian Scenario
 The  potential is about 84000 MW at 60% load
  factor spread across six major basins in the
  country.
 Pumped storage sites have been found recently
  which leads to a further addition of a maximum of
  94000 MW.
 The possible installed capacity is around 150000
  MW (Based on the report submitted by CEA to
  the Ministry of Power)

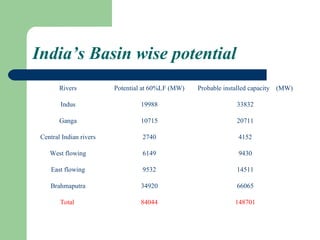

India’s Basin wise potential
        Rivers           Potential at 60%LF (MW)   Probable installed capacity (MW)

        Indus                    19988                          33832

        Ganga                    10715                          20711

 Central Indian rivers            2740                          4152

    West flowing                  6149                          9430

     East flowing                 9532                          14511

    Brahmaputra                  34920                          66065

        Total                    84044                         148701

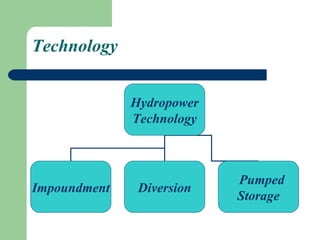

TECHNOLOGY
Technology

              Hydropower
              Technology

                           Pumped
Impoundment    Diversion
                           Storage
Impoundment facility
Dam Types

 Arch
   Gravity
   Buttress

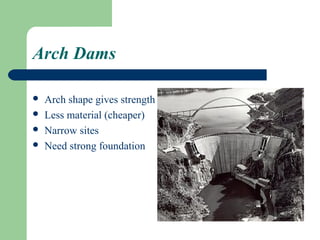

Arch Dams

   Arch shape gives strength
   Less material (cheaper)
   Narrow sites
   Need strong foundation

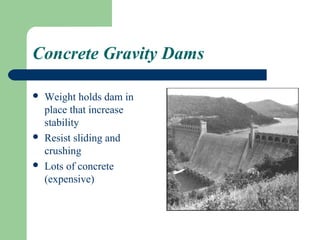

Concrete Gravity Dams

   Weight holds dam in
    place that increase
    stability
   Resist sliding and
    crushing
   Lots of concrete
    (expensive)

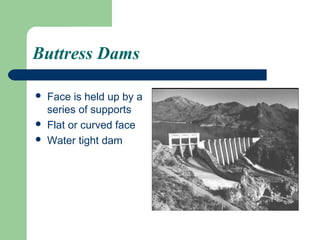

Buttress Dams

   Face is held up by a
    series of supports
   Flat or curved face
   Water tight dam

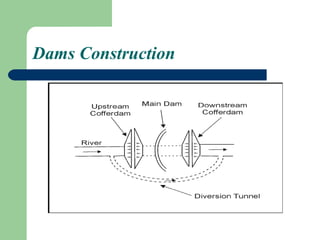

Dams Construction
Pumped Storage
   During Storage, water
    pumped from lower
    reservoir to higher one.
   Water released back to
    lower reservoir to
    generate electricity.

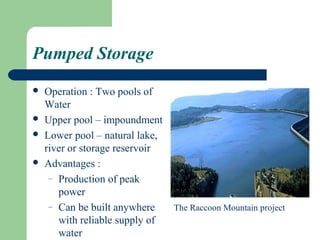

Pumped Storage
   Operation : Two pools of
    Water
   Upper pool – impoundment
   Lower pool – natural lake,
    river or storage reservoir
   Advantages :
     – Production of peak
       power
     – Can be built anywhere     The Raccoon Mountain project
       with reliable supply of
       water
Sizes of Hydropower Plants

 Definitionsmay vary.
 Large plants : capacity >30 MW
 Small Plants : capacity b/w 100 kW to 30 MW
 Micro Plants : capacity up to 100 kW
Large Scale Hydropower plant

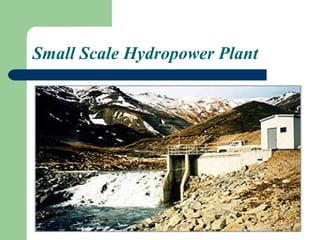

Small Scale Hydropower Plant

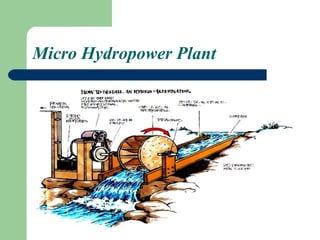

Micro Hydropower Plant

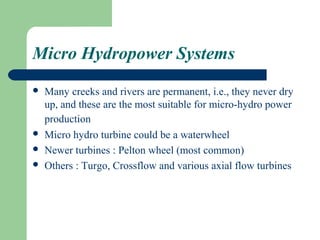

Micro Hydropower Systems
   Many creeks and rivers are permanent, i.e., they never dry
    up, and these are the most suitable for micro-hydro power
    production
   Micro hydro turbine could be a waterwheel
   Newer turbines : Pelton wheel (most common)
   Others : Turgo, Crossflow and various axial flow turbines
Generating Technologies
   Types of Hydro Turbines:
     – Impulse turbines
          Pelton Wheel
          Cross Flow Turbines
     – Reaction turbines
          Propeller Turbines : Bulb turbine, Straflo, Tube Turbine,

                                Kaplan Turbine
          Francis Turbines
          Kinetic Turbines

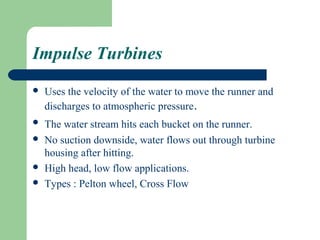

Impulse Turbines
   Uses the velocity of the water to move the runner and
    discharges to atmospheric pressure.
   The water stream hits each bucket on the runner.
   No suction downside, water flows out through turbine
    housing after hitting.
   High head, low flow applications.
   Types : Pelton wheel, Cross Flow
Pelton Wheels
   Nozzles direct forceful
    streams of water against a
    series of spoon-shaped
    buckets mounted around
    the edge of a wheel.
   Each bucket reverses the
    flow of water and this
    impulse spins the turbine.
Pelton Wheels (continued…)

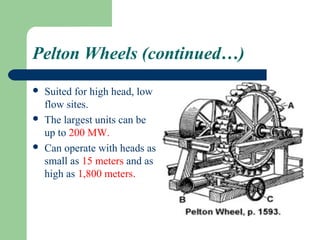

   Suited for high head, low
    flow sites.
   The largest units can be
    up to 200 MW.
   Can operate with heads as
    small as 15 meters and as
    high as 1,800 meters.
Cross Flow Turbines
   drum-shaped
   elongated, rectangular-
    section nozzle directed
    against curved vanes on a
    cylindrically shaped
    runner
   “squirrel cage” blower
    water flows through the
    blades twice

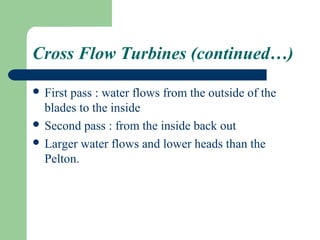

Cross Flow Turbines (continued…)

 Firstpass : water flows from the outside of the
  blades to the inside
 Second pass : from the inside back out
 Larger water flows and lower heads than the
  Pelton.

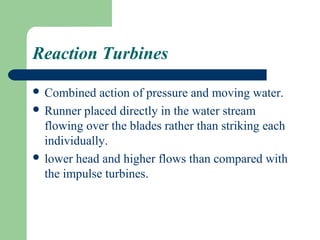

Reaction Turbines

 Combined   action of pressure and moving water.
 Runner placed directly in the water stream
  flowing over the blades rather than striking each
  individually.
 lower head and higher flows than compared with
  the impulse turbines.

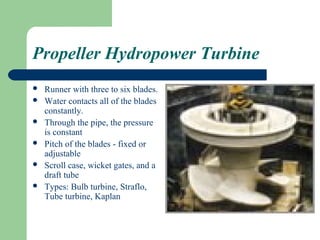

Propeller Hydropower Turbine
   Runner with three to six blades.
   Water contacts all of the blades
    constantly.
   Through the pipe, the pressure
    is constant
   Pitch of the blades - fixed or
    adjustable
   Scroll case, wicket gates, and a
    draft tube
   Types: Bulb turbine, Straflo,
    Tube turbine, Kaplan
Bulb Turbine
   The turbine and
    generator are a sealed
    unit placed directly in
    the water stream.

Others…
   Straflo : The generator is attached directly to the
    perimeter of the turbine.
   Tube Turbine : The penstock bends just before or after the
    runner, allowing a straight line connection to the generator
   Kaplan : Both the blades and the wicket gates are
    adjustable, allowing for a wider range of operation

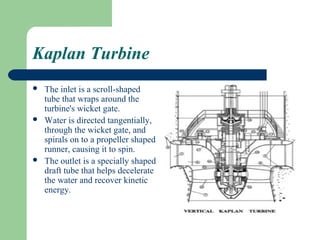

Kaplan Turbine
   The inlet is a scroll-shaped
    tube that wraps around the
    turbine's wicket gate.
   Water is directed tangentially,
    through the wicket gate, and
    spirals on to a propeller shaped
    runner, causing it to spin.
   The outlet is a specially shaped
    draft tube that helps decelerate
    the water and recover kinetic
    energy.

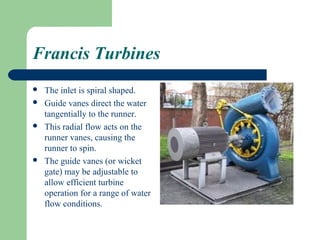

Francis Turbines
   The inlet is spiral shaped.
   Guide vanes direct the water
    tangentially to the runner.
   This radial flow acts on the
    runner vanes, causing the
    runner to spin.
   The guide vanes (or wicket
    gate) may be adjustable to
    allow efficient turbine
    operation for a range of water
    flow conditions.
Francis Turbines (continued…)
                   Best suited for sites with
                    high flows and low to
                    medium head.
                   Efficiency of 90%.
                   expensive to design,
                    manufacture and install,
                    but operate for decades.

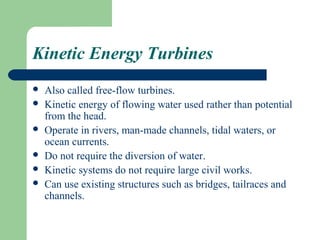

Kinetic Energy Turbines
   Also called free-flow turbines.
   Kinetic energy of flowing water used rather than potential
    from the head.
   Operate in rivers, man-made channels, tidal waters, or
    ocean currents.
   Do not require the diversion of water.
   Kinetic systems do not require large civil works.
   Can use existing structures such as bridges, tailraces and
    channels.

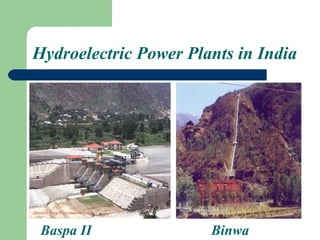

Hydroelectric Power Plants in India

 Baspa II              Binwa
Continued …

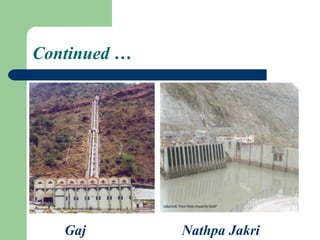

   Gaj        Nathpa Jakri
Continued…

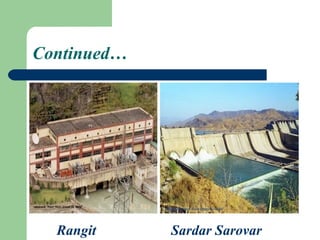

  Rangit     Sardar Sarovar
ENVIRONMENTAL IMPACT

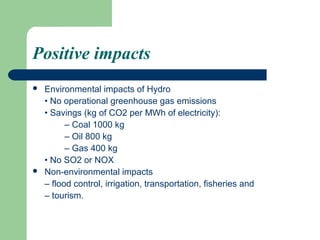

Positive impacts
   Environmental impacts of Hydro
    • No operational greenhouse gas emissions
    • Savings (kg of CO2 per MWh of electricity):
          – Coal 1000 kg
          – Oil 800 kg
          – Gas 400 kg
    • No SO2 or NOX
   Non-environmental impacts
    – flood control, irrigation, transportation, fisheries and
    – tourism.

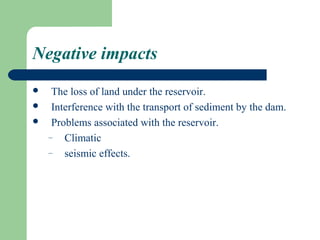

Negative impacts
    The loss of land under the reservoir.
    Interference with the transport of sediment by the dam.
    Problems associated with the reservoir.
    – Climatic
    – seismic effects.

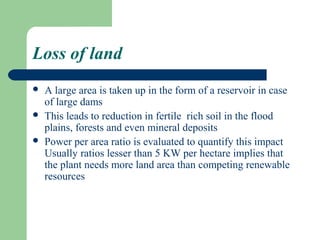

Loss of land
   A large area is taken up in the form of a reservoir in case
    of large dams
   This leads to reduction in fertile rich soil in the flood
    plains, forests and even mineral deposits
   Power per area ratio is evaluated to quantify this impact
    Usually ratios lesser than 5 KW per hectare implies that
    the plant needs more land area than competing renewable
    resources

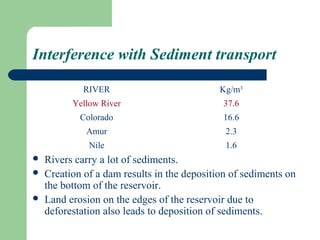

Interference with Sediment transport

             RIVER                           Kg/m3
          Yellow River                        37.6
            Colorado                          16.6
             Amur                             2.3
              Nile                            1.6
   Rivers carry a lot of sediments.
   Creation of a dam results in the deposition of sediments on
    the bottom of the reservoir.
   Land erosion on the edges of the reservoir due to
    deforestation also leads to deposition of sediments.

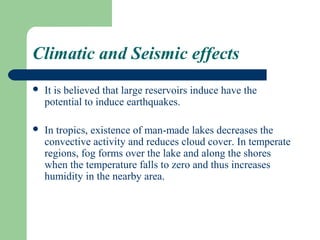

Climatic and Seismic effects
   It is believed that large reservoirs induce have the
    potential to induce earthquakes.

   In tropics, existence of man-made lakes decreases the
    convective activity and reduces cloud cover. In temperate
    regions, fog forms over the lake and along the shores
    when the temperature falls to zero and thus increases
    humidity in the nearby area.

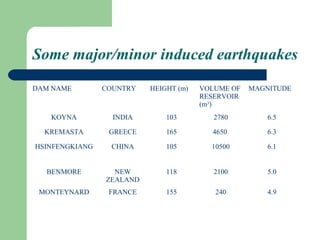

Some major/minor induced earthquakes
DAM NAME        COUNTRY   HEIGHT (m)   VOLUME OF   MAGNITUDE
                                       RESERVOIR
                                       (m3)
   KOYNA          INDIA       103         2780        6.5

  KREMASTA       GREECE       165        4650         6.3

HSINFENGKIANG    CHINA        105        10500        6.1

  BENMORE         NEW         118         2100        5.0
                ZEALAND
 MONTEYNARD      FRANCE       155         240         4.9
Other problems
   Many fishes require flowing water for reproduction and
    cannot adapt to stagnant resulting in the reduction in its
    population.
   Heating of the reservoirs may lead to decrease in the
    dissolved oxygen levels.
   Other water-borne diseases like malaria, river-blindness
    become prevalent.
Methods to alleviate the negative impact

   Creation of ecological reserves.
   Limiting dam construction to allow substantial free
    flowing water.
   Building sluice gates and passes that help prevent fishes
    getting trapped.
ECONOMICS OF HYDRO POWER
Local HP Economics
   Development, operating, and maintenance costs, and electricity
    generation
   First check if site is developed or not.
   If a dam does not exist, several things to consider are: land/land
    rights, structures and improvements, equipment, reservoirs, dams,
    waterways, roads, railroads, and bridges.
   Development costs include recreation, preserving historical and
    archeological sites, maintaining water quality, protecting fish and
    wildlife.
Construction Costs

 Hydro   costs are highly site specific
   Dams are very expensive
   Civil works form two-thirds of total cost
       – Varies 25 to 80%
   Large Western schemes: $ 1200/kW
   Developing nations: $ 800 to $ 2000/kW
   Compare with CCGT: $ 600 to $800/kW
Production Costs

 Compared   with fossil-fuelled plant
 – No fuel costs
 – Low O&M cost
 – Long lifetime
Case study
Sardar Sarovar Dam
   Project planning started as
    early as 1946.
   Project still under
    construction with a part of
    the dam in operation.
   A concrete gravity dam,
    1210 meters (3970 feet) in
    length and with a maximum
    height of 163 meters
   The gross storage capacity of the reservoir is 0.95 M.
    ha.m. (7.7 MAF) while live storage capacity is 0.58
    M.ha.m. (4.75 MAF).
   The total project cost was estimated at Rs. 49 billion at
    1987 price levels.
   There are two power houses project- 1200 MW River Bed
    Power House and 250 MW Canal Head Power House.
    Power benefits are shared among Madhya Pradesh,
    Maharashtra and Gujarat in the ratio of 57:27:16
    respectively.

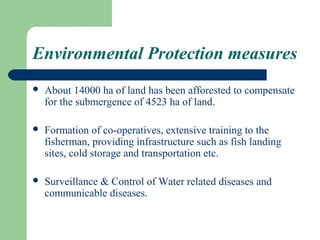

Environmental Protection measures
   About 14000 ha of land has been afforested to compensate
    for the submergence of 4523 ha of land.

   Formation of co-operatives, extensive training to the
    fisherman, providing infrastructure such as fish landing
    sites, cold storage and transportation etc.

   Surveillance & Control of Water related diseases and
    communicable diseases.

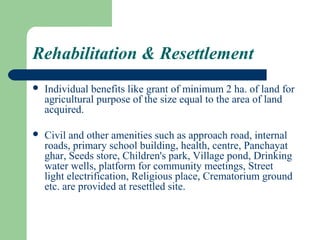

Rehabilitation & Resettlement
   Individual benefits like grant of minimum 2 ha. of land for
    agricultural purpose of the size equal to the area of land
    acquired.

   Civil and other amenities such as approach road, internal
    roads, primary school building, health, centre, Panchayat
    ghar, Seeds store, Children's park, Village pond, Drinking
    water wells, platform for community meetings, Street
    light electrification, Religious place, Crematorium ground
    etc. are provided at resettled site.
Hydro p-s

Hydro p-s

  • 1.
    Hydro Power Presented by : Prof. Javed Taili
  • 2.
    Power Stations basedon source energy  Fuels :- – Solid fuels Coals Thermal power station – Liquid fuels Diesel Diesel power station – Gaseous fuels Gas Biogas plant  Water :- Hydro power station  Nuclear power :- Atomic power station  Wind power :- Wind mills  Solar power  Tidal power
  • 3.
    Advantages of Hydropower  Once the dam is built, the energy is virtually free  A clean source of renewable energy  Has the capacity to provide base and peak-load  Has the capacity to follow demand fluctuations almost instantly  Offers a quick response to failings in power grids  No waste or pollution produced  Much more reliable than wind, solar or wave power
  • 4.
    Disadvantages of Hydropower  The dams are very expensive to build  Building a large dam will flood a very large area upstream, causing problems for animals that used to live there  Finding a suitable site can be difficult - the impact on residents and the environment may be unacceptable  Water quality and quantity downstream can be affected, which can have an impact on plant life.
  • 5.
    How Hydropower Works!  Hydrologic cycle
  • 6.
    How Hydropower Works!(ctd…)  Water from the reservoir flows due to gravity to drive the turbine.  Turbine is connected to a generator.  Power generated is transmitted over power lines.
  • 7.
  • 8.
    Potential  THEORETICAL- The maximum potential that exists.  TECHNICAL- It takes into account the cost involved in exploiting a source (including the environmental and engineering restrictions)  ECONOMIC- Calculated after detailed environmental, geological, and other economic constraints.
  • 9.
    UNDP estimates  Theoretical potential is about 40,500 TWh per year.  The technical potential is about 14,300 TWh per year.  The economic potential is about 8100 TWh per year.  The world installed hydro capacity currently stands at 694 GW.  In the 1980s the percentage of contribution by hydroelectric power was about 8 to 9%.  Currently the percentage of contribution by hydroelectric power is close to 20% of the total energy generation.
  • 10.
  • 11.
  • 12.
    The Indian Scenario The potential is about 84000 MW at 60% load factor spread across six major basins in the country.  Pumped storage sites have been found recently which leads to a further addition of a maximum of 94000 MW.  The possible installed capacity is around 150000 MW (Based on the report submitted by CEA to the Ministry of Power)
  • 13.
    India’s Basin wisepotential Rivers Potential at 60%LF (MW) Probable installed capacity (MW) Indus 19988 33832 Ganga 10715 20711 Central Indian rivers 2740 4152 West flowing 6149 9430 East flowing 9532 14511 Brahmaputra 34920 66065 Total 84044 148701
  • 14.
  • 15.
    Technology Hydropower Technology Pumped Impoundment Diversion Storage
  • 16.
  • 17.
    Dam Types  Arch  Gravity  Buttress
  • 18.
    Arch Dams  Arch shape gives strength  Less material (cheaper)  Narrow sites  Need strong foundation
  • 19.
    Concrete Gravity Dams  Weight holds dam in place that increase stability  Resist sliding and crushing  Lots of concrete (expensive)
  • 20.
    Buttress Dams  Face is held up by a series of supports  Flat or curved face  Water tight dam
  • 21.
  • 22.
    Pumped Storage  During Storage, water pumped from lower reservoir to higher one.  Water released back to lower reservoir to generate electricity.
  • 23.
    Pumped Storage  Operation : Two pools of Water  Upper pool – impoundment  Lower pool – natural lake, river or storage reservoir  Advantages : – Production of peak power – Can be built anywhere The Raccoon Mountain project with reliable supply of water
  • 24.
    Sizes of HydropowerPlants  Definitionsmay vary.  Large plants : capacity >30 MW  Small Plants : capacity b/w 100 kW to 30 MW  Micro Plants : capacity up to 100 kW
  • 25.
  • 26.
  • 27.
  • 28.
    Micro Hydropower Systems  Many creeks and rivers are permanent, i.e., they never dry up, and these are the most suitable for micro-hydro power production  Micro hydro turbine could be a waterwheel  Newer turbines : Pelton wheel (most common)  Others : Turgo, Crossflow and various axial flow turbines
  • 29.
    Generating Technologies  Types of Hydro Turbines: – Impulse turbines  Pelton Wheel  Cross Flow Turbines – Reaction turbines  Propeller Turbines : Bulb turbine, Straflo, Tube Turbine, Kaplan Turbine  Francis Turbines  Kinetic Turbines
  • 30.
    Impulse Turbines  Uses the velocity of the water to move the runner and discharges to atmospheric pressure.  The water stream hits each bucket on the runner.  No suction downside, water flows out through turbine housing after hitting.  High head, low flow applications.  Types : Pelton wheel, Cross Flow
  • 31.
    Pelton Wheels  Nozzles direct forceful streams of water against a series of spoon-shaped buckets mounted around the edge of a wheel.  Each bucket reverses the flow of water and this impulse spins the turbine.
  • 32.
    Pelton Wheels (continued…)  Suited for high head, low flow sites.  The largest units can be up to 200 MW.  Can operate with heads as small as 15 meters and as high as 1,800 meters.
  • 33.
    Cross Flow Turbines  drum-shaped  elongated, rectangular- section nozzle directed against curved vanes on a cylindrically shaped runner  “squirrel cage” blower  water flows through the blades twice
  • 34.
    Cross Flow Turbines(continued…)  Firstpass : water flows from the outside of the blades to the inside  Second pass : from the inside back out  Larger water flows and lower heads than the Pelton.
  • 35.
    Reaction Turbines  Combined action of pressure and moving water.  Runner placed directly in the water stream flowing over the blades rather than striking each individually.  lower head and higher flows than compared with the impulse turbines.
  • 36.
    Propeller Hydropower Turbine  Runner with three to six blades.  Water contacts all of the blades constantly.  Through the pipe, the pressure is constant  Pitch of the blades - fixed or adjustable  Scroll case, wicket gates, and a draft tube  Types: Bulb turbine, Straflo, Tube turbine, Kaplan
  • 37.
    Bulb Turbine  The turbine and generator are a sealed unit placed directly in the water stream.
  • 38.
    Others…  Straflo : The generator is attached directly to the perimeter of the turbine.  Tube Turbine : The penstock bends just before or after the runner, allowing a straight line connection to the generator  Kaplan : Both the blades and the wicket gates are adjustable, allowing for a wider range of operation
  • 39.
    Kaplan Turbine  The inlet is a scroll-shaped tube that wraps around the turbine's wicket gate.  Water is directed tangentially, through the wicket gate, and spirals on to a propeller shaped runner, causing it to spin.  The outlet is a specially shaped draft tube that helps decelerate the water and recover kinetic energy.
  • 40.
    Francis Turbines  The inlet is spiral shaped.  Guide vanes direct the water tangentially to the runner.  This radial flow acts on the runner vanes, causing the runner to spin.  The guide vanes (or wicket gate) may be adjustable to allow efficient turbine operation for a range of water flow conditions.
  • 41.
    Francis Turbines (continued…)  Best suited for sites with high flows and low to medium head.  Efficiency of 90%.  expensive to design, manufacture and install, but operate for decades.
  • 42.
    Kinetic Energy Turbines  Also called free-flow turbines.  Kinetic energy of flowing water used rather than potential from the head.  Operate in rivers, man-made channels, tidal waters, or ocean currents.  Do not require the diversion of water.  Kinetic systems do not require large civil works.  Can use existing structures such as bridges, tailraces and channels.
  • 43.
    Hydroelectric Power Plantsin India Baspa II Binwa
  • 44.
    Continued … Gaj Nathpa Jakri
  • 45.
    Continued… Rangit Sardar Sarovar
  • 46.
  • 47.
    Positive impacts  Environmental impacts of Hydro • No operational greenhouse gas emissions • Savings (kg of CO2 per MWh of electricity): – Coal 1000 kg – Oil 800 kg – Gas 400 kg • No SO2 or NOX  Non-environmental impacts – flood control, irrigation, transportation, fisheries and – tourism.
  • 48.
    Negative impacts  The loss of land under the reservoir.  Interference with the transport of sediment by the dam.  Problems associated with the reservoir. – Climatic – seismic effects.
  • 49.
    Loss of land  A large area is taken up in the form of a reservoir in case of large dams  This leads to reduction in fertile rich soil in the flood plains, forests and even mineral deposits  Power per area ratio is evaluated to quantify this impact Usually ratios lesser than 5 KW per hectare implies that the plant needs more land area than competing renewable resources
  • 50.
    Interference with Sedimenttransport RIVER Kg/m3 Yellow River 37.6 Colorado 16.6 Amur 2.3 Nile 1.6  Rivers carry a lot of sediments.  Creation of a dam results in the deposition of sediments on the bottom of the reservoir.  Land erosion on the edges of the reservoir due to deforestation also leads to deposition of sediments.
  • 51.
    Climatic and Seismiceffects  It is believed that large reservoirs induce have the potential to induce earthquakes.  In tropics, existence of man-made lakes decreases the convective activity and reduces cloud cover. In temperate regions, fog forms over the lake and along the shores when the temperature falls to zero and thus increases humidity in the nearby area.
  • 52.
    Some major/minor inducedearthquakes DAM NAME COUNTRY HEIGHT (m) VOLUME OF MAGNITUDE RESERVOIR (m3) KOYNA INDIA 103 2780 6.5 KREMASTA GREECE 165 4650 6.3 HSINFENGKIANG CHINA 105 10500 6.1 BENMORE NEW 118 2100 5.0 ZEALAND MONTEYNARD FRANCE 155 240 4.9
  • 53.
    Other problems  Many fishes require flowing water for reproduction and cannot adapt to stagnant resulting in the reduction in its population.  Heating of the reservoirs may lead to decrease in the dissolved oxygen levels.  Other water-borne diseases like malaria, river-blindness become prevalent.
  • 54.
    Methods to alleviatethe negative impact  Creation of ecological reserves.  Limiting dam construction to allow substantial free flowing water.  Building sluice gates and passes that help prevent fishes getting trapped.
  • 55.
  • 56.
    Local HP Economics  Development, operating, and maintenance costs, and electricity generation  First check if site is developed or not.  If a dam does not exist, several things to consider are: land/land rights, structures and improvements, equipment, reservoirs, dams, waterways, roads, railroads, and bridges.  Development costs include recreation, preserving historical and archeological sites, maintaining water quality, protecting fish and wildlife.
  • 57.
    Construction Costs  Hydro costs are highly site specific  Dams are very expensive  Civil works form two-thirds of total cost – Varies 25 to 80%  Large Western schemes: $ 1200/kW  Developing nations: $ 800 to $ 2000/kW  Compare with CCGT: $ 600 to $800/kW
  • 58.
    Production Costs  Compared with fossil-fuelled plant – No fuel costs – Low O&M cost – Long lifetime
  • 59.
  • 60.
    Sardar Sarovar Dam  Project planning started as early as 1946.  Project still under construction with a part of the dam in operation.  A concrete gravity dam, 1210 meters (3970 feet) in length and with a maximum height of 163 meters
  • 61.
    The gross storage capacity of the reservoir is 0.95 M. ha.m. (7.7 MAF) while live storage capacity is 0.58 M.ha.m. (4.75 MAF).  The total project cost was estimated at Rs. 49 billion at 1987 price levels.  There are two power houses project- 1200 MW River Bed Power House and 250 MW Canal Head Power House. Power benefits are shared among Madhya Pradesh, Maharashtra and Gujarat in the ratio of 57:27:16 respectively.
  • 62.
    Environmental Protection measures  About 14000 ha of land has been afforested to compensate for the submergence of 4523 ha of land.  Formation of co-operatives, extensive training to the fisherman, providing infrastructure such as fish landing sites, cold storage and transportation etc.  Surveillance & Control of Water related diseases and communicable diseases.
  • 63.
    Rehabilitation & Resettlement  Individual benefits like grant of minimum 2 ha. of land for agricultural purpose of the size equal to the area of land acquired.  Civil and other amenities such as approach road, internal roads, primary school building, health, centre, Panchayat ghar, Seeds store, Children's park, Village pond, Drinking water wells, platform for community meetings, Street light electrification, Religious place, Crematorium ground etc. are provided at resettled site.
