Interconnection Issues at
Higher Penetrations
Sky C. Stanfield

1

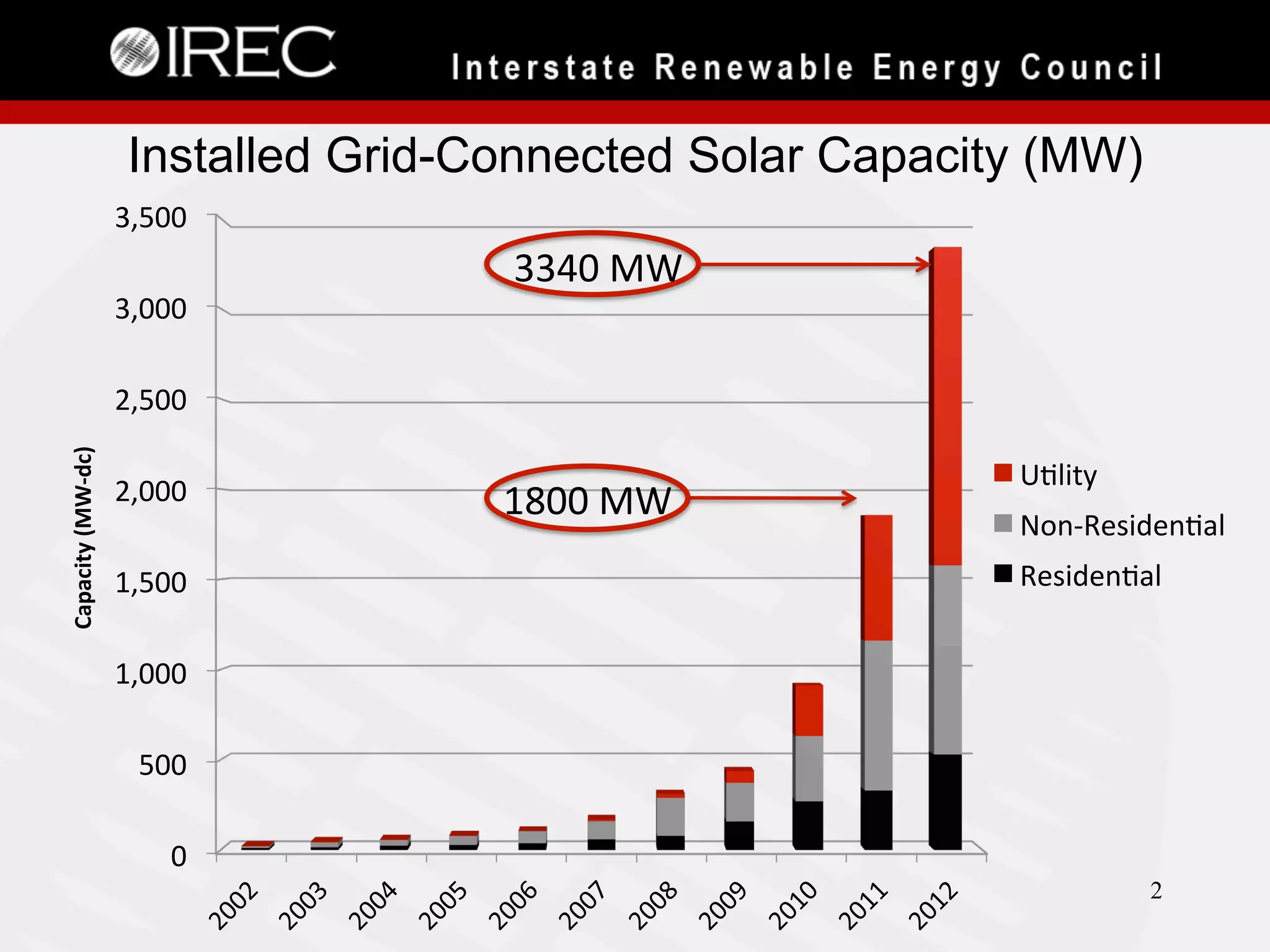

Installed Grid-Connected Solar Capacity (MW)
3,500

3,000


3340
  MW


Capacity
  (MW-­‐dc)


2,500

2,000

1,500


1800
  MW


U)lity

Non-­‐Residen)al

Residen)al


1,000

500

0

2

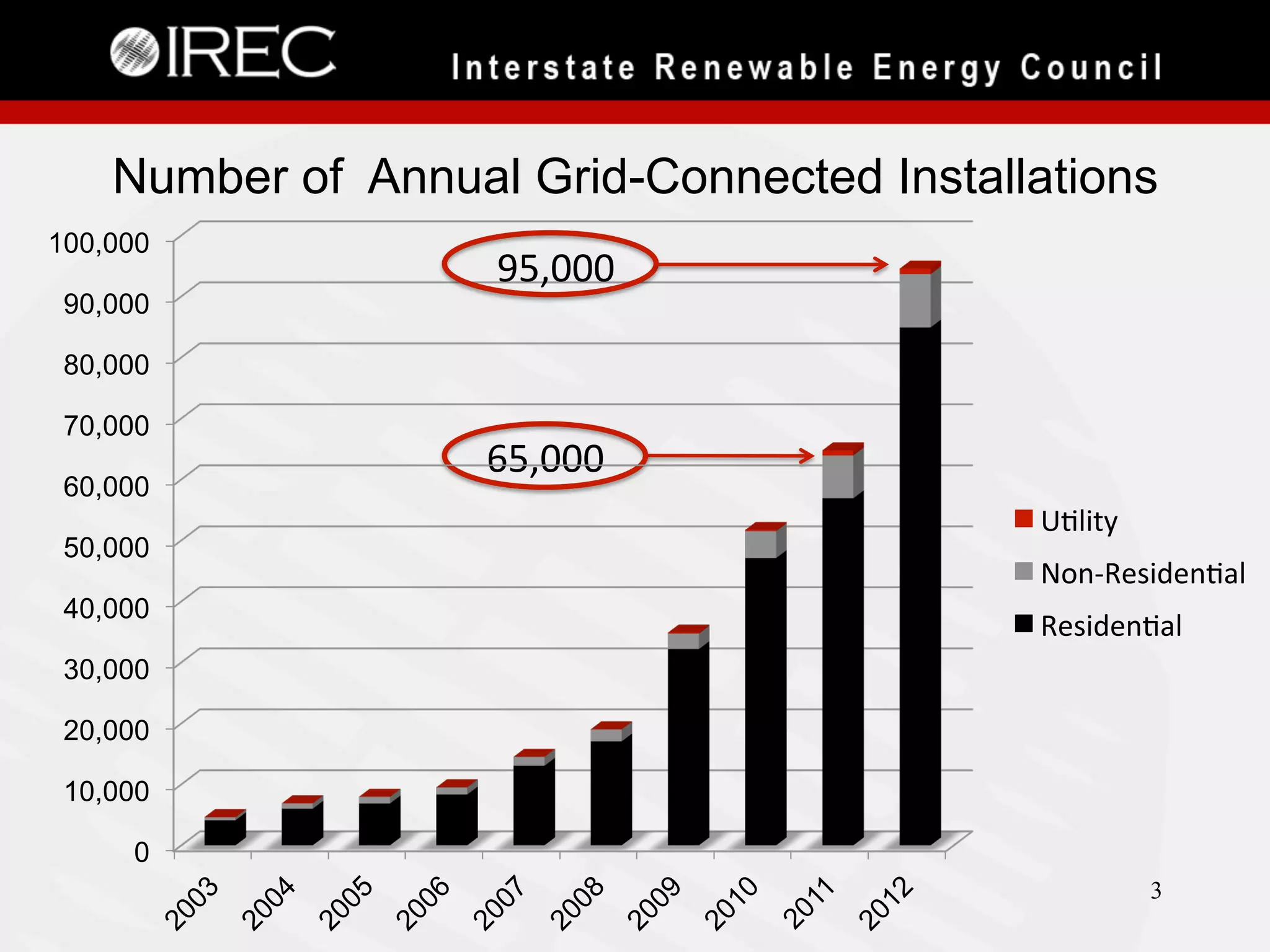

Number of Annual Grid-Connected Installations
100,000
90,000

95,000


80,000
70,000
60,000
50,000
40,000

65,000

U)lity

Non-­‐Residen)al

Residen)al


30,000
20,000
10,000
0
3

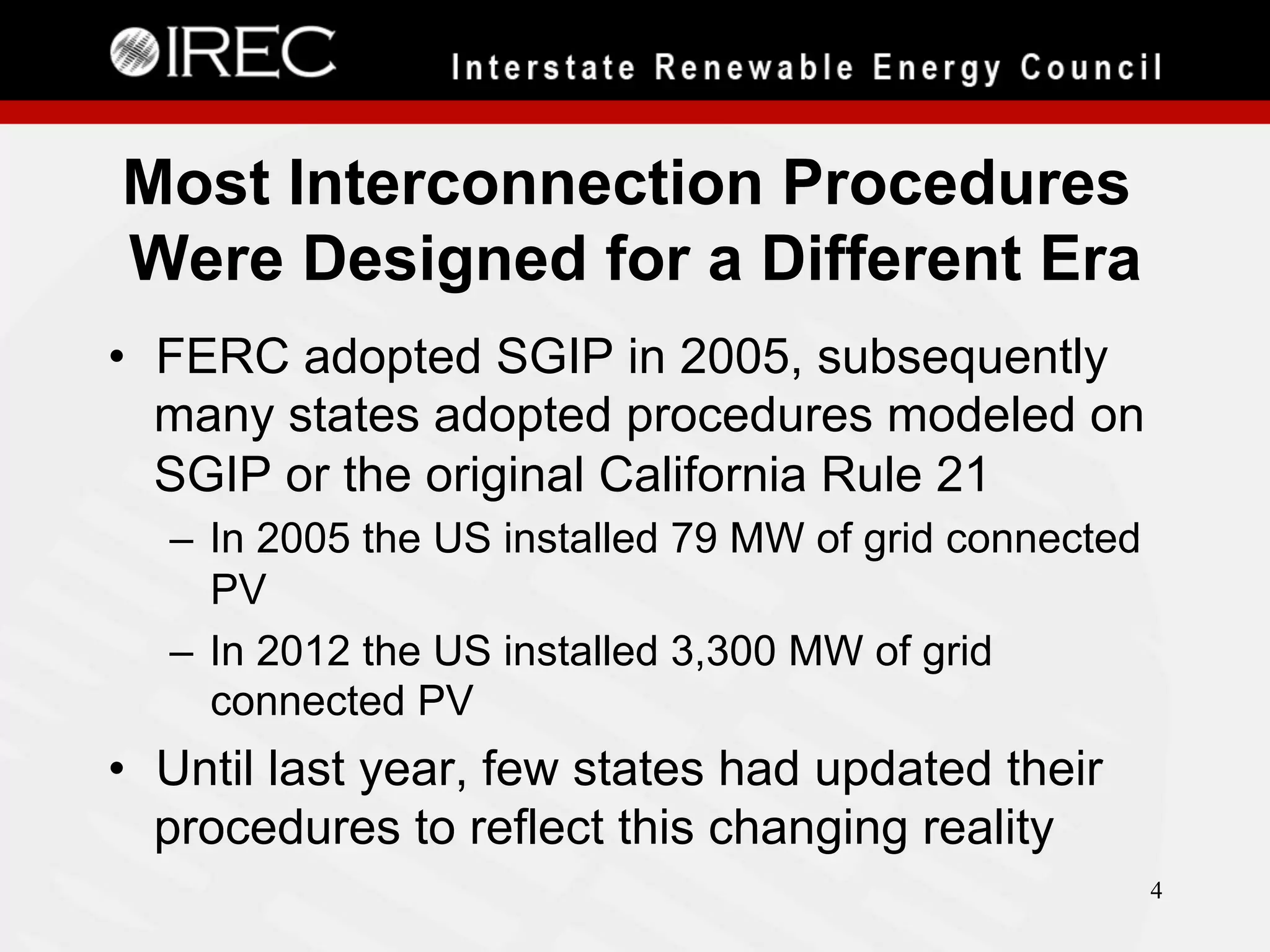

Most Interconnection Procedures
Were Designed for a Different Era
•  FERC adopted SGIP in 2005, subsequently
many states adopted procedures modeled on
SGIP or the original California Rule 21
–  In 2005 the US installed 79 MW of grid connected
PV
–  In 2012 the US installed 3,300 MW of grid
connected PV

•  Until last year, few states had updated their
procedures to reflect this changing reality
4

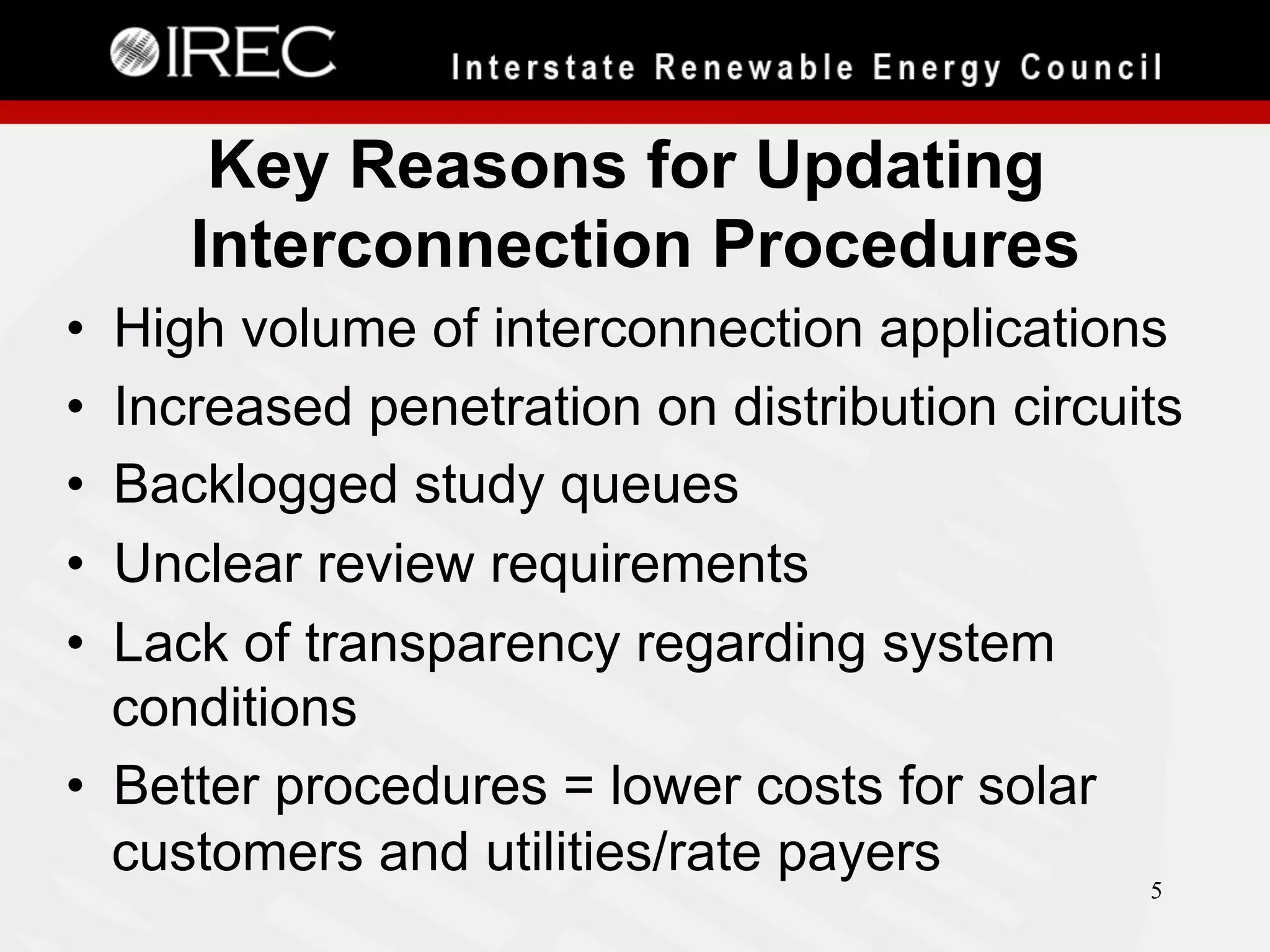

Key Reasons for Updating
Interconnection Procedures
• 
• 
• 
• 
• 

High volume of interconnection applications
Increased penetration on distribution circuits
Backlogged study queues
Unclear review requirements
Lack of transparency regarding system
conditions
•  Better procedures = lower costs for solar
customers and utilities/rate payers
5

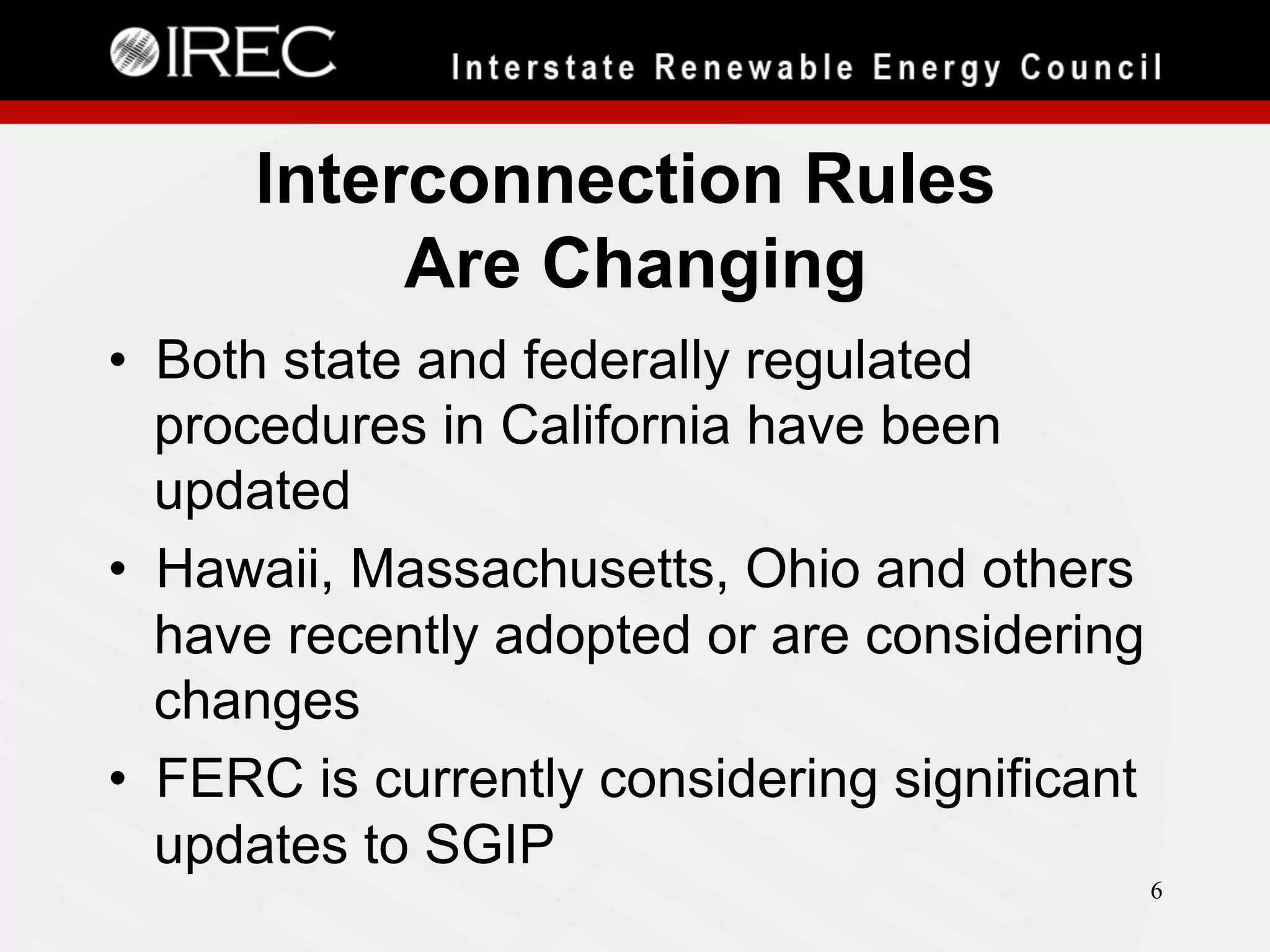

Interconnection Rules
Are Changing
•  Both state and federally regulated
procedures in California have been
updated
•  Hawaii, Massachusetts, Ohio and others
have recently adopted or are considering
changes
•  FERC is currently considering significant
updates to SGIP
6

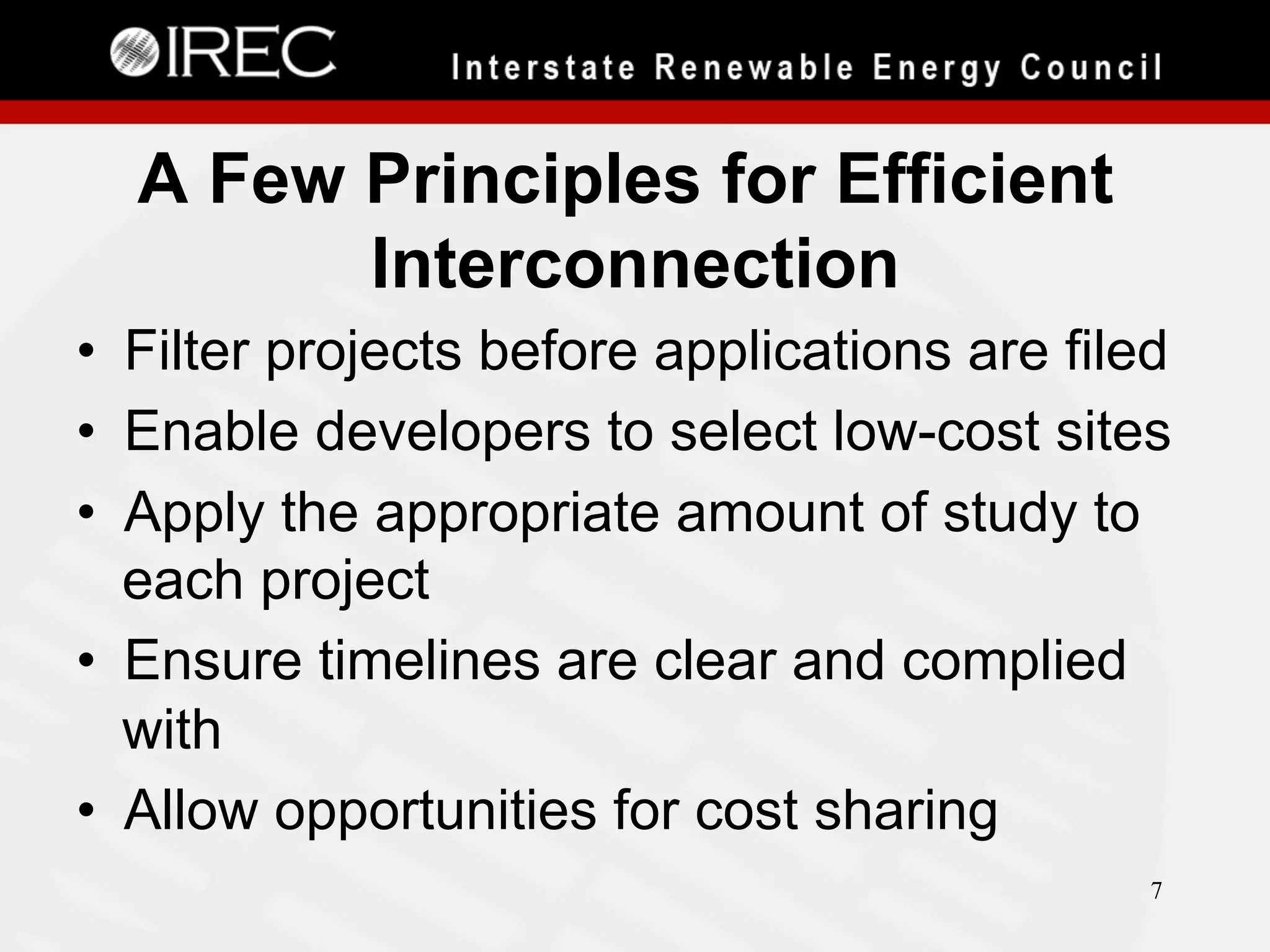

A Few Principles for Efficient
Interconnection
•  Filter projects before applications are filed
•  Enable developers to select low-cost sites
•  Apply the appropriate amount of study to
each project
•  Ensure timelines are clear and complied
with
•  Allow opportunities for cost sharing
7

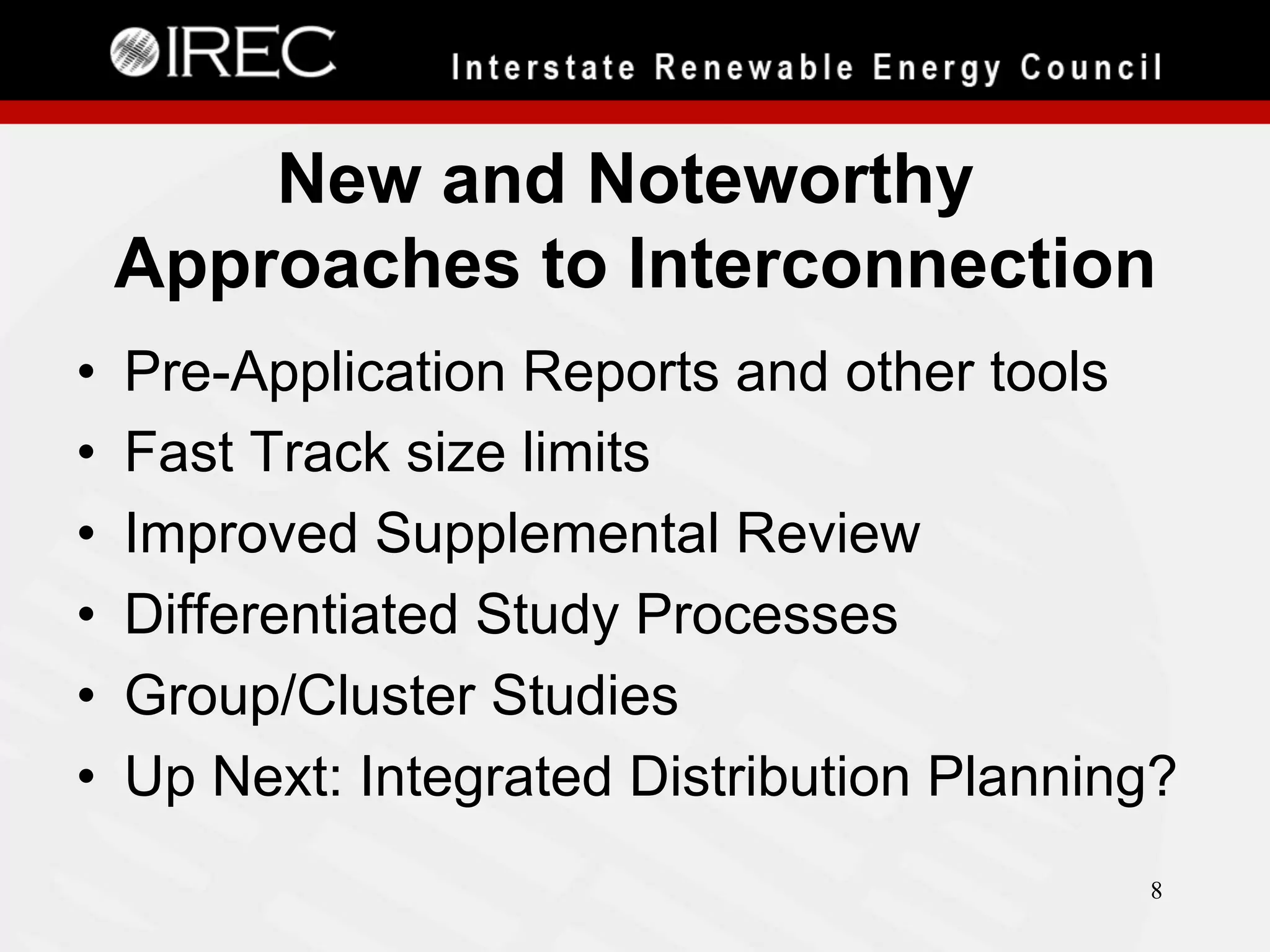

New and Noteworthy
Approaches to Interconnection
• 
• 
• 
• 
• 
• 

Pre-Application Reports and other tools
Fast Track size limits
Improved Supplemental Review
Differentiated Study Processes
Group/Cluster Studies
Up Next: Integrated Distribution Planning?
8
Pre-Application Report
•  Report on system conditions at a particular
point of interconnection
•  Reduces number of speculative projects
•  Help developers strategically locate projects
•  Maximizes utilization of existing infrastructure
•  Can help manage expectations
•  Minimizes study queues, conserves utility
staff time
9

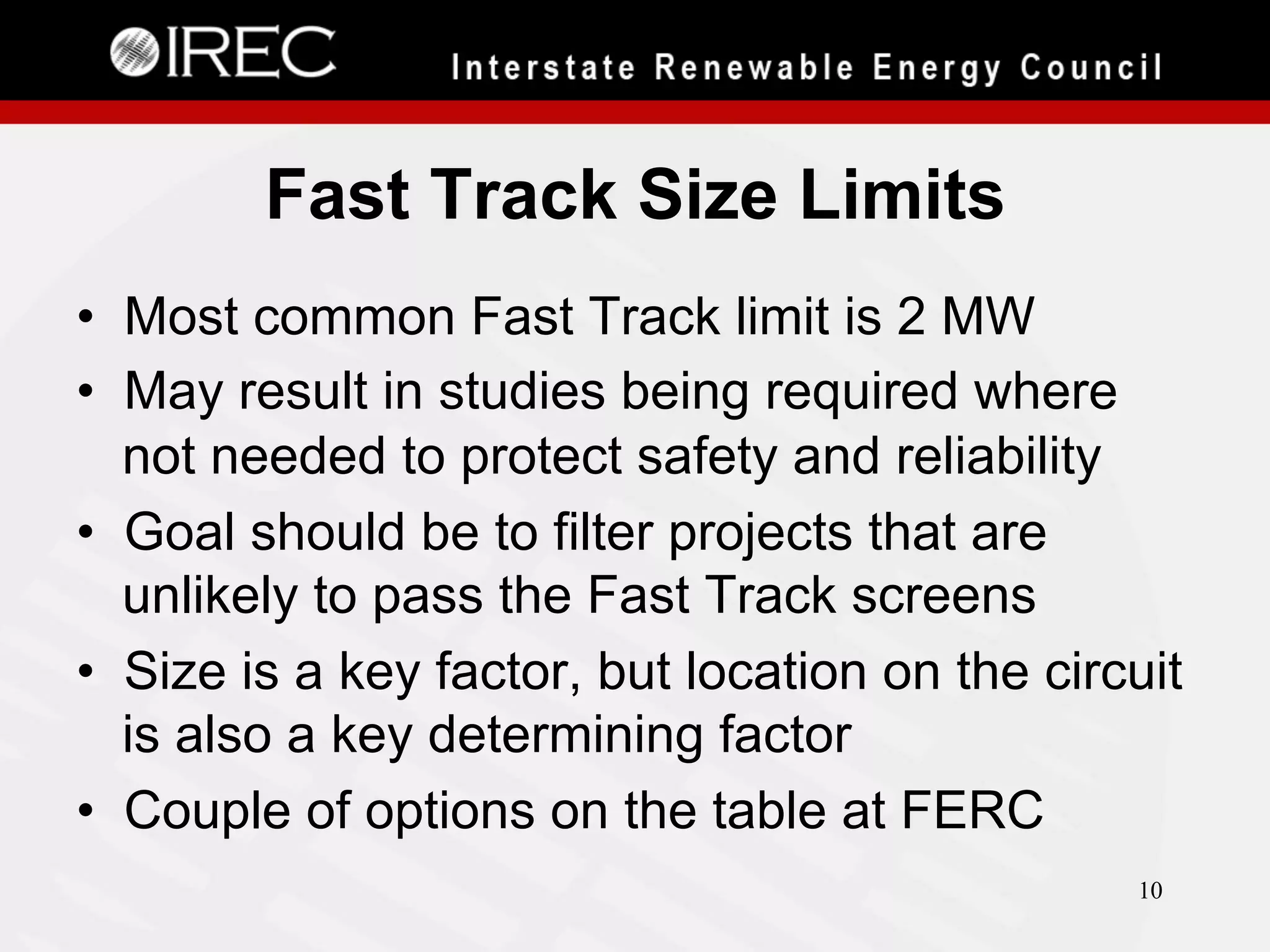

Fast Track Size Limits
•  Most common Fast Track limit is 2 MW
•  May result in studies being required where
not needed to protect safety and reliability
•  Goal should be to filter projects that are
unlikely to pass the Fast Track screens
•  Size is a key factor, but location on the circuit
is also a key determining factor
•  Couple of options on the table at FERC
10
Fast Track Eligibility Proposals
Line Capacity

Fast Track Eligibilityregardless of location

Fast Track Eligibility- on >
600 amp line and < 2.5
miles from substation

< 4kV
5kV – 14 kV
15 kV – 30 kV
31 kV – 60 kV

< 1MW
< 2MW
< 3MW
< 4MW

< 2 MW
< 3 MW
< 4 MW
< 5 MW

Line Voltage

Fast Track Eligibility
Regardless of Location

Fast Track Eligibility on a
Mainline* and <2.5 Miles**
from Substation

< 5 kilovolt (kV)
≥ 5 kV and < 15 kV
≥ 15 kV and < 30 kV
≥ 30 kV and 69 kV

< 500 kW
< 2 MW
< 3 MW
< 4 MW

< 500 kW
< 3 MW
< 4 MW
< 5 MW

* For purposes of this table, a mainline will typically constitute lines with wire sizes of 4/0 AWG, 336.5 kcmil, 397.5 kcmil, 477
kcmil and 795 kcmil
** Electrical Line Miles
*** An Interconnection Customer can determine this information in advanced by requesting a pre-application report pursuant to
section 1.2.

11

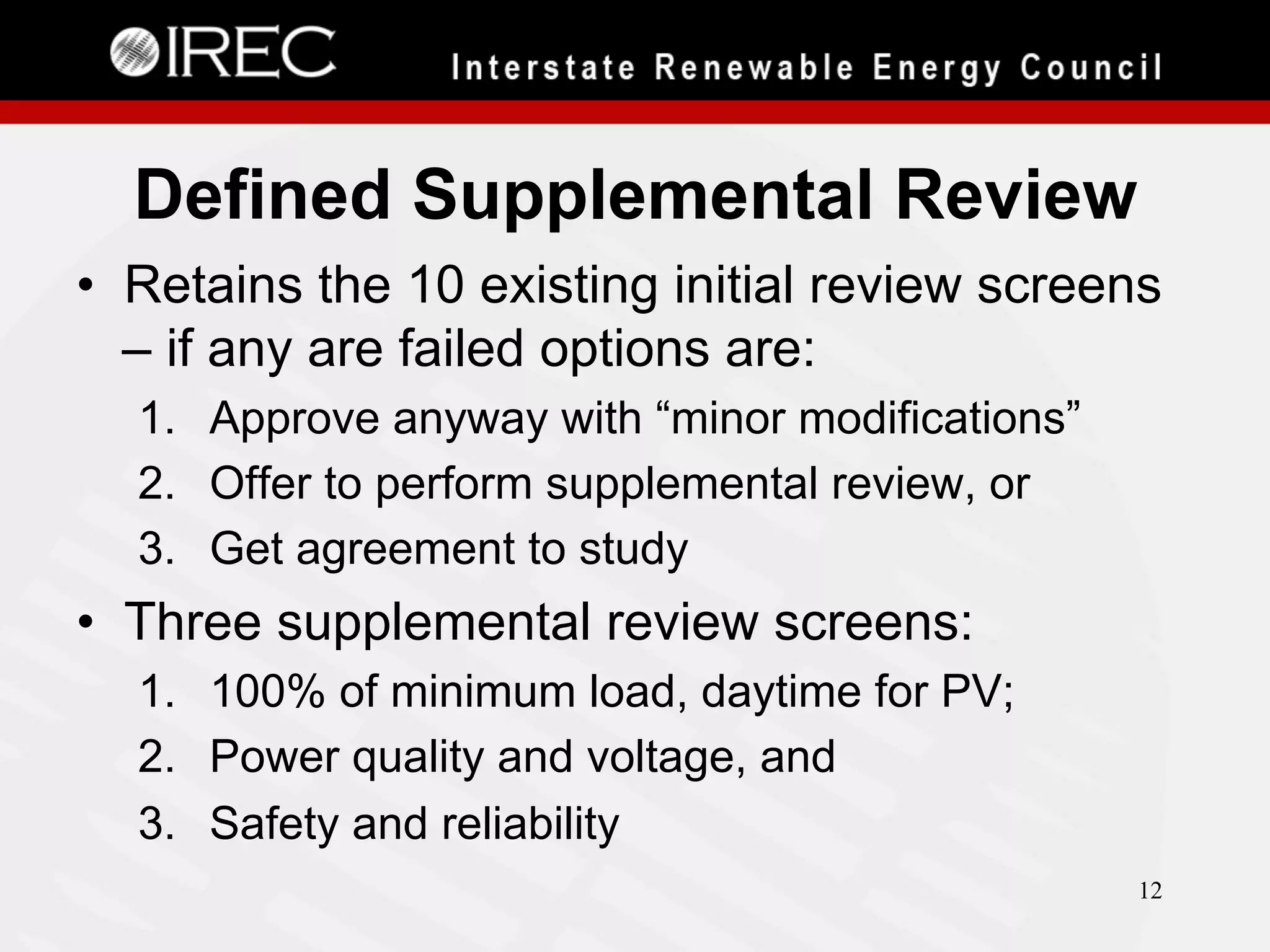

Defined Supplemental Review
•  Retains the 10 existing initial review screens
– if any are failed options are:
1.  Approve anyway with “minor modifications”
2.  Offer to perform supplemental review, or
3.  Get agreement to study

•  Three supplemental review screens:
1.  100% of minimum load, daytime for PV;
2.  Power quality and voltage, and
3.  Safety and reliability
12
Differentiated Study Processes
• 
• 
• 
• 
• 
• 

Pre-Application (± 10 days)
Fast Track (± 30 days)
Supplemental Review (± 60 days)
Independent Study (± 6 months)
Distribution Group Study (± one year)
Transmission Cluster Study (± two years)
13

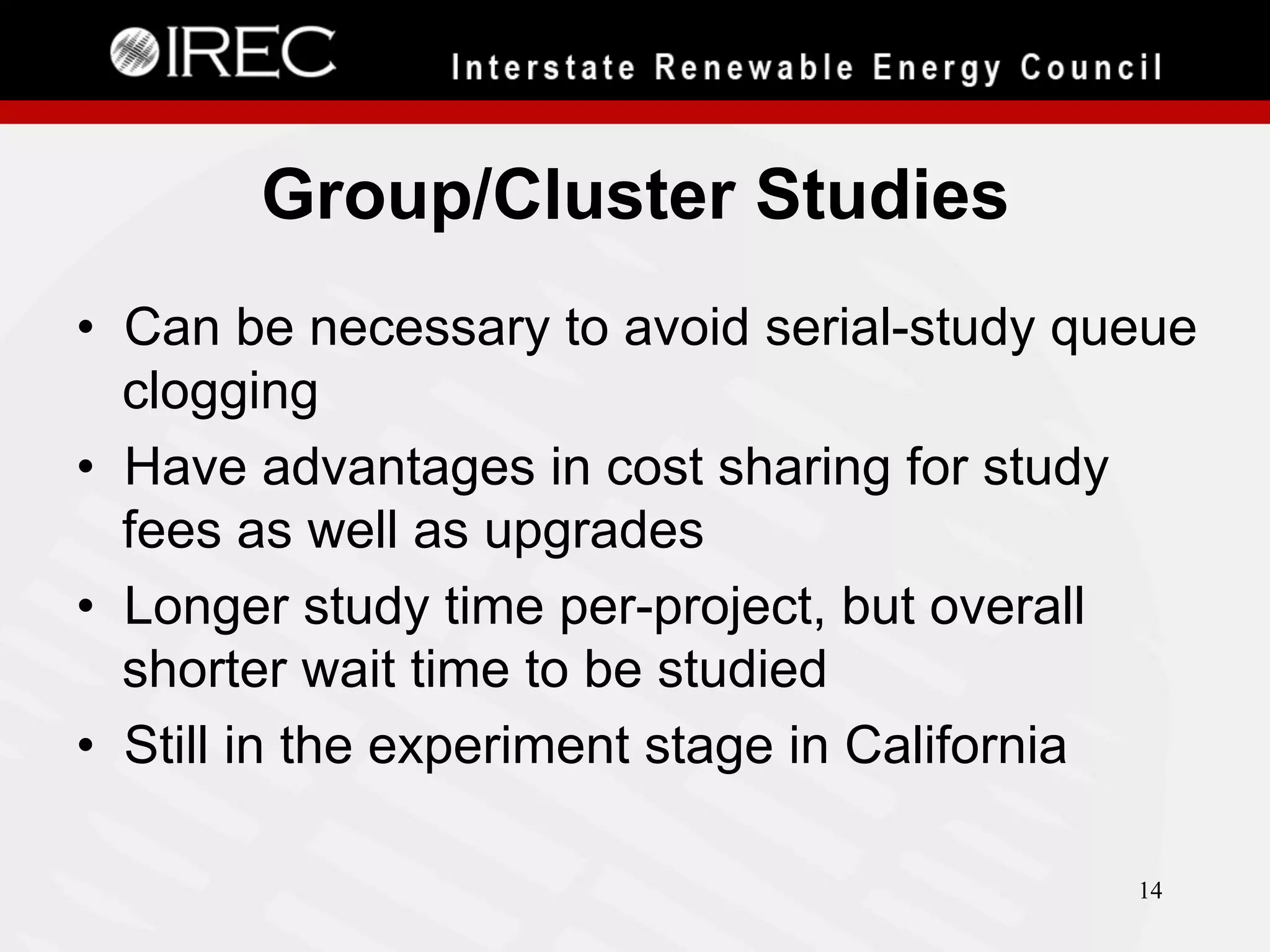

Group/Cluster Studies
•  Can be necessary to avoid serial-study queue
clogging
•  Have advantages in cost sharing for study
fees as well as upgrades
•  Longer study time per-project, but overall
shorter wait time to be studied
•  Still in the experiment stage in California
14

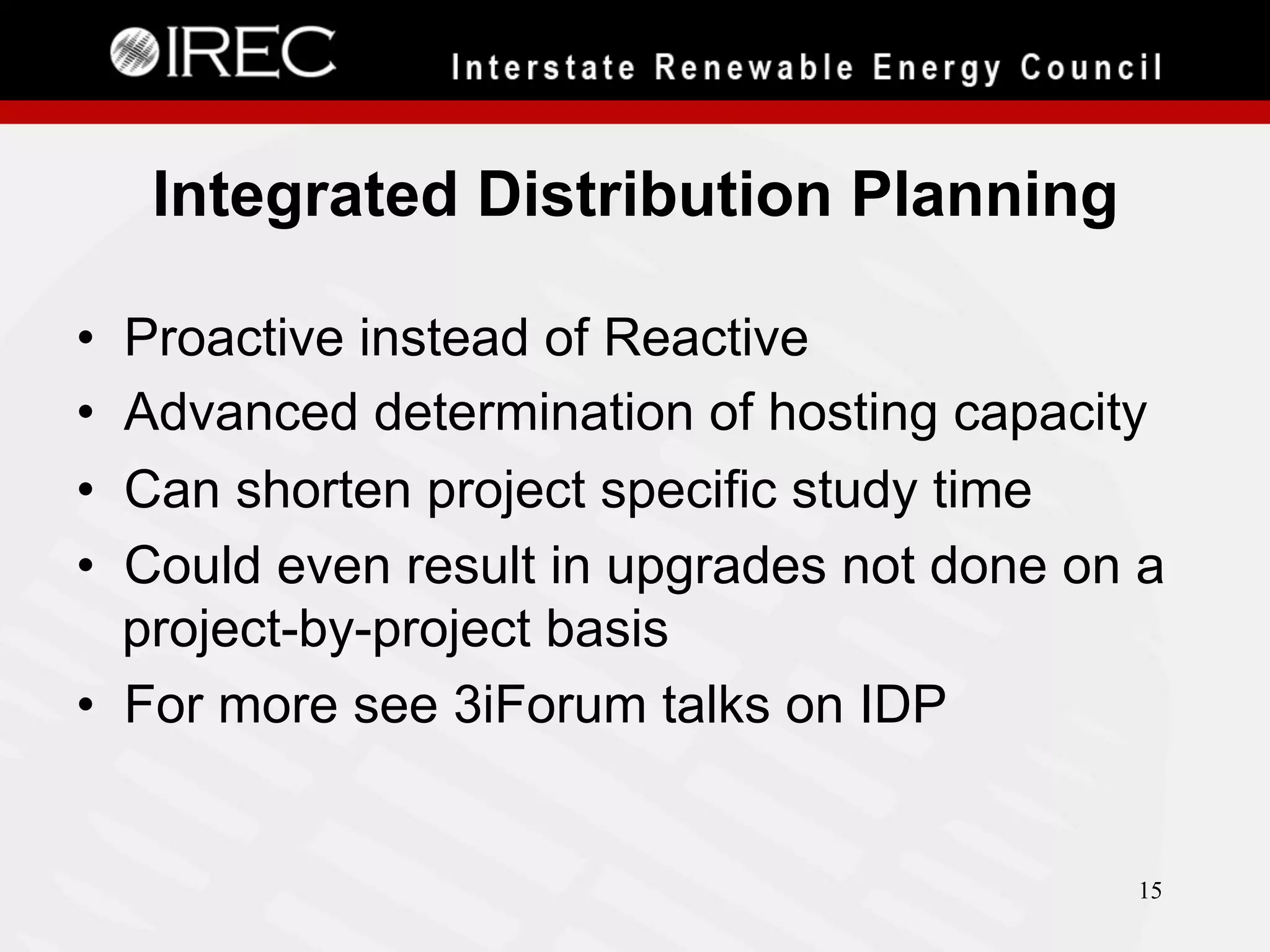

Integrated Distribution Planning
• 
• 
• 
• 

Proactive instead of Reactive
Advanced determination of hosting capacity
Can shorten project specific study time
Could even result in upgrades not done on a
project-by-project basis
•  For more see 3iForum talks on IDP

15
Questions?
Sky Stanfield
Keyes, Fox & Wiedman LLP
(510) 314-8204
sstanfield@kfwlaw.com

16

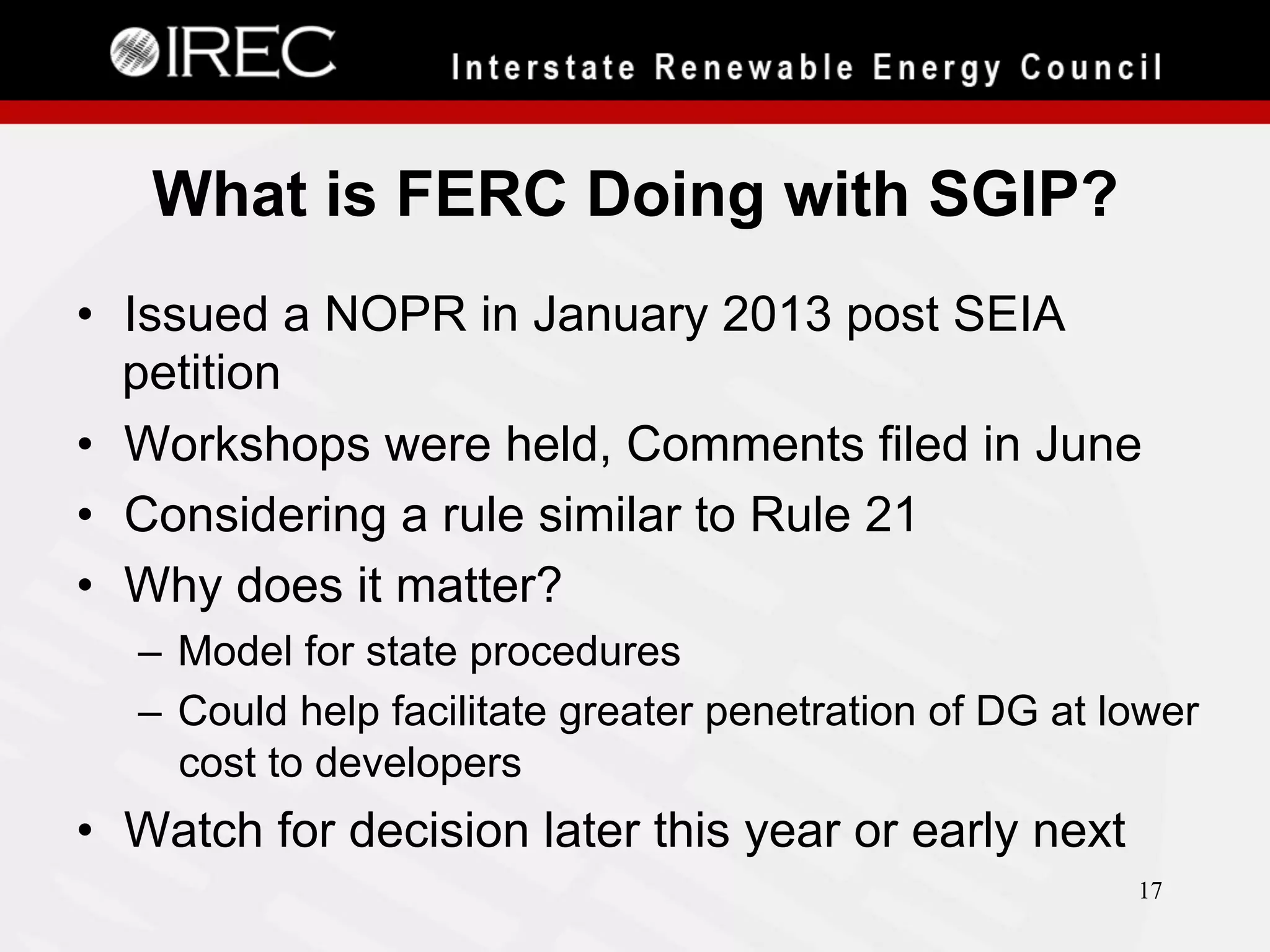

What is FERC Doing with SGIP?
•  Issued a NOPR in January 2013 post SEIA
petition
•  Workshops were held, Comments filed in June
•  Considering a rule similar to Rule 21
•  Why does it matter?
–  Model for state procedures
–  Could help facilitate greater penetration of DG at lower
cost to developers

•  Watch for decision later this year or early next
17
THANKS to our generous sponsors for the
2013 3iForum and 3iAwards
