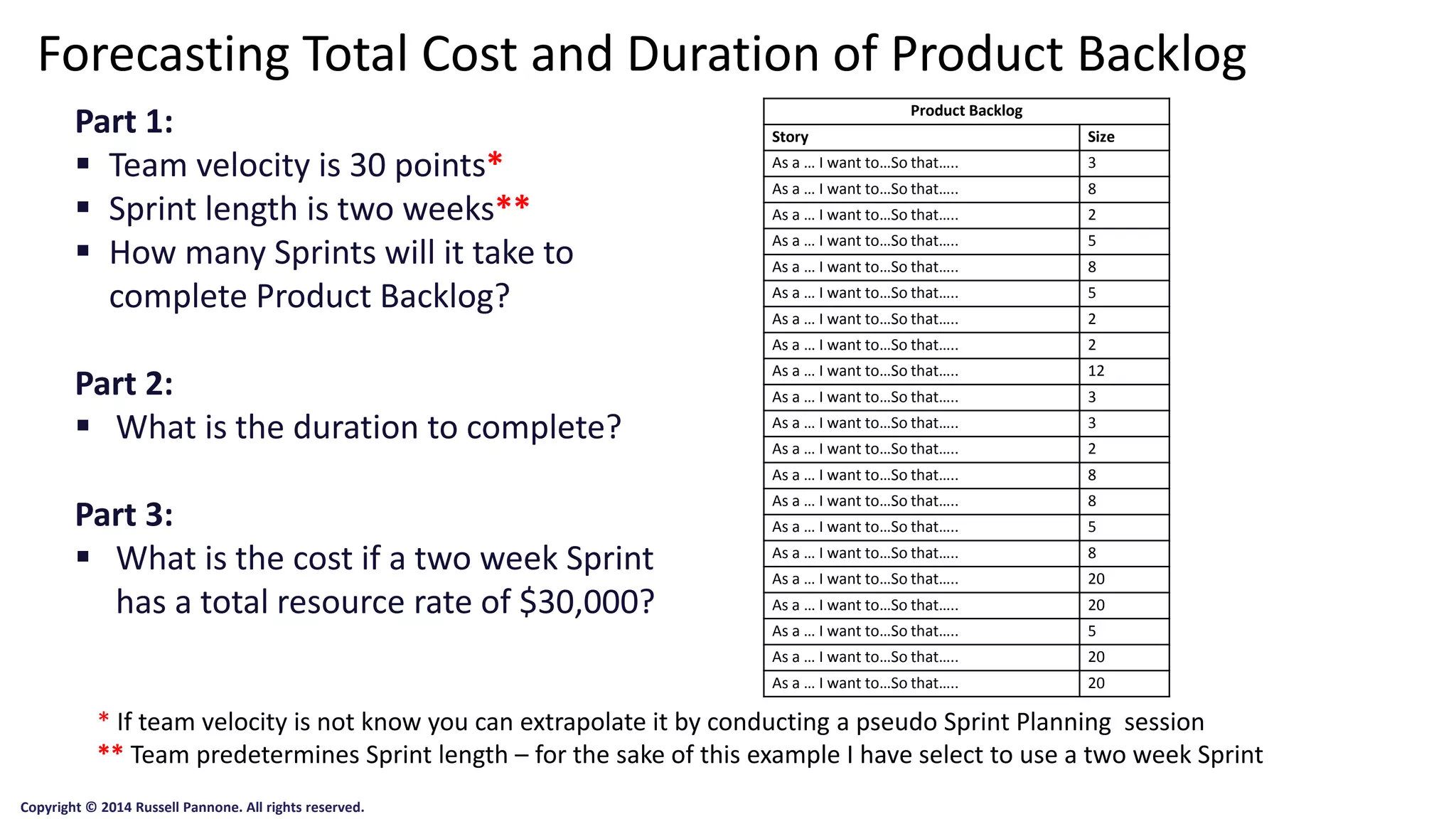

Part 1:
Team velocity is 30 points*
Sprint length is two weeks**
How many Sprints will it take to complete Product Backlog?
Part 2:
What is the duration to complete?
Part 3:
What is the cost if a two week Sprint has a total resource rate of $30,000?
Product Backlog
Story
Size
As a … I want to…So that…..
3
As a … I want to…So that…..
8
As a … I want to…So that…..
2
As a … I want to…So that…..
5
As a … I want to…So that…..
8
As a … I want to…So that…..
5
As a … I want to…So that…..
2
As a … I want to…So that…..
2
As a … I want to…So that…..
12
As a … I want to…So that…..
3
As a … I want to…So that…..
3
As a … I want to…So that…..
2
As a … I want to…So that…..
8
As a … I want to…So that…..
8
As a … I want to…So that…..
5
As a … I want to…So that…..
8
As a … I want to…So that…..
20
As a … I want to…So that…..
20
As a … I want to…So that…..
5
As a … I want to…So that…..
20
As a … I want to…So that…..
20
Forecasting Total Cost and Duration of Product Backlog
* If team velocity is not know you can extrapolate it by conducting a pseudo Sprint Planning session
**Team predetermines Sprint length –for the sake of this example I have select to use a two week Sprint
Copyright © 2014 Russell Pannone. All rights reserved.

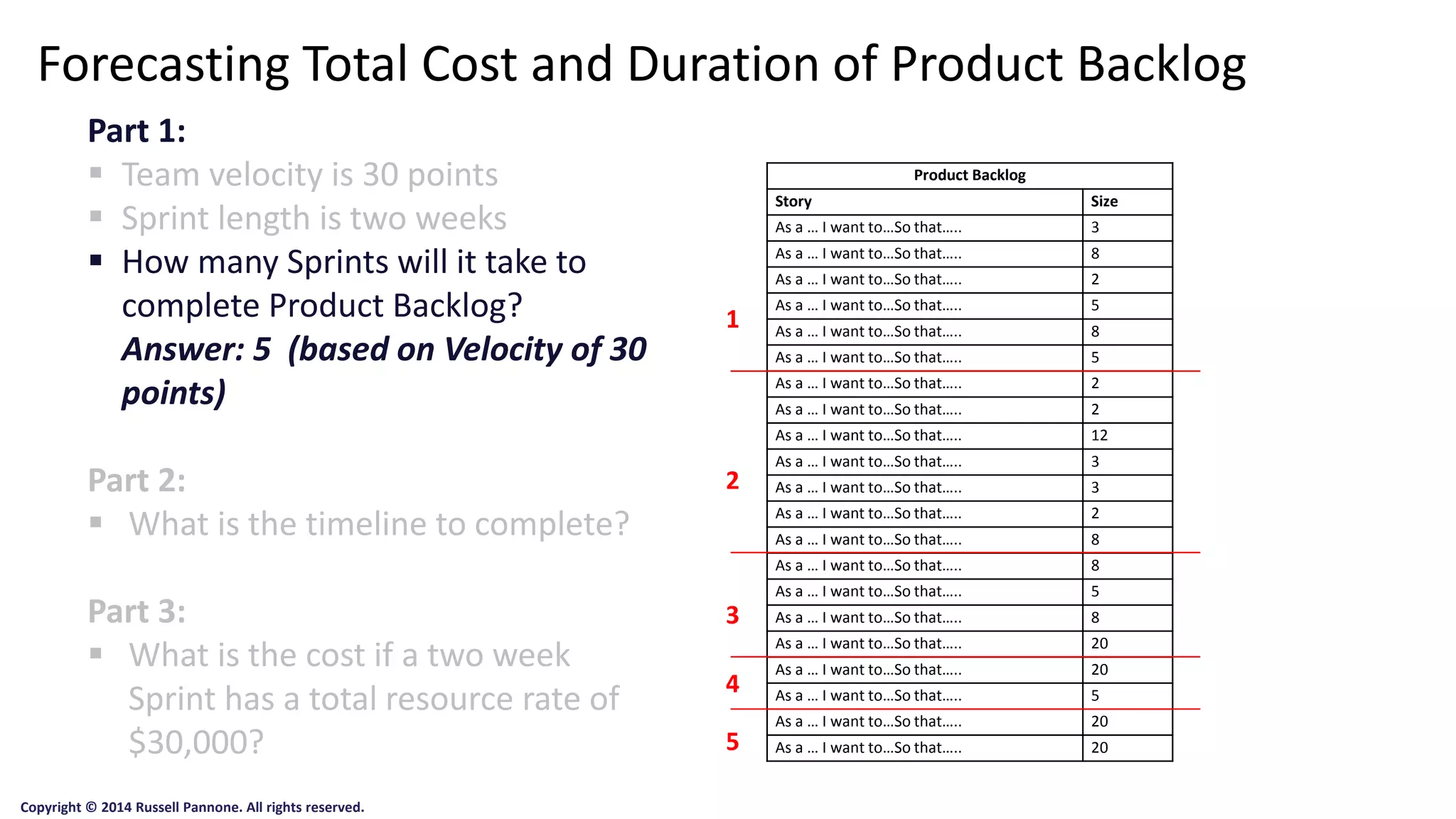

Part 1:
Team velocity is 30 points
Sprint length is two weeks
How many Sprints will it take to complete Product Backlog? Answer: 5 (based on Velocity of 30 points)
Part 2:
What is the timeline to complete?
Part 3:
What is the cost if a two week Sprint has a total resource rate of $30,000?
Product Backlog
Story
Size
As a … I want to…So that…..
3
As a … I want to…So that…..
8
As a … I want to…So that…..
2
As a … I want to…So that…..
5
As a … I want to…So that…..
8
As a … I want to…So that…..
5
As a … I want to…So that…..
2
As a … I want to…So that…..
2
As a … I want to…So that…..
12
As a … I want to…So that…..
3
As a … I want to…So that…..
3
As a … I want to…So that…..
2
As a … I want to…So that…..
8
As a … I want to…So that…..
8
As a … I want to…So that…..
5
As a … I want to…So that…..
8
As a … I want to…So that…..
20
As a … I want to…So that…..
20
As a … I want to…So that…..
5
As a … I want to…So that…..
20
As a … I want to…So that…..
20
Forecasting Total Cost and Duration of Product Backlog
1
2
3
4
5
Copyright © 2014 Russell Pannone. All rights reserved.

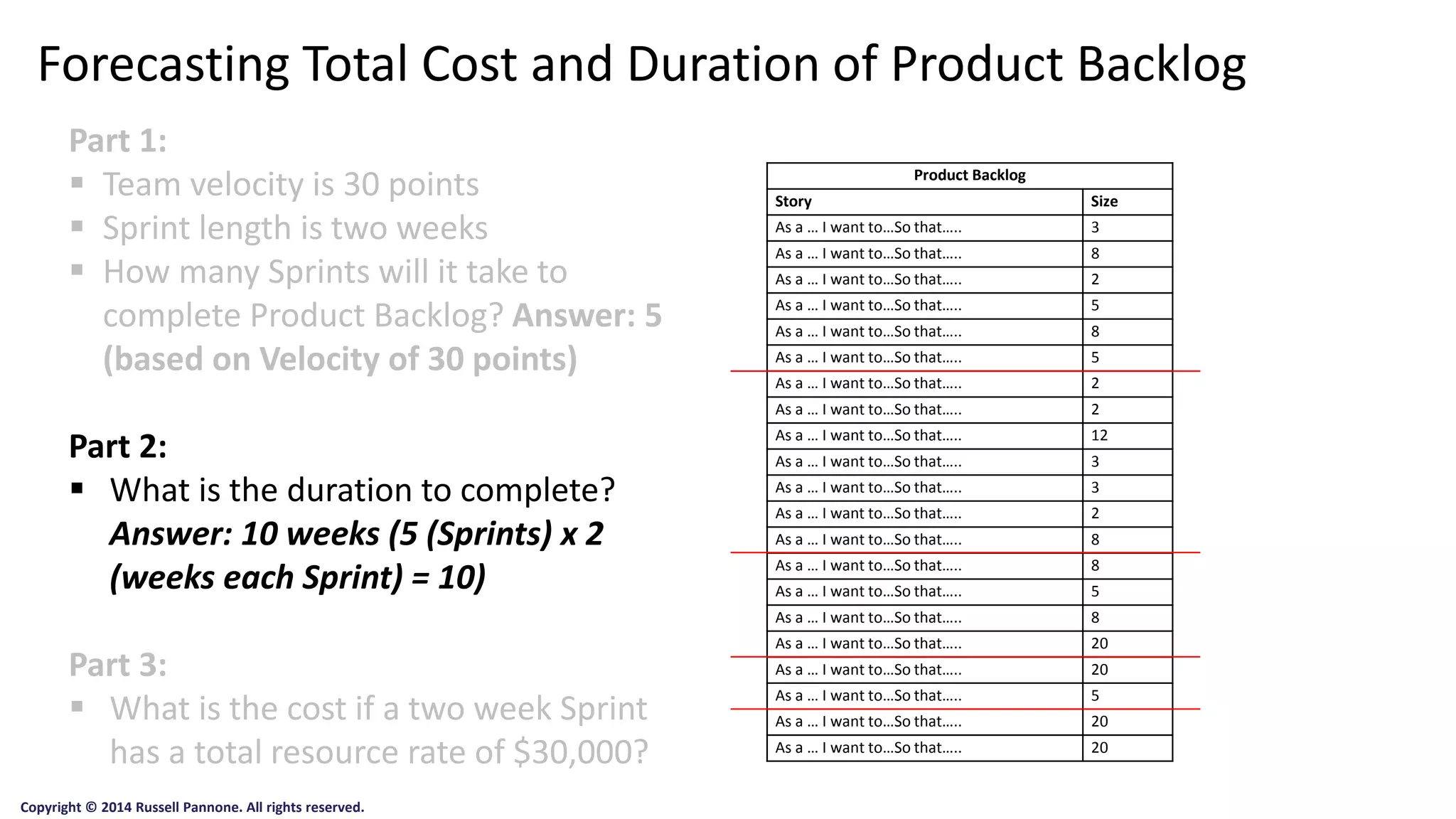

Part 1:
Team velocity is 30 points
Sprint length is two weeks
How many Sprints will it take to complete Product Backlog? Answer: 5 (based on Velocity of 30 points)
Part 2:
What is the duration to complete? Answer: 10 weeks (5 (Sprints) x 2 (weeks each Sprint) = 10)
Part 3:
What is the cost if a two week Sprint has a total resource rate of $30,000?
Product Backlog
Story
Size
As a … I want to…So that…..
3
As a … I want to…So that…..
8
As a … I want to…So that…..
2
As a … I want to…So that…..
5
As a … I want to…So that…..
8
As a … I want to…So that…..
5
As a … I want to…So that…..
2
As a … I want to…So that…..
2
As a … I want to…So that…..
12
As a … I want to…So that…..
3
As a … I want to…So that…..
3
As a … I want to…So that…..
2
As a … I want to…So that…..
8
As a … I want to…So that…..
8
As a … I want to…So that…..
5
As a … I want to…So that…..
8
As a … I want to…So that…..
20
As a … I want to…So that…..
20
As a … I want to…So that…..
5
As a … I want to…So that…..
20
As a … I want to…So that…..
20
Forecasting Total Cost and Duration of Product Backlog
Copyright © 2014 Russell Pannone. All rights reserved.

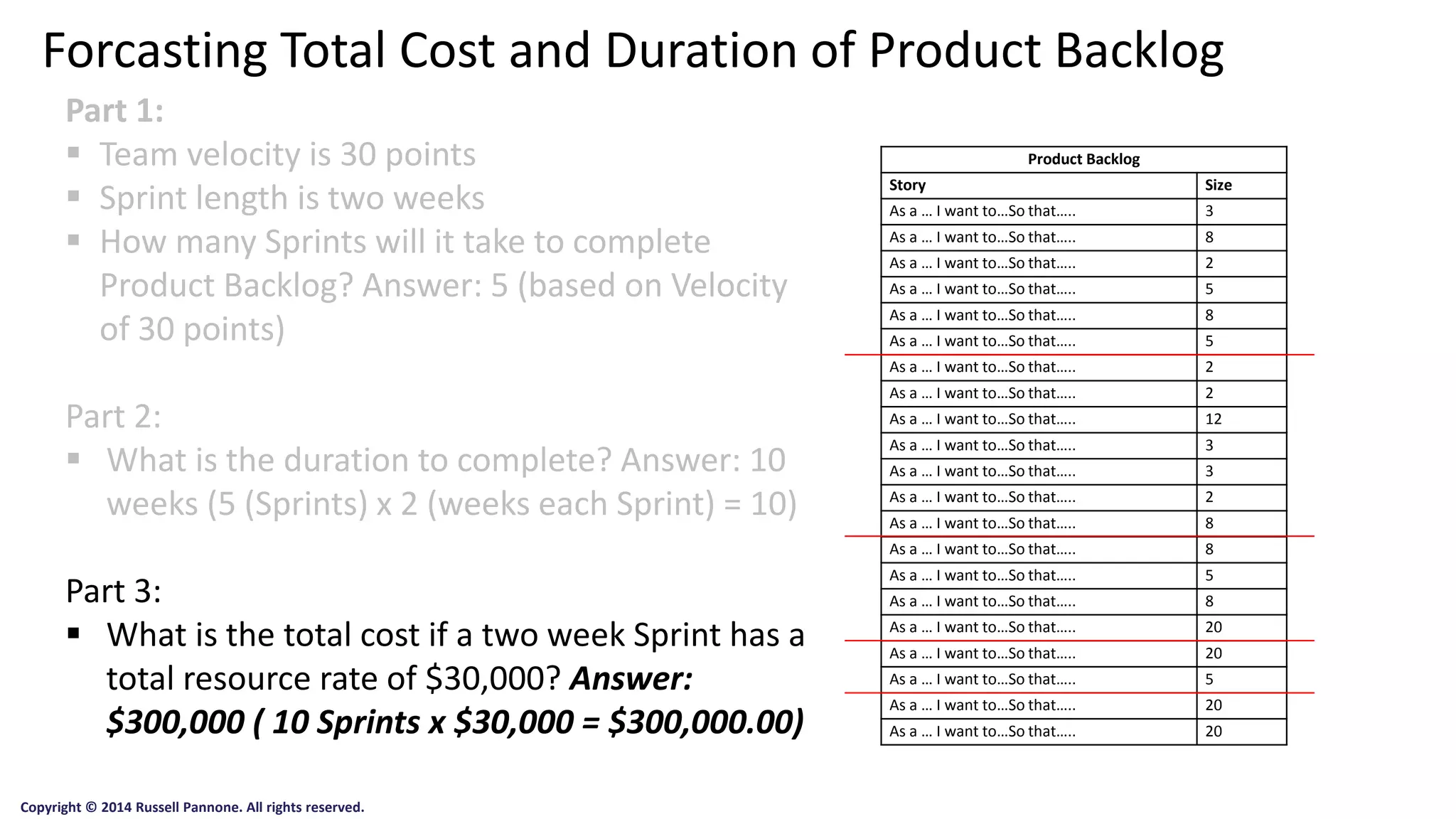

Part 1:
Team velocity is 30 points
Sprint length is two weeks
How many Sprints will it take to complete Product Backlog? Answer: 5 (based on Velocity of 30 points)
Part 2:
What is the duration to complete? Answer: 10 weeks (5 (Sprints) x 2 (weeks each Sprint) = 10)
Part 3:
What is the total cost if a two week Sprint has a total resource rate of $30,000? Answer: $300,000 ( 10 Sprints x $30,000 = $300,000.00)
Product Backlog
Story
Size
As a … I want to…So that…..
3
As a … I want to…So that…..
8
As a … I want to…So that…..
2
As a … I want to…So that…..
5
As a … I want to…So that…..
8
As a … I want to…So that…..
5
As a … I want to…So that…..
2
As a … I want to…So that…..
2
As a … I want to…So that…..
12
As a … I want to…So that…..
3
As a … I want to…So that…..
3
As a … I want to…So that…..
2
As a … I want to…So that…..
8
As a … I want to…So that…..
8
As a … I want to…So that…..
5
As a … I want to…So that…..
8
As a … I want to…So that…..
20
As a … I want to…So that…..
20
As a … I want to…So that…..
5
As a … I want to…So that…..
20
As a … I want to…So that…..
20
ForcastingTotal Cost and Duration of Product Backlog
Copyright © 2014 Russell Pannone. All rights reserved.

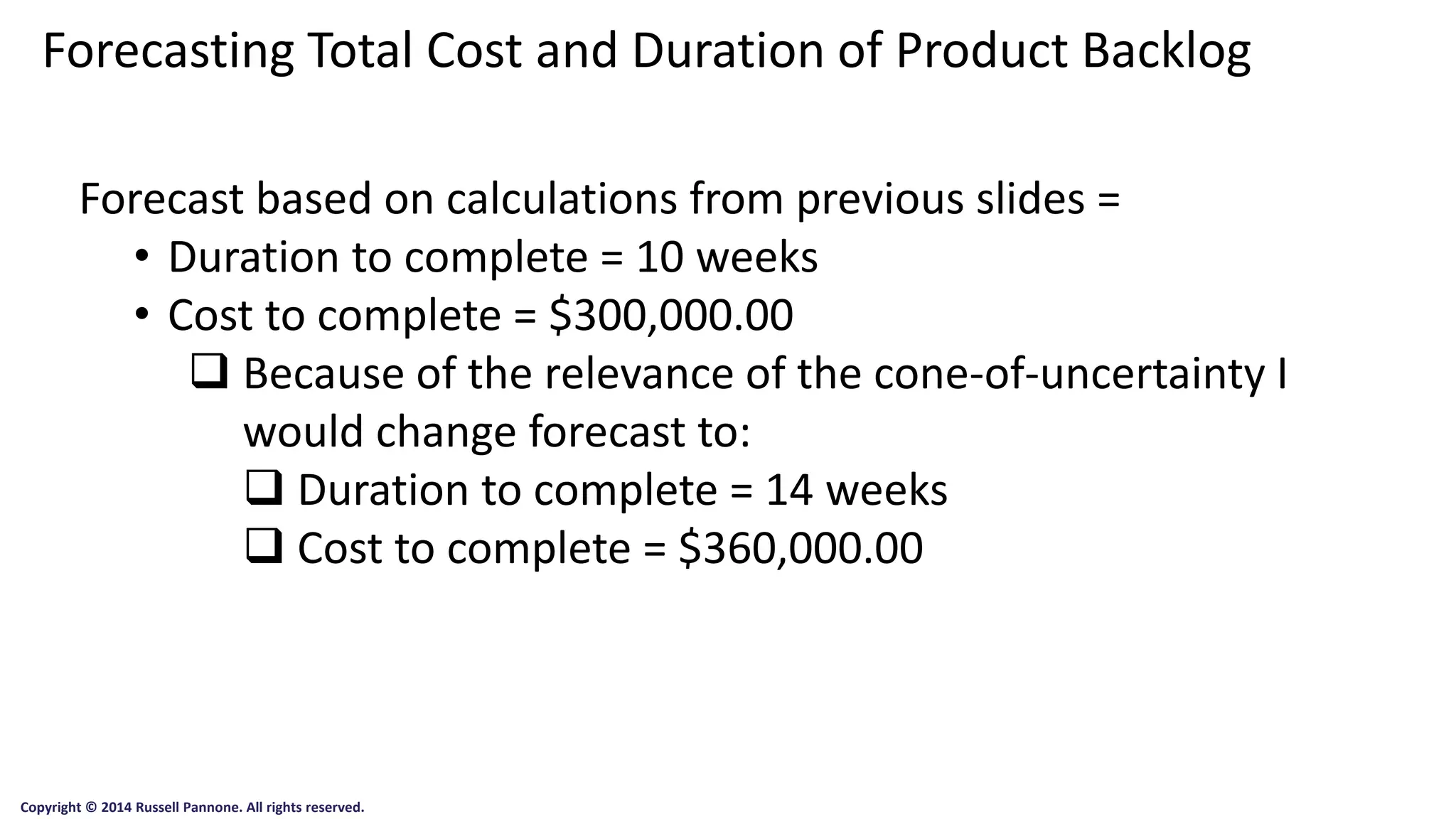

Forecasting Total Cost and Duration of Product Backlog
Copyright © 2014 Russell Pannone. All rights reserved.
Forecast based on calculations from previous slides =
•Duration to complete = 10 weeks
•Cost to complete = $300,000.00
Because of the relevance of the cone-of-uncertainty I would change forecast to:
Duration to complete = 14 weeks
Cost to complete = $360,000.00

Forecasting total cost and duration of Product Backlog

  • 1.
    Part 1: Teamvelocity is 30 points* Sprint length is two weeks** How many Sprints will it take to complete Product Backlog? Part 2: What is the duration to complete? Part 3: What is the cost if a two week Sprint has a total resource rate of $30,000? Product Backlog Story Size As a … I want to…So that….. 3 As a … I want to…So that….. 8 As a … I want to…So that….. 2 As a … I want to…So that….. 5 As a … I want to…So that….. 8 As a … I want to…So that….. 5 As a … I want to…So that….. 2 As a … I want to…So that….. 2 As a … I want to…So that….. 12 As a … I want to…So that….. 3 As a … I want to…So that….. 3 As a … I want to…So that….. 2 As a … I want to…So that….. 8 As a … I want to…So that….. 8 As a … I want to…So that….. 5 As a … I want to…So that….. 8 As a … I want to…So that….. 20 As a … I want to…So that….. 20 As a … I want to…So that….. 5 As a … I want to…So that….. 20 As a … I want to…So that….. 20 Forecasting Total Cost and Duration of Product Backlog * If team velocity is not know you can extrapolate it by conducting a pseudo Sprint Planning session **Team predetermines Sprint length –for the sake of this example I have select to use a two week Sprint Copyright © 2014 Russell Pannone. All rights reserved.
  • 2.
    Part 1: Teamvelocity is 30 points Sprint length is two weeks How many Sprints will it take to complete Product Backlog? Answer: 5 (based on Velocity of 30 points) Part 2: What is the timeline to complete? Part 3: What is the cost if a two week Sprint has a total resource rate of $30,000? Product Backlog Story Size As a … I want to…So that….. 3 As a … I want to…So that….. 8 As a … I want to…So that….. 2 As a … I want to…So that….. 5 As a … I want to…So that….. 8 As a … I want to…So that….. 5 As a … I want to…So that….. 2 As a … I want to…So that….. 2 As a … I want to…So that….. 12 As a … I want to…So that….. 3 As a … I want to…So that….. 3 As a … I want to…So that….. 2 As a … I want to…So that….. 8 As a … I want to…So that….. 8 As a … I want to…So that….. 5 As a … I want to…So that….. 8 As a … I want to…So that….. 20 As a … I want to…So that….. 20 As a … I want to…So that….. 5 As a … I want to…So that….. 20 As a … I want to…So that….. 20 Forecasting Total Cost and Duration of Product Backlog 1 2 3 4 5 Copyright © 2014 Russell Pannone. All rights reserved.
  • 3.
    Part 1: Teamvelocity is 30 points Sprint length is two weeks How many Sprints will it take to complete Product Backlog? Answer: 5 (based on Velocity of 30 points) Part 2: What is the duration to complete? Answer: 10 weeks (5 (Sprints) x 2 (weeks each Sprint) = 10) Part 3: What is the cost if a two week Sprint has a total resource rate of $30,000? Product Backlog Story Size As a … I want to…So that….. 3 As a … I want to…So that….. 8 As a … I want to…So that….. 2 As a … I want to…So that….. 5 As a … I want to…So that….. 8 As a … I want to…So that….. 5 As a … I want to…So that….. 2 As a … I want to…So that….. 2 As a … I want to…So that….. 12 As a … I want to…So that….. 3 As a … I want to…So that….. 3 As a … I want to…So that….. 2 As a … I want to…So that….. 8 As a … I want to…So that….. 8 As a … I want to…So that….. 5 As a … I want to…So that….. 8 As a … I want to…So that….. 20 As a … I want to…So that….. 20 As a … I want to…So that….. 5 As a … I want to…So that….. 20 As a … I want to…So that….. 20 Forecasting Total Cost and Duration of Product Backlog Copyright © 2014 Russell Pannone. All rights reserved.
  • 4.
    Part 1: Teamvelocity is 30 points Sprint length is two weeks How many Sprints will it take to complete Product Backlog? Answer: 5 (based on Velocity of 30 points) Part 2: What is the duration to complete? Answer: 10 weeks (5 (Sprints) x 2 (weeks each Sprint) = 10) Part 3: What is the total cost if a two week Sprint has a total resource rate of $30,000? Answer: $300,000 ( 10 Sprints x $30,000 = $300,000.00) Product Backlog Story Size As a … I want to…So that….. 3 As a … I want to…So that….. 8 As a … I want to…So that….. 2 As a … I want to…So that….. 5 As a … I want to…So that….. 8 As a … I want to…So that….. 5 As a … I want to…So that….. 2 As a … I want to…So that….. 2 As a … I want to…So that….. 12 As a … I want to…So that….. 3 As a … I want to…So that….. 3 As a … I want to…So that….. 2 As a … I want to…So that….. 8 As a … I want to…So that….. 8 As a … I want to…So that….. 5 As a … I want to…So that….. 8 As a … I want to…So that….. 20 As a … I want to…So that….. 20 As a … I want to…So that….. 5 As a … I want to…So that….. 20 As a … I want to…So that….. 20 ForcastingTotal Cost and Duration of Product Backlog Copyright © 2014 Russell Pannone. All rights reserved.
  • 5.
    Forecasting Total Costand Duration of Product Backlog Copyright © 2014 Russell Pannone. All rights reserved. Forecast based on calculations from previous slides = •Duration to complete = 10 weeks •Cost to complete = $300,000.00 Because of the relevance of the cone-of-uncertainty I would change forecast to: Duration to complete = 14 weeks Cost to complete = $360,000.00
