Essentials of Validation Project Management - Part 1
1. The Industry’s Authoritative Source
®
Essentials of Validation
Project Management
Part I
William Garvey
T
he qualification and validation of complex pharmaceutical
manufacturing facilities requires the careful coordination
VECTOR CORPORATION
of multiple activities. Conceptual, preliminary, and detailed
designs must be reviewed to ensure compliance with cur-
rent good manufacturing practices (CGMPs); protocol and stan-
dard operating procedure (SOP) formats must be developed; and
project resources must be identified and obtained. A validation
schedule must be created and integrated with the facility construc-
tion schedule. The Quality Assurance and Calibration–Metrology
To qualify and validate a pharmaceutical
departments must be notified of impending increased workloads.
manufacturing facility, one must carefully review
And finally, the manufacturer should alert the local US Food and
the facility design for compliance with good Drug Administration district office that a new facility is planned.
manufacturing practices and manage project Considering all these activities, careful planning and cautious man-
scope definition, labor and cost estimating, and agement will increase the likelihood of a successful project out-
come, no matter how difficult or complicated the project. Success-
master-plan development. These activities,
ful project completion is never guaranteed, but by implementing
properly implemented, help deliver a validated
proven techniques and the programs described in this article, a fa-
facility on schedule, at the estimated cost, and
vorable end-result is much more likely.
with expected quality. Parts 1 and 2 of this article will examine seven critical compo-
nents of a comprehensive validation program for new and reno-
William Garvey is Validation Consultant at
vated manufacturing facilities. The programs and procedures ex-
Millipore Corporation (Billerica, MA).
plained are appropriate for all commonly manufactured dosage
Phone: (781) 533-2407.
forms (e.g., tablets and capsules, active pharmaceutical ingredients
Email: William_garvey@millipore.com
[APIs], parenterals). Given that the design, construction, and qual-
Submitted: Aug. 16, 2005. Accepted: Sept. 9, 2005.
ification and validation of a major facility are relatively infrequent
events in most corporate life cycles, some of these project compo-
nents are not well known or understood. For this reason, Part 1 of
2. DATA AND REVIEW
this article examines the following areas:
• facility- and equipment-design review to en-
sure compliance with CGMP regulations;
• project scope definition, organization, and
planning;
• project labor requirements and budget;
• validation master plan development.
Part 2 will continue with a discussion of the
following validation-related subjects:
• protocol and SOP development, scheduling,
and implementation;
• design- and construction-document collec-
tion (turnover package);
• evaluation of deviations and discrepancies.
Facility- and equipment-design review
By definition, the construction of a new or ren-

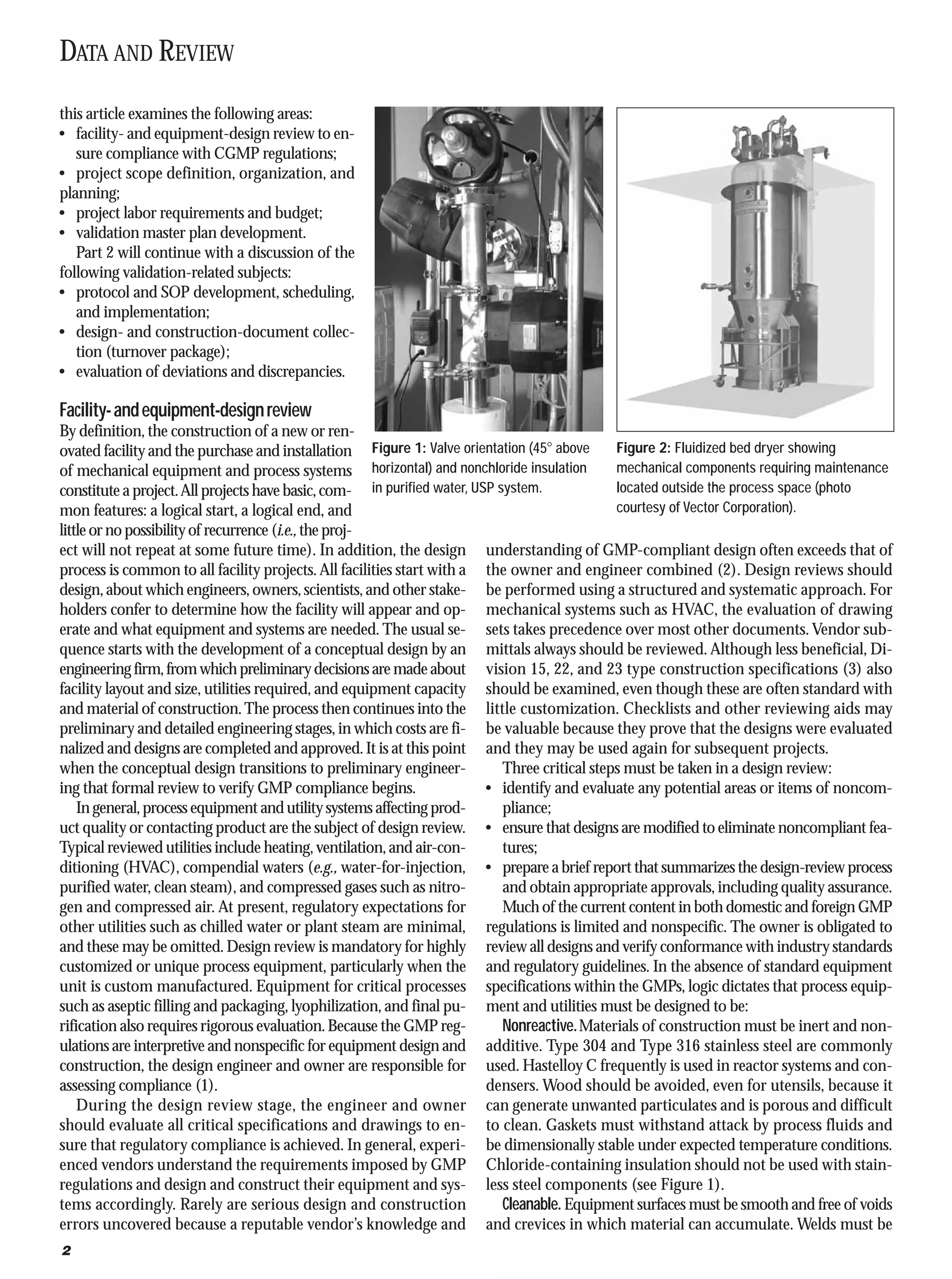

Figure 2: Fluidized bed dryer showing
ovated facility and the purchase and installation Figure 1: Valve orientation (45 above
mechanical components requiring maintenance
horizontal) and nonchloride insulation
of mechanical equipment and process systems
located outside the process space (photo
in purified water, USP system.
constitute a project. All projects have basic, com-
courtesy of Vector Corporation).
mon features: a logical start, a logical end, and
little or no possibility of recurrence (i.e., the proj-
ect will not repeat at some future time). In addition, the design understanding of GMP-compliant design often exceeds that of
process is common to all facility projects. All facilities start with a the owner and engineer combined (2). Design reviews should
design, about which engineers, owners, scientists, and other stake- be performed using a structured and systematic approach. For
holders confer to determine how the facility will appear and op- mechanical systems such as HVAC, the evaluation of drawing
erate and what equipment and systems are needed. The usual se- sets takes precedence over most other documents. Vendor sub-
quence starts with the development of a conceptual design by an mittals always should be reviewed. Although less beneficial, Di-
engineering firm, from which preliminary decisions are made about vision 15, 22, and 23 type construction specifications (3) also
facility layout and size, utilities required, and equipment capacity should be examined, even though these are often standard with
and material of construction. The process then continues into the little customization. Checklists and other reviewing aids may
preliminary and detailed engineering stages, in which costs are fi- be valuable because they prove that the designs were evaluated
nalized and designs are completed and approved. It is at this point and they may be used again for subsequent projects.
when the conceptual design transitions to preliminary engineer- Three critical steps must be taken in a design review:
ing that formal review to verify GMP compliance begins. • identify and evaluate any potential areas or items of noncom-
In general, process equipment and utility systems affecting prod- pliance;
uct quality or contacting product are the subject of design review. • ensure that designs are modified to eliminate noncompliant fea-
Typical reviewed utilities include heating, ventilation, and air-con- tures;
ditioning (HVAC), compendial waters (e.g., water-for-injection, • prepare a brief report that summarizes the design-review process
purified water, clean steam), and compressed gases such as nitro- and obtain appropriate approvals, including quality assurance.
gen and compressed air. At present, regulatory expectations for Much of the current content in both domestic and foreign GMP
other utilities such as chilled water or plant steam are minimal, regulations is limited and nonspecific. The owner is obligated to
and these may be omitted. Design review is mandatory for highly review all designs and verify conformance with industry standards
customized or unique process equipment, particularly when the and regulatory guidelines. In the absence of standard equipment
unit is custom manufactured. Equipment for critical processes specifications within the GMPs, logic dictates that process equip-
such as aseptic filling and packaging, lyophilization, and final pu- ment and utilities must be designed to be:
Nonreactive.Materials of construction must be inert and non-
rification also requires rigorous evaluation. Because the GMP reg-
ulations are interpretive and nonspecific for equipment design and additive. Type 304 and Type 316 stainless steel are commonly
construction, the design engineer and owner are responsible for used. Hastelloy C frequently is used in reactor systems and con-
assessing compliance (1). densers. Wood should be avoided, even for utensils, because it
During the design review stage, the engineer and owner can generate unwanted particulates and is porous and difficult
should evaluate all critical specifications and drawings to en- to clean. Gaskets must withstand attack by process fluids and
sure that regulatory compliance is achieved. In general, experi- be dimensionally stable under expected temperature conditions.
enced vendors understand the requirements imposed by GMP Chloride-containing insulation should not be used with stain-
regulations and design and construct their equipment and sys- less steel components (see Figure 1).
Cleanable. Equipment surfaces must be smooth and free of voids
tems accordingly. Rarely are serious design and construction
errors uncovered because a reputable vendor’s knowledge and and crevices in which material can accumulate. Welds must be
2
3. polished smooth, although mirror polishing is not always recom-
mended where glare is a concern. Short-radius corners are pre-
ferred at joined surfaces. Threaded fittings usually are not permit-
ted on sanitary systems. Diaphragm valves must be installed on
horizontal lines at 45 angles to ensure complete drainage (see
Figure 1). Labeling and packaging equipment must be designed
to permit thorough inspection. If cut labels are used, equipment
should permit stray labels to fall to the floor unimpeded. Seam-
less floor coverings should be installed where practical because
they prevent the infiltration and exfiltration of water and con-
Figure 3: Duplex steam-trap assembly at a critical air-handling unit.
taminants from and to sublayers. Valves and flanges should be
minimized in concealed-piping runs over critical process areas
where leakage or failure could be problematic. of these standards and their application to pharmaceutical man-
Maintainable. Through-the-wall designs should be used where ufacturing are readily apparent. The 3A Sanitary Standards should
serviceable mechanical components are located outside process be consulted when equipment such as holding tanks, clean-in-
spaces (see Figure 2). Such items include HVAC air-control valves place systems, valves, and pumps are undergoing GMP compli-
and instrumentation, process filters, and operator workstations. ance review. Design errors are uncommon, however, because most
Remote grease fittings should be installed on fan bearings to min- equipment vendors already fully understand and comply with these
imize air handler entry. Adequate clearance should be allowed at standards.
heat exchangers to permit coil removal and inspection. Redun- For high-value projects and facilities intended to manufacture
dancy should always be considered for mission-critical systems, sterile products, it is often required and worthwhile to contact the
including sanitary pumps, steam traps (see Figure 3), filter assem- local FDA district office. This alerts the agency that inspections
blies and regulators, and recorders on sterilizers. Ergonomics also must be scheduled, often to coincide with critical construction
should be considered. milestones and events. FDA Office of Regulatory Affairs Field Man-
Reliable and controlled. Control systems such as programmable agement Directive (FMD) 135 also encourages manufacturers to
logic controllers (PLCs) should be used to control equipment. Au- contact FDA when facility and equipment designs are being pre-
tomation allows processes to be replicated without variability, a pared (6). The following is a summary of FMD 135, which can be
fundamental principle on which GMPs are based. Mechanical- found on FDA’s Web site:
type (cam) controllers should be avoided because regulations re- Providing [FDA] review and comment is desirable because it
quire that current and modern technology be used. Manual con- may reveal [design] defects early and prevent costly construc-
trol also should be avoided where possible because replication is tion errors which could lead to defective operations and prod-
inherently difficult. Any system that may alter batch-to-batch uni- ucts. It also affords FDA the opportunity to become aware of
formity, and ultimately the product therapeutic response, must be future work load obligations and, in some cases, new technolo-
gies. Early field involvement with new or modified facilities will
very carefully considered.
increase efficiency and result in the timely processing of appli-
Correct for application. The correct design criteria must be spec-
cations (6).
ified. For example, clean compressed air must have a dewpoint
temperature of approximately –40 F to prevent condensation. Re- Companies should understand and recognize that partnering
frigerated air driers cannot meet this requirement. Oil-free com- with FDA to review proposed designs is beneficial to both parties.
pressors should be used to exclude oil contamination unless sev- Costs and delays associated with rework can be avoided if prob-
eral levels of filtration are used (4). Industry standards allow no lems are detected early. Definitive dates for facility inspections can
more than 1 ppm (1 mg/m3) of oil/hydrocarbon in compressed air. be established, which serve as endpoints that motivate project com-
Besides developing some original standards for process equip- pletion. Current agency inspectional focus also may be apparent,
ment design and construction, the pharmaceutical industry has foretold by the types of questions that are asked. Overall, early di-
borrowed standards from industries that produce similar con- alogue and FDA involvement may expedite facility completion, re-
sumer products, most notably the dairy industry. The 3-A Sani- duce engineering and construction costs, and lead to a smooth
tary Standards are voluntary guidelines followed by dairy equip- transition from start-up to operation. These results are desirable
ment vendors and dairy operators. The standards provide material for all manufacturers, regardless of company size or complexity.
specifications, design criteria, and other necessary information for
Scope definition,organization,and planning
the construction of dairy equipment to satisfy public health con-
cerns. The ultimate objective is to safeguard public health from Successfully implemented validation projects all begin with a well-
contaminated dairy products. defined scope (i.e., the set of activities and deliverables that must
To meet this objective, 3-A Sanitary Standards and 3-A occur to complete the project). Scope definition is critical if con-
Accepted Practices ensure that dairy, food, and other microbial- tracted validation resources are used because it becomes the basis
sensitive products are protected from contamination; that all prod- for cost estimates and assessing job completion.
uct contact surfaces can be cleaned in place or easily dismantled Validation project scope definition usually begins by reviewing
for manual cleaning; and that all product contact surfaces can be the following drawings and documents (7):
easily inspected to confirm cleaning effectiveness (5). The purpose • air-flow diagrams (see Figure 4);
3
4. Table I: Estimated labor hours for commissioning and qualification.
Protocol Standard operating
Commissioning Protocol preparation execution procedures
Final
System Doc. rev. Procedure Implement Doc. rev. IQ OQ IQ OQ Oper. Clean. Mainten.
Reports
Utilities
Cold glycol 2 16 20
Hot glycol 2 16 20
Steam (50 lb.) 2 16 20
Instrument air 2 16 20
Process water 2 16 24 20 16 16 16 16
Nitrogen (50 PSIG) 2 16 24 20 16 16 16 16
Chilled water 2 16 20
Tempered glycol 2 16 20
Breathing air 2 16 20
Scrubber 2 16 20
Tempered water 2 16 20
HVAC 2 24 40 32 40 20 16 16
Vacuum pump LP2 2 16 20
Vacuum pump LP4 2 8 20
Subtotal 22 168 220 6 56 88 72 72 52 48 0 48
Process equipment
T-4000 mix tank 2 16 16 24 24 16 16 16 12
Mixing vessel (T-501) 2 16 16 20 16 16 16 16 12
Mixing vessel (T-502) 2 8 8 20 16 16
T-500 reactor 2 24 24 24 24 16 16 16 16
T-504 receiver 2 16 16 20 16 16 16 16 16
T-1003 mix tank 2 8 8 20 16 16
Transfer panel system 2 16 16 24 20 12 16 16 16
Walk-in hood 2 16 20 24 24 16 16 16 16
Subtotal 16 120 124 176 156 124 96 96 88
Total 22 168 220 22 176 212 248 228 176 144 96 136
Grand total 1848
Abbreviations: Doc. rev. is document collection and review; IQ is installation qualification; OQ is operational qualification; Oper. is operation;
Clean. is cleaning; and Mainten. is maintenance.
• piping and instrumentation diagrams; qualification. Column headings and subheadings usually consist
• utility-flow diagrams; of the following:
• equipment lists. • document collection and review (to develop protocols and SOPs);
These four types of documents are common and essential to • calibration and metrology;
all validation projects, although the level of detail and content • protocol preparation (installation qualification [IQ], operational
may vary. Design-document quality is usually closely associated qualification [OQ], performance qualification [PQ], and clean-
with cost; the greater the upfront engineering costs, the more ing);
detail that can be found in drawings and lists. Because facility • protocol execution (IQ, OQ, PQ, and cleaning);
construction and protocol preparation require drawings that are • final reports;
detailed, accurate, and thoroughly checked, increased funding • turnover packages (contain construction test reports, as-built
for engineering services is usually money well spent. In general, drawings);
one can expect that the cost of facility-design services will be ap- • SOPs (operation, maintenance, cleaning).
proximately 10–12% of the facility’s total installed cost. A checkmark is placed in each cell for which a specific activity
It is useful to identify project activities on a spreadsheet when is required. This checkmark may be replaced eventually with the
establishing project scope. Systems and equipment requiring name of the individual responsible for the activity. Assigning labor
qualification and validation are first determined by reviewing the hours to each checkmark is even more useful because this provides
project documents described previously. Then, the spreadsheet an estimate of the labor required for each activity and for the en-
is created and the first column is reserved for each identified sys- tire project (see Table I).
tem and piece of equipment. Adjacent columns become a ma-
trix of activities necessary to complete system and equipment
4
5. Figure 4: Typical air-flow diagram for an API facility.
Project labor requirements and budgeting thus requiring that outside validation services be contracted. As-
By revising the spreadsheet to include labor hours, and then total- signing a dollar amount (e.g., $75) to each hour of labor provides
ing each row and column, a project labor estimate per activity and an estimate of validation project costs, which often is used to jus-
system can be derived (7). Dividing total project hours by 2080 tify requests for financial resources and to support the annual budg-
h/year provides an estimate of personnel required to complete all eting process.
activities. Total project headcount will vary depending on project Industry experience has shown that validation costs (excluding
duration, however. Anticipating the number of labor hours is im- commissioning and process validation) typically range from 2.5–5%
portant because the labor involved may exceed available resources, of the total installed cost of the facility. Aseptic-filling and biotech-
5
6. DATA AND REVIEW
nology facilities frequently have the highest validation cost, whereas portation into corresponding protocols);
API facilities tend to be the least expensive. Care must be taken not • preliminary acceptance criteria (for each system and piece of
to apply these guidelines too tightly because the percentage vali- equipment);
dation cost will vary with project size. As an example, the purchase • SOP listing;
and installation of a small steam sterilizer might have a total in- • other GMP-required activities (document control, training, en-
stalled cost of $150,000; however, the validation costs may exceed vironmental monitoring, and so forth);
$50,000 (33%), when protocol preparation and implementation, • drawings, particularly facility layouts, piping and instrumenta-
SOP development, and laboratory supplies are considered. tion diagrams, and air-flow diagrams.
On validation projects, personnel are often subdivided into If possible, special or unique features should be emphasized
teams, with one team preparing SOPs, another team preparing in the master plan, especially those that ensure product unifor-
protocols, and so forth. Alternately, one person may be assigned mity or the elimination of contamination and cross-contami-
to a specific system, taking full responsibility for protocol and SOP nation. These features might include a description of extract
preparation, implementation, and final-report development. The booths, personnel showers, and isolators used during toxic ma-
spreadsheet described previously helps with this decision. Either terials processing. Room air-change rates, personnel gowning
method is satisfactory, but the one chosen must account for per- practices, and decontamination with formaldehyde or vapor-
sonnel availability and future operational needs. Often, contrac- ized hydrogen peroxide also are worth mentioning. It is impor-
tors are employed to prepare protocols and SOPs only, while im- tant to convey quality and attention to detail in the master plan
plementation is reserved for company personnel. This approach because this document is approved by the Quality Assurance
has several benefits. First, the contractor travel expenses are min- department and often is reviewed by FDA.
imized because all document development can occur in the con- Other programs to describe in the validation master plan are
tractor’s home office. Second, protocol implementation is per- the facility revalidation program, turnover package develop-
formed by those who will ultimately operate and maintain the ment, and system or equipment commissioning. With the pub-
validated equipment and systems. This process may reduce the lication of the International Society for Pharmaceutical Engi-
transition time from start-up to manufacturing, and if properly neering’s Baseline Pharmaceutical Engineering Guide:
documented, can satisfy GMP training requirements. Commissioning and Qualification in March 2001, greater em-
phasis has been placed on system and equipment commission-
Validation master plan development ing (8). Until recently, commissioning was an activity often per-
The validation master plan complements the project scope. Al- formed without any involvement of quality assurance or
though master plans are not officially required by some regulatory validation personnel. The construction team or an agent hired
agencies, these documents may be submitted to FDA as part of the by the project manager usually performed system commission-
preoperational review program (FMD 135) discussed previously. ing. Commissioning documents were often prepared and exe-
Master plans typically describe the project scope in detail and in- cuted without any review or oversight by the Quality Assurance
clude preliminary validation acceptance criteria. They also con- department. In many instances, validation often repeated com-
tain a description of all programs that collectively make the facil- mon commissioning tests and verifications, thereby increasing
ity GMP compliant. A well-conceived and well-written master plan costs and creating inefficiencies. In addition, systems often were
reduces the likelihood that a critical activity or program will be commissioned and validated where commissioning would have
omitted and provides regulators with a sense that the company is satisfied operational requirements. It is worthwhile to identify
quality-minded and operating in a state of control. and describe the interaction between commissioning and val-
Once the project scope is determined and reduced to spread- idation in the master plan. The plan may include a description
sheet format, the spreadsheet may be imported into the draft val- of required commissioning documents and how they support
idation master plan. Master plans usually are focused on project the validation effort. In general, systems that have no product
deliverables, not costs. Therefore, estimated costs and labor hours contact are good candidates for commissioning only, although
do not need to be presented. There is no standard format for val- there are occasional exceptions to this rule.
idation master plans, although the concept has evolved so that The facility revalidation program also should be described in
many features are standard from company to company. Each mas- the master plan because the validation life cycle continues long
ter plan is an analysis and evaluation of a manufacturing facility’s after the facility is mechanically complete and handed over for op-
validation and compliance requirements. Typical master plan con- eration. Revalidation usually takes two forms: time or event based
tents include the following: (9). Time-based revalidation is the practice in which a system or
• approval page (quality-assurance approval is required); process is recertified at a specified interval. Time-based assessments
• introduction and facility description; also can include a review of historical system performance data.
• project organizational chart (optional); Event-based revalidation is implemented whenever physical or op-
• descriptions of component and material storage areas, produc- erational changes are made to the system outside the scope of the
tion areas, quality assurance areas, critical utility systems (HVAC, original validation. All such modifications are the subject of the
purified water, water-for-injection, building management sys- facility’s change control program, which also should be described
tem); in detail in the master plan.
• spreadsheet (described previously); Turnover package (TOP) development also can be described
• system and equipment descriptions (in sufficient detail for im- in the master plan. Turnover package is a system for organiz-
6
