The Emerging Demand
 for Business Project Audits
                  Presented by: Dr Raymond Young
                       DrRYoung@gmail.com

                     ISACA Technical Session
                      Sydney, 14 March 2007

© Raymond Young             The Emerging Demand for Business Project Audits   No 1

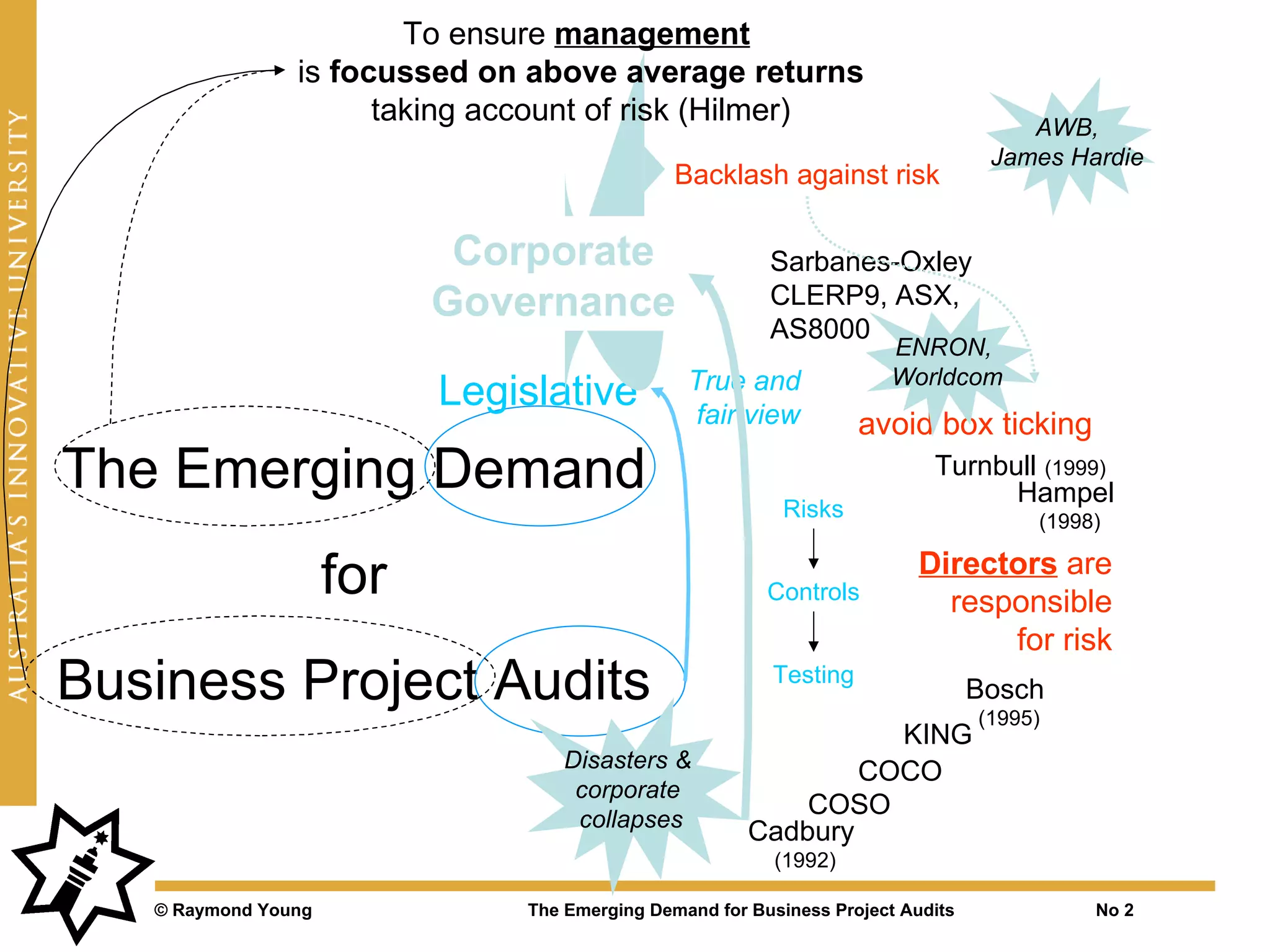

To ensure management
                is focussed on above average returns
                      taking account of risk (Hilmer)                                AWB,
                                                                                  James Hardie
                                               Backlash against risk

                            Corporate                    Sarbanes-Oxley
                           Governance                    CLERP9, ASX,
                                                         AS8000
                                                                       ENRON,
                                                True and               Worldcom
                           Legislative          fair view          avoid box ticking
The Emerging Demand                                                        Turnbull (1999)
                                                                                 Hampel
                                                           Risks                      (1998)

                     for                                 Controls
                                                                          Directors are
                                                                            responsible
                                                                                for risk
Business Project Audits                                  Testing
                                                                                 Bosch
                                                                                 (1995)
                                                                 KING
                                  Disasters &                  COCO
                                   corporate
                                   collapses
                                                           COSO
                                                       Cadbury
                                                          (1992)

   © Raymond Young             The Emerging Demand for Business Project Audits             No 2

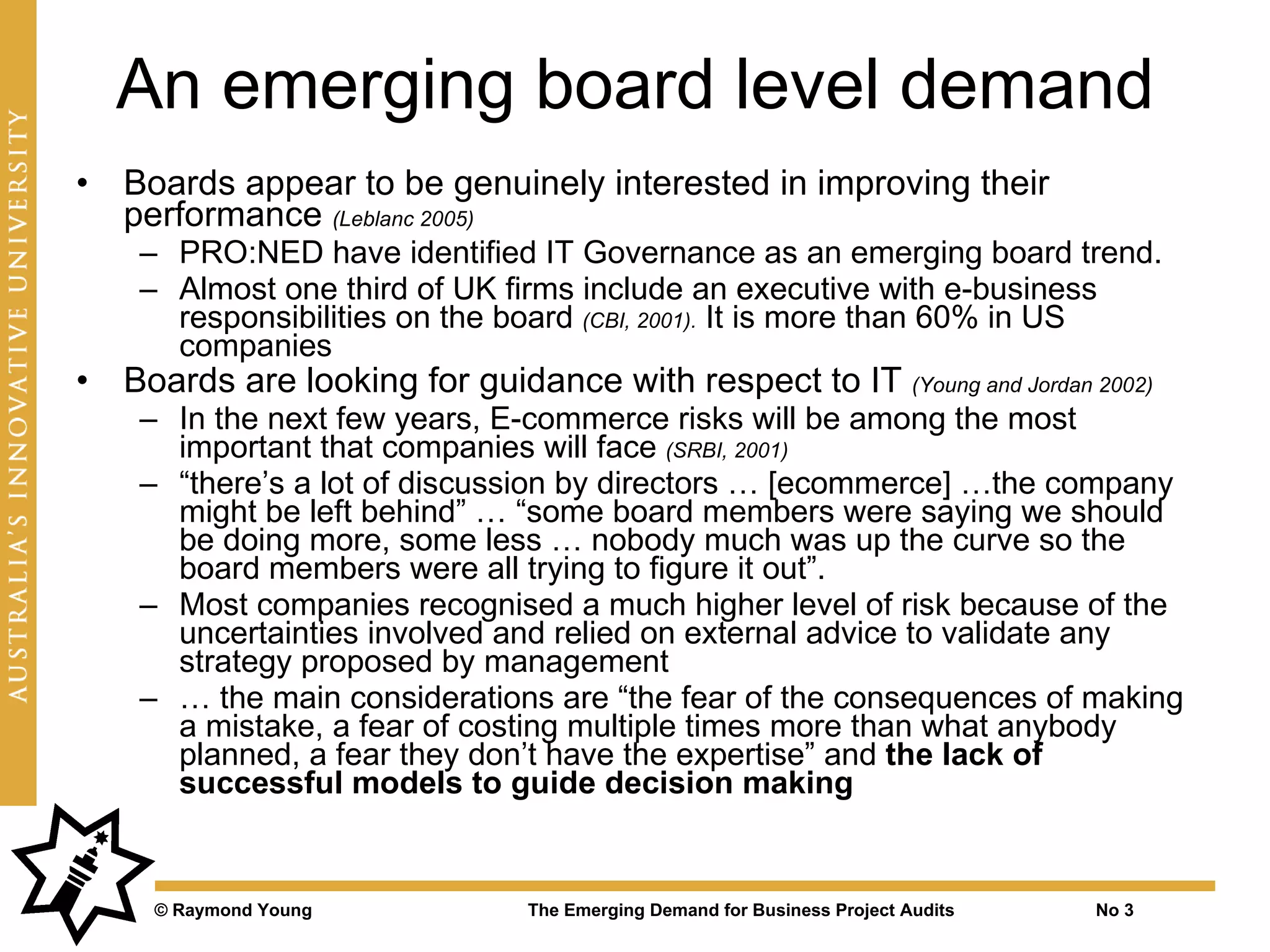

An emerging board level demand
• Boards appear to be genuinely interested in improving their
  performance (Leblanc 2005)
    – PRO:NED have identified IT Governance as an emerging board trend.
    – Almost one third of UK firms include an executive with e-business
      responsibilities on the board (CBI, 2001). It is more than 60% in US
      companies
• Boards are looking for guidance with respect to IT (Young and Jordan 2002)
    – In the next few years, E-commerce risks will be among the most
      important that companies will face (SRBI, 2001)
    – “there’s a lot of discussion by directors … [ecommerce] …the company
      might be left behind” … “some board members were saying we should
      be doing more, some less … nobody much was up the curve so the
      board members were all trying to figure it out”.
    – Most companies recognised a much higher level of risk because of the
      uncertainties involved and relied on external advice to validate any
      strategy proposed by management
    – … the main considerations are “the fear of the consequences of making
      a mistake, a fear of costing multiple times more than what anybody
      planned, a fear they don’t have the expertise” and the lack of
      successful models to guide decision making

     © Raymond Young           The Emerging Demand for Business Project Audits   No 3

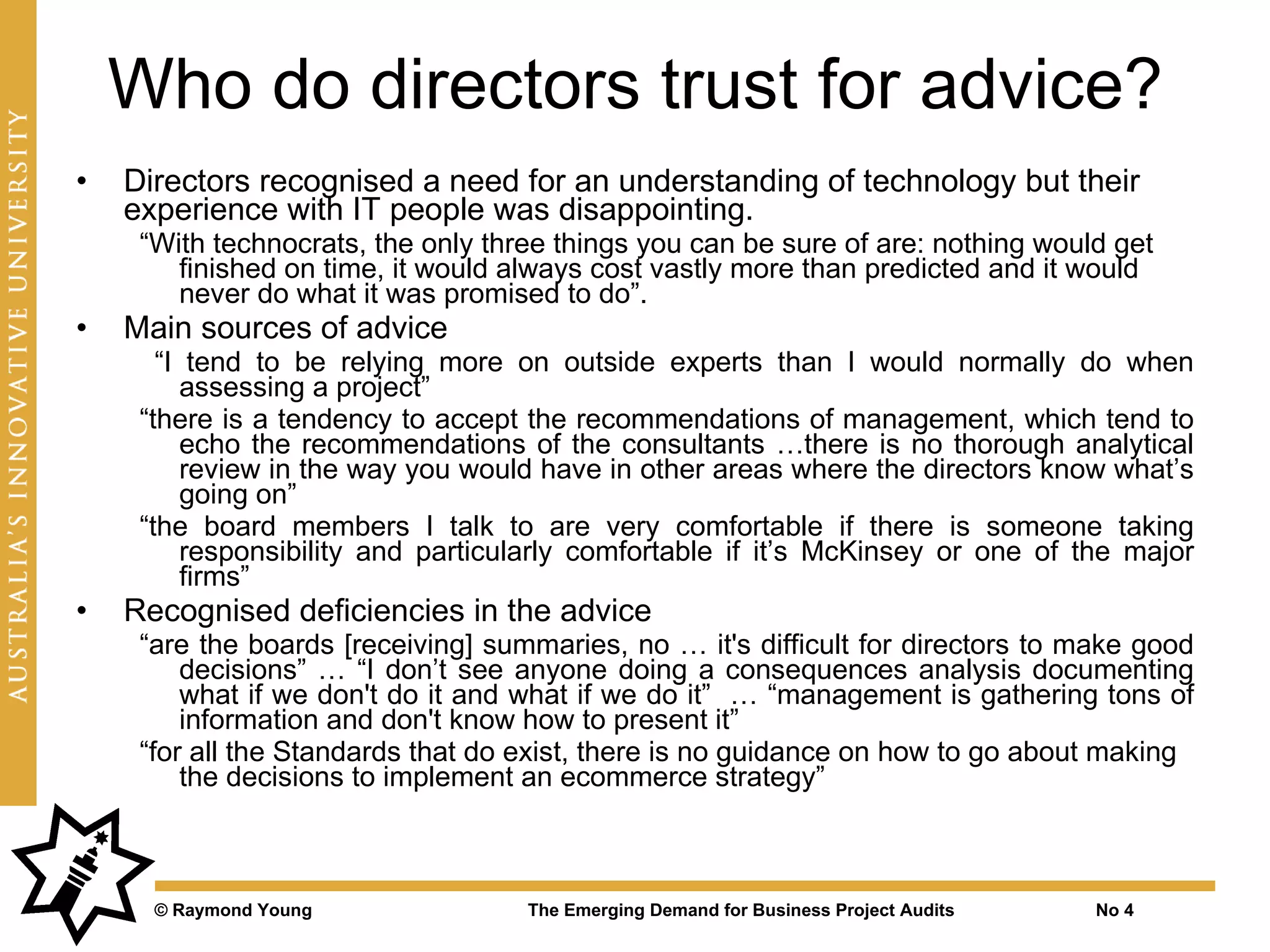

Who do directors trust for advice?
•   Directors recognised a need for an understanding of technology but their
    experience with IT people was disappointing.
     “With technocrats, the only three things you can be sure of are: nothing would get
        finished on time, it would always cost vastly more than predicted and it would
        never do what it was promised to do”.
•   Main sources of advice
       “I tend to be relying more on outside experts than I would normally do when
          assessing a project”
     “there is a tendency to accept the recommendations of management, which tend to
          echo the recommendations of the consultants …there is no thorough analytical
          review in the way you would have in other areas where the directors know what’s
          going on”
     “the board members I talk to are very comfortable if there is someone taking
          responsibility and particularly comfortable if it’s McKinsey or one of the major
          firms”
•   Recognised deficiencies in the advice
     “are the boards [receiving] summaries, no … it's difficult for directors to make good
         decisions” … “I don’t see anyone doing a consequences analysis documenting
         what if we don't do it and what if we do it” … “management is gathering tons of
         information and don't know how to present it”
     “for all the Standards that do exist, there is no guidance on how to go about making
         the decisions to implement an ecommerce strategy”

      © Raymond Young               The Emerging Demand for Business Project Audits   No 4

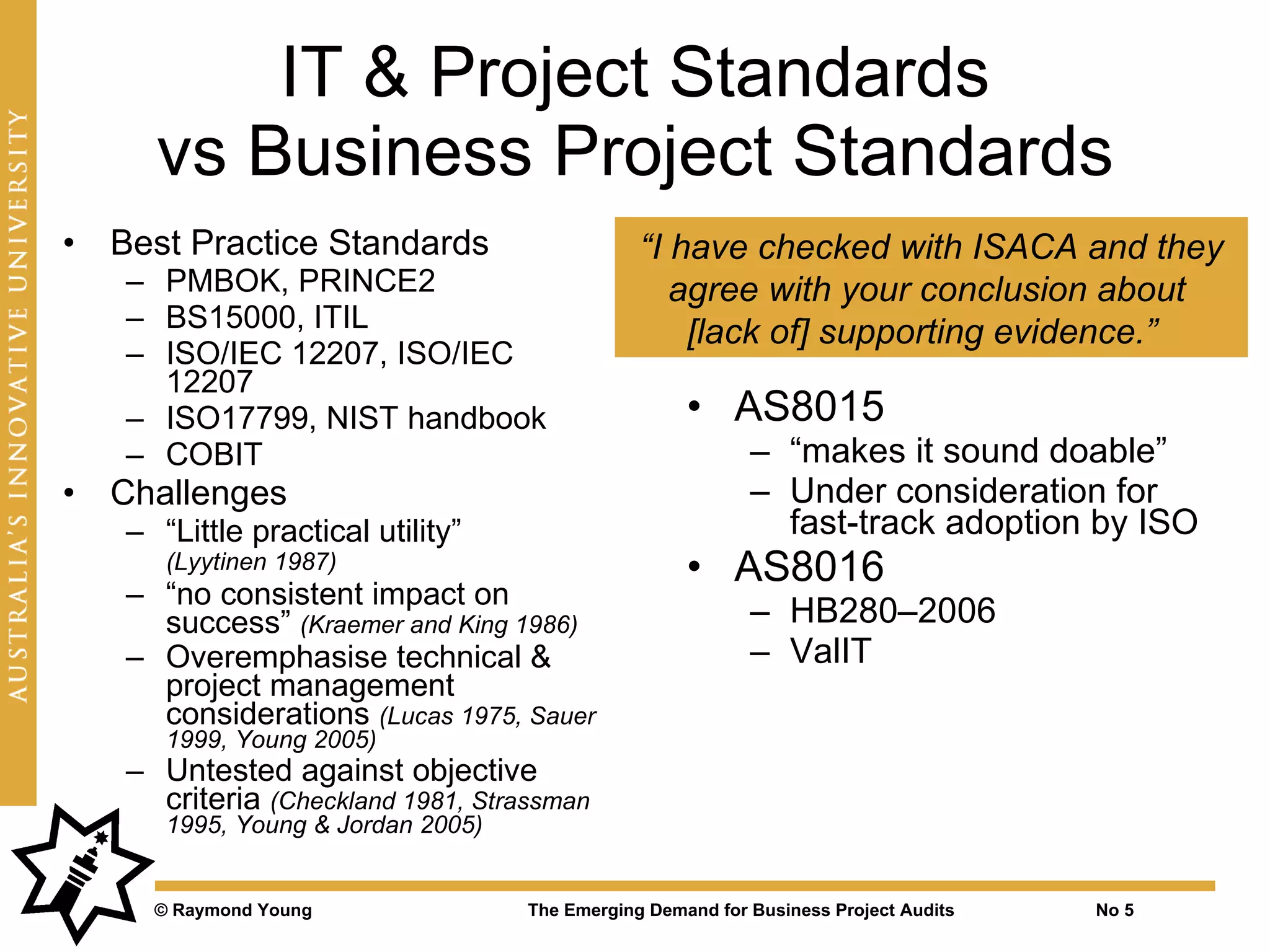

IT & Project Standards
      vs Business Project Standards
•   Best Practice Standards                     “I have checked with ISACA and they
    – PMBOK, PRINCE2                               agree with your conclusion about
    – BS15000, ITIL                                 [lack of] supporting evidence.”
    – ISO/IEC 12207, ISO/IEC
      12207
    – ISO17799, NIST handbook                        • AS8015
    – COBIT                                                 – “makes it sound doable”
•   Challenges                                              – Under consideration for
    – “Little practical utility”                              fast-track adoption by ISO
       (Lyytinen 1987)                               • AS8016
    – “no consistent impact on
      success” (Kraemer and King 1986)                      – HB280–2006
    – Overemphasise technical &                             – ValIT
      project management
      considerations (Lucas 1975, Sauer
       1999, Young 2005)
    – Untested against objective
      criteria (Checkland 1981, Strassman
       1995, Young & Jordan 2005)

      © Raymond Young               The Emerging Demand for Business Project Audits   No 5

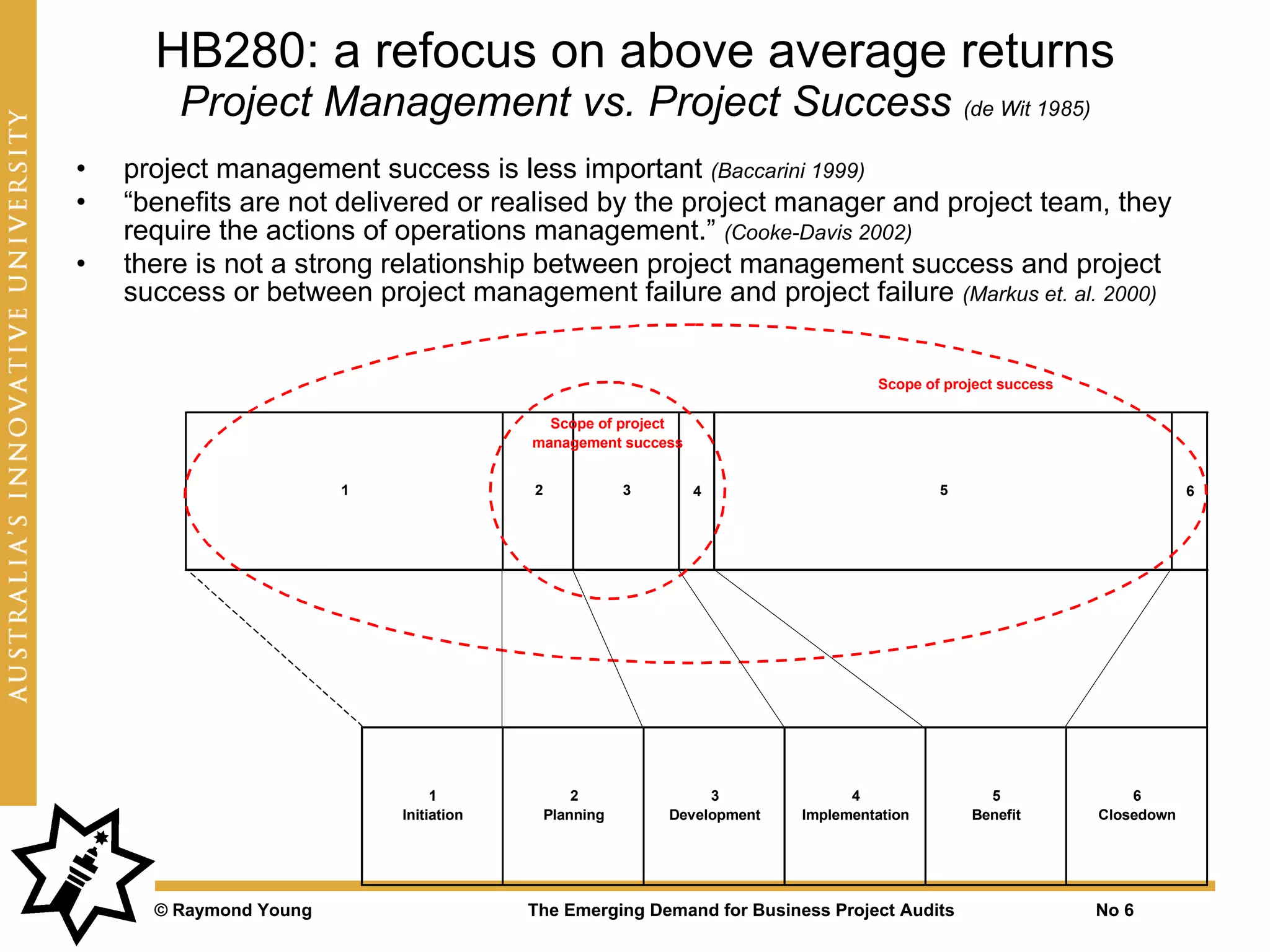

HB280: a refocus on above average returns
        Project Management vs. Project Success (de Wit 1985)
•   project management success is less important (Baccarini 1999)
•   “benefits are not delivered or realised by the project manager and project team, they
    require the actions of operations management.” (Cooke-Davis 2002)
•   there is not a strong relationship between project management success and project
    success or between project management failure and project failure (Markus et. al. 2000)

                                                                                   Scope of project success

                                           Scope of project
                                         management success

                        1                2              3     4                            5                              6

                                 1               2               3              4                5                6
                            Initiation       Planning       Development   Implementation       Benefit        Closedown

      © Raymond Young                    The Emerging Demand for Business Project Audits                      No 6

HB280: Case Studies
           What is the most important success factor?

     Hypothesis             T-Serv   T-Media         ABS           Agency          SkyHigh   Conclusion
     Top management
1.
     support                                                                            Strong support
     High level
2.
     project planning                                                                   Inconclusive
     Project
3.
     methodologies                                    -                                  Inconclusive
     User
4.
     involvement                                                                        Inconclusive

5.   Project staff                                                                      Not supported

          © Raymond Young                The Emerging Demand for Business Project Audits        No 7

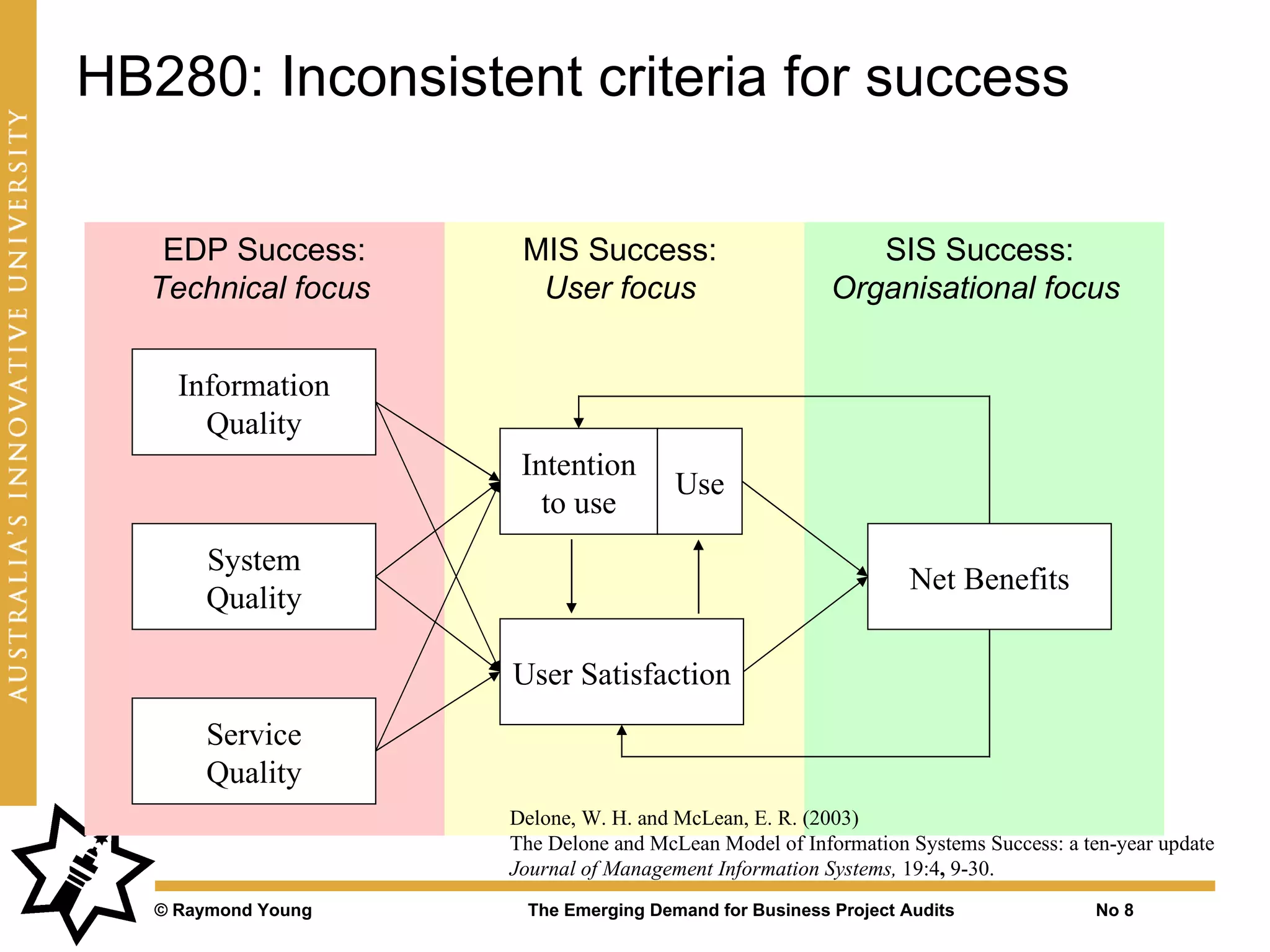

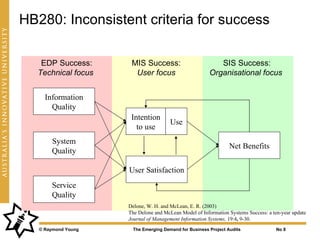

HB280: Inconsistent criteria for success

   EDP Success:       MIS Success:                         SIS Success:
  Technical focus      User focus                       Organisational focus

     Information
       Quality
                      Intention
                                       Use
                        to use
       System
                                                                Net Benefits
       Quality

                     User Satisfaction
       Service
       Quality
                     Delone, W. H. and McLean, E. R. (2003)
                     The Delone and McLean Model of Information Systems Success: a ten-year update
                     Journal of Management Information Systems, 19:4, 9-30.
   © Raymond Young    The Emerging Demand for Business Project Audits                No 8

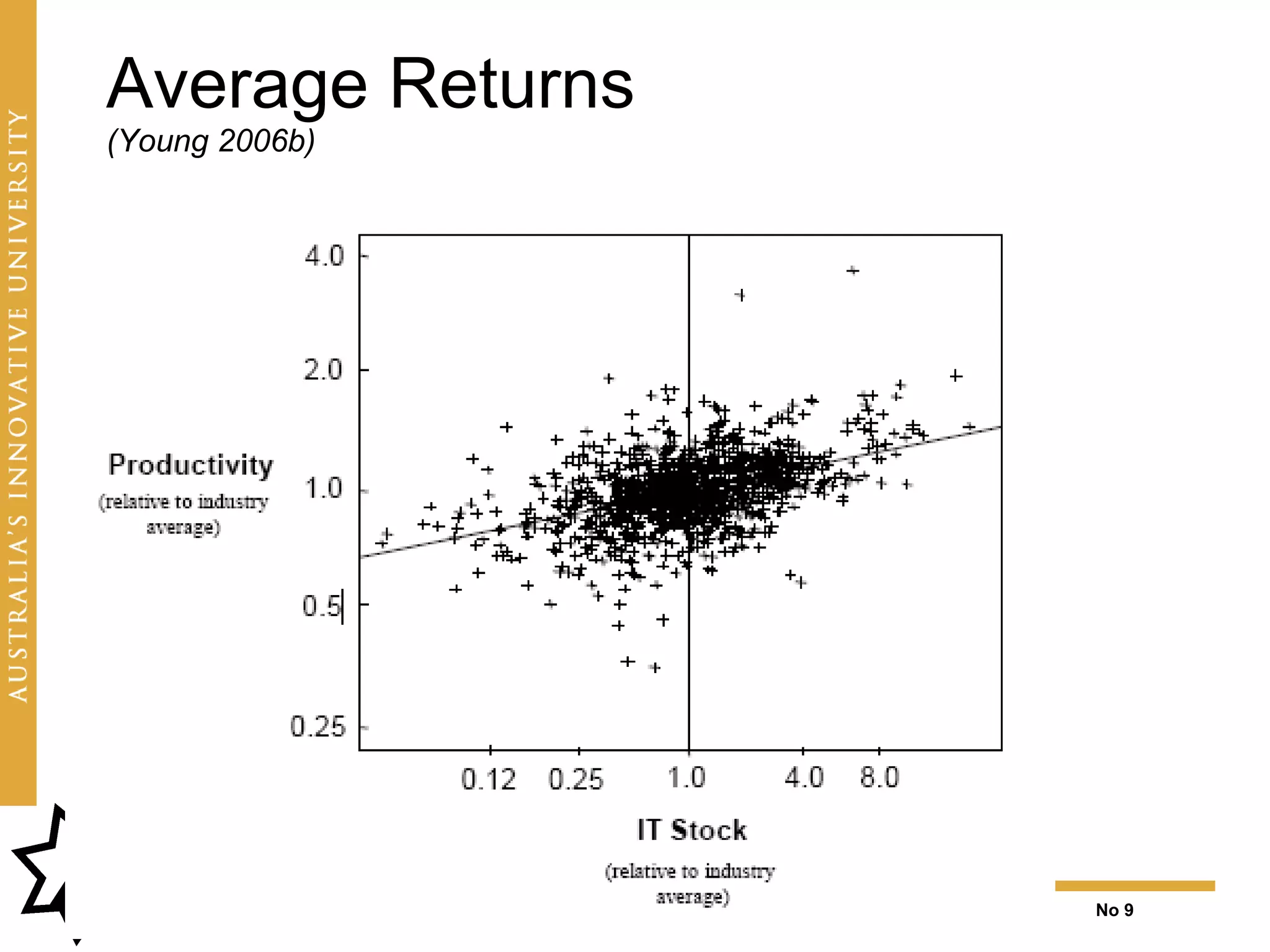

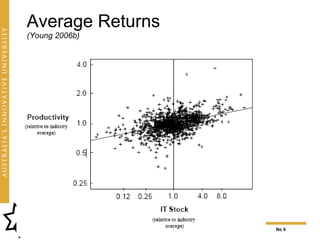

Average Returns
(Young 2006b)

                                          4–10x (Brynjolfsson & Hitt 1998)
                                          or    ROI
                                          30% (Garrity 1963)
                                                30%

                                      Some OK
   10-20% (Clegg et al 1997)

              35%
                                  2/3 of projects
            30-40%                    No
  (Willcocks and Margetts 1994)
                                  deliver no benefits
                                  whatsoever
                                      Fail

   15% (Standish 1999,2003)

   © Raymond Young                   The Emerging Demand for Business Project Audits   No 9

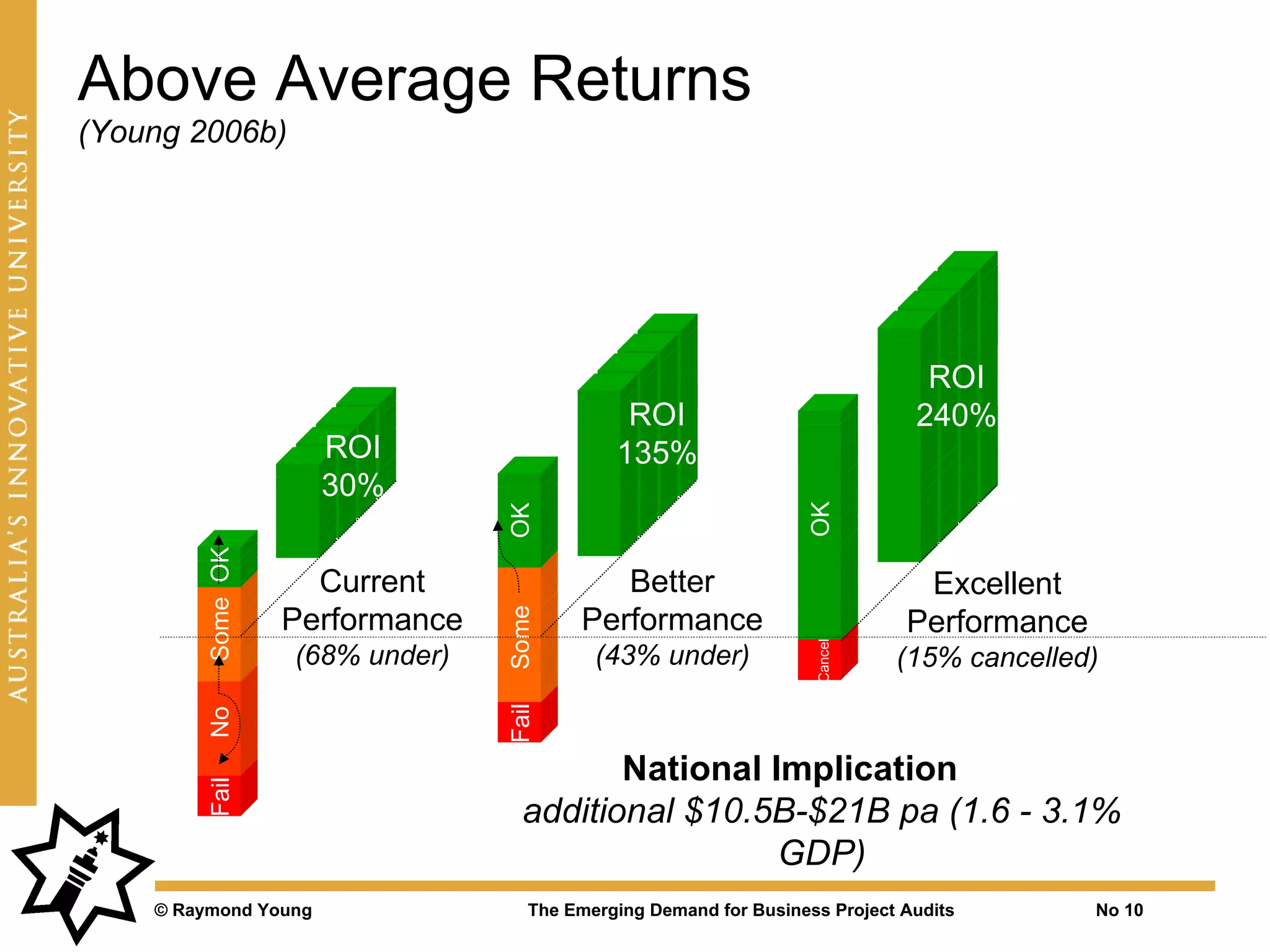

Above Average Returns
(Young 2006b)

                                                                              ROI
                                             ROI                             240%
                      ROI                   135%
                      30%

                                                                 OK
                                OK
        Some OK

                    Current                Better                            Excellent
                  Performance           Performance                         Performance
                                Some

                                                                  Cancel
                  (68% under)             (43% under)                      (15% cancelled)
                                Fail
        No

                                         National Implication
        Fail

                                  additional $10.5B-$21B pa (1.6 - 3.1%
                                                   GDP)
    © Raymond Young                The Emerging Demand for Business Project Audits        No 10

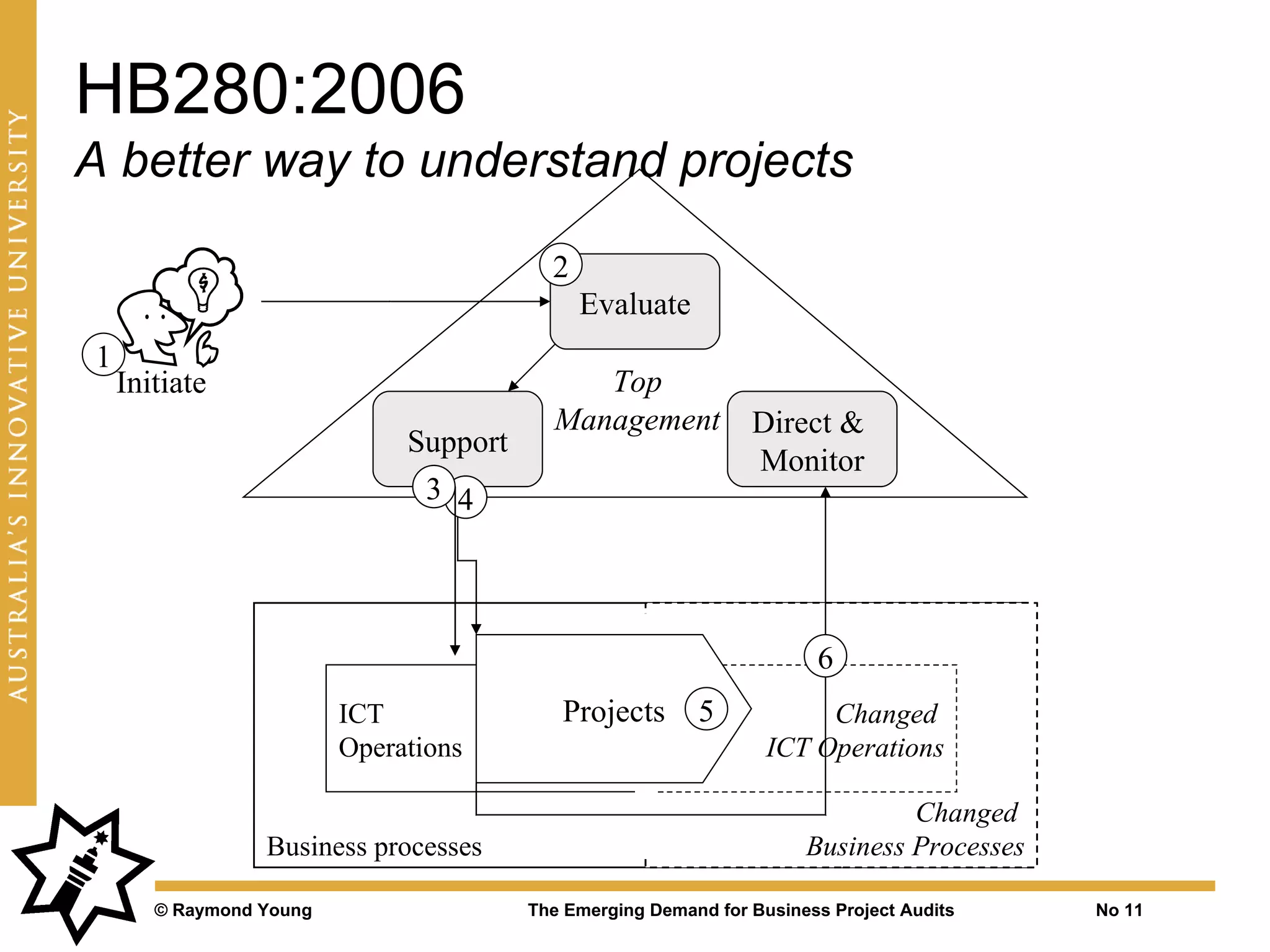

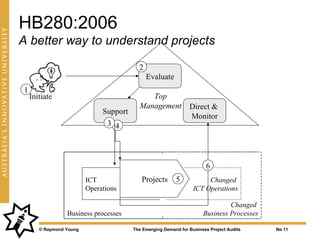

HB280:2006
A better way to understand projects

                                          2
                                              Evaluate
1
    Initiate                                 Top
                                          Management            Direct &
                              Support
                                                                Monitor
                               3 4

                                                                       6
                         ICT               Projects       5            Changed
                         Operations                               ICT Operations

                                                                               Changed
                 Business processes                                   Business Processes

       © Raymond Young                  The Emerging Demand for Business Project Audits    No 11

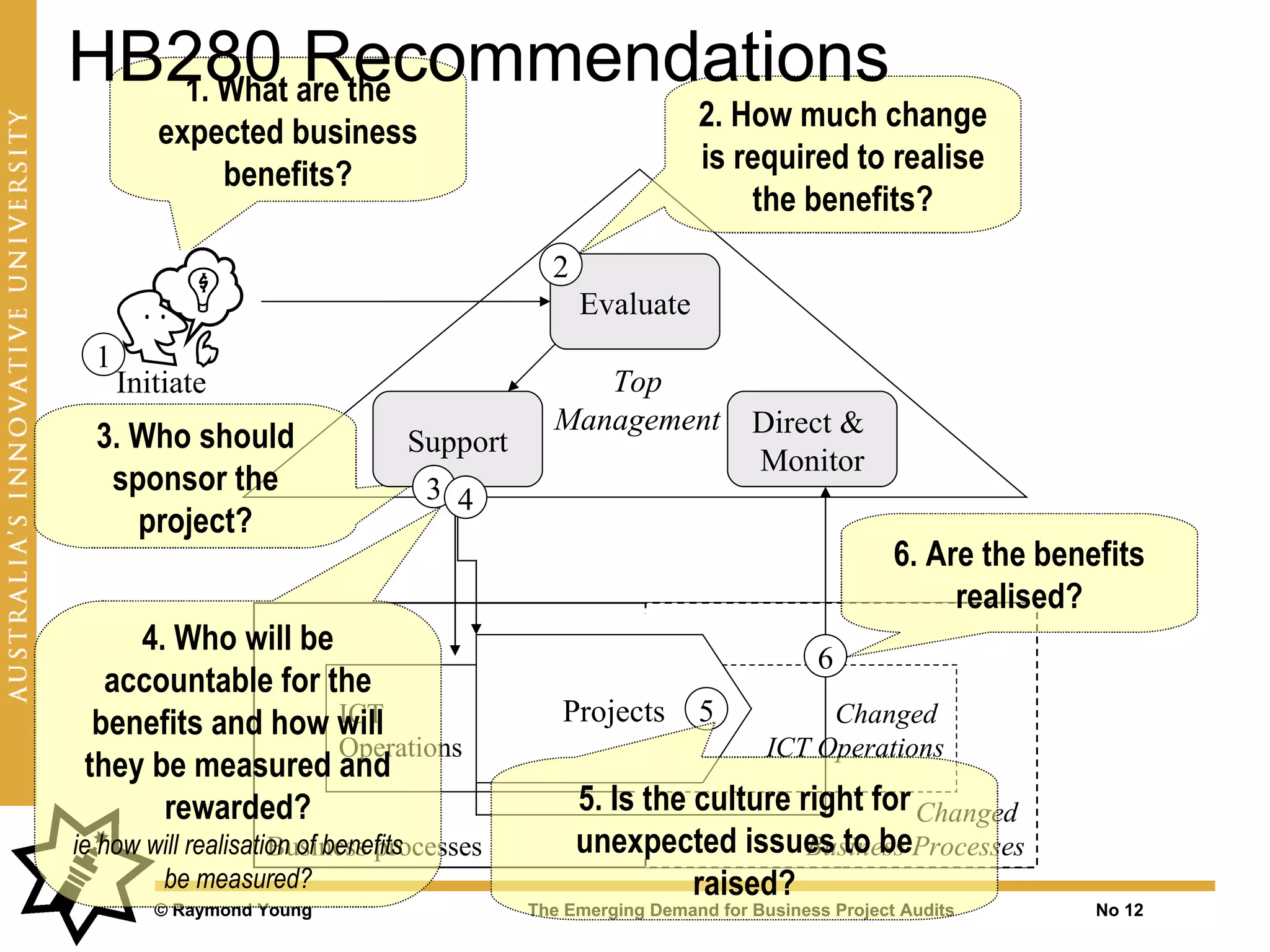

HB280 are the
   1. What
           Recommendations
         expected business                                  2. How much change
             benefits?                                      is required to realise
                                                                the benefits?
                                            2
                                                Evaluate
  1
      Initiate                                 Top
                                            Management            Direct &
  3. Who should                Support
                                                                  Monitor
   sponsor the                  3 4
     project?
                                                                                  6. Are the benefits
                                                                                       realised?
     4. Who will be
                                                                         6
   accountable for the
                    ICT
  benefits and how will                      Projects       5            Changed
                    Operations                                      ICT Operations
 they be measured and
       rewarded?                                5. Is the culture right for Changed
ie how will realisation of benefits
                     Business processes         unexpected issues to beProcesses
                                                                   Business
        be measured?                                      raised?
         © Raymond Young                  The Emerging Demand for Business Project Audits        No 12

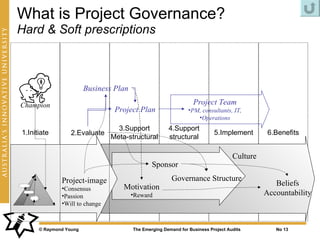

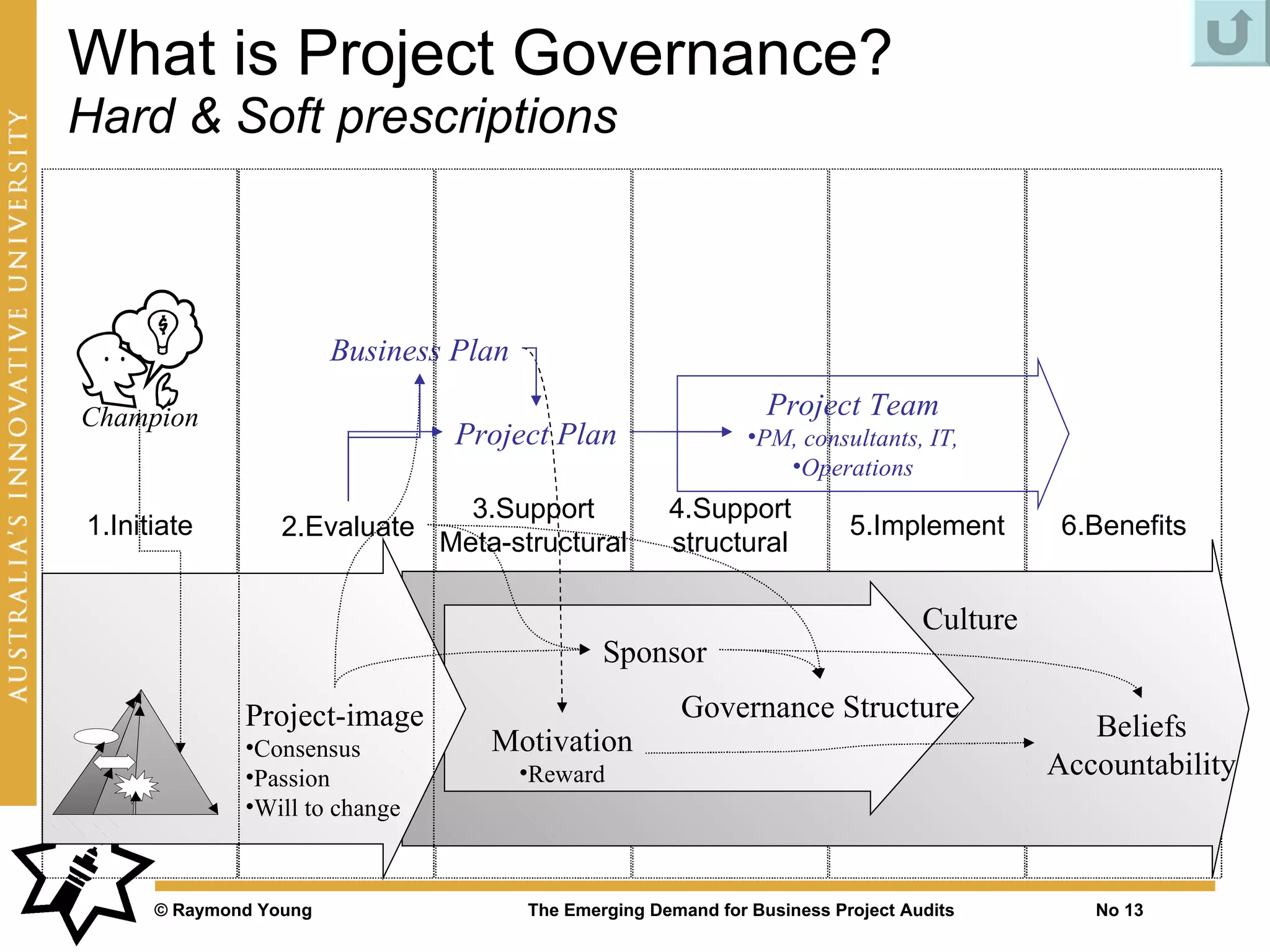

What is Project Governance?
Hard & Soft prescriptions

                        Business Plan

Champion                                                          Project Team
                                 Project Plan                   •PM, consultants, IT,
                                                                   •Operations
                                  3.Support            4.Support
1.Initiate        2.Evaluate                                               5.Implement        6.Benefits
                                Meta-structural        structural

                                                                                   Culture
                                                Sponsor

              Project-image                             Governance Structure
                                    Motivation                                                  Beliefs
              •Consensus
              •Passion                  •Reward                                              Accountability
              •Will to change

      © Raymond Young                   The Emerging Demand for Business Project Audits         No 13

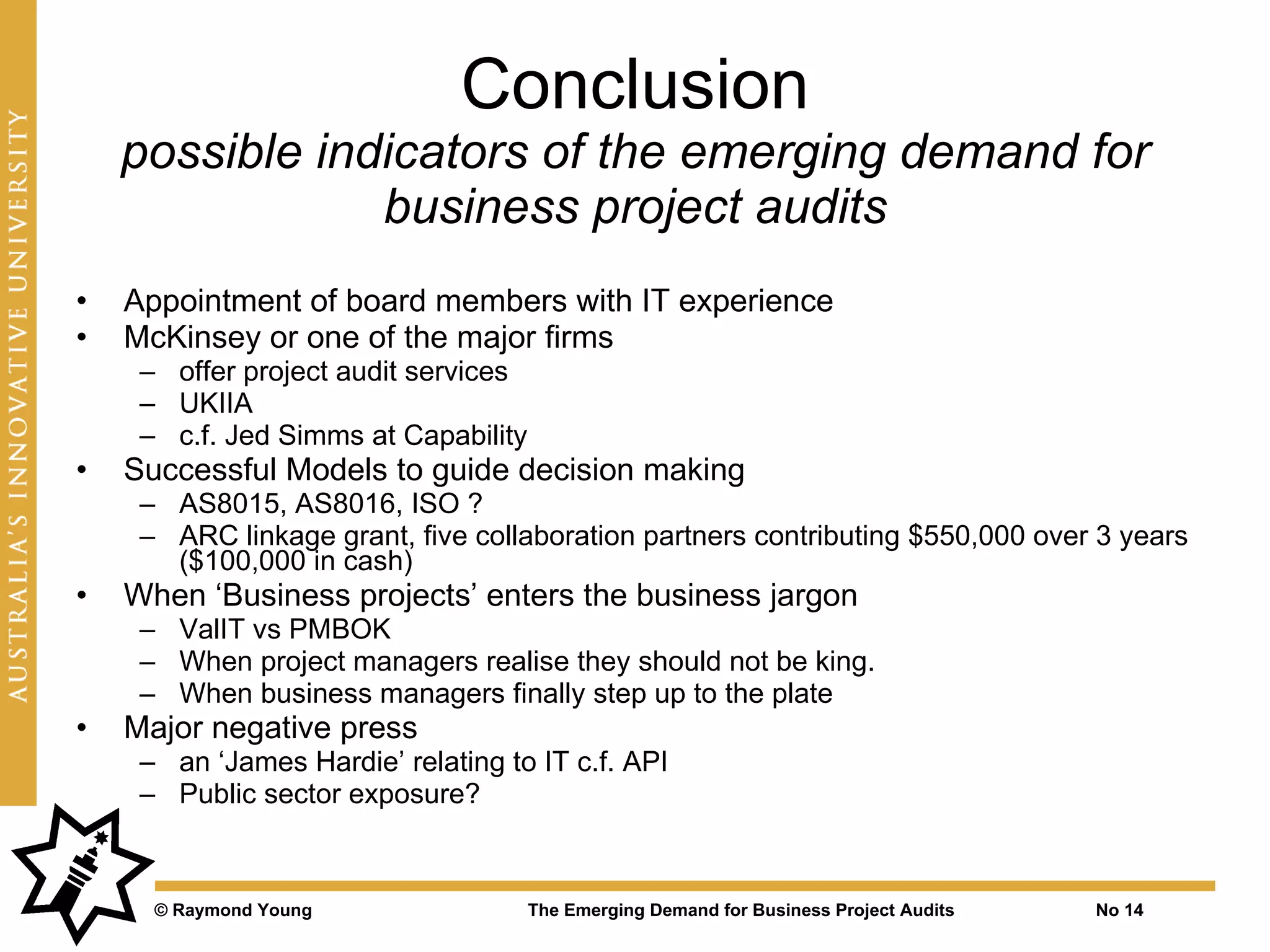

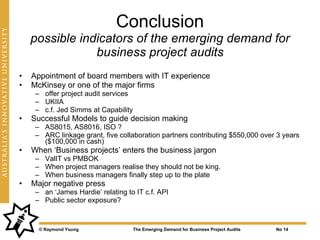

Conclusion
    possible indicators of the emerging demand for
                business project audits
•   Appointment of board members with IT experience
•   McKinsey or one of the major firms
     – offer project audit services
     – UKIIA
     – c.f. Jed Simms at Capability
•   Successful Models to guide decision making
     – AS8015, AS8016, ISO ?
     – ARC linkage grant, five collaboration partners contributing $550,000 over 3 years
       ($100,000 in cash)
•   When ‘Business projects’ enters the business jargon
     – ValIT vs PMBOK
     – When project managers realise they should not be king.
     – When business managers finally step up to the plate
•   Major negative press
     – an ‘James Hardie’ relating to IT c.f. API
     – Public sector exposure?

      © Raymond Young                 The Emerging Demand for Business Project Audits   No 14

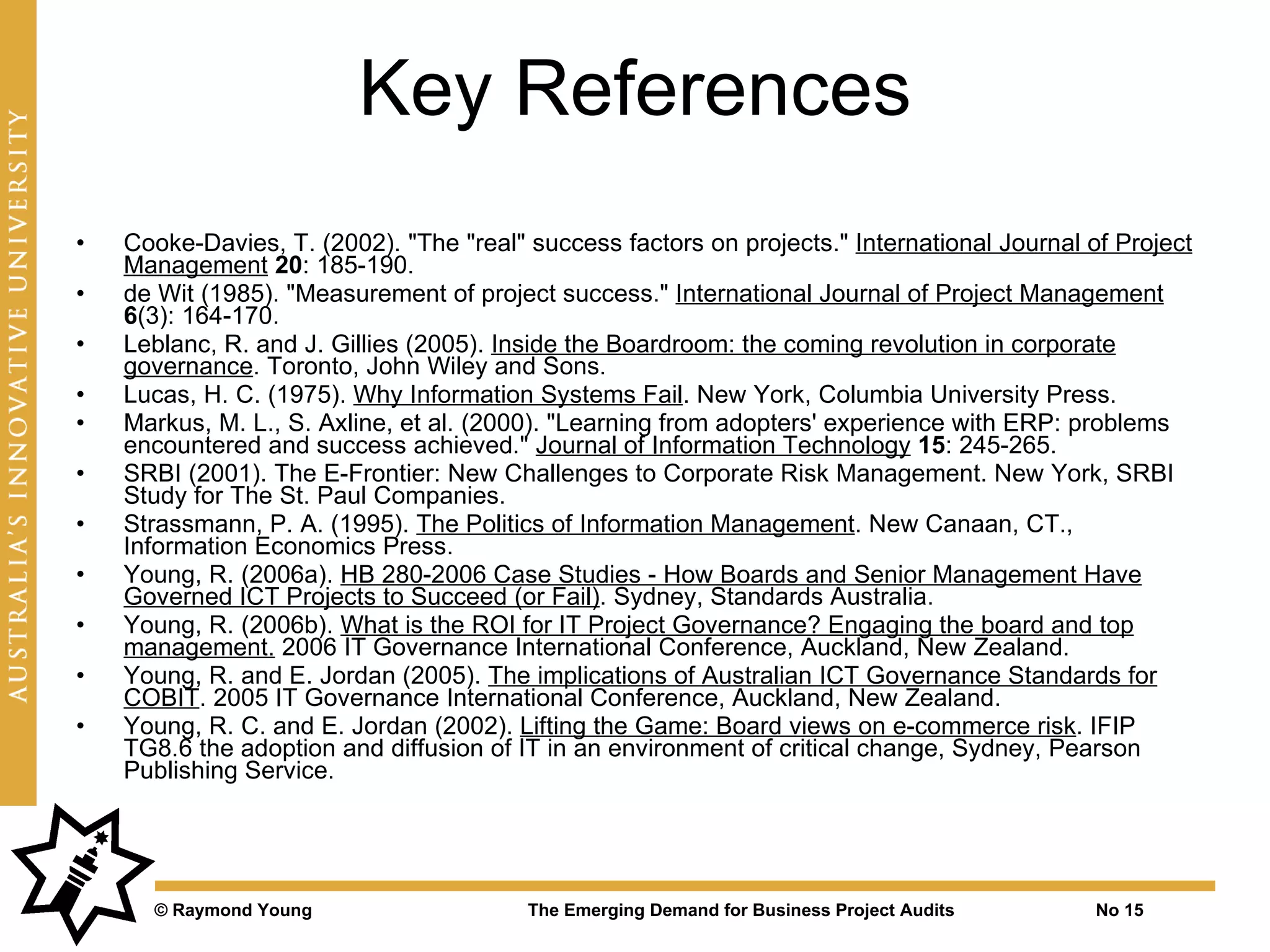

Key References
•   Cooke-Davies, T. (2002). "The "real" success factors on projects." International Journal of Project
    Management 20: 185-190.
•   de Wit (1985). "Measurement of project success." International Journal of Project Management
    6(3): 164-170.
•   Leblanc, R. and J. Gillies (2005). Inside the Boardroom: the coming revolution in corporate
    governance. Toronto, John Wiley and Sons.
•   Lucas, H. C. (1975). Why Information Systems Fail. New York, Columbia University Press.
•   Markus, M. L., S. Axline, et al. (2000). "Learning from adopters' experience with ERP: problems
    encountered and success achieved." Journal of Information Technology 15: 245-265.
•   SRBI (2001). The E-Frontier: New Challenges to Corporate Risk Management. New York, SRBI
    Study for The St. Paul Companies.
•   Strassmann, P. A. (1995). The Politics of Information Management. New Canaan, CT.,
    Information Economics Press.
•   Young, R. (2006a). HB 280-2006 Case Studies - How Boards and Senior Management Have
    Governed ICT Projects to Succeed (or Fail). Sydney, Standards Australia.
•   Young, R. (2006b). What is the ROI for IT Project Governance? Engaging the board and top
    management. 2006 IT Governance International Conference, Auckland, New Zealand.
•   Young, R. and E. Jordan (2005). The implications of Australian ICT Governance Standards for
    COBIT. 2005 IT Governance International Conference, Auckland, New Zealand.
•   Young, R. C. and E. Jordan (2002). Lifting the Game: Board views on e-commerce risk. IFIP
    TG8.6 the adoption and diffusion of IT in an environment of critical change, Sydney, Pearson
    Publishing Service.

      © Raymond Young                    The Emerging Demand for Business Project Audits      No 15
Questions

      Please provide your business card for
           a copy of this presentation

          Warning: You will be “researched”

© Raymond Young      The Emerging Demand for Business Project Audits   No 16

Emerging Demand For Business Project Audits

  • 1.
    The Emerging Demand for Business Project Audits Presented by: Dr Raymond Young DrRYoung@gmail.com ISACA Technical Session Sydney, 14 March 2007 © Raymond Young The Emerging Demand for Business Project Audits No 1
  • 2.
    To ensure management is focussed on above average returns taking account of risk (Hilmer) AWB, James Hardie Backlash against risk Corporate Sarbanes-Oxley Governance CLERP9, ASX, AS8000 ENRON, True and Worldcom Legislative fair view avoid box ticking The Emerging Demand Turnbull (1999) Hampel Risks (1998) for Controls Directors are responsible for risk Business Project Audits Testing Bosch (1995) KING Disasters & COCO corporate collapses COSO Cadbury (1992) © Raymond Young The Emerging Demand for Business Project Audits No 2
  • 3.
    An emerging boardlevel demand • Boards appear to be genuinely interested in improving their performance (Leblanc 2005) – PRO:NED have identified IT Governance as an emerging board trend. – Almost one third of UK firms include an executive with e-business responsibilities on the board (CBI, 2001). It is more than 60% in US companies • Boards are looking for guidance with respect to IT (Young and Jordan 2002) – In the next few years, E-commerce risks will be among the most important that companies will face (SRBI, 2001) – “there’s a lot of discussion by directors … [ecommerce] …the company might be left behind” … “some board members were saying we should be doing more, some less … nobody much was up the curve so the board members were all trying to figure it out”. – Most companies recognised a much higher level of risk because of the uncertainties involved and relied on external advice to validate any strategy proposed by management – … the main considerations are “the fear of the consequences of making a mistake, a fear of costing multiple times more than what anybody planned, a fear they don’t have the expertise” and the lack of successful models to guide decision making © Raymond Young The Emerging Demand for Business Project Audits No 3
  • 4.
    Who do directorstrust for advice? • Directors recognised a need for an understanding of technology but their experience with IT people was disappointing. “With technocrats, the only three things you can be sure of are: nothing would get finished on time, it would always cost vastly more than predicted and it would never do what it was promised to do”. • Main sources of advice “I tend to be relying more on outside experts than I would normally do when assessing a project” “there is a tendency to accept the recommendations of management, which tend to echo the recommendations of the consultants …there is no thorough analytical review in the way you would have in other areas where the directors know what’s going on” “the board members I talk to are very comfortable if there is someone taking responsibility and particularly comfortable if it’s McKinsey or one of the major firms” • Recognised deficiencies in the advice “are the boards [receiving] summaries, no … it's difficult for directors to make good decisions” … “I don’t see anyone doing a consequences analysis documenting what if we don't do it and what if we do it” … “management is gathering tons of information and don't know how to present it” “for all the Standards that do exist, there is no guidance on how to go about making the decisions to implement an ecommerce strategy” © Raymond Young The Emerging Demand for Business Project Audits No 4
  • 5.
    IT & ProjectStandards vs Business Project Standards • Best Practice Standards “I have checked with ISACA and they – PMBOK, PRINCE2 agree with your conclusion about – BS15000, ITIL [lack of] supporting evidence.” – ISO/IEC 12207, ISO/IEC 12207 – ISO17799, NIST handbook • AS8015 – COBIT – “makes it sound doable” • Challenges – Under consideration for – “Little practical utility” fast-track adoption by ISO (Lyytinen 1987) • AS8016 – “no consistent impact on success” (Kraemer and King 1986) – HB280–2006 – Overemphasise technical & – ValIT project management considerations (Lucas 1975, Sauer 1999, Young 2005) – Untested against objective criteria (Checkland 1981, Strassman 1995, Young & Jordan 2005) © Raymond Young The Emerging Demand for Business Project Audits No 5
  • 6.
    HB280: a refocuson above average returns Project Management vs. Project Success (de Wit 1985) • project management success is less important (Baccarini 1999) • “benefits are not delivered or realised by the project manager and project team, they require the actions of operations management.” (Cooke-Davis 2002) • there is not a strong relationship between project management success and project success or between project management failure and project failure (Markus et. al. 2000) Scope of project success Scope of project management success 1 2 3 4 5 6 1 2 3 4 5 6 Initiation Planning Development Implementation Benefit Closedown © Raymond Young The Emerging Demand for Business Project Audits No 6
  • 7.
    HB280: Case Studies What is the most important success factor? Hypothesis T-Serv T-Media ABS Agency SkyHigh Conclusion Top management 1. support      Strong support High level 2. project planning      Inconclusive Project 3. methodologies   -   Inconclusive User 4. involvement      Inconclusive 5. Project staff      Not supported © Raymond Young The Emerging Demand for Business Project Audits No 7
  • 8.
    HB280: Inconsistent criteriafor success EDP Success: MIS Success: SIS Success: Technical focus User focus Organisational focus Information Quality Intention Use to use System Net Benefits Quality User Satisfaction Service Quality Delone, W. H. and McLean, E. R. (2003) The Delone and McLean Model of Information Systems Success: a ten-year update Journal of Management Information Systems, 19:4, 9-30. © Raymond Young The Emerging Demand for Business Project Audits No 8
  • 9.
    Average Returns (Young 2006b) 4–10x (Brynjolfsson & Hitt 1998) or ROI 30% (Garrity 1963) 30% Some OK 10-20% (Clegg et al 1997) 35% 2/3 of projects 30-40% No (Willcocks and Margetts 1994) deliver no benefits whatsoever Fail 15% (Standish 1999,2003) © Raymond Young The Emerging Demand for Business Project Audits No 9
  • 10.
    Above Average Returns (Young2006b) ROI ROI 240% ROI 135% 30% OK OK Some OK Current Better Excellent Performance Performance Performance Some Cancel (68% under) (43% under) (15% cancelled) Fail No National Implication Fail additional $10.5B-$21B pa (1.6 - 3.1% GDP) © Raymond Young The Emerging Demand for Business Project Audits No 10
  • 11.
    HB280:2006 A better wayto understand projects 2 Evaluate 1 Initiate Top Management Direct & Support Monitor 3 4 6 ICT Projects 5 Changed Operations ICT Operations Changed Business processes Business Processes © Raymond Young The Emerging Demand for Business Project Audits No 11
  • 12.
    HB280 are the 1. What Recommendations expected business 2. How much change benefits? is required to realise the benefits? 2 Evaluate 1 Initiate Top Management Direct & 3. Who should Support Monitor sponsor the 3 4 project? 6. Are the benefits realised? 4. Who will be 6 accountable for the ICT benefits and how will Projects 5 Changed Operations ICT Operations they be measured and rewarded? 5. Is the culture right for Changed ie how will realisation of benefits Business processes unexpected issues to beProcesses Business be measured? raised? © Raymond Young The Emerging Demand for Business Project Audits No 12
  • 13.
    What is ProjectGovernance? Hard & Soft prescriptions Business Plan Champion Project Team Project Plan •PM, consultants, IT, •Operations 3.Support 4.Support 1.Initiate 2.Evaluate 5.Implement 6.Benefits Meta-structural structural Culture Sponsor Project-image Governance Structure Motivation Beliefs •Consensus •Passion •Reward Accountability •Will to change © Raymond Young The Emerging Demand for Business Project Audits No 13
  • 14.
    Conclusion possible indicators of the emerging demand for business project audits • Appointment of board members with IT experience • McKinsey or one of the major firms – offer project audit services – UKIIA – c.f. Jed Simms at Capability • Successful Models to guide decision making – AS8015, AS8016, ISO ? – ARC linkage grant, five collaboration partners contributing $550,000 over 3 years ($100,000 in cash) • When ‘Business projects’ enters the business jargon – ValIT vs PMBOK – When project managers realise they should not be king. – When business managers finally step up to the plate • Major negative press – an ‘James Hardie’ relating to IT c.f. API – Public sector exposure? © Raymond Young The Emerging Demand for Business Project Audits No 14
  • 15.
    Key References • Cooke-Davies, T. (2002). "The "real" success factors on projects." International Journal of Project Management 20: 185-190. • de Wit (1985). "Measurement of project success." International Journal of Project Management 6(3): 164-170. • Leblanc, R. and J. Gillies (2005). Inside the Boardroom: the coming revolution in corporate governance. Toronto, John Wiley and Sons. • Lucas, H. C. (1975). Why Information Systems Fail. New York, Columbia University Press. • Markus, M. L., S. Axline, et al. (2000). "Learning from adopters' experience with ERP: problems encountered and success achieved." Journal of Information Technology 15: 245-265. • SRBI (2001). The E-Frontier: New Challenges to Corporate Risk Management. New York, SRBI Study for The St. Paul Companies. • Strassmann, P. A. (1995). The Politics of Information Management. New Canaan, CT., Information Economics Press. • Young, R. (2006a). HB 280-2006 Case Studies - How Boards and Senior Management Have Governed ICT Projects to Succeed (or Fail). Sydney, Standards Australia. • Young, R. (2006b). What is the ROI for IT Project Governance? Engaging the board and top management. 2006 IT Governance International Conference, Auckland, New Zealand. • Young, R. and E. Jordan (2005). The implications of Australian ICT Governance Standards for COBIT. 2005 IT Governance International Conference, Auckland, New Zealand. • Young, R. C. and E. Jordan (2002). Lifting the Game: Board views on e-commerce risk. IFIP TG8.6 the adoption and diffusion of IT in an environment of critical change, Sydney, Pearson Publishing Service. © Raymond Young The Emerging Demand for Business Project Audits No 15
  • 16.
    Questions Please provide your business card for a copy of this presentation Warning: You will be “researched” © Raymond Young The Emerging Demand for Business Project Audits No 16
