Introduction
One of the most environmental
problems that people are facing
now is the proper management of
our wastes. Wastes are
everywhere and these impose
health related problems if not
manage in right way.
Government primarily is concern with
this problem. That is why, they create
laws to complement with this matter.
Moreover, local officials from Brgy.
Inocencio, Trece Martires, Cavite is
supporting it by implementing a pilot
project on solid waste management in
their area. The question is, will the
residents of Brgy. Inocencio willing to
support the project?
Map of the Philippines
MAP OF CAVITE

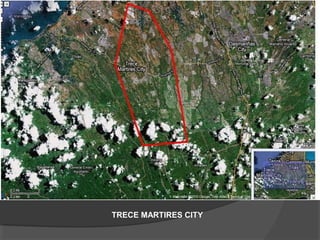

TRECE MARTIRES CITY

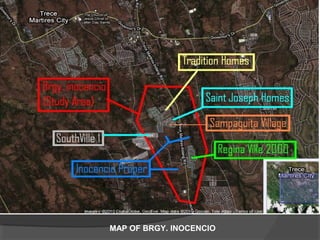

MAP OF BRGY. INOCENCIO
Barangay Inocencio
 one of the thirteen barangay in Trece
Martires City, Cavite.
 has been named in honor of Maximo
Inocencio.
 Total area= 243 hectares
 Adjacent barangays
Luciano on the North
Alulod Indang, Cavite on the
South
Conchu on the East
Aguado on the West
 Has a total population of 28,299.
(census by the Barangay Nutrition Scholar,
BNS)
 Land use- Agri-business
 Terrain Characteristics- rolling terrain
 Type of soil:
90% clay loam
10% clay

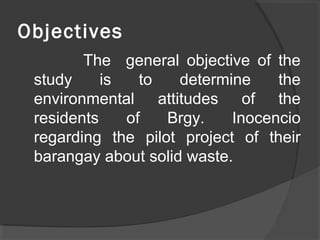

Objectives
The general objective of the
study is to determine the
environmental attitudes of the
residents of Brgy. Inocencio
regarding the pilot project of their
barangay about solid waste.
Specifically, this study aims:
 to identify the project of Brgy.
Inocencio about solid waste;
 to identify each process of the
project;
 to identify the respondents’
attitudes towards the project.

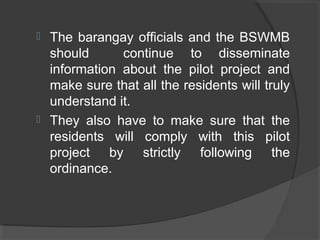

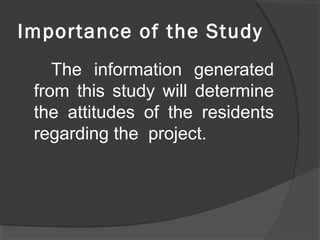

Importance of the Study
The information generated
from this study will determine
the attitudes of the residents
regarding the project.
This case study will help the
residents of Brgy Inocencio
become more aware with the
project of the barangay.
Moreover, the people will support
for the success of the project if
they really aware of the project.

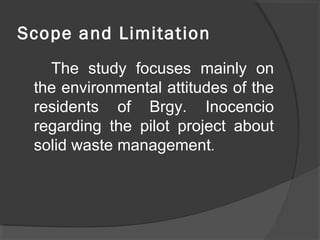

Scope and Limitation
The study focuses mainly on
the environmental attitudes of the
residents of Brgy. Inocencio
regarding the pilot project about
solid waste management.

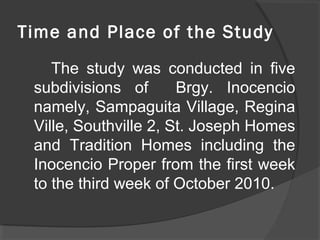

Time and Place of the Study
The study was conducted in five
subdivisions of Brgy. Inocencio
namely, Sampaguita Village, Regina
Ville, Southville 2, St. Joseph Homes
and Tradition Homes including the
Inocencio Proper from the first week
to the third week of October 2010.
Methodology
The materials used in the
conduct of the study were the
following:
 Barangay profile documents
 Digital camera for documentation
 Survey questionnaires
Methods
 Collections of data regarding
the project by interviewing the
designated person.
 Preparation for the survey

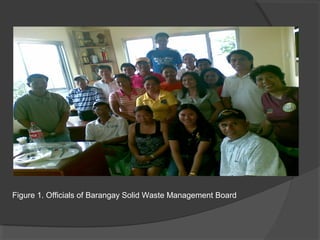

A questionnaire was designed
to primary gather the residents’
response towards the solid waste
program.

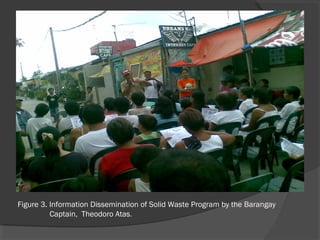

An interview was conducted to
determine the following:

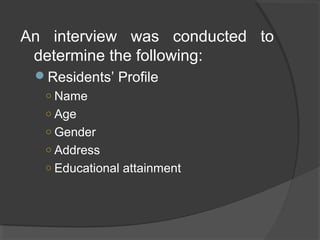

Residents’ Profile
○ Name
○ Age
○ Gender
○ Address
○ Educational attainment

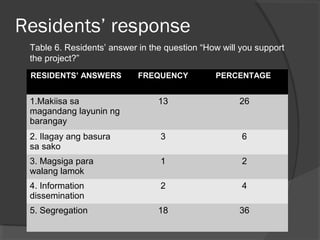

 Residents’ response by
answering the following question:
Do you know the project of your
barangay about solid waste?
Are you willing to support it?
What will you do to support the project?
 Integration of the gathered data.
The questionnaires were then
analyzed.
Before coming up with an
ordinance in relation to RA 9003,
the following activities were made
and conducted.
Program launching of Clean
and Green Project in Brgy.
Inocencio
Where: Bagong Pook Elem.
School
When: May 8, 2008
Sponsor
○ Mrs. Nenita Casaba
 Speakers:
Kapitan Teodoro “During”
Atas
Mayor Jun Sagun

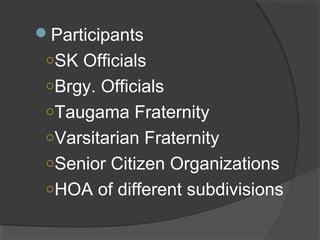

Participants
○SK Officials
○Brgy. Officials
○Taugama Fraternity
○Varsitarian Fraternity
○Senior Citizen Organizations
○HOA of different subdivisions

Activity: Tree planting
○Where: Southville 2, Phase I
○Participants: more or less 80
persons
○What: 200 mahogany

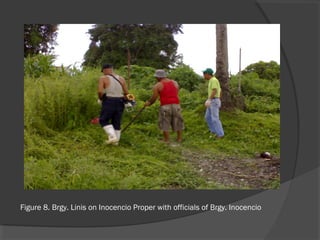

Followed up by Brgy. Linis on
Subdivisions
May 11- Oct. 23, 2008
Who: Barangay Officials
When: Every Sunday
Where: all Subdivisions
Seminar on Solid Waste with
Prof. Noel A. Sedigo
When: June 21, 2008

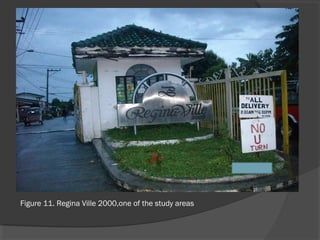

Where: Regina Ville 2000
Participants: HOA officials,
Regina Ville 2000 residents
Special Guest: Councilor Alex
Lubigan (City Councilor)
School visitations for Information
Dissemination
○Bagong Pook Elementary
School
○Southville Elementary School
 After school visitation, the barangay
decided to visit subdivisions by blocks.
 The first subdivision visited was
Southville.
 They already visited five blocks.
 Other subdivisions will be visited after
the barangay election last October 25,
2010.
Search for Ambassador of
Good Will to Cleanliness
Initiator: Mrs. Nenita Casaba
Where: Regina Ville 2000,
Brgy. Inocencio
When: Nov. 22, 2008
Guest: Prof. Noel A. Sedigo
 Board of Judges:
Ms. Jazel Lomboy (SK Councilor)
Mr. Richard Dein Altarez (Senior
Student, CVSU, EnSci)
Ms. Diana Bawag (Senior Student,
CVSU, EnSci)

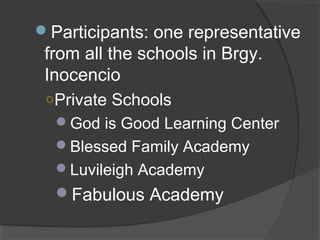

Participants: one representative
from all the schools in Brgy.
Inocencio
○Private Schools
God is Good Learning Center
Blessed Family Academy
Luvileigh Academy
Fabulous Academy
John Merced Academy

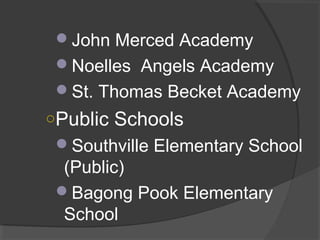

Noelles Angels Academy
St. Thomas Becket Academy
○Public Schools
Southville Elementary School
(Public)
Bagong Pook Elementary
School
Winners
○First Place: Paricipants from
Luveleigh Academy
○2nd
Place: Participants from
Blessed Family Academy
○3rd
Place: Participants from
Southville Elemenary School
Search for the Cleanest and
Greenest subdivision of Brgy.
Inocencio
It was a fund raising program
It was held on Sept. 3, 2009.
Initiated by barangay officials
Judges were the following:
○Mr. Robert Fairman (Head,
Provincial Tourism Office)
○Mr. Ronaldo Molina (Vice
President, HOA (ReginaVille
2000)

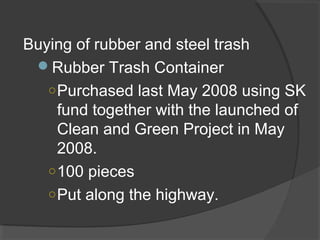

Buying of rubber and steel trash
Rubber Trash Container
○Purchased last May 2008 using SK
fund together with the launched of
Clean and Green Project in May
2008.
○100 pieces
○Put along the highway.

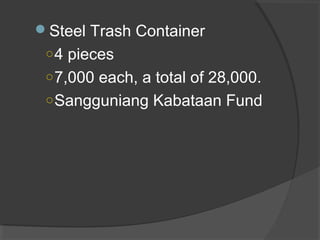

Steel Trash Container
○4 pieces
○7,000 each, a total of 28,000.
○Sangguniang Kabataan Fund

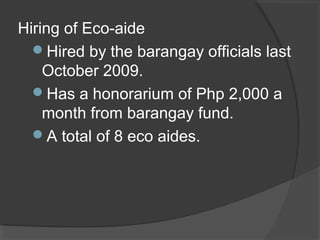

Hiring of Eco-aide
Hired by the barangay officials last
October 2009.
Has a honorarium of Php 2,000 a
month from barangay fund.
A total of 8 eco aides.
○Mr. Rico S. Ilagan
○Mr. Marlon Roguel
○Mr. Pedro Ablan
○Mr. Herman Alano
○Mr. Mark Joseph Crudo
○Mr. Victor Garcia
○Mr. Wilfredo Escalante
○Mr. Ronnie Escubido
Seminar of Barangay officials about Solid
Waste
Title: Lakbay Aral cum Seminar
When: March 11-25 2010
Where: City Hall (Session Hall) of
Cavite, Laguna, Marikina, Carmona,
Teresa Rizal
Initiator: Mayor Jun Sagun
Participants: All the officials of different
barangays of Trece Martires City.

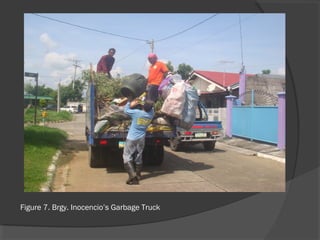

Purchase of Garbage truck
When: June 1, 2010
Amount: Php 520,000
Quantity: 1
Before, city garbage truck collect
the garbage in the whole Trece.
Now, Inocencio has its own
garbage truck.
 June 25, 2010- Another seminar was
conducted
What: Solid Waste Management
Seminar
Venue: Session Hall of City Hall, Trece
Martires City, Cavite
Time: 8:00 am to 5:00 pm
Speakers:
○ Prof. Noel A. Sedigo
○ Mr. Richard Dein Altarez (Environment
Management Specialist, Carmona,
Cavite)

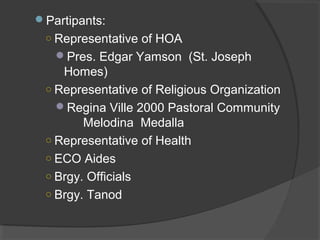

Partipants:
○ Representative of HOA
Pres. Edgar Yamson (St. Joseph
Homes)
○ Representative of Religious Organization
Regina Ville 2000 Pastoral Community
Melodina Medalla
○ Representative of Health
○ ECO Aides
○ Brgy. Officials
○ Brgy. Tanod
Creation of Barangay Solid Waste
Management Board (BSWMB)
When: Aug. 18, 2010
Creation of Task Force Kalikasan
Also known as Bantay Kalikasan
It was created last August 23, 2010.
They are partners of the BSWMB to
implement and disseminate information
about the Solid Waste Program.
They have designated area to teach
people how to segregate wastes
properly.
They have a honorarium of Php
100 per day.
Members of Task Force Kalikasan
are the following:
○ Mrs. Evelyn Pamimdim
○ Mrs. Josephine Carillo
○ Mrs. Mary Grace Puzon
○ Mrs. Mila Segundo
○ Mrs. Divina Dela Rosa

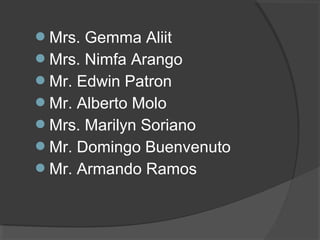

Mrs. Gemma Aliit
Mrs. Nimfa Arango
Mr. Edwin Patron
Mr. Alberto Molo
Mrs. Marilyn Soriano
Mr. Domingo Buenvenuto
Mr. Armando Ramos
 Passing of Ordinance of Brgy.
Inocencio in regarding RA 9003
ORDINANCE NO. 3
AN ORDINANCE ENACTING THE SOLID
WASTE MANAGEMENT PROGRAM
OF BARANGAY INOCENCIO
 Non-government Organizations
Home Owners Association
(HOA)
○Southville 2 Phase1
Pres. Sherwin Nataya
○Regina Ville 2000 Phase 1
Pres. Beth Gaton
○Regina Ville 2000 Phase 2
Pres. Editha Dipano
○Sampaguita Asiatic
Pres. Melody Perez
○Sampaguita Ayala
Pres. Ma. Gelia
Blancaflor
○St. Joseph Homes
Pres. Edgar Yamson
○Tradition Phase 1
Pres. Edgardo Clada
○Tradition Phase 2
Pres. Ernesto Claro
Senior Citizen Organization
President: Cornillo Garcia
(Inocencio Proper)
Religious sectors
○Sampaguita Pastoral
Community
Mrs. Felisa Ramos
○Regina Ville 2000 Pastoral
Community
Mrs. Melodina Medalla

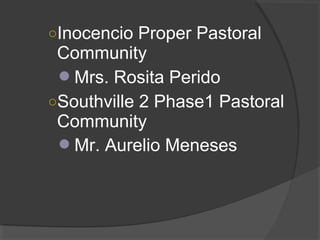

○Inocencio Proper Pastoral
Community
Mrs. Rosita Perido
○Southville 2 Phase1 Pastoral
Community
Mr. Aurelio Meneses

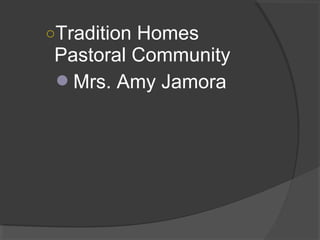

○Tradition Homes
Pastoral Community
Mrs. Amy Jamora
Parents-Teachers Association
○Mr. Noli Perez (Southville
Elementary School)
BUSINESS SECTOR
○King Leo’s Construction
Supply
Mr. Marlon Miran

 LOCAL GOVERNMENT
Proponent
○Chairman
Barangay Captain Teodoro
Atas
○ Vice Chairman
Councilor Nenita Casaba
○SK Chairman
Khalid Abdalla
○Pres. of HOA
Edgar Yamson (St. Joseph)
○Public School
Ana Marie Aranzanso
(Principal, Southville Elem.
School)
○Private School
Noel Panganiban
(Principal, Noelles Angels
Academy)

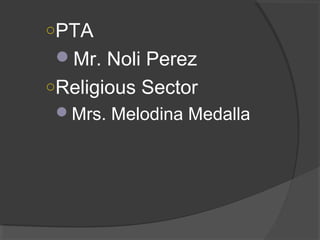

○PTA
Mr. Noli Perez
○Religious Sector
Mrs. Melodina Medalla
Time Frame
The pilot project on Solid
Waste Program in Brgy.
Inocencio will take effect for ten
years after the issuance of the
ordinance. It was started last
October 3, 2010 through
information dissemination about
the program.

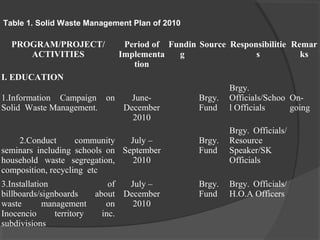

SOLID WASTE
MANAGEMENT PLAN
2010
PROGRAM/PROJECT/
ACTIVITIES
Period of
Implementa
tion
Fundin
g
Source Responsibilitie
s
Remar
ks
I. EDUCATION
1.Information Campaign on
Solid Waste Management.
June-
December
2010
Brgy.
Fund
Brgy.
Officials/Schoo
l Officials
On-
going
2.Conduct community
seminars including schools on
household waste segregation,
composition, recycling etc
July –
September
2010
Brgy.
Fund
Brgy. Officials/
Resource
Speaker/SK
Officials
3.Installation of
billboards/signboards about
waste management on
Inocencio territory inc.
subdivisions
July –
December
2010
Brgy.
Fund
Brgy. Officials/
H.O.A Officers
Table 1. Solid Waste Management Plan of 2010
II.ENGINEERING
1.
Acquisition/Maint.of
Garbage Collection
Service Vehicle
May-
June
2010
Brgy.
Fund
Brgy.
Officials
2. Provision of trash
receptacles(segregati
on of waste) at
designated areas
3rd
Qtr-
4th
Qtr
of 2010
Brgy.
Fund
Brgy.
Officials
3.Distribution of
trash can
IV.ENTREPRENEUR
IAL
1. Establishment of
system of buying and
selling of recyclable
waste.
3rd
Quart
er of
2010
Brgy.
Officia
ls/ SK
Officia
l
2. Promotion of
livelihood activities
from waste materials.
3rd
Quart
er of
2010
Brgy.
Officia
ls
III. ENFORCEMENT
1. Conduct Operation
Linis
January-
December
2010
Brgy.Offi
cials,SK
Officials,
HOA
Officials
On-
going

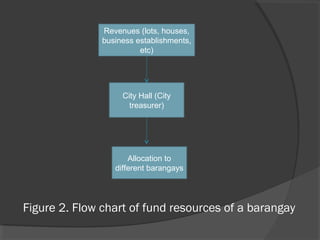

Figure 2. Flow chart of fund resources of a barangay
Revenues (lots, houses,
business establishments,
etc)
City Hall (City
treasurer)
Allocation to
different barangays
Financial Aspect
The pilot project of Brgy. Inocencio needs
financial support in order to materialize. A budget
of P 800,000 is allotted for the project for ten
years. The budget will come from the barangay
fund through IRA (Internal Revenue Allocation).
This money is subdivided into the following
expenses:
1 Garbage Truck Php 520, 000
Seminars and Trainings Php15, 000
Kit Php 1, 500
Information Dissemination Php 3,000
Meals every meeting
(for 7 meetings) Php 7,000
Gasoline Php 19,500
Others Php 234,000
Total Php 800,000
 The remaining fund will be
allotted to:
Additional trash fund
Information allocation campaign (e.g.
leafleting)
Unexpected expenses
 The budget allotted was not
enough to support the project for
ten years.
Objective of the Project
“Zero Plastic Waste”
Activities
1. It was started when barangay hall sell NFA
rice. Whoever buy rice needs to carry their
own container (plastic is not allowed) like
rice sack.
2. Information dissemination of do’s and
don'ts of using plastics.
General Response
  In five subdivisions in Brgy.
Inocencio, namely, Regina Ville,
Tradition Homes, Sampaguita (Asiatic
and Ayala), St. Joseph Homes and
Southville 2, ten randomly selected
residents in each subdivisions were
interviewed to determine their
environmental attitudes about the
project on solid waste management.
The attitudes of the residents
were also determined through
their age structure, gender and
educational attainment.
Residents’ Attitude
RESIDENTS'
ATTITUDE
NO. OF
RESPONDENTS
PERCENTAGE
Informed
Not informed
43
7
86
14
Table 2. The response of the residents in Brgy. Inocencio
about the project
Table 2. Response of the residents about the project
in terms of willingness
RESIDENTS’
ATTITUDES
NO. OF
RESPONDENTS
PERCENTAGE
Will support 47 94
Will not support 3 6
Age Structure
Table 3. Attitudes of the residents based on age
structure
AGE
CATEG
ORY
AGE
BRACK
ET
NO. OF
RESPO
NDENTS
PERCEN
TAGE
FREQUE
NCY
WILL
SUPP
ORT
(%)
FREQ
UENC
Y
WILL
NOT
SUPPO
RT (%)
Teenag
er
13 - 20 6 12 6 100 0 0
Young
Adult
21 - 30 16 32 16 100 0 0
Adult 31 - 59 21 42 19 90 2 10
Senior
Citizen
60
above
7 14 4 57 3 43
Gender
GENDE
R
NO. OF
RESPO
NDENT
S
PERCEN
TAGE
FREQUE
NCY
WILL
SUPPO
RT (%)
FREQU
ENCY
WILL
NOT
SUPPO
RT (%)
Male 17 34 14 82 3 18
Female 33 66 31 94 2 6
Table 4. Attitudes of the residents based on gender
Educational Attainment
Table 5. Attitudes of the residents based on
educational attainment
EDUC.
ATTAINM
ENT
NO. OF
RESP
ONDE
NTS
PERCE
NTAGE
FREQU
ENCY
WILL
SUPPO
RT (%)
FREQU
ENCY
WILL
NOT
SUPPO
RT (%)
College
degree
15 30 15 100 0 0
College
undergrad
uate
12 24 12 100 0 0
High
School
19 38 16 84 3 16
Elementar
y
1 2 1 100 0 0
No formal
education 3 6 2 67 1 33
Residents’ response
RESIDENTS’ ANSWERS FREQUENCY PERCENTAGE
1.Makiisa sa
magandang layunin ng
barangay
13 26
2. Ilagay ang basura
sa sako
3 6
3. Magsiga para
walang lamok
1 2
4. Information
dissemination
2 4
5. Segregation 18 36
Table 6. Residents’ answer in the question “How will you support
the project?”
6. Sa
magandang
paraan
1 2
7. Paglilinis ng
paligid
3 6
8. Hindi
magkalat
5 10
9. No answer 4 8
TOTAL 50 100
Though they were informed and
willing to support the project, they still
do not know the practical and
appropriate actions they can do.
Seems like not everyone truly
understands the project and just
answered they were informed and they
are willing to support.
Conclusion
 According to the survey result, almost all
people in Brgy. Inocencio were aware of
the project. A few number of individuals
were not informed.
 Majority of the respondents were willing
to support the project.
 However, majority were not able to answer
appropriately the question, “How will you
support the project?” It only means that the
respondents were not knowledgeable
enough.
 Overall, their attitude towards the
environment was good. Though they do not
know what will they do based on the third
question, they are still willing to support the
program.
Recommendation
 The data gathered must be subjected to
statistical analysis to obtain a more precise
results.
 Also, the barangay needs to have Gantt
chart in every year to monitor if the plan of
activities are properly followed and if any
revisions must be done.
 It must also show the yearly allotted money
for the project in order to know if there are
needs to have government subsidies.
 The barangay officials and the BSWMB
should continue to disseminate
information about the pilot project and
make sure that all the residents will truly
understand it.
 They also have to make sure that the
residents will comply with this pilot
project by strictly following the
ordinance.
Figure 1. Officials of Barangay Solid Waste Management Board
Figure 2. Information Dissemination of Solid Waste Project in Southville2 Phase 1
Figure 3. Information Dissemination of Solid Waste Program by the Barangay
Captain, Theodoro Atas.

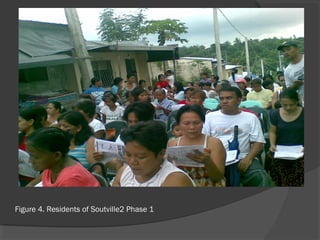

Figure 4. Residents of Soutville2 Phase 1
Figure 5. Barangay Secretary, Ms. Jennifer Calbaquinto, addressing the roles of the
residents regarding the program.

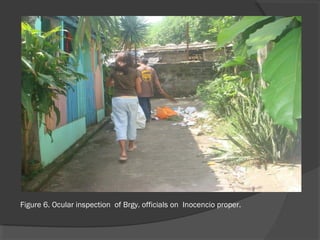

Figure 6. Ocular inspection of Brgy. officials on Inocencio proper.
Figure 7. Brgy. Inocencio’s Garbage Truck
Figure 8. Brgy. Linis on Inocencio Proper with officials of Brgy. Inocencio
Figure 9. Tree Planting of the officials of Brgy. Inocencio
Figure 10. Planting of mahogany of the barangay officials of Barangay
Inocencio along the highway
Different Subdivisions of
Barangay Inocencio
(Study Areas)
Figure 11. Regina Ville 2000,one of the study areas
Figure 12. Sampaguita Village, one of the study areas

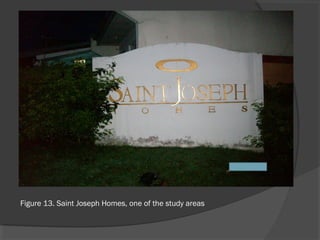

Figure 13. Saint Joseph Homes, one of the study areas
Figure 14. Tradition Homes, one of the study areas
Figure 15. Southville 2 Phase 1, one of the study areas
Respondents from
Different Subdivisions
Figure 16. One of the respondents from Sampaguita Village
Figure 17. One of the respondents from Saint Joseph Homes
Figure 18. One of the respondents from Regina Ville 2000

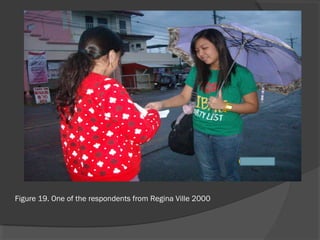

Figure 19. One of the respondents from Regina Ville 2000

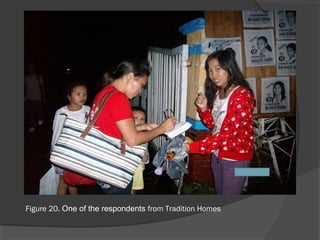

Figure 20. One of the respondents from Tradition Homes
Figure 21. One of the respondents from Inocencio Proper
Figure 22. One of the respondents from Southville 2 Phase 1
DATA COLLECTION

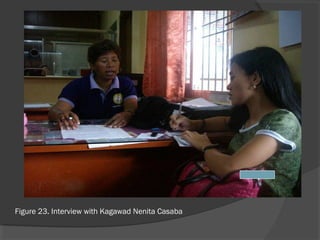

Figure 23. Interview with Kagawad Nenita Casaba

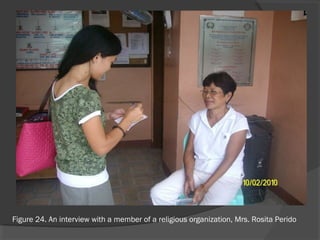

Figure 24. An interview with a member of a religious organization, Mrs. Rosita Perido
Figure 25. Researchers together with the Barangay Inocencio’s secretary, Ms. Jennifer
Calbaquinto
MRF AND STEEL TRASH
MODEL

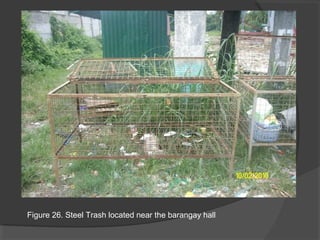

Figure 26. Steel Trash located near the barangay hall
Figure 27. Steel trash container located near the barangay hall
Figure 28. Sample Material Recovery Facility (MRF) near the Barangay hall.
-END-
Prepared by:
 Jonafe P. Aguda
 Czarah Jade V. Bazan
 Christopher E. Casaba
 Ann Pamela D. Constante
 Karla Joyce L. Marges

Case study brgy. inocencio ppt. final report

  • 3.
    Introduction One of themost environmental problems that people are facing now is the proper management of our wastes. Wastes are everywhere and these impose health related problems if not manage in right way.
  • 4.
    Government primarily isconcern with this problem. That is why, they create laws to complement with this matter. Moreover, local officials from Brgy. Inocencio, Trece Martires, Cavite is supporting it by implementing a pilot project on solid waste management in their area. The question is, will the residents of Brgy. Inocencio willing to support the project?
  • 5.
    Map of thePhilippines
  • 6.
  • 7.
  • 8.
    MAP OF BRGY.INOCENCIO
  • 9.
    Barangay Inocencio  oneof the thirteen barangay in Trece Martires City, Cavite.  has been named in honor of Maximo Inocencio.  Total area= 243 hectares
  • 10.
     Adjacent barangays Lucianoon the North Alulod Indang, Cavite on the South Conchu on the East Aguado on the West
  • 11.
     Has atotal population of 28,299. (census by the Barangay Nutrition Scholar, BNS)  Land use- Agri-business  Terrain Characteristics- rolling terrain  Type of soil: 90% clay loam 10% clay
  • 12.
    Objectives The general objectiveof the study is to determine the environmental attitudes of the residents of Brgy. Inocencio regarding the pilot project of their barangay about solid waste.
  • 13.
    Specifically, this studyaims:  to identify the project of Brgy. Inocencio about solid waste;  to identify each process of the project;  to identify the respondents’ attitudes towards the project.
  • 14.
    Importance of theStudy The information generated from this study will determine the attitudes of the residents regarding the project.
  • 15.
    This case studywill help the residents of Brgy Inocencio become more aware with the project of the barangay. Moreover, the people will support for the success of the project if they really aware of the project.
  • 16.
    Scope and Limitation Thestudy focuses mainly on the environmental attitudes of the residents of Brgy. Inocencio regarding the pilot project about solid waste management.
  • 17.
    Time and Placeof the Study The study was conducted in five subdivisions of Brgy. Inocencio namely, Sampaguita Village, Regina Ville, Southville 2, St. Joseph Homes and Tradition Homes including the Inocencio Proper from the first week to the third week of October 2010.
  • 18.
    Methodology The materials usedin the conduct of the study were the following:  Barangay profile documents  Digital camera for documentation  Survey questionnaires
  • 19.
    Methods  Collections ofdata regarding the project by interviewing the designated person.
  • 20.
     Preparation forthe survey A questionnaire was designed to primary gather the residents’ response towards the solid waste program.
  • 21.
    An interview wasconducted to determine the following: Residents’ Profile ○ Name ○ Age ○ Gender ○ Address ○ Educational attainment
  • 22.
     Residents’ responseby answering the following question: Do you know the project of your barangay about solid waste? Are you willing to support it? What will you do to support the project?
  • 23.
     Integration ofthe gathered data. The questionnaires were then analyzed.
  • 24.
    Before coming upwith an ordinance in relation to RA 9003, the following activities were made and conducted.
  • 25.
    Program launching ofClean and Green Project in Brgy. Inocencio Where: Bagong Pook Elem. School When: May 8, 2008 Sponsor ○ Mrs. Nenita Casaba
  • 26.
     Speakers: Kapitan Teodoro“During” Atas Mayor Jun Sagun
  • 27.
    Participants ○SK Officials ○Brgy. Officials ○TaugamaFraternity ○Varsitarian Fraternity ○Senior Citizen Organizations ○HOA of different subdivisions
  • 28.
    Activity: Tree planting ○Where:Southville 2, Phase I ○Participants: more or less 80 persons ○What: 200 mahogany
  • 29.
    Followed up byBrgy. Linis on Subdivisions May 11- Oct. 23, 2008 Who: Barangay Officials When: Every Sunday Where: all Subdivisions
  • 30.
    Seminar on SolidWaste with Prof. Noel A. Sedigo When: June 21, 2008 Where: Regina Ville 2000 Participants: HOA officials, Regina Ville 2000 residents Special Guest: Councilor Alex Lubigan (City Councilor)
  • 31.
    School visitations forInformation Dissemination ○Bagong Pook Elementary School ○Southville Elementary School
  • 32.
     After schoolvisitation, the barangay decided to visit subdivisions by blocks.  The first subdivision visited was Southville.  They already visited five blocks.  Other subdivisions will be visited after the barangay election last October 25, 2010.
  • 33.
    Search for Ambassadorof Good Will to Cleanliness Initiator: Mrs. Nenita Casaba Where: Regina Ville 2000, Brgy. Inocencio When: Nov. 22, 2008 Guest: Prof. Noel A. Sedigo
  • 34.
     Board ofJudges: Ms. Jazel Lomboy (SK Councilor) Mr. Richard Dein Altarez (Senior Student, CVSU, EnSci) Ms. Diana Bawag (Senior Student, CVSU, EnSci)
  • 35.
    Participants: one representative fromall the schools in Brgy. Inocencio ○Private Schools God is Good Learning Center Blessed Family Academy Luvileigh Academy Fabulous Academy
  • 36.
    John Merced Academy NoellesAngels Academy St. Thomas Becket Academy ○Public Schools Southville Elementary School (Public) Bagong Pook Elementary School
  • 37.
    Winners ○First Place: Paricipantsfrom Luveleigh Academy ○2nd Place: Participants from Blessed Family Academy ○3rd Place: Participants from Southville Elemenary School
  • 38.
    Search for theCleanest and Greenest subdivision of Brgy. Inocencio It was a fund raising program It was held on Sept. 3, 2009. Initiated by barangay officials
  • 39.
    Judges were thefollowing: ○Mr. Robert Fairman (Head, Provincial Tourism Office) ○Mr. Ronaldo Molina (Vice President, HOA (ReginaVille 2000)
  • 40.
    Buying of rubberand steel trash Rubber Trash Container ○Purchased last May 2008 using SK fund together with the launched of Clean and Green Project in May 2008. ○100 pieces ○Put along the highway.
  • 41.
    Steel Trash Container ○4pieces ○7,000 each, a total of 28,000. ○Sangguniang Kabataan Fund
  • 42.
    Hiring of Eco-aide Hiredby the barangay officials last October 2009. Has a honorarium of Php 2,000 a month from barangay fund. A total of 8 eco aides.
  • 43.
    ○Mr. Rico S.Ilagan ○Mr. Marlon Roguel ○Mr. Pedro Ablan ○Mr. Herman Alano ○Mr. Mark Joseph Crudo ○Mr. Victor Garcia ○Mr. Wilfredo Escalante ○Mr. Ronnie Escubido
  • 44.
    Seminar of Barangayofficials about Solid Waste Title: Lakbay Aral cum Seminar When: March 11-25 2010 Where: City Hall (Session Hall) of Cavite, Laguna, Marikina, Carmona, Teresa Rizal Initiator: Mayor Jun Sagun Participants: All the officials of different barangays of Trece Martires City.
  • 45.
    Purchase of Garbagetruck When: June 1, 2010 Amount: Php 520,000 Quantity: 1 Before, city garbage truck collect the garbage in the whole Trece. Now, Inocencio has its own garbage truck.
  • 46.
     June 25,2010- Another seminar was conducted What: Solid Waste Management Seminar Venue: Session Hall of City Hall, Trece Martires City, Cavite Time: 8:00 am to 5:00 pm Speakers: ○ Prof. Noel A. Sedigo ○ Mr. Richard Dein Altarez (Environment Management Specialist, Carmona, Cavite)
  • 47.
    Partipants: ○ Representative ofHOA Pres. Edgar Yamson (St. Joseph Homes) ○ Representative of Religious Organization Regina Ville 2000 Pastoral Community Melodina Medalla ○ Representative of Health ○ ECO Aides ○ Brgy. Officials ○ Brgy. Tanod
  • 48.
    Creation of BarangaySolid Waste Management Board (BSWMB) When: Aug. 18, 2010
  • 50.
    Creation of TaskForce Kalikasan Also known as Bantay Kalikasan It was created last August 23, 2010. They are partners of the BSWMB to implement and disseminate information about the Solid Waste Program. They have designated area to teach people how to segregate wastes properly.
  • 51.
    They have ahonorarium of Php 100 per day. Members of Task Force Kalikasan are the following: ○ Mrs. Evelyn Pamimdim ○ Mrs. Josephine Carillo ○ Mrs. Mary Grace Puzon ○ Mrs. Mila Segundo ○ Mrs. Divina Dela Rosa
  • 52.
    Mrs. Gemma Aliit Mrs.Nimfa Arango Mr. Edwin Patron Mr. Alberto Molo Mrs. Marilyn Soriano Mr. Domingo Buenvenuto Mr. Armando Ramos
  • 53.
     Passing ofOrdinance of Brgy. Inocencio in regarding RA 9003
  • 54.
    ORDINANCE NO. 3 ANORDINANCE ENACTING THE SOLID WASTE MANAGEMENT PROGRAM OF BARANGAY INOCENCIO
  • 56.
     Non-government Organizations HomeOwners Association (HOA) ○Southville 2 Phase1 Pres. Sherwin Nataya ○Regina Ville 2000 Phase 1 Pres. Beth Gaton
  • 57.
    ○Regina Ville 2000Phase 2 Pres. Editha Dipano ○Sampaguita Asiatic Pres. Melody Perez ○Sampaguita Ayala Pres. Ma. Gelia Blancaflor
  • 58.
    ○St. Joseph Homes Pres.Edgar Yamson ○Tradition Phase 1 Pres. Edgardo Clada ○Tradition Phase 2 Pres. Ernesto Claro
  • 59.
    Senior Citizen Organization President:Cornillo Garcia (Inocencio Proper)
  • 60.
    Religious sectors ○Sampaguita Pastoral Community Mrs.Felisa Ramos ○Regina Ville 2000 Pastoral Community Mrs. Melodina Medalla
  • 61.
    ○Inocencio Proper Pastoral Community Mrs.Rosita Perido ○Southville 2 Phase1 Pastoral Community Mr. Aurelio Meneses
  • 62.
  • 63.
    Parents-Teachers Association ○Mr. NoliPerez (Southville Elementary School) BUSINESS SECTOR ○King Leo’s Construction Supply Mr. Marlon Miran
  • 64.
     LOCAL GOVERNMENT Proponent ○Chairman BarangayCaptain Teodoro Atas ○ Vice Chairman Councilor Nenita Casaba
  • 65.
    ○SK Chairman Khalid Abdalla ○Pres.of HOA Edgar Yamson (St. Joseph) ○Public School Ana Marie Aranzanso (Principal, Southville Elem. School)
  • 66.
  • 67.
    ○PTA Mr. Noli Perez ○ReligiousSector Mrs. Melodina Medalla
  • 68.
    Time Frame The pilotproject on Solid Waste Program in Brgy. Inocencio will take effect for ten years after the issuance of the ordinance. It was started last October 3, 2010 through information dissemination about the program.
  • 69.
  • 70.
    PROGRAM/PROJECT/ ACTIVITIES Period of Implementa tion Fundin g Source Responsibilitie s Remar ks I.EDUCATION 1.Information Campaign on Solid Waste Management. June- December 2010 Brgy. Fund Brgy. Officials/Schoo l Officials On- going 2.Conduct community seminars including schools on household waste segregation, composition, recycling etc July – September 2010 Brgy. Fund Brgy. Officials/ Resource Speaker/SK Officials 3.Installation of billboards/signboards about waste management on Inocencio territory inc. subdivisions July – December 2010 Brgy. Fund Brgy. Officials/ H.O.A Officers Table 1. Solid Waste Management Plan of 2010
  • 71.
    II.ENGINEERING 1. Acquisition/Maint.of Garbage Collection Service Vehicle May- June 2010 Brgy. Fund Brgy. Officials 2.Provision of trash receptacles(segregati on of waste) at designated areas 3rd Qtr- 4th Qtr of 2010 Brgy. Fund Brgy. Officials 3.Distribution of trash can
  • 72.
    IV.ENTREPRENEUR IAL 1. Establishment of systemof buying and selling of recyclable waste. 3rd Quart er of 2010 Brgy. Officia ls/ SK Officia l 2. Promotion of livelihood activities from waste materials. 3rd Quart er of 2010 Brgy. Officia ls
  • 73.
    III. ENFORCEMENT 1. ConductOperation Linis January- December 2010 Brgy.Offi cials,SK Officials, HOA Officials On- going
  • 74.
    Figure 2. Flowchart of fund resources of a barangay Revenues (lots, houses, business establishments, etc) City Hall (City treasurer) Allocation to different barangays
  • 75.
    Financial Aspect The pilotproject of Brgy. Inocencio needs financial support in order to materialize. A budget of P 800,000 is allotted for the project for ten years. The budget will come from the barangay fund through IRA (Internal Revenue Allocation). This money is subdivided into the following expenses: 1 Garbage Truck Php 520, 000 Seminars and Trainings Php15, 000 Kit Php 1, 500 Information Dissemination Php 3,000
  • 76.
    Meals every meeting (for7 meetings) Php 7,000 Gasoline Php 19,500 Others Php 234,000 Total Php 800,000
  • 77.
     The remainingfund will be allotted to: Additional trash fund Information allocation campaign (e.g. leafleting) Unexpected expenses
  • 78.
     The budgetallotted was not enough to support the project for ten years.
  • 79.
    Objective of theProject “Zero Plastic Waste”
  • 80.
    Activities 1. It wasstarted when barangay hall sell NFA rice. Whoever buy rice needs to carry their own container (plastic is not allowed) like rice sack. 2. Information dissemination of do’s and don'ts of using plastics.
  • 81.
    General Response   Infive subdivisions in Brgy. Inocencio, namely, Regina Ville, Tradition Homes, Sampaguita (Asiatic and Ayala), St. Joseph Homes and Southville 2, ten randomly selected residents in each subdivisions were interviewed to determine their environmental attitudes about the project on solid waste management.
  • 82.
    The attitudes ofthe residents were also determined through their age structure, gender and educational attainment.
  • 83.
    Residents’ Attitude RESIDENTS' ATTITUDE NO. OF RESPONDENTS PERCENTAGE Informed Notinformed 43 7 86 14 Table 2. The response of the residents in Brgy. Inocencio about the project
  • 84.
    Table 2. Responseof the residents about the project in terms of willingness RESIDENTS’ ATTITUDES NO. OF RESPONDENTS PERCENTAGE Will support 47 94 Will not support 3 6
  • 85.
    Age Structure Table 3.Attitudes of the residents based on age structure AGE CATEG ORY AGE BRACK ET NO. OF RESPO NDENTS PERCEN TAGE FREQUE NCY WILL SUPP ORT (%) FREQ UENC Y WILL NOT SUPPO RT (%) Teenag er 13 - 20 6 12 6 100 0 0 Young Adult 21 - 30 16 32 16 100 0 0 Adult 31 - 59 21 42 19 90 2 10 Senior Citizen 60 above 7 14 4 57 3 43
  • 86.
    Gender GENDE R NO. OF RESPO NDENT S PERCEN TAGE FREQUE NCY WILL SUPPO RT (%) FREQU ENCY WILL NOT SUPPO RT(%) Male 17 34 14 82 3 18 Female 33 66 31 94 2 6 Table 4. Attitudes of the residents based on gender
  • 87.
    Educational Attainment Table 5.Attitudes of the residents based on educational attainment EDUC. ATTAINM ENT NO. OF RESP ONDE NTS PERCE NTAGE FREQU ENCY WILL SUPPO RT (%) FREQU ENCY WILL NOT SUPPO RT (%) College degree 15 30 15 100 0 0 College undergrad uate 12 24 12 100 0 0 High School 19 38 16 84 3 16 Elementar y 1 2 1 100 0 0 No formal education 3 6 2 67 1 33
  • 88.
    Residents’ response RESIDENTS’ ANSWERSFREQUENCY PERCENTAGE 1.Makiisa sa magandang layunin ng barangay 13 26 2. Ilagay ang basura sa sako 3 6 3. Magsiga para walang lamok 1 2 4. Information dissemination 2 4 5. Segregation 18 36 Table 6. Residents’ answer in the question “How will you support the project?”
  • 89.
    6. Sa magandang paraan 1 2 7.Paglilinis ng paligid 3 6 8. Hindi magkalat 5 10 9. No answer 4 8 TOTAL 50 100
  • 90.
    Though they wereinformed and willing to support the project, they still do not know the practical and appropriate actions they can do. Seems like not everyone truly understands the project and just answered they were informed and they are willing to support.
  • 91.
    Conclusion  According tothe survey result, almost all people in Brgy. Inocencio were aware of the project. A few number of individuals were not informed.  Majority of the respondents were willing to support the project.
  • 92.
     However, majoritywere not able to answer appropriately the question, “How will you support the project?” It only means that the respondents were not knowledgeable enough.  Overall, their attitude towards the environment was good. Though they do not know what will they do based on the third question, they are still willing to support the program.
  • 93.
    Recommendation  The datagathered must be subjected to statistical analysis to obtain a more precise results.  Also, the barangay needs to have Gantt chart in every year to monitor if the plan of activities are properly followed and if any revisions must be done.  It must also show the yearly allotted money for the project in order to know if there are needs to have government subsidies.
  • 94.
     The barangayofficials and the BSWMB should continue to disseminate information about the pilot project and make sure that all the residents will truly understand it.  They also have to make sure that the residents will comply with this pilot project by strictly following the ordinance.
  • 95.
    Figure 1. Officialsof Barangay Solid Waste Management Board
  • 96.
    Figure 2. InformationDissemination of Solid Waste Project in Southville2 Phase 1
  • 97.
    Figure 3. InformationDissemination of Solid Waste Program by the Barangay Captain, Theodoro Atas.
  • 98.
    Figure 4. Residentsof Soutville2 Phase 1
  • 99.
    Figure 5. BarangaySecretary, Ms. Jennifer Calbaquinto, addressing the roles of the residents regarding the program.
  • 100.
    Figure 6. Ocularinspection of Brgy. officials on Inocencio proper.
  • 101.
    Figure 7. Brgy.Inocencio’s Garbage Truck
  • 102.
    Figure 8. Brgy.Linis on Inocencio Proper with officials of Brgy. Inocencio
  • 103.
    Figure 9. TreePlanting of the officials of Brgy. Inocencio
  • 104.
    Figure 10. Plantingof mahogany of the barangay officials of Barangay Inocencio along the highway
  • 105.
    Different Subdivisions of BarangayInocencio (Study Areas)
  • 106.
    Figure 11. ReginaVille 2000,one of the study areas
  • 107.
    Figure 12. SampaguitaVillage, one of the study areas
  • 108.
    Figure 13. SaintJoseph Homes, one of the study areas
  • 109.
    Figure 14. TraditionHomes, one of the study areas
  • 110.
    Figure 15. Southville2 Phase 1, one of the study areas
  • 111.
  • 112.
    Figure 16. Oneof the respondents from Sampaguita Village
  • 113.
    Figure 17. Oneof the respondents from Saint Joseph Homes
  • 114.
    Figure 18. Oneof the respondents from Regina Ville 2000
  • 115.
    Figure 19. Oneof the respondents from Regina Ville 2000
  • 116.
    Figure 20. Oneof the respondents from Tradition Homes
  • 117.
    Figure 21. Oneof the respondents from Inocencio Proper
  • 118.
    Figure 22. Oneof the respondents from Southville 2 Phase 1
  • 119.
  • 120.
    Figure 23. Interviewwith Kagawad Nenita Casaba
  • 121.
    Figure 24. Aninterview with a member of a religious organization, Mrs. Rosita Perido
  • 122.
    Figure 25. Researcherstogether with the Barangay Inocencio’s secretary, Ms. Jennifer Calbaquinto
  • 123.
    MRF AND STEELTRASH MODEL
  • 124.
    Figure 26. SteelTrash located near the barangay hall
  • 125.
    Figure 27. Steeltrash container located near the barangay hall
  • 126.
    Figure 28. SampleMaterial Recovery Facility (MRF) near the Barangay hall.
  • 127.
  • 128.
    Prepared by:  JonafeP. Aguda  Czarah Jade V. Bazan  Christopher E. Casaba  Ann Pamela D. Constante  Karla Joyce L. Marges
