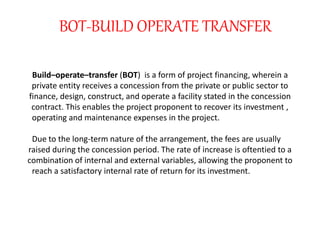

Build–operate–transfer (BOT) is a form of project financing, wherein a
private entity receives a concession from the private or public sector to
finance, design, construct, and operate a facility stated in the concession
contract. This enables the project proponent to recover its investment ,
operating and maintenance expenses in the project.
Due to the long-term nature of the arrangement, the fees are usually
raised during the concession period. The rate of increase is oftentied to a
combination of internal and external variables, allowing the proponent to
reach a satisfactory internal rate of return for its investment.
BOT-BUILD OPERATE TRANSFER
BOT Benefits
• BOT offers attractive business benefits over the traditional offshore
subsidiary path, including:
• Rapid scaling of operations
• Wider service offerings, quickly filling business model gaps
• Lower infrastructure set-up costs
• Reduced time to operations through utilization of knowledgeable
3rd
• party management resources responsible for:
• Real Estate
• Government rules and regulations
• Cultural transition
• IT infrastructure procurement
• Security

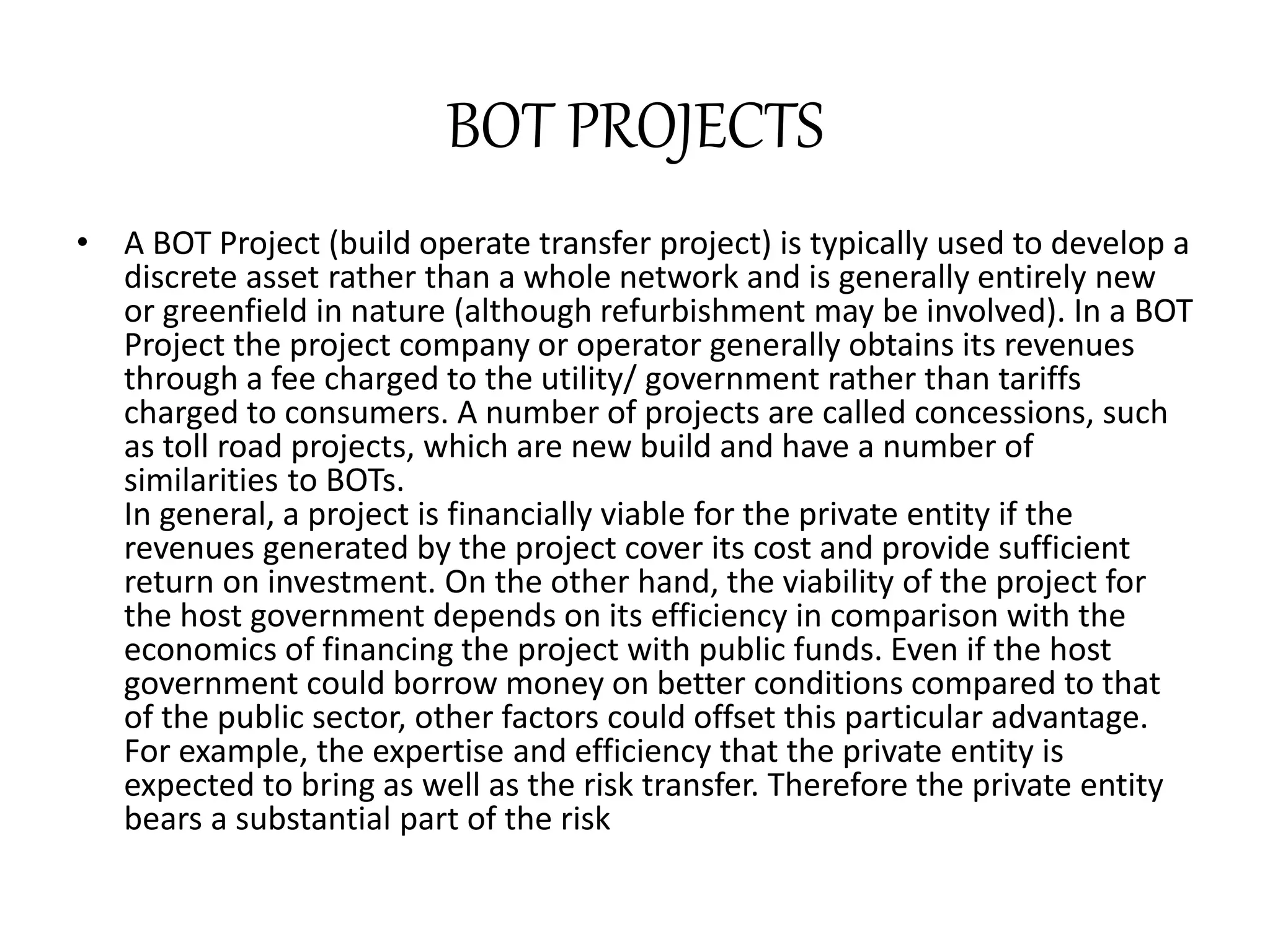

BOT PROJECTS
• A BOT Project (build operate transfer project) is typically used to develop a
discrete asset rather than a whole network and is generally entirely new
or greenfield in nature (although refurbishment may be involved). In a BOT
Project the project company or operator generally obtains its revenues
through a fee charged to the utility/ government rather than tariffs
charged to consumers. A number of projects are called concessions, such
as toll road projects, which are new build and have a number of
similarities to BOTs.
In general, a project is financially viable for the private entity if the
revenues generated by the project cover its cost and provide sufficient
return on investment. On the other hand, the viability of the project for
the host government depends on its efficiency in comparison with the
economics of financing the project with public funds. Even if the host
government could borrow money on better conditions compared to that
of the public sector, other factors could offset this particular advantage.
For example, the expertise and efficiency that the private entity is
expected to bring as well as the risk transfer. Therefore the private entity
bears a substantial part of the risk
VARIOUS RISKS
• POLITICAL RISK
especially in the developing countries because of the possibility of dramatic
overnight political change.
• TECHNICAL RISK
construction difficulties, for example unforeseen soil conditions, breakdown
of equipment.
• Financing risk
foreign exchange rate risk and interest rate fluctuation, market risk (change in
the price of raw materials), income risk (over-optimistic cash-flow
forecasts), cost overrun risk
Case Study 1:
Delhi Gurgaon
Expressway

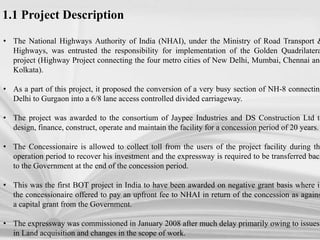

• The National Highways Authority of India (NHAI), under the Ministry of Road Transport &
Highways, was entrusted the responsibility for implementation of the Golden Quadrilatera
project (Highway Project connecting the four metro cities of New Delhi, Mumbai, Chennai and
Kolkata).
• As a part of this project, it proposed the conversion of a very busy section of NH-8 connecting
Delhi to Gurgaon into a 6/8 lane access controlled divided carriageway.
• The project was awarded to the consortium of Jaypee Industries and DS Construction Ltd to
design, finance, construct, operate and maintain the facility for a concession period of 20 years.
• The Concessionaire is allowed to collect toll from the users of the project facility during the
operation period to recover his investment and the expressway is required to be transferred back
to the Government at the end of the concession period.
• This was the first BOT project in India to have been awarded on negative grant basis where in
the concessionaire offered to pay an upfront fee to NHAI in return of the concession as agains
a capital grant from the Government.
• The expressway was commissioned in January 2008 after much delay primarily owing to issues
in Land acquisition and changes in the scope of work.

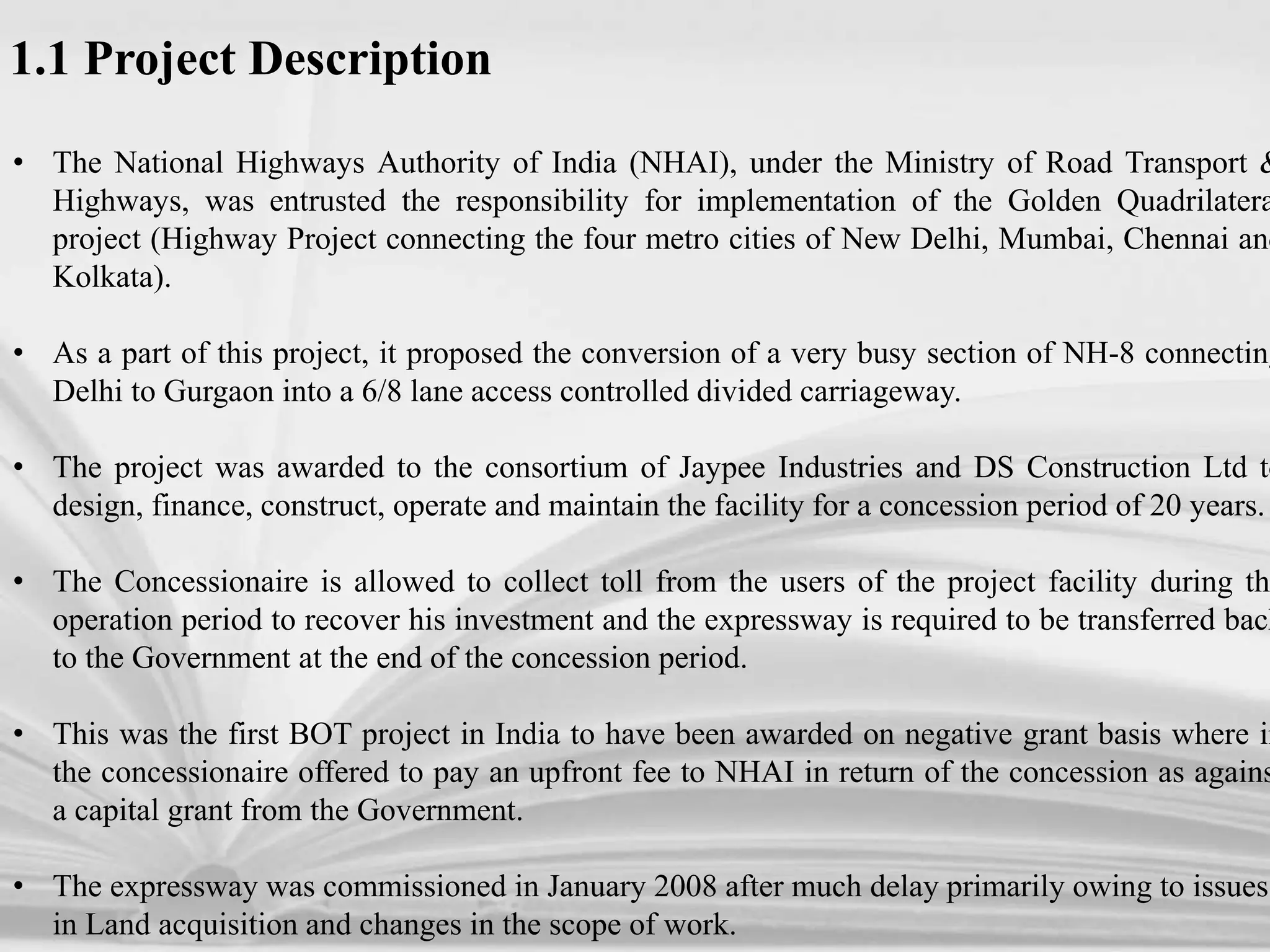

1.1 Project Description

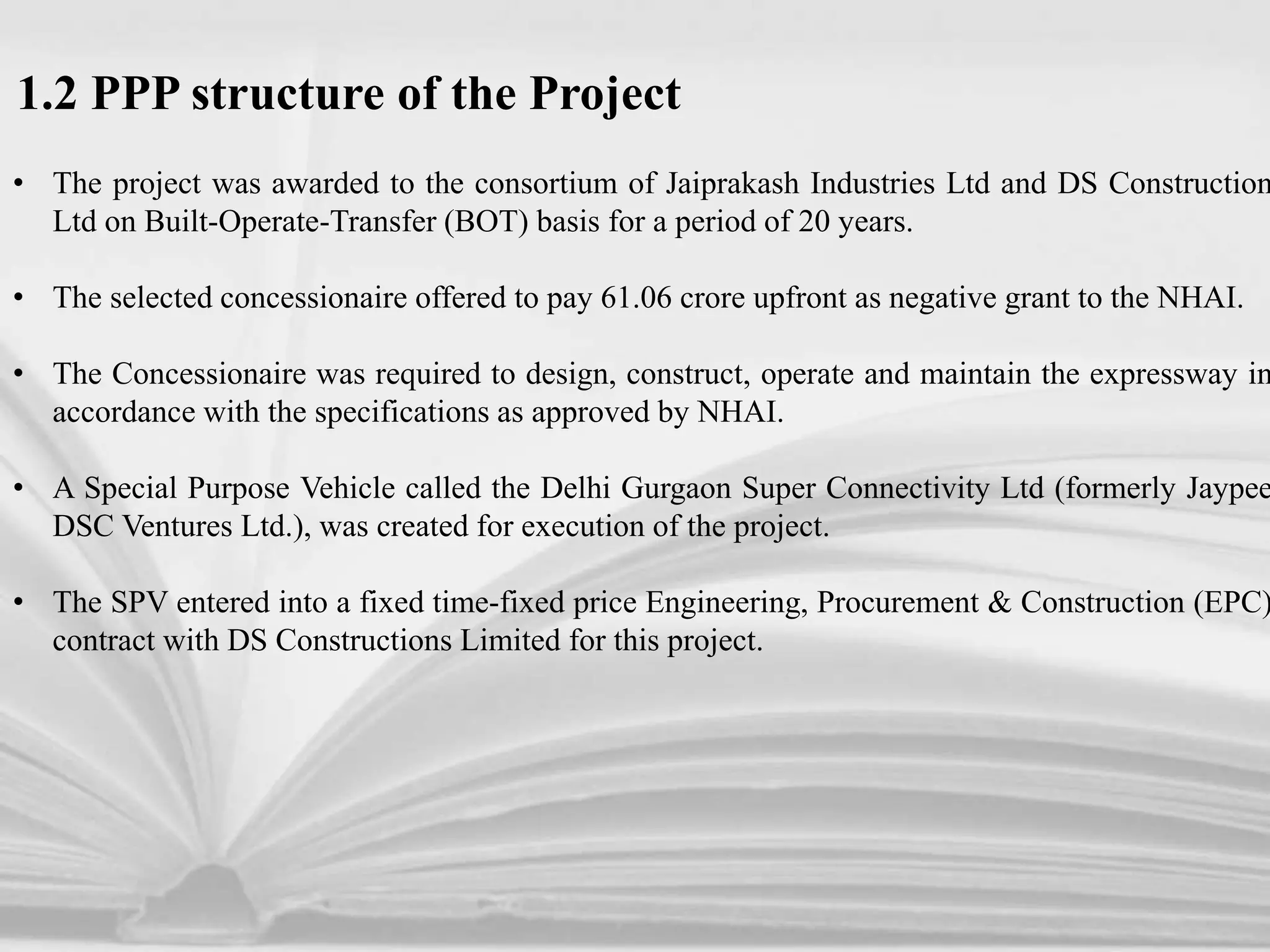

1.2 PPP structure of the Project
• The project was awarded to the consortium of Jaiprakash Industries Ltd and DS Construction
Ltd on Built-Operate-Transfer (BOT) basis for a period of 20 years.
• The selected concessionaire offered to pay 61.06 crore upfront as negative grant to the NHAI.
• The Concessionaire was required to design, construct, operate and maintain the expressway in
accordance with the specifications as approved by NHAI.
• A Special Purpose Vehicle called the Delhi Gurgaon Super Connectivity Ltd (formerly Jaypee
DSC Ventures Ltd.), was created for execution of the project.
• The SPV entered into a fixed time-fixed price Engineering, Procurement & Construction (EPC)
contract with DS Constructions Limited for this project.

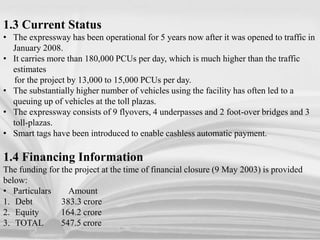

1.3 Current Status
• The expressway has been operational for 5 years now after it was opened to traffic in
January 2008.
• It carries more than 180,000 PCUs per day, which is much higher than the traffic
estimates
for the project by 13,000 to 15,000 PCUs per day.
• The substantially higher number of vehicles using the facility has often led to a
queuing up of vehicles at the toll plazas.
• The expressway consists of 9 flyovers, 4 underpasses and 2 foot-over bridges and 3
toll-plazas.
• Smart tags have been introduced to enable cashless automatic payment.
1.4 Financing Information
The funding for the project at the time of financial closure (9 May 2003) is provided
below:
• Particulars Amount
1. Debt 383.3 crore
2. Equity 164.2 crore
3. TOTAL 547.5 crore

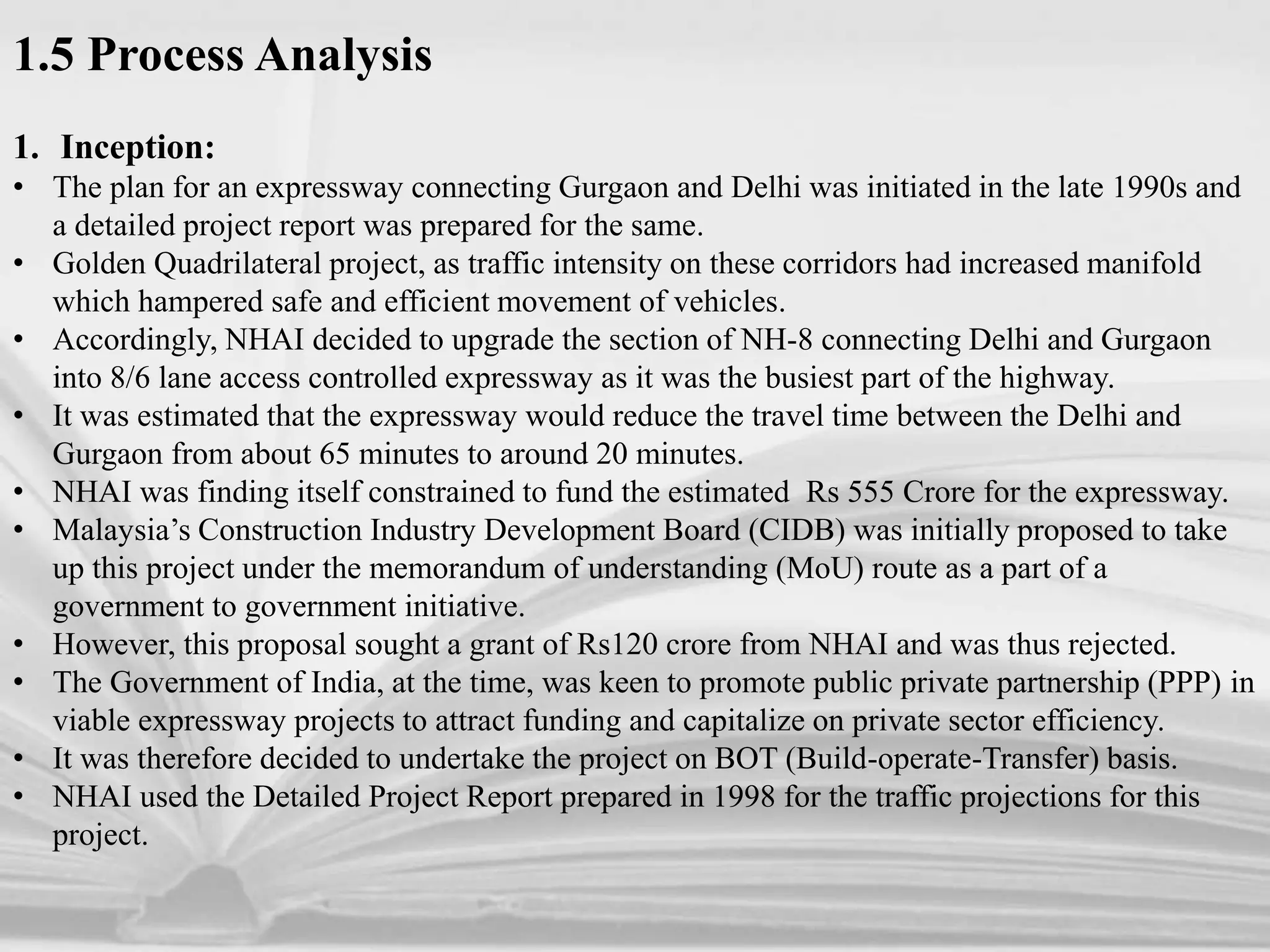

1.5 Process Analysis
1. Inception:
• The plan for an expressway connecting Gurgaon and Delhi was initiated in the late 1990s and
a detailed project report was prepared for the same.
• Golden Quadrilateral project, as traffic intensity on these corridors had increased manifold
which hampered safe and efficient movement of vehicles.
• Accordingly, NHAI decided to upgrade the section of NH-8 connecting Delhi and Gurgaon
into 8/6 lane access controlled expressway as it was the busiest part of the highway.
• It was estimated that the expressway would reduce the travel time between the Delhi and
Gurgaon from about 65 minutes to around 20 minutes.
• NHAI was finding itself constrained to fund the estimated Rs 555 Crore for the expressway.
• Malaysia’s Construction Industry Development Board (CIDB) was initially proposed to take
up this project under the memorandum of understanding (MoU) route as a part of a
government to government initiative.
• However, this proposal sought a grant of Rs120 crore from NHAI and was thus rejected.
• The Government of India, at the time, was keen to promote public private partnership (PPP) in
viable expressway projects to attract funding and capitalize on private sector efficiency.
• It was therefore decided to undertake the project on BOT (Build-operate-Transfer) basis.
• NHAI used the Detailed Project Report prepared in 1998 for the traffic projections for this
project.

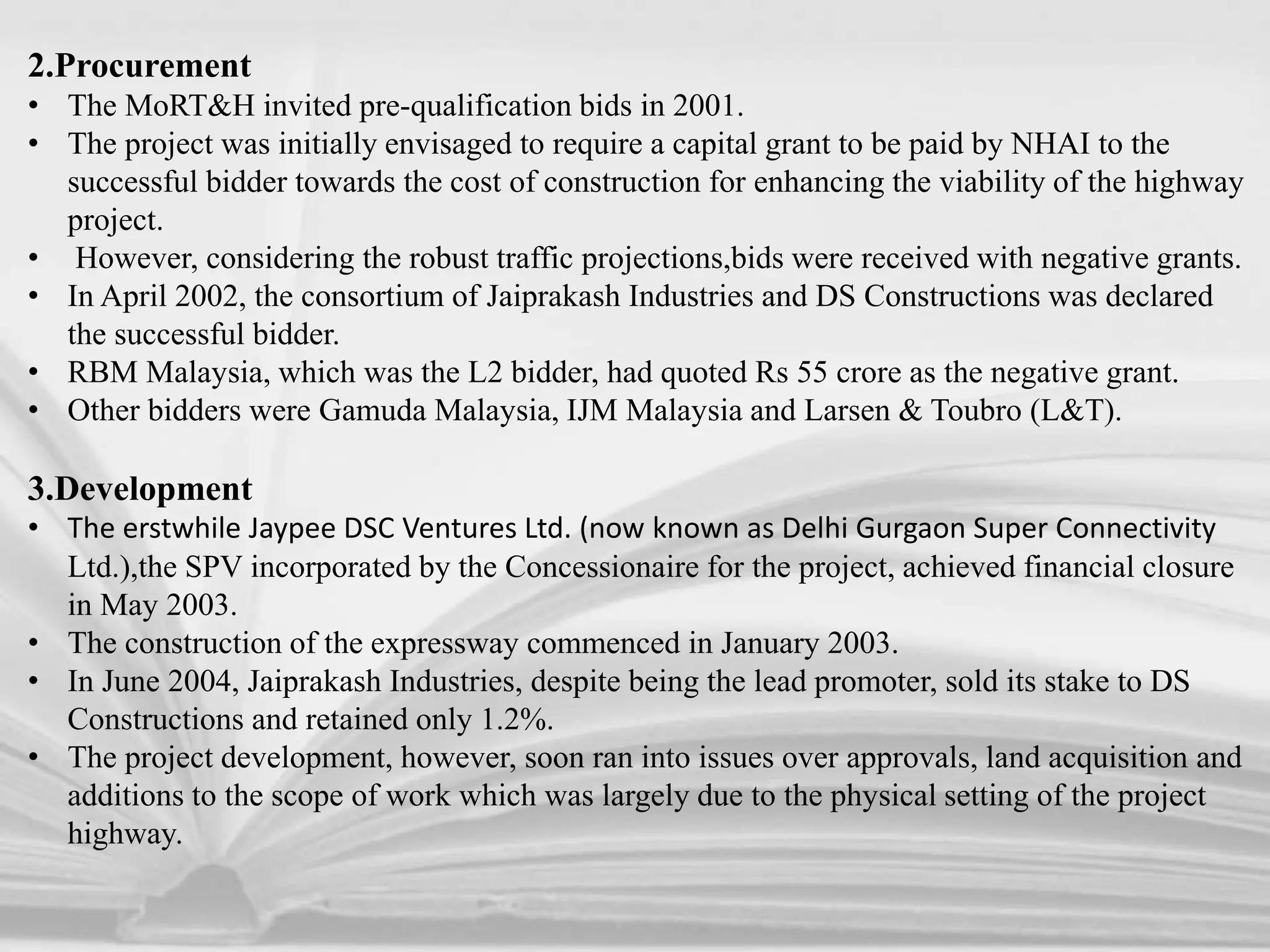

2.Procurement
• The MoRT&H invited pre-qualification bids in 2001.
• The project was initially envisaged to require a capital grant to be paid by NHAI to the
successful bidder towards the cost of construction for enhancing the viability of the highway
project.
• However, considering the robust traffic projections,bids were received with negative grants.
• In April 2002, the consortium of Jaiprakash Industries and DS Constructions was declared
the successful bidder.
• RBM Malaysia, which was the L2 bidder, had quoted Rs 55 crore as the negative grant.
• Other bidders were Gamuda Malaysia, IJM Malaysia and Larsen & Toubro (L&T).
3.Development
• The erstwhile Jaypee DSC Ventures Ltd. (now known as Delhi Gurgaon Super Connectivity
Ltd.),the SPV incorporated by the Concessionaire for the project, achieved financial closure
in May 2003.
• The construction of the expressway commenced in January 2003.
• In June 2004, Jaiprakash Industries, despite being the lead promoter, sold its stake to DS
Constructions and retained only 1.2%.
• The project development, however, soon ran into issues over approvals, land acquisition and
additions to the scope of work which was largely due to the physical setting of the project
highway.

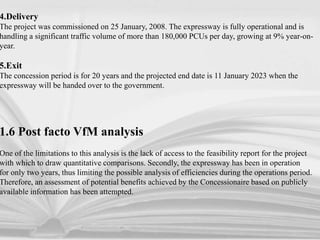

4.Delivery
The project was commissioned on 25 January, 2008. The expressway is fully operational and is
handling a significant traffic volume of more than 180,000 PCUs per day, growing at 9% year-on-
year.
5.Exit
The concession period is for 20 years and the projected end date is 11 January 2023 when the
expressway will be handed over to the government.
1.6 Post facto VfM analysis
One of the limitations to this analysis is the lack of access to the feasibility report for the project
with which to draw quantitative comparisons. Secondly, the expressway has been in operation
for only two years, thus limiting the possible analysis of efficiencies during the operations period.
Therefore, an assessment of potential benefits achieved by the Concessionaire based on publicly
available information has been attempted.

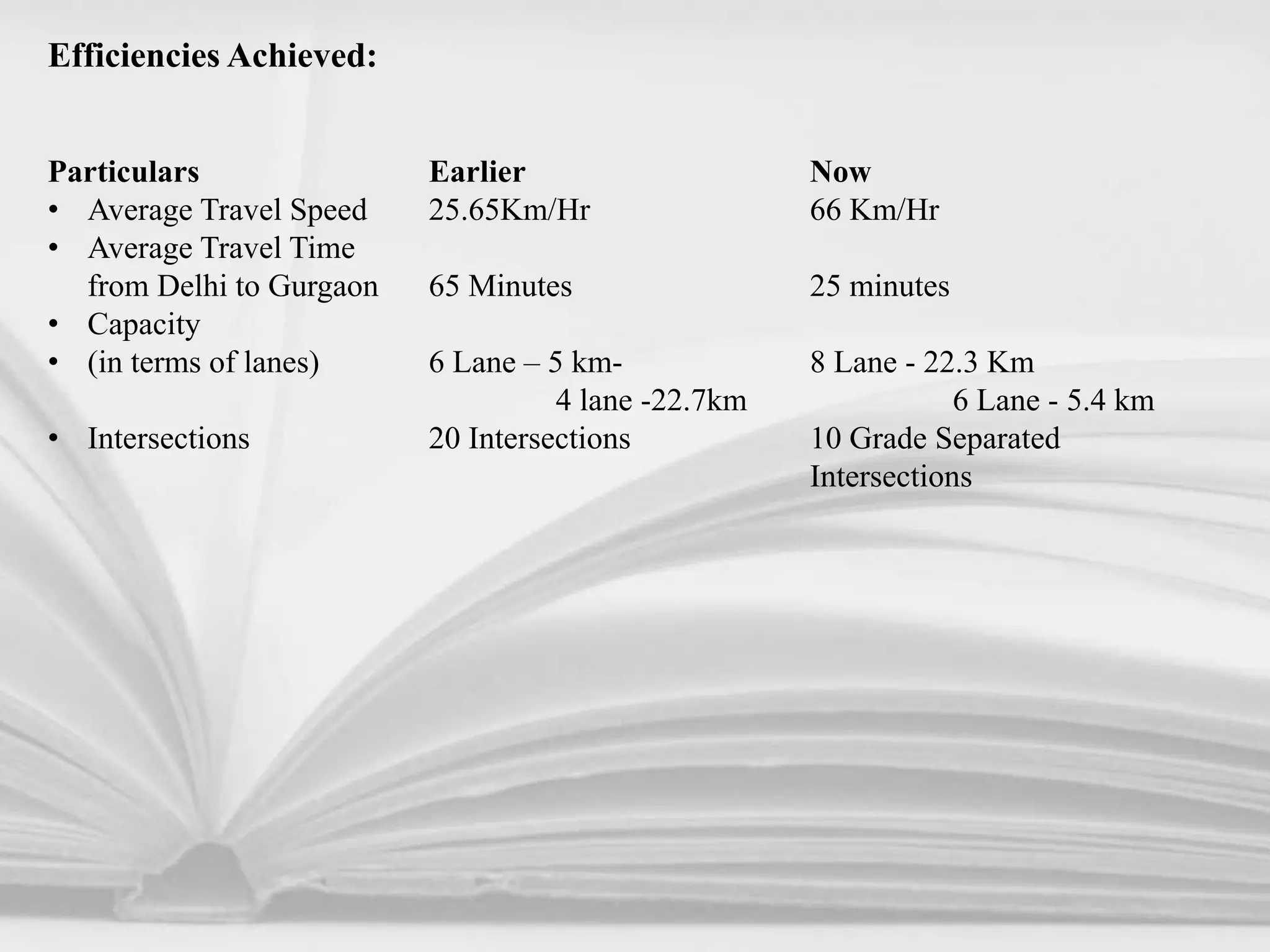

Efficiencies Achieved:
Particulars Earlier Now
• Average Travel Speed 25.65Km/Hr 66 Km/Hr
• Average Travel Time
from Delhi to Gurgaon 65 Minutes 25 minutes
• Capacity
• (in terms of lanes) 6 Lane – 5 km- 8 Lane - 22.3 Km
4 lane -22.7km 6 Lane - 5.4 km
• Intersections 20 Intersections 10 Grade Separated
Intersections

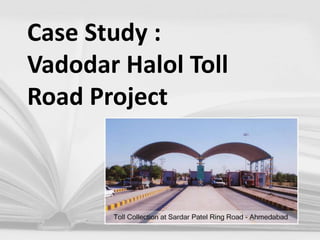

Case Study :
Vadodar Halol Toll
Road Project
VHTR was an initiative commissioned as a part of the Vision 2010 –
an infrastructure master plan developed by the Government of Gujarat
(GoG).
The project involved widening and strengthening of 32 km of the
existing two-lane State Highway (SH 87) connecting Vadodara to the
industrial town of Halol into a four-lane tolled expressway.
The underlying principle of the vision was to develop infrastructure
projects in Gujarat by attracting private sector participation.

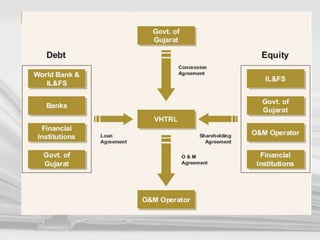

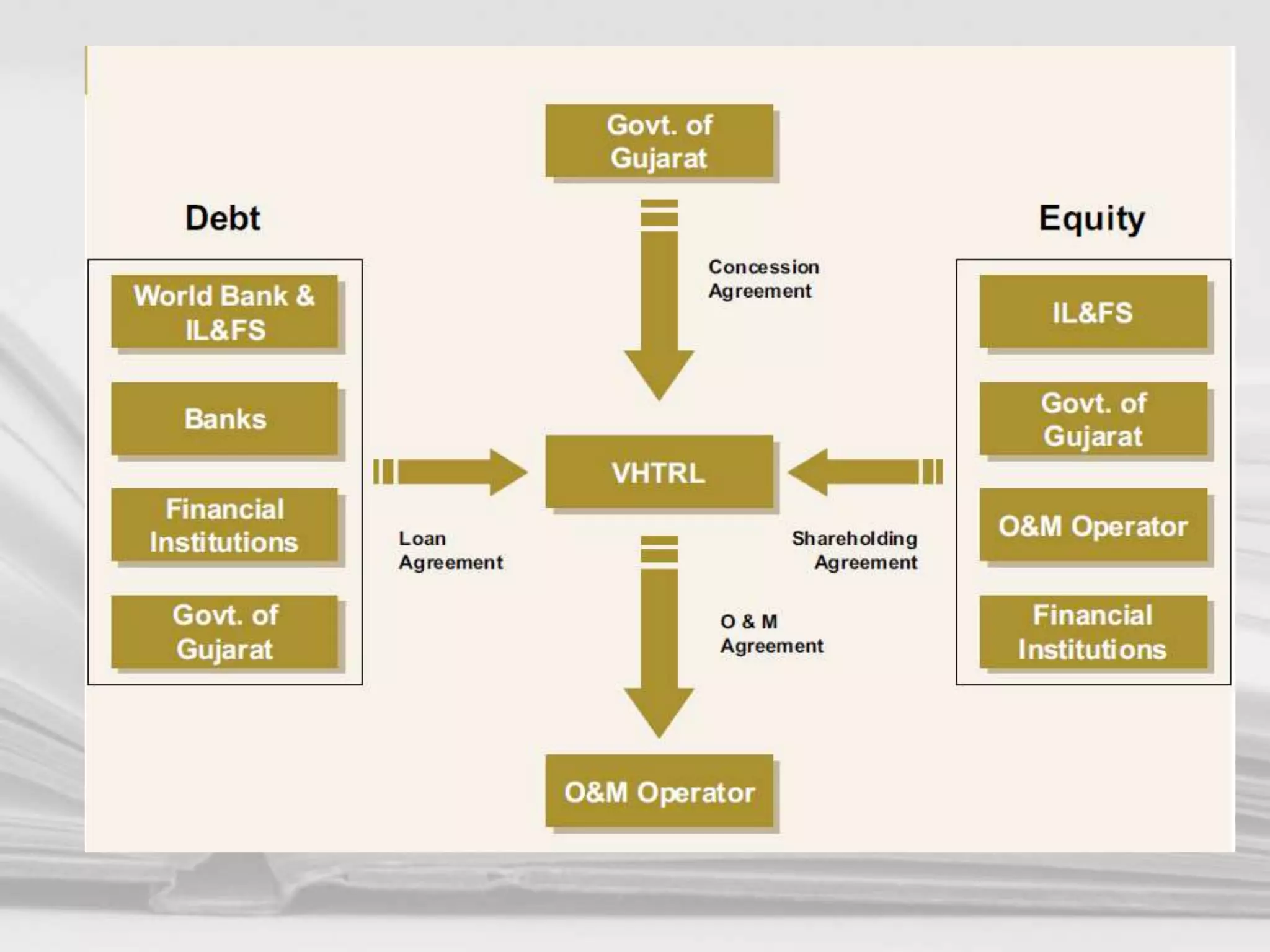

 The Roads and Buildings Department (R&B), GoG and Infrastructure
Leasing and Financial Services (IL&FS) signed a Memorandum of
Agreement (MoA) to this effect on 31st October 1995.
 A special purpose vehicle (SPV) was constituted for this purpose named
the Vadodara Halol Toll Road Company Limited (VHTRL)
 The construction of VHTR commenced on 1st March 1999 and
completed on 15th September 2000.
 The toll operations commenced on 24th October 2000. VHTRL
manages, operates and maintains the road for 30 years starting from 2000.

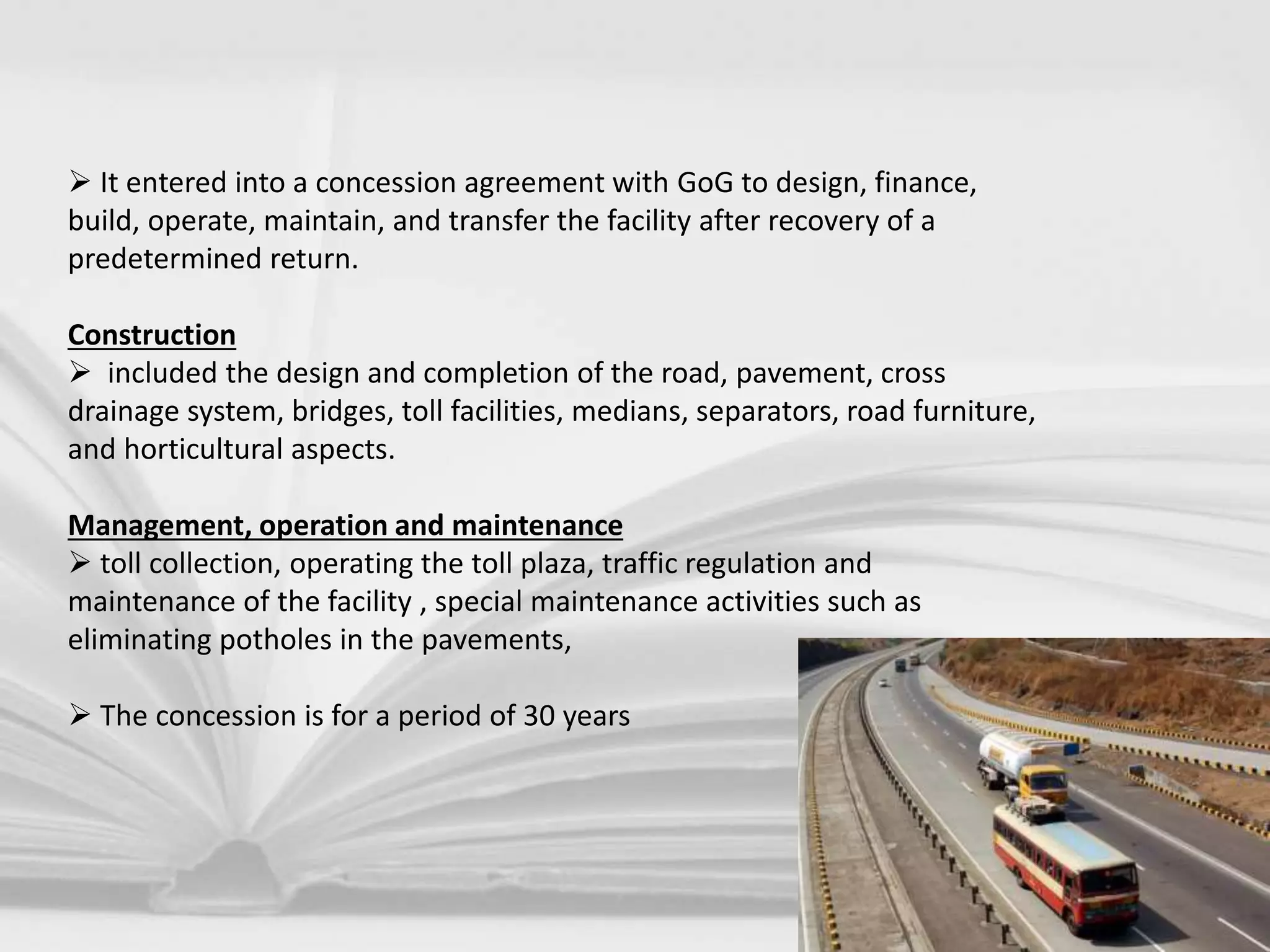

 It entered into a concession agreement with GoG to design, finance,
build, operate, maintain, and transfer the facility after recovery of a
predetermined return.
Construction
 included the design and completion of the road, pavement, cross
drainage system, bridges, toll facilities, medians, separators, road furniture,
and horticultural aspects.
Management, operation and maintenance
 toll collection, operating the toll plaza, traffic regulation and
maintenance of the facility , special maintenance activities such as
eliminating potholes in the pavements,
 The concession is for a period of 30 years

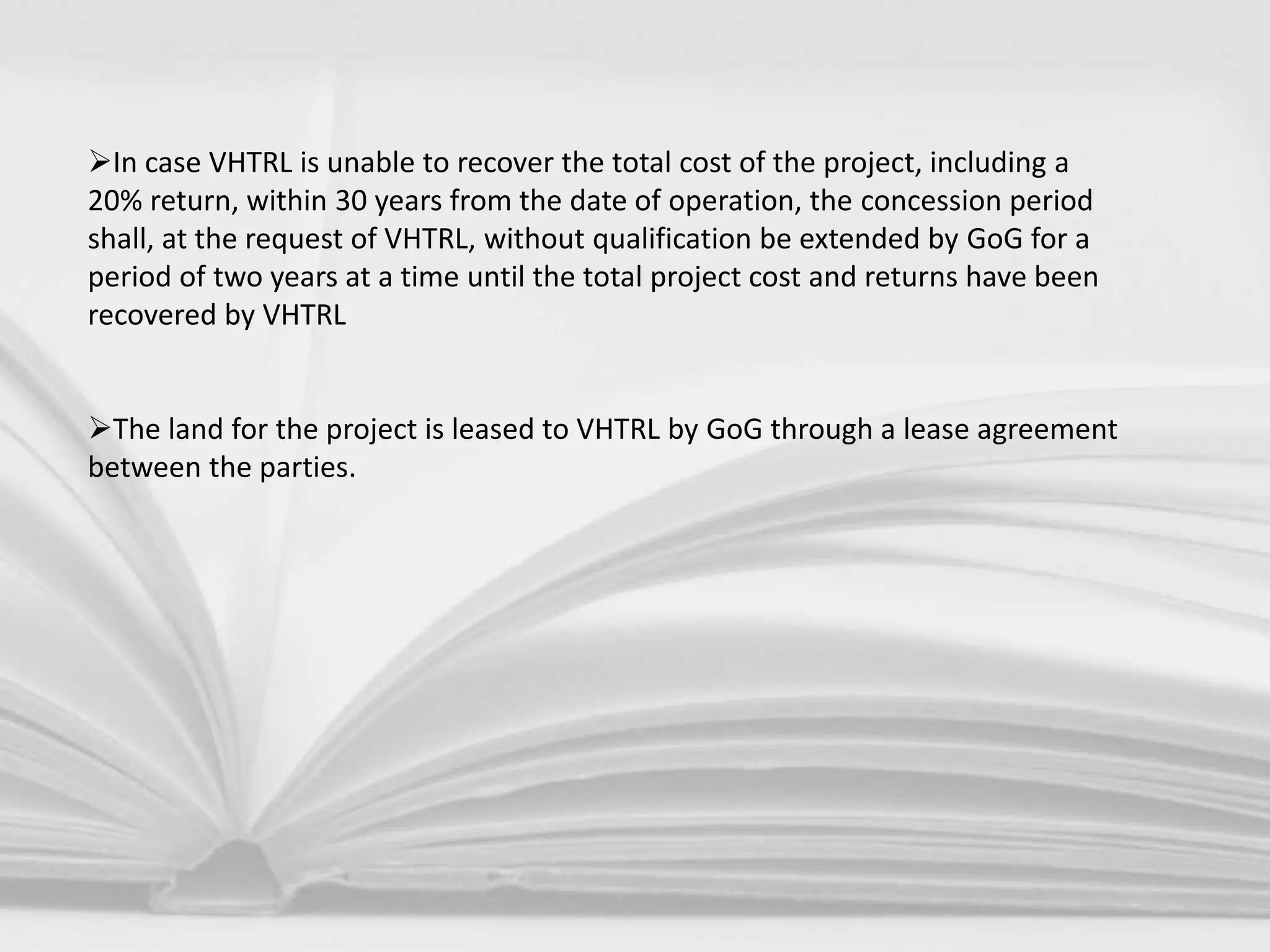

In case VHTRL is unable to recover the total cost of the project, including a
20% return, within 30 years from the date of operation, the concession period
shall, at the request of VHTRL, without qualification be extended by GoG for a
period of two years at a time until the total project cost and returns have been
recovered by VHTRL
The land for the project is leased to VHTRL by GoG through a lease agreement
between the parties.
Project operational since 2000
But the traffic on road not I line with the expected traffic
levels
the financial condition of VHTRL started deteriorating
was unable to service its debt obligations.
Financing Information
The cost of the project was 161 crores.
construction cost accounted 119 crores.
Equity of ` 67.9 crores was raised from GoG
IL&FS also raised debt of ` 93.2 crores through various Indian
financial institutions including Industrial Development Bank of India,

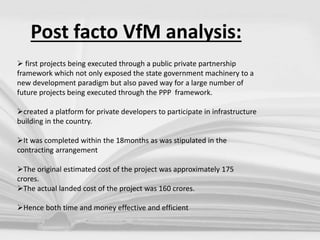

Post facto VfM analysis:
 first projects being executed through a public private partnership
framework which not only exposed the state government machinery to a
new development paradigm but also paved way for a large number of
future projects being executed through the PPP framework.
created a platform for private developers to participate in infrastructure
building in the country.
It was completed within the 18months as was stipulated in the
contracting arrangement
The original estimated cost of the project was approximately 175
crores.
The actual landed cost of the project was 160 crores.
Hence both time and money effective and efficient
Key Learning and Observations
Pre-development market assessment is critical :
more robust,
For instance, the traffic estimations for
the project were based on the assumptions that the industrial
incentives available for the area would continue for long-term.
Eventually, with time the incentives were withdrawn and the traffic
was almost 50% lower than the projected traffic. Such unaccounted
risk factors can jeopardize the project and lead to significant losses.
Competitive bidding can ensure a “better deal”
extremely critical
VHTR was developed through a MoA between the GoG and IL&FS and
did not create adequate competitive tension since there were no
precedents that were available to develop such a structure.
Need to create a balanced risk return profile:
The risk return profile of the project was skewed in favour of the
private developer. For instance, the concession agreement
ensured that the private developer earned toll revenues till he was able
to achieve a return of 20% on the overall investment.
Environmentally and Socially responsive development
framework:
was the first project that introduced Environmental and Social Safeguards
measures as part of the contractual obligation of the developer. This created a
benchmark and had immense demonstration value since it highlighted that
infrastructure can be developed in an environmentally and socially responsible
manner.
Bot(build operate transfr)

More Related Content

What's hot

STUDY ON BOT PROJECT WITH A CASE STUDY OF DELHI GURGAON EXPRESSWAY
STUDY ON BOT PROJECT WITH A CASE STUDY OF DELHI GURGAON EXPRESSWAYSTUDY ON BOT PROJECT WITH A CASE STUDY OF DELHI GURGAON EXPRESSWAY
STUDY ON BOT PROJECT WITH A CASE STUDY OF DELHI GURGAON EXPRESSWAYShabaz Khan

Construction project delivery methods
Construction project delivery methodsConstruction project delivery methods
Construction project delivery methodsNitin Kumar

Comparison of boot and bolt modes of Construction
Comparison of boot and bolt modes of ConstructionComparison of boot and bolt modes of Construction
Comparison of boot and bolt modes of ConstructionEdwinJacob5

Fidic contract
Fidic contract Fidic contract
Fidic contract Yash Patel

BOT MODEL.pdf
BOT MODEL.pdfBOT MODEL.pdf
BOT MODEL.pdfvsballa1

#FIDIC Understanding Basics# By SN Panigrahi
#FIDIC Understanding Basics# By SN Panigrahi#FIDIC Understanding Basics# By SN Panigrahi
#FIDIC Understanding Basics# By SN PanigrahiSN Panigrahi, PMP

Public Private Partnership
Public Private PartnershipPublic Private Partnership
Public Private Partnershiprajeshrvth60

Types of Contract in Construction Management
Types of Contract in Construction ManagementTypes of Contract in Construction Management
Types of Contract in Construction ManagementShahin MB

BOOT, BOT, Management Contracts & Turnkey PROJECTS
BOOT, BOT, Management Contracts & Turnkey PROJECTSBOOT, BOT, Management Contracts & Turnkey PROJECTS
BOOT, BOT, Management Contracts & Turnkey PROJECTSaly_ayk

Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...
Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...
Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...Divyanshu Dayal

Ahmedabad metro.
Ahmedabad metro.Ahmedabad metro.
Ahmedabad metro.Axay Sharma

Conditions of CPWD contract in INDIA
Conditions of CPWD contract in INDIAConditions of CPWD contract in INDIA
Conditions of CPWD contract in INDIAAvinash Kumar Gupta

National Urban Transport Policy
National Urban Transport PolicyNational Urban Transport Policy
National Urban Transport PolicyAshu Kedia

Private public partnership (ppp)
Private public partnership (ppp)Private public partnership (ppp)
Private public partnership (ppp)Môhãñ Raj

Public-Private Partnerships - Business & Legal Issues
Public-Private Partnerships - Business & Legal IssuesPublic-Private Partnerships - Business & Legal Issues
Public-Private Partnerships - Business & Legal IssuesLou Milrad

MASS RAPID TRANSIT SYSTEM
MASS RAPID TRANSIT SYSTEMMASS RAPID TRANSIT SYSTEM
MASS RAPID TRANSIT SYSTEMChandanPadhi3

What's hot (20)

STUDY ON BOT PROJECT WITH A CASE STUDY OF DELHI GURGAON EXPRESSWAY
STUDY ON BOT PROJECT WITH A CASE STUDY OF DELHI GURGAON EXPRESSWAYSTUDY ON BOT PROJECT WITH A CASE STUDY OF DELHI GURGAON EXPRESSWAY
STUDY ON BOT PROJECT WITH A CASE STUDY OF DELHI GURGAON EXPRESSWAY

public private partnership
 public private partnership public private partnership
public private partnership

Construction project delivery methods
Construction project delivery methodsConstruction project delivery methods
Construction project delivery methods

Comparison of boot and bolt modes of Construction
Comparison of boot and bolt modes of ConstructionComparison of boot and bolt modes of Construction
Comparison of boot and bolt modes of Construction

Bot contracts
Bot contractsBot contracts
Bot contracts

Fidic contract
Fidic contract Fidic contract
Fidic contract

BOT MODEL.pdf
BOT MODEL.pdfBOT MODEL.pdf
BOT MODEL.pdf

#FIDIC Understanding Basics# By SN Panigrahi
#FIDIC Understanding Basics# By SN Panigrahi#FIDIC Understanding Basics# By SN Panigrahi
#FIDIC Understanding Basics# By SN Panigrahi

Types of contracts
Types of contractsTypes of contracts
Types of contracts

Public Private Partnership
Public Private PartnershipPublic Private Partnership
Public Private Partnership

Types of Contract in Construction Management
Types of Contract in Construction ManagementTypes of Contract in Construction Management
Types of Contract in Construction Management

BOOT, BOT, Management Contracts & Turnkey PROJECTS
BOOT, BOT, Management Contracts & Turnkey PROJECTSBOOT, BOT, Management Contracts & Turnkey PROJECTS
BOOT, BOT, Management Contracts & Turnkey PROJECTS

Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...
Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...
Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...

Ahmedabad metro.
Ahmedabad metro.Ahmedabad metro.
Ahmedabad metro.

Conditions of CPWD contract in INDIA
Conditions of CPWD contract in INDIAConditions of CPWD contract in INDIA
Conditions of CPWD contract in INDIA

National Urban Transport Policy
National Urban Transport PolicyNational Urban Transport Policy
National Urban Transport Policy

Private public partnership (ppp)
Private public partnership (ppp)Private public partnership (ppp)
Private public partnership (ppp)

Public-Private Partnerships - Business & Legal Issues
Public-Private Partnerships - Business & Legal IssuesPublic-Private Partnerships - Business & Legal Issues
Public-Private Partnerships - Business & Legal Issues

DBFOT project
DBFOT projectDBFOT project
DBFOT project

MASS RAPID TRANSIT SYSTEM
MASS RAPID TRANSIT SYSTEMMASS RAPID TRANSIT SYSTEM
MASS RAPID TRANSIT SYSTEM

Similar to Bot(build operate transfr)

The PPP model- Delhi Gurgaon Expressway.
The PPP model- Delhi Gurgaon Expressway.The PPP model- Delhi Gurgaon Expressway.
The PPP model- Delhi Gurgaon Expressway.TwinkleVincent2

Public private partnership in development of road network
Public private partnership in development of road networkPublic private partnership in development of road network
Public private partnership in development of road networkGokul K Prasad

mumbai metro PPP model.pptx
mumbai metro PPP model.pptxmumbai metro PPP model.pptx
mumbai metro PPP model.pptxTwinkleVincent2

projectfinancingandpublicprivatepartnershipppp-191120191032.pdf
projectfinancingandpublicprivatepartnershipppp-191120191032.pdfprojectfinancingandpublicprivatepartnershipppp-191120191032.pdf
projectfinancingandpublicprivatepartnershipppp-191120191032.pdfSeshukumar53

Project financing and public private partnership (ppp)
Project financing and public private partnership (ppp)Project financing and public private partnership (ppp)
Project financing and public private partnership (ppp)M. Asim U Khan

Infrastructure Management - DMRC Study
Infrastructure Management - DMRC StudyInfrastructure Management - DMRC Study
Infrastructure Management - DMRC StudyMohit Gaur

Emerging Professional and Ethical Challenges for Railway Engineers
Emerging Professional and Ethical Challenges for Railway EngineersEmerging Professional and Ethical Challenges for Railway Engineers
Emerging Professional and Ethical Challenges for Railway EngineersAnil Kumar Gupta

Chapter19 financinginfrastructureprojects
Chapter19 financinginfrastructureprojectsChapter19 financinginfrastructureprojects
Chapter19 financinginfrastructureprojectsAKSHAYA0000

Mumbai Metro Phase 1
Mumbai Metro Phase 1Mumbai Metro Phase 1
Mumbai Metro Phase 1OmkarRasal

Procurement & contract.(bot)
Procurement & contract.(bot)Procurement & contract.(bot)
Procurement & contract.(bot)rajlaxmipardeshi

Aba forum division_4_aurora_light_rail_presentation_shresta_2012_11_27
Aba forum division_4_aurora_light_rail_presentation_shresta_2012_11_27Aba forum division_4_aurora_light_rail_presentation_shresta_2012_11_27
Aba forum division_4_aurora_light_rail_presentation_shresta_2012_11_27Roland_Nikles

Amritsar Inter City Bus Terminal PPP Structure and Risk mitigation matrix
Amritsar Inter City Bus Terminal PPP Structure and Risk mitigation matrixAmritsar Inter City Bus Terminal PPP Structure and Risk mitigation matrix
Amritsar Inter City Bus Terminal PPP Structure and Risk mitigation matrixNISHCHAY SAXENA

public private partnership
public private partnershippublic private partnership
public private partnershipDiyaGarg5

P3s for Puerto Rico - 17 May 2023 - Updated.pptx
P3s for Puerto Rico  - 17 May 2023 - Updated.pptxP3s for Puerto Rico  - 17 May 2023 - Updated.pptx
P3s for Puerto Rico - 17 May 2023 - Updated.pptxMarc Joffe

Public private partnership
Public private partnershipPublic private partnership
Public private partnershipSuryansh Kori

Similar to Bot(build operate transfr) (20)

The PPP model- Delhi Gurgaon Expressway.
The PPP model- Delhi Gurgaon Expressway.The PPP model- Delhi Gurgaon Expressway.
The PPP model- Delhi Gurgaon Expressway.

Public private partnership in development of road network
Public private partnership in development of road networkPublic private partnership in development of road network
Public private partnership in development of road network

mumbai metro PPP model.pptx
mumbai metro PPP model.pptxmumbai metro PPP model.pptx
mumbai metro PPP model.pptx

Ppp
PppPpp
Ppp

projectfinancingandpublicprivatepartnershipppp-191120191032.pdf
projectfinancingandpublicprivatepartnershipppp-191120191032.pdfprojectfinancingandpublicprivatepartnershipppp-191120191032.pdf
projectfinancingandpublicprivatepartnershipppp-191120191032.pdf

Project financing and public private partnership (ppp)
Project financing and public private partnership (ppp)Project financing and public private partnership (ppp)
Project financing and public private partnership (ppp)

Project finance ppt final
Project finance ppt finalProject finance ppt final
Project finance ppt final

Infrastructure Management - DMRC Study
Infrastructure Management - DMRC StudyInfrastructure Management - DMRC Study
Infrastructure Management - DMRC Study

Emerging Professional and Ethical Challenges for Railway Engineers
Emerging Professional and Ethical Challenges for Railway EngineersEmerging Professional and Ethical Challenges for Railway Engineers
Emerging Professional and Ethical Challenges for Railway Engineers

PPTs for presentation on 14.03.15
PPTs for presentation on 14.03.15PPTs for presentation on 14.03.15
PPTs for presentation on 14.03.15

Infra on Roads
Infra on RoadsInfra on Roads
Infra on Roads

BOOT 2
BOOT 2BOOT 2
BOOT 2

Chapter19 financinginfrastructureprojects
Chapter19 financinginfrastructureprojectsChapter19 financinginfrastructureprojects
Chapter19 financinginfrastructureprojects

Mumbai Metro Phase 1
Mumbai Metro Phase 1Mumbai Metro Phase 1
Mumbai Metro Phase 1

Procurement & contract.(bot)
Procurement & contract.(bot)Procurement & contract.(bot)
Procurement & contract.(bot)

Aba forum division_4_aurora_light_rail_presentation_shresta_2012_11_27
Aba forum division_4_aurora_light_rail_presentation_shresta_2012_11_27Aba forum division_4_aurora_light_rail_presentation_shresta_2012_11_27
Aba forum division_4_aurora_light_rail_presentation_shresta_2012_11_27

Amritsar Inter City Bus Terminal PPP Structure and Risk mitigation matrix
Amritsar Inter City Bus Terminal PPP Structure and Risk mitigation matrixAmritsar Inter City Bus Terminal PPP Structure and Risk mitigation matrix
Amritsar Inter City Bus Terminal PPP Structure and Risk mitigation matrix

public private partnership
public private partnershippublic private partnership
public private partnership

P3s for Puerto Rico - 17 May 2023 - Updated.pptx
P3s for Puerto Rico  - 17 May 2023 - Updated.pptxP3s for Puerto Rico  - 17 May 2023 - Updated.pptx
P3s for Puerto Rico - 17 May 2023 - Updated.pptx

Public private partnership
Public private partnershipPublic private partnership
Public private partnership

More from Kritika Garg

Death mystery of netaji subhash chandra bose
Death mystery of netaji subhash chandra boseDeath mystery of netaji subhash chandra bose
Death mystery of netaji subhash chandra boseKritika Garg

Objectification of women
Objectification of womenObjectification of women
Objectification of womenKritika Garg

East india company
East india companyEast india company
East india companyKritika Garg

Plant layout and its types
Plant layout and its typesPlant layout and its types
Plant layout and its typesKritika Garg

Nationalisation of banks in india
Nationalisation of banks in indiaNationalisation of banks in india
Nationalisation of banks in indiaKritika Garg

Discipline of teams a harward case review
Discipline of teams a harward case reviewDiscipline of teams a harward case review
Discipline of teams a harward case reviewKritika Garg

Case study analysis arvind eye care
Case study analysis arvind eye careCase study analysis arvind eye care
Case study analysis arvind eye careKritika Garg

Design of work organisation example book cafe
Design of work organisation example book cafeDesign of work organisation example book cafe
Design of work organisation example book cafeKritika Garg

Performance management national institute of management case analysis
Performance management national institute of management case analysisPerformance management national institute of management case analysis
Performance management national institute of management case analysisKritika Garg

More from Kritika Garg (9)

Death mystery of netaji subhash chandra bose
Death mystery of netaji subhash chandra boseDeath mystery of netaji subhash chandra bose
Death mystery of netaji subhash chandra bose

Objectification of women
Objectification of womenObjectification of women
Objectification of women

East india company
East india companyEast india company
East india company

Plant layout and its types
Plant layout and its typesPlant layout and its types
Plant layout and its types

Nationalisation of banks in india
Nationalisation of banks in indiaNationalisation of banks in india
Nationalisation of banks in india

Discipline of teams a harward case review
Discipline of teams a harward case reviewDiscipline of teams a harward case review
Discipline of teams a harward case review

Case study analysis arvind eye care
Case study analysis arvind eye careCase study analysis arvind eye care
Case study analysis arvind eye care

Design of work organisation example book cafe
Design of work organisation example book cafeDesign of work organisation example book cafe
Design of work organisation example book cafe

Performance management national institute of management case analysis
Performance management national institute of management case analysisPerformance management national institute of management case analysis
Performance management national institute of management case analysis

Recently uploaded

Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...
Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...
Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...lizamodels9

(8264348440) 🔝 Call Girls In Mahipalpur 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Mahipalpur 🔝 Delhi NCR(8264348440) 🔝 Call Girls In Mahipalpur 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Mahipalpur 🔝 Delhi NCRsoniya singh

The CMO Survey - Highlights and Insights Report - Spring 2024
The CMO Survey - Highlights and Insights Report - Spring 2024The CMO Survey - Highlights and Insights Report - Spring 2024
The CMO Survey - Highlights and Insights Report - Spring 2024christinemoorman

Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...
Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...
Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...lizamodels9

CATALOG cáp điện Goldcup (bảng giá) 1.4.2024.PDF
CATALOG cáp điện Goldcup (bảng giá) 1.4.2024.PDFCATALOG cáp điện Goldcup (bảng giá) 1.4.2024.PDF
CATALOG cáp điện Goldcup (bảng giá) 1.4.2024.PDFOrient Homes

(8264348440) 🔝 Call Girls In Hauz Khas 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Hauz Khas 🔝 Delhi NCR(8264348440) 🔝 Call Girls In Hauz Khas 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Hauz Khas 🔝 Delhi NCRsoniya singh

VIP Call Girl Jamshedpur Aashi 8250192130 Independent Escort Service Jamshedpur
VIP Call Girl Jamshedpur Aashi 8250192130 Independent Escort Service JamshedpurVIP Call Girl Jamshedpur Aashi 8250192130 Independent Escort Service Jamshedpur
VIP Call Girl Jamshedpur Aashi 8250192130 Independent Escort Service JamshedpurSuhani Kapoor

FULL ENJOY - 9953040155 Call Girls in Chhatarpur | Delhi
FULL ENJOY - 9953040155 Call Girls in Chhatarpur | DelhiFULL ENJOY - 9953040155 Call Girls in Chhatarpur | Delhi
FULL ENJOY - 9953040155 Call Girls in Chhatarpur | DelhiMalviyaNagarCallGirl

A.I. Bot Summit 3 Opening Keynote - Perry Belcher
A.I. Bot Summit 3 Opening Keynote - Perry BelcherA.I. Bot Summit 3 Opening Keynote - Perry Belcher
A.I. Bot Summit 3 Opening Keynote - Perry BelcherPerry Belcher

Progress Report - Oracle Database Analyst Summit
Progress  Report - Oracle Database Analyst SummitProgress  Report - Oracle Database Analyst Summit
Progress Report - Oracle Database Analyst SummitHolger Mueller

Call Girls In ⇛⇛Chhatarpur⇚⇚. Brings Offer Delhi Contact Us 8377877756
Call Girls In ⇛⇛Chhatarpur⇚⇚. Brings Offer Delhi Contact Us 8377877756Call Girls In ⇛⇛Chhatarpur⇚⇚. Brings Offer Delhi Contact Us 8377877756
Call Girls In ⇛⇛Chhatarpur⇚⇚. Brings Offer Delhi Contact Us 8377877756dollysharma2066

Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...
Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...
Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...lizamodels9

Call Girls In Kishangarh Delhi ❤️8860477959 Good Looking Escorts In 24/7 Delh...
Call Girls In Kishangarh Delhi ❤️8860477959 Good Looking Escorts In 24/7 Delh...Call Girls In Kishangarh Delhi ❤️8860477959 Good Looking Escorts In 24/7 Delh...
Call Girls In Kishangarh Delhi ❤️8860477959 Good Looking Escorts In 24/7 Delh...lizamodels9

Vip Dewas Call Girls #9907093804 Contact Number Escorts Service Dewas
Vip Dewas Call Girls #9907093804 Contact Number Escorts Service DewasVip Dewas Call Girls #9907093804 Contact Number Escorts Service Dewas
Vip Dewas Call Girls #9907093804 Contact Number Escorts Service Dewasmakika9823

Investment analysis and portfolio management
Investment analysis and portfolio managementInvestment analysis and portfolio management
Investment analysis and portfolio managementJunaidKhan750825

Catalogue ONG NUOC PPR DE NHAT .pdf
Catalogue ONG NUOC PPR DE NHAT      .pdfCatalogue ONG NUOC PPR DE NHAT      .pdf
Catalogue ONG NUOC PPR DE NHAT .pdfOrient Homes

Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...
Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...
Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...lizamodels9

VIP Kolkata Call Girl Howrah 👉 8250192130 Available With Room
VIP Kolkata Call Girl Howrah 👉 8250192130  Available With RoomVIP Kolkata Call Girl Howrah 👉 8250192130  Available With Room
VIP Kolkata Call Girl Howrah 👉 8250192130 Available With Roomdivyansh0kumar0

(8264348440) 🔝 Call Girls In Keshav Puram 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Keshav Puram 🔝 Delhi NCR(8264348440) 🔝 Call Girls In Keshav Puram 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Keshav Puram 🔝 Delhi NCRsoniya singh

Recently uploaded (20)

Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...
Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...
Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...

(8264348440) 🔝 Call Girls In Mahipalpur 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Mahipalpur 🔝 Delhi NCR(8264348440) 🔝 Call Girls In Mahipalpur 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Mahipalpur 🔝 Delhi NCR

The CMO Survey - Highlights and Insights Report - Spring 2024
The CMO Survey - Highlights and Insights Report - Spring 2024The CMO Survey - Highlights and Insights Report - Spring 2024
The CMO Survey - Highlights and Insights Report - Spring 2024

Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...
Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...
Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...

CATALOG cáp điện Goldcup (bảng giá) 1.4.2024.PDF
CATALOG cáp điện Goldcup (bảng giá) 1.4.2024.PDFCATALOG cáp điện Goldcup (bảng giá) 1.4.2024.PDF
CATALOG cáp điện Goldcup (bảng giá) 1.4.2024.PDF

KestrelPro Flyer Japan IT Week 2024 (English)
KestrelPro Flyer Japan IT Week 2024 (English)KestrelPro Flyer Japan IT Week 2024 (English)
KestrelPro Flyer Japan IT Week 2024 (English)

(8264348440) 🔝 Call Girls In Hauz Khas 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Hauz Khas 🔝 Delhi NCR(8264348440) 🔝 Call Girls In Hauz Khas 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Hauz Khas 🔝 Delhi NCR

VIP Call Girl Jamshedpur Aashi 8250192130 Independent Escort Service Jamshedpur
VIP Call Girl Jamshedpur Aashi 8250192130 Independent Escort Service JamshedpurVIP Call Girl Jamshedpur Aashi 8250192130 Independent Escort Service Jamshedpur
VIP Call Girl Jamshedpur Aashi 8250192130 Independent Escort Service Jamshedpur

FULL ENJOY - 9953040155 Call Girls in Chhatarpur | Delhi
FULL ENJOY - 9953040155 Call Girls in Chhatarpur | DelhiFULL ENJOY - 9953040155 Call Girls in Chhatarpur | Delhi
FULL ENJOY - 9953040155 Call Girls in Chhatarpur | Delhi

A.I. Bot Summit 3 Opening Keynote - Perry Belcher
A.I. Bot Summit 3 Opening Keynote - Perry BelcherA.I. Bot Summit 3 Opening Keynote - Perry Belcher
A.I. Bot Summit 3 Opening Keynote - Perry Belcher

Progress Report - Oracle Database Analyst Summit
Progress  Report - Oracle Database Analyst SummitProgress  Report - Oracle Database Analyst Summit
Progress Report - Oracle Database Analyst Summit

Call Girls In ⇛⇛Chhatarpur⇚⇚. Brings Offer Delhi Contact Us 8377877756
Call Girls In ⇛⇛Chhatarpur⇚⇚. Brings Offer Delhi Contact Us 8377877756Call Girls In ⇛⇛Chhatarpur⇚⇚. Brings Offer Delhi Contact Us 8377877756
Call Girls In ⇛⇛Chhatarpur⇚⇚. Brings Offer Delhi Contact Us 8377877756

Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...
Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...
Call Girls In Sikandarpur Gurgaon ❤️8860477959_Russian 100% Genuine Escorts I...

Call Girls In Kishangarh Delhi ❤️8860477959 Good Looking Escorts In 24/7 Delh...
Call Girls In Kishangarh Delhi ❤️8860477959 Good Looking Escorts In 24/7 Delh...Call Girls In Kishangarh Delhi ❤️8860477959 Good Looking Escorts In 24/7 Delh...
Call Girls In Kishangarh Delhi ❤️8860477959 Good Looking Escorts In 24/7 Delh...

Vip Dewas Call Girls #9907093804 Contact Number Escorts Service Dewas
Vip Dewas Call Girls #9907093804 Contact Number Escorts Service DewasVip Dewas Call Girls #9907093804 Contact Number Escorts Service Dewas
Vip Dewas Call Girls #9907093804 Contact Number Escorts Service Dewas

Investment analysis and portfolio management
Investment analysis and portfolio managementInvestment analysis and portfolio management
Investment analysis and portfolio management

Catalogue ONG NUOC PPR DE NHAT .pdf
Catalogue ONG NUOC PPR DE NHAT      .pdfCatalogue ONG NUOC PPR DE NHAT      .pdf
Catalogue ONG NUOC PPR DE NHAT .pdf

Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...
Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...
Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...

VIP Kolkata Call Girl Howrah 👉 8250192130 Available With Room
VIP Kolkata Call Girl Howrah 👉 8250192130  Available With RoomVIP Kolkata Call Girl Howrah 👉 8250192130  Available With Room
VIP Kolkata Call Girl Howrah 👉 8250192130 Available With Room

(8264348440) 🔝 Call Girls In Keshav Puram 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Keshav Puram 🔝 Delhi NCR(8264348440) 🔝 Call Girls In Keshav Puram 🔝 Delhi NCR
(8264348440) 🔝 Call Girls In Keshav Puram 🔝 Delhi NCR

Bot(build operate transfr)

  • 1.
  • 2. Build–operate–transfer (BOT) is a form of project financing, wherein a private entity receives a concession from the private or public sector to finance, design, construct, and operate a facility stated in the concession contract. This enables the project proponent to recover its investment , operating and maintenance expenses in the project. Due to the long-term nature of the arrangement, the fees are usually raised during the concession period. The rate of increase is oftentied to a combination of internal and external variables, allowing the proponent to reach a satisfactory internal rate of return for its investment. BOT-BUILD OPERATE TRANSFER
  • 3.
  • 4.

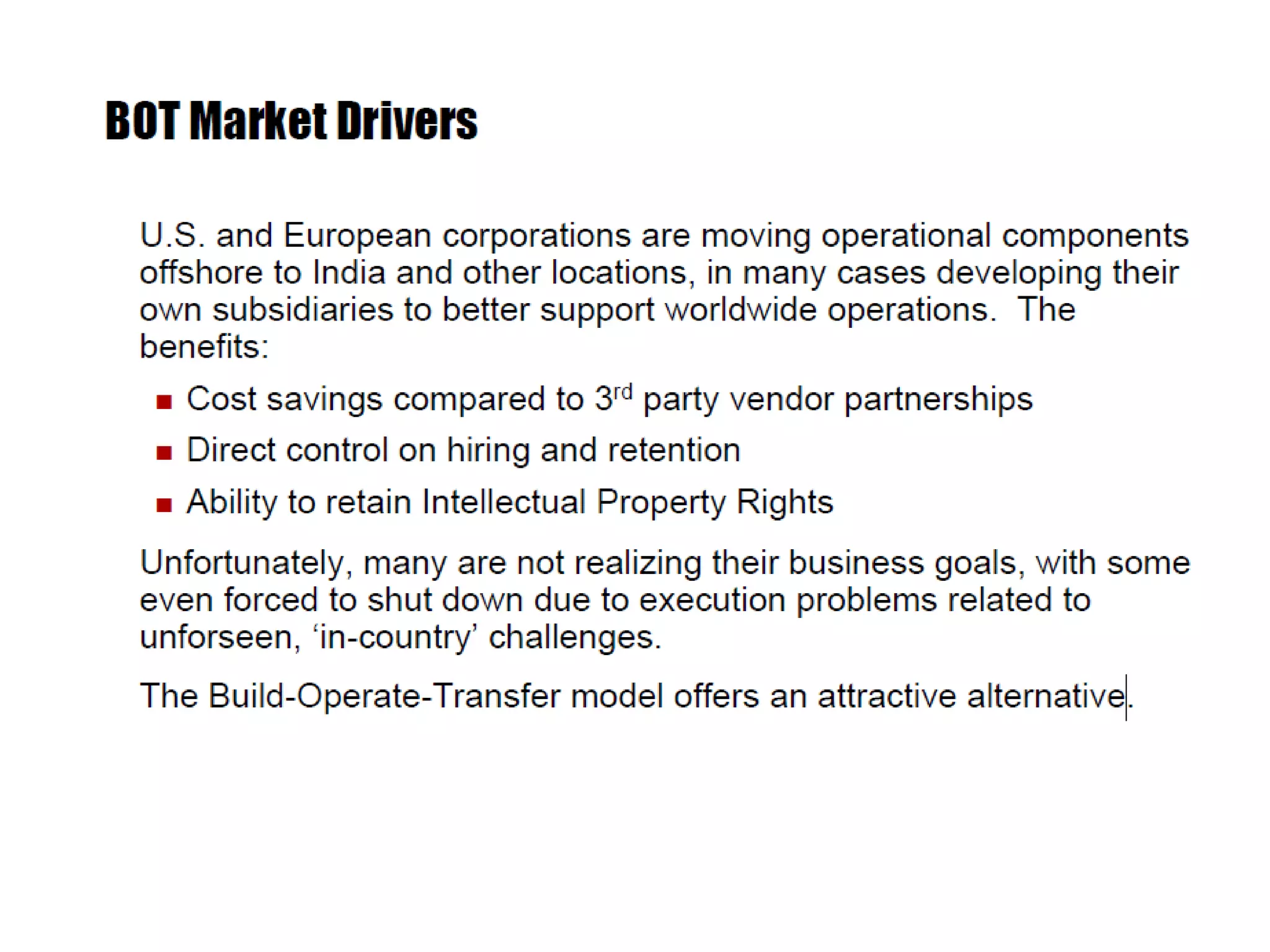

  • 5. BOT Benefits • BOT offers attractive business benefits over the traditional offshore subsidiary path, including: • Rapid scaling of operations • Wider service offerings, quickly filling business model gaps • Lower infrastructure set-up costs • Reduced time to operations through utilization of knowledgeable 3rd • party management resources responsible for: • Real Estate • Government rules and regulations • Cultural transition • IT infrastructure procurement • Security
  • 6. BOT PROJECTS • A BOT Project (build operate transfer project) is typically used to develop a discrete asset rather than a whole network and is generally entirely new or greenfield in nature (although refurbishment may be involved). In a BOT Project the project company or operator generally obtains its revenues through a fee charged to the utility/ government rather than tariffs charged to consumers. A number of projects are called concessions, such as toll road projects, which are new build and have a number of similarities to BOTs. In general, a project is financially viable for the private entity if the revenues generated by the project cover its cost and provide sufficient return on investment. On the other hand, the viability of the project for the host government depends on its efficiency in comparison with the economics of financing the project with public funds. Even if the host government could borrow money on better conditions compared to that of the public sector, other factors could offset this particular advantage. For example, the expertise and efficiency that the private entity is expected to bring as well as the risk transfer. Therefore the private entity bears a substantial part of the risk
  • 7. VARIOUS RISKS • POLITICAL RISK especially in the developing countries because of the possibility of dramatic overnight political change. • TECHNICAL RISK construction difficulties, for example unforeseen soil conditions, breakdown of equipment. • Financing risk foreign exchange rate risk and interest rate fluctuation, market risk (change in the price of raw materials), income risk (over-optimistic cash-flow forecasts), cost overrun risk
  • 8. Case Study 1: Delhi Gurgaon Expressway
  • 9. • The National Highways Authority of India (NHAI), under the Ministry of Road Transport & Highways, was entrusted the responsibility for implementation of the Golden Quadrilatera project (Highway Project connecting the four metro cities of New Delhi, Mumbai, Chennai and Kolkata). • As a part of this project, it proposed the conversion of a very busy section of NH-8 connecting Delhi to Gurgaon into a 6/8 lane access controlled divided carriageway. • The project was awarded to the consortium of Jaypee Industries and DS Construction Ltd to design, finance, construct, operate and maintain the facility for a concession period of 20 years. • The Concessionaire is allowed to collect toll from the users of the project facility during the operation period to recover his investment and the expressway is required to be transferred back to the Government at the end of the concession period. • This was the first BOT project in India to have been awarded on negative grant basis where in the concessionaire offered to pay an upfront fee to NHAI in return of the concession as agains a capital grant from the Government. • The expressway was commissioned in January 2008 after much delay primarily owing to issues in Land acquisition and changes in the scope of work. 1.1 Project Description
  • 10. 1.2 PPP structure of the Project • The project was awarded to the consortium of Jaiprakash Industries Ltd and DS Construction Ltd on Built-Operate-Transfer (BOT) basis for a period of 20 years. • The selected concessionaire offered to pay 61.06 crore upfront as negative grant to the NHAI. • The Concessionaire was required to design, construct, operate and maintain the expressway in accordance with the specifications as approved by NHAI. • A Special Purpose Vehicle called the Delhi Gurgaon Super Connectivity Ltd (formerly Jaypee DSC Ventures Ltd.), was created for execution of the project. • The SPV entered into a fixed time-fixed price Engineering, Procurement & Construction (EPC) contract with DS Constructions Limited for this project.
  • 11. 1.3 Current Status • The expressway has been operational for 5 years now after it was opened to traffic in January 2008. • It carries more than 180,000 PCUs per day, which is much higher than the traffic estimates for the project by 13,000 to 15,000 PCUs per day. • The substantially higher number of vehicles using the facility has often led to a queuing up of vehicles at the toll plazas. • The expressway consists of 9 flyovers, 4 underpasses and 2 foot-over bridges and 3 toll-plazas. • Smart tags have been introduced to enable cashless automatic payment. 1.4 Financing Information The funding for the project at the time of financial closure (9 May 2003) is provided below: • Particulars Amount 1. Debt 383.3 crore 2. Equity 164.2 crore 3. TOTAL 547.5 crore
  • 12. 1.5 Process Analysis 1. Inception: • The plan for an expressway connecting Gurgaon and Delhi was initiated in the late 1990s and a detailed project report was prepared for the same. • Golden Quadrilateral project, as traffic intensity on these corridors had increased manifold which hampered safe and efficient movement of vehicles. • Accordingly, NHAI decided to upgrade the section of NH-8 connecting Delhi and Gurgaon into 8/6 lane access controlled expressway as it was the busiest part of the highway. • It was estimated that the expressway would reduce the travel time between the Delhi and Gurgaon from about 65 minutes to around 20 minutes. • NHAI was finding itself constrained to fund the estimated Rs 555 Crore for the expressway. • Malaysia’s Construction Industry Development Board (CIDB) was initially proposed to take up this project under the memorandum of understanding (MoU) route as a part of a government to government initiative. • However, this proposal sought a grant of Rs120 crore from NHAI and was thus rejected. • The Government of India, at the time, was keen to promote public private partnership (PPP) in viable expressway projects to attract funding and capitalize on private sector efficiency. • It was therefore decided to undertake the project on BOT (Build-operate-Transfer) basis. • NHAI used the Detailed Project Report prepared in 1998 for the traffic projections for this project.
  • 13. 2.Procurement • The MoRT&H invited pre-qualification bids in 2001. • The project was initially envisaged to require a capital grant to be paid by NHAI to the successful bidder towards the cost of construction for enhancing the viability of the highway project. • However, considering the robust traffic projections,bids were received with negative grants. • In April 2002, the consortium of Jaiprakash Industries and DS Constructions was declared the successful bidder. • RBM Malaysia, which was the L2 bidder, had quoted Rs 55 crore as the negative grant. • Other bidders were Gamuda Malaysia, IJM Malaysia and Larsen & Toubro (L&T). 3.Development • The erstwhile Jaypee DSC Ventures Ltd. (now known as Delhi Gurgaon Super Connectivity Ltd.),the SPV incorporated by the Concessionaire for the project, achieved financial closure in May 2003. • The construction of the expressway commenced in January 2003. • In June 2004, Jaiprakash Industries, despite being the lead promoter, sold its stake to DS Constructions and retained only 1.2%. • The project development, however, soon ran into issues over approvals, land acquisition and additions to the scope of work which was largely due to the physical setting of the project highway.
  • 14. 4.Delivery The project was commissioned on 25 January, 2008. The expressway is fully operational and is handling a significant traffic volume of more than 180,000 PCUs per day, growing at 9% year-on- year. 5.Exit The concession period is for 20 years and the projected end date is 11 January 2023 when the expressway will be handed over to the government. 1.6 Post facto VfM analysis One of the limitations to this analysis is the lack of access to the feasibility report for the project with which to draw quantitative comparisons. Secondly, the expressway has been in operation for only two years, thus limiting the possible analysis of efficiencies during the operations period. Therefore, an assessment of potential benefits achieved by the Concessionaire based on publicly available information has been attempted.
  • 15. Efficiencies Achieved: Particulars Earlier Now • Average Travel Speed 25.65Km/Hr 66 Km/Hr • Average Travel Time from Delhi to Gurgaon 65 Minutes 25 minutes • Capacity • (in terms of lanes) 6 Lane – 5 km- 8 Lane - 22.3 Km 4 lane -22.7km 6 Lane - 5.4 km • Intersections 20 Intersections 10 Grade Separated Intersections
  • 16. Case Study : Vadodar Halol Toll Road Project
  • 17. VHTR was an initiative commissioned as a part of the Vision 2010 – an infrastructure master plan developed by the Government of Gujarat (GoG). The project involved widening and strengthening of 32 km of the existing two-lane State Highway (SH 87) connecting Vadodara to the industrial town of Halol into a four-lane tolled expressway. The underlying principle of the vision was to develop infrastructure projects in Gujarat by attracting private sector participation.
  • 18.  The Roads and Buildings Department (R&B), GoG and Infrastructure Leasing and Financial Services (IL&FS) signed a Memorandum of Agreement (MoA) to this effect on 31st October 1995.  A special purpose vehicle (SPV) was constituted for this purpose named the Vadodara Halol Toll Road Company Limited (VHTRL)  The construction of VHTR commenced on 1st March 1999 and completed on 15th September 2000.  The toll operations commenced on 24th October 2000. VHTRL manages, operates and maintains the road for 30 years starting from 2000.
  • 19.  It entered into a concession agreement with GoG to design, finance, build, operate, maintain, and transfer the facility after recovery of a predetermined return. Construction  included the design and completion of the road, pavement, cross drainage system, bridges, toll facilities, medians, separators, road furniture, and horticultural aspects. Management, operation and maintenance  toll collection, operating the toll plaza, traffic regulation and maintenance of the facility , special maintenance activities such as eliminating potholes in the pavements,  The concession is for a period of 30 years
  • 20. In case VHTRL is unable to recover the total cost of the project, including a 20% return, within 30 years from the date of operation, the concession period shall, at the request of VHTRL, without qualification be extended by GoG for a period of two years at a time until the total project cost and returns have been recovered by VHTRL The land for the project is leased to VHTRL by GoG through a lease agreement between the parties.
  • 21. Project operational since 2000 But the traffic on road not I line with the expected traffic levels the financial condition of VHTRL started deteriorating was unable to service its debt obligations.
  • 22. Financing Information The cost of the project was 161 crores. construction cost accounted 119 crores. Equity of ` 67.9 crores was raised from GoG IL&FS also raised debt of ` 93.2 crores through various Indian financial institutions including Industrial Development Bank of India,
  • 23.
  • 24. Post facto VfM analysis:  first projects being executed through a public private partnership framework which not only exposed the state government machinery to a new development paradigm but also paved way for a large number of future projects being executed through the PPP framework. created a platform for private developers to participate in infrastructure building in the country. It was completed within the 18months as was stipulated in the contracting arrangement The original estimated cost of the project was approximately 175 crores. The actual landed cost of the project was 160 crores. Hence both time and money effective and efficient
  • 25. Key Learning and Observations Pre-development market assessment is critical : more robust, For instance, the traffic estimations for the project were based on the assumptions that the industrial incentives available for the area would continue for long-term. Eventually, with time the incentives were withdrawn and the traffic was almost 50% lower than the projected traffic. Such unaccounted risk factors can jeopardize the project and lead to significant losses.
  • 26. Competitive bidding can ensure a “better deal” extremely critical VHTR was developed through a MoA between the GoG and IL&FS and did not create adequate competitive tension since there were no precedents that were available to develop such a structure. Need to create a balanced risk return profile: The risk return profile of the project was skewed in favour of the private developer. For instance, the concession agreement ensured that the private developer earned toll revenues till he was able to achieve a return of 20% on the overall investment.
  • 27. Environmentally and Socially responsive development framework: was the first project that introduced Environmental and Social Safeguards measures as part of the contractual obligation of the developer. This created a benchmark and had immense demonstration value since it highlighted that infrastructure can be developed in an environmentally and socially responsible manner.
