Prepared by:
Abdul Aziz Abas
Nur Ilylia Iryani Mohamed Nasir
Anis Mardhiah Mukhtar
Nor Yatini Isa
Contents
Introduction
Benefits of BIM
Barriers of BIM Implementation
Case Study: BIM Implementation in Kwasaland
Case Study: Strategies to overcome the barriers
Conclusion & Recommendations
Introduction

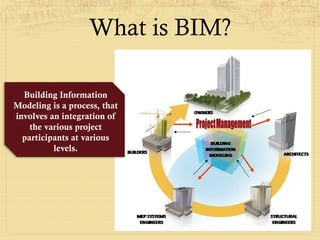

Building Information
Modeling is a process, that
involves an integration of
the various project
participants at various
levels.

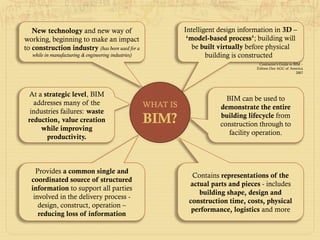

What is BIM?

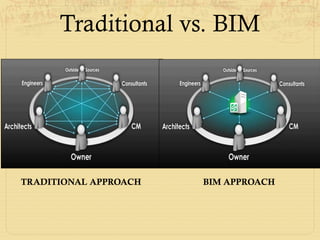

BIM APPROACH
TRADITIONAL APPROACH
Traditional vs. BIM

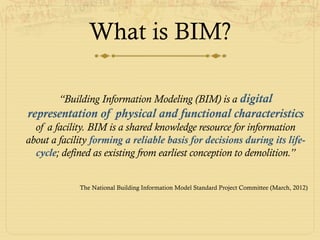

What is BIM?
“Building Information Modeling (BIM) is a digital
representation of physical and functional characteristics
of a facility. BIM is a shared knowledge resource for information
about a facility forming a reliable basis for decisions during its life-
cycle; defined as existing from earliest conception to demolition.”
The National Building Information Model Standard Project Committee (March, 2012)
minimizes
risk and
promote
quality
Staub-French & Khanzode (2007)

3D & 4D
Modeling
BIM
will be accepted
as industry copes
with realities of
tight labor market
minimizes
risk and
promotes
quality
• eliminate field
interferences
• less rework
• increased productivity
• fewer RFI
• fewer change orders
• less cost growth
• decrease construction to
facility turnover
BIM – PROJECT LIFE CYCLE
Intelligent design information in 3D –
‘model-based process’; building will
be built virtually before physical
building is constructed
Contractor’s Guide to BIM –
Edition One AGC of America
2007
New technology and new way of
working, beginning to make an impact
to construction industry (has been used for a
while in manufacturing & engineering industries)
At a strategic level, BIM
addresses many of the
industries failures: waste
reduction, value creation
while improving
productivity.
Provides a common single and
coordinated source of structured
information to support all parties
involved in the delivery process -
design, construct, operation –
reducing loss of information
BIM can be used to
demonstrate the entire
building lifecycle from
construction through to
facility operation.
Contains representations of the
actual parts and pieces - includes
building shape, design and
construction time, costs, physical
performance, logistics and more

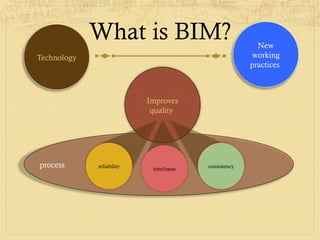

WHAT IS
BIM?
New
working
practices
Technology
Quality
Improves
quality
process reliability timeliness consistency
What is BIM?
Lack of project co-ordination
Time & Cost
over-runs
Manual bill of quantities or no
integration
No accuracy in Job
Costing & Budgeting
Not feasible to integrate with
facility management applications
and preventive, corrective
maintenance
Further investment
needed for data
procurement &
incurring cost per year

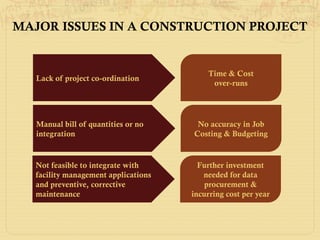

MAJOR ISSUES IN A CONSTRUCTION PROJECT

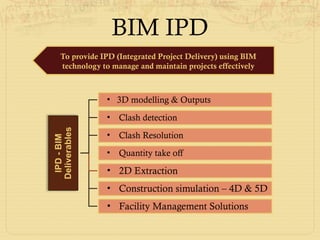

IPD
-
BIM

Deliverables
• 3D modelling & Outputs
• Clash detection
• Clash Resolution

• Quantity take off
• 2D Extraction
• Construction simulation – 4D & 5D
• Facility Management Solutions
To provide IPD (Integrated Project Delivery) using BIM
technology to manage and maintain projects effectively
BIM IPD
Construction Simulation
Video
Benefits of BIM
1. Better outcomes through collaboration

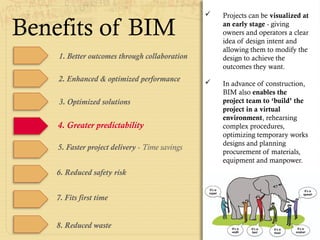

4. Greater predictability
5. Faster project delivery - Time savings
6. Reduced safety risk
7. Fits first time
8. Reduced waste

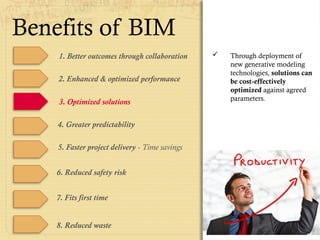

Benefits of BIM
2. Enhanced & optimized performance
3. Optimized solutions
1. Better outcomes through collaboration
2. Enhanced & optimized performance
3. Optimized solutions
4. Greater predictability
5. Faster project delivery - Time savings
6. Reduced safety risk
7. Fits first time
8. Reduced waste
Benefits of BIM
 All project partners – uses a
single, shared 3D model,
cultivating collaborative
working relationships.
 This ensures everyone is
focused on achieving best
value, from project inception
to eventual decommissioning.

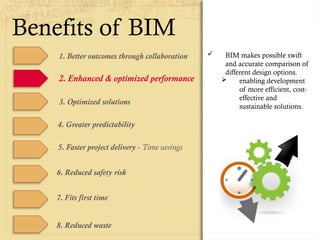

1. Better outcomes through collaboration
2. Enhanced & optimized performance
 BIM makes possible swift
and accurate comparison of
different design options.
 enabling development
of more efficient, cost-
effective and
sustainable solutions.
3. Optimized solutions
4. Greater predictability
5. Faster project delivery - Time savings
6. Reduced safety risk
7. Fits first time
8. Reduced waste
Benefits of BIM
Benefits of BIM
1. Better outcomes through collaboration
4. Greater predictability
5. Faster project delivery - Time savings
6. Reduced safety risk
7. Fits first time
8. Reduced waste
 Through deployment of
new generative modeling
technologies, solutions can
be cost-effectively
optimized against agreed
parameters.
2. Enhanced & optimized performance
3. Optimized solutions
4. Greater predictability
5. Faster project delivery - Time savings
6. Reduced safety risk
7. Fits first time
8. Reduced waste
 Projects can be visualized at
an early stage - giving
owners and operators a clear
idea of design intent and
allowing them to modify the
design to achieve the
outcomes they want.
 In advance of construction,
BIM also enables the
project team to ‘build’ the
project in a virtual
environment, rehearsing
complex procedures,
optimizing temporary works
designs and planning
procurement of materials,
equipment and manpower.
2. Enhanced & optimized performance
3. Optimized solutions
1. Better outcomes through collaboration
Benefits of BIM
Benefits of BIM
4. Greater predictability
5. Faster project delivery - Time savings
6. Reduced safety risk
7. Fits first time
8. Reduced waste
 Agreeing the design concept
early in project development
to eliminate late stage design
changes;
 Using standard design
elements when practicable;
 Resolving complex
construction details before the
project goes on site;
 Avoiding clashes;
 Taking advantage of
intelligence and automation
within the model to check
design integrity and estimate
quantities;
 Producing fabrication and
construction drawings from
the model; and
 Using data to control
construction equipment.
2. Enhanced & optimized performance
3. Optimized solutions
1. Better outcomes through collaboration
Benefits of BIM
4. Greater predictability
5. Faster project delivery - Time savings
6. Reduced safety risk
7. Fits first time
8. Reduced waste
 Crowd behavior and fire
modeling capability enable
designs to be optimized for
public safety.
 Asset managers can use
the 3D model to enhance
operational safety.
 Contractors can minimize
construction risks by
reviewing complex details
or procedures before going
on site.
2. Enhanced & optimized performance
3. Optimized solutions
1. Better outcomes through collaboration
Benefits of BIM
4. Greater predictability
5. Faster project delivery - Time savings
6. Reduced safety risk
7. Fits first time
8. Reduced waste
 Integrating multidisciplinary
design inputs using a single
3D model allows
 interface issues to be
identified and resolved in
advance of construction
 eliminating the cost and
time impacts of
redesign.
 The model also enables new
and existing assets to be
integrated seamlessly.
2. Enhanced & optimized performance
3. Optimized solutions
1. Better outcomes through collaboration
Benefits of BIM
4. Greater predictability
5. Faster project delivery - Time savings
6. Reduced safety risk
7. Fits first time
8. Reduced waste
 Exact quantity take-offs mean
that materials are not over-
ordered.
 Precise programme
scheduling enables just-in-
time delivery of materials and
equipment, reducing potential
for damage.
 Use of BIM for automated
fabrication of equipment and
components enables more
efficient materials handling
and waste recovery.
2. Enhanced & optimized performance
3. Optimized solutions
1. Better outcomes through collaboration
Five Top-Rated Positive

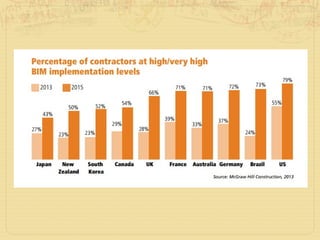

Impacts of BIM
Metrics for the Impact of BIM on Cost.
Schedule, RFIs and Safety
BIM : RETURN ON INVESTMENT
Respondent
Type
% Rating
High or Very
High
Improved
Constructability of Final
Design
Contractors 74%
Increased Owner’s
Understanding of
Proposed Design
Solutions
Owners 73%
Improved Quality /
Function of Final Design
Engineers 71%
Generated Better
Construction
Documents
Owners 70%
Improved Ability to Plan
Construction Phasing
and Logistics
Owners 70%
Source : Dodge Data & Analytics – Smart Market Report
Published on 2015 in Associate with Building Smart Alliance

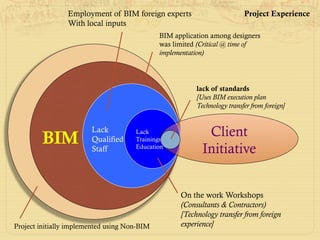

Barriers of BIM Implementation

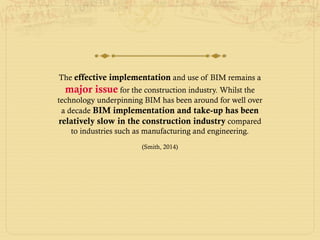

The effective implementation and use of BIM remains a
major issue for the construction industry. Whilst the
technology underpinning BIM has been around for well over
a decade BIM implementation and take-up has been
relatively slow in the construction industry compared
to industries such as manufacturing and engineering.
(Smith, 2014)

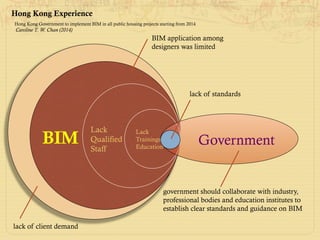

lack of client demand
BIM
BIM application among
designers was limited
Lack
Qualified
Staff
Caroline T. W. Chan (2014)
Hong Kong Experience
Lack
Trainings
Education
government should collaborate with industry,
professional bodies and education institutes to
establish clear standards and guidance on BIM
Government
Hong Kong Government to implement BIM in all public housing projects starting from 2014
lack of standards

1. High cost to implement BIM
2. IT availability (software, hardware,
computer)
3. Require Time for training and
implementing BIM
4. Readiness organization to change
5. Lack of knowledge in BIM
6. New technology require expertise and
training.
7. Lack of information about benefits of BIM
(Ismail, 2014)
Malaysia Context
Barriers of BIM implementation
(IEM, 2014)
Malaysia Context
Barriers of BIM implementation

Case Study

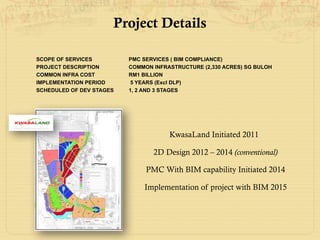

Project Details
SCOPE OF SERVICES PMC SERVICES ( BIM COMPLIANCE)
PROJECT DESCRIPTION COMMON INFRASTRUCTURE (2,330 ACRES) SG BULOH
COMMON INFRA COST RM1 BILLION
IMPLEMENTATION PERIOD 5 YEARS (Excl DLP)
SCHEDULED OF DEV STAGES 1, 2 AND 3 STAGES
PMC With BIM capability Initiated 2014
Implementation of project with BIM 2015
KwasaLand Initiated 2011
2D Design 2012 – 2014 (conventional)
LTSAAS
SUBANG BISTARI DEVELOPMENT
KOTA DAMANSARA DEVELOPMENT
SUBANG PERDANA
SG BULOH
DAMANSARA
Jln Sg Buloh – Shah Alam
North-South Highway
Location Plan
ARA
DAMANSARA
Jln Subang
To Ipoh
To JB
To Airport
To Shah Alam
N
KWASA DAMANSARA DEVELOPMENT
2,320Ac

1. Secretary
2. Clerk / Doc Controller
F/T
Const. Eng. (C&S)
TBN
F/T
Const. Eng. (M&E)
TBN
F/T
Arch. Manager
TBN
F/T
Project Director
TBN
TBN
Construction
Management
Design
Management
Overall
Management
3rd
Party Works
1. Soil Investigation
2. Topographical
survey
KWASA LAND
Specialist Consultant
PMC
1. Planner
2. Cost Manager
3. QA/QC &
Manager
4. EIA / EMP
5. GBI
6. Infra. Engineer
7. Structure Engineer
8. Geotech Engineer
9. M&E Engineer
10. Interface / Integrated
Head Office Support
Project Manager
Construction Manager
Civil / Structure / Arch
F/T
BIM Manager (Interface)
TBN
Landscape
TBN TBN
Contracts Manager
TBN
Cost Manager / QS
Planning Control
Management
Doc Control
TBN
Planning Manager
TBN
Scheduler
TBN
Contracts
Management
TBN
Quality
Manager
Technical
Management
Sr. Engineers & Sub - Professional Support
Civil
Manager
TBN
Electrical
TBN
TBN
Geotechnical
Despatch
Secretary / Clerk
Document Controller
Engineering
TBN
TBN
L’scape Manager
Mechanical
TBN
Asst. Project Manager (M&E)
F/T
Interface Management
With BIM
TBN
F/T
TBN
Asst. Project Manager (C&S)
F/T
ORGANISATION
CHART
M&E Manager
TBN
Infrastructures
TBN
Structural
BIM Manager
TBN
F/T
Project Aim
The development carries the promise of a sustainable community township that focuses
on 4 Key Components: Green Township, Connectivity, Inclusivity and Regional
Commercial Centre.
BIMs are ultimately developed to operate the facility after construction completion.
The models will be utilized during the construction stage to monitor;
• work progress
• identify conflicts prior to construction
• manage logistics
Project initially implemented using Non-BIM
BIM
BIM application among designers
was limited (Critical @ time of
implementation)
Lack
Qualified
Staff
Lack
Trainings
Education
Client
Initiative
lack of standards
[Uses BIM execution plan
Technology transfer from foreign]
On the work Workshops
(Consultants & Contractors)
[Technology transfer from foreign
experience]
Employment of BIM foreign experts
With local inputs
Project Experience
Design Coordination: Using Clash
Detection software during
coordination process to determine
field conflicts by comparing 3D
models of building systems.
Design Authoring: BIM software is
used to incorporate design intent
input documentation, metadata and
other requirements and translating
them into a comprehensive BIM.
As-Built Modeling: A
process used to depict an
accurate representation of
the actual condition of the
Building in BIM
Site Utilization Planning:
Using construction
simulation based modeling
to represent both
permanent and temporary
facilities on site and related
construction activities
4D Modeling: Using 4D
modeling (3D models with
added dimension of time)
to effectively plan phased
occupancy in a
renovation, retrofit,
addition, or to show the
construction sequence and
space requirements on a
building site.
Existing Conditions Modeling: Project team
develops BIM to reflect existing conditions on site,
including location of facilities, graded levels etc.
BIM
uses in
Kwasaland
Project

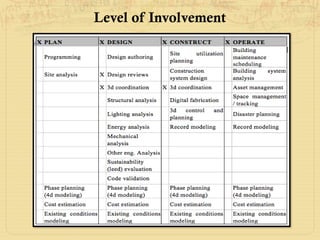

Level of Involvement
Interacts on a regular basis to assess various BIM processes and deliverables

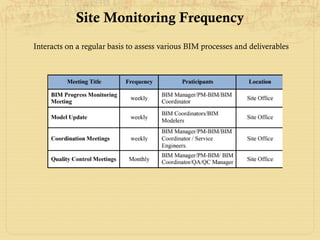

Site Monitoring Frequency
Construction
Simulation (based on
contractors approved
programme)
2D Design
Drawings
from Client
3D Modelling
Clash
Analysis &
Detection
Produce Clash
Reports to Identify/
Specify all Clashes
Resolve all Clashes
Deliverable 1
Deliverable 2
Deliverable 3
3D Design
Drawings
from Client
BIM
Coordination
With
Consultants
A
B
Deliverable 4
Construction
Phase
Deliverable 5 FM
Management
As Built
Model
BIM Process Flow

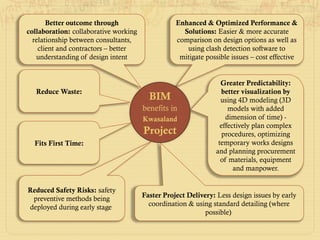

Enhanced & Optimized Performance &
Solutions: Easier & more accurate
comparison on design options as well as
using clash detection software to
mitigate possible issues – cost effective
Better outcome through
collaboration: collaborative working
relationship between consultants,
client and contractors – better
understanding of design intent
Fits First Time:
Reduced Safety Risks: safety
preventive methods being
deployed during early stage
Greater Predictability:
better visualization by
using 4D modeling (3D
models with added
dimension of time) -
effectively plan complex
procedures, optimizing
temporary works designs
and planning procurement
of materials, equipment
and manpower.
Faster Project Delivery: Less design issues by early
coordination & using standard detailing (where
possible)
BIM
benefits in
Kwasaland
Project
Reduce Waste:
CLASH COORDINATION

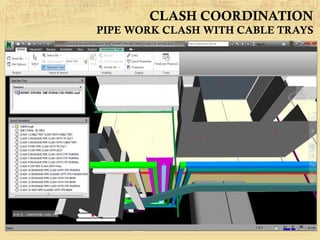

PIPE WORK CLASH WITH CABLE TRAYS
CLASH COORDINATION
DRAINAGE CLASH WITH STRUCTURAL SLAB
CLASH COORDINATION

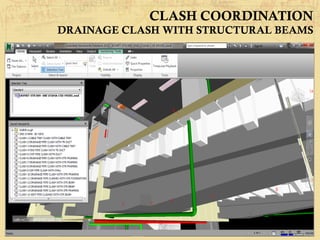

DRAINAGE CLASH WITH STRUCTURAL BEAMS
CLASH COORDINATION
DRAINAGE CLASH WITH PILE CAP FOUNDATION

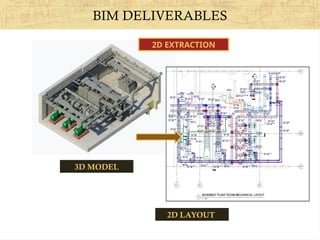

BIM DELIVERABLES
2D EXTRACTION
3D MODEL
2D LAYOUT
QUANTITY TAKE-OFF
CROSS REFERENCE
BOQ
Raft Slab Concrete Quantities
BIM DELIVERABLES
BIM DELIVERABLES
INTEGRATION WITH FM
TOOLS

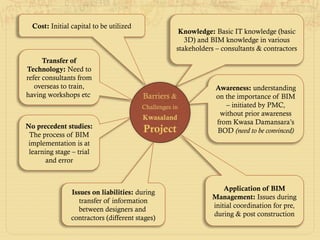

Knowledge: Basic IT knowledge (basic
3D) and BIM knowledge in various
stakeholders – consultants & contractors
Cost: Initial capital to be utilized
No precedent studies:
The process of BIM
implementation is at
learning stage – trial
and error
Issues on liabilities: during
transfer of information
between designers and
contractors (different stages)
Awareness: understanding
on the importance of BIM
– initiated by PMC,
without prior awareness
from Kwasa Damansara’s
BOD (need to be convinced)
Application of BIM
Management: Issues during
initial coordination for pre,
during & post construction
Barriers &
Challenges in
Kwasaland
Project
Transfer of
Technology: Need to
refer consultants from
overseas to train,
having workshops etc
Case Study:
Strategies to Overcome Barriers
(IEM, 2014)
Malaysia Context – Steps to increase pace of BIM
The Main Question is HOW?
CHANGE
MANAGEMENT
Change Management
 The set of tools, processes, skills and
principles for managing the people
side of change to achieve the required
outcomes of the project or initiative.
 Strategic change become necessary when
opportunities or threats arise in the
following main areas:
 Environment
 Diversification
 Technology
 People
People in Change Management
Organization
Team
Me
• How does change impact people
across the organization?
• How do we make this work for
all of us?
• How does each one show up
(Acceptance, fear, anger,
resistance)
• What can I do to help them
cope?
• How do I show up?
• Can I cope?
• What do I need to help me
cope?
C
H
A
N
G
E
A
G
E
N
T
Change Management
Strategy Tools
Situationa
l
Awareness
• Understand the change and who is
impacted. i.e : Change characteristics,
impacted group, organizational attributes
Supportin
g
Structures
• Team and sponsor structures
Strategy
Analysis
• Risk, resistance and
special tactic
 Formulating the
change
management
strategy is the first
critical step in
implementing a
change management
methodology.
 The strategy provide
direction and
results in
informed decision
making throughout
the change process.
 A well formulated
strategy really brings
the project or change
to life, describing who
and how it will
impact the
organization.
Change Management Process
UNFREEZING CHANGING REFREEZING
LEWIN’s
Change
Management
Model
Make sure the change
stick as part of the new
routine
Kotter’s 8 Steps Change
Management Model

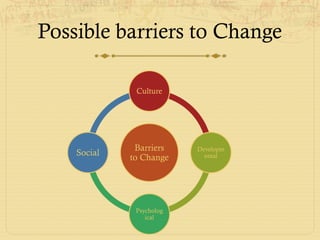

Possible barriers to Change
Barriers
to Change
Culture
Developm
ental
Psycholog
ical
Social
Evaluation of a Change Strategy
Determine
objectives
Describe Objectives
Measure effects
Establish baseline
points
Control Extraneous
factors
Detect
unanticipated
consequences
Strategies to overcome the barriers
Change Agent PMC
Establish Urgency Powerful Coalition Remove Obstacles Create Vision
Communicate Vision Create Quick Wins Build on the Change Make it Stick
• Importance of
coordinating for
FM
• Request from the
client
• PMC initiated
coalition between
consultants,
specialists and
contractors
• Create awareness
in BIM
implementation
• Training given to
stakeholders (staff,
contractors, clients, LA)
• Highlighting
advantages of
BIM (time, cost,
quality)
• Consistent
monitoring –
meeting & updates
to obtain similar
goals
• Establish sequence
• Visualization prior
to implementation
(at different stages)
• Trial and error –
learning curve
• Practice makes
perfect
• Continuous
improvements
Conclusion & Recommendations
Conclusion
• BIM is an important management tool in mitigating most
construction issues
• BIM is seen to be a technology that might be mandatory
implementation in the construction industry in Malaysia
Thank you

BIM Assignment Presentation BIM Assignment Presentation BIM Assignment Presentation

  • 1.
    Prepared by: Abdul AzizAbas Nur Ilylia Iryani Mohamed Nasir Anis Mardhiah Mukhtar Nor Yatini Isa
  • 2.
    Contents Introduction Benefits of BIM Barriersof BIM Implementation Case Study: BIM Implementation in Kwasaland Case Study: Strategies to overcome the barriers Conclusion & Recommendations
  • 3.
  • 5.
    Building Information Modeling isa process, that involves an integration of the various project participants at various levels. What is BIM?
  • 6.
  • 7.
    What is BIM? “BuildingInformation Modeling (BIM) is a digital representation of physical and functional characteristics of a facility. BIM is a shared knowledge resource for information about a facility forming a reliable basis for decisions during its life- cycle; defined as existing from earliest conception to demolition.” The National Building Information Model Standard Project Committee (March, 2012)
  • 8.
    minimizes risk and promote quality Staub-French &Khanzode (2007) 3D & 4D Modeling BIM will be accepted as industry copes with realities of tight labor market minimizes risk and promotes quality • eliminate field interferences • less rework • increased productivity • fewer RFI • fewer change orders • less cost growth • decrease construction to facility turnover
  • 9.
    BIM – PROJECTLIFE CYCLE
  • 10.
    Intelligent design informationin 3D – ‘model-based process’; building will be built virtually before physical building is constructed Contractor’s Guide to BIM – Edition One AGC of America 2007 New technology and new way of working, beginning to make an impact to construction industry (has been used for a while in manufacturing & engineering industries) At a strategic level, BIM addresses many of the industries failures: waste reduction, value creation while improving productivity. Provides a common single and coordinated source of structured information to support all parties involved in the delivery process - design, construct, operation – reducing loss of information BIM can be used to demonstrate the entire building lifecycle from construction through to facility operation. Contains representations of the actual parts and pieces - includes building shape, design and construction time, costs, physical performance, logistics and more WHAT IS BIM?
  • 11.
  • 12.
    Lack of projectco-ordination Time & Cost over-runs Manual bill of quantities or no integration No accuracy in Job Costing & Budgeting Not feasible to integrate with facility management applications and preventive, corrective maintenance Further investment needed for data procurement & incurring cost per year MAJOR ISSUES IN A CONSTRUCTION PROJECT
  • 13.
    IPD - BIM Deliverables • 3D modelling& Outputs • Clash detection • Clash Resolution • Quantity take off • 2D Extraction • Construction simulation – 4D & 5D • Facility Management Solutions To provide IPD (Integrated Project Delivery) using BIM technology to manage and maintain projects effectively BIM IPD
  • 14.
  • 15.
  • 16.
    1. Better outcomesthrough collaboration 4. Greater predictability 5. Faster project delivery - Time savings 6. Reduced safety risk 7. Fits first time 8. Reduced waste Benefits of BIM 2. Enhanced & optimized performance 3. Optimized solutions
  • 17.
    1. Better outcomesthrough collaboration 2. Enhanced & optimized performance 3. Optimized solutions 4. Greater predictability 5. Faster project delivery - Time savings 6. Reduced safety risk 7. Fits first time 8. Reduced waste Benefits of BIM  All project partners – uses a single, shared 3D model, cultivating collaborative working relationships.  This ensures everyone is focused on achieving best value, from project inception to eventual decommissioning.
  • 18.
    1. Better outcomesthrough collaboration 2. Enhanced & optimized performance  BIM makes possible swift and accurate comparison of different design options.  enabling development of more efficient, cost- effective and sustainable solutions. 3. Optimized solutions 4. Greater predictability 5. Faster project delivery - Time savings 6. Reduced safety risk 7. Fits first time 8. Reduced waste Benefits of BIM
  • 19.
    Benefits of BIM 1.Better outcomes through collaboration 4. Greater predictability 5. Faster project delivery - Time savings 6. Reduced safety risk 7. Fits first time 8. Reduced waste  Through deployment of new generative modeling technologies, solutions can be cost-effectively optimized against agreed parameters. 2. Enhanced & optimized performance 3. Optimized solutions
  • 20.
    4. Greater predictability 5.Faster project delivery - Time savings 6. Reduced safety risk 7. Fits first time 8. Reduced waste  Projects can be visualized at an early stage - giving owners and operators a clear idea of design intent and allowing them to modify the design to achieve the outcomes they want.  In advance of construction, BIM also enables the project team to ‘build’ the project in a virtual environment, rehearsing complex procedures, optimizing temporary works designs and planning procurement of materials, equipment and manpower. 2. Enhanced & optimized performance 3. Optimized solutions 1. Better outcomes through collaboration Benefits of BIM
  • 21.
    Benefits of BIM 4.Greater predictability 5. Faster project delivery - Time savings 6. Reduced safety risk 7. Fits first time 8. Reduced waste  Agreeing the design concept early in project development to eliminate late stage design changes;  Using standard design elements when practicable;  Resolving complex construction details before the project goes on site;  Avoiding clashes;  Taking advantage of intelligence and automation within the model to check design integrity and estimate quantities;  Producing fabrication and construction drawings from the model; and  Using data to control construction equipment. 2. Enhanced & optimized performance 3. Optimized solutions 1. Better outcomes through collaboration
  • 22.
    Benefits of BIM 4.Greater predictability 5. Faster project delivery - Time savings 6. Reduced safety risk 7. Fits first time 8. Reduced waste  Crowd behavior and fire modeling capability enable designs to be optimized for public safety.  Asset managers can use the 3D model to enhance operational safety.  Contractors can minimize construction risks by reviewing complex details or procedures before going on site. 2. Enhanced & optimized performance 3. Optimized solutions 1. Better outcomes through collaboration
  • 23.
    Benefits of BIM 4.Greater predictability 5. Faster project delivery - Time savings 6. Reduced safety risk 7. Fits first time 8. Reduced waste  Integrating multidisciplinary design inputs using a single 3D model allows  interface issues to be identified and resolved in advance of construction  eliminating the cost and time impacts of redesign.  The model also enables new and existing assets to be integrated seamlessly. 2. Enhanced & optimized performance 3. Optimized solutions 1. Better outcomes through collaboration
  • 24.
    Benefits of BIM 4.Greater predictability 5. Faster project delivery - Time savings 6. Reduced safety risk 7. Fits first time 8. Reduced waste  Exact quantity take-offs mean that materials are not over- ordered.  Precise programme scheduling enables just-in- time delivery of materials and equipment, reducing potential for damage.  Use of BIM for automated fabrication of equipment and components enables more efficient materials handling and waste recovery. 2. Enhanced & optimized performance 3. Optimized solutions 1. Better outcomes through collaboration
  • 25.
    Five Top-Rated Positive Impactsof BIM Metrics for the Impact of BIM on Cost. Schedule, RFIs and Safety BIM : RETURN ON INVESTMENT Respondent Type % Rating High or Very High Improved Constructability of Final Design Contractors 74% Increased Owner’s Understanding of Proposed Design Solutions Owners 73% Improved Quality / Function of Final Design Engineers 71% Generated Better Construction Documents Owners 70% Improved Ability to Plan Construction Phasing and Logistics Owners 70% Source : Dodge Data & Analytics – Smart Market Report Published on 2015 in Associate with Building Smart Alliance
  • 27.
    Barriers of BIMImplementation
  • 28.
    The effective implementationand use of BIM remains a major issue for the construction industry. Whilst the technology underpinning BIM has been around for well over a decade BIM implementation and take-up has been relatively slow in the construction industry compared to industries such as manufacturing and engineering. (Smith, 2014)
  • 29.
    lack of clientdemand BIM BIM application among designers was limited Lack Qualified Staff Caroline T. W. Chan (2014) Hong Kong Experience Lack Trainings Education government should collaborate with industry, professional bodies and education institutes to establish clear standards and guidance on BIM Government Hong Kong Government to implement BIM in all public housing projects starting from 2014 lack of standards
  • 30.
    1. High costto implement BIM 2. IT availability (software, hardware, computer) 3. Require Time for training and implementing BIM 4. Readiness organization to change 5. Lack of knowledge in BIM 6. New technology require expertise and training. 7. Lack of information about benefits of BIM (Ismail, 2014) Malaysia Context Barriers of BIM implementation
  • 31.
  • 32.
  • 33.
    Project Details SCOPE OFSERVICES PMC SERVICES ( BIM COMPLIANCE) PROJECT DESCRIPTION COMMON INFRASTRUCTURE (2,330 ACRES) SG BULOH COMMON INFRA COST RM1 BILLION IMPLEMENTATION PERIOD 5 YEARS (Excl DLP) SCHEDULED OF DEV STAGES 1, 2 AND 3 STAGES PMC With BIM capability Initiated 2014 Implementation of project with BIM 2015 KwasaLand Initiated 2011 2D Design 2012 – 2014 (conventional)
  • 34.
    LTSAAS SUBANG BISTARI DEVELOPMENT KOTADAMANSARA DEVELOPMENT SUBANG PERDANA SG BULOH DAMANSARA Jln Sg Buloh – Shah Alam North-South Highway Location Plan ARA DAMANSARA Jln Subang To Ipoh To JB To Airport To Shah Alam N KWASA DAMANSARA DEVELOPMENT 2,320Ac
  • 35.
    1. Secretary 2. Clerk/ Doc Controller F/T Const. Eng. (C&S) TBN F/T Const. Eng. (M&E) TBN F/T Arch. Manager TBN F/T Project Director TBN TBN Construction Management Design Management Overall Management 3rd Party Works 1. Soil Investigation 2. Topographical survey KWASA LAND Specialist Consultant PMC 1. Planner 2. Cost Manager 3. QA/QC & Manager 4. EIA / EMP 5. GBI 6. Infra. Engineer 7. Structure Engineer 8. Geotech Engineer 9. M&E Engineer 10. Interface / Integrated Head Office Support Project Manager Construction Manager Civil / Structure / Arch F/T BIM Manager (Interface) TBN Landscape TBN TBN Contracts Manager TBN Cost Manager / QS Planning Control Management Doc Control TBN Planning Manager TBN Scheduler TBN Contracts Management TBN Quality Manager Technical Management Sr. Engineers & Sub - Professional Support Civil Manager TBN Electrical TBN TBN Geotechnical Despatch Secretary / Clerk Document Controller Engineering TBN TBN L’scape Manager Mechanical TBN Asst. Project Manager (M&E) F/T Interface Management With BIM TBN F/T TBN Asst. Project Manager (C&S) F/T ORGANISATION CHART M&E Manager TBN Infrastructures TBN Structural BIM Manager TBN F/T
  • 36.
    Project Aim The developmentcarries the promise of a sustainable community township that focuses on 4 Key Components: Green Township, Connectivity, Inclusivity and Regional Commercial Centre. BIMs are ultimately developed to operate the facility after construction completion. The models will be utilized during the construction stage to monitor; • work progress • identify conflicts prior to construction • manage logistics
  • 37.
    Project initially implementedusing Non-BIM BIM BIM application among designers was limited (Critical @ time of implementation) Lack Qualified Staff Lack Trainings Education Client Initiative lack of standards [Uses BIM execution plan Technology transfer from foreign] On the work Workshops (Consultants & Contractors) [Technology transfer from foreign experience] Employment of BIM foreign experts With local inputs Project Experience
  • 38.
    Design Coordination: UsingClash Detection software during coordination process to determine field conflicts by comparing 3D models of building systems. Design Authoring: BIM software is used to incorporate design intent input documentation, metadata and other requirements and translating them into a comprehensive BIM. As-Built Modeling: A process used to depict an accurate representation of the actual condition of the Building in BIM Site Utilization Planning: Using construction simulation based modeling to represent both permanent and temporary facilities on site and related construction activities 4D Modeling: Using 4D modeling (3D models with added dimension of time) to effectively plan phased occupancy in a renovation, retrofit, addition, or to show the construction sequence and space requirements on a building site. Existing Conditions Modeling: Project team develops BIM to reflect existing conditions on site, including location of facilities, graded levels etc. BIM uses in Kwasaland Project
  • 39.
  • 40.
    Interacts on aregular basis to assess various BIM processes and deliverables Site Monitoring Frequency
  • 41.
    Construction Simulation (based on contractorsapproved programme) 2D Design Drawings from Client 3D Modelling Clash Analysis & Detection Produce Clash Reports to Identify/ Specify all Clashes Resolve all Clashes Deliverable 1 Deliverable 2 Deliverable 3 3D Design Drawings from Client BIM Coordination With Consultants A B Deliverable 4 Construction Phase Deliverable 5 FM Management As Built Model BIM Process Flow
  • 42.
    Enhanced & OptimizedPerformance & Solutions: Easier & more accurate comparison on design options as well as using clash detection software to mitigate possible issues – cost effective Better outcome through collaboration: collaborative working relationship between consultants, client and contractors – better understanding of design intent Fits First Time: Reduced Safety Risks: safety preventive methods being deployed during early stage Greater Predictability: better visualization by using 4D modeling (3D models with added dimension of time) - effectively plan complex procedures, optimizing temporary works designs and planning procurement of materials, equipment and manpower. Faster Project Delivery: Less design issues by early coordination & using standard detailing (where possible) BIM benefits in Kwasaland Project Reduce Waste:
  • 43.
    CLASH COORDINATION PIPE WORKCLASH WITH CABLE TRAYS
  • 44.
  • 45.
    CLASH COORDINATION DRAINAGE CLASHWITH STRUCTURAL BEAMS
  • 46.
    CLASH COORDINATION DRAINAGE CLASHWITH PILE CAP FOUNDATION
  • 47.
  • 48.
    QUANTITY TAKE-OFF CROSS REFERENCE BOQ RaftSlab Concrete Quantities BIM DELIVERABLES
  • 49.
  • 50.
    Knowledge: Basic ITknowledge (basic 3D) and BIM knowledge in various stakeholders – consultants & contractors Cost: Initial capital to be utilized No precedent studies: The process of BIM implementation is at learning stage – trial and error Issues on liabilities: during transfer of information between designers and contractors (different stages) Awareness: understanding on the importance of BIM – initiated by PMC, without prior awareness from Kwasa Damansara’s BOD (need to be convinced) Application of BIM Management: Issues during initial coordination for pre, during & post construction Barriers & Challenges in Kwasaland Project Transfer of Technology: Need to refer consultants from overseas to train, having workshops etc
  • 51.
    Case Study: Strategies toOvercome Barriers
  • 52.
    (IEM, 2014) Malaysia Context– Steps to increase pace of BIM
  • 53.
    The Main Questionis HOW? CHANGE MANAGEMENT
  • 54.
    Change Management  Theset of tools, processes, skills and principles for managing the people side of change to achieve the required outcomes of the project or initiative.  Strategic change become necessary when opportunities or threats arise in the following main areas:  Environment  Diversification  Technology  People
  • 55.
    People in ChangeManagement Organization Team Me • How does change impact people across the organization? • How do we make this work for all of us? • How does each one show up (Acceptance, fear, anger, resistance) • What can I do to help them cope? • How do I show up? • Can I cope? • What do I need to help me cope? C H A N G E A G E N T
  • 56.
    Change Management Strategy Tools Situationa l Awareness •Understand the change and who is impacted. i.e : Change characteristics, impacted group, organizational attributes Supportin g Structures • Team and sponsor structures Strategy Analysis • Risk, resistance and special tactic  Formulating the change management strategy is the first critical step in implementing a change management methodology.  The strategy provide direction and results in informed decision making throughout the change process.  A well formulated strategy really brings the project or change to life, describing who and how it will impact the organization.
  • 57.
    Change Management Process UNFREEZINGCHANGING REFREEZING LEWIN’s Change Management Model Make sure the change stick as part of the new routine
  • 58.
    Kotter’s 8 StepsChange Management Model
  • 59.
    Possible barriers toChange Barriers to Change Culture Developm ental Psycholog ical Social
  • 60.
    Evaluation of aChange Strategy Determine objectives Describe Objectives Measure effects Establish baseline points Control Extraneous factors Detect unanticipated consequences
  • 61.
    Strategies to overcomethe barriers Change Agent PMC Establish Urgency Powerful Coalition Remove Obstacles Create Vision Communicate Vision Create Quick Wins Build on the Change Make it Stick • Importance of coordinating for FM • Request from the client • PMC initiated coalition between consultants, specialists and contractors • Create awareness in BIM implementation • Training given to stakeholders (staff, contractors, clients, LA) • Highlighting advantages of BIM (time, cost, quality) • Consistent monitoring – meeting & updates to obtain similar goals • Establish sequence • Visualization prior to implementation (at different stages) • Trial and error – learning curve • Practice makes perfect • Continuous improvements
  • 62.
  • 63.
    Conclusion • BIM isan important management tool in mitigating most construction issues • BIM is seen to be a technology that might be mandatory implementation in the construction industry in Malaysia
  • 64.
