BI 4.0 Migration Methodology and Best Practices

Eric Molner

February 3, 2013
Who Is Analytics8?

– Founded in 2002
– Offices in
  Chicago, Raleigh, Dallas, Sydn
  ey, Brisbane, and Melbourne
– 100+ Consultants
– 150+ Customers
– Consulting, Training, Support/
  Help Desk, Software
  Procurement

                                   1

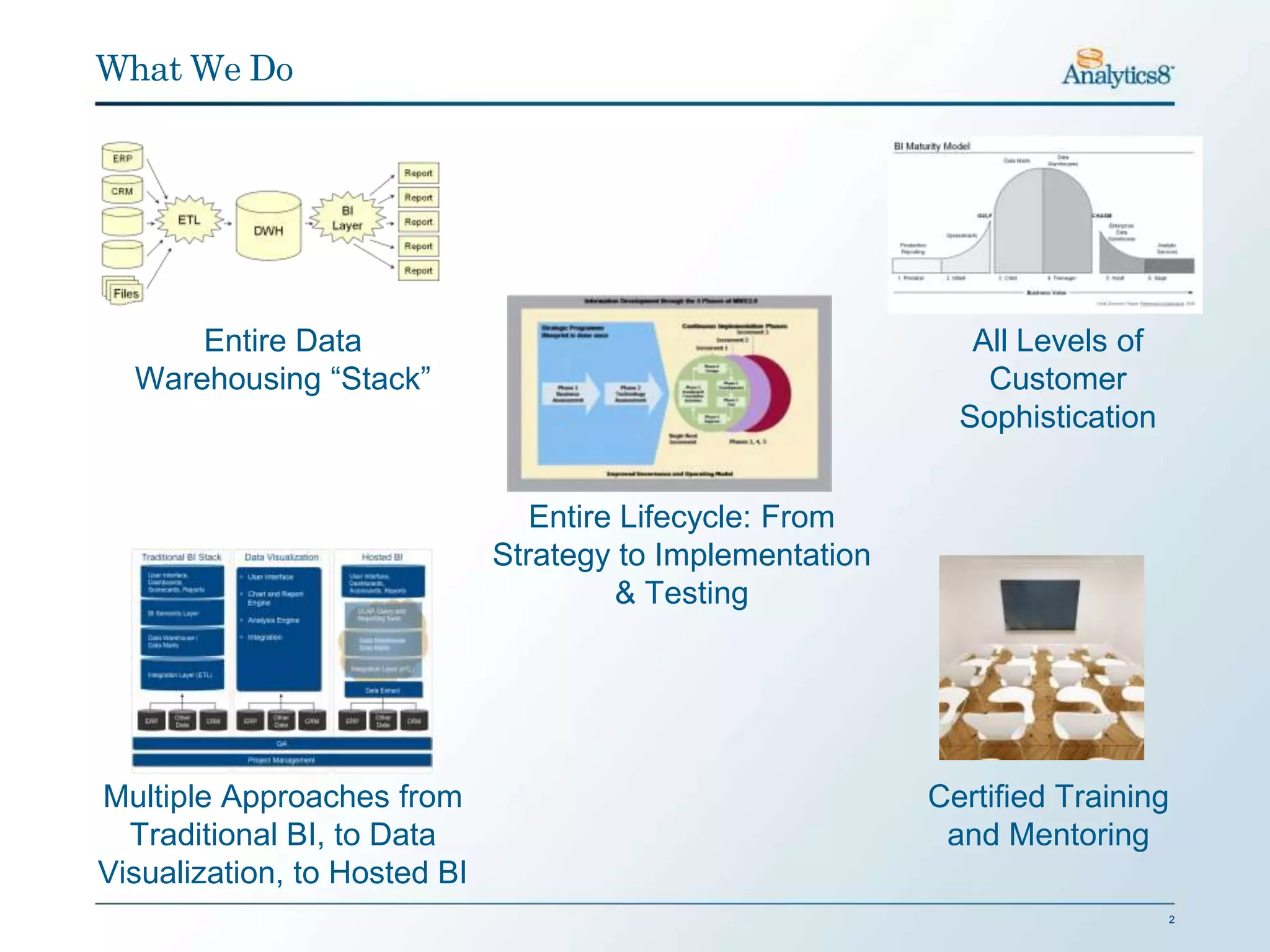

What We Do

      Entire Data                                             All Levels of
  Warehousing “Stack”                                          Customer
                                                             Sophistication

                                 Entire Lifecycle: From
                              Strategy to Implementation
                                       & Testing

Multiple Approaches from                                   Certified Training
  Traditional BI, to Data                                   and Mentoring
Visualization, to Hosted BI
                                                                              2

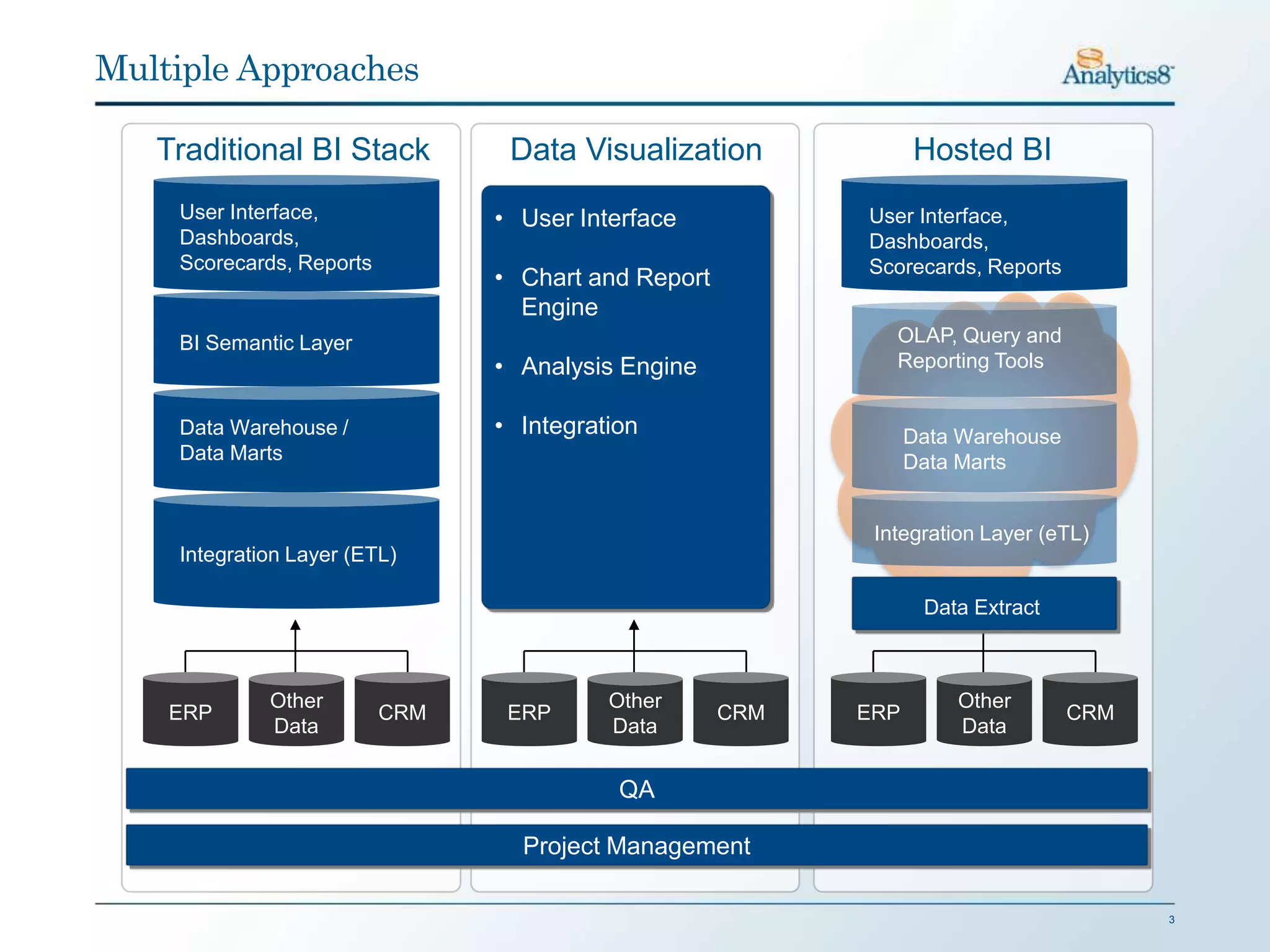

Multiple Approaches

   Traditional BI Stack          Data Visualization              Hosted BI
    User Interface,             • User Interface           User Interface,
    Dashboards,                                            Dashboards,
    Scorecards, Reports                                    Scorecards, Reports
                                • Chart and Report
                                  Engine
    BI Semantic Layer                                         OLAP, Query and
                                • Analysis Engine             Reporting Tools

    Data Warehouse /            • Integration                    Data Warehouse
    Data Marts                                                   Data Marts

                                                            Integration Layer (eTL)
    Integration Layer (ETL)

                                                                  Data Extract

             Other                        Other                      Other
    ERP                   CRM    ERP                 CRM   ERP                    CRM
             Data                         Data                       Data

                                           QA

                                  Project Management

                                                                                        3
Advantages of Working With Us

– Not Just Technicians
– Accelerated Time to Value
– End-to-End Expertise
– Single-Source Solution
– Work with the Leading Business Intelligence Vendors
– Industry-Specific Domain Knowledge
– Structured, but Flexible Project Delivery Methodology

2/3/2013                                                  4
Our Customers

             Insurance          Manufacturing

           Financial Services   Retail & CPG

2/3/2013                                        5
Check Out our New Website
Eric Molner
– Principal Consultant, based out of Chicago
– Over 8 years of Business Intelligence experience
– Held a variety of roles from lead developer to project
  manager
– Effectively worked with clients in the financial, retail,
  healthcare, and transportation industries
– Main areas of concentration:
             SAP BusinessObjects Migrations
             Deployment, Installation, and Configuration of SAP
              BusinessObjects Enterprise
             Data Visualization/Data Discovery
             Reporting Best Practices
             Business Analysis
             Logical database design for reporting
             Testing/Data Quality Management

Sunday, February 03, 2013                                          7

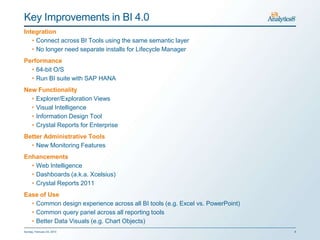

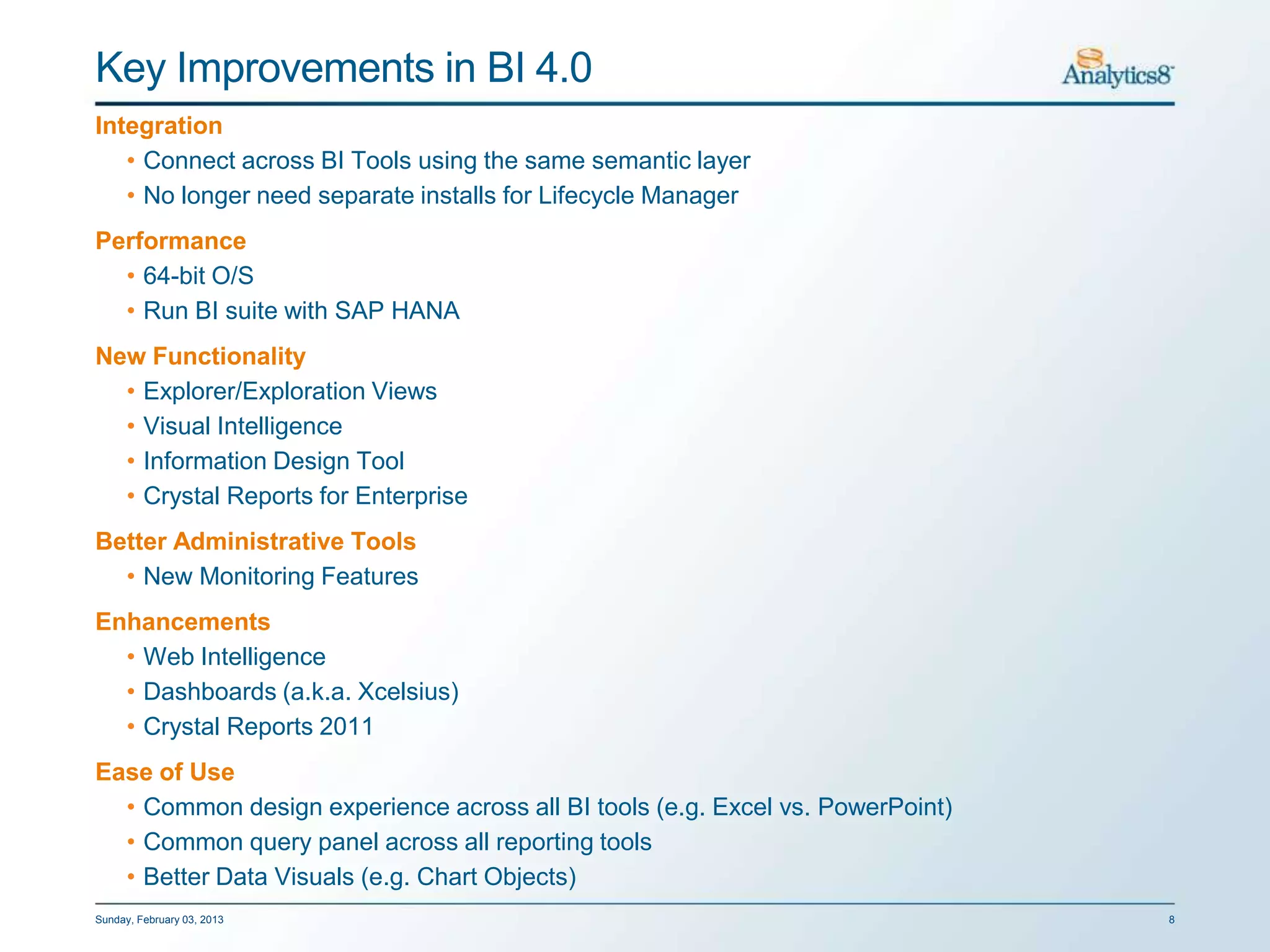

Key Improvements in BI 4.0
Integration
   • Connect across BI Tools using the same semantic layer
   • No longer need separate installs for Lifecycle Manager
Performance
  • 64-bit O/S
  • Run BI suite with SAP HANA
New Functionality
  • Explorer/Exploration Views
  • Visual Intelligence
  • Information Design Tool
  • Crystal Reports for Enterprise
Better Administrative Tools
  • New Monitoring Features
Enhancements
  • Web Intelligence
  • Dashboards (a.k.a. Xcelsius)
  • Crystal Reports 2011
Ease of Use
  • Common design experience across all BI tools (e.g. Excel vs. PowerPoint)
  • Common query panel across all reporting tools
  • Better Data Visuals (e.g. Chart Objects)
Sunday, February 03, 2013                                                      8

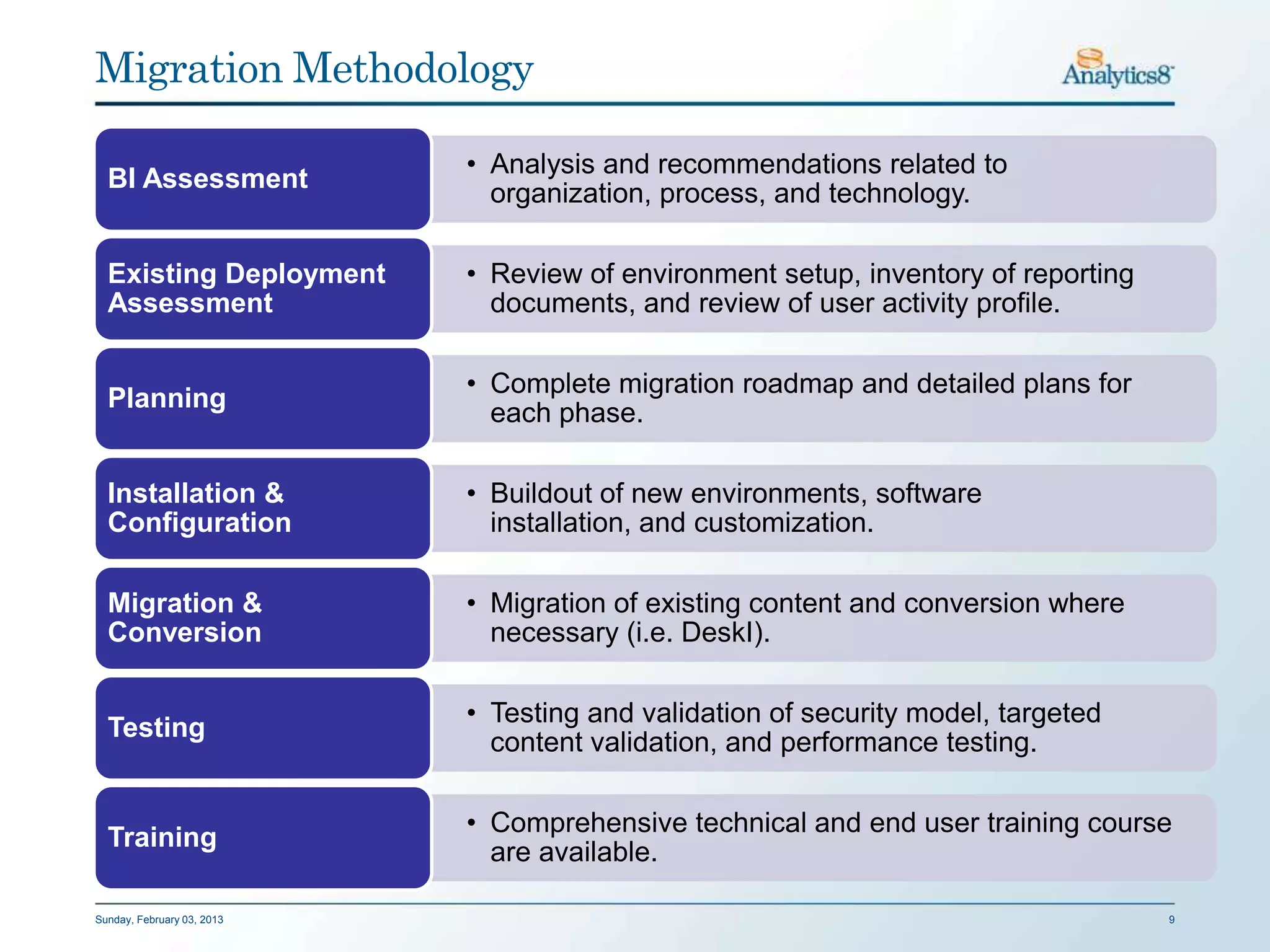

Migration Methodology

                            • Analysis and recommendations related to
  BI Assessment
                              organization, process, and technology.

  Existing Deployment       • Review of environment setup, inventory of reporting
  Assessment                  documents, and review of user activity profile.

                            • Complete migration roadmap and detailed plans for
  Planning
                              each phase.

  Installation &            • Buildout of new environments, software
  Configuration               installation, and customization.

  Migration &               • Migration of existing content and conversion where
  Conversion                  necessary (i.e. DeskI).

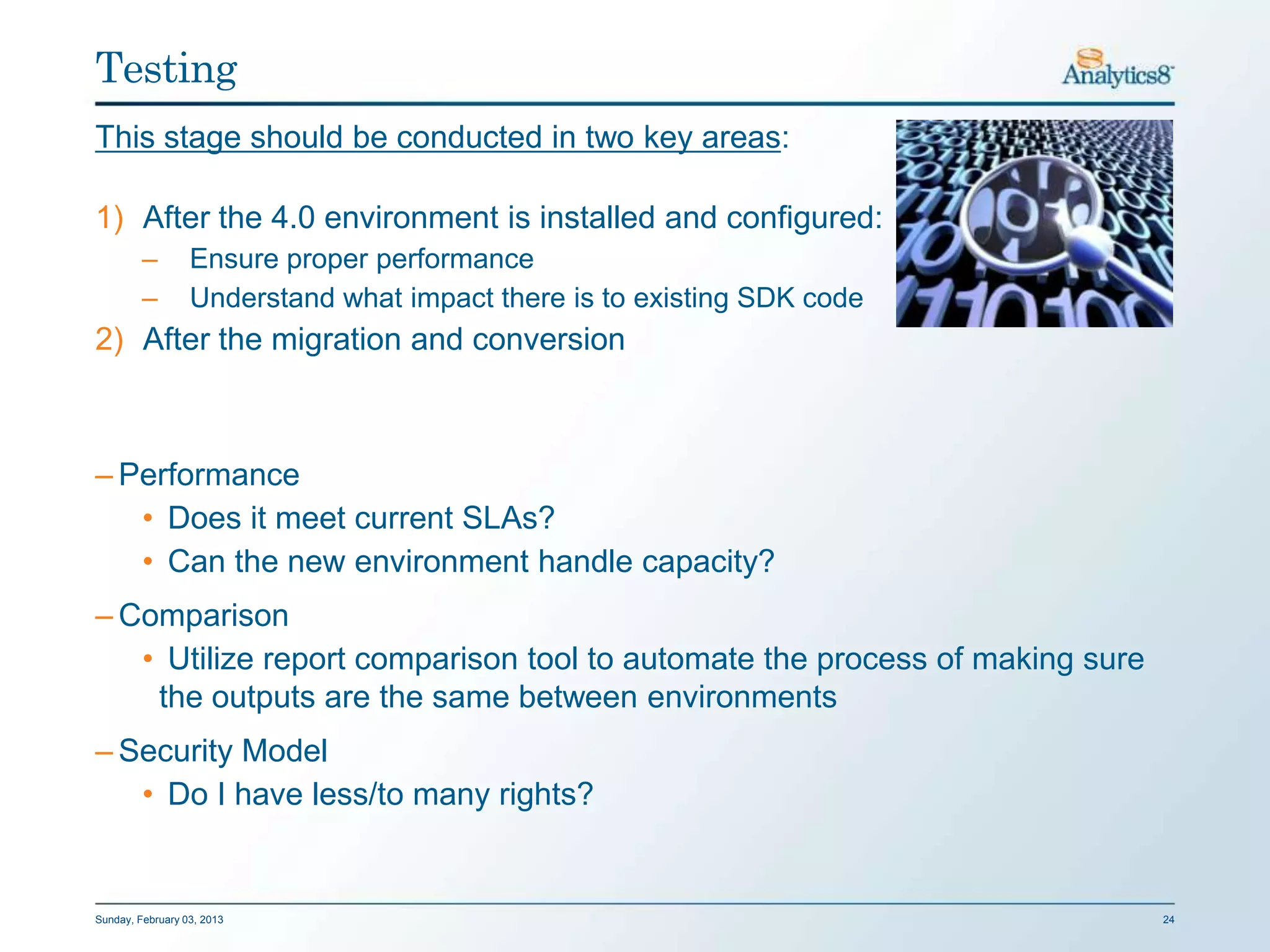

                            • Testing and validation of security model, targeted
  Testing
                              content validation, and performance testing.

                            • Comprehensive technical and end user training course
  Training
                              are available.

Sunday, February 03, 2013                                                           9

BI Assessment
Based on a comprehensive analysis of the Current State, the Desired or Target
State, and a Transition Plan or Roadmap to move from the former to the latter.

                            Current          Target           Transition
                             State           State               Plan

Sunday, February 03, 2013                                                  10

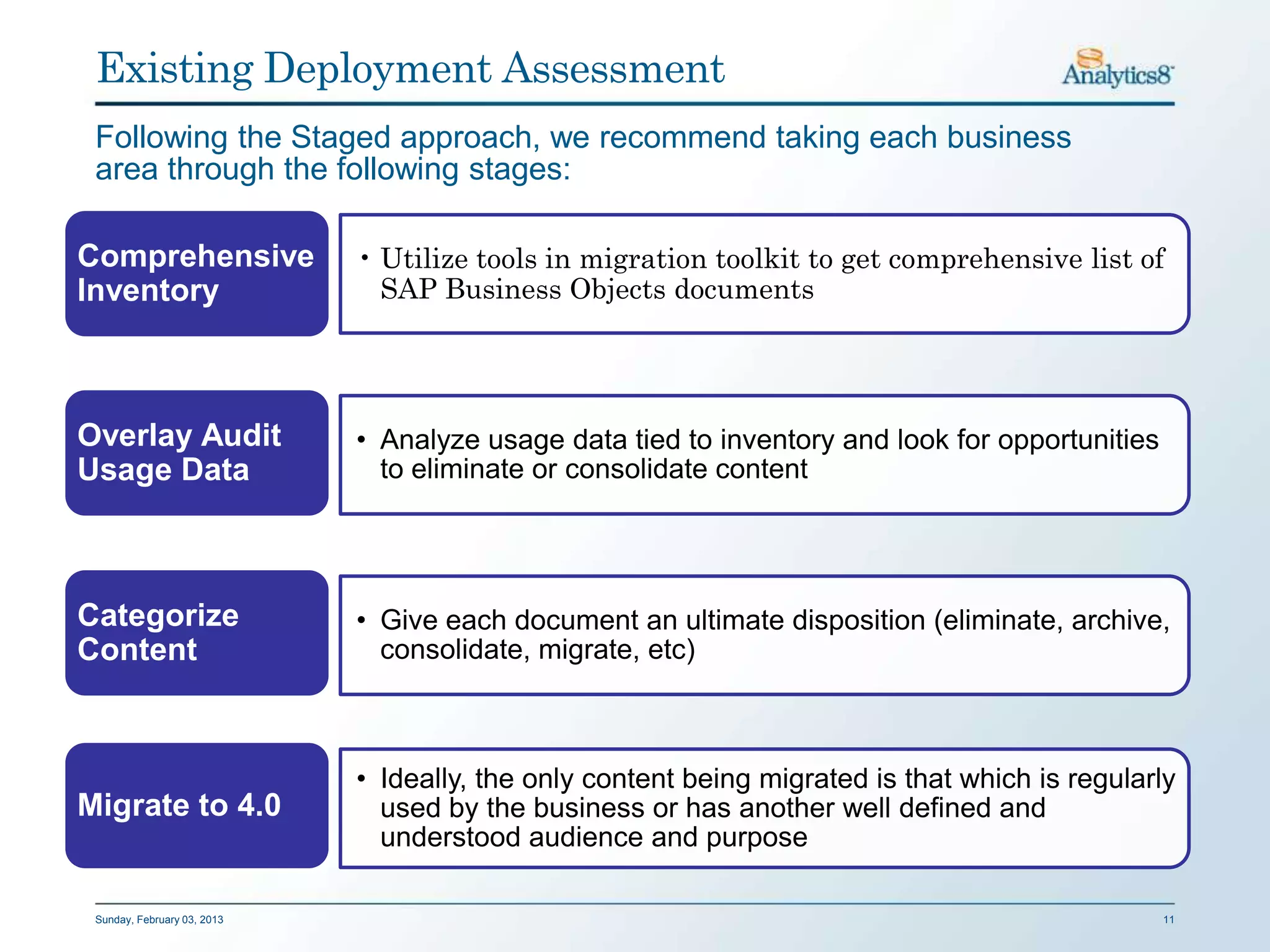

Existing Deployment Assessment
 Following the Staged approach, we recommend taking each business
 area through the following stages:

Comprehensive                • Utilize tools in migration toolkit to get comprehensive list of
Inventory                      SAP Business Objects documents

Overlay Audit                • Analyze usage data tied to inventory and look for opportunities
Usage Data                     to eliminate or consolidate content

Categorize                   • Give each document an ultimate disposition (eliminate, archive,
Content                        consolidate, migrate, etc)

                             • Ideally, the only content being migrated is that which is regularly
Migrate to 4.0                 used by the business or has another well defined and
                               understood audience and purpose

 Sunday, February 03, 2013                                                                       11

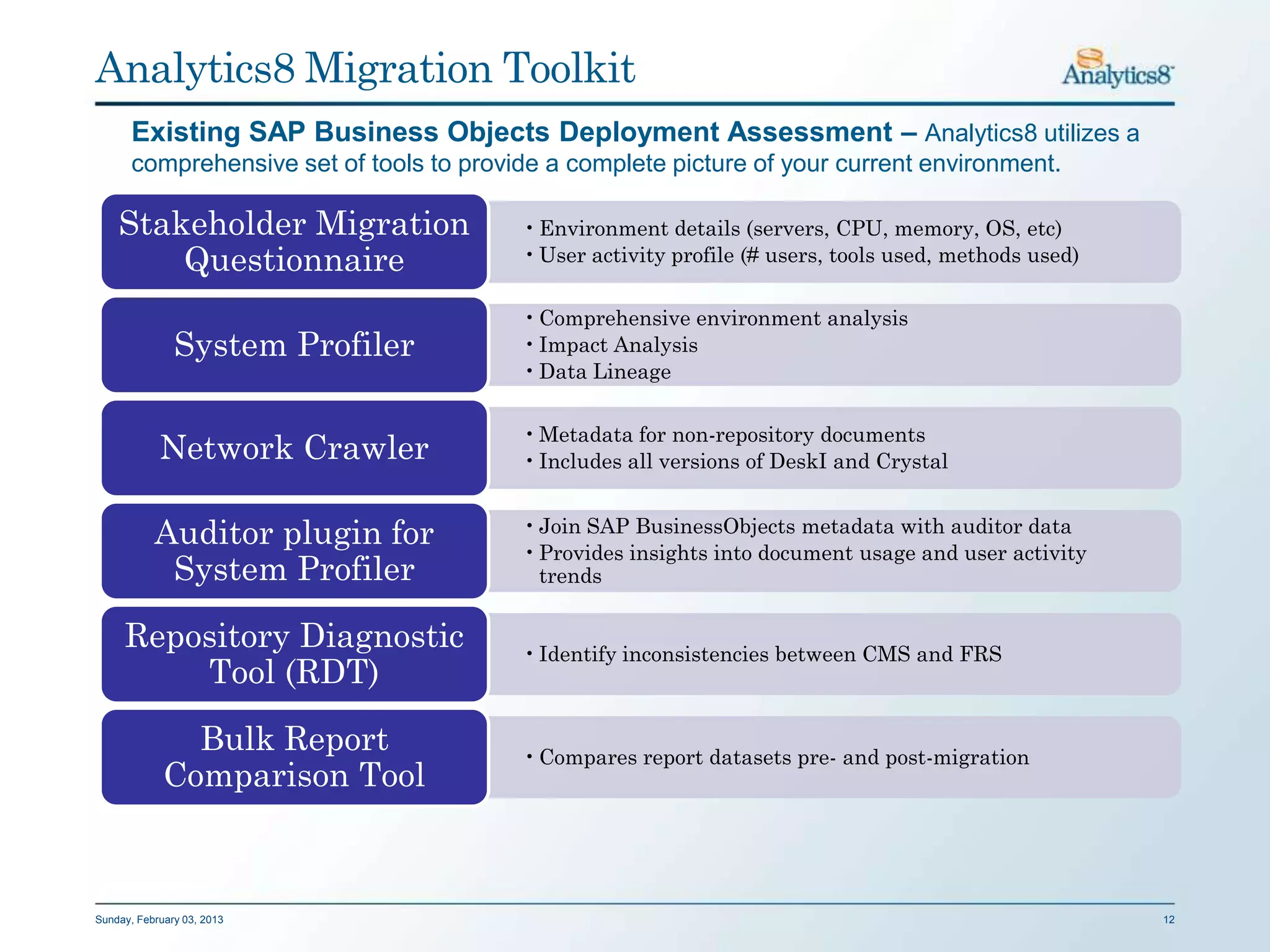

Analytics8 Migration Toolkit
       Existing SAP Business Objects Deployment Assessment – Analytics8 utilizes a
       comprehensive set of tools to provide a complete picture of your current environment.

    Stakeholder Migration                 • Environment details (servers, CPU, memory, OS, etc)
        Questionnaire                     • User activity profile (# users, tools used, methods used)

                                          • Comprehensive environment analysis
               System Profiler            • Impact Analysis
                                          • Data Lineage

                                          • Metadata for non-repository documents
            Network Crawler               • Includes all versions of DeskI and Crystal

           Auditor plugin for             • Join SAP BusinessObjects metadata with auditor data
                                          • Provides insights into document usage and user activity
            System Profiler                 trends

     Repository Diagnostic                • Identify inconsistencies between CMS and FRS
         Tool (RDT)

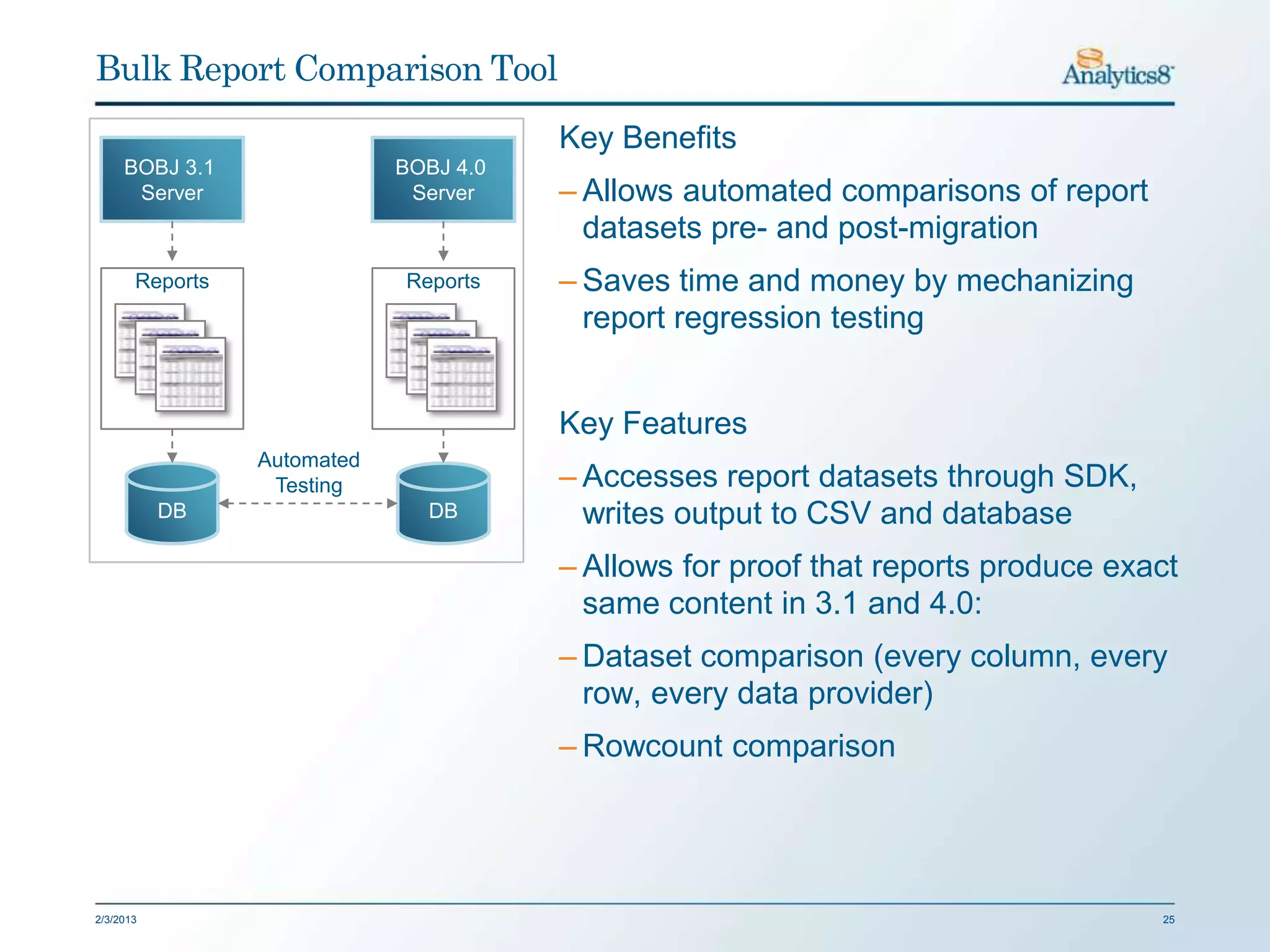

               Bulk Report                • Compares report datasets pre- and post-migration
             Comparison Tool

Sunday, February 03, 2013                                                                               12

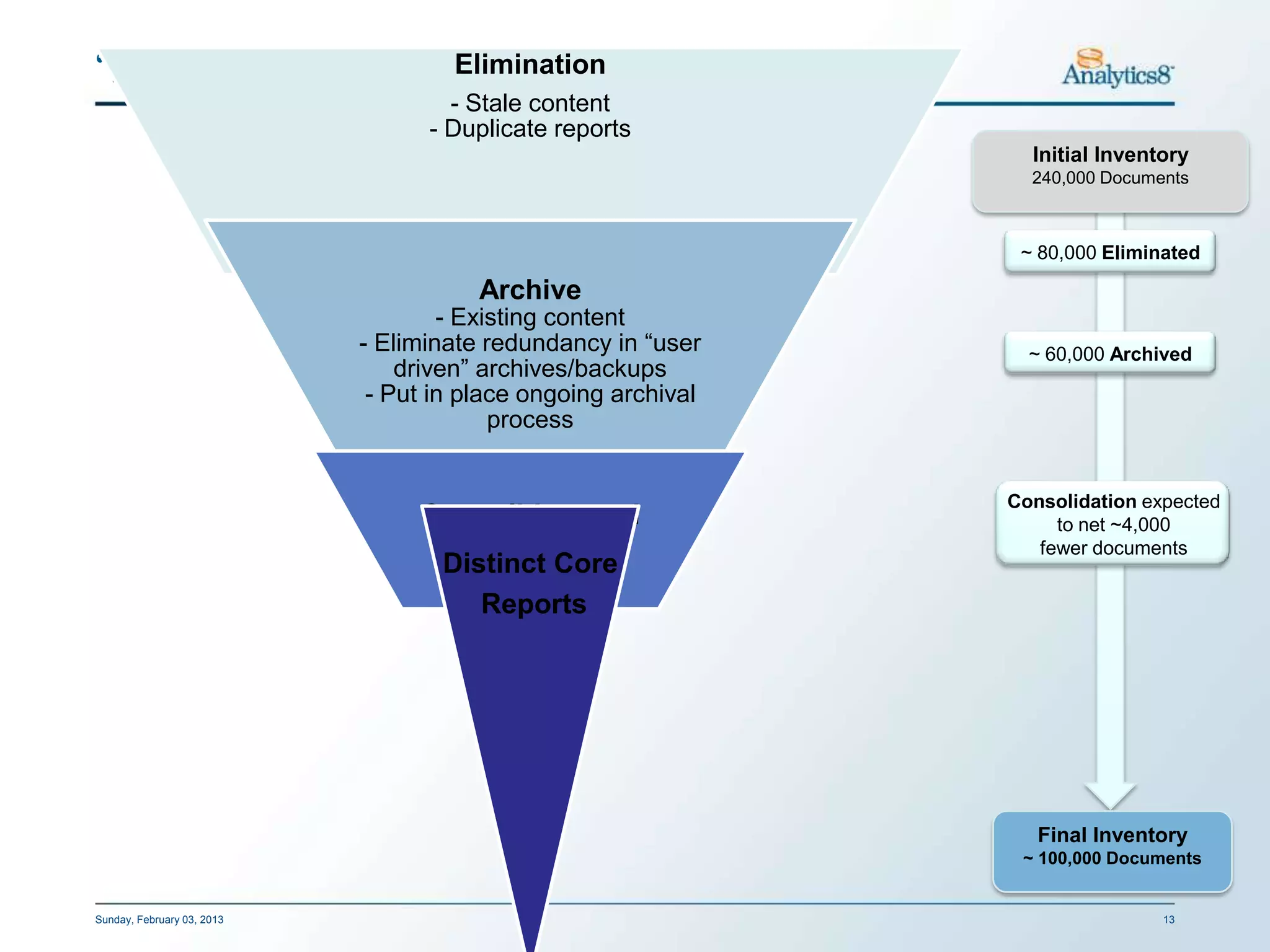

“House Cleaning” Existing Environment
                  Elimination
                                    - Stale content
                                  - Duplicate reports
                                                                 Initial Inventory
                                                                 240,000 Documents

                                                                ~ 80,000 Eliminated

                                       Archive
                                    - Existing content
                            - Eliminate redundancy in “user      ~ 60,000 Archived
                                driven” archives/backups
                             - Put in place ongoing archival
                                         process

                                                               Consolidation expected
                                 Consolidate and                    to net ~4,000
                                     Refine                       fewer documents
                                  Distinct Core
                                     Reports

                                                                  Final Inventory
                                                                ~ 100,000 Documents

Sunday, February 03, 2013                                                      13

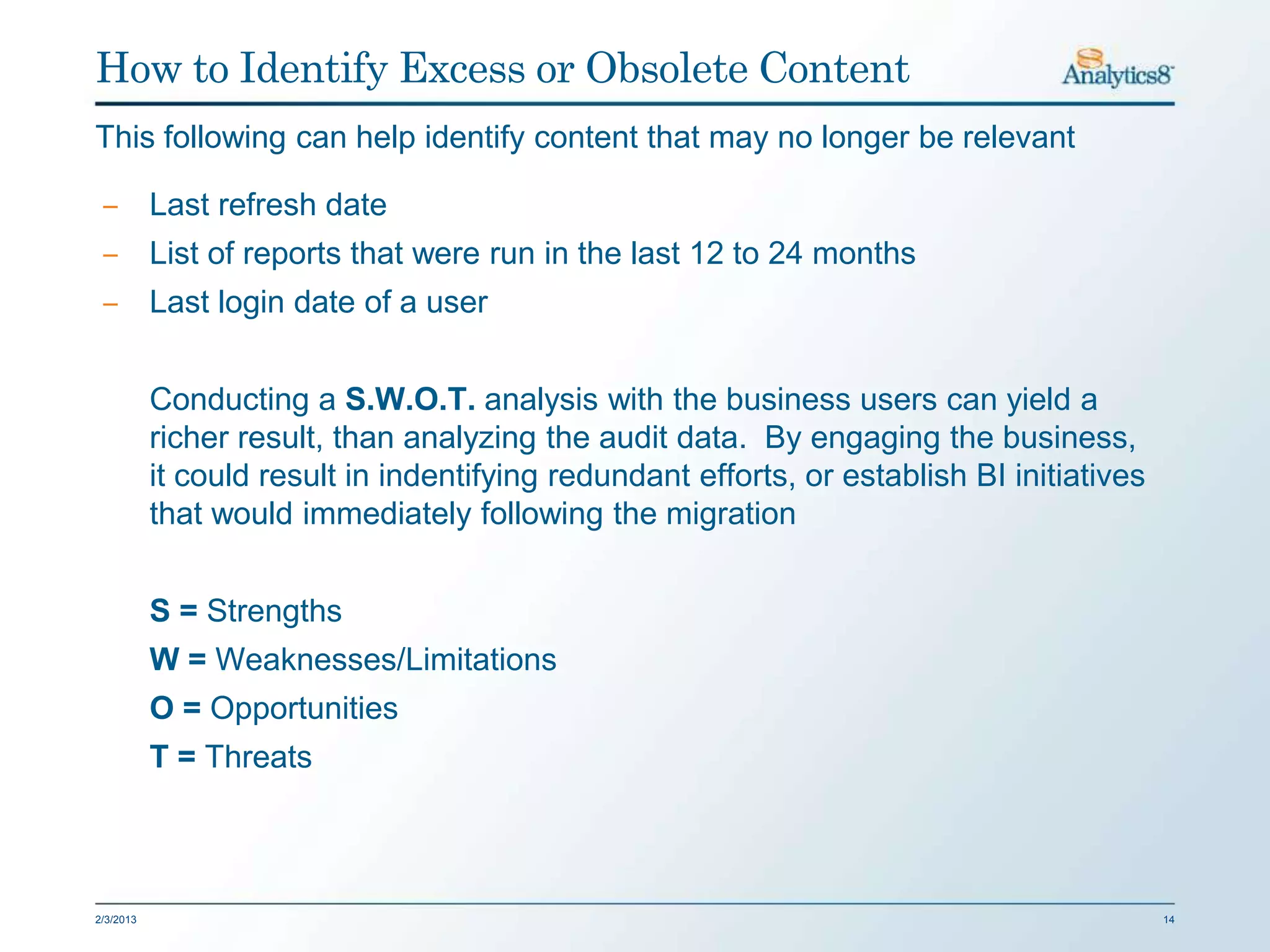

How to Identify Excess or Obsolete Content
This following can help identify content that may no longer be relevant

 ‒ Last refresh date
 ‒ List of reports that were run in the last 12 to 24 months
 ‒ Last login date of a user

           Conducting a S.W.O.T. analysis with the business users can yield a
           richer result, than analyzing the audit data. By engaging the business,
           it could result in indentifying redundant efforts, or establish BI initiatives
           that would immediately following the migration

           S = Strengths
           W = Weaknesses/Limitations
           O = Opportunities
           T = Threats

2/3/2013                                                                                    14

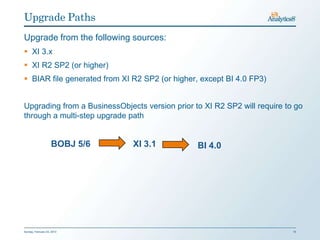

Upgrade Paths
Upgrade from the following sources:
 XI 3.x
 XI R2 SP2 (or higher)
 BIAR file generated from XI R2 SP2 (or higher, except BI 4.0 FP3)

Upgrading from a BusinessObjects version prior to XI R2 SP2 will require to go
through a multi-step upgrade path

                    BOBJ 5/6   XI 3.1           BI 4.0

Sunday, February 03, 2013                                                  15

Planning
Consider the following when putting together a project plan:

                            •What does my current BOBJ environment look like?
           Assessment       •What issues (e.g. technical) are we struggling with?

           Time and         •When can we start the project?
                            •Are we passed the End of Life (EOL) date on our current
           Deadlines         version?

           Resources        •What internal/external resources do we need to be successful?

             Impact         •Will the upgrade project impact any current developments?

            Training        •Will our administrators and power users be able support the
                             new version?

2/3/2013                                                                                     16

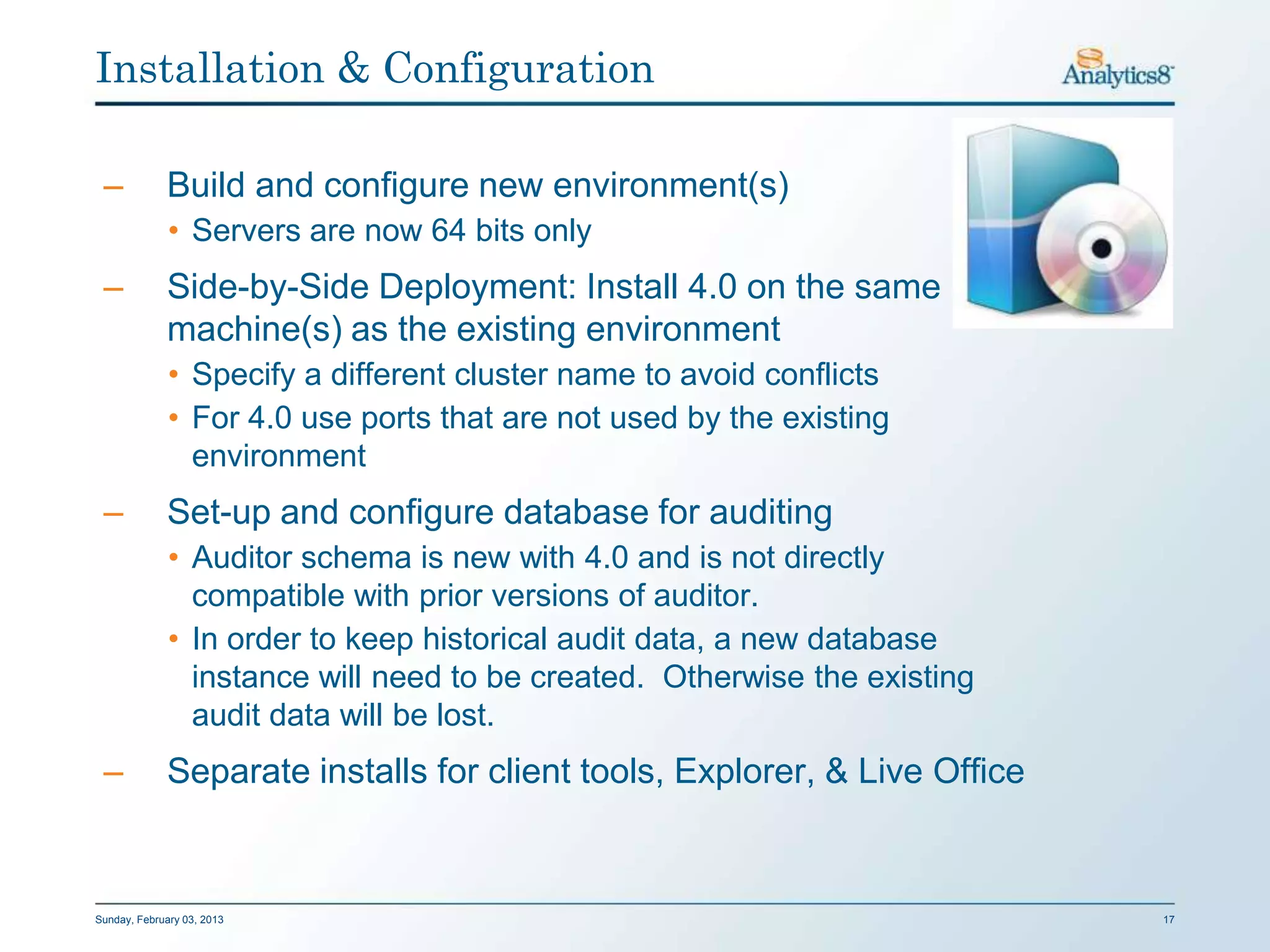

Installation & Configuration

 –           Build and configure new environment(s)
              • Servers are now 64 bits only
 –           Side-by-Side Deployment: Install 4.0 on the same
             machine(s) as the existing environment
              • Specify a different cluster name to avoid conflicts
              • For 4.0 use ports that are not used by the existing
                environment
 –           Set-up and configure database for auditing
              • Auditor schema is new with 4.0 and is not directly
                compatible with prior versions of auditor.
              • In order to keep historical audit data, a new database
                instance will need to be created. Otherwise the existing
                audit data will be lost.
 –           Separate installs for client tools, Explorer, & Live Office

Sunday, February 03, 2013                                                  17

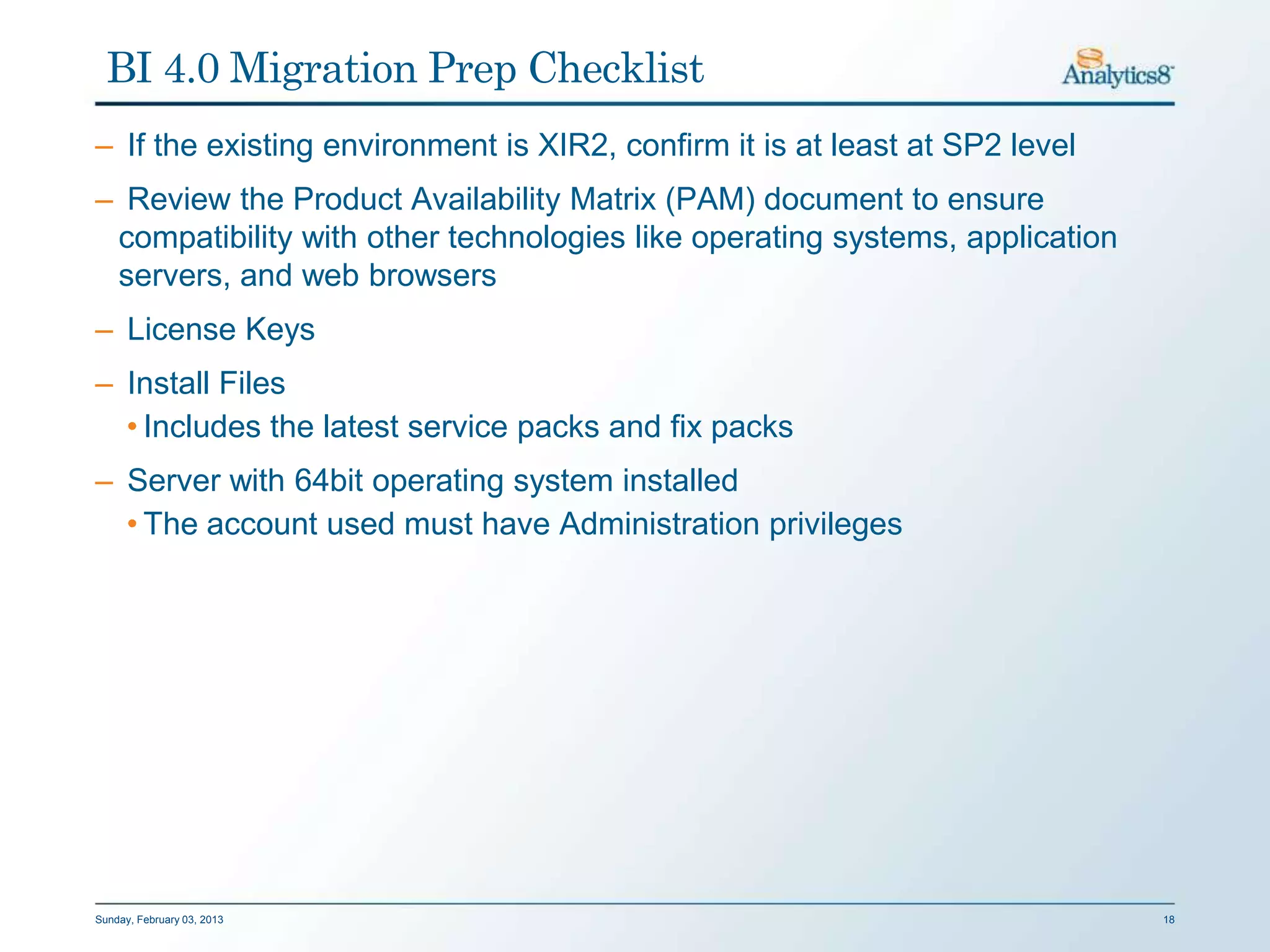

BI 4.0 Migration Prep Checklist
– If the existing environment is XIR2, confirm it is at least at SP2 level
– Review the Product Availability Matrix (PAM) document to ensure
 compatibility with other technologies like operating systems, application
 servers, and web browsers
– License Keys
– Install Files
  • Includes the latest service packs and fix packs
– Server with 64bit operating system installed
  • The account used must have Administration privileges

Sunday, February 03, 2013                                                    18

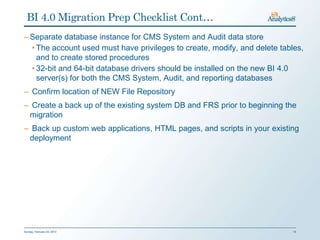

BI 4.0 Migration Prep Checklist Cont…
– Separate database instance for CMS System and Audit data store
  • The account used must have privileges to create, modify, and delete tables,
    and to create stored procedures
  • 32-bit and 64-bit database drivers should be installed on the new BI 4.0
    server(s) for both the CMS System, Audit, and reporting databases
– Confirm location of NEW File Repository
– Create a back up of the existing system DB and FRS prior to beginning the
 migration
– Back up custom web applications, HTML pages, and scripts in your existing
 deployment

Sunday, February 03, 2013                                                   19

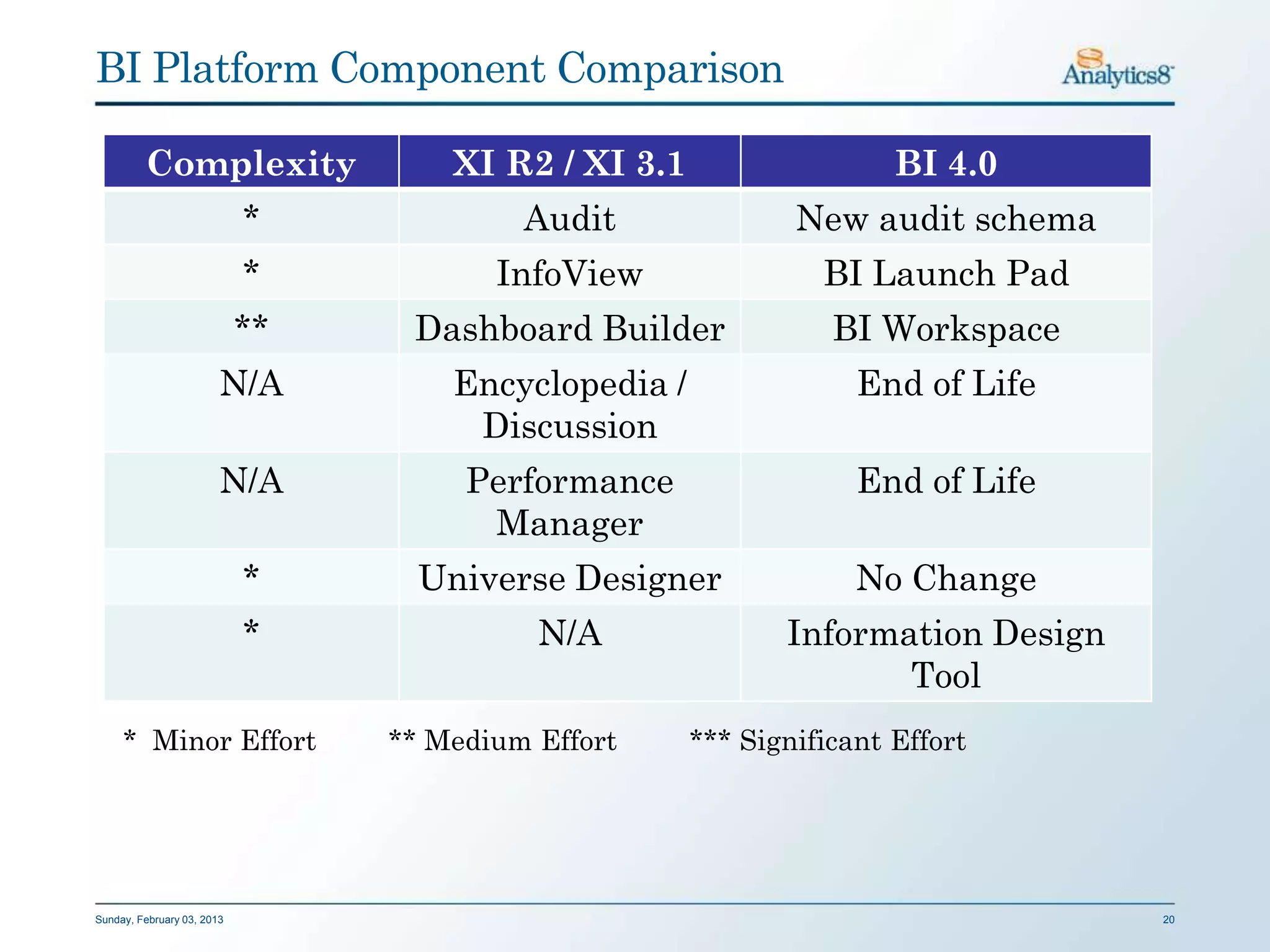

BI Platform Component Comparison

         Complexity                  XI R2 / XI 3.1                   BI 4.0
                            *             Audit               New audit schema
                            *           InfoView                BI Launch Pad
                            **    Dashboard Builder              BI Workspace
                        N/A          Encyclopedia /                End of Life
                                      Discussion
                        N/A           Performance                  End of Life
                                       Manager
                            *      Universe Designer               No Change
                            *              N/A               Information Design
                                                                    Tool
     * Minor Effort              ** Medium Effort     *** Significant Effort

Sunday, February 03, 2013                                                         20

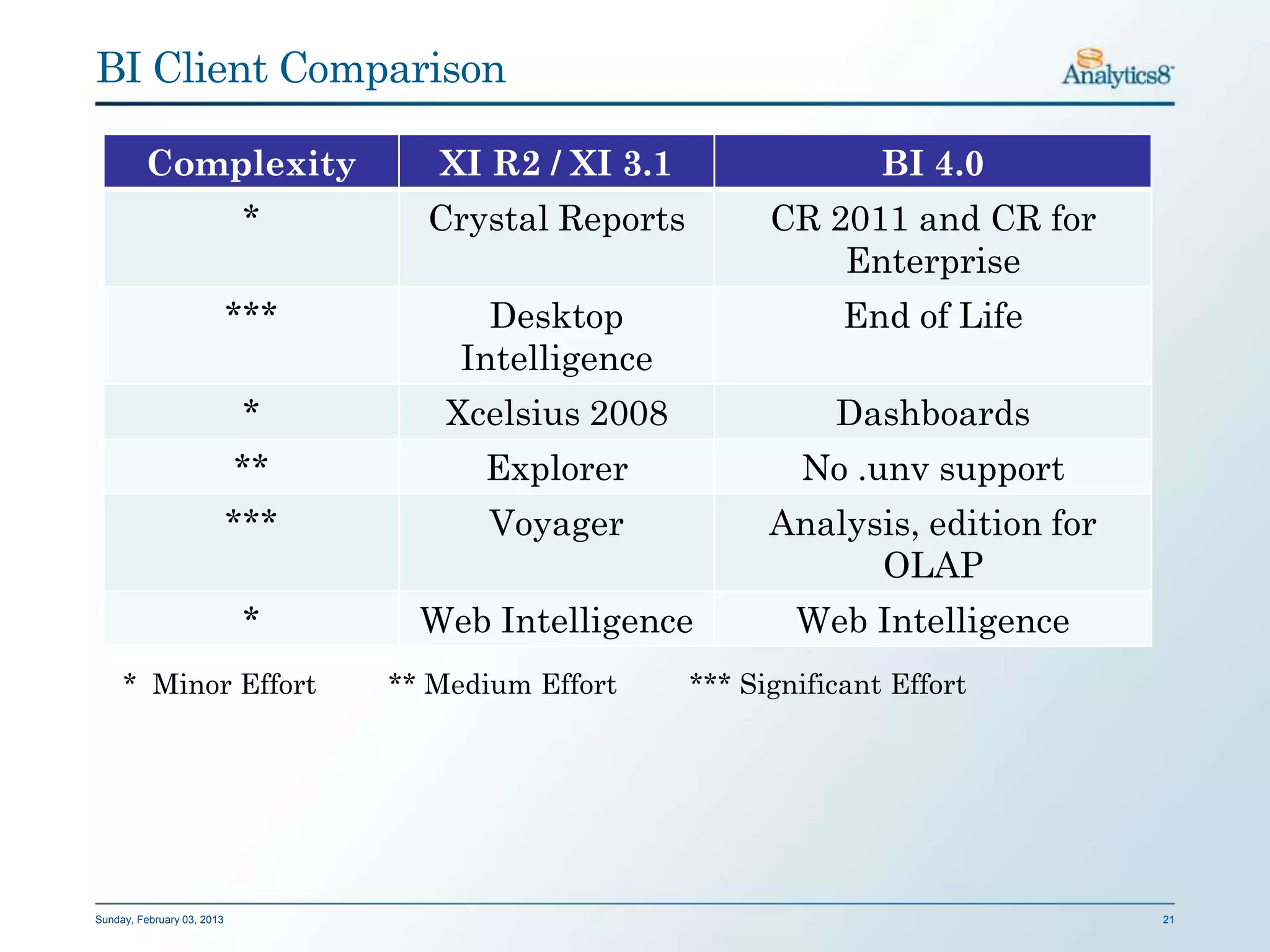

BI Client Comparison

         Complexity                  XI R2 / XI 3.1                  BI 4.0
                             *      Crystal Reports         CR 2011 and CR for
                                                                Enterprise
                            ***          Desktop                  End of Life
                                       Intelligence
                             *        Xcelsius 2008              Dashboards
                            **          Explorer              No .unv support
                            ***          Voyager            Analysis, edition for
                                                                  OLAP
                             *      Web Intelligence          Web Intelligence
     * Minor Effort               ** Medium Effort    *** Significant Effort

Sunday, February 03, 2013                                                           21

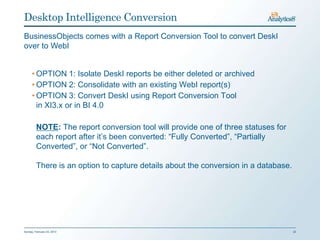

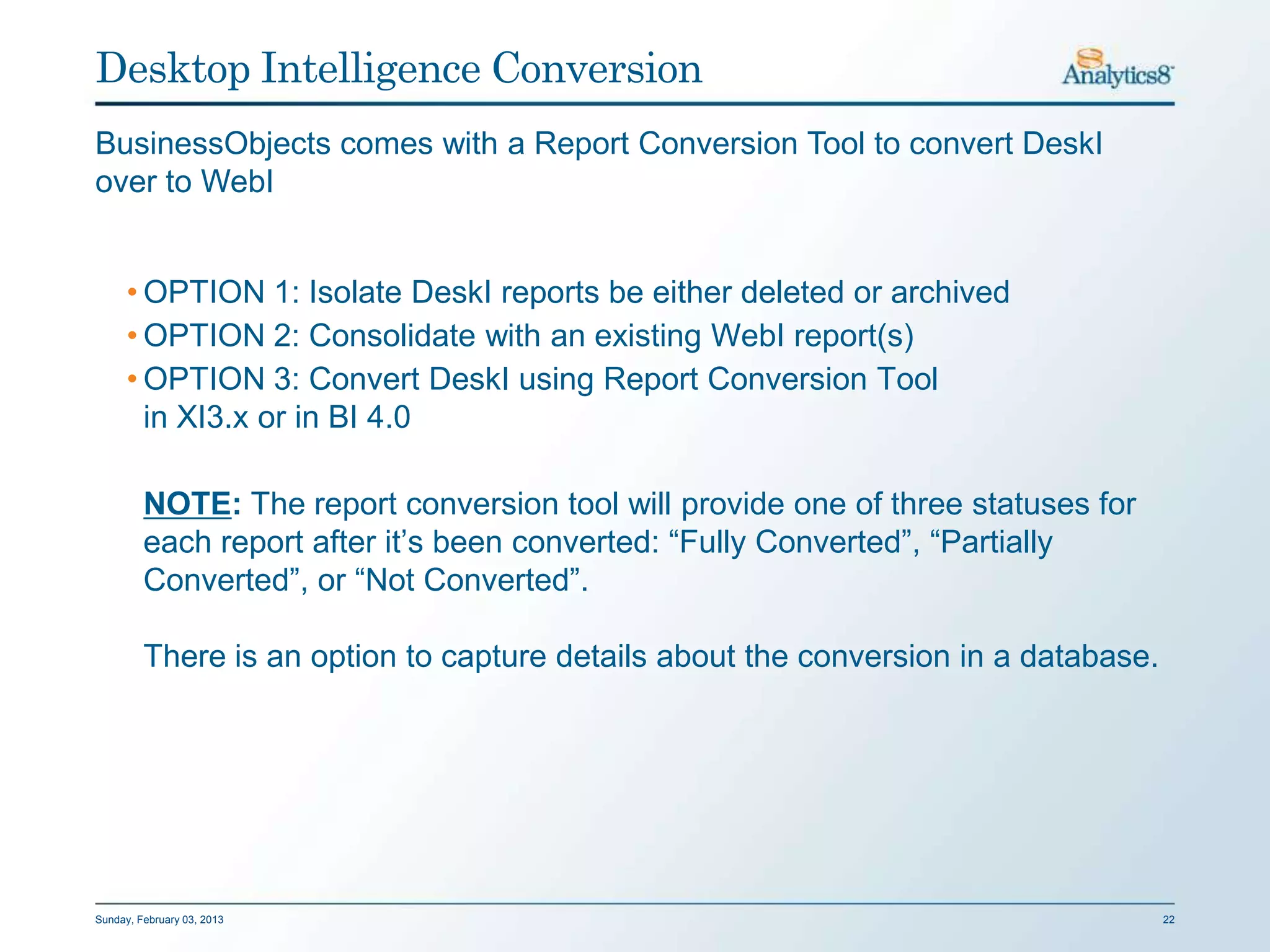

Desktop Intelligence Conversion
BusinessObjects comes with a Report Conversion Tool to convert DeskI
over to WebI

      • OPTION 1: Isolate DeskI reports be either deleted or archived
      • OPTION 2: Consolidate with an existing WebI report(s)
      • OPTION 3: Convert DeskI using Report Conversion Tool
        in XI3.x or in BI 4.0

         NOTE: The report conversion tool will provide one of three statuses for
         each report after it’s been converted: “Fully Converted”, “Partially
         Converted”, or “Not Converted”.

         There is an option to capture details about the conversion in a database.

Sunday, February 03, 2013                                                            22

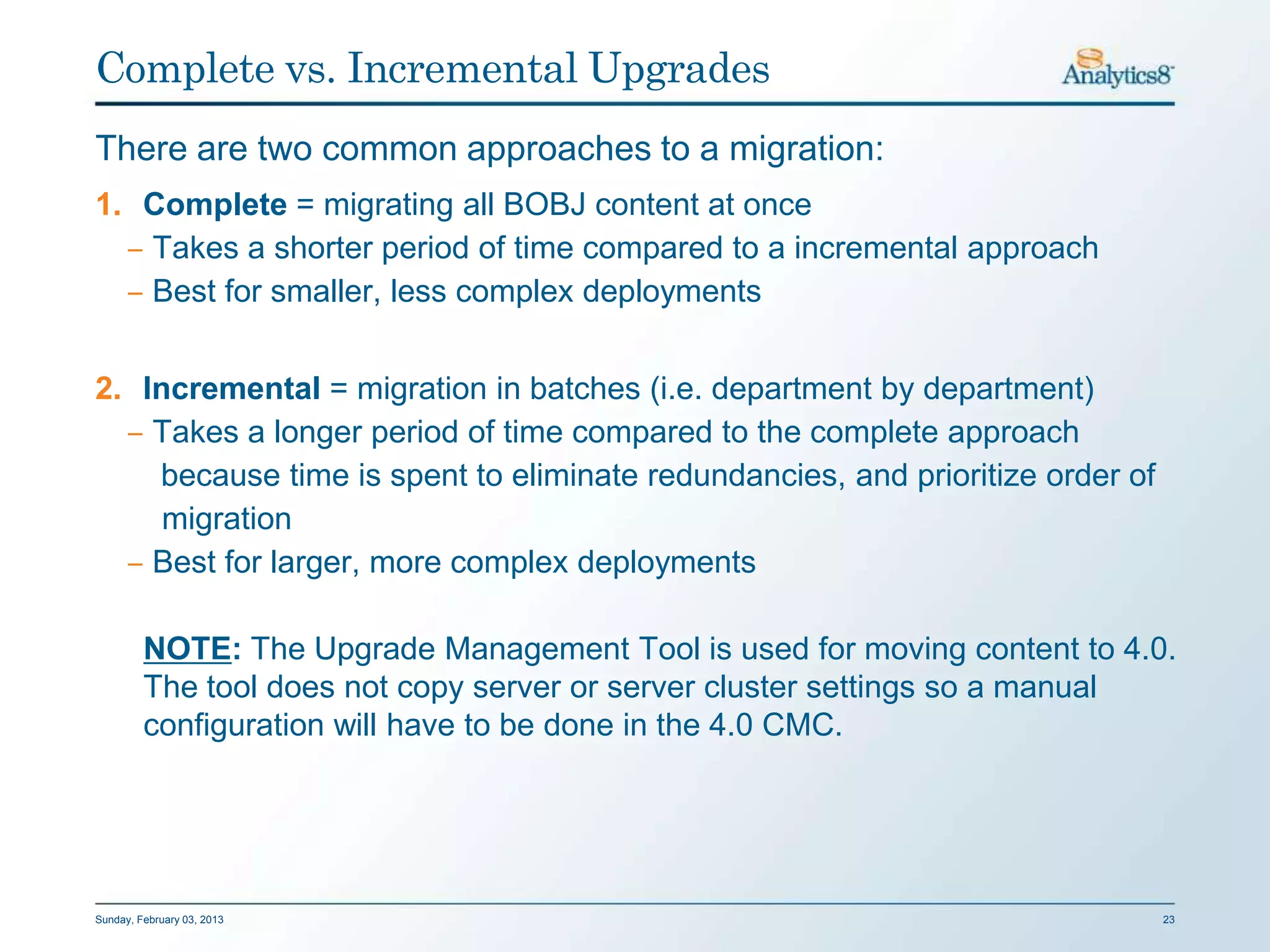

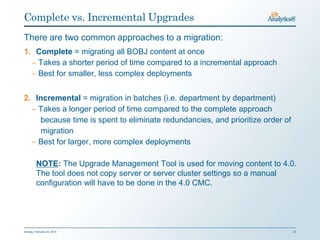

Complete vs. Incremental Upgrades
There are two common approaches to a migration:
1. Complete = migrating all BOBJ content at once
  ‒ Takes a shorter period of time compared to a incremental approach
  ‒ Best for smaller, less complex deployments

2. Incremental = migration in batches (i.e. department by department)
  ‒ Takes a longer period of time compared to the complete approach
    because time is spent to eliminate redundancies, and prioritize order of
     migration
  ‒ Best for larger, more complex deployments

         NOTE: The Upgrade Management Tool is used for moving content to 4.0.
         The tool does not copy server or server cluster settings so a manual
         configuration will have to be done in the 4.0 CMC.

Sunday, February 03, 2013                                                      23

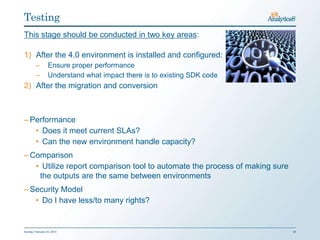

Testing
This stage should be conducted in two key areas:

1) After the 4.0 environment is installed and configured:
         –        Ensure proper performance
         –        Understand what impact there is to existing SDK code
2) After the migration and conversion

– Performance
   • Does it meet current SLAs?
   • Can the new environment handle capacity?
– Comparison
   • Utilize report comparison tool to automate the process of making sure
    the outputs are the same between environments
– Security Model
   • Do I have less/to many rights?

Sunday, February 03, 2013                                                    24
Bulk Report Comparison Tool
                                        Key Benefits
     BOBJ 3.1                BOBJ 4.0
      Server                  Server    – Allows automated comparisons of report
                                          datasets pre- and post-migration
       Reports               Reports    – Saves time and money by mechanizing
                                          report regression testing

                                        Key Features
                 Automated
                  Testing               – Accesses report datasets through SDK,
           DB                  DB         writes output to CSV and database
                                        – Allows for proof that reports produce exact
                                          same content in 3.1 and 4.0:
                                        – Dataset comparison (every column, every
                                          row, every data provider)
                                        – Rowcount comparison

2/3/2013                                                                           25
Training – SAP Certified Training Partner
– Most of the existing SAP BusinessObjects
  courses have been updated or are in the
  process of being updated for 4.0 where
  applicable
– Special consideration should be given to
  training in the following areas given the
  amount of changes made in 4.0
      • Web Intelligence – Full upgrade with
        dramatically changed interface
      • Information Design Tool – New semantic layer
      • Dashboards (formerly Xcelsius) – New
        connectivity functionality and features including
        some changes to the interface
      • Crystal Reports Enterprise – For customers
        wishing to abandon Crystal Reports 2011 and
        move to Enterprise

Sunday, February 03, 2013                                   26
Migration Best Practices

 ‒ “House Cleaning” Existing Environment : Example remove
   excess and obsolete reports
 ‒ Conduct S.W.O.T analysis with the business users
 ‒ Keep the original environment available long enough to compare
   to the new environment to ensure that the content was migrated
   successfully
 ‒ Go through a “practice run” of the migration
 ‒ Development should NOT be done on any 4.0 environment until
   the migration is complete
 ‒ Security = specify the new “owner right” for existing products, and
   set rights for new products (IDT, LCM, etc)

Sunday, February 03, 2013                                            27

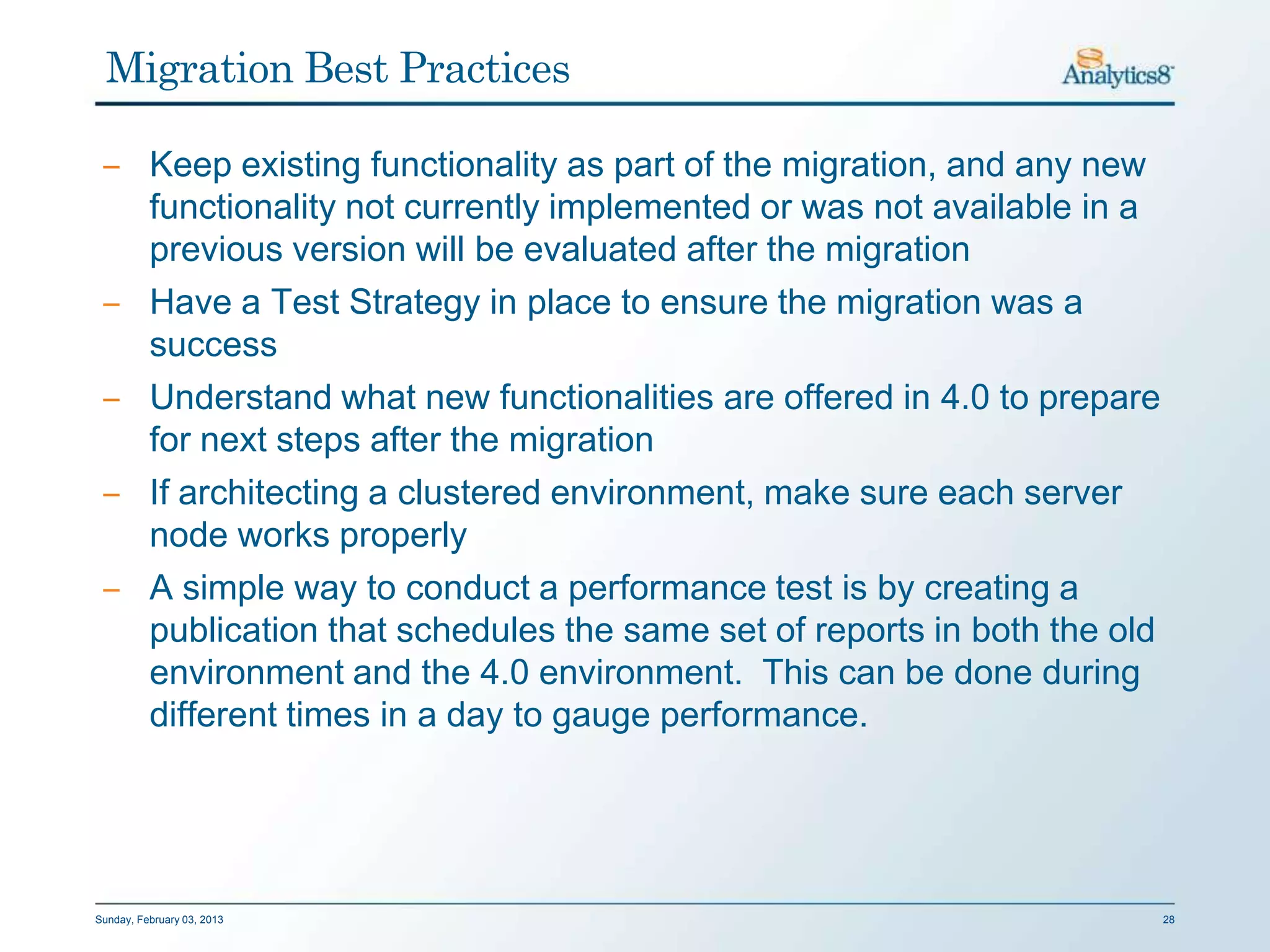

Migration Best Practices

 ‒ Keep existing functionality as part of the migration, and any new
   functionality not currently implemented or was not available in a
   previous version will be evaluated after the migration
 ‒ Have a Test Strategy in place to ensure the migration was a
   success
 ‒ Understand what new functionalities are offered in 4.0 to prepare
   for next steps after the migration
 ‒ If architecting a clustered environment, make sure each server
   node works properly
 ‒ A simple way to conduct a performance test is by creating a
   publication that schedules the same set of reports in both the old
   environment and the 4.0 environment. This can be done during
   different times in a day to gauge performance.

Sunday, February 03, 2013                                               28
Questions?

                    Thank you!

                        Eric Molner

                                      Analytics8
                                      500 N. Michigan Ave
                                      Suite 810
                                      Chicago, IL 60611

                                      T: 312 878 6600
                                      F: 773 326 0749

                                      www.Analytics8.com

Sunday, February 03, 2013                                   29

Bi 4.0 Migration Strategy and Best Practices

  • 1.
    BI 4.0 MigrationMethodology and Best Practices Eric Molner February 3, 2013
  • 2.
    Who Is Analytics8? –Founded in 2002 – Offices in Chicago, Raleigh, Dallas, Sydn ey, Brisbane, and Melbourne – 100+ Consultants – 150+ Customers – Consulting, Training, Support/ Help Desk, Software Procurement 1
  • 3.
    What We Do Entire Data All Levels of Warehousing “Stack” Customer Sophistication Entire Lifecycle: From Strategy to Implementation & Testing Multiple Approaches from Certified Training Traditional BI, to Data and Mentoring Visualization, to Hosted BI 2
  • 4.
    Multiple Approaches Traditional BI Stack Data Visualization Hosted BI User Interface, • User Interface User Interface, Dashboards, Dashboards, Scorecards, Reports Scorecards, Reports • Chart and Report Engine BI Semantic Layer OLAP, Query and • Analysis Engine Reporting Tools Data Warehouse / • Integration Data Warehouse Data Marts Data Marts Integration Layer (eTL) Integration Layer (ETL) Data Extract Other Other Other ERP CRM ERP CRM ERP CRM Data Data Data QA Project Management 3
  • 5.
    Advantages of WorkingWith Us – Not Just Technicians – Accelerated Time to Value – End-to-End Expertise – Single-Source Solution – Work with the Leading Business Intelligence Vendors – Industry-Specific Domain Knowledge – Structured, but Flexible Project Delivery Methodology 2/3/2013 4
  • 6.
    Our Customers Insurance Manufacturing Financial Services Retail & CPG 2/3/2013 5
  • 7.
    Check Out ourNew Website
  • 8.
    Eric Molner – PrincipalConsultant, based out of Chicago – Over 8 years of Business Intelligence experience – Held a variety of roles from lead developer to project manager – Effectively worked with clients in the financial, retail, healthcare, and transportation industries – Main areas of concentration:  SAP BusinessObjects Migrations  Deployment, Installation, and Configuration of SAP BusinessObjects Enterprise  Data Visualization/Data Discovery  Reporting Best Practices  Business Analysis  Logical database design for reporting  Testing/Data Quality Management Sunday, February 03, 2013 7
  • 9.
    Key Improvements inBI 4.0 Integration • Connect across BI Tools using the same semantic layer • No longer need separate installs for Lifecycle Manager Performance • 64-bit O/S • Run BI suite with SAP HANA New Functionality • Explorer/Exploration Views • Visual Intelligence • Information Design Tool • Crystal Reports for Enterprise Better Administrative Tools • New Monitoring Features Enhancements • Web Intelligence • Dashboards (a.k.a. Xcelsius) • Crystal Reports 2011 Ease of Use • Common design experience across all BI tools (e.g. Excel vs. PowerPoint) • Common query panel across all reporting tools • Better Data Visuals (e.g. Chart Objects) Sunday, February 03, 2013 8
  • 10.
    Migration Methodology • Analysis and recommendations related to BI Assessment organization, process, and technology. Existing Deployment • Review of environment setup, inventory of reporting Assessment documents, and review of user activity profile. • Complete migration roadmap and detailed plans for Planning each phase. Installation & • Buildout of new environments, software Configuration installation, and customization. Migration & • Migration of existing content and conversion where Conversion necessary (i.e. DeskI). • Testing and validation of security model, targeted Testing content validation, and performance testing. • Comprehensive technical and end user training course Training are available. Sunday, February 03, 2013 9
  • 11.
    BI Assessment Based ona comprehensive analysis of the Current State, the Desired or Target State, and a Transition Plan or Roadmap to move from the former to the latter. Current Target Transition State State Plan Sunday, February 03, 2013 10
  • 12.
    Existing Deployment Assessment Following the Staged approach, we recommend taking each business area through the following stages: Comprehensive • Utilize tools in migration toolkit to get comprehensive list of Inventory SAP Business Objects documents Overlay Audit • Analyze usage data tied to inventory and look for opportunities Usage Data to eliminate or consolidate content Categorize • Give each document an ultimate disposition (eliminate, archive, Content consolidate, migrate, etc) • Ideally, the only content being migrated is that which is regularly Migrate to 4.0 used by the business or has another well defined and understood audience and purpose Sunday, February 03, 2013 11
  • 13.
    Analytics8 Migration Toolkit Existing SAP Business Objects Deployment Assessment – Analytics8 utilizes a comprehensive set of tools to provide a complete picture of your current environment. Stakeholder Migration • Environment details (servers, CPU, memory, OS, etc) Questionnaire • User activity profile (# users, tools used, methods used) • Comprehensive environment analysis System Profiler • Impact Analysis • Data Lineage • Metadata for non-repository documents Network Crawler • Includes all versions of DeskI and Crystal Auditor plugin for • Join SAP BusinessObjects metadata with auditor data • Provides insights into document usage and user activity System Profiler trends Repository Diagnostic • Identify inconsistencies between CMS and FRS Tool (RDT) Bulk Report • Compares report datasets pre- and post-migration Comparison Tool Sunday, February 03, 2013 12
  • 14.
    “House Cleaning” ExistingEnvironment Elimination - Stale content - Duplicate reports Initial Inventory 240,000 Documents ~ 80,000 Eliminated Archive - Existing content - Eliminate redundancy in “user ~ 60,000 Archived driven” archives/backups - Put in place ongoing archival process Consolidation expected Consolidate and to net ~4,000 Refine fewer documents Distinct Core Reports Final Inventory ~ 100,000 Documents Sunday, February 03, 2013 13
  • 15.
    How to IdentifyExcess or Obsolete Content This following can help identify content that may no longer be relevant ‒ Last refresh date ‒ List of reports that were run in the last 12 to 24 months ‒ Last login date of a user Conducting a S.W.O.T. analysis with the business users can yield a richer result, than analyzing the audit data. By engaging the business, it could result in indentifying redundant efforts, or establish BI initiatives that would immediately following the migration S = Strengths W = Weaknesses/Limitations O = Opportunities T = Threats 2/3/2013 14
  • 16.
    Upgrade Paths Upgrade fromthe following sources:  XI 3.x  XI R2 SP2 (or higher)  BIAR file generated from XI R2 SP2 (or higher, except BI 4.0 FP3) Upgrading from a BusinessObjects version prior to XI R2 SP2 will require to go through a multi-step upgrade path BOBJ 5/6 XI 3.1 BI 4.0 Sunday, February 03, 2013 15
  • 17.
    Planning Consider the followingwhen putting together a project plan: •What does my current BOBJ environment look like? Assessment •What issues (e.g. technical) are we struggling with? Time and •When can we start the project? •Are we passed the End of Life (EOL) date on our current Deadlines version? Resources •What internal/external resources do we need to be successful? Impact •Will the upgrade project impact any current developments? Training •Will our administrators and power users be able support the new version? 2/3/2013 16
  • 18.
    Installation & Configuration – Build and configure new environment(s) • Servers are now 64 bits only – Side-by-Side Deployment: Install 4.0 on the same machine(s) as the existing environment • Specify a different cluster name to avoid conflicts • For 4.0 use ports that are not used by the existing environment – Set-up and configure database for auditing • Auditor schema is new with 4.0 and is not directly compatible with prior versions of auditor. • In order to keep historical audit data, a new database instance will need to be created. Otherwise the existing audit data will be lost. – Separate installs for client tools, Explorer, & Live Office Sunday, February 03, 2013 17
  • 19.
    BI 4.0 MigrationPrep Checklist – If the existing environment is XIR2, confirm it is at least at SP2 level – Review the Product Availability Matrix (PAM) document to ensure compatibility with other technologies like operating systems, application servers, and web browsers – License Keys – Install Files • Includes the latest service packs and fix packs – Server with 64bit operating system installed • The account used must have Administration privileges Sunday, February 03, 2013 18
  • 20.
    BI 4.0 MigrationPrep Checklist Cont… – Separate database instance for CMS System and Audit data store • The account used must have privileges to create, modify, and delete tables, and to create stored procedures • 32-bit and 64-bit database drivers should be installed on the new BI 4.0 server(s) for both the CMS System, Audit, and reporting databases – Confirm location of NEW File Repository – Create a back up of the existing system DB and FRS prior to beginning the migration – Back up custom web applications, HTML pages, and scripts in your existing deployment Sunday, February 03, 2013 19
  • 21.
    BI Platform ComponentComparison Complexity XI R2 / XI 3.1 BI 4.0 * Audit New audit schema * InfoView BI Launch Pad ** Dashboard Builder BI Workspace N/A Encyclopedia / End of Life Discussion N/A Performance End of Life Manager * Universe Designer No Change * N/A Information Design Tool * Minor Effort ** Medium Effort *** Significant Effort Sunday, February 03, 2013 20
  • 22.
    BI Client Comparison Complexity XI R2 / XI 3.1 BI 4.0 * Crystal Reports CR 2011 and CR for Enterprise *** Desktop End of Life Intelligence * Xcelsius 2008 Dashboards ** Explorer No .unv support *** Voyager Analysis, edition for OLAP * Web Intelligence Web Intelligence * Minor Effort ** Medium Effort *** Significant Effort Sunday, February 03, 2013 21
  • 23.
    Desktop Intelligence Conversion BusinessObjectscomes with a Report Conversion Tool to convert DeskI over to WebI • OPTION 1: Isolate DeskI reports be either deleted or archived • OPTION 2: Consolidate with an existing WebI report(s) • OPTION 3: Convert DeskI using Report Conversion Tool in XI3.x or in BI 4.0 NOTE: The report conversion tool will provide one of three statuses for each report after it’s been converted: “Fully Converted”, “Partially Converted”, or “Not Converted”. There is an option to capture details about the conversion in a database. Sunday, February 03, 2013 22
  • 24.
    Complete vs. IncrementalUpgrades There are two common approaches to a migration: 1. Complete = migrating all BOBJ content at once ‒ Takes a shorter period of time compared to a incremental approach ‒ Best for smaller, less complex deployments 2. Incremental = migration in batches (i.e. department by department) ‒ Takes a longer period of time compared to the complete approach because time is spent to eliminate redundancies, and prioritize order of migration ‒ Best for larger, more complex deployments NOTE: The Upgrade Management Tool is used for moving content to 4.0. The tool does not copy server or server cluster settings so a manual configuration will have to be done in the 4.0 CMC. Sunday, February 03, 2013 23
  • 25.
    Testing This stage shouldbe conducted in two key areas: 1) After the 4.0 environment is installed and configured: – Ensure proper performance – Understand what impact there is to existing SDK code 2) After the migration and conversion – Performance • Does it meet current SLAs? • Can the new environment handle capacity? – Comparison • Utilize report comparison tool to automate the process of making sure the outputs are the same between environments – Security Model • Do I have less/to many rights? Sunday, February 03, 2013 24
  • 26.
    Bulk Report ComparisonTool Key Benefits BOBJ 3.1 BOBJ 4.0 Server Server – Allows automated comparisons of report datasets pre- and post-migration Reports Reports – Saves time and money by mechanizing report regression testing Key Features Automated Testing – Accesses report datasets through SDK, DB DB writes output to CSV and database – Allows for proof that reports produce exact same content in 3.1 and 4.0: – Dataset comparison (every column, every row, every data provider) – Rowcount comparison 2/3/2013 25
  • 27.
    Training – SAPCertified Training Partner – Most of the existing SAP BusinessObjects courses have been updated or are in the process of being updated for 4.0 where applicable – Special consideration should be given to training in the following areas given the amount of changes made in 4.0 • Web Intelligence – Full upgrade with dramatically changed interface • Information Design Tool – New semantic layer • Dashboards (formerly Xcelsius) – New connectivity functionality and features including some changes to the interface • Crystal Reports Enterprise – For customers wishing to abandon Crystal Reports 2011 and move to Enterprise Sunday, February 03, 2013 26
  • 28.
    Migration Best Practices ‒ “House Cleaning” Existing Environment : Example remove excess and obsolete reports ‒ Conduct S.W.O.T analysis with the business users ‒ Keep the original environment available long enough to compare to the new environment to ensure that the content was migrated successfully ‒ Go through a “practice run” of the migration ‒ Development should NOT be done on any 4.0 environment until the migration is complete ‒ Security = specify the new “owner right” for existing products, and set rights for new products (IDT, LCM, etc) Sunday, February 03, 2013 27
  • 29.
    Migration Best Practices ‒ Keep existing functionality as part of the migration, and any new functionality not currently implemented or was not available in a previous version will be evaluated after the migration ‒ Have a Test Strategy in place to ensure the migration was a success ‒ Understand what new functionalities are offered in 4.0 to prepare for next steps after the migration ‒ If architecting a clustered environment, make sure each server node works properly ‒ A simple way to conduct a performance test is by creating a publication that schedules the same set of reports in both the old environment and the 4.0 environment. This can be done during different times in a day to gauge performance. Sunday, February 03, 2013 28
  • 30.
    Questions? Thank you! Eric Molner Analytics8 500 N. Michigan Ave Suite 810 Chicago, IL 60611 T: 312 878 6600 F: 773 326 0749 www.Analytics8.com Sunday, February 03, 2013 29

Editor's Notes

  • #3 Services cover the end-to-end BI life cycle- from strategy to design, development, implementation, support, and training
  • #6 Not Just Technicians: Though we have deep technical skills, we understand that technology is just an enabler. We use it to solve business problems. Accelerated Time to Value: 30-day cycles, not 9-month cyclesEnd-to-End Expertise: Not only can we recommend the best solution, we can make it happen. Single-Source Solution: We consult, train, handle support, and even work with software vendors for you. Vendor Agnostic: We have deep skills with many tools and we can help you find the best one to satisfy your requirements. Industry-Specific Domain Knowledge: Associations,Finance, Healthcare, Insurance, Life Sciences, and Manufacturing Structured, but Flexible Project Delivery Methodology: Derived from MIKE 2.0 and PMP principles.
  • #17 A poor project plan will result in more time spent, and additional cost. Just like any other project.
