Flexible Budgets and
Overhead Analysis
Chapter
7
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill

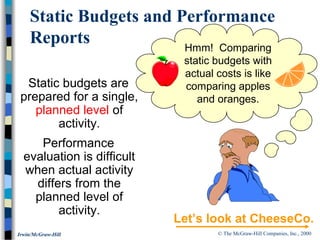

Static Budgets and Performance
Reports Hmm! Comparing
static budgets with
actual costs is like
comparing apples
and oranges.
Static budgets are
prepared for a single,
planned level of
activity.
Performance
evaluation is difficult
when actual activity
differs from the
planned level of
activity.
Let’s look at CheeseCo.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill

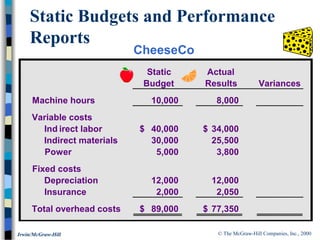

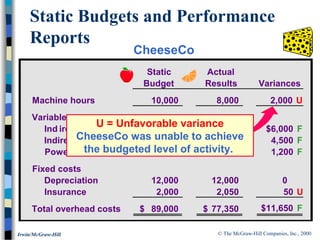

Static Actual
Budget Results Variances
Machine hours 10,000 8,000
Variable costs
Ind irect labor 40,000$ 34,000$
Indirect materials 30,000 25,500
Power 5,000 3,800
Fixed costs
Depreciation 12,000 12,000
Insurance 2,000 2,050
Total overhead costs 89,000$ 77,350$
Static Budgets and Performance
Reports
CheeseCo
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Static Actual
Budget Results Variances
Machine hours 10,000 8,000 2,000 U
Variable costs
Indirect labor 40,000$ 34,000$ $6,000 F
Indirect materials 30,000 25,500 4,500 F
Power 5,000 3,800 1,200 F
Fixed costs
Depreciation 12,000 12,000 0
Insurance 2,000 2,050 50 U
Total overhead costs 89,000$ 77,350$ $11,650 F
Static Actual
Budget Results Variances
Machine hours 10,000 8,000 2,000 U
Variable costs
Ind irect labor 40,000$ 34,000$ $6,000 F
Indirect materials 30,000 25,500 4,500 F
Power 5,000 3,800 1,200 F
Fixed costs
Depreciation 12,000 12,000 0
Insurance 2,000 2,050 50 U
Total overhead costs 89,000$ 77,350$ $11,650 F
Static Budgets and Performance
Reports
U = Unfavorable variance

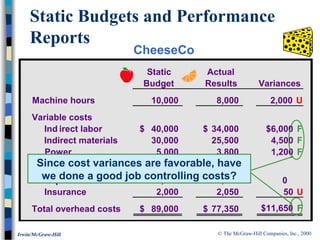

CheeseCo was unable to achieve
the budgeted level of activity.
CheeseCo
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Static Actual
Budget Results Variances
Machine hours 10,000 8,000 2,000 U
Variable costs
Indirect labor 40,000$ 34,000$ $6,000 F
Indirect materials 30,000 25,500 4,500 F
Power 5,000 3,800 1,200 F
Fixed costs
Depreciation 12,000 12,000 0
Insurance 2,000 2,050 50 U
Total overhead costs 89,000$ 77,350$ $11,650 F
Static Actual
Budget Results Variances
Machine hours 10,000 8,000 2,000 U
Variable costs
Ind irect labor 40,000$ 34,000$ $6,000 F
Indirect materials 30,000 25,500 4,500 F
Power 5,000 3,800 1,200 F
Fixed costs
Depreciation 12,000 12,000 0
Insurance 2,000 2,050 50 U
Total overhead costs 89,000$ 77,350$ $11,650 F
Static Budgets and Performance
Reports
F = Favorable variance that occurs when
actual costs are less than budgeted costs.
CheeseCo
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Static Actual
Budget Results Variances
Machine hours 10,000 8,000 2,000 U
Variable costs
Indirect labor 40,000$ 34,000$ $6,000 F
Indirect materials 30,000 25,500 4,500 F
Power 5,000 3,800 1,200 F
Fixed costs
Depreciation 12,000 12,000 0
Insurance 2,000 2,050 50 U
Total overhead costs 89,000$ 77,350$ $11,650 F
Static Actual
Budget Results Variances
Machine hours 10,000 8,000 2,000 U
Variable costs
Ind irect labor 40,000$ 34,000$ $6,000 F
Indirect materials 30,000 25,500 4,500 F
Power 5,000 3,800 1,200 F
Fixed costs
Depreciation 12,000 12,000 0
Insurance 2,000 2,050 50 U
Total overhead costs 89,000$ 77,350$ $11,650 F
Static Budgets and Performance
Reports
Since cost variances are favorable, have
we done a good job controlling costs?
CheeseCo
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Static Budgets and Performance
Reports
I don’t think I
can answer the
question using
a static budget.
Actual activity is below
budgeted activity which
is unfavorable.
So, shouldn’t variable costs
be lower if actual activity
is lower?
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill

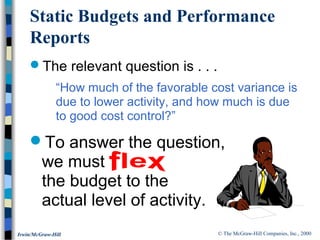

The relevant question is . . .
“How much of the favorable cost variance is
due to lower activity, and how much is due
to good cost control?”
To answer the question,
we must
the budget to the
actual level of activity.
Static Budgets and Performance
Reports
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill

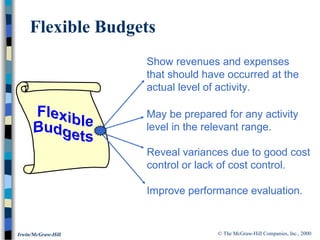

Flexible Budgets
Improve performance evaluation.
May be prepared for any activity
level in the relevant range.
Show revenues and expenses
that should have occurred at the
actual level of activity.
Reveal variances due to good cost
control or lack of cost control.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Flexible Budgets
Central Concept
If you can tell me what your activity was
for the period, I will tell you what your costs
and revenue should have been.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Preparing a Flexible Budget
To a budget we need to know that:
Total variable costs change
in direct proportion to
changes in activity.
Total fixed costs remain
unchanged within the
relevant range. Fixed
Variable
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Preparing a Flexible Budget
Let’s prepare
budgets
for CheeseCo.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill

Cost Total Flexible Budgets
Formula Fixed 8,000 10,000 12,000
Per Hour Cost Hours Hours Hours
Machine hours 8,000 10,000 12,000
Variable costs
Indirect labor 4.00 32,000$
Indirect material 3.00 24,000
Power 0.50 4,000
Total variable cost 7.50$ 60,000$
Fixed costs
Depreciation 12,000$
Insurance 2,000
Total fixed cost
Total overhead costs
Preparing a Flexible Budget
Fixed costs are
expressed as a
total amount.
Variable costs are expressed as
a constant amount per hour.
$40,000 ÷ 10,000 hours is
$4.00 per hour.
CheeseCo
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Cost Total Flexible Budgets
Formula Fixed 8,000 10,000 12,000
Per Hour Cost Hours Hours Hours
Machine hours 8,000 10,000 12,000
Variable costs
Indirect labor 4.00 32,000$
Indirect material 3.00 24,000
Power 0.50 4,000
Total variable cost 7.50$ 60,000$
Fixed costs
Depreciation 12,000$
Insurance 2,000
Total fixed cost
Total overhead costs
Preparing a Flexible Budget
$4.00 per hour × 8,000 hours = $32,000
CheeseCo
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Preparing a Flexible Budget
Cost Total Flexible Budgets
Formula Fixed 8,000 10,000 12,000
Per Hour Cost Hours Hours Hours
Machine hours 8,000 10,000 12,000
Variable costs
Indirect labor 4.00 32,000$ 40,000$ 48,000$
Indirect material 3.00 24,000 30,000 36,000
Power 0.50 4,000 5,000 6,000
Total variable cost 7.50$ 60,000$ 75,000$ 90,000$
Fixed costs
Depreciation 12,000$ 12,000$ 12,000$ 12,000$
Insurance 2,000 2,000 2,000 2,000
Total fixed cost 14,000$ 14,000$ 14,000$
Total overhead costs 74,000$ 89,000$ 104,000$
CheeseCo
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Preparing a Flexible Budget
Cost Total Flexible Budgets
Formula Fixed 8,000 10,000 12,000
Per Hour Cost Hours Hours Hours
Machine hours 8,000 10,000 12,000
Variable costs
Indirect labor 4.00 32,000$ 40,000$ 48,000$
Indirect material 3.00 24,000 30,000 36,000
Power 0.50 4,000 5,000 6,000
Total variable cost 7.50$ 60,000$ 75,000$ 90,000$
Fixed costs
Depreciation 12,000$ 12,000$ 12,000$ 12,000$
Insurance 2,000 2,000 2,000 2,000
Total fixed cost 14,000$ 14,000$ 14,000$
Total overhead costs 74,000$ 89,000$ 104,000$
Total fixed costs
do not change in
the relevant range.
CheeseCo
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Let’s prepare a
budget performance report
for CheeseCo.
Flexible Budget
Performance Report
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Cost Total
Formula Fixed Flexible Actual
Per Hour Costs Budget Results Variances
Machine hours 8,000 8,000 0
Variable costs
Indirect labor 4.00$ 32,000$ 34,000$
Indirect material 3.00 24,000 25,500
Power 0.50 4,000 3,800
Total variable costs 7.50$ 60,000$ 63,300$
Fixed Expenses
Depreciation 12,000$ 12,000$ 12,000$
Insurance 2,000 2,000 2,050
Total fixed costs 14,000$ 14,050$
Total overhead costs 74,000$ 77,350$
Flexible Budget
Performance Report
Flexible budget is
prepared for the
same activity level
(8,000 hours) as
actually achieved.
CheeseCo
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Cost Total
Formula Fixed Flexible Actual
Per Hour Costs Budget Results Variances
Machine hours 8,000 8,000 0
Variable costs
Indirect labor 4.00$ 32,000$ 34,000$ $ 2,000 U
Indirect material 3.00 24,000 25,500 1,500 U
Power 0.50 4,000 3,800 200 F
Total variable costs 7.50$ 60,000$ 63,300$ $ 3,300 U
Fixed Expenses
Depreciation 12,000$ 12,000$ 12,000$ 0
Insurance 2,000 2,000 2,050 50 U
Total fixed costs 14,000$ 14,050$ 50 U
Total overhead costs 74,000$ 77,350$ $ 3,350 U
Flexible Budget
Performance Report
CheeseCo
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Remember the question:
“How much of the totalvariance is due to activityand how much is due to
cost control?”
Flexible Budget
Performance Report
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill

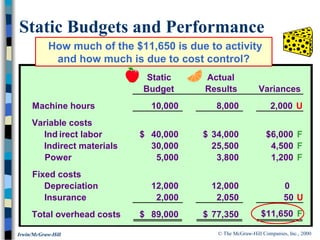

Static Actual
Budget Results Variances
Machine hours 10,000 8,000 2,000 U
Variable costs
Ind irect labor 40,000$ 34,000$ $6,000 F
Indirect materials 30,000 25,500 4,500 F
Power 5,000 3,800 1,200 F
Fixed costs
Depreciation 12,000 12,000 0
Insurance 2,000 2,050 50 U
Total overhead costs 89,000$ 77,350$ $11,650 F
Static Budgets and Performance
How much of the $11,650 is due to activity
and how much is due to cost control?
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Flexible Budget
Performance Report

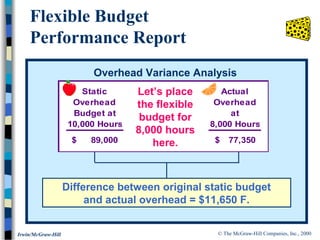

Difference between original static budget
and actual overhead = $11,650 F.
Overhead Variance Analysis
Static Actual
Overhead Overhead
Budget at at
10,000 Hours 8,000 Hours
89,000$ 77,350$
Let’s place
the flexible
budget for
8,000 hours
here.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill

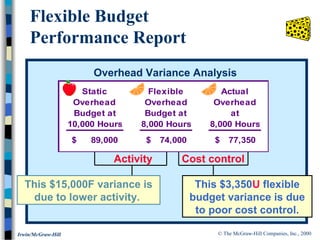

Flexible Budget
Performance Report
This $15,000F variance is
due to lower activity.
Overhead Variance Analysis
Activity
This $3,350U flexible
budget variance is due
to poor cost control.
Cost control
Static Flexible Actual
Overhead Overhead Overhead
Budget at Budget at at
10,000 Hours 8,000 Hours 8,000 Hours
89,000$ 74,000$ 77,350$
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Flexible Budget
Performance Report

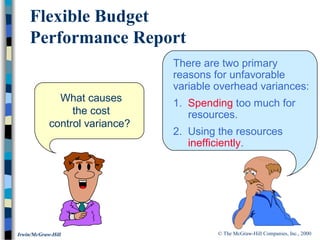

What causes
the cost
control variance?
There are two primary
reasons for unfavorable
variable overhead variances:
1. Spending too much for
resources.
2. Using the resources
inefficiently.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill

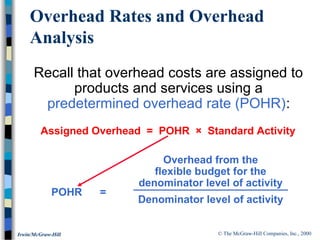

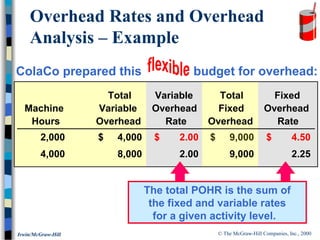

Overhead Rates and Overhead
Analysis
Overhead from the
flexible budget for the
denominator level of activity
POHR =
Recall that overhead costs are assigned to
products and services using a
predetermined overhead rate (POHR):
Assigned Overhead = POHR × Standard Activity
Denominator level of activity
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Overhead Rates and Overhead

Analysis – Example

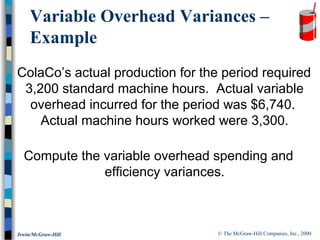

Let’s look at overhead
rates in a
budget for ColaCo.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
ColaCo prepared this budget for overhead:
Overhead Rates and Overhead
Analysis – Example
Total Variable Total Fixed
Machine Variable Overhead Fixed Overhead
Hours Overhead Rate Overhead Rate
2,000 4,000$ ? 9,000$ ?
4,000 8,000 ? 9,000 ?
ColaCo applies overhead based
on machine hour activity.
ColaCo applies overhead based
on machine hour activity.
Let’s calculate overhead rates.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Overhead Rates and Overhead
Analysis – Example
Rate = Total Variable Overhead ÷ Machine Hours
ColaCo prepared this budget for overhead:
This rate is constant at all levels of activity.
Total Variable Total Fixed
Machine Variable Overhead Fixed Overhead
Hours Overhead Rate Overhead Rate
2,000 4,000$ 2.00$ 9,000$ ?
4,000 8,000 2.00 9,000 ?
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Total Variable Total Fixed
Machine Variable Overhead Fixed Overhead
Hours Overhead Rate Overhead Rate
2,000 4,000$ 2.00$ 9,000$ 4.50$
4,000 8,000 2.00 9,000 2.25
Overhead Rates and Overhead
Analysis – Example
Rate = Total Fixed Overhead ÷ Machine Hours
ColaCo prepared this budget for overhead:
This rate decreases when activity increases.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Total Variable Total Fixed
Machine Variable Overhead Fixed Overhead
Hours Overhead Rate Overhead Rate
2,000 4,000$ 2.00$ 9,000$ 4.50$
4,000 8,000 2.00 9,000 2.25
Overhead Rates and Overhead
Analysis – Example
The total POHR is the sum of
the fixed and variable rates
for a given activity level.
ColaCo prepared this budget for overhead:
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Overhead Variances
Let’s use the
overhead rates, to
determine variable
and fixed overhead
variances.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
ColaCo’s actual production for the period required
3,200 standard machine hours. Actual variable
overhead incurred for the period was $6,740.
Actual machine hours worked were 3,300.
Compute the variable overhead spending and
efficiency variances.
Variable Overhead Variances –
Example
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Variable Overhead Variances
AH × SRAH × AR
Spending variance = AH(AR - SR)
Efficiency variance = SR(AH - SH)
SH × SR
Spending
Variance
Efficiency
Variance
Actual Flexible Budget Flexible Budget
Variable for Variable for Variable
Overhead Overhead at Overhead at
Incurred Actual Hours Standard Hours
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
3,300 hours 3,200 hours
× ×
$2.00 per hour $2.00 per hour
Variable Overhead Variances –
Example
Actual Flexible Budget Flexible Budget
Variable for Variable for Variable
Overhead Overhead at Overhead at
Incurred Actual Hours Standard Hours
$6,740 $6,600 $6,400
Spending variance
$140 unfavorable
Efficiency variance
$200 unfavorable
$340 unfavorable flexible budget total variance$340 unfavorable flexible budget total variance
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Variable Overhead Variances – A
Closer Look
Spending Variance Efficiency Variance
Results from paying more
or less than expected for
overhead items and from
excessive usage of
overhead items.
Controlled by
managing the
overhead cost driver.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Overhead Variances
Now let’s turn
our attention
to fixed
overhead.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Overhead Rates and Overhead
Analysis – Example
ColaCo prepared this budget for overhead:
What is ColaCo’s fixed overhead rate for an
estimated activity of 3,000 machine hours?
Total Variable Total Fixed
Machine Variable Overhead Fixed Overhead
Hours Overhead Rate Overhead Rate
2,000 4,000$ 2.00$ 9,000$ 4.50$
4,000 8,000 2.00 9,000 2.25
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Overhead Rates and Overhead
Analysis – Example
ColaCo prepared this budget for overhead:
What is ColaCo’s fixed overhead rate for an
estimated activity of 3,000 machine hours?
Fixed Overhead Rate
FR = $9,000 ÷ 3,000 machine hours
FR = $3.00 per machine hour
Total Variable Total Fixed
Machine Variable Overhead Fixed Overhead
Hours Overhead Rate Overhead Rate
2,000 4,000$ 2.00$ 9,000$ 4.50$
4,000 8,000 2.00 9,000 2.25
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
ColaCo’s actual production required 3,200
standard machine hours. Actual fixed overhead
was $8,450.
Compute the fixed overhead budget and volume
variances.
Fixed Overhead Variances –
Example
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill

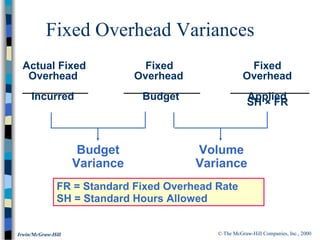

Fixed Overhead Variances
Budget
Variance
Volume
Variance
FR = Standard Fixed Overhead Rate
SH = Standard Hours Allowed
SH × FR
Actual Fixed Fixed Fixed
Overhead Overhead Overhead
Incurred Budget Applied
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
3,200 hours
×
$3.00 per hour
Budget variance
$550 favorable
Fixed Overhead Variances –

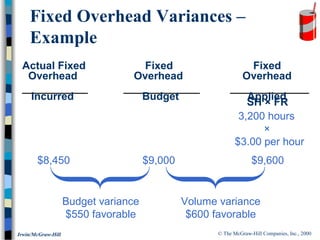

Example
$8,450 $9,000 $9,600
Actual Fixed Fixed Fixed
Overhead Overhead Overhead
Incurred Budget Applied
Volume variance
$600 favorable
SH × FR
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Fixed Overhead Variances –
A Closer Look
Budget Variance Volume Variance
Results from paying more
or less than expected for
overhead items.
Results from operating
at an activity level
different from the
denominator activity.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Overhead Variances
Let’s look at a
graph showing
fixed overhead
variances. We will
use ColaCo’s
numbers from the
previous example.
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Volume
Cost
3,200
Standard
Hours
3,000 Hours
Expected
Activity
Fixed Overhead Variances
Fixed overhead
applied to products
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill

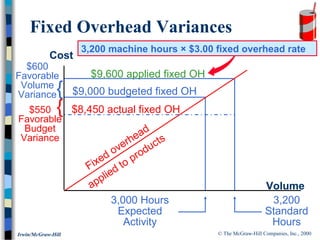

Fixed Overhead Variances
$8,450 actual fixed OH
Volume
Cost
$9,600 applied fixed OH
$9,000 budgeted fixed OH
3,200
Standard
Hours
3,000 Hours
Expected
Activity
Fixed overhead
applied to products
3,200 machine hours × $3.00 fixed overhead rate
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
{
$600
Favorable
Volume
Variance
Fixed Overhead Variances
{$550
Favorable
Budget
Variance
$8,450 actual fixed OH$8,450 actual fixed OH
Volume
Cost
$9,600 applied fixed OH
$9,000 budgeted fixed OH
3,200
Standard
Hours
3,000 Hours
Expected
Activity
Fixed overhead
applied to products
3,200 machine hours × $3.00 fixed overhead rate
{
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Results when standard hours
allowed for actual output differs
from the denominator activity.
Volume Variance – A Closer Look
Volume
Variance
Favorable
when standard hours
> denominator hours
Unfavorable
when standard hours
< denominator hours
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Results when standard hours
allowed for actual output differs
from the denominator activity.
Volume Variance – A Closer Look
Volume
Variance
Favorable
when standard hours
> denominator hours
Unfavorable
when standard hours
< denominator hours
Does not measure over-
or under spending
Explainable by and
controllable only through
activity
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
Overhead Variances and Under- or
Overapplied Overhead Cost
The sum of the overhead variances
equals the under- or overapplied
overhead cost for a period.
Favorable
variances are equivalent
to overapplied overhead.
Unfavorable
variances are equivalent
to underapplied overhead.
In a standard
cost system:
© The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill
End of Chapter 11
I’m here to your
budget. Are you ready to
ante up?

More Related Content

What's hot

Chapter 6 Connect Quiz (Variable Costing and Segment Reporting:Tools for Mana...
Chapter 6 Connect Quiz (Variable Costing and Segment Reporting:Tools for Mana...Chapter 6 Connect Quiz (Variable Costing and Segment Reporting:Tools for Mana...
Chapter 6 Connect Quiz (Variable Costing and Segment Reporting:Tools for Mana...
Emily Bauer

3. Analisi delle Spese Generali e Budget Flessibile
3. Analisi delle Spese Generali e Budget Flessibile3. Analisi delle Spese Generali e Budget Flessibile
3. Analisi delle Spese Generali e Budget Flessibile
Manager.it

Cost accounting sample assignment help
Cost accounting sample assignment helpCost accounting sample assignment help
Cost accounting sample assignment help
Expertsmind IT Education Pvt Ltd.

1. Budget Statico e Consuntivi
1. Budget Statico e Consuntivi1. Budget Statico e Consuntivi
1. Budget Statico e Consuntivi
Manager.it

Gnb 02 12e
Gnb 02 12eGnb 02 12e
Gnb 02 12e
Saif Mahmud

Gnb 05 12e
Gnb 05 12eGnb 05 12e
Gnb 05 12e
Saif Mahmud

Cost accounting (Hypothetical problems of labor costing and solution of these...
Cost accounting (Hypothetical problems of labor costing and solution of these...Cost accounting (Hypothetical problems of labor costing and solution of these...
Cost accounting (Hypothetical problems of labor costing and solution of these...
Md. Shamim Ahmed

Acc 349 final_exam
Acc 349 final_examAcc 349 final_exam
Acc 349 final_exam
supportonlineexam11

Managerial Accounting in class exercise chapter 4 solution
Managerial Accounting in class exercise chapter 4 solutionManagerial Accounting in class exercise chapter 4 solution
Managerial Accounting in class exercise chapter 4 solution
Helen Wong

Chapter 12 var
Chapter 12 varChapter 12 var
Chapter 12 var
Muhammad Irfan

Manufacturinf overhead variance
Manufacturinf overhead varianceManufacturinf overhead variance
Manufacturinf overhead variance
employee goverment

Activity based costing & activity based management
Activity  based costing & activity based managementActivity  based costing & activity based management
Activity based costing & activity based management
Piyush Gaur

B5 vc alat_mjn
B5 vc alat_mjnB5 vc alat_mjn
B5 vc alat_mjn
Sejahtera Affif

Running head group case 1
Running head group case 1                                       Running head group case 1
Running head group case 1
DIPESH30

Practice topic 9 - answers (1)
Practice   topic 9 - answers (1)Practice   topic 9 - answers (1)
Practice topic 9 - answers (1)
IrfanKhan679364

Cost_sample
Cost_sampleCost_sample
Cost_sample
ahmad bassiouny

What's hot (16)

Chapter 6 Connect Quiz (Variable Costing and Segment Reporting:Tools for Mana...
Chapter 6 Connect Quiz (Variable Costing and Segment Reporting:Tools for Mana...Chapter 6 Connect Quiz (Variable Costing and Segment Reporting:Tools for Mana...
Chapter 6 Connect Quiz (Variable Costing and Segment Reporting:Tools for Mana...

3. Analisi delle Spese Generali e Budget Flessibile
3. Analisi delle Spese Generali e Budget Flessibile3. Analisi delle Spese Generali e Budget Flessibile
3. Analisi delle Spese Generali e Budget Flessibile

Cost accounting sample assignment help
Cost accounting sample assignment helpCost accounting sample assignment help
Cost accounting sample assignment help

1. Budget Statico e Consuntivi
1. Budget Statico e Consuntivi1. Budget Statico e Consuntivi
1. Budget Statico e Consuntivi

Gnb 02 12e
Gnb 02 12eGnb 02 12e
Gnb 02 12e

Gnb 05 12e
Gnb 05 12eGnb 05 12e
Gnb 05 12e

Cost accounting (Hypothetical problems of labor costing and solution of these...
Cost accounting (Hypothetical problems of labor costing and solution of these...Cost accounting (Hypothetical problems of labor costing and solution of these...
Cost accounting (Hypothetical problems of labor costing and solution of these...

Acc 349 final_exam
Acc 349 final_examAcc 349 final_exam
Acc 349 final_exam

Managerial Accounting in class exercise chapter 4 solution
Managerial Accounting in class exercise chapter 4 solutionManagerial Accounting in class exercise chapter 4 solution
Managerial Accounting in class exercise chapter 4 solution

Chapter 12 var
Chapter 12 varChapter 12 var
Chapter 12 var

Manufacturinf overhead variance
Manufacturinf overhead varianceManufacturinf overhead variance
Manufacturinf overhead variance

Activity based costing & activity based management
Activity  based costing & activity based managementActivity  based costing & activity based management
Activity based costing & activity based management

B5 vc alat_mjn
B5 vc alat_mjnB5 vc alat_mjn
B5 vc alat_mjn

Running head group case 1
Running head group case 1                                       Running head group case 1
Running head group case 1

Practice topic 9 - answers (1)
Practice   topic 9 - answers (1)Practice   topic 9 - answers (1)
Practice topic 9 - answers (1)

Cost_sample
Cost_sampleCost_sample
Cost_sample

Viewers also liked

Pp4 2014-penyelenggaraan-pendidikan-tinggi-pengelolaan-perguruan-tinggi
Pp4 2014-penyelenggaraan-pendidikan-tinggi-pengelolaan-perguruan-tinggiPp4 2014-penyelenggaraan-pendidikan-tinggi-pengelolaan-perguruan-tinggi
Pp4 2014-penyelenggaraan-pendidikan-tinggi-pengelolaan-perguruan-tinggi
Sejahtera Affif

Cara ternak belut di rumah
Cara ternak belut di rumahCara ternak belut di rumah
Cara ternak belut di rumah
Sejahtera Affif

Rpp bhs-arab-xii-smt-2
Rpp bhs-arab-xii-smt-2Rpp bhs-arab-xii-smt-2
Rpp bhs-arab-xii-smt-2
Sejahtera Affif

Affif soal lct sd
Affif soal lct sdAffif soal lct sd
Affif soal lct sd
Sejahtera Affif

Cscu module 08 securing online transactions
Cscu module 08 securing online transactionsCscu module 08 securing online transactions
Cscu module 08 securing online transactions
Sejahtera Affif

Helping dad
Helping dadHelping dad
Helping dad
Clarivon

Is it time_to_own_your_network2
Is it time_to_own_your_network2Is it time_to_own_your_network2
Is it time_to_own_your_network2
Clarivon

Affif bab2
Affif bab2Affif bab2
Affif bab2
Sejahtera Affif

Affif cara membuat form login pada php
Affif cara membuat form login pada phpAffif cara membuat form login pada php
Affif cara membuat form login pada php
Sejahtera Affif

Ap m2 ak sumber dana
Ap m2 ak sumber danaAp m2 ak sumber dana
Ap m2 ak sumber dana
Sejahtera Affif

S jkr 0704960_chapter1
S jkr 0704960_chapter1S jkr 0704960_chapter1
S jkr 0704960_chapter1
Sejahtera Affif

Affif bahasa arab
Affif bahasa arabAffif bahasa arab
Affif bahasa arab
Sejahtera Affif

09 e02819
09 e0281909 e02819
09 e02819
Sejahtera Affif

Test presentationwithsound
Test presentationwithsoundTest presentationwithsound
Test presentationwithsound
ayshahsheikh

Cscu module 01 foundations of security
Cscu module 01 foundations of securityCscu module 01 foundations of security
Cscu module 01 foundations of security
Sejahtera Affif

Viewers also liked (15)

Pp4 2014-penyelenggaraan-pendidikan-tinggi-pengelolaan-perguruan-tinggi
Pp4 2014-penyelenggaraan-pendidikan-tinggi-pengelolaan-perguruan-tinggiPp4 2014-penyelenggaraan-pendidikan-tinggi-pengelolaan-perguruan-tinggi
Pp4 2014-penyelenggaraan-pendidikan-tinggi-pengelolaan-perguruan-tinggi

Cara ternak belut di rumah
Cara ternak belut di rumahCara ternak belut di rumah
Cara ternak belut di rumah

Rpp bhs-arab-xii-smt-2
Rpp bhs-arab-xii-smt-2Rpp bhs-arab-xii-smt-2
Rpp bhs-arab-xii-smt-2

Affif soal lct sd
Affif soal lct sdAffif soal lct sd
Affif soal lct sd

Cscu module 08 securing online transactions
Cscu module 08 securing online transactionsCscu module 08 securing online transactions
Cscu module 08 securing online transactions

Helping dad
Helping dadHelping dad
Helping dad

Is it time_to_own_your_network2
Is it time_to_own_your_network2Is it time_to_own_your_network2
Is it time_to_own_your_network2

Affif bab2
Affif bab2Affif bab2
Affif bab2

Affif cara membuat form login pada php
Affif cara membuat form login pada phpAffif cara membuat form login pada php
Affif cara membuat form login pada php

Ap m2 ak sumber dana
Ap m2 ak sumber danaAp m2 ak sumber dana
Ap m2 ak sumber dana

S jkr 0704960_chapter1
S jkr 0704960_chapter1S jkr 0704960_chapter1
S jkr 0704960_chapter1

Affif bahasa arab
Affif bahasa arabAffif bahasa arab
Affif bahasa arab

09 e02819
09 e0281909 e02819
09 e02819

Test presentationwithsound
Test presentationwithsoundTest presentationwithsound
Test presentationwithsound

Cscu module 01 foundations of security
Cscu module 01 foundations of securityCscu module 01 foundations of security
Cscu module 01 foundations of security

Similar to B7 flexi budget

Flexible budget (Management Accounting)
Flexible budget (Management Accounting)Flexible budget (Management Accounting)
Flexible budget (Management Accounting)
Abdul Basit

Management Accounting (Flexible budget)
Management Accounting (Flexible budget)Management Accounting (Flexible budget)
Management Accounting (Flexible budget)
Abdul Basit

chap11notes.pdf
chap11notes.pdfchap11notes.pdf
chap11notes.pdf
Ellamae79

Cost Sample
Cost SampleCost Sample
Cost Sample
ahmad bassiouny

Managerial Accounting Garrison Noreen Brewer Chapter 07
Managerial Accounting Garrison Noreen Brewer Chapter 07Managerial Accounting Garrison Noreen Brewer Chapter 07
Managerial Accounting Garrison Noreen Brewer Chapter 07
Asif Hasan

Variance Analysis.pptx
 Variance Analysis.pptx Variance Analysis.pptx
Variance Analysis.pptx
VrutikJentibhaiSangh

chap07notes.pdf
chap07notes.pdfchap07notes.pdf
chap07notes.pdf
Ellamae79

Variable costing a tool for management
Variable costing a tool for managementVariable costing a tool for management
Variable costing a tool for management
Muhammad Sario

B8 relevan cost
B8 relevan costB8 relevan cost
B8 relevan cost
Sejahtera Affif

Actual Cost Vs Plan Projection Powerpoint Presentation Slides
Actual Cost Vs Plan Projection Powerpoint Presentation SlidesActual Cost Vs Plan Projection Powerpoint Presentation Slides
Actual Cost Vs Plan Projection Powerpoint Presentation Slides
SlideTeam

Actual Cost Vs Budget Powerpoint Presentation Slides
Actual Cost Vs Budget Powerpoint Presentation SlidesActual Cost Vs Budget Powerpoint Presentation Slides
Actual Cost Vs Budget Powerpoint Presentation Slides
SlideTeam

Actual Cost Vs Budget PowerPoint Presentation Slides
Actual Cost Vs Budget PowerPoint Presentation Slides Actual Cost Vs Budget PowerPoint Presentation Slides
Actual Cost Vs Budget PowerPoint Presentation Slides
SlideTeam

Manufacturing cost accounting ppt @ mba finance
Manufacturing cost accounting ppt @ mba financeManufacturing cost accounting ppt @ mba finance
Manufacturing cost accounting ppt @ mba finance
Babasab Patil

Actual Cost Vs Plan Projection PowerPoint Presentation Slides
Actual Cost Vs Plan Projection PowerPoint Presentation Slides Actual Cost Vs Plan Projection PowerPoint Presentation Slides
Actual Cost Vs Plan Projection PowerPoint Presentation Slides
SlideTeam

yuty
yutyyuty
Actual Vs Budget Variance PowerPoint Presentation Slides
Actual Vs Budget Variance PowerPoint Presentation SlidesActual Vs Budget Variance PowerPoint Presentation Slides
Actual Vs Budget Variance PowerPoint Presentation Slides
SlideTeam

Plan Vs Forecast PowerPoint Presentation Slides
Plan Vs Forecast PowerPoint Presentation SlidesPlan Vs Forecast PowerPoint Presentation Slides
Plan Vs Forecast PowerPoint Presentation Slides
SlideTeam

Cost Vs Budget PowerPoint Presentation Slides
Cost Vs Budget PowerPoint Presentation SlidesCost Vs Budget PowerPoint Presentation Slides
Cost Vs Budget PowerPoint Presentation Slides
SlideTeam

Horngrenima14e ch13
Horngrenima14e ch13Horngrenima14e ch13
Horngrenima14e ch13
Anchit Jain

The Changing Role of Managerial Accounting in a GLOBAL Business Environment
The Changing Role of Managerial Accounting in a GLOBAL Business EnvironmentThe Changing Role of Managerial Accounting in a GLOBAL Business Environment
The Changing Role of Managerial Accounting in a GLOBAL Business Environment
Abdullah Rabaya

Similar to B7 flexi budget (20)

Flexible budget (Management Accounting)
Flexible budget (Management Accounting)Flexible budget (Management Accounting)
Flexible budget (Management Accounting)

Management Accounting (Flexible budget)
Management Accounting (Flexible budget)Management Accounting (Flexible budget)
Management Accounting (Flexible budget)

chap11notes.pdf
chap11notes.pdfchap11notes.pdf
chap11notes.pdf

Cost Sample
Cost SampleCost Sample
Cost Sample

Managerial Accounting Garrison Noreen Brewer Chapter 07
Managerial Accounting Garrison Noreen Brewer Chapter 07Managerial Accounting Garrison Noreen Brewer Chapter 07
Managerial Accounting Garrison Noreen Brewer Chapter 07

Variance Analysis.pptx
 Variance Analysis.pptx Variance Analysis.pptx
Variance Analysis.pptx

chap07notes.pdf
chap07notes.pdfchap07notes.pdf
chap07notes.pdf

Variable costing a tool for management
Variable costing a tool for managementVariable costing a tool for management
Variable costing a tool for management

B8 relevan cost
B8 relevan costB8 relevan cost
B8 relevan cost

Actual Cost Vs Plan Projection Powerpoint Presentation Slides
Actual Cost Vs Plan Projection Powerpoint Presentation SlidesActual Cost Vs Plan Projection Powerpoint Presentation Slides
Actual Cost Vs Plan Projection Powerpoint Presentation Slides

Actual Cost Vs Budget Powerpoint Presentation Slides
Actual Cost Vs Budget Powerpoint Presentation SlidesActual Cost Vs Budget Powerpoint Presentation Slides
Actual Cost Vs Budget Powerpoint Presentation Slides

Actual Cost Vs Budget PowerPoint Presentation Slides
Actual Cost Vs Budget PowerPoint Presentation Slides Actual Cost Vs Budget PowerPoint Presentation Slides
Actual Cost Vs Budget PowerPoint Presentation Slides

Manufacturing cost accounting ppt @ mba finance
Manufacturing cost accounting ppt @ mba financeManufacturing cost accounting ppt @ mba finance
Manufacturing cost accounting ppt @ mba finance

Actual Cost Vs Plan Projection PowerPoint Presentation Slides
Actual Cost Vs Plan Projection PowerPoint Presentation Slides Actual Cost Vs Plan Projection PowerPoint Presentation Slides
Actual Cost Vs Plan Projection PowerPoint Presentation Slides

yuty
yutyyuty
yuty

Actual Vs Budget Variance PowerPoint Presentation Slides
Actual Vs Budget Variance PowerPoint Presentation SlidesActual Vs Budget Variance PowerPoint Presentation Slides
Actual Vs Budget Variance PowerPoint Presentation Slides

Plan Vs Forecast PowerPoint Presentation Slides
Plan Vs Forecast PowerPoint Presentation SlidesPlan Vs Forecast PowerPoint Presentation Slides
Plan Vs Forecast PowerPoint Presentation Slides

Cost Vs Budget PowerPoint Presentation Slides
Cost Vs Budget PowerPoint Presentation SlidesCost Vs Budget PowerPoint Presentation Slides
Cost Vs Budget PowerPoint Presentation Slides

Horngrenima14e ch13
Horngrenima14e ch13Horngrenima14e ch13
Horngrenima14e ch13

The Changing Role of Managerial Accounting in a GLOBAL Business Environment
The Changing Role of Managerial Accounting in a GLOBAL Business EnvironmentThe Changing Role of Managerial Accounting in a GLOBAL Business Environment
The Changing Role of Managerial Accounting in a GLOBAL Business Environment

Recently uploaded

How MJ Global Leads the Packaging Industry.pdf
How MJ Global Leads the Packaging Industry.pdfHow MJ Global Leads the Packaging Industry.pdf
How MJ Global Leads the Packaging Industry.pdf
MJ Global

Company Valuation webinar series - Tuesday, 4 June 2024
Company Valuation webinar series - Tuesday, 4 June 2024Company Valuation webinar series - Tuesday, 4 June 2024
Company Valuation webinar series - Tuesday, 4 June 2024
FelixPerez547899

How to Implement a Strategy: Transform Your Strategy with BSC Designer's Comp...
How to Implement a Strategy: Transform Your Strategy with BSC Designer's Comp...How to Implement a Strategy: Transform Your Strategy with BSC Designer's Comp...
How to Implement a Strategy: Transform Your Strategy with BSC Designer's Comp...
Aleksey Savkin

Part 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 SlowdownPart 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 Slowdown
jeffkluth1

Income Tax exemption for Start up : Section 80 IAC
Income Tax  exemption for Start up : Section 80 IACIncome Tax  exemption for Start up : Section 80 IAC
Income Tax exemption for Start up : Section 80 IAC
CA Dr. Prithvi Ranjan Parhi

Innovation Management Frameworks: Your Guide to Creativity & Innovation
Innovation Management Frameworks: Your Guide to Creativity & InnovationInnovation Management Frameworks: Your Guide to Creativity & Innovation
Innovation Management Frameworks: Your Guide to Creativity & Innovation
Operational Excellence Consulting

Chapter 7 Final business management sciences .ppt
Chapter 7 Final business management sciences .pptChapter 7 Final business management sciences .ppt
Chapter 7 Final business management sciences .ppt
ssuser567e2d

Taurus Zodiac Sign: Unveiling the Traits, Dates, and Horoscope Insights of th...
Taurus Zodiac Sign: Unveiling the Traits, Dates, and Horoscope Insights of th...Taurus Zodiac Sign: Unveiling the Traits, Dates, and Horoscope Insights of th...
Taurus Zodiac Sign: Unveiling the Traits, Dates, and Horoscope Insights of th...
my Pandit

Dpboss Matka Guessing Satta Matta Matka Kalyan Chart Satta Matka
Dpboss Matka Guessing Satta Matta Matka Kalyan Chart Satta MatkaDpboss Matka Guessing Satta Matta Matka Kalyan Chart Satta Matka
Dpboss Matka Guessing Satta Matta Matka Kalyan Chart Satta Matka
➒➌➎➏➑➐➋➑➐➐Dpboss Matka Guessing Satta Matka Kalyan Chart Indian Matka

2024-6-01-IMPACTSilver-Corp-Presentation.pdf
2024-6-01-IMPACTSilver-Corp-Presentation.pdf2024-6-01-IMPACTSilver-Corp-Presentation.pdf
2024-6-01-IMPACTSilver-Corp-Presentation.pdf
hartfordclub1

Top mailing list providers in the USA.pptx
Top mailing list providers in the USA.pptxTop mailing list providers in the USA.pptx
Top mailing list providers in the USA.pptx
JeremyPeirce1

Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
my Pandit

The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...
The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...
The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...
Stephen Cashman

Call 8867766396 Satta Matka Dpboss Matka Guessing Satta batta Matka 420 Satta...
Call 8867766396 Satta Matka Dpboss Matka Guessing Satta batta Matka 420 Satta...Call 8867766396 Satta Matka Dpboss Matka Guessing Satta batta Matka 420 Satta...
Call 8867766396 Satta Matka Dpboss Matka Guessing Satta batta Matka 420 Satta...
bosssp10

Event Report - SAP Sapphire 2024 Orlando - lots of innovation and old challenges
Event Report - SAP Sapphire 2024 Orlando - lots of innovation and old challengesEvent Report - SAP Sapphire 2024 Orlando - lots of innovation and old challenges
Event Report - SAP Sapphire 2024 Orlando - lots of innovation and old challenges
Holger Mueller

amptalk_RecruitingDeck_english_2024.06.05
amptalk_RecruitingDeck_english_2024.06.05amptalk_RecruitingDeck_english_2024.06.05
amptalk_RecruitingDeck_english_2024.06.05
marketing317746

Organizational Change Leadership Agile Tour Geneve 2024
Organizational Change Leadership Agile Tour Geneve 2024Organizational Change Leadership Agile Tour Geneve 2024
Organizational Change Leadership Agile Tour Geneve 2024
Kirill Klimov

The Genesis of BriansClub.cm Famous Dark WEb Platform
The Genesis of BriansClub.cm Famous Dark WEb PlatformThe Genesis of BriansClub.cm Famous Dark WEb Platform
The Genesis of BriansClub.cm Famous Dark WEb Platform
SabaaSudozai

Mastering B2B Payments Webinar from BlueSnap
Mastering B2B Payments Webinar from BlueSnapMastering B2B Payments Webinar from BlueSnap
Mastering B2B Payments Webinar from BlueSnap
Norma Mushkat Gaffin

-- June 2024 is National Volunteer Month --
-- June 2024 is National Volunteer Month ---- June 2024 is National Volunteer Month --
-- June 2024 is National Volunteer Month --
NZSG

Recently uploaded (20)

How MJ Global Leads the Packaging Industry.pdf
How MJ Global Leads the Packaging Industry.pdfHow MJ Global Leads the Packaging Industry.pdf
How MJ Global Leads the Packaging Industry.pdf

Company Valuation webinar series - Tuesday, 4 June 2024
Company Valuation webinar series - Tuesday, 4 June 2024Company Valuation webinar series - Tuesday, 4 June 2024
Company Valuation webinar series - Tuesday, 4 June 2024

How to Implement a Strategy: Transform Your Strategy with BSC Designer's Comp...
How to Implement a Strategy: Transform Your Strategy with BSC Designer's Comp...How to Implement a Strategy: Transform Your Strategy with BSC Designer's Comp...
How to Implement a Strategy: Transform Your Strategy with BSC Designer's Comp...

Part 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 SlowdownPart 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 Slowdown

Income Tax exemption for Start up : Section 80 IAC
Income Tax  exemption for Start up : Section 80 IACIncome Tax  exemption for Start up : Section 80 IAC
Income Tax exemption for Start up : Section 80 IAC

Innovation Management Frameworks: Your Guide to Creativity & Innovation
Innovation Management Frameworks: Your Guide to Creativity & InnovationInnovation Management Frameworks: Your Guide to Creativity & Innovation
Innovation Management Frameworks: Your Guide to Creativity & Innovation

Chapter 7 Final business management sciences .ppt
Chapter 7 Final business management sciences .pptChapter 7 Final business management sciences .ppt
Chapter 7 Final business management sciences .ppt

Taurus Zodiac Sign: Unveiling the Traits, Dates, and Horoscope Insights of th...
Taurus Zodiac Sign: Unveiling the Traits, Dates, and Horoscope Insights of th...Taurus Zodiac Sign: Unveiling the Traits, Dates, and Horoscope Insights of th...
Taurus Zodiac Sign: Unveiling the Traits, Dates, and Horoscope Insights of th...

Dpboss Matka Guessing Satta Matta Matka Kalyan Chart Satta Matka
Dpboss Matka Guessing Satta Matta Matka Kalyan Chart Satta MatkaDpboss Matka Guessing Satta Matta Matka Kalyan Chart Satta Matka
Dpboss Matka Guessing Satta Matta Matka Kalyan Chart Satta Matka

2024-6-01-IMPACTSilver-Corp-Presentation.pdf
2024-6-01-IMPACTSilver-Corp-Presentation.pdf2024-6-01-IMPACTSilver-Corp-Presentation.pdf
2024-6-01-IMPACTSilver-Corp-Presentation.pdf

Top mailing list providers in the USA.pptx
Top mailing list providers in the USA.pptxTop mailing list providers in the USA.pptx
Top mailing list providers in the USA.pptx

Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...

The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...
The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...
The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...

Call 8867766396 Satta Matka Dpboss Matka Guessing Satta batta Matka 420 Satta...
Call 8867766396 Satta Matka Dpboss Matka Guessing Satta batta Matka 420 Satta...Call 8867766396 Satta Matka Dpboss Matka Guessing Satta batta Matka 420 Satta...
Call 8867766396 Satta Matka Dpboss Matka Guessing Satta batta Matka 420 Satta...

Event Report - SAP Sapphire 2024 Orlando - lots of innovation and old challenges
Event Report - SAP Sapphire 2024 Orlando - lots of innovation and old challengesEvent Report - SAP Sapphire 2024 Orlando - lots of innovation and old challenges
Event Report - SAP Sapphire 2024 Orlando - lots of innovation and old challenges

amptalk_RecruitingDeck_english_2024.06.05
amptalk_RecruitingDeck_english_2024.06.05amptalk_RecruitingDeck_english_2024.06.05
amptalk_RecruitingDeck_english_2024.06.05

Organizational Change Leadership Agile Tour Geneve 2024
Organizational Change Leadership Agile Tour Geneve 2024Organizational Change Leadership Agile Tour Geneve 2024
Organizational Change Leadership Agile Tour Geneve 2024

The Genesis of BriansClub.cm Famous Dark WEb Platform
The Genesis of BriansClub.cm Famous Dark WEb PlatformThe Genesis of BriansClub.cm Famous Dark WEb Platform
The Genesis of BriansClub.cm Famous Dark WEb Platform

Mastering B2B Payments Webinar from BlueSnap
Mastering B2B Payments Webinar from BlueSnapMastering B2B Payments Webinar from BlueSnap
Mastering B2B Payments Webinar from BlueSnap

-- June 2024 is National Volunteer Month --
-- June 2024 is National Volunteer Month ---- June 2024 is National Volunteer Month --
-- June 2024 is National Volunteer Month --

B7 flexi budget

  • 1. Flexible Budgets and Overhead Analysis Chapter 7
  • 2. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Static Budgets and Performance Reports Hmm! Comparing static budgets with actual costs is like comparing apples and oranges. Static budgets are prepared for a single, planned level of activity. Performance evaluation is difficult when actual activity differs from the planned level of activity. Let’s look at CheeseCo.
  • 3. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Static Actual Budget Results Variances Machine hours 10,000 8,000 Variable costs Ind irect labor 40,000$ 34,000$ Indirect materials 30,000 25,500 Power 5,000 3,800 Fixed costs Depreciation 12,000 12,000 Insurance 2,000 2,050 Total overhead costs 89,000$ 77,350$ Static Budgets and Performance Reports CheeseCo
  • 4. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Static Actual Budget Results Variances Machine hours 10,000 8,000 2,000 U Variable costs Indirect labor 40,000$ 34,000$ $6,000 F Indirect materials 30,000 25,500 4,500 F Power 5,000 3,800 1,200 F Fixed costs Depreciation 12,000 12,000 0 Insurance 2,000 2,050 50 U Total overhead costs 89,000$ 77,350$ $11,650 F Static Actual Budget Results Variances Machine hours 10,000 8,000 2,000 U Variable costs Ind irect labor 40,000$ 34,000$ $6,000 F Indirect materials 30,000 25,500 4,500 F Power 5,000 3,800 1,200 F Fixed costs Depreciation 12,000 12,000 0 Insurance 2,000 2,050 50 U Total overhead costs 89,000$ 77,350$ $11,650 F Static Budgets and Performance Reports U = Unfavorable variance CheeseCo was unable to achieve the budgeted level of activity. CheeseCo
  • 5. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Static Actual Budget Results Variances Machine hours 10,000 8,000 2,000 U Variable costs Indirect labor 40,000$ 34,000$ $6,000 F Indirect materials 30,000 25,500 4,500 F Power 5,000 3,800 1,200 F Fixed costs Depreciation 12,000 12,000 0 Insurance 2,000 2,050 50 U Total overhead costs 89,000$ 77,350$ $11,650 F Static Actual Budget Results Variances Machine hours 10,000 8,000 2,000 U Variable costs Ind irect labor 40,000$ 34,000$ $6,000 F Indirect materials 30,000 25,500 4,500 F Power 5,000 3,800 1,200 F Fixed costs Depreciation 12,000 12,000 0 Insurance 2,000 2,050 50 U Total overhead costs 89,000$ 77,350$ $11,650 F Static Budgets and Performance Reports F = Favorable variance that occurs when actual costs are less than budgeted costs. CheeseCo
  • 6. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Static Actual Budget Results Variances Machine hours 10,000 8,000 2,000 U Variable costs Indirect labor 40,000$ 34,000$ $6,000 F Indirect materials 30,000 25,500 4,500 F Power 5,000 3,800 1,200 F Fixed costs Depreciation 12,000 12,000 0 Insurance 2,000 2,050 50 U Total overhead costs 89,000$ 77,350$ $11,650 F Static Actual Budget Results Variances Machine hours 10,000 8,000 2,000 U Variable costs Ind irect labor 40,000$ 34,000$ $6,000 F Indirect materials 30,000 25,500 4,500 F Power 5,000 3,800 1,200 F Fixed costs Depreciation 12,000 12,000 0 Insurance 2,000 2,050 50 U Total overhead costs 89,000$ 77,350$ $11,650 F Static Budgets and Performance Reports Since cost variances are favorable, have we done a good job controlling costs? CheeseCo
  • 7. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Static Budgets and Performance Reports I don’t think I can answer the question using a static budget. Actual activity is below budgeted activity which is unfavorable. So, shouldn’t variable costs be lower if actual activity is lower?
  • 8. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill The relevant question is . . . “How much of the favorable cost variance is due to lower activity, and how much is due to good cost control?” To answer the question, we must the budget to the actual level of activity. Static Budgets and Performance Reports
  • 9. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Flexible Budgets Improve performance evaluation. May be prepared for any activity level in the relevant range. Show revenues and expenses that should have occurred at the actual level of activity. Reveal variances due to good cost control or lack of cost control.
  • 10. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Flexible Budgets Central Concept If you can tell me what your activity was for the period, I will tell you what your costs and revenue should have been.
  • 11. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Preparing a Flexible Budget To a budget we need to know that: Total variable costs change in direct proportion to changes in activity. Total fixed costs remain unchanged within the relevant range. Fixed Variable
  • 12. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Preparing a Flexible Budget Let’s prepare budgets for CheeseCo.
  • 13. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Cost Total Flexible Budgets Formula Fixed 8,000 10,000 12,000 Per Hour Cost Hours Hours Hours Machine hours 8,000 10,000 12,000 Variable costs Indirect labor 4.00 32,000$ Indirect material 3.00 24,000 Power 0.50 4,000 Total variable cost 7.50$ 60,000$ Fixed costs Depreciation 12,000$ Insurance 2,000 Total fixed cost Total overhead costs Preparing a Flexible Budget Fixed costs are expressed as a total amount. Variable costs are expressed as a constant amount per hour. $40,000 ÷ 10,000 hours is $4.00 per hour. CheeseCo
  • 14. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Cost Total Flexible Budgets Formula Fixed 8,000 10,000 12,000 Per Hour Cost Hours Hours Hours Machine hours 8,000 10,000 12,000 Variable costs Indirect labor 4.00 32,000$ Indirect material 3.00 24,000 Power 0.50 4,000 Total variable cost 7.50$ 60,000$ Fixed costs Depreciation 12,000$ Insurance 2,000 Total fixed cost Total overhead costs Preparing a Flexible Budget $4.00 per hour × 8,000 hours = $32,000 CheeseCo
  • 15. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Preparing a Flexible Budget Cost Total Flexible Budgets Formula Fixed 8,000 10,000 12,000 Per Hour Cost Hours Hours Hours Machine hours 8,000 10,000 12,000 Variable costs Indirect labor 4.00 32,000$ 40,000$ 48,000$ Indirect material 3.00 24,000 30,000 36,000 Power 0.50 4,000 5,000 6,000 Total variable cost 7.50$ 60,000$ 75,000$ 90,000$ Fixed costs Depreciation 12,000$ 12,000$ 12,000$ 12,000$ Insurance 2,000 2,000 2,000 2,000 Total fixed cost 14,000$ 14,000$ 14,000$ Total overhead costs 74,000$ 89,000$ 104,000$ CheeseCo
  • 16. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Preparing a Flexible Budget Cost Total Flexible Budgets Formula Fixed 8,000 10,000 12,000 Per Hour Cost Hours Hours Hours Machine hours 8,000 10,000 12,000 Variable costs Indirect labor 4.00 32,000$ 40,000$ 48,000$ Indirect material 3.00 24,000 30,000 36,000 Power 0.50 4,000 5,000 6,000 Total variable cost 7.50$ 60,000$ 75,000$ 90,000$ Fixed costs Depreciation 12,000$ 12,000$ 12,000$ 12,000$ Insurance 2,000 2,000 2,000 2,000 Total fixed cost 14,000$ 14,000$ 14,000$ Total overhead costs 74,000$ 89,000$ 104,000$ Total fixed costs do not change in the relevant range. CheeseCo
  • 17. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Let’s prepare a budget performance report for CheeseCo. Flexible Budget Performance Report
  • 18. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Cost Total Formula Fixed Flexible Actual Per Hour Costs Budget Results Variances Machine hours 8,000 8,000 0 Variable costs Indirect labor 4.00$ 32,000$ 34,000$ Indirect material 3.00 24,000 25,500 Power 0.50 4,000 3,800 Total variable costs 7.50$ 60,000$ 63,300$ Fixed Expenses Depreciation 12,000$ 12,000$ 12,000$ Insurance 2,000 2,000 2,050 Total fixed costs 14,000$ 14,050$ Total overhead costs 74,000$ 77,350$ Flexible Budget Performance Report Flexible budget is prepared for the same activity level (8,000 hours) as actually achieved. CheeseCo
  • 19. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Cost Total Formula Fixed Flexible Actual Per Hour Costs Budget Results Variances Machine hours 8,000 8,000 0 Variable costs Indirect labor 4.00$ 32,000$ 34,000$ $ 2,000 U Indirect material 3.00 24,000 25,500 1,500 U Power 0.50 4,000 3,800 200 F Total variable costs 7.50$ 60,000$ 63,300$ $ 3,300 U Fixed Expenses Depreciation 12,000$ 12,000$ 12,000$ 0 Insurance 2,000 2,000 2,050 50 U Total fixed costs 14,000$ 14,050$ 50 U Total overhead costs 74,000$ 77,350$ $ 3,350 U Flexible Budget Performance Report CheeseCo
  • 20. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Remember the question: “How much of the totalvariance is due to activityand how much is due to cost control?” Flexible Budget Performance Report
  • 21. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Static Actual Budget Results Variances Machine hours 10,000 8,000 2,000 U Variable costs Ind irect labor 40,000$ 34,000$ $6,000 F Indirect materials 30,000 25,500 4,500 F Power 5,000 3,800 1,200 F Fixed costs Depreciation 12,000 12,000 0 Insurance 2,000 2,050 50 U Total overhead costs 89,000$ 77,350$ $11,650 F Static Budgets and Performance How much of the $11,650 is due to activity and how much is due to cost control?
  • 22. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Flexible Budget Performance Report Difference between original static budget and actual overhead = $11,650 F. Overhead Variance Analysis Static Actual Overhead Overhead Budget at at 10,000 Hours 8,000 Hours 89,000$ 77,350$ Let’s place the flexible budget for 8,000 hours here.
  • 23. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Flexible Budget Performance Report This $15,000F variance is due to lower activity. Overhead Variance Analysis Activity This $3,350U flexible budget variance is due to poor cost control. Cost control Static Flexible Actual Overhead Overhead Overhead Budget at Budget at at 10,000 Hours 8,000 Hours 8,000 Hours 89,000$ 74,000$ 77,350$
  • 24. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Flexible Budget Performance Report What causes the cost control variance? There are two primary reasons for unfavorable variable overhead variances: 1. Spending too much for resources. 2. Using the resources inefficiently.
  • 25. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Overhead Rates and Overhead Analysis Overhead from the flexible budget for the denominator level of activity POHR = Recall that overhead costs are assigned to products and services using a predetermined overhead rate (POHR): Assigned Overhead = POHR × Standard Activity Denominator level of activity
  • 26. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Overhead Rates and Overhead Analysis – Example Let’s look at overhead rates in a budget for ColaCo.
  • 27. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill ColaCo prepared this budget for overhead: Overhead Rates and Overhead Analysis – Example Total Variable Total Fixed Machine Variable Overhead Fixed Overhead Hours Overhead Rate Overhead Rate 2,000 4,000$ ? 9,000$ ? 4,000 8,000 ? 9,000 ? ColaCo applies overhead based on machine hour activity. ColaCo applies overhead based on machine hour activity. Let’s calculate overhead rates.
  • 28. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Overhead Rates and Overhead Analysis – Example Rate = Total Variable Overhead ÷ Machine Hours ColaCo prepared this budget for overhead: This rate is constant at all levels of activity. Total Variable Total Fixed Machine Variable Overhead Fixed Overhead Hours Overhead Rate Overhead Rate 2,000 4,000$ 2.00$ 9,000$ ? 4,000 8,000 2.00 9,000 ?
  • 29. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Total Variable Total Fixed Machine Variable Overhead Fixed Overhead Hours Overhead Rate Overhead Rate 2,000 4,000$ 2.00$ 9,000$ 4.50$ 4,000 8,000 2.00 9,000 2.25 Overhead Rates and Overhead Analysis – Example Rate = Total Fixed Overhead ÷ Machine Hours ColaCo prepared this budget for overhead: This rate decreases when activity increases.
  • 30. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Total Variable Total Fixed Machine Variable Overhead Fixed Overhead Hours Overhead Rate Overhead Rate 2,000 4,000$ 2.00$ 9,000$ 4.50$ 4,000 8,000 2.00 9,000 2.25 Overhead Rates and Overhead Analysis – Example The total POHR is the sum of the fixed and variable rates for a given activity level. ColaCo prepared this budget for overhead:
  • 31. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Overhead Variances Let’s use the overhead rates, to determine variable and fixed overhead variances.
  • 32. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill ColaCo’s actual production for the period required 3,200 standard machine hours. Actual variable overhead incurred for the period was $6,740. Actual machine hours worked were 3,300. Compute the variable overhead spending and efficiency variances. Variable Overhead Variances – Example
  • 33. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Variable Overhead Variances AH × SRAH × AR Spending variance = AH(AR - SR) Efficiency variance = SR(AH - SH) SH × SR Spending Variance Efficiency Variance Actual Flexible Budget Flexible Budget Variable for Variable for Variable Overhead Overhead at Overhead at Incurred Actual Hours Standard Hours
  • 34. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill 3,300 hours 3,200 hours × × $2.00 per hour $2.00 per hour Variable Overhead Variances – Example Actual Flexible Budget Flexible Budget Variable for Variable for Variable Overhead Overhead at Overhead at Incurred Actual Hours Standard Hours $6,740 $6,600 $6,400 Spending variance $140 unfavorable Efficiency variance $200 unfavorable $340 unfavorable flexible budget total variance$340 unfavorable flexible budget total variance
  • 35. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Variable Overhead Variances – A Closer Look Spending Variance Efficiency Variance Results from paying more or less than expected for overhead items and from excessive usage of overhead items. Controlled by managing the overhead cost driver.
  • 36. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Overhead Variances Now let’s turn our attention to fixed overhead.
  • 37. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Overhead Rates and Overhead Analysis – Example ColaCo prepared this budget for overhead: What is ColaCo’s fixed overhead rate for an estimated activity of 3,000 machine hours? Total Variable Total Fixed Machine Variable Overhead Fixed Overhead Hours Overhead Rate Overhead Rate 2,000 4,000$ 2.00$ 9,000$ 4.50$ 4,000 8,000 2.00 9,000 2.25
  • 38. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Overhead Rates and Overhead Analysis – Example ColaCo prepared this budget for overhead: What is ColaCo’s fixed overhead rate for an estimated activity of 3,000 machine hours? Fixed Overhead Rate FR = $9,000 ÷ 3,000 machine hours FR = $3.00 per machine hour Total Variable Total Fixed Machine Variable Overhead Fixed Overhead Hours Overhead Rate Overhead Rate 2,000 4,000$ 2.00$ 9,000$ 4.50$ 4,000 8,000 2.00 9,000 2.25
  • 39. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill ColaCo’s actual production required 3,200 standard machine hours. Actual fixed overhead was $8,450. Compute the fixed overhead budget and volume variances. Fixed Overhead Variances – Example
  • 40. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Fixed Overhead Variances Budget Variance Volume Variance FR = Standard Fixed Overhead Rate SH = Standard Hours Allowed SH × FR Actual Fixed Fixed Fixed Overhead Overhead Overhead Incurred Budget Applied
  • 41. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill 3,200 hours × $3.00 per hour Budget variance $550 favorable Fixed Overhead Variances – Example $8,450 $9,000 $9,600 Actual Fixed Fixed Fixed Overhead Overhead Overhead Incurred Budget Applied Volume variance $600 favorable SH × FR
  • 42. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Fixed Overhead Variances – A Closer Look Budget Variance Volume Variance Results from paying more or less than expected for overhead items. Results from operating at an activity level different from the denominator activity.
  • 43. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Overhead Variances Let’s look at a graph showing fixed overhead variances. We will use ColaCo’s numbers from the previous example.
  • 44. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Volume Cost 3,200 Standard Hours 3,000 Hours Expected Activity Fixed Overhead Variances Fixed overhead applied to products
  • 45. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Fixed Overhead Variances $8,450 actual fixed OH Volume Cost $9,600 applied fixed OH $9,000 budgeted fixed OH 3,200 Standard Hours 3,000 Hours Expected Activity Fixed overhead applied to products 3,200 machine hours × $3.00 fixed overhead rate
  • 46. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill { $600 Favorable Volume Variance Fixed Overhead Variances {$550 Favorable Budget Variance $8,450 actual fixed OH$8,450 actual fixed OH Volume Cost $9,600 applied fixed OH $9,000 budgeted fixed OH 3,200 Standard Hours 3,000 Hours Expected Activity Fixed overhead applied to products 3,200 machine hours × $3.00 fixed overhead rate {
  • 47. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Results when standard hours allowed for actual output differs from the denominator activity. Volume Variance – A Closer Look Volume Variance Favorable when standard hours > denominator hours Unfavorable when standard hours < denominator hours
  • 48. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Results when standard hours allowed for actual output differs from the denominator activity. Volume Variance – A Closer Look Volume Variance Favorable when standard hours > denominator hours Unfavorable when standard hours < denominator hours Does not measure over- or under spending Explainable by and controllable only through activity
  • 49. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill Overhead Variances and Under- or Overapplied Overhead Cost The sum of the overhead variances equals the under- or overapplied overhead cost for a period. Favorable variances are equivalent to overapplied overhead. Unfavorable variances are equivalent to underapplied overhead. In a standard cost system:
  • 50. © The McGraw-Hill Companies, Inc., 2000Irwin/McGraw-Hill End of Chapter 11 I’m here to your budget. Are you ready to ante up?
