Introduction
Calibration
PA Power Management IC
TX Timing Optimization
RF Power Amplifier
RF Connector
VCO
Supply Voltage
I/Q Signal
Power Management IC

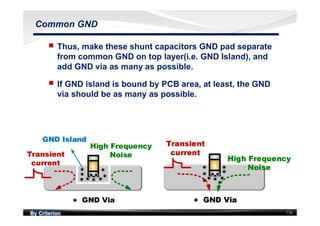

Common GND
By Criterion 4
Introduction
By Criterion 5
ACPR(Adjacent Channel Power Ratio)
nn For many of the current and future transmission
standards(GSM, CDMA, TD-SCDMA, WCDMA, and LTE),
ACPR (sometimes also termed adjacent channel
leakage ratio-ACLR) is an important test parameter for
characterizing the distortion of subsystems and the
likelihood that a given system may cause interference
with a neighboring radio[32].
By Criterion 6
ORFS(Output Radio Frequency Spectrum)
nn In GSM, As part of the out-of-channel measurements,
the ACPR is defined by two measurements: spectrum
due to modulation and wideband noise, and spectrum
due to switching. These two measurements are usually
grouped together and referred to as output RF
spectrum (ORFS)[34].
By Criterion 7

ORFS due to Modulation
nn The modulation process in a transmitter causes
continuous wave carriers to spread spectrally. The
spectrum due to modulation and wideband noise
measurement is used to ensure that the modulation
process does not cause excessive spread. This would
cause interference to adjacent channel users[34].
With max PCL,
why is the
carrier power
merely 22 dBm?
With max PCL,
why is the
carrier power
merely 22 dBm?
By Criterion 8
ORFS due to Modulation
nn The analyzer is tuned to a spot frequency and then
time-gated across 50% ~ 90% part of the modulated
burst to avoid training sequence[34].
nn Besides, spectral components that result from the
effect of bursting do NOT appear because the ramps
are gated out[34].
By Criterion 9
ORFS due to Switching

nn GSM/EDGE transmitters ramp RF power rapidly due to
burst mode. If RF power is ramped too quickly,
undesirable spectral components exist in the
transmission. Users operating on different frequencies,
especially those close to the channel of interest, will
experience significant interference[34].

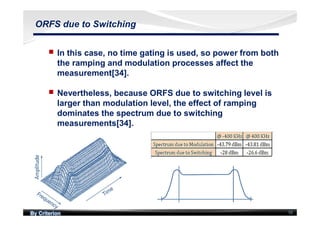

By Criterion 10
ORFS due to Switching
nn In this case, no time gating is used, so power from both
the ramping and modulation processes affect the
measurement[34].
nn Nevertheless, because ORFS due to switching level is
larger than modulation level, the effect of ramping
dominates the spectrum due to switching
measurements[34].
By Criterion 11
Calibration
By Criterion 12
DPD
nn DPD(Digital Predistortion) is applied to linearize the PA
to improve the linearity in the linear region and increase
the linear region by compensating the compression
with an inverse function[39].
nn As shown below, DPD can be used to lower spectral
regrowth to improve both ACLR and ORFS as
well[1,41,66].
By Criterion 13
GMSK and 8PSK

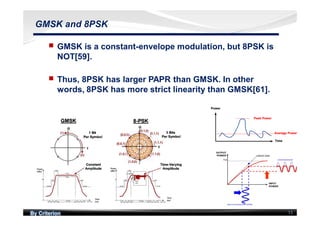

nn GMSK is a constant-envelope modulation, but 8PSK is
NOT[59].
nn Thus, 8PSK has larger PAPR than GMSK. In other
words, 8PSK has more strict linearity than GMSK[61].
Average Power
Peak Power
Time
Power
Average Power
Peak Power
Time
Power
By Criterion 14

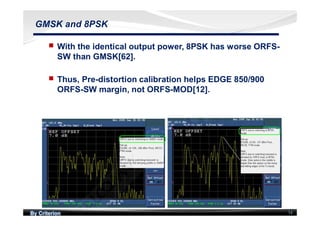

GMSK and 8PSK
nn With the identical output power, 8PSK has worse ORFS-
SW than GMSK[62].
nn Thus, Pre-distortion calibration helps EDGE 850/900
ORFS-SW margin, not ORFS-MOD[12].
By Criterion 15

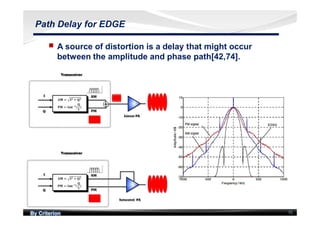

Path Delay for EDGE
nn A source of distortion is a delay that might occur
between the amplitude and phase path[42,74].
By Criterion 16
Path Delay for EDGE

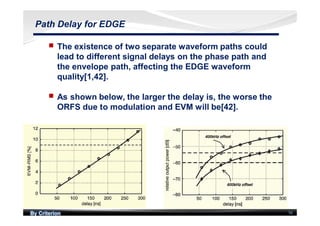

nn The existence of two separate waveform paths could
lead to different signal delays on the phase path and
the envelope path, affecting the EDGE waveform
quality[1,42].
nn As shown below, the larger the delay is, the worse the
ORFS due to modulation and EVM will be[42].
By Criterion 17
Path Delay for EDGE

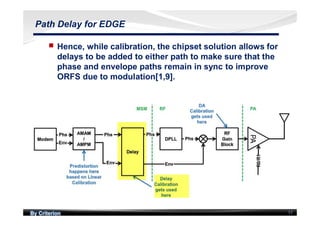

nn Hence, while calibration, the chipset solution allows for
delays to be added to either path to make sure that the
phase and envelope paths remain in sync to improve
ORFS due to modulation[1,9].
By Criterion 18
Path Delay for EDGE

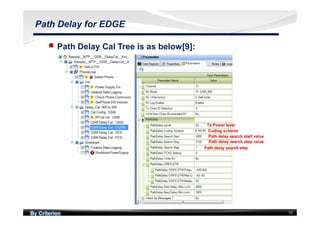

nn Path Delay Cal Tree is as below[9]:
By Criterion 19

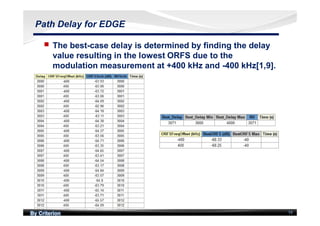

Path Delay for EDGE
nn The best-case delay is determined by finding the delay
value resulting in the lowest ORFS due to the
modulation measurement at +400 kHz and -400 kHz[1,9].
By Criterion 20
Path Delay for EDGE

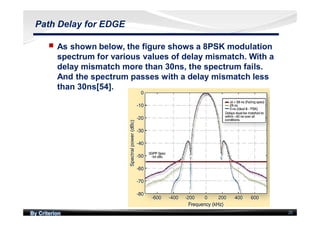

nn As shown below, the figure shows a 8PSK modulation
spectrum for various values of delay mismatch. With a
delay mismatch more than 30ns, the spectrum fails.
And the spectrum passes with a delay mismatch less
than 30ns[54].
By Criterion 21
PA Power
Management IC
By Criterion 22

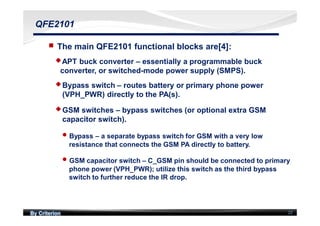

QFE2101
nn The main QFE2101 functional blocks are[4]:
uuAPT buck converter – essentially a programmable buck
converter, or switched-mode power supply (SMPS).
uuBypass switch – routes battery or primary phone power
(VPH_PWR) directly to the PA(s).
uuGSM switches – bypass switches (or optional extra GSM
capacitor switch).
ll Bypass – a separate bypass switch for GSM with a very low
resistance that connects the GSM PA directly to battery.
ll GSM capacitor switch – C_GSM pin should be connected to primary
phone power (VPH_PWR); utilize this switch as the third bypass
switch to further reduce the IR drop.
By Criterion 23

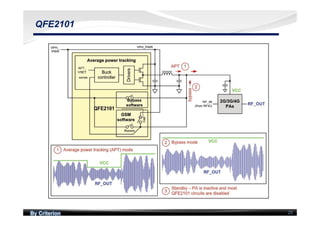

QFE2101
By Criterion 24
QFE2101

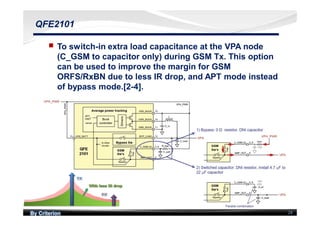

nn To switch-in extra load capacitance at the VPA node
(C_GSM to capacitor only) during GSM Tx. This option
can be used to improve the margin for GSM
ORFS/RxBN due to less IR drop, and APT mode instead
of bypass mode.[2-4].
By Criterion 25
TX Timing
Optimization
By Criterion 26

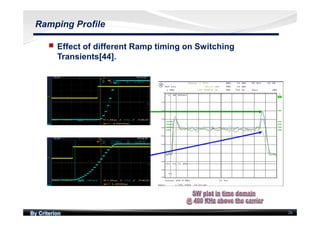

Ramping Profile
nn Effect of different Ramp timing on Switching
Transients[44].
By Criterion 27
Ramping Profile
nn Nevertheless, there is a trade-off between GSM PvT and
GSM ORFS due to switching @400kHz with high PCL[6].
nn Hence, tune ramping profile to pass PVT and ORFS
specification simultaneously[6,8].
By Criterion 28

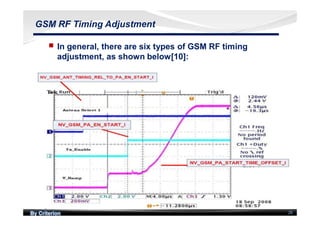

GSM RF Timing Adjustment
nn In general, there are six types of GSM RF timing

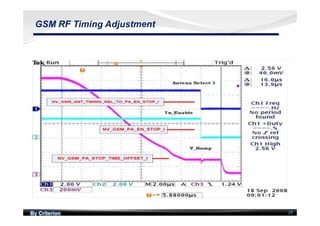

adjustment, as shown below[10]:
By Criterion 29
GSM RF Timing Adjustment
By Criterion 30
GSM RF Timing Adjustment

nn pa_en_start/stop_offset_adj:The PA enable signal
start/stop time adjustment value can be altered to move
the rising edge of the PA enable signal forward or
backward to get the optimal configuration[9].
nn pa_start/stop_offset_adj :The PA turn-on/off time
adjustment value can be altered to adjust the rising
edge of the TDMA Tx power burst[9].
nn ant_timing_start/stop_offset_adj : The antenna
select control signal start/stop time adjustment value
can be altered to move the falling edge of antenna
select control signal forward or backward relative to the
PA enable signal falling edge to get the optimal
configuration[9].
By Criterion 31

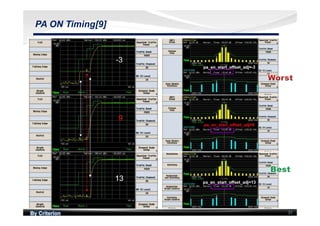

PA ON Timing[9]

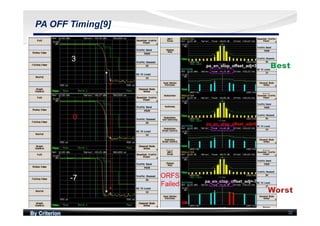

By Criterion 32
PA OFF Timing[9]
By Criterion 33

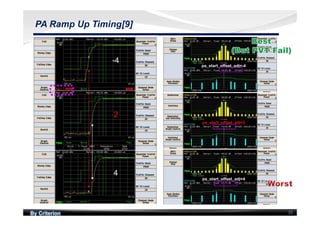

PA Ramp Up Timing[9]
By Criterion 34

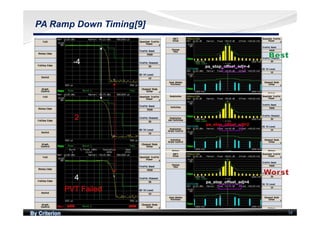

PA Ramp Down Timing[9]
By Criterion 35

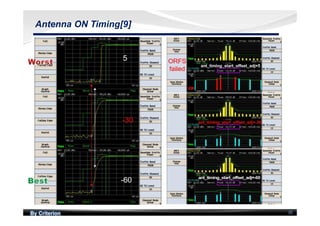

Antenna ON Timing[9]
By Criterion 36

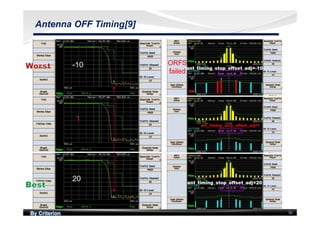

Antenna OFF Timing[9]
By Criterion 37

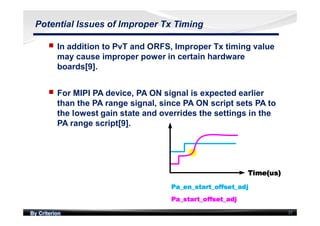

Potential Issues of Improper Tx Timing
nn In addition to PvT and ORFS, Improper Tx timing value
may cause improper power in certain hardware
boards[9].
nn For MIPI PA device, PA ON signal is expected earlier
than the PA range signal, since PA ON script sets PA to
the lowest gain state and overrides the settings in the
PA range script[9].
By Criterion 38
Potential Issues of Improper Tx Timing

nn If PA ON is later than PA range timing, the power will be
lower than expected; e.g. Max Tx power is merely ~20
dBm[9]
nn The error message can be observed in QXDM log[9].
By Criterion 39
Potential Issues of Improper Tx Timing
nn And the improper power may cause EDGE calibration or
registration failure in certain hardware boards[9]
nn Failed to calibrate GSM850 due to improper PA timing
applied[9].
nn Failed to calibrate GSM900 per improper PA timing
applied[9].
By Criterion 40
Potential Issues of Improper Tx Timing

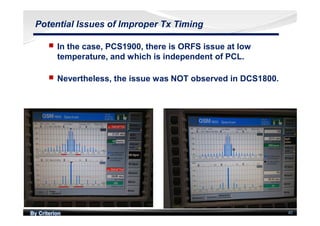

nn In the case, PCS1900, there is ORFS issue at low
temperature, and which is independent of PCL.
nn Nevertheless, the issue was NOT observed in DCS1800.
By Criterion 41
Potential Issues of Improper Tx Timing
nn First, we did NOT observe this issue in FTM(Factory
Test Mode). In other words, the issue disappears
without RX operation.
nn Second, we did NOT observe this issue at transceiver
output, as shown below :
By Criterion 42
Potential Issues of Improper Tx Timing
nn Because there are merely two blocks(transceiver and
PAMiD) in TX chain, so we conclude that this issue is
related to PAMiD[74], especially ASM timing.
By Criterion 43
Potential Issues of Improper Tx Timing

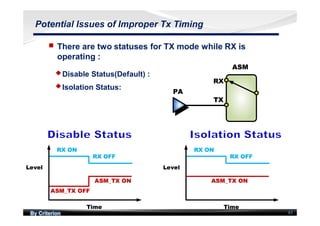

nn There are two statuses for TX mode while RX is
operating :
uuDisable Status(Default) :
uuIsolation Status:
RX OFF
RX ON
ASM_TX OFF
ASM_TX ON
Level
Time
RX OFF
RX ON
ASM_TX OFF
ASM_TX ON
Level
Time
ASM
RX
TX
PA
ASM
RX
TX
PA
RX OFF
RX ON
ASM_TX ON
Level
Time
RX OFF
RX ON
ASM_TX ON
Level
Time
By Criterion 44
Potential Issues of Improper Tx Timing

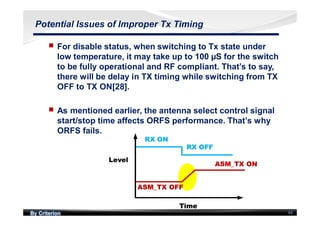

nn For disable status, when switching to Tx state under
low temperature, it may take up to 100 µS for the switch
to be fully operational and RF compliant. That’s to say,
there will be delay in TX timing while switching from TX
OFF to TX ON[28].
nn As mentioned earlier, the antenna select control signal
start/stop time affects ORFS performance. That’s why
ORFS fails.
RX OFF
RX ON
ASM_TX OFF
ASM_TX ON
Level
Time
RX OFF
RX ON
ASM_TX OFF
ASM_TX ON
Level
Time

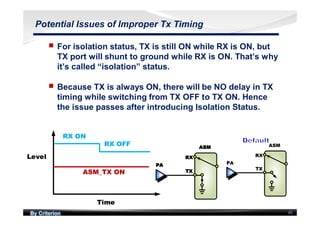

By Criterion 45
Potential Issues of Improper Tx Timing
nn For isolation status, TX is still ON while RX is ON, but
TX port will shunt to ground while RX is ON. That’s why
it’s called “isolation” status.
nn Because TX is always ON, there will be NO delay in TX
timing while switching from TX OFF to TX ON. Hence
the issue passes after introducing Isolation Status.
RX OFF
RX ON
ASM_TX ON
Level
Time
RX OFF
RX ON
ASM_TX ON
Level
Time
ASM
RX
TX
PA
ASM
RX
TX
PA
By Criterion 46
Potential Issues of Improper Tx Timing

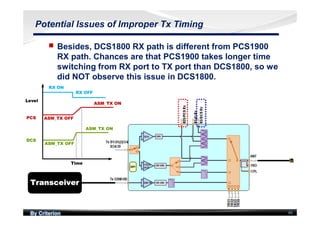

nn Besides, DCS1800 RX path is different from PCS1900
RX path. Chances are that PCS1900 takes longer time
switching from RX port to TX port than DCS1800, so we
did NOT observe this issue in DCS1800.
RX OFF
RX ON
Level
Time
ASM_TX OFF
ASM_TX ON
ASM_TX OFF
ASM_TX ON
PCS
DCS
RX OFF
RX ON
Level
Time
ASM_TX OFF
ASM_TX ON
ASM_TX OFF
ASM_TX ON
PCS
DCS
By Criterion 47
RF Power Amplifier
By Criterion 48
Linearity
nn As mentioned above, ORFS is just the concept of ACLR.
And the formula of ACLR is :
ACLR = 2(Pin - OIP3 + G)+C, where C is correction coefficient
nn Hence, the better the linearity is, the better the ORFS
due to switching will be[45,46].
By Criterion 49
Temperature
nn In general, the higher the temperature is, the worse the
OIP3 will be[47].
nn Thus, chances are that high temperature leads to worse
ORFS due to switching[15].
By Criterion 50
Layout

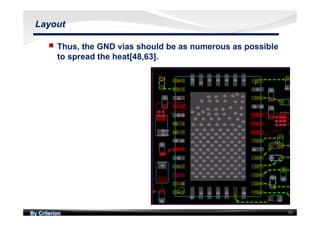

nn Thus, the GND vias should be as numerous as possible
to spread the heat[48,63].
By Criterion 51
Temperature

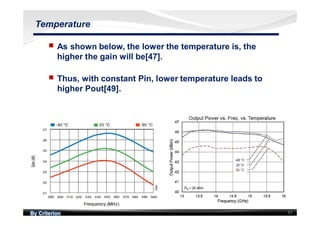

nn As shown below, the lower the temperature is, the
higher the gain will be[47].
nn Thus, with constant Pin, lower temperature leads to
higher Pout[49].
By Criterion 52
Temperature

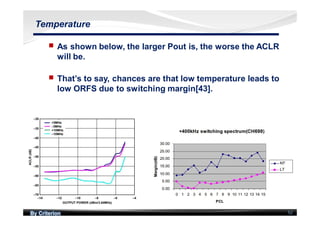

nn As shown below, the larger Pout is, the worse the ACLR
will be.
nn That’s to say, chances are that low temperature leads to
low ORFS due to switching margin[43].
By Criterion 53

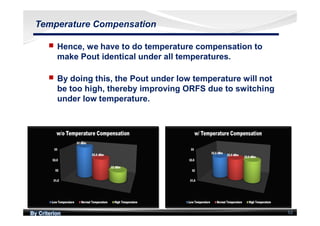

Temperature Compensation
nn Hence, we have to do temperature compensation to
make Pout identical under all temperatures.
nn By doing this, the Pout under low temperature will not
be too high, thereby improving ORFS due to switching
under low temperature.
By Criterion 54

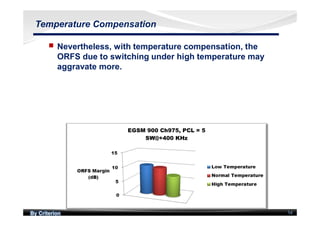

Temperature Compensation
nn Nevertheless, with temperature compensation, the
ORFS due to switching under high temperature may
aggravate more.
By Criterion 55
Temperature Compensation
nn As mentioned earlier, high temperature aggravates
linearity, thereby degrading ORFS due to switching.
nn With TC(Temperature Compensation), the Pout under
high temperature becomes larger. With worse linearity
and larger Pout, that’s why ORFS due to switching
under high temperature may aggravate more with TC.
By Criterion 56

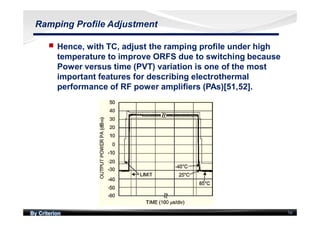

Ramping Profile Adjustment
nn Hence, with TC, adjust the ramping profile under high
temperature to improve ORFS due to switching because
Power versus time (PVT) variation is one of the most
important features for describing electrothermal
performance of RF power amplifiers (PAs)[51,52].
By Criterion 57
PA Output Matching Network Adjustment
nn Besides, adjust PA output matching network to improve
linearity and lower noise floor, thereby improving ORFS
due to switching and RxBN under high temperature
with TC[6].
By Criterion 58

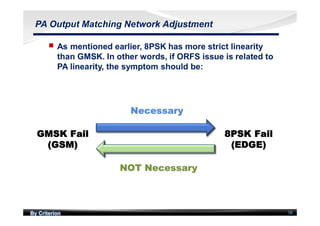

PA Output Matching Network Adjustment
nn As mentioned earlier, 8PSK has more strict linearity
than GMSK. In other words, if ORFS issue is related to
PA linearity, the symptom should be:
By Criterion 59
PA Input Matching Adjustment
nn As shown below, the PA input matching networks is
DA’s(Driver Amplifier) load-pull as well.
nn In other words, good ORFS@PA input leads to good
ORFS@PA output[50,53].
nn Hence, to optimize PA input matching network can be
used to improve ORFS as well.
By Criterion 60

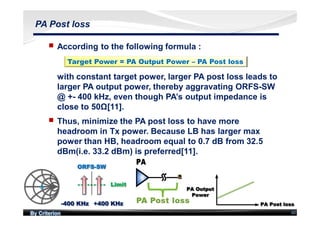

PA Post loss
nn According to the following formula :
with constant target power, larger PA post loss leads to
larger PA output power, thereby aggravating ORFS-SW
@ +- 400 kHz, even though PA’s output impedance is
close to 50Ω[11].
Target Power = PA Output Power – PA Post loss
nn Thus, minimize the PA post loss to have more
headroom in Tx power. Because LB has larger max
power than HB, headroom equal to 0.7 dB from 32.5
dBm(i.e. 33.2 dBm) is preferred[11].
By Criterion 61

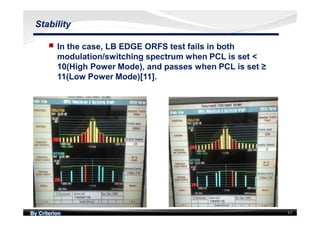

Stability
nn In the case, LB EDGE ORFS test fails in both
modulation/switching spectrum when PCL is set <
10(High Power Mode), and passes when PCL is set ≥
11(Low Power Mode)[11].
By Criterion 62

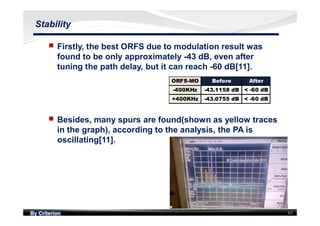

Stability
nn Firstly, the best ORFS due to modulation result was
found to be only approximately -43 dB, even after
tuning the path delay, but it can reach -60 dB[11].
ORFS-MO Before After
-400KHz -43.1158 dB < -60 dB
+400KHz -43.0755 dB < -60 dB
ORFS-MO Before After
-400KHz -43.1158 dB < -60 dB
+400KHz -43.0755 dB < -60 dB
nn Besides, many spurs are found(shown as yellow traces
in the graph), according to the analysis, the PA is
oscillating[11].
By Criterion 63
Stability
nn According to the K-factor definition, the stability
depends on S-parameter[56]. Chances are that the
components marked as red circle affect the
S-parameter and stability of QFE2320, thereby
oscillating[11]
nn Because the issue occurs in LB, the components
marked as red circle must be changed to remove
oscillation[11].
By Criterion 64

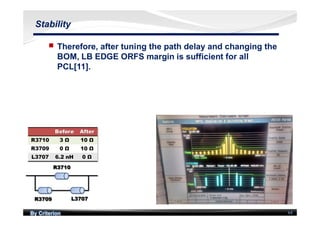

Stability
nn Therefore, after tuning the path delay and changing the
BOM, LB EDGE ORFS margin is sufficient for all
PCL[11].
By Criterion 65

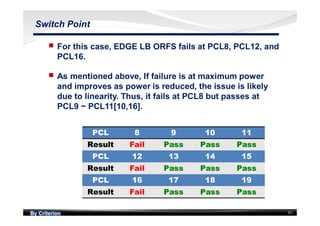

Switch Point
nn For this case, EDGE LB ORFS fails at PCL8, PCL12, and
PCL16.
nn As mentioned above, If failure is at maximum power
and improves as power is reduced, the issue is likely
due to linearity. Thus, it fails at PCL8 but passes at
PCL9 ~ PCL11[10,16].
PCL 8 9 10 11
Result Fail Pass Pass Pass
PCL 12 13 14 15
Result Fail Pass Pass Pass
PCL 16 17 18 19
Result Fail Pass Pass Pass
By Criterion 66
Switch Point

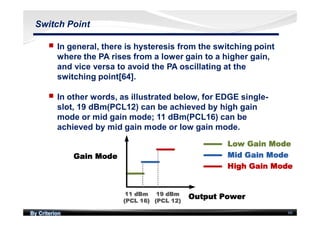

nn In general, there is hysteresis from the switching point
where the PA rises from a lower gain to a higher gain,
and vice versa to avoid the PA oscillating at the
switching point[64].
nn In other words, as illustrated below, for EDGE single-
slot, 19 dBm(PCL12) can be achieved by high gain
mode or mid gain mode; 11 dBm(PCL16) can be
achieved by mid gain mode or low gain mode.
By Criterion 67
Switch Point
nn Hence, as illustrated below, if 11 dBm is achieved by
low gain mode, the PA will be in saturation region,
thereby degrading linearity and aggravating ORFS.
So is 19 dBm(PCL 12).
nn In order to solve this issue, make these output power @
switch points be in proper gain mode to be in linear
region[16].
By Criterion 68
RF Connector
By Criterion 69
Material issue

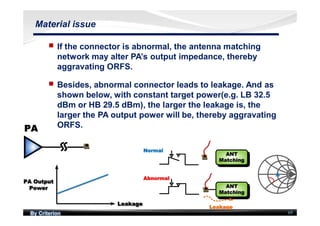

nn If the connector is abnormal, the antenna matching
network may alter PA’s output impedance, thereby
aggravating ORFS.
nn Besides, abnormal connector leads to leakage. And as
shown below, with constant target power(e.g. LB 32.5
dBm or HB 29.5 dBm), the larger the leakage is, the
larger the PA output power will be, thereby aggravating
ORFS.
By Criterion
Layout issue
nn In the case, it is very difficult to pull load impedance to
50 Ω for the common path[11].
nn Hence, ORFS due to switching
performance is not good enough.
By Criterion

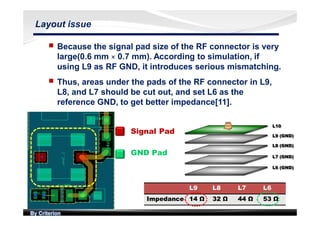

Layout issue
nn Because the signal pad size of the RF connector is very
large(0.6 mm × 0.7 mm). According to simulation, if
using L9 as RF GND, it introduces serious mismatching.
nn Thus, areas under the pads of the RF connector in L9,
L8, and L7 should be cut out, and set L6 as the
reference GND, to get better impedance[11].
Signal Pad
GND Pad
L9 L8 L7 L6
Impedance 14 Ω 32 Ω 44 Ω 53 Ω
By Criterion 72
VCO
By Criterion 73

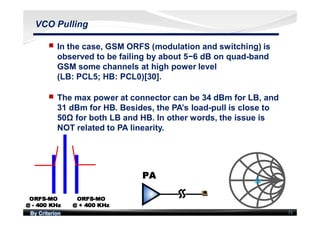

VCO Pulling
nn In the case, GSM ORFS (modulation and switching) is
observed to be failing by about 5−6 dB on quad-band
GSM some channels at high power level
(LB: PCL5; HB: PCL0)[30].
nn The max power at connector can be 34 dBm for LB, and
31 dBm for HB. Besides, the PA’s load-pull is close to
50Ω for both LB and HB. In other words, the issue is
NOT related to PA linearity.
By Criterion 74
VCO Pulling
nn As shown below, the issue can be solved with SPDT.
By Criterion 75
VCO Pulling
nn Without SPDT, the issue is root caused too high Tx
power during GSM operation leaking into FBRx path
through front-end coupler and later coupling into TX
quadrature up-converter of transceiver[16,17,30,72].
By Criterion 76
VCO Pulling
nn An SPDT (with bypass option) is recommended at front
end, as shown here to isolate GSM Tx power from
leaking into FBRx path[17,30].
nn Since FBRx is not operational in GSM mode. FBRX only
works in 3G/4G mode. So this switch (SPDT) does not
impact GSM operation[16,30].
nn Two possible implementations during GSM operation
are shown here[30]:
By Criterion 77

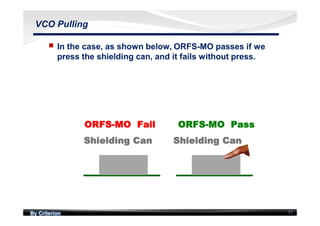

VCO Pulling
nn In the case, as shown below, ORFS-MO passes if we
press the shielding can, and it fails without press.
By Criterion 78

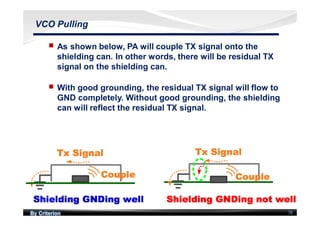

VCO Pulling
nn As shown below, PA will couple TX signal onto the
shielding can. In other words, there will be residual TX
signal on the shielding can.
nn With good grounding, the residual TX signal will flow to
GND completely. Without good grounding, the shielding
can will reflect the residual TX signal.
By Criterion 79

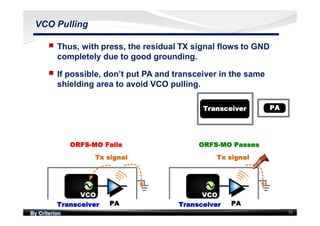

VCO Pulling
nn Thus, with press, the residual TX signal flows to GND
completely due to good grounding.
nn If possible, don’t put PA and transceiver in the same
shielding area to avoid VCO pulling.
By Criterion 80
VCO Pulling
nn As mentioned earlier, the PA input matching networks is
DA’s(Driver Amplifier) load-pull as well.
nn Besides, for Direct-Conversion transmitter architecture,
the RF frequency is the same as LO. So if PA input
matching is not close to 50Ω, the reflection due to poor
S11 may interfere VCO, thereby aggravating ORFS-MO.
By Criterion 81

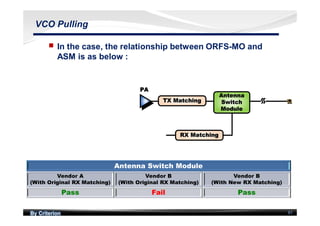

VCO Pulling
nn In the case, the relationship between ORFS-MO and
ASM is as below :
Antenna Switch Module
Vendor A
(With Original RX Matching)
Vendor B
(With Original RX Matching)
Vendor B
(With New RX Matching)
Pass Fail Pass
By Criterion 82
VCO Pulling

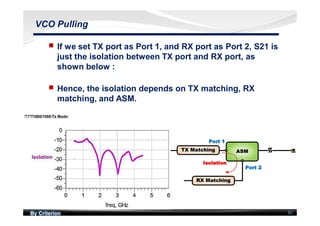

nn If we set TX port as Port 1, and RX port as Port 2, S21 is
just the isolation between TX port and RX port, as
shown below :
nn Hence, the isolation depends on TX matching, RX
matching, and ASM.
By Criterion 83
VCO Pulling
nn Therefore, vendor B ASM degrades isolation, and
ORFS-MO fails.
nn With vendor B ASM, we introduce new RX matching,
and isolation improves, thereby improving ORFS-MO.
nn As shown below, the isolation affects VCO pulling
through RX path.
By Criterion 84

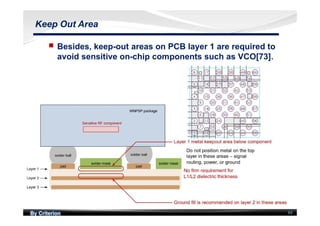

Keep Out Area
nn Besides, keep-out areas on PCB layer 1 are required to
avoid sensitive on-chip components such as VCO[73].
By Criterion 85

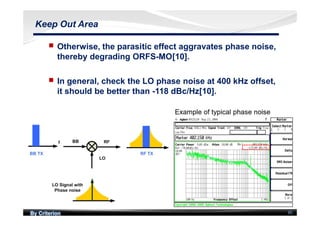

Keep Out Area
nn Otherwise, the parasitic effect aggravates phase noise,
thereby degrading ORFS-MO[10].
nn In general, check the LO phase noise at 400 kHz offset,
it should be better than -118 dBc/Hz[10].
By Criterion 86
Supply Voltage

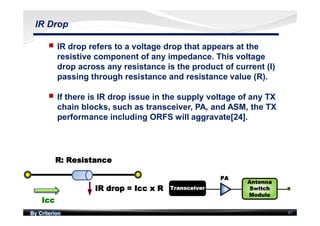

By Criterion 87
IR Drop
nn IR drop refers to a voltage drop that appears at the
resistive component of any impedance. This voltage
drop across any resistance is the product of current (I)
passing through resistance and resistance value (R).
nn If there is IR drop issue in the supply voltage of any TX
chain blocks, such as transceiver, PA, and ASM, the TX
performance including ORFS will aggravate[24].
By Criterion 88
IR Drop
nn In the case, LB GSM ORFS-MO fails for high power
mode In low temperature.
nn We found the ORFS-MO issue appears not only in
connector, but also in transceiver output. As mentioned
above, poor ORFS performance in PA input leads to
worse ORFS performance in PA output.

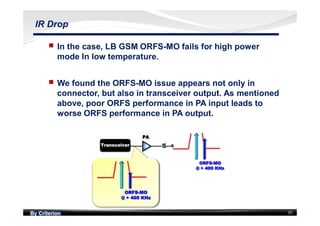

By Criterion 89

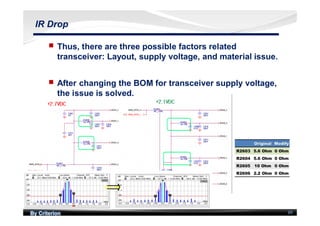

IR Drop
nn Thus, there are three possible factors related
transceiver: Layout, supply voltage, and material issue.
nn After changing the BOM for transceiver supply voltage,
the issue is solved.
By Criterion 90
IR Drop
nn As mentioned above, low temperature makes gain
increase. Higher gain leads to higher Icc, thereby
increasing IR drop.
nn In addition, with max PCL, low band has larger output
power than high band. So the issue occurred in LB
instead of HB[57].
LB 14 dBm
HB 11 dBm
By Criterion 91
IR Drop
nn As shown below, power is getting lower as supply
voltage drops[11]. In other words, the lower the supply
voltage is, the lower power will be.
By Criterion 92
IR Drop
nn In other words, with constant target power(e.g. LB 32.5
dBm or HB 29.5 dBm), the larger the IR drop is, the
larger PA output power and current consumption(i.e. Icc)
will be, thereby aggravating ORFS-SW performance.
IR drop
PA Output Power
& Icc
IR drop
PA Output Power
& Icc
By Criterion 93
IR Drop
nn Besides, as shown below, the larger the temperature is,
the larger the resistance including chip resistor or trace
will be, thereby increasing IR drop.
By Criterion 94
IR Drop

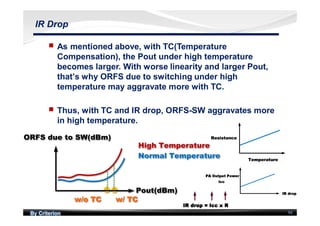

nn As mentioned above, with TC(Temperature
Compensation), the Pout under high temperature
becomes larger. With worse linearity and larger Pout,
that’s why ORFS due to switching under high
temperature may aggravate more with TC.
nn Thus, with TC and IR drop, ORFS-SW aggravates more
in high temperature.
By Criterion 95

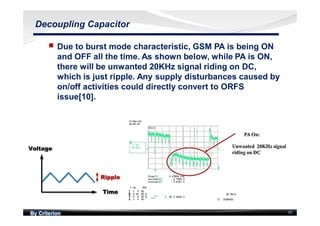

Decoupling Capacitor
nn Due to burst mode characteristic, GSM PA is being ON
and OFF all the time. As shown below, while PA is ON,
there will be unwanted 20KHz signal riding on DC,
which is just ripple. Any supply disturbances caused by
on/off activities could directly convert to ORFS
issue[10].
By Criterion 96

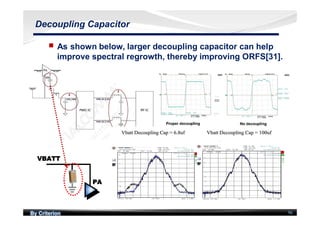

Decoupling Capacitor
nn As shown below, larger decoupling capacitor can help
improve spectral regrowth, thereby improving ORFS[31].
By Criterion 97
Decoupling Capacitor

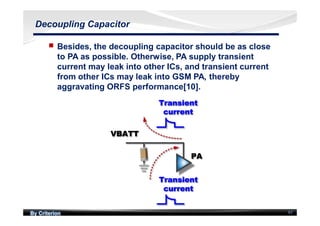

nn Besides, the decoupling capacitor should be as close
to PA as possible. Otherwise, PA supply transient
current may leak into other ICs, and transient current
from other ICs may leak into GSM PA, thereby
aggravating ORFS performance[10].
By Criterion 98
Decoupling Capacitor

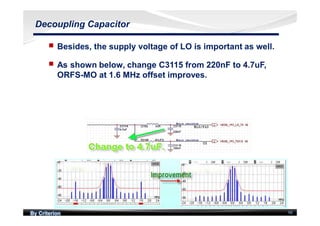

nn Besides, the supply voltage of LO is important as well.
nn As shown below, change C3115 from 220nF to 4.7uF,
ORFS-MO at 1.6 MHz offset improves.
By Criterion 99
Decoupling Capacitor

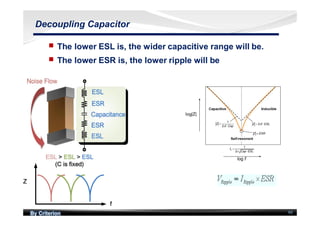

nn The lower ESL is, the wider capacitive range will be.
nn The lower ESR is, the lower ripple will be
By Criterion 100
Decoupling Capacitor

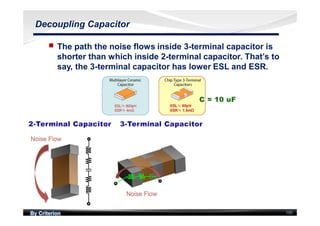

nn The path the noise flows inside 3-terminal capacitor is
shorter than which inside 2-terminal capacitor. That’s to
say, the 3-terminal capacitor has lower ESL and ESR.
By Criterion 101
Decoupling Capacitor

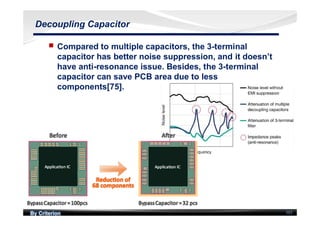

nn Compared to multiple capacitors, the 3-terminal
capacitor has better noise suppression, and it doesn’t
have anti-resonance issue. Besides, the 3-terminal
capacitor can save PCB area due to less
components[75].
By Criterion 102

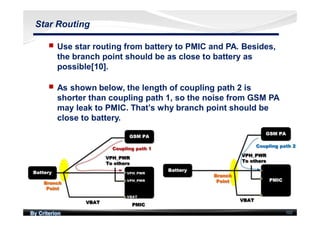

Star Routing
nn Use star routing from battery to PMIC and PA. Besides,
the branch point should be as close to battery as
possible[10].
nn As shown below, the length of coupling path 2 is
shorter than coupling path 1, so the noise from GSM PA
may leak to PMIC. That’s why branch point should be
close to battery.
By Criterion 103
Star Routing

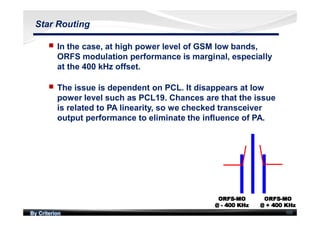

nn In the case, at high power level of GSM low bands,
ORFS modulation performance is marginal, especially
at the 400 kHz offset.
nn The issue is dependent on PCL. It disappears at low
power level such as PCL19. Chances are that the issue
is related to PA linearity, so we checked transceiver
output performance to eliminate the influence of PA.

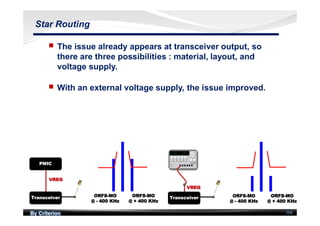

By Criterion 104
Star Routing
nn The issue already appears at transceiver output, so
there are three possibilities : material, layout, and
voltage supply.
nn With an external voltage supply, the issue improved.
By Criterion 105
Star Routing

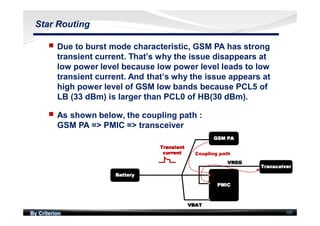

nn Due to burst mode characteristic, GSM PA has strong
transient current. That’s why the issue disappears at
low power level because low power level leads to low
transient current. And that’s why the issue appears at
high power level of GSM low bands because PCL5 of
LB (33 dBm) is larger than PCL0 of HB(30 dBm).
nn As shown below, the coupling path :
GSM PA => PMIC => transceiver
By Criterion 106
Star Routing
nn In the case, as shown below, ORFS modulation
performance fails when monitor is ON, but performance
is good when monitor is OFF.
nn Besides, the issue appears at GSM quad-band,
especially at the 400 kHz offset. And the issue is
independent on power level.
By Criterion 107

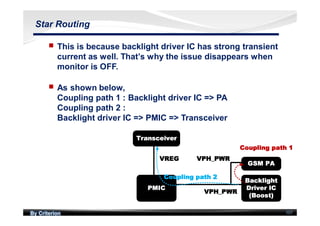

Star Routing
nn This is because backlight driver IC has strong transient
current as well. That’s why the issue disappears when
monitor is OFF.
nn As shown below,
Coupling path 1 : Backlight driver IC => PA
Coupling path 2 :
Backlight driver IC => PMIC => Transceiver
By Criterion 108

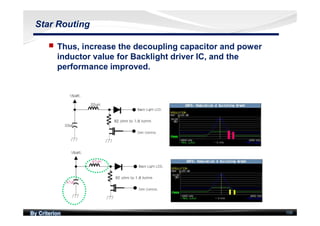

Star Routing
nn Thus, increase the decoupling capacitor and power
inductor value for Backlight driver IC, and the
performance improved.
By Criterion 109
Star Routing
nn Similarly, use star routing from PMIC to VBATT pin and
Vcc_GSM pin of GSM PA separately, and the branch
point should be as close to PMIC as possible.
nn At least, the branch point should NOT be close to GSM
PA, as shown below :
By Criterion 110

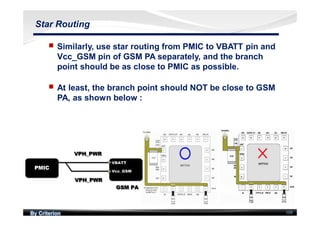

Star Routing

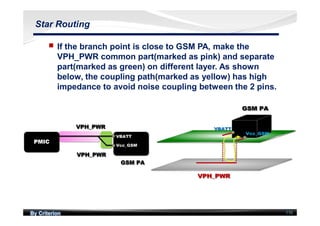

nn If the branch point is close to GSM PA, make the
VPH_PWR common part(marked as pink) and separate
part(marked as green) on different layer. As shown
below, the coupling path(marked as yellow) has high
impedance to avoid noise coupling between the 2 pins.
By Criterion 111

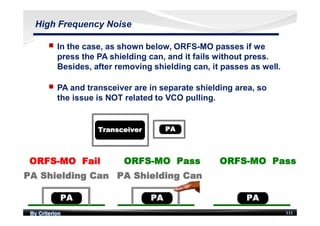

High Frequency Noise
nn In the case, as shown below, ORFS-MO passes if we
press the PA shielding can, and it fails without press.
Besides, after removing shielding can, it passes as well.
nn PA and transceiver are in separate shielding area, so
the issue is NOT related to VCO pulling.
By Criterion 112

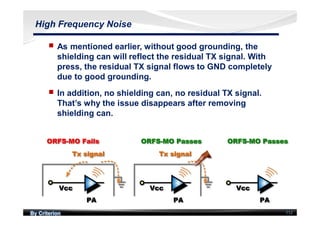

High Frequency Noise
nn As mentioned earlier, without good grounding, the
shielding can will reflect the residual TX signal. With
press, the residual TX signal flows to GND completely
due to good grounding.
nn In addition, no shielding can, no residual TX signal.
That’s why the issue disappears after removing
shielding can.
By Criterion 113

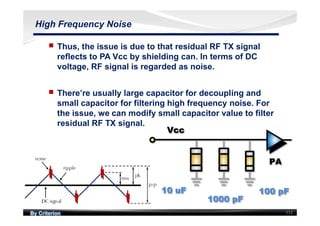

High Frequency Noise
nn Thus, the issue is due to that residual RF TX signal
reflects to PA Vcc by shielding can. In terms of DC
voltage, RF signal is regarded as noise.
nn There’re usually large capacitor for decoupling and
small capacitor for filtering high frequency noise. For
the issue, we can modify small capacitor value to filter
residual RF TX signal.
By Criterion 114
I/Q Signal
By Criterion 115
XO Harmonics
nn In the case, on certain channels of GSM high bands,
ORFS switching and modulation performance is
marginal, especially at the 400 kHz offset.
nn The most affected channels are DCS channel 599, 600,
602, 791, 792, 794, and 795; and PCS channel 668.
By Criterion 116
XO Harmonics

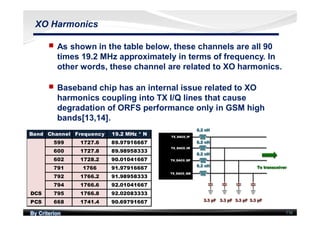

nn As shown in the table below, these channels are all 90
times 19.2 MHz approximately in terms of frequency. In
other words, these channel are related to XO harmonics.
nn Baseband chip has an internal issue related to XO
harmonics coupling into TX I/Q lines that cause
degradation of ORFS performance only in GSM high
bands[13,14].
Band Channel Frequency 19.2 MHz * N
599 1727.6 89.97916667
600 1727.8 89.98958333
602 1728.2 90.01041667
791 1766 91.97916667
792 1766.2 91.98958333
794 1766.6 92.01041667
795 1766.8 92.02083333
PCS 668 1741.4 90.69791667
DCS
Band Channel Frequency 19.2 MHz * N
599 1727.6 89.97916667
600 1727.8 89.98958333
602 1728.2 90.01041667
791 1766 91.97916667
792 1766.2 91.98958333
794 1766.6 92.01041667
795 1766.8 92.02083333
PCS 668 1741.4 90.69791667
DCS
By Criterion 117
XO Harmonics

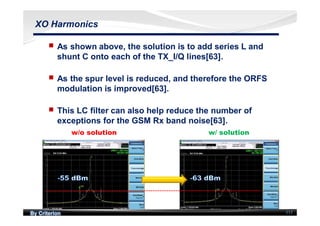

nn As shown above, the solution is to add series L and
shunt C onto each of the TX_I/Q lines[63].
nn As the spur level is reduced, and therefore the ORFS
modulation is improved[63].
nn This LC filter can also help reduce the number of
exceptions for the GSM Rx band noise[63].
w/o solution w/ solution
By Criterion 118

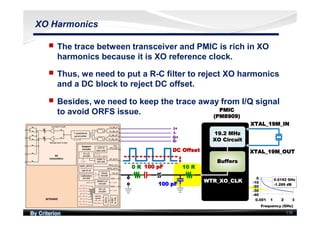

XO Harmonics
nn The trace between transceiver and PMIC is rich in XO
harmonics because it is XO reference clock.
nn Thus, we need to put a R-C filter to reject XO harmonics
and a DC block to reject DC offset.
nn Besides, we need to keep the trace away from I/Q signal
to avoid ORFS issue.
By Criterion 119

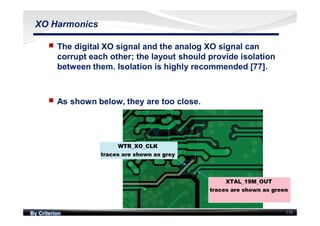

XO Harmonics
nn The digital XO signal and the analog XO signal can
corrupt each other; the layout should provide isolation
between them. Isolation is highly recommended [77].
nn As shown below, they are too close.
By Criterion 120
I/Q Imbalance
nn I/Q imbalance can be characterized by: a phase
mismatch that can happen between the I and the Q
components of the local oscillator signals, which
becomes not exactly 90 degrees, and an amplitude
mismatch due to the gain difference of the mixers of the
I and Q branches[70].
By Criterion 121

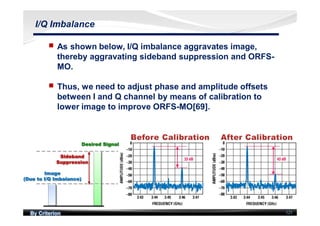

I/Q Imbalance
nn As shown below, I/Q imbalance aggravates image,
thereby aggravating sideband suppression and ORFS-
MO.
nn Thus, we need to adjust phase and amplitude offsets
between I and Q channel by means of calibration to
lower image to improve ORFS-MO[69].
By Criterion 122
I/Q Imbalance
nn Besides, in terms of modulator, high temperature
aggravates sideband suppression as well, thereby
aggravating ORFS-MO. So good thermal design of
transceiver is important[69].
nn This is especially important for direct up-conversion
transmitter because I/Q imbalance are the inherent
shortcomings of it[69].
By Criterion 123
I/Q Imbalance

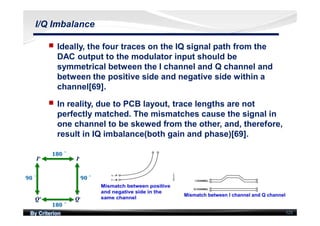

nn Ideally, the four traces on the IQ signal path from the
DAC output to the modulator input should be
symmetrical between the I channel and Q channel and
between the positive side and negative side within a
channel[69].
nn In reality, due to PCB layout, trace lengths are not
perfectly matched. The mismatches cause the signal in
one channel to be skewed from the other, and, therefore,
result in IQ imbalance(both gain and phase)[69].
By Criterion 124

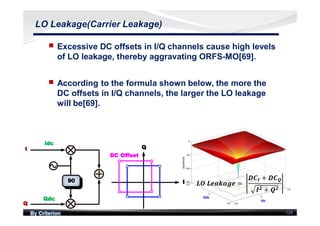

LO Leakage(Carrier Leakage)
nn Excessive DC offsets in I/Q channels cause high levels
of LO leakage, thereby aggravating ORFS-MO[69].
nn According to the formula shown below, the more the
DC offsets in I/Q channels, the larger the LO leakage
will be[69].
	 =
+
+
By Criterion 125
LO Leakage(Carrier Leakage)
nn Thus, we need to remove DC Offsets by means of
calibration to lower LO leakage to improve ORFS-
MO[69].
nn In terms of modulator, high temperature aggravates
carrier suppression as well, thereby aggravating ORFS-
MO. So good thermal design of transceiver is
important[69].
By Criterion 126
Power Management
IC
By Criterion 127
Charging

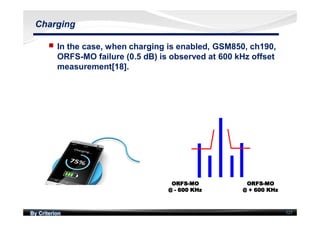

nn In the case, when charging is enabled, GSM850, ch190,
ORFS-MO failure (0.5 dB) is observed at 600 kHz offset
measurement[18].

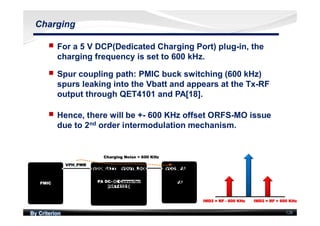

By Criterion 128
Charging
nn For a 5 V DCP(Dedicated Charging Port) plug-in, the
charging frequency is set to 600 kHz.
nn Spur coupling path: PMIC buck switching (600 kHz)
spurs leaking into the Vbatt and appears at the Tx-RF
output through QET4101 and PA[18].
nn Hence, there will be +- 600 KHz offset ORFS-MO issue
due to 2nd order intermodulation mechanism.
By Criterion 129

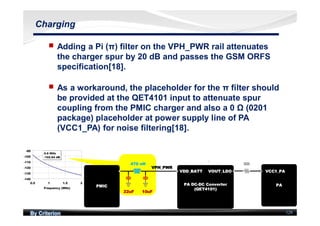

Charging
nn Adding a Pi (π) filter on the VPH_PWR rail attenuates
the charger spur by 20 dB and passes the GSM ORFS
specification[18].
nn As a workaround, the placeholder for the π filter should
be provided at the QET4101 input to attenuate spur
coupling from the PMIC charger and also a 0 Ω (0201
package) placeholder at power supply line of PA
(VCC1_PA) for noise filtering[18].
By Criterion 130
Charging
nn As shown below[18]:
By Criterion 131
SMPS

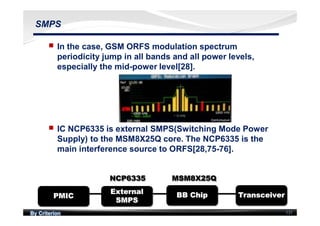

nn In the case, GSM ORFS modulation spectrum
periodicity jump in all bands and all power levels,
especially the mid-power level[28].
nn IC NCP6335 is external SMPS(Switching Mode Power
Supply) to the MSM8X25Q core. The NCP6335 is the
main interference source to ORFS[28,75-76].
By Criterion 132
SMPS

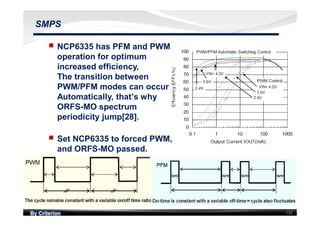

nn NCP6335 has PFM and PWM
operation for optimum
increased efficiency,
The transition between
PWM/PFM modes can occur
Automatically, that’s why
ORFS-MO spectrum
periodicity jump[28].
nn Set NCP6335 to forced PWM,
and ORFS-MO passed.
By Criterion 133
Common GND
By Criterion 134
Common GND
nn In the case, with all decoupling capacitor and bypass
capacitors, ORFS fails; without all decoupling capacitor
and bypass capacitor, ORFS passes.
By Criterion 135
Common GND

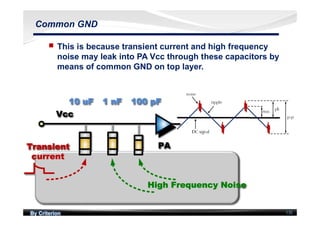

nn This is because transient current and high frequency
noise may leak into PA Vcc through these capacitors by
means of common GND on top layer.
By Criterion 136
Common GND
nn Thus, make these shunt capacitors GND pad separate
from common GND on top layer(i.e. GND Island), and
add GND via as many as possible.
nn If GND island is bound by PCB area, at least, the GND
via should be as many as possible.
By Criterion
Noise
137
Common GND

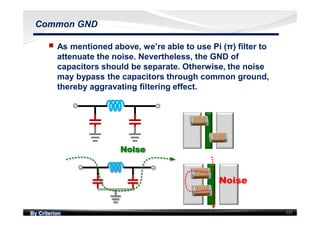

nn As mentioned above, we’re able to use Pi (π) filter to
attenuate the noise. Nevertheless, the GND of
capacitors should be separate. Otherwise, the noise
may bypass the capacitors through common ground,
thereby aggravating filtering effect.
Analysis of GSM ORFS Issue
Analysis of GSM ORFS Issue
Analysis of GSM ORFS Issue
Analysis of GSM ORFS Issue
Analysis of GSM ORFS Issue
Analysis of GSM ORFS Issue
Analysis of GSM ORFS Issue

Analysis of GSM ORFS Issue

  • 2.
    Introduction Calibration PA Power ManagementIC TX Timing Optimization RF Power Amplifier RF Connector
  • 3.
    VCO Supply Voltage I/Q Signal PowerManagement IC Common GND
  • 4.
  • 5.
    By Criterion 5 ACPR(AdjacentChannel Power Ratio) nn For many of the current and future transmission standards(GSM, CDMA, TD-SCDMA, WCDMA, and LTE), ACPR (sometimes also termed adjacent channel leakage ratio-ACLR) is an important test parameter for characterizing the distortion of subsystems and the likelihood that a given system may cause interference with a neighboring radio[32].
  • 6.
    By Criterion 6 ORFS(OutputRadio Frequency Spectrum) nn In GSM, As part of the out-of-channel measurements, the ACPR is defined by two measurements: spectrum due to modulation and wideband noise, and spectrum due to switching. These two measurements are usually grouped together and referred to as output RF spectrum (ORFS)[34].
  • 7.
    By Criterion 7 ORFSdue to Modulation nn The modulation process in a transmitter causes continuous wave carriers to spread spectrally. The spectrum due to modulation and wideband noise measurement is used to ensure that the modulation process does not cause excessive spread. This would cause interference to adjacent channel users[34]. With max PCL, why is the carrier power merely 22 dBm? With max PCL, why is the carrier power merely 22 dBm?
  • 8.
    By Criterion 8 ORFSdue to Modulation nn The analyzer is tuned to a spot frequency and then time-gated across 50% ~ 90% part of the modulated burst to avoid training sequence[34]. nn Besides, spectral components that result from the effect of bursting do NOT appear because the ramps are gated out[34].
  • 9.
    By Criterion 9 ORFSdue to Switching nn GSM/EDGE transmitters ramp RF power rapidly due to burst mode. If RF power is ramped too quickly, undesirable spectral components exist in the transmission. Users operating on different frequencies, especially those close to the channel of interest, will experience significant interference[34].
  • 10.
    By Criterion 10 ORFSdue to Switching nn In this case, no time gating is used, so power from both the ramping and modulation processes affect the measurement[34]. nn Nevertheless, because ORFS due to switching level is larger than modulation level, the effect of ramping dominates the spectrum due to switching measurements[34].
  • 11.
  • 12.
    By Criterion 12 DPD nnDPD(Digital Predistortion) is applied to linearize the PA to improve the linearity in the linear region and increase the linear region by compensating the compression with an inverse function[39]. nn As shown below, DPD can be used to lower spectral regrowth to improve both ACLR and ORFS as well[1,41,66].
  • 13.
    By Criterion 13 GMSKand 8PSK nn GMSK is a constant-envelope modulation, but 8PSK is NOT[59]. nn Thus, 8PSK has larger PAPR than GMSK. In other words, 8PSK has more strict linearity than GMSK[61]. Average Power Peak Power Time Power Average Power Peak Power Time Power
  • 14.
    By Criterion 14 GMSKand 8PSK nn With the identical output power, 8PSK has worse ORFS- SW than GMSK[62]. nn Thus, Pre-distortion calibration helps EDGE 850/900 ORFS-SW margin, not ORFS-MOD[12].
  • 15.
    By Criterion 15 PathDelay for EDGE nn A source of distortion is a delay that might occur between the amplitude and phase path[42,74].
  • 16.
    By Criterion 16 PathDelay for EDGE nn The existence of two separate waveform paths could lead to different signal delays on the phase path and the envelope path, affecting the EDGE waveform quality[1,42]. nn As shown below, the larger the delay is, the worse the ORFS due to modulation and EVM will be[42].
  • 17.
    By Criterion 17 PathDelay for EDGE nn Hence, while calibration, the chipset solution allows for delays to be added to either path to make sure that the phase and envelope paths remain in sync to improve ORFS due to modulation[1,9].
  • 18.
    By Criterion 18 PathDelay for EDGE nn Path Delay Cal Tree is as below[9]:
  • 19.
    By Criterion 19 PathDelay for EDGE nn The best-case delay is determined by finding the delay value resulting in the lowest ORFS due to the modulation measurement at +400 kHz and -400 kHz[1,9].
  • 20.
    By Criterion 20 PathDelay for EDGE nn As shown below, the figure shows a 8PSK modulation spectrum for various values of delay mismatch. With a delay mismatch more than 30ns, the spectrum fails. And the spectrum passes with a delay mismatch less than 30ns[54].
  • 21.
    By Criterion 21 PAPower Management IC
  • 22.
    By Criterion 22 QFE2101 nnThe main QFE2101 functional blocks are[4]: uuAPT buck converter – essentially a programmable buck converter, or switched-mode power supply (SMPS). uuBypass switch – routes battery or primary phone power (VPH_PWR) directly to the PA(s). uuGSM switches – bypass switches (or optional extra GSM capacitor switch). ll Bypass – a separate bypass switch for GSM with a very low resistance that connects the GSM PA directly to battery. ll GSM capacitor switch – C_GSM pin should be connected to primary phone power (VPH_PWR); utilize this switch as the third bypass switch to further reduce the IR drop.
  • 23.
  • 24.
    By Criterion 24 QFE2101 nnTo switch-in extra load capacitance at the VPA node (C_GSM to capacitor only) during GSM Tx. This option can be used to improve the margin for GSM ORFS/RxBN due to less IR drop, and APT mode instead of bypass mode.[2-4].
  • 25.
    By Criterion 25 TXTiming Optimization
  • 26.
    By Criterion 26 RampingProfile nn Effect of different Ramp timing on Switching Transients[44].
  • 27.
    By Criterion 27 RampingProfile nn Nevertheless, there is a trade-off between GSM PvT and GSM ORFS due to switching @400kHz with high PCL[6]. nn Hence, tune ramping profile to pass PVT and ORFS specification simultaneously[6,8].
  • 28.
    By Criterion 28 GSMRF Timing Adjustment nn In general, there are six types of GSM RF timing adjustment, as shown below[10]:
  • 29.
    By Criterion 29 GSMRF Timing Adjustment
  • 30.
    By Criterion 30 GSMRF Timing Adjustment nn pa_en_start/stop_offset_adj:The PA enable signal start/stop time adjustment value can be altered to move the rising edge of the PA enable signal forward or backward to get the optimal configuration[9]. nn pa_start/stop_offset_adj :The PA turn-on/off time adjustment value can be altered to adjust the rising edge of the TDMA Tx power burst[9]. nn ant_timing_start/stop_offset_adj : The antenna select control signal start/stop time adjustment value can be altered to move the falling edge of antenna select control signal forward or backward relative to the PA enable signal falling edge to get the optimal configuration[9].
  • 31.
    By Criterion 31 PAON Timing[9]
  • 32.
    By Criterion 32 PAOFF Timing[9]
  • 33.
    By Criterion 33 PARamp Up Timing[9]
  • 34.
    By Criterion 34 PARamp Down Timing[9]
  • 35.
  • 36.
  • 37.
    By Criterion 37 PotentialIssues of Improper Tx Timing nn In addition to PvT and ORFS, Improper Tx timing value may cause improper power in certain hardware boards[9]. nn For MIPI PA device, PA ON signal is expected earlier than the PA range signal, since PA ON script sets PA to the lowest gain state and overrides the settings in the PA range script[9].
  • 38.
    By Criterion 38 PotentialIssues of Improper Tx Timing nn If PA ON is later than PA range timing, the power will be lower than expected; e.g. Max Tx power is merely ~20 dBm[9] nn The error message can be observed in QXDM log[9].
  • 39.
    By Criterion 39 PotentialIssues of Improper Tx Timing nn And the improper power may cause EDGE calibration or registration failure in certain hardware boards[9] nn Failed to calibrate GSM850 due to improper PA timing applied[9]. nn Failed to calibrate GSM900 per improper PA timing applied[9].
  • 40.
    By Criterion 40 PotentialIssues of Improper Tx Timing nn In the case, PCS1900, there is ORFS issue at low temperature, and which is independent of PCL. nn Nevertheless, the issue was NOT observed in DCS1800.
  • 41.
    By Criterion 41 PotentialIssues of Improper Tx Timing nn First, we did NOT observe this issue in FTM(Factory Test Mode). In other words, the issue disappears without RX operation. nn Second, we did NOT observe this issue at transceiver output, as shown below :
  • 42.
    By Criterion 42 PotentialIssues of Improper Tx Timing nn Because there are merely two blocks(transceiver and PAMiD) in TX chain, so we conclude that this issue is related to PAMiD[74], especially ASM timing.
  • 43.
    By Criterion 43 PotentialIssues of Improper Tx Timing nn There are two statuses for TX mode while RX is operating : uuDisable Status(Default) : uuIsolation Status: RX OFF RX ON ASM_TX OFF ASM_TX ON Level Time RX OFF RX ON ASM_TX OFF ASM_TX ON Level Time ASM RX TX PA ASM RX TX PA RX OFF RX ON ASM_TX ON Level Time RX OFF RX ON ASM_TX ON Level Time
  • 44.
    By Criterion 44 PotentialIssues of Improper Tx Timing nn For disable status, when switching to Tx state under low temperature, it may take up to 100 µS for the switch to be fully operational and RF compliant. That’s to say, there will be delay in TX timing while switching from TX OFF to TX ON[28]. nn As mentioned earlier, the antenna select control signal start/stop time affects ORFS performance. That’s why ORFS fails. RX OFF RX ON ASM_TX OFF ASM_TX ON Level Time RX OFF RX ON ASM_TX OFF ASM_TX ON Level Time
  • 45.
    By Criterion 45 PotentialIssues of Improper Tx Timing nn For isolation status, TX is still ON while RX is ON, but TX port will shunt to ground while RX is ON. That’s why it’s called “isolation” status. nn Because TX is always ON, there will be NO delay in TX timing while switching from TX OFF to TX ON. Hence the issue passes after introducing Isolation Status. RX OFF RX ON ASM_TX ON Level Time RX OFF RX ON ASM_TX ON Level Time ASM RX TX PA ASM RX TX PA
  • 46.
    By Criterion 46 PotentialIssues of Improper Tx Timing nn Besides, DCS1800 RX path is different from PCS1900 RX path. Chances are that PCS1900 takes longer time switching from RX port to TX port than DCS1800, so we did NOT observe this issue in DCS1800. RX OFF RX ON Level Time ASM_TX OFF ASM_TX ON ASM_TX OFF ASM_TX ON PCS DCS RX OFF RX ON Level Time ASM_TX OFF ASM_TX ON ASM_TX OFF ASM_TX ON PCS DCS
  • 47.
    By Criterion 47 RFPower Amplifier
  • 48.
    By Criterion 48 Linearity nnAs mentioned above, ORFS is just the concept of ACLR. And the formula of ACLR is : ACLR = 2(Pin - OIP3 + G)+C, where C is correction coefficient nn Hence, the better the linearity is, the better the ORFS due to switching will be[45,46].
  • 49.
    By Criterion 49 Temperature nnIn general, the higher the temperature is, the worse the OIP3 will be[47]. nn Thus, chances are that high temperature leads to worse ORFS due to switching[15].
  • 50.
    By Criterion 50 Layout nnThus, the GND vias should be as numerous as possible to spread the heat[48,63].
  • 51.
    By Criterion 51 Temperature nnAs shown below, the lower the temperature is, the higher the gain will be[47]. nn Thus, with constant Pin, lower temperature leads to higher Pout[49].
  • 52.
    By Criterion 52 Temperature nnAs shown below, the larger Pout is, the worse the ACLR will be. nn That’s to say, chances are that low temperature leads to low ORFS due to switching margin[43].
  • 53.
    By Criterion 53 TemperatureCompensation nn Hence, we have to do temperature compensation to make Pout identical under all temperatures. nn By doing this, the Pout under low temperature will not be too high, thereby improving ORFS due to switching under low temperature.
  • 54.
    By Criterion 54 TemperatureCompensation nn Nevertheless, with temperature compensation, the ORFS due to switching under high temperature may aggravate more.
  • 55.
    By Criterion 55 TemperatureCompensation nn As mentioned earlier, high temperature aggravates linearity, thereby degrading ORFS due to switching. nn With TC(Temperature Compensation), the Pout under high temperature becomes larger. With worse linearity and larger Pout, that’s why ORFS due to switching under high temperature may aggravate more with TC.
  • 56.
    By Criterion 56 RampingProfile Adjustment nn Hence, with TC, adjust the ramping profile under high temperature to improve ORFS due to switching because Power versus time (PVT) variation is one of the most important features for describing electrothermal performance of RF power amplifiers (PAs)[51,52].
  • 57.
    By Criterion 57 PAOutput Matching Network Adjustment nn Besides, adjust PA output matching network to improve linearity and lower noise floor, thereby improving ORFS due to switching and RxBN under high temperature with TC[6].
  • 58.
    By Criterion 58 PAOutput Matching Network Adjustment nn As mentioned earlier, 8PSK has more strict linearity than GMSK. In other words, if ORFS issue is related to PA linearity, the symptom should be:
  • 59.
    By Criterion 59 PAInput Matching Adjustment nn As shown below, the PA input matching networks is DA’s(Driver Amplifier) load-pull as well. nn In other words, good ORFS@PA input leads to good ORFS@PA output[50,53]. nn Hence, to optimize PA input matching network can be used to improve ORFS as well.
  • 60.
    By Criterion 60 PAPost loss nn According to the following formula : with constant target power, larger PA post loss leads to larger PA output power, thereby aggravating ORFS-SW @ +- 400 kHz, even though PA’s output impedance is close to 50Ω[11]. Target Power = PA Output Power – PA Post loss nn Thus, minimize the PA post loss to have more headroom in Tx power. Because LB has larger max power than HB, headroom equal to 0.7 dB from 32.5 dBm(i.e. 33.2 dBm) is preferred[11].
  • 61.
    By Criterion 61 Stability nnIn the case, LB EDGE ORFS test fails in both modulation/switching spectrum when PCL is set < 10(High Power Mode), and passes when PCL is set ≥ 11(Low Power Mode)[11].
  • 62.
    By Criterion 62 Stability nnFirstly, the best ORFS due to modulation result was found to be only approximately -43 dB, even after tuning the path delay, but it can reach -60 dB[11]. ORFS-MO Before After -400KHz -43.1158 dB < -60 dB +400KHz -43.0755 dB < -60 dB ORFS-MO Before After -400KHz -43.1158 dB < -60 dB +400KHz -43.0755 dB < -60 dB nn Besides, many spurs are found(shown as yellow traces in the graph), according to the analysis, the PA is oscillating[11].
  • 63.
    By Criterion 63 Stability nnAccording to the K-factor definition, the stability depends on S-parameter[56]. Chances are that the components marked as red circle affect the S-parameter and stability of QFE2320, thereby oscillating[11] nn Because the issue occurs in LB, the components marked as red circle must be changed to remove oscillation[11].
  • 64.
    By Criterion 64 Stability nnTherefore, after tuning the path delay and changing the BOM, LB EDGE ORFS margin is sufficient for all PCL[11].
  • 65.
    By Criterion 65 SwitchPoint nn For this case, EDGE LB ORFS fails at PCL8, PCL12, and PCL16. nn As mentioned above, If failure is at maximum power and improves as power is reduced, the issue is likely due to linearity. Thus, it fails at PCL8 but passes at PCL9 ~ PCL11[10,16]. PCL 8 9 10 11 Result Fail Pass Pass Pass PCL 12 13 14 15 Result Fail Pass Pass Pass PCL 16 17 18 19 Result Fail Pass Pass Pass
  • 66.
    By Criterion 66 SwitchPoint nn In general, there is hysteresis from the switching point where the PA rises from a lower gain to a higher gain, and vice versa to avoid the PA oscillating at the switching point[64]. nn In other words, as illustrated below, for EDGE single- slot, 19 dBm(PCL12) can be achieved by high gain mode or mid gain mode; 11 dBm(PCL16) can be achieved by mid gain mode or low gain mode.
  • 67.
    By Criterion 67 SwitchPoint nn Hence, as illustrated below, if 11 dBm is achieved by low gain mode, the PA will be in saturation region, thereby degrading linearity and aggravating ORFS. So is 19 dBm(PCL 12). nn In order to solve this issue, make these output power @ switch points be in proper gain mode to be in linear region[16].
  • 68.
  • 69.
    By Criterion 69 Materialissue nn If the connector is abnormal, the antenna matching network may alter PA’s output impedance, thereby aggravating ORFS. nn Besides, abnormal connector leads to leakage. And as shown below, with constant target power(e.g. LB 32.5 dBm or HB 29.5 dBm), the larger the leakage is, the larger the PA output power will be, thereby aggravating ORFS.
  • 70.
    By Criterion Layout issue nnIn the case, it is very difficult to pull load impedance to 50 Ω for the common path[11]. nn Hence, ORFS due to switching performance is not good enough.
  • 71.
    By Criterion Layout issue nnBecause the signal pad size of the RF connector is very large(0.6 mm × 0.7 mm). According to simulation, if using L9 as RF GND, it introduces serious mismatching. nn Thus, areas under the pads of the RF connector in L9, L8, and L7 should be cut out, and set L6 as the reference GND, to get better impedance[11]. Signal Pad GND Pad L9 L8 L7 L6 Impedance 14 Ω 32 Ω 44 Ω 53 Ω
  • 72.
  • 73.
    By Criterion 73 VCOPulling nn In the case, GSM ORFS (modulation and switching) is observed to be failing by about 5−6 dB on quad-band GSM some channels at high power level (LB: PCL5; HB: PCL0)[30]. nn The max power at connector can be 34 dBm for LB, and 31 dBm for HB. Besides, the PA’s load-pull is close to 50Ω for both LB and HB. In other words, the issue is NOT related to PA linearity.
  • 74.
    By Criterion 74 VCOPulling nn As shown below, the issue can be solved with SPDT.
  • 75.
    By Criterion 75 VCOPulling nn Without SPDT, the issue is root caused too high Tx power during GSM operation leaking into FBRx path through front-end coupler and later coupling into TX quadrature up-converter of transceiver[16,17,30,72].
  • 76.
    By Criterion 76 VCOPulling nn An SPDT (with bypass option) is recommended at front end, as shown here to isolate GSM Tx power from leaking into FBRx path[17,30]. nn Since FBRx is not operational in GSM mode. FBRX only works in 3G/4G mode. So this switch (SPDT) does not impact GSM operation[16,30]. nn Two possible implementations during GSM operation are shown here[30]:
  • 77.
    By Criterion 77 VCOPulling nn In the case, as shown below, ORFS-MO passes if we press the shielding can, and it fails without press.
  • 78.
    By Criterion 78 VCOPulling nn As shown below, PA will couple TX signal onto the shielding can. In other words, there will be residual TX signal on the shielding can. nn With good grounding, the residual TX signal will flow to GND completely. Without good grounding, the shielding can will reflect the residual TX signal.
  • 79.
    By Criterion 79 VCOPulling nn Thus, with press, the residual TX signal flows to GND completely due to good grounding. nn If possible, don’t put PA and transceiver in the same shielding area to avoid VCO pulling.
  • 80.
    By Criterion 80 VCOPulling nn As mentioned earlier, the PA input matching networks is DA’s(Driver Amplifier) load-pull as well. nn Besides, for Direct-Conversion transmitter architecture, the RF frequency is the same as LO. So if PA input matching is not close to 50Ω, the reflection due to poor S11 may interfere VCO, thereby aggravating ORFS-MO.
  • 81.
    By Criterion 81 VCOPulling nn In the case, the relationship between ORFS-MO and ASM is as below : Antenna Switch Module Vendor A (With Original RX Matching) Vendor B (With Original RX Matching) Vendor B (With New RX Matching) Pass Fail Pass
  • 82.
    By Criterion 82 VCOPulling nn If we set TX port as Port 1, and RX port as Port 2, S21 is just the isolation between TX port and RX port, as shown below : nn Hence, the isolation depends on TX matching, RX matching, and ASM.
  • 83.
    By Criterion 83 VCOPulling nn Therefore, vendor B ASM degrades isolation, and ORFS-MO fails. nn With vendor B ASM, we introduce new RX matching, and isolation improves, thereby improving ORFS-MO. nn As shown below, the isolation affects VCO pulling through RX path.
  • 84.
    By Criterion 84 KeepOut Area nn Besides, keep-out areas on PCB layer 1 are required to avoid sensitive on-chip components such as VCO[73].
  • 85.
    By Criterion 85 KeepOut Area nn Otherwise, the parasitic effect aggravates phase noise, thereby degrading ORFS-MO[10]. nn In general, check the LO phase noise at 400 kHz offset, it should be better than -118 dBc/Hz[10].
  • 86.
  • 87.
    By Criterion 87 IRDrop nn IR drop refers to a voltage drop that appears at the resistive component of any impedance. This voltage drop across any resistance is the product of current (I) passing through resistance and resistance value (R). nn If there is IR drop issue in the supply voltage of any TX chain blocks, such as transceiver, PA, and ASM, the TX performance including ORFS will aggravate[24].
  • 88.
    By Criterion 88 IRDrop nn In the case, LB GSM ORFS-MO fails for high power mode In low temperature. nn We found the ORFS-MO issue appears not only in connector, but also in transceiver output. As mentioned above, poor ORFS performance in PA input leads to worse ORFS performance in PA output.
  • 89.
    By Criterion 89 IRDrop nn Thus, there are three possible factors related transceiver: Layout, supply voltage, and material issue. nn After changing the BOM for transceiver supply voltage, the issue is solved.
  • 90.
    By Criterion 90 IRDrop nn As mentioned above, low temperature makes gain increase. Higher gain leads to higher Icc, thereby increasing IR drop. nn In addition, with max PCL, low band has larger output power than high band. So the issue occurred in LB instead of HB[57]. LB 14 dBm HB 11 dBm
  • 91.
    By Criterion 91 IRDrop nn As shown below, power is getting lower as supply voltage drops[11]. In other words, the lower the supply voltage is, the lower power will be.
  • 92.
    By Criterion 92 IRDrop nn In other words, with constant target power(e.g. LB 32.5 dBm or HB 29.5 dBm), the larger the IR drop is, the larger PA output power and current consumption(i.e. Icc) will be, thereby aggravating ORFS-SW performance. IR drop PA Output Power & Icc IR drop PA Output Power & Icc
  • 93.
    By Criterion 93 IRDrop nn Besides, as shown below, the larger the temperature is, the larger the resistance including chip resistor or trace will be, thereby increasing IR drop.
  • 94.
    By Criterion 94 IRDrop nn As mentioned above, with TC(Temperature Compensation), the Pout under high temperature becomes larger. With worse linearity and larger Pout, that’s why ORFS due to switching under high temperature may aggravate more with TC. nn Thus, with TC and IR drop, ORFS-SW aggravates more in high temperature.
  • 95.
    By Criterion 95 DecouplingCapacitor nn Due to burst mode characteristic, GSM PA is being ON and OFF all the time. As shown below, while PA is ON, there will be unwanted 20KHz signal riding on DC, which is just ripple. Any supply disturbances caused by on/off activities could directly convert to ORFS issue[10].
  • 96.
    By Criterion 96 DecouplingCapacitor nn As shown below, larger decoupling capacitor can help improve spectral regrowth, thereby improving ORFS[31].
  • 97.
    By Criterion 97 DecouplingCapacitor nn Besides, the decoupling capacitor should be as close to PA as possible. Otherwise, PA supply transient current may leak into other ICs, and transient current from other ICs may leak into GSM PA, thereby aggravating ORFS performance[10].
  • 98.
    By Criterion 98 DecouplingCapacitor nn Besides, the supply voltage of LO is important as well. nn As shown below, change C3115 from 220nF to 4.7uF, ORFS-MO at 1.6 MHz offset improves.
  • 99.
    By Criterion 99 DecouplingCapacitor nn The lower ESL is, the wider capacitive range will be. nn The lower ESR is, the lower ripple will be
  • 100.
    By Criterion 100 DecouplingCapacitor nn The path the noise flows inside 3-terminal capacitor is shorter than which inside 2-terminal capacitor. That’s to say, the 3-terminal capacitor has lower ESL and ESR.
  • 101.
    By Criterion 101 DecouplingCapacitor nn Compared to multiple capacitors, the 3-terminal capacitor has better noise suppression, and it doesn’t have anti-resonance issue. Besides, the 3-terminal capacitor can save PCB area due to less components[75].
  • 102.
    By Criterion 102 StarRouting nn Use star routing from battery to PMIC and PA. Besides, the branch point should be as close to battery as possible[10]. nn As shown below, the length of coupling path 2 is shorter than coupling path 1, so the noise from GSM PA may leak to PMIC. That’s why branch point should be close to battery.
  • 103.
    By Criterion 103 StarRouting nn In the case, at high power level of GSM low bands, ORFS modulation performance is marginal, especially at the 400 kHz offset. nn The issue is dependent on PCL. It disappears at low power level such as PCL19. Chances are that the issue is related to PA linearity, so we checked transceiver output performance to eliminate the influence of PA.
  • 104.
    By Criterion 104 StarRouting nn The issue already appears at transceiver output, so there are three possibilities : material, layout, and voltage supply. nn With an external voltage supply, the issue improved.
  • 105.
    By Criterion 105 StarRouting nn Due to burst mode characteristic, GSM PA has strong transient current. That’s why the issue disappears at low power level because low power level leads to low transient current. And that’s why the issue appears at high power level of GSM low bands because PCL5 of LB (33 dBm) is larger than PCL0 of HB(30 dBm). nn As shown below, the coupling path : GSM PA => PMIC => transceiver
  • 106.
    By Criterion 106 StarRouting nn In the case, as shown below, ORFS modulation performance fails when monitor is ON, but performance is good when monitor is OFF. nn Besides, the issue appears at GSM quad-band, especially at the 400 kHz offset. And the issue is independent on power level.
  • 107.
    By Criterion 107 StarRouting nn This is because backlight driver IC has strong transient current as well. That’s why the issue disappears when monitor is OFF. nn As shown below, Coupling path 1 : Backlight driver IC => PA Coupling path 2 : Backlight driver IC => PMIC => Transceiver
  • 108.
    By Criterion 108 StarRouting nn Thus, increase the decoupling capacitor and power inductor value for Backlight driver IC, and the performance improved.
  • 109.
    By Criterion 109 StarRouting nn Similarly, use star routing from PMIC to VBATT pin and Vcc_GSM pin of GSM PA separately, and the branch point should be as close to PMIC as possible. nn At least, the branch point should NOT be close to GSM PA, as shown below :
  • 110.
    By Criterion 110 StarRouting nn If the branch point is close to GSM PA, make the VPH_PWR common part(marked as pink) and separate part(marked as green) on different layer. As shown below, the coupling path(marked as yellow) has high impedance to avoid noise coupling between the 2 pins.
  • 111.
    By Criterion 111 HighFrequency Noise nn In the case, as shown below, ORFS-MO passes if we press the PA shielding can, and it fails without press. Besides, after removing shielding can, it passes as well. nn PA and transceiver are in separate shielding area, so the issue is NOT related to VCO pulling.
  • 112.
    By Criterion 112 HighFrequency Noise nn As mentioned earlier, without good grounding, the shielding can will reflect the residual TX signal. With press, the residual TX signal flows to GND completely due to good grounding. nn In addition, no shielding can, no residual TX signal. That’s why the issue disappears after removing shielding can.
  • 113.
    By Criterion 113 HighFrequency Noise nn Thus, the issue is due to that residual RF TX signal reflects to PA Vcc by shielding can. In terms of DC voltage, RF signal is regarded as noise. nn There’re usually large capacitor for decoupling and small capacitor for filtering high frequency noise. For the issue, we can modify small capacitor value to filter residual RF TX signal.
  • 114.
  • 115.
    By Criterion 115 XOHarmonics nn In the case, on certain channels of GSM high bands, ORFS switching and modulation performance is marginal, especially at the 400 kHz offset. nn The most affected channels are DCS channel 599, 600, 602, 791, 792, 794, and 795; and PCS channel 668.
  • 116.
    By Criterion 116 XOHarmonics nn As shown in the table below, these channels are all 90 times 19.2 MHz approximately in terms of frequency. In other words, these channel are related to XO harmonics. nn Baseband chip has an internal issue related to XO harmonics coupling into TX I/Q lines that cause degradation of ORFS performance only in GSM high bands[13,14]. Band Channel Frequency 19.2 MHz * N 599 1727.6 89.97916667 600 1727.8 89.98958333 602 1728.2 90.01041667 791 1766 91.97916667 792 1766.2 91.98958333 794 1766.6 92.01041667 795 1766.8 92.02083333 PCS 668 1741.4 90.69791667 DCS Band Channel Frequency 19.2 MHz * N 599 1727.6 89.97916667 600 1727.8 89.98958333 602 1728.2 90.01041667 791 1766 91.97916667 792 1766.2 91.98958333 794 1766.6 92.01041667 795 1766.8 92.02083333 PCS 668 1741.4 90.69791667 DCS
  • 117.
    By Criterion 117 XOHarmonics nn As shown above, the solution is to add series L and shunt C onto each of the TX_I/Q lines[63]. nn As the spur level is reduced, and therefore the ORFS modulation is improved[63]. nn This LC filter can also help reduce the number of exceptions for the GSM Rx band noise[63]. w/o solution w/ solution
  • 118.
    By Criterion 118 XOHarmonics nn The trace between transceiver and PMIC is rich in XO harmonics because it is XO reference clock. nn Thus, we need to put a R-C filter to reject XO harmonics and a DC block to reject DC offset. nn Besides, we need to keep the trace away from I/Q signal to avoid ORFS issue.
  • 119.
    By Criterion 119 XOHarmonics nn The digital XO signal and the analog XO signal can corrupt each other; the layout should provide isolation between them. Isolation is highly recommended [77]. nn As shown below, they are too close.
  • 120.
    By Criterion 120 I/QImbalance nn I/Q imbalance can be characterized by: a phase mismatch that can happen between the I and the Q components of the local oscillator signals, which becomes not exactly 90 degrees, and an amplitude mismatch due to the gain difference of the mixers of the I and Q branches[70].
  • 121.
    By Criterion 121 I/QImbalance nn As shown below, I/Q imbalance aggravates image, thereby aggravating sideband suppression and ORFS- MO. nn Thus, we need to adjust phase and amplitude offsets between I and Q channel by means of calibration to lower image to improve ORFS-MO[69].
  • 122.
    By Criterion 122 I/QImbalance nn Besides, in terms of modulator, high temperature aggravates sideband suppression as well, thereby aggravating ORFS-MO. So good thermal design of transceiver is important[69]. nn This is especially important for direct up-conversion transmitter because I/Q imbalance are the inherent shortcomings of it[69].
  • 123.
    By Criterion 123 I/QImbalance nn Ideally, the four traces on the IQ signal path from the DAC output to the modulator input should be symmetrical between the I channel and Q channel and between the positive side and negative side within a channel[69]. nn In reality, due to PCB layout, trace lengths are not perfectly matched. The mismatches cause the signal in one channel to be skewed from the other, and, therefore, result in IQ imbalance(both gain and phase)[69].
  • 124.
    By Criterion 124 LOLeakage(Carrier Leakage) nn Excessive DC offsets in I/Q channels cause high levels of LO leakage, thereby aggravating ORFS-MO[69]. nn According to the formula shown below, the more the DC offsets in I/Q channels, the larger the LO leakage will be[69]. = + +
  • 125.
    By Criterion 125 LOLeakage(Carrier Leakage) nn Thus, we need to remove DC Offsets by means of calibration to lower LO leakage to improve ORFS- MO[69]. nn In terms of modulator, high temperature aggravates carrier suppression as well, thereby aggravating ORFS- MO. So good thermal design of transceiver is important[69].
  • 126.
  • 127.
    By Criterion 127 Charging nnIn the case, when charging is enabled, GSM850, ch190, ORFS-MO failure (0.5 dB) is observed at 600 kHz offset measurement[18].
  • 128.
    By Criterion 128 Charging nnFor a 5 V DCP(Dedicated Charging Port) plug-in, the charging frequency is set to 600 kHz. nn Spur coupling path: PMIC buck switching (600 kHz) spurs leaking into the Vbatt and appears at the Tx-RF output through QET4101 and PA[18]. nn Hence, there will be +- 600 KHz offset ORFS-MO issue due to 2nd order intermodulation mechanism.
  • 129.
    By Criterion 129 Charging nnAdding a Pi (π) filter on the VPH_PWR rail attenuates the charger spur by 20 dB and passes the GSM ORFS specification[18]. nn As a workaround, the placeholder for the π filter should be provided at the QET4101 input to attenuate spur coupling from the PMIC charger and also a 0 Ω (0201 package) placeholder at power supply line of PA (VCC1_PA) for noise filtering[18].
  • 130.
    By Criterion 130 Charging nnAs shown below[18]:
  • 131.
    By Criterion 131 SMPS nnIn the case, GSM ORFS modulation spectrum periodicity jump in all bands and all power levels, especially the mid-power level[28]. nn IC NCP6335 is external SMPS(Switching Mode Power Supply) to the MSM8X25Q core. The NCP6335 is the main interference source to ORFS[28,75-76].
  • 132.
    By Criterion 132 SMPS nnNCP6335 has PFM and PWM operation for optimum increased efficiency, The transition between PWM/PFM modes can occur Automatically, that’s why ORFS-MO spectrum periodicity jump[28]. nn Set NCP6335 to forced PWM, and ORFS-MO passed.
  • 133.
  • 134.
    By Criterion 134 CommonGND nn In the case, with all decoupling capacitor and bypass capacitors, ORFS fails; without all decoupling capacitor and bypass capacitor, ORFS passes.
  • 135.
    By Criterion 135 CommonGND nn This is because transient current and high frequency noise may leak into PA Vcc through these capacitors by means of common GND on top layer.
  • 136.
    By Criterion 136 CommonGND nn Thus, make these shunt capacitors GND pad separate from common GND on top layer(i.e. GND Island), and add GND via as many as possible. nn If GND island is bound by PCB area, at least, the GND via should be as many as possible.
  • 137.
    By Criterion Noise 137 Common GND nnAs mentioned above, we’re able to use Pi (π) filter to attenuate the noise. Nevertheless, the GND of capacitors should be separate. Otherwise, the noise may bypass the capacitors through common ground, thereby aggravating filtering effect.
