Agile@Scale: be SAFe!
DAD & SAFe
07 Aprile 2014
@felicepescatore Disciplined Agile Delivery Italy Groupwww.felicepescatore.it
Felice Pescatore
Agile@Scale: be SAFe!
Reality is complex… software is complex!
COMPLEX
Emergent
Practices
COMPLICATED
Good
Practices
CHAOTIC
Novel
Practices
SIMPLE
Best
Practices
Cynefin Model
2
Agile@Scale: be SAFe!
Too complicated and too complex for traditional
approach
If a process is too unpredictable or too complicated for the planned,
(predictive) approach, then the empirical approach (measure and adapt)
is the method of choice. - Ken Schwaber
3

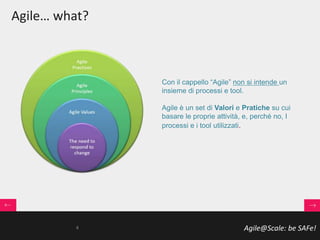

Agile@Scale: be SAFe!
Con il cappello “Agile” non si intende un
insieme di processi e tool.
Agile è un set di Valori e Pratiche su cui
basare le proprie attività, e, perché no, I
processi e i tool utilizzati.
Agile… what?
4
Agile@Scale: be SAFe!
Agile Manifesto
5
Agile@Scale: be SAFe!
What Agile isn’t…
6
Agile@Scale: be SAFe!

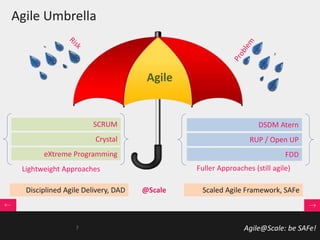

DSDM Atern
RUP / Open UP
FDD
Fuller Approaches (still agile)
SCRUM
Crystal
eXtreme Programming
Lightweight Approaches
Disciplined Agile Delivery, DAD Scaled Agile Framework, SAFe@Scale
Agile
Agile Umbrella
7

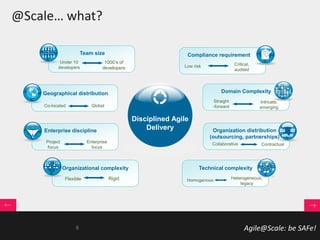

Agile@Scale: be SAFe!
Domain Complexity
Straight
-forward
Intricate,
emerging
Compliance requirement
Low risk Critical,
audited
Team size
Under 10
developers
1000’s of
developers
Co-located
Geographical distribution
Global
Enterprise discipline
Project
focus
Enterprise
focus
Technical complexity
Homogenous Heterogeneous,
legacy
Organization distribution
(outsourcing, partnerships)
Collaborative Contractual
Disciplined Agile
Delivery
Flexible Rigid
Organizational complexity
@Scale… what?
8
Agile@Scale: be SAFe!
A project is more than only development…
@Scale… why?
9
Agile@Scale: be SAFe!

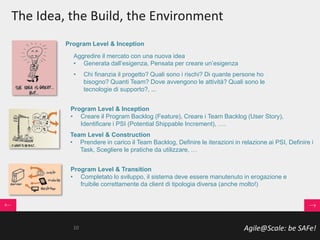

The Idea, the Build, the Environment
Aggredire il mercato con una nuova idea
• Generata dall’esigenza, Pensata per creare un’esigenza
• Chi finanzia il progetto? Quali sono i rischi? Di quante persone ho
bisogno? Quanti Team? Dove avvengono le attività? Quali sono le
tecnologie di supporto?, ...
Program Level & Inception
Program Level & Inception
• Creare il Program Backlog (Feature), Creare i Team Backlog (User Story),
Identificare i PSI (Potential Shippable Increment), ….
Team Level & Construction
• Prendere in carico il Team Backlog, Definire le iterazioni in relazione ai PSI, Definire i
Task, Scegliere le pratiche da utilizzare, …
Program Level & Transition
• Completato lo sviluppo, il sistema deve essere manutenuto in erogazione e
fruibile correttamente da client di tipologia diversa (anche molto!)
10

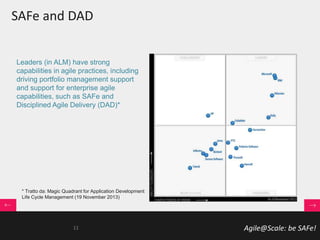

Agile@Scale: be SAFe!
Leaders (in ALM) have strong
capabilities in agile practices, including
driving portfolio management support
and support for enterprise agile
capabilities, such as SAFe and
Disciplined Agile Delivery (DAD)*
* Tratto da: Magic Quadrant for Application Development
Life Cycle Management (19 November 2013)
SAFe and DAD
11
Agile@Scale: be SAFe!
SAFe, Scaled Agile Framework
• Framework maturo per l’adozione di
pratiche Agili all’interno di contesti
Enterprise
• In grado di gestire, con successo, un
ampio numero di «Agilisti» e di Team
• Costruito sui principi delle metodologie
Agile@Core e Lean
• Sincronizzazione tra sviluppo e delivery
Grazie alla «Big Picture» è possibile evidenziare le
relazioni ed i ruoli dei vari attori aziendali che
concorrono al processo Agile@Scale, unitamente
agli artefatti e le cerimonie di riferimento
12
Agile@Scale: be SAFe!

SAFe «Big Picture»
13

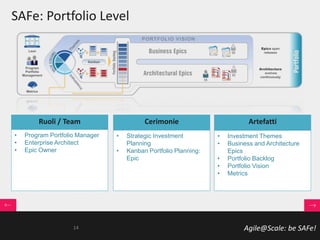

Agile@Scale: be SAFe!
SAFe: Portfolio Level
Ruoli / Team
• Program Portfolio Manager
• Enterprise Architect
• Epic Owner
Cerimonie
• Strategic Investment
Planning
• Kanban Portfolio Planning:
Epic
Artefatti
• Investment Themes
• Business and Architecture
Epics
• Portfolio Backlog
• Portfolio Vision
• Metrics
14

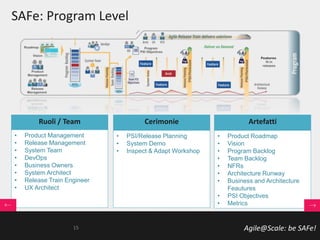

Agile@Scale: be SAFe!
SAFe: Program Level
Ruoli / Team
• Product Management
• Release Management
• System Team
• DevOps
• Business Owners
• System Architect
• Release Train Engineer
• UX Architect
Cerimonie
• PSI/Release Planning
• System Demo
• Inspect & Adapt Workshop
Artefatti
• Product Roadmap
• Vision
• Program Backlog
• Team Backlog
• NFRs
• Architecture Runway
• Business and Architecture
Feautures
• PSI Objectives
• Metrics
15
Agile@Scale: be SAFe!

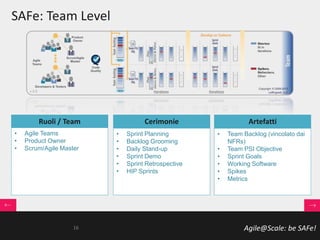

SAFe: Team Level
Ruoli / Team
• Agile Teams
• Product Owner
• Scrum/Agile Master
Cerimonie
• Sprint Planning
• Backlog Grooming
• Daily Stand-up
• Sprint Demo
• Sprint Retrospective
• HIP Sprints
Artefatti
• Team Backlog (vincolato dai
NFRs)
• Team PSI Objective
• Sprint Goals
• Working Software
• Spikes
• Metrics
16
Agile@Scale: be SAFe!
DAD, Disciplined Agile Delivery
• Framework per lo sviluppo di soluzioni
End-to-End con ampia libertà di
personalizzazione
• Costruito sui principi delle metodologie
Agile@Core e Lean
• Scalabile, people-first oriented, learning
oriented, goal-driven, enterprise aware,
risk and value driven
• Linee guida per la governance di team
enterprise secondo le best-guide Agili
Grazie alla «Big Picture» è possibile evidenziare le fasi di
sviluppo di una soluzione end-to-end in ambito enterprise
secondo i principi Agili.
DAD è un framework ibrido, Value & Risk driven, fortemente
orientano alle persone e al loro apprendimento, il tutto con la
finalità di produrre in modo ottimale il delivery della soluzione.
I
C
T
Inception
Construction
Transition
17
Agile@Scale: be SAFe!

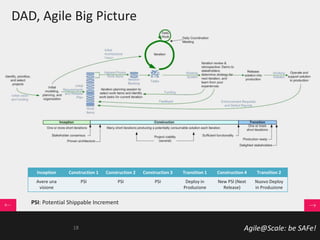

DAD, Agile Big Picture
Inception Construction 1 Construction 2 Construction 3 Transition 1 Construction 4 Transition 2
Avere una
visione
PSI PSI PSI Deploy in
Produzione
New PSI (Next
Release)
Nuovo Deploy
in Produzione
PSI: Potential Shippable Increment
18
Agile@Scale: be SAFe!

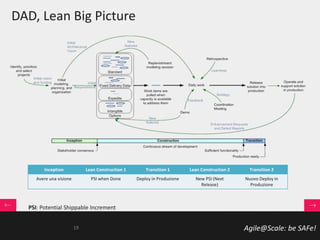

DAD, Lean Big Picture
Inception Lean Construction 1 Transition 1 Lean Construction 2 Transition 2
Avere una visione PSI when Done Deploy in Produzione New PSI (Next
Release)
Nuovo Deploy in
Produzione
PSI: Potential Shippable Increment
19
Agile@Scale: be SAFe!

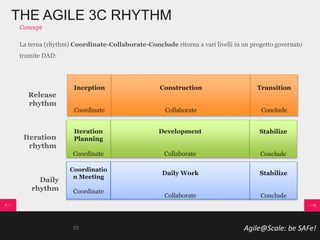

THE AGILE 3C RHYTHM
Concept
Inception
Coordinate
Construction
Collaborate
Transition
Conclude
Release
rhythm
Iteration
rhythm
Development
Collaborate
Iteration
Planning
Coordinate
Stabilize
Conclude
Daily
rhythm
Coordinatio
n Meeting
Coordinate
Daily Work
Collaborate
Stabilize
Conclude
La terna (rhythm) Coordinate-Collaborate-Conclude ritorna a vari livelli in un progetto governato
tramite DAD:
20
Agile@Scale: be SAFe!
DAD PHASES: INCEPTION
Stakeholderconsensus
Project/ProductApprovedtostart
Collaborate ConcludeCoordinate
• Individuare i possibili Team
Member;
• Pianificare una sessione di “vision”
del progetto;
• Precettare gli stakeholder per la
sessione di “vision” .
• Rifinire la Vision;
• Effettuare una prima valutazione dei
requisiti;
• Effettuare una prima ipotesi
Architetturale;
• Valutare la fattibilità del progetto;
• Creare un primo Release Plan;
• Strutturare il (i) Team;
• Settare l’ambiente;
• Garantirsi la sostenibilità economica
• Identificare i rischi.
• Review di quanto definite
(mailstone);
• Comunicare la Vision agli
stakeholder;
• Impegnarsi sulle Iterazioni ed i
rilasci continui.
Fino ad alcune ore
(se tutti gli stakeholder
sono disponibili)
Idealmente: 1-2 settimane
Media: 4 settimane
Caso Peggiore: Più mesi
Qualche ora
21
Agile@Scale: be SAFe!
DAD PHASES: CONSTRUCTION PHASE
Second
Stakeholderconsensus
SufficientFunctionality
Collaborate ConcludeCoordinate
Dimostrare che le assunzioni
Architetturali sono corretti tramite
pezzi funzionati della stessa
• Produrre incrementalmente
soluzioni utilizzabili;
• Condividere lo stato del progetto con
gli stakeholder;
• Essere in linea con gli obiettivi
organizzativi;
• Allinearsi con gli altri Team;
• Migliorare se stessi ed il Team
nell’insieme.
• Determinare quando quello che si è
sviluppato è sufficiente per il
raggiungimento degli obietti;
• Stabilizzare la soluzione.
Tipicamente: 1 iterazione
Caso peggiore: Molte
iterazioni
Tipicamente: diverse
iterazioni Idealmente: alcune ore
22
Agile@Scale: be SAFe!

DAD PHASES: AGILE CONSTRUCTION PHASE
Typical Construction Iteration for Agile DAD Approach
• Iteration
planning
• Iteration
modeling
Pratiche standard:
• Focalizzare le attività;
• Meeting di Coordinamento
giornaliero;
• Test di regressione;
• Evoluzione dell’Architettura ed
eventuali Spike relativi (task di una o
più story);
• Continuous Integration;
• Refactoring;
• Ritmo sostenibile;
• Priorizzare i work item;
• Attività di configurazione;
• “Track “done” delle attività (es.
Burndown)
• JIT model storming
• Iteration demo;
• Retrospettiva;
• Valutare le
funzionalità
sufficienti al
raggiungimento
dell’obiettivo;
• Aggiornamento del
Release plan.
2 ore per ogni
settimana
dell’iterazione
Tipicamente: due settimane nel caso di progetti standard,
Quattro settimane nel caso di progetti complessi con
integrazione tra Team cross-agile
Caso peggiore: Sei Settimane
2 ore per ogni
settimana
dell’iterazione
Pratiche avanzate:
• Test-driven development
(TDD);
• Acceptance TDD;
• Continuous deployment
(CD);
• Parallel independent
testing;
• Non-solo development;
• Look-ahead modeling;
• Look-ahead planning;
• Continuous
documentation.
Iterationstart
Potentiallyconsumablesolution
Coordinate Collaborate Conclude
23
Agile@Scale: be SAFe!
DAD PHASES: AGILE CONSTRUCTION PHASE
Typical Construction Day
Coordinate Collaborate Conclude
StartofDay
WorkingBuild
• Meeting di coordinamento
giornaliero;
• Aggiornamento della Taskboard
• Aggiornamento dell’Iteration
Burndown.
• Affrontare i problemi bloccanti;
• Creare i test;
• Sviluppare codice;
• Integrare quanto sviluppato;
• Risolvere i problemi ed i bug;
• Modellazione;
• Validazione del Codice.
• Stabilizzare quanto realizzato.
Fino a 15 minuti Tipicamente: 5 o 6 ore Idealmente: Non necessario
24
Agile@Scale: be SAFe!

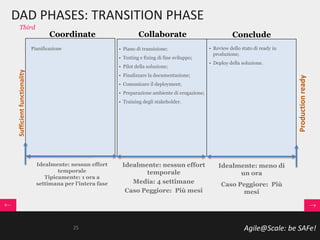

DAD PHASES: TRANSITION PHASE
Third
Sufficientfunctionality
Productionready
Collaborate ConcludeCoordinate
Pianificazione • Piano di transizione;
• Testing e fixing di fine sviluppo;
• Pilot della soluzione;
• Finalizzare la documentazione;
• Comunicare il deployment;
• Preparazione ambiente di erogazione;
• Training degli stakeholder.
• Review dello stato di ready in
produzione;
• Deploy della soluzione.
Idealmente: nessun effort
temporale
Tipicamente: 1 ora a
settimana per l’intera fase
Idealmente: nessun effort
temporale
Media: 4 settimane
Caso Peggiore: Più mesi
Idealmente: meno di
un ora
Caso Peggiore: Più
mesi
25
Agile@Scale: be SAFe!

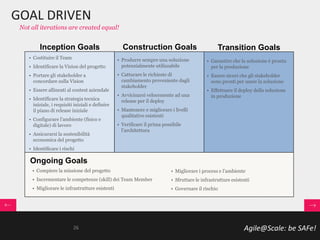

GOAL DRIVEN
Not all iterations are created equal!
Construction Goals Transition GoalsInception Goals
• Costituire il Team
• Identificare la Vision del progetto
• Portare gli stakeholder a
concordare sulla Vision
• Essere allineati al contest aziendale
• Identificare la strategia tecnica
iniziale, i requisiti iniziali e definire
il piano di release iniziale
• Configurare l’ambiente (fisico e
digitale) di lavoro
• Assicurarsi la sostenibilità
economica del progetto
• Identificare i rischi
• Produrre sempre una soluzione
potenzialmente utilizzabile
• Catturare le richieste di
cambiamento proveniente dagli
stakeholder
• Avvicinarsi velocemente ad una
release per il deploy
• Mantenere e migliorare i livelli
qualitative esistenti
• Verificare il prima possibile
l’architettura
• Garantire che la soluzione è pronta
per la produzione
• Essere sicuri che gli stakeholder
sono pronti per usare la soluzione
• Effettuare il deploy della soluzione
in produzione
• Compiere la missione del progetto
• Incrementare le competenze (skill) dei Team Member
• Migliorare le infrastrutture esistenti
Ongoing Goals
• Migliorare i process e l’ambiente
• Sfruttare le infrastrutture esistenti
• Governare il rischio
26
Agile@Scale: be SAFe!
DAD Governance Strategy
• Esistono modalità diverse di governance per i progetti @Scale, in
particolare rispetto al contesto di applicazione
• DAD supporta differenti strategie e modalità di governance
• Le strategie fanno tesoro di quanto già in essere presso l’azienda
• Applicare ogni decisione quanto più localmente possibile
Corporate
Investimenti ITOperationDelivery/Deployment
Security
Infrastrutture
(Servizi, Cloud…)
Dati
Information Technology
27
Agile@Scale: be SAFe!
SAFe Governance Deliverable and Alignments
Shared Resources
• Operat.l Acceptance Plan
• Acceptance Criteria Plan
• Reqs Specification Doc
• Sys Security Plan
• Production Ops Manual
• Security Guide
• 508 Certification
• ATO
• Privacy Impact Assess
• User Guide
• SLA
Program Portfolio Man.
• Quad Chart
• IPT Charter
• BRD
• Project Charter
• Acquisition Strategy
Program and Release
Management
• PMP
• Transition Plan
• Risk Register/Log
• Outcome Stmt
• Version Description Doc
• Deployment Plan
• Lessons Learned
• Legislation
• Budget
• Policy
• Directives
• Architectural
Standard
• Data
Exchange
Standards
• Hosting
Stregies
• Security
Standards
System Architect
• System Design Doc
System Team
• Test Evaluation
• Master Test Plan
Ruoli SAFe con responsabilità inerenti la documentazione
dell’SDLD (Software Development Lifecycle Documentation)
28
Agile@Scale: be SAFe!
DAD «on» SAFe
InceptionI ConstructionC TransitionT
I C TI C T
29
Agile@Scale: be SAFe!
DAD «on» SAFe
I
30
Agile@Scale: be SAFe!
DAD «on» SAFe
Collaborate ConcludeCoordinate
• Individuare i
possibili Team
Member;
• Pianificare una sessione di
“vision” del progetto;
• Precettare gli stakeholder per
la sessione di “vision” .
• Rifinire la Vision;
• Effettuare una prima
valutazione dei requisiti;
• Effettuare una prima ipotesi
Architetturale;
• Valutare la fattibilità del
progetto;
• Creare un primo Release Plan;
• Strutturare il (i) Team;
• Settare l’ambiente;
• Garantirsi la sostenibilità
economica
• Identificare i rischi.
• Review di quanto definite
(mailstone);
• Comunicare la Vision agli
stakeholder;
• Impegnarsi sulle Iterazioni ed
in rilasci continui.
Fino ad alcune ore
(se tutti gli stakeholder
sono disponibili)
Idealmente: 1-2 settimane
Media: 4 settimane
Caso Peggiore: Più mesi
Qualche ora
I
31
Agile@Scale: be SAFe!
DAD «on» SAFe
Collaborate ConcludeCoordinate
• Individuare i possibili Team
Member;
• Pianificare una sessione di
“vision” del progetto;
• Precettare gli stakeholder per
la sessione di “vision” .
• Rifinire la Vision;
• Effettuare una prima
valutazione dei requisiti;
• Effettuare una
prima ipotesi
Architetturale;
• Valutare la fattibilità del
progetto;
• Creare un primo Release Plan;
• Strutturare il (i) Team;
• Settare l’ambiente;
• Garantirsi la sostenibilità
economica
• Identificare i rischi.
• Review di quanto definite
(mailstone);
• Comunicare la Vision agli
stakeholder;
• Impegnarsi sulle Iterazioni ed
in rilasci continui.
Fino ad alcune ore
(se tutti gli stakeholder
sono disponibili)
Idealmente: 1-2 settimane
Media: 4 settimane
Caso Peggiore: Più mesi
Qualche ora
I
32
Agile@Scale: be SAFe!
DAD «on» SAFe
Collaborate ConcludeCoordinate
• Individuare i possibili Team
Member;
• Pianificare una sessione di
“vision” del progetto;
• Precettare gli stakeholder per
la sessione di “vision” .
• Rifinire la Vision;
• Effettuare una prima
valutazione dei requisiti;
• Effettuare una prima ipotesi
Architetturale;
• Valutare la fattibilità del
progetto;
• Creare un primo
Release Plan;
• Strutturare il (i) Team;
• Settare l’ambiente;
• Garantirsi la sostenibilità
economica
• Identificare i rischi.
• Review di quanto definite
(mailstone);
• Comunicare la Vision agli
stakeholder;
• Impegnarsi sulle Iterazioni ed
in rilasci continui.
Fino ad alcune ore
(se tutti gli stakeholder
sono disponibili)
Idealmente: 1-2 settimane
Media: 4 settimane
Caso Peggiore: Più mesi
Qualche ora
I
33
Agile@Scale: be SAFe!
DAD «on» SAFe
Collaborate ConcludeCoordinate
• Individuare i possibili Team
Member;
• Pianificare una sessione di
“vision” del progetto;
• Precettare gli stakeholder per
la sessione di “vision” .
• Rifinire la
Vision;
• Effettuare una prima
valutazione dei requisiti;
• Effettuare una prima ipotesi
Architetturale;
• Valutare la fattibilità del
progetto;
• Creare un primo Release Plan;
• Strutturare il (i) Team;
• Settare l’ambiente;
• Garantirsi la sostenibilità
economica
• Identificare i rischi.
• Review di quanto definite
(mailstone);
• Comunicare la Vision agli
stakeholder;
• Impegnarsi sulle Iterazioni ed
in rilasci continui.
Fino ad alcune ore
(se tutti gli stakeholder
sono disponibili)
Idealmente: 1-2 settimane
Media: 4 settimane
Caso Peggiore: Più mesi
Qualche ora
I
34
Agile@Scale: be SAFe!
DAD «on» SAFe
• Iteration
planning
• Iteration
modeling
Pratiche standard:
• Focalizzare le attività;
• Meeting di Coordinamento
giornaliero;
• Test di regressione;
• Evoluzione dell’Architettura ed
eventuali Spike relativi (task di
una o più story);
• Continuous Integration;
• Refactoring;
• Ritmo sostenibile;
• Priorizzare i work item;
• Attività di configurazione;
• “Track “done” delle attività (es.
Burndown)
• JIT model storming
• Iteration demo;
• Retrospettiva;
• Valutare le
funzionalità
sufficienti al
raggiungiment
o dell’obiettivo;
• Aggiornamento
del Release
plan.
Pratiche
avanzate:
• Test-driven
development (TDD);
• Acceptance TDD;
• Continuous
deployment (CD);
• Parallel independent
testing;
• Non-solo
development;
• Look-ahead
modeling;
• Look-ahead
planning;
• Continuous
documentation.
Coordinate Collaborate Conclude
C
35
Agile@Scale: be SAFe!
DAD «on» SAFe
InceptionI ConstructionC TransitionT
I C TI C T
• Iteration
planning
• Iteration
modeling
Pratiche standard:
• Focalizzare le attività;
• Meeting di Coordinamento
giornaliero;
• Test di regressione;
• Evoluzione dell’Architettura ed
eventuali Spike relativi (task di
una o più story);
• Continuous
Integration;
• Refactoring;
• Ritmo sostenibile;
• Priorizzare i work item;
• Attività di configurazione;
• “Track “done” delle attività (es.
Burndown)
• JIT model storming
• Iteration demo;
• Retrospettiva;
• Valutare le
funzionalità
sufficienti al
raggiungiment
o dell’obiettivo;
• Aggiornamento
del Release
plan.
Pratiche
avanzate:
• Test-driven
development (TDD);
• Acceptance TDD;
• Continuous
deployment (CD);
• Parallel independent
testing;
• Non-solo
development;
• Look-ahead
modeling;
• Look-ahead
planning;
• Continuous
documentation.
Coordinate Collaborate Conclude
C
36
Agile@Scale: be SAFe!
DAD «on» SAFe
• Iteration
planning
• Iteration
modeling
Pratiche standard:
• Focalizzare le attività;
• Meeting di Coordinamento
giornaliero;
• Test di regressione;
• Evoluzione dell’Architettura ed
eventuali Spike relativi (task di
una o più story);
• Continuous Integration;
• Refactoring;
• Ritmo sostenibile;
• Priorizzare i
work item;
• Attività di configurazione;
• “Track “done” delle attività (es.
Burndown)
• JIT model storming
• Iteration demo;
• Retrospettiva;
• Valutare le
funzionalità
sufficienti al
raggiungiment
o dell’obiettivo;
• Aggiornamento
del Release
plan.
Pratiche
avanzate:
• Test-driven
development (TDD);
• Acceptance TDD;
• Continuous
deployment (CD);
• Parallel independent
testing;
• Non-solo
development;
• Look-ahead
modeling;
• Look-ahead
planning;
• Continuous
documentation.
Coordinate Collaborate Conclude
C
37
Agile@Scale: be SAFe!
DAD «on» SAFe
38
• Iteration
planning
• Iteration
modeling
Pratiche standard:
• Focalizzare le attività;
• Meeting di Coordinamento
giornaliero;
• Test di regressione;
• Evoluzione dell’Architettura ed
eventuali Spike relativi (task di
una o più story);
• Continuous Integration;
• Refactoring;
• Ritmo sostenibile;
• Priorizzare i work item;
• Attività di configurazione;
• “Track “done” delle attività (es.
Burndown)
• JIT model storming
• Iteration demo;
• Retrospettiva;
• Valutare le
funzionalità
sufficienti al
raggiungiment
o dell’obiettivo;
• Aggiornamento
del Release
plan.
Pratiche avanzate:
• Test-driven
development
(TDD);
• Acceptance TDD;
• Continuous deployment
(CD);
• Parallel independent
testing;
• Non-solo development;
• Look-ahead modeling;
• Look-ahead planning;
• Continuous
documentation.
Coordinate Collaborate Conclude
C
Agile@Scale: be SAFe!
DAD «on» SAFe
• Iteration
planning
• Iteration
modeling
Pratiche standard:
• Focalizzare le attività;
• Meeting di Coordinamento
giornaliero;
• Test di regressione;
• Evoluzione dell’Architettura ed
eventuali Spike relativi (task di
una o più story);
• Continuous Integration;
• Refactoring;
• Ritmo sostenibile;
• Priorizzare i work item;
• Attività di configurazione;
• “Track “done” delle attività (es.
Burndown)
• JIT model storming
• Iteration
demo;
• Retrospettiva;
• Valutare le
funzionalità
sufficienti al
raggiungiment
o dell’obiettivo;
• Aggiornamento
del Release
plan.
Pratiche avanzate:
• Test-driven
development (TDD);
• Acceptance TDD;
• Continuous deployment
(CD);
• Parallel independent
testing;
• Non-solo development;
• Look-ahead modeling;
• Look-ahead planning;
• Continuous
documentation.
Coordinate Collaborate Conclude
C
39
Agile@Scale: be SAFe!
DAD «on» SAFe
I C TI C T
Collaborate ConcludeCoordinate
Pianificazione • Piano di transizione;
• Testing e fixing di fine
sviluppo;
• Pilot della soluzione;
• Finalizzare la
documentazione;
• Comunicare il deployment;
• Preparazione ambiente di
erogazione
• Training degli stakeholder.
• Review dello stato di ready in
produzione;
• Deploy della soluzione.
Idealmente: nessun effort
temporale
Tipicamente: 1 ora a
settimana per l’intera fase
Idealmente: nessun effort
temporale
Media: 4 settimane
Caso Peggiore: Più mesi
Idealmente: meno di un ora
Caso Peggiore: Più mesi
T
40
Agile@Scale: be SAFe!
DAD «on» SAFe
41
Collaborate ConcludeCoordinate
Pianificazione • Piano di transizione;
• Testing e fixing di fine
sviluppo;
• Pilot della soluzione;
• Finalizzare la
documentazione;
• Comunicare il deployment;
• Preparazione
ambiente di
erogazione;
• Training degli stakeholder.
• Review dello stato di ready in
produzione;
• Deploy della soluzione.
Idealmente: nessun effort
temporale
Tipicamente: 1 ora a
settimana per l’intera fase
Idealmente: nessun effort
temporale
Media: 4 settimane
Caso Peggiore: Più mesi
Idealmente: meno di un ora
Caso Peggiore: Più mesi
T
Agile@Scale: be SAFe!
DAD «on» SAFe
TransitionT
Collaborate ConcludeCoordinate
Pianificazione • Piano di transizione;
• Testing e
fixing di fine
sviluppo;
• Pilot della soluzione;
• Finalizzare la
documentazione;
• Comunicare il deployment;
• Preparazione ambiente di
erogazione
• Training degli stakeholder.
• Review dello stato di ready in
produzione;
• Deploy della soluzione.
Idealmente: nessun effort
temporale
Tipicamente: 1 ora a
settimana per l’intera fase
Idealmente: nessun effort
temporale
Media: 4 settimane
Caso Peggiore: Più mesi
Idealmente: meno di un ora
Caso Peggiore: Più mesi
42
T
Agile@Scale: be SAFe!
DAD «on» SAFe
Collaborate ConcludeCoordinate
Pianificazione • Piano di transizione;
• Testing e fixing di fine
sviluppo;
• Pilot della soluzione;
• Finalizzare la
documentazione
• Comunicare il deployment;
• Preparazione ambiente di
erogazione;
• Training degli stakeholder.
• Review dello stato di ready in
produzione;
• Deploy della soluzione.
Idealmente: nessun effort
temporale
Tipicamente: 1 ora a
settimana per l’intera fase
Idealmente: nessun effort
temporale
Media: 4 settimane
Caso Peggiore: Più mesi
Idealmente: meno di un ora
Caso Peggiore: Più mesi
T
43
Agile@Scale: be SAFe!
DAD «on» SAFe
Collaborate ConcludeCoordinate
Pianificazione • Piano di transizione;
• Testing e fixing di fine
sviluppo;
• Pilot della soluzione;
• Finalizzare la
documentazione
• Comunicare il deployment;
• Preparazione ambiente di
erogazione;
• Training degli stakeholder.
• Review dello
stato di ready
in
produzione;
• Deploy della soluzione.
Idealmente: nessun effort
temporale
Tipicamente: 1 ora a
settimana per l’intera fase
Idealmente: nessun effort
temporale
Media: 4 settimane
Caso Peggiore: Più mesi
Idealmente: meno di un ora
Caso Peggiore: Più mesi
T
44
Agile@Scale: be SAFe!
DAD «on» SAFe
Collaborate ConcludeCoordinate
Pianificazione • Piano di transizione;
• Testing e fixing di fine
sviluppo;
• Pilot della soluzione;
• Finalizzare la
documentazione
• Comunicare il deployment;
• Preparazione ambiente di
erogazione;
• Training degli stakeholder.
• Review dello stato di ready in
produzione;
• Deploy della
soluzione.
Idealmente: nessun effort
temporale
Tipicamente: 1 ora a
settimana per l’intera fase
Idealmente: nessun effort
temporale
Media: 4 settimane
Caso Peggiore: Più mesi
Idealmente: meno di un ora
Caso Peggiore: Più mesi
T
45
Agile@Scale: be SAFe!
SAFe Key Point
• Framework maturo e robusto, ben
documentato e utilizzato in diversi
contesti reali;
• Ruolo centrale delle persone in tutte le
fasi di delivery, con ruoli chiari, artefatti
precisi e eventi espliciti;
• Visione olistica dell’organizzazione
aziendale, con una identificazione di 3
livelli di partecipazione e valore;
• Focus sulla qualità del software (Agile
& DevOps);
• Costanti review ed aggiornamenti.
• Prescrittivo;
• Pesante/Complesso;
• Incentrato sui processi di
Certificazione;
Pro Pro
46
Agile@Scale: be SAFe!
DAD Key Point
• Framework ibrido che si fonda su
approcci Agile e Lean affermati;
• La gestione delle milestone permette
di adattarlo a contesti enterprise reali;
• Ampia flessibilità rispetto alle pratiche
Agili da adottare;
• Forte attenzione sugli aspetti
architetturali ed ingegneristici;
• Governance chiara per i
program/product manager.
• Adozione poco nota;
• Limitata azione di
formazione per la
certificazione;
• Mancanza di prescrizioni
per un’adozione sistematica
delle pratiche Agili.
Pro Pro
47
Agile@Scale: be SAFe!
@felicepescatore
ABOUT ME
get in touch
Disciplined Agile Delivery Italy
Group
Felice Pescatore, Agile Software Architect
Email: felice.pescatore@gmail.com
Cell. 392/7157684
www.felicepescatore.it
48
Agile@Scale: be SAFe!
THANKS FOR WATCHING
Quest'opera è distribuita con Licenza Creative Commons Attribuzione - Non commerciale 3.0 Italia.

Agile@scale: be SAFe!

  • 1.
    Agile@Scale: be SAFe! DAD& SAFe 07 Aprile 2014 @felicepescatore Disciplined Agile Delivery Italy Groupwww.felicepescatore.it Felice Pescatore
  • 2.
    Agile@Scale: be SAFe! Realityis complex… software is complex! COMPLEX Emergent Practices COMPLICATED Good Practices CHAOTIC Novel Practices SIMPLE Best Practices Cynefin Model 2
  • 3.
    Agile@Scale: be SAFe! Toocomplicated and too complex for traditional approach If a process is too unpredictable or too complicated for the planned, (predictive) approach, then the empirical approach (measure and adapt) is the method of choice. - Ken Schwaber 3
  • 4.
    Agile@Scale: be SAFe! Conil cappello “Agile” non si intende un insieme di processi e tool. Agile è un set di Valori e Pratiche su cui basare le proprie attività, e, perché no, I processi e i tool utilizzati. Agile… what? 4
  • 5.
  • 6.
    Agile@Scale: be SAFe! WhatAgile isn’t… 6
  • 7.
    Agile@Scale: be SAFe! DSDMAtern RUP / Open UP FDD Fuller Approaches (still agile) SCRUM Crystal eXtreme Programming Lightweight Approaches Disciplined Agile Delivery, DAD Scaled Agile Framework, SAFe@Scale Agile Agile Umbrella 7
  • 8.
    Agile@Scale: be SAFe! DomainComplexity Straight -forward Intricate, emerging Compliance requirement Low risk Critical, audited Team size Under 10 developers 1000’s of developers Co-located Geographical distribution Global Enterprise discipline Project focus Enterprise focus Technical complexity Homogenous Heterogeneous, legacy Organization distribution (outsourcing, partnerships) Collaborative Contractual Disciplined Agile Delivery Flexible Rigid Organizational complexity @Scale… what? 8
  • 9.
    Agile@Scale: be SAFe! Aproject is more than only development… @Scale… why? 9
  • 10.
    Agile@Scale: be SAFe! TheIdea, the Build, the Environment Aggredire il mercato con una nuova idea • Generata dall’esigenza, Pensata per creare un’esigenza • Chi finanzia il progetto? Quali sono i rischi? Di quante persone ho bisogno? Quanti Team? Dove avvengono le attività? Quali sono le tecnologie di supporto?, ... Program Level & Inception Program Level & Inception • Creare il Program Backlog (Feature), Creare i Team Backlog (User Story), Identificare i PSI (Potential Shippable Increment), …. Team Level & Construction • Prendere in carico il Team Backlog, Definire le iterazioni in relazione ai PSI, Definire i Task, Scegliere le pratiche da utilizzare, … Program Level & Transition • Completato lo sviluppo, il sistema deve essere manutenuto in erogazione e fruibile correttamente da client di tipologia diversa (anche molto!) 10
  • 11.
    Agile@Scale: be SAFe! Leaders(in ALM) have strong capabilities in agile practices, including driving portfolio management support and support for enterprise agile capabilities, such as SAFe and Disciplined Agile Delivery (DAD)* * Tratto da: Magic Quadrant for Application Development Life Cycle Management (19 November 2013) SAFe and DAD 11
  • 12.
    Agile@Scale: be SAFe! SAFe,Scaled Agile Framework • Framework maturo per l’adozione di pratiche Agili all’interno di contesti Enterprise • In grado di gestire, con successo, un ampio numero di «Agilisti» e di Team • Costruito sui principi delle metodologie Agile@Core e Lean • Sincronizzazione tra sviluppo e delivery Grazie alla «Big Picture» è possibile evidenziare le relazioni ed i ruoli dei vari attori aziendali che concorrono al processo Agile@Scale, unitamente agli artefatti e le cerimonie di riferimento 12
  • 13.
    Agile@Scale: be SAFe! SAFe«Big Picture» 13
  • 14.
    Agile@Scale: be SAFe! SAFe:Portfolio Level Ruoli / Team • Program Portfolio Manager • Enterprise Architect • Epic Owner Cerimonie • Strategic Investment Planning • Kanban Portfolio Planning: Epic Artefatti • Investment Themes • Business and Architecture Epics • Portfolio Backlog • Portfolio Vision • Metrics 14
  • 15.
    Agile@Scale: be SAFe! SAFe:Program Level Ruoli / Team • Product Management • Release Management • System Team • DevOps • Business Owners • System Architect • Release Train Engineer • UX Architect Cerimonie • PSI/Release Planning • System Demo • Inspect & Adapt Workshop Artefatti • Product Roadmap • Vision • Program Backlog • Team Backlog • NFRs • Architecture Runway • Business and Architecture Feautures • PSI Objectives • Metrics 15
  • 16.
    Agile@Scale: be SAFe! SAFe:Team Level Ruoli / Team • Agile Teams • Product Owner • Scrum/Agile Master Cerimonie • Sprint Planning • Backlog Grooming • Daily Stand-up • Sprint Demo • Sprint Retrospective • HIP Sprints Artefatti • Team Backlog (vincolato dai NFRs) • Team PSI Objective • Sprint Goals • Working Software • Spikes • Metrics 16
  • 17.
    Agile@Scale: be SAFe! DAD,Disciplined Agile Delivery • Framework per lo sviluppo di soluzioni End-to-End con ampia libertà di personalizzazione • Costruito sui principi delle metodologie Agile@Core e Lean • Scalabile, people-first oriented, learning oriented, goal-driven, enterprise aware, risk and value driven • Linee guida per la governance di team enterprise secondo le best-guide Agili Grazie alla «Big Picture» è possibile evidenziare le fasi di sviluppo di una soluzione end-to-end in ambito enterprise secondo i principi Agili. DAD è un framework ibrido, Value & Risk driven, fortemente orientano alle persone e al loro apprendimento, il tutto con la finalità di produrre in modo ottimale il delivery della soluzione. I C T Inception Construction Transition 17
  • 18.
    Agile@Scale: be SAFe! DAD,Agile Big Picture Inception Construction 1 Construction 2 Construction 3 Transition 1 Construction 4 Transition 2 Avere una visione PSI PSI PSI Deploy in Produzione New PSI (Next Release) Nuovo Deploy in Produzione PSI: Potential Shippable Increment 18
  • 19.
    Agile@Scale: be SAFe! DAD,Lean Big Picture Inception Lean Construction 1 Transition 1 Lean Construction 2 Transition 2 Avere una visione PSI when Done Deploy in Produzione New PSI (Next Release) Nuovo Deploy in Produzione PSI: Potential Shippable Increment 19
  • 20.
    Agile@Scale: be SAFe! THEAGILE 3C RHYTHM Concept Inception Coordinate Construction Collaborate Transition Conclude Release rhythm Iteration rhythm Development Collaborate Iteration Planning Coordinate Stabilize Conclude Daily rhythm Coordinatio n Meeting Coordinate Daily Work Collaborate Stabilize Conclude La terna (rhythm) Coordinate-Collaborate-Conclude ritorna a vari livelli in un progetto governato tramite DAD: 20
  • 21.
    Agile@Scale: be SAFe! DADPHASES: INCEPTION Stakeholderconsensus Project/ProductApprovedtostart Collaborate ConcludeCoordinate • Individuare i possibili Team Member; • Pianificare una sessione di “vision” del progetto; • Precettare gli stakeholder per la sessione di “vision” . • Rifinire la Vision; • Effettuare una prima valutazione dei requisiti; • Effettuare una prima ipotesi Architetturale; • Valutare la fattibilità del progetto; • Creare un primo Release Plan; • Strutturare il (i) Team; • Settare l’ambiente; • Garantirsi la sostenibilità economica • Identificare i rischi. • Review di quanto definite (mailstone); • Comunicare la Vision agli stakeholder; • Impegnarsi sulle Iterazioni ed i rilasci continui. Fino ad alcune ore (se tutti gli stakeholder sono disponibili) Idealmente: 1-2 settimane Media: 4 settimane Caso Peggiore: Più mesi Qualche ora 21
  • 22.
    Agile@Scale: be SAFe! DADPHASES: CONSTRUCTION PHASE Second Stakeholderconsensus SufficientFunctionality Collaborate ConcludeCoordinate Dimostrare che le assunzioni Architetturali sono corretti tramite pezzi funzionati della stessa • Produrre incrementalmente soluzioni utilizzabili; • Condividere lo stato del progetto con gli stakeholder; • Essere in linea con gli obiettivi organizzativi; • Allinearsi con gli altri Team; • Migliorare se stessi ed il Team nell’insieme. • Determinare quando quello che si è sviluppato è sufficiente per il raggiungimento degli obietti; • Stabilizzare la soluzione. Tipicamente: 1 iterazione Caso peggiore: Molte iterazioni Tipicamente: diverse iterazioni Idealmente: alcune ore 22
  • 23.
    Agile@Scale: be SAFe! DADPHASES: AGILE CONSTRUCTION PHASE Typical Construction Iteration for Agile DAD Approach • Iteration planning • Iteration modeling Pratiche standard: • Focalizzare le attività; • Meeting di Coordinamento giornaliero; • Test di regressione; • Evoluzione dell’Architettura ed eventuali Spike relativi (task di una o più story); • Continuous Integration; • Refactoring; • Ritmo sostenibile; • Priorizzare i work item; • Attività di configurazione; • “Track “done” delle attività (es. Burndown) • JIT model storming • Iteration demo; • Retrospettiva; • Valutare le funzionalità sufficienti al raggiungimento dell’obiettivo; • Aggiornamento del Release plan. 2 ore per ogni settimana dell’iterazione Tipicamente: due settimane nel caso di progetti standard, Quattro settimane nel caso di progetti complessi con integrazione tra Team cross-agile Caso peggiore: Sei Settimane 2 ore per ogni settimana dell’iterazione Pratiche avanzate: • Test-driven development (TDD); • Acceptance TDD; • Continuous deployment (CD); • Parallel independent testing; • Non-solo development; • Look-ahead modeling; • Look-ahead planning; • Continuous documentation. Iterationstart Potentiallyconsumablesolution Coordinate Collaborate Conclude 23
  • 24.
    Agile@Scale: be SAFe! DADPHASES: AGILE CONSTRUCTION PHASE Typical Construction Day Coordinate Collaborate Conclude StartofDay WorkingBuild • Meeting di coordinamento giornaliero; • Aggiornamento della Taskboard • Aggiornamento dell’Iteration Burndown. • Affrontare i problemi bloccanti; • Creare i test; • Sviluppare codice; • Integrare quanto sviluppato; • Risolvere i problemi ed i bug; • Modellazione; • Validazione del Codice. • Stabilizzare quanto realizzato. Fino a 15 minuti Tipicamente: 5 o 6 ore Idealmente: Non necessario 24
  • 25.
    Agile@Scale: be SAFe! DADPHASES: TRANSITION PHASE Third Sufficientfunctionality Productionready Collaborate ConcludeCoordinate Pianificazione • Piano di transizione; • Testing e fixing di fine sviluppo; • Pilot della soluzione; • Finalizzare la documentazione; • Comunicare il deployment; • Preparazione ambiente di erogazione; • Training degli stakeholder. • Review dello stato di ready in produzione; • Deploy della soluzione. Idealmente: nessun effort temporale Tipicamente: 1 ora a settimana per l’intera fase Idealmente: nessun effort temporale Media: 4 settimane Caso Peggiore: Più mesi Idealmente: meno di un ora Caso Peggiore: Più mesi 25
  • 26.
    Agile@Scale: be SAFe! GOALDRIVEN Not all iterations are created equal! Construction Goals Transition GoalsInception Goals • Costituire il Team • Identificare la Vision del progetto • Portare gli stakeholder a concordare sulla Vision • Essere allineati al contest aziendale • Identificare la strategia tecnica iniziale, i requisiti iniziali e definire il piano di release iniziale • Configurare l’ambiente (fisico e digitale) di lavoro • Assicurarsi la sostenibilità economica del progetto • Identificare i rischi • Produrre sempre una soluzione potenzialmente utilizzabile • Catturare le richieste di cambiamento proveniente dagli stakeholder • Avvicinarsi velocemente ad una release per il deploy • Mantenere e migliorare i livelli qualitative esistenti • Verificare il prima possibile l’architettura • Garantire che la soluzione è pronta per la produzione • Essere sicuri che gli stakeholder sono pronti per usare la soluzione • Effettuare il deploy della soluzione in produzione • Compiere la missione del progetto • Incrementare le competenze (skill) dei Team Member • Migliorare le infrastrutture esistenti Ongoing Goals • Migliorare i process e l’ambiente • Sfruttare le infrastrutture esistenti • Governare il rischio 26
  • 27.
    Agile@Scale: be SAFe! DADGovernance Strategy • Esistono modalità diverse di governance per i progetti @Scale, in particolare rispetto al contesto di applicazione • DAD supporta differenti strategie e modalità di governance • Le strategie fanno tesoro di quanto già in essere presso l’azienda • Applicare ogni decisione quanto più localmente possibile Corporate Investimenti ITOperationDelivery/Deployment Security Infrastrutture (Servizi, Cloud…) Dati Information Technology 27
  • 28.
    Agile@Scale: be SAFe! SAFeGovernance Deliverable and Alignments Shared Resources • Operat.l Acceptance Plan • Acceptance Criteria Plan • Reqs Specification Doc • Sys Security Plan • Production Ops Manual • Security Guide • 508 Certification • ATO • Privacy Impact Assess • User Guide • SLA Program Portfolio Man. • Quad Chart • IPT Charter • BRD • Project Charter • Acquisition Strategy Program and Release Management • PMP • Transition Plan • Risk Register/Log • Outcome Stmt • Version Description Doc • Deployment Plan • Lessons Learned • Legislation • Budget • Policy • Directives • Architectural Standard • Data Exchange Standards • Hosting Stregies • Security Standards System Architect • System Design Doc System Team • Test Evaluation • Master Test Plan Ruoli SAFe con responsabilità inerenti la documentazione dell’SDLD (Software Development Lifecycle Documentation) 28
  • 29.
    Agile@Scale: be SAFe! DAD«on» SAFe InceptionI ConstructionC TransitionT I C TI C T 29
  • 30.
    Agile@Scale: be SAFe! DAD«on» SAFe I 30
  • 31.
    Agile@Scale: be SAFe! DAD«on» SAFe Collaborate ConcludeCoordinate • Individuare i possibili Team Member; • Pianificare una sessione di “vision” del progetto; • Precettare gli stakeholder per la sessione di “vision” . • Rifinire la Vision; • Effettuare una prima valutazione dei requisiti; • Effettuare una prima ipotesi Architetturale; • Valutare la fattibilità del progetto; • Creare un primo Release Plan; • Strutturare il (i) Team; • Settare l’ambiente; • Garantirsi la sostenibilità economica • Identificare i rischi. • Review di quanto definite (mailstone); • Comunicare la Vision agli stakeholder; • Impegnarsi sulle Iterazioni ed in rilasci continui. Fino ad alcune ore (se tutti gli stakeholder sono disponibili) Idealmente: 1-2 settimane Media: 4 settimane Caso Peggiore: Più mesi Qualche ora I 31
  • 32.
    Agile@Scale: be SAFe! DAD«on» SAFe Collaborate ConcludeCoordinate • Individuare i possibili Team Member; • Pianificare una sessione di “vision” del progetto; • Precettare gli stakeholder per la sessione di “vision” . • Rifinire la Vision; • Effettuare una prima valutazione dei requisiti; • Effettuare una prima ipotesi Architetturale; • Valutare la fattibilità del progetto; • Creare un primo Release Plan; • Strutturare il (i) Team; • Settare l’ambiente; • Garantirsi la sostenibilità economica • Identificare i rischi. • Review di quanto definite (mailstone); • Comunicare la Vision agli stakeholder; • Impegnarsi sulle Iterazioni ed in rilasci continui. Fino ad alcune ore (se tutti gli stakeholder sono disponibili) Idealmente: 1-2 settimane Media: 4 settimane Caso Peggiore: Più mesi Qualche ora I 32
  • 33.
    Agile@Scale: be SAFe! DAD«on» SAFe Collaborate ConcludeCoordinate • Individuare i possibili Team Member; • Pianificare una sessione di “vision” del progetto; • Precettare gli stakeholder per la sessione di “vision” . • Rifinire la Vision; • Effettuare una prima valutazione dei requisiti; • Effettuare una prima ipotesi Architetturale; • Valutare la fattibilità del progetto; • Creare un primo Release Plan; • Strutturare il (i) Team; • Settare l’ambiente; • Garantirsi la sostenibilità economica • Identificare i rischi. • Review di quanto definite (mailstone); • Comunicare la Vision agli stakeholder; • Impegnarsi sulle Iterazioni ed in rilasci continui. Fino ad alcune ore (se tutti gli stakeholder sono disponibili) Idealmente: 1-2 settimane Media: 4 settimane Caso Peggiore: Più mesi Qualche ora I 33
  • 34.
    Agile@Scale: be SAFe! DAD«on» SAFe Collaborate ConcludeCoordinate • Individuare i possibili Team Member; • Pianificare una sessione di “vision” del progetto; • Precettare gli stakeholder per la sessione di “vision” . • Rifinire la Vision; • Effettuare una prima valutazione dei requisiti; • Effettuare una prima ipotesi Architetturale; • Valutare la fattibilità del progetto; • Creare un primo Release Plan; • Strutturare il (i) Team; • Settare l’ambiente; • Garantirsi la sostenibilità economica • Identificare i rischi. • Review di quanto definite (mailstone); • Comunicare la Vision agli stakeholder; • Impegnarsi sulle Iterazioni ed in rilasci continui. Fino ad alcune ore (se tutti gli stakeholder sono disponibili) Idealmente: 1-2 settimane Media: 4 settimane Caso Peggiore: Più mesi Qualche ora I 34
  • 35.
    Agile@Scale: be SAFe! DAD«on» SAFe • Iteration planning • Iteration modeling Pratiche standard: • Focalizzare le attività; • Meeting di Coordinamento giornaliero; • Test di regressione; • Evoluzione dell’Architettura ed eventuali Spike relativi (task di una o più story); • Continuous Integration; • Refactoring; • Ritmo sostenibile; • Priorizzare i work item; • Attività di configurazione; • “Track “done” delle attività (es. Burndown) • JIT model storming • Iteration demo; • Retrospettiva; • Valutare le funzionalità sufficienti al raggiungiment o dell’obiettivo; • Aggiornamento del Release plan. Pratiche avanzate: • Test-driven development (TDD); • Acceptance TDD; • Continuous deployment (CD); • Parallel independent testing; • Non-solo development; • Look-ahead modeling; • Look-ahead planning; • Continuous documentation. Coordinate Collaborate Conclude C 35
  • 36.
    Agile@Scale: be SAFe! DAD«on» SAFe InceptionI ConstructionC TransitionT I C TI C T • Iteration planning • Iteration modeling Pratiche standard: • Focalizzare le attività; • Meeting di Coordinamento giornaliero; • Test di regressione; • Evoluzione dell’Architettura ed eventuali Spike relativi (task di una o più story); • Continuous Integration; • Refactoring; • Ritmo sostenibile; • Priorizzare i work item; • Attività di configurazione; • “Track “done” delle attività (es. Burndown) • JIT model storming • Iteration demo; • Retrospettiva; • Valutare le funzionalità sufficienti al raggiungiment o dell’obiettivo; • Aggiornamento del Release plan. Pratiche avanzate: • Test-driven development (TDD); • Acceptance TDD; • Continuous deployment (CD); • Parallel independent testing; • Non-solo development; • Look-ahead modeling; • Look-ahead planning; • Continuous documentation. Coordinate Collaborate Conclude C 36
  • 37.
    Agile@Scale: be SAFe! DAD«on» SAFe • Iteration planning • Iteration modeling Pratiche standard: • Focalizzare le attività; • Meeting di Coordinamento giornaliero; • Test di regressione; • Evoluzione dell’Architettura ed eventuali Spike relativi (task di una o più story); • Continuous Integration; • Refactoring; • Ritmo sostenibile; • Priorizzare i work item; • Attività di configurazione; • “Track “done” delle attività (es. Burndown) • JIT model storming • Iteration demo; • Retrospettiva; • Valutare le funzionalità sufficienti al raggiungiment o dell’obiettivo; • Aggiornamento del Release plan. Pratiche avanzate: • Test-driven development (TDD); • Acceptance TDD; • Continuous deployment (CD); • Parallel independent testing; • Non-solo development; • Look-ahead modeling; • Look-ahead planning; • Continuous documentation. Coordinate Collaborate Conclude C 37
  • 38.
    Agile@Scale: be SAFe! DAD«on» SAFe 38 • Iteration planning • Iteration modeling Pratiche standard: • Focalizzare le attività; • Meeting di Coordinamento giornaliero; • Test di regressione; • Evoluzione dell’Architettura ed eventuali Spike relativi (task di una o più story); • Continuous Integration; • Refactoring; • Ritmo sostenibile; • Priorizzare i work item; • Attività di configurazione; • “Track “done” delle attività (es. Burndown) • JIT model storming • Iteration demo; • Retrospettiva; • Valutare le funzionalità sufficienti al raggiungiment o dell’obiettivo; • Aggiornamento del Release plan. Pratiche avanzate: • Test-driven development (TDD); • Acceptance TDD; • Continuous deployment (CD); • Parallel independent testing; • Non-solo development; • Look-ahead modeling; • Look-ahead planning; • Continuous documentation. Coordinate Collaborate Conclude C
  • 39.
    Agile@Scale: be SAFe! DAD«on» SAFe • Iteration planning • Iteration modeling Pratiche standard: • Focalizzare le attività; • Meeting di Coordinamento giornaliero; • Test di regressione; • Evoluzione dell’Architettura ed eventuali Spike relativi (task di una o più story); • Continuous Integration; • Refactoring; • Ritmo sostenibile; • Priorizzare i work item; • Attività di configurazione; • “Track “done” delle attività (es. Burndown) • JIT model storming • Iteration demo; • Retrospettiva; • Valutare le funzionalità sufficienti al raggiungiment o dell’obiettivo; • Aggiornamento del Release plan. Pratiche avanzate: • Test-driven development (TDD); • Acceptance TDD; • Continuous deployment (CD); • Parallel independent testing; • Non-solo development; • Look-ahead modeling; • Look-ahead planning; • Continuous documentation. Coordinate Collaborate Conclude C 39
  • 40.
    Agile@Scale: be SAFe! DAD«on» SAFe I C TI C T Collaborate ConcludeCoordinate Pianificazione • Piano di transizione; • Testing e fixing di fine sviluppo; • Pilot della soluzione; • Finalizzare la documentazione; • Comunicare il deployment; • Preparazione ambiente di erogazione • Training degli stakeholder. • Review dello stato di ready in produzione; • Deploy della soluzione. Idealmente: nessun effort temporale Tipicamente: 1 ora a settimana per l’intera fase Idealmente: nessun effort temporale Media: 4 settimane Caso Peggiore: Più mesi Idealmente: meno di un ora Caso Peggiore: Più mesi T 40
  • 41.
    Agile@Scale: be SAFe! DAD«on» SAFe 41 Collaborate ConcludeCoordinate Pianificazione • Piano di transizione; • Testing e fixing di fine sviluppo; • Pilot della soluzione; • Finalizzare la documentazione; • Comunicare il deployment; • Preparazione ambiente di erogazione; • Training degli stakeholder. • Review dello stato di ready in produzione; • Deploy della soluzione. Idealmente: nessun effort temporale Tipicamente: 1 ora a settimana per l’intera fase Idealmente: nessun effort temporale Media: 4 settimane Caso Peggiore: Più mesi Idealmente: meno di un ora Caso Peggiore: Più mesi T
  • 42.
    Agile@Scale: be SAFe! DAD«on» SAFe TransitionT Collaborate ConcludeCoordinate Pianificazione • Piano di transizione; • Testing e fixing di fine sviluppo; • Pilot della soluzione; • Finalizzare la documentazione; • Comunicare il deployment; • Preparazione ambiente di erogazione • Training degli stakeholder. • Review dello stato di ready in produzione; • Deploy della soluzione. Idealmente: nessun effort temporale Tipicamente: 1 ora a settimana per l’intera fase Idealmente: nessun effort temporale Media: 4 settimane Caso Peggiore: Più mesi Idealmente: meno di un ora Caso Peggiore: Più mesi 42 T
  • 43.
    Agile@Scale: be SAFe! DAD«on» SAFe Collaborate ConcludeCoordinate Pianificazione • Piano di transizione; • Testing e fixing di fine sviluppo; • Pilot della soluzione; • Finalizzare la documentazione • Comunicare il deployment; • Preparazione ambiente di erogazione; • Training degli stakeholder. • Review dello stato di ready in produzione; • Deploy della soluzione. Idealmente: nessun effort temporale Tipicamente: 1 ora a settimana per l’intera fase Idealmente: nessun effort temporale Media: 4 settimane Caso Peggiore: Più mesi Idealmente: meno di un ora Caso Peggiore: Più mesi T 43
  • 44.
    Agile@Scale: be SAFe! DAD«on» SAFe Collaborate ConcludeCoordinate Pianificazione • Piano di transizione; • Testing e fixing di fine sviluppo; • Pilot della soluzione; • Finalizzare la documentazione • Comunicare il deployment; • Preparazione ambiente di erogazione; • Training degli stakeholder. • Review dello stato di ready in produzione; • Deploy della soluzione. Idealmente: nessun effort temporale Tipicamente: 1 ora a settimana per l’intera fase Idealmente: nessun effort temporale Media: 4 settimane Caso Peggiore: Più mesi Idealmente: meno di un ora Caso Peggiore: Più mesi T 44
  • 45.
    Agile@Scale: be SAFe! DAD«on» SAFe Collaborate ConcludeCoordinate Pianificazione • Piano di transizione; • Testing e fixing di fine sviluppo; • Pilot della soluzione; • Finalizzare la documentazione • Comunicare il deployment; • Preparazione ambiente di erogazione; • Training degli stakeholder. • Review dello stato di ready in produzione; • Deploy della soluzione. Idealmente: nessun effort temporale Tipicamente: 1 ora a settimana per l’intera fase Idealmente: nessun effort temporale Media: 4 settimane Caso Peggiore: Più mesi Idealmente: meno di un ora Caso Peggiore: Più mesi T 45
  • 46.
    Agile@Scale: be SAFe! SAFeKey Point • Framework maturo e robusto, ben documentato e utilizzato in diversi contesti reali; • Ruolo centrale delle persone in tutte le fasi di delivery, con ruoli chiari, artefatti precisi e eventi espliciti; • Visione olistica dell’organizzazione aziendale, con una identificazione di 3 livelli di partecipazione e valore; • Focus sulla qualità del software (Agile & DevOps); • Costanti review ed aggiornamenti. • Prescrittivo; • Pesante/Complesso; • Incentrato sui processi di Certificazione; Pro Pro 46
  • 47.
    Agile@Scale: be SAFe! DADKey Point • Framework ibrido che si fonda su approcci Agile e Lean affermati; • La gestione delle milestone permette di adattarlo a contesti enterprise reali; • Ampia flessibilità rispetto alle pratiche Agili da adottare; • Forte attenzione sugli aspetti architetturali ed ingegneristici; • Governance chiara per i program/product manager. • Adozione poco nota; • Limitata azione di formazione per la certificazione; • Mancanza di prescrizioni per un’adozione sistematica delle pratiche Agili. Pro Pro 47
  • 48.
    Agile@Scale: be SAFe! @felicepescatore ABOUTME get in touch Disciplined Agile Delivery Italy Group Felice Pescatore, Agile Software Architect Email: felice.pescatore@gmail.com Cell. 392/7157684 www.felicepescatore.it 48
  • 49.
    Agile@Scale: be SAFe! THANKSFOR WATCHING Quest'opera è distribuita con Licenza Creative Commons Attribuzione - Non commerciale 3.0 Italia.
