Agile and Lean
                   for
              Construction
 September 2011             Engineering Innovation.

Friday, 23 September 2011
Construction Project Overruns                                Engineering Innovation.

        Sydney Opera        Channel Tunnel             Boston Arterial
        House               Final cost 80%             Tunnel
        Final cost 15       more than was              Final cost 196%
        times more than     originally planned         more than was
        was originally                                 originally planned
        planned

                               Copyright Ennova 2011

Friday, 23 September 2011
Project Overruns                                                                                             Engineering Innovation.

      Construction Industry                                                         Software Industry
               Source: 2002 Journal of the American Planning Association                      Source: 2009 Chaos Report - Standish Group

 • 90% projects exceed costs                                                    • 68% projects exceed cost or
                                                                                    time or did not satisfy scope
 • Overruns of between
      50% to 100%                                                               • Average overruns of 43%

                                                                  Copyright Ennova 2011

Friday, 23 September 2011
Cause of Construction Overruns                                                                                 Engineering Innovation.

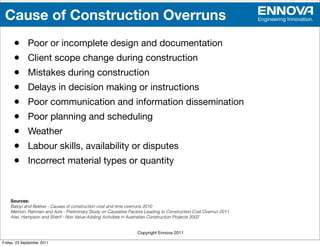

      •      Poor or incomplete design and documentation
      •      Client scope change during construction
      •      Mistakes during construction
      •      Delays in decision making or instructions
      •      Poor communication and information dissemination
      •      Poor planning and scheduling
      •      Weather
      •      Labour skills, availability or disputes
      •      Incorrect material types or quantity

    Sources:
    Baloyi and Bekker - Causes of construction cost and time overruns 2010
    Memon, Rahman and Azis - Preliminary Study on Causative Factors Leading to Construction Cost Overrun 2011
    Alwi, Hampson and Sherif - Non Value-Adding Activities in Australian Construction Projects 2002

                                                                 Copyright Ennova 2011

Friday, 23 September 2011

Construction Productivity                          Engineering Innovation.

                            Copyright Ennova 2011

Friday, 23 September 2011
Construction Productivity                                                                      Engineering Innovation.

                  Manufacturing                      Construction

                                                                      57%
                                  26%
               62%                             10%

                                12%                        33%

                    Non-Value Added     Support Activity             Value Added

                                                                         Source: Construction Industry Institute
                                             Copyright Ennova 2011

Friday, 23 September 2011
Lean and
                      Construction

                                 Engineering Innovation.

Friday, 23 September 2011

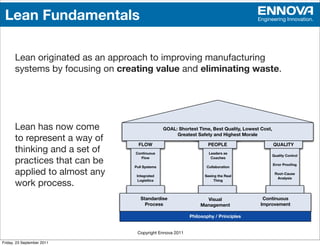

Lean Fundamentals                                                                     Engineering Innovation.

      Lean originated as an approach to improving manufacturing
      systems by focusing on creating value and eliminating waste.

      Lean has now come                        GOAL: Shortest Time, Best Quality, Lowest Cost,
                                                    Greatest Safety and Highest Morale
      to represent a way of
                                  FLOW                            PEOPLE                         QUALITY
      thinking and a set of      Continuous                        Leaders as
                                                                                                 Quality Control
      practices that can be        Flow

                                Pull Systems
                                                                    Coaches

                                                                  Collaboration
                                                                                                 Error Proofing

      applied to almost any      Integrated                      Seeing the Real
                                                                                                  Root-Cause
                                                                                                   Analysis
      work process.               Logisitics                          Thing

                                   Standardise                   Visual                   Continuous
                                     Process                   Management                Improvement

                                                          Philosophy / Principles

                                 Copyright Ennova 2011

Friday, 23 September 2011
Lean Construction
                                    fully occupied and profitable.! This is an example of the waste of
                                    common in mass production.                     Engineering Innovation.
                                        These features highlight the importance of the influence of Ford’s
                                    conscious design of the production system set in place for the Empire
 Lean Construction is an     adaption of Lean
                                    They lead us to identify it as a mass construction system4.
 principles and practices to the design and                           Empire State Building
 execution of construction projects.

 Lean Construction supplements traditional
 construction management approaches by
 focusing on:

         1. Creating material and
            information flows
         2. Maximising value generation
         3. Using plan, execute and
            control paradigms

                                                 Fig. 2: Construction of the Empire Source: Willis and Friedman 1998
                                                                                    State Building (Willis and Friedman

                                       THE DEVELOPMENT OF CONSTRUCTION SYSTEMS
                                       Copyright Ennova 2011

Friday, 23 September 2011              Introducing the term mass construction to define practices to create
Lean Construction                                             Engineering Innovation.

    Shared Principles
    • Optimisation of entire system through collaboration and systematic
      learning
    • Continual improvement and pursuit of perfection involving everyone
      in the system
    • Focus on delivering the value desired by the owner/client/end-user
    • Creating flow though systematically eliminating obstacles to value
      creation and elimination of processes that create no value (waste)
    • Creating pull production

    Key Differences
    • Construction projects are unique (one-of-a-kind) prototypes
    • Multiple suppliers act under different commercial arrangements
    • Construction environments are typically outdoors and/or difficult to
      control
                                  Copyright Ennova 2011

Friday, 23 September 2011

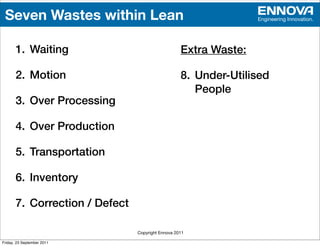

Seven Wastes within Lean                                         Engineering Innovation.

       1. Waiting                                  Extra Waste:

       2. Motion                                   8. Under-Utilised
                                                      People
       3. Over Processing

       4. Over Production

       5. Transportation

       6. Inventory

       7. Correction / Defect

                                Copyright Ennova 2011

Friday, 23 September 2011
Lean Wastes in Construction                                                                              Engineering Innovation.

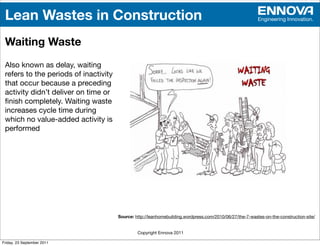

 Waiting Waste
 Also known as delay, waiting
 refers to the periods of inactivity
 that occur because a preceding
 activity didn’t deliver on time or
 finish completely. Waiting waste
 increases cycle time during
 which no value-added activity is
 performed

                                       Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/

                                                Copyright Ennova 2011

Friday, 23 September 2011
Lean Wastes in Construction                                                                           Engineering Innovation.

 Motion Waste
 This term refers to the extra
 steps taken by people to
 accommodate inefficient process
 layout, defects, reprocessing,
 overproduction or excess
 inventory. Motion takes time and
 adds no value to the product or
 service. To move and add value
 is called work. To move and not
 add value is called motion.

                                    Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/

                                             Copyright Ennova 2011

Friday, 23 September 2011
Lean Wastes in Construction                                                                        Engineering Innovation.

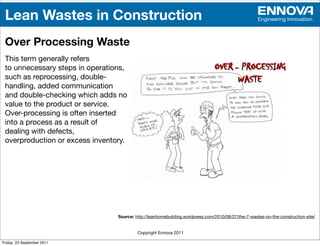

 Over Processing Waste
 This term generally refers
 to unnecessary steps in operations,
 such as reprocessing, double-
 handling, added communication
 and double-checking which adds no
 value to the product or service.
 Over-processing is often inserted
 into a process as a result of
 dealing with defects,
 overproduction or excess inventory.

                                 Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/

                                          Copyright Ennova 2011

Friday, 23 September 2011
Lean Wastes in Construction                                                                          Engineering Innovation.

 Over Production Waste
 Overproduction occurs when
 operations continue after they
 should have stopped.  It’s
 producing more than is needed,
 faster than needed or before it is
 needed. This results in product
 being produced in excess of what’s
 required, products being made too
 early, and excess inventory carrying
 costs.

                                   Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/

                                            Copyright Ennova 2011

Friday, 23 September 2011
Lean Wastes in Construction                                                                           Engineering Innovation.

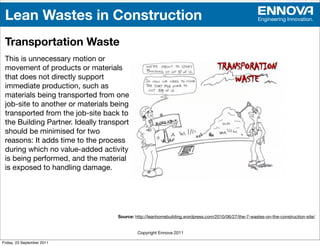

 Transportation Waste
 This is unnecessary motion or
 movement of products or materials
 that does not directly support
 immediate production, such as
 materials being transported from one
 job-site to another or materials being
 transported from the job-site back to
 the Building Partner. Ideally transport
 should be minimised for two
 reasons: It adds time to the process
 during which no value-added activity
 is being performed, and the material
 is exposed to handling damage.

                                    Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/

                                             Copyright Ennova 2011

Friday, 23 September 2011
Lean Wastes in Construction                                                                         Engineering Innovation.

 Inventory Waste
 This refers to any supply (materials
 or goods) in excess of what is
 required to build the current homes
 under construction. Inventory
 includes raw materials, work-in-
 process and finished goods. Though
 not all inventory is unnecessary
 waste, excess inventory can quickly
 build-up and tie-up dollars and
 resources. All Inventory requires
 additional handling and space.

                                  Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/

                                           Copyright Ennova 2011

Friday, 23 September 2011
Lean Wastes in Construction                                                                         Engineering Innovation.

 Correction Waste
 These are products, materials or
 services that do not meet
 expectation or conform to
 specification. Corrections and
 defects are anything not done
 correctly the first time and must
 be repaired, sorted, re-made or re-
 done, as well as materials which are
 scrapped due to defects.

                                  Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/

                                           Copyright Ennova 2011

Friday, 23 September 2011
Challenges for Lean in Construction                                          Engineering Innovation.

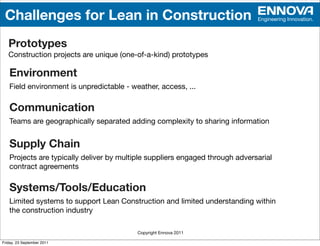

   Prototypes
   Construction projects are unique (one-of-a-kind) prototypes

   Environment
   Field environment is unpredictable - weather, access, ...

   Communication
   Teams are geographically separated adding complexity to sharing information

   Supply Chain
   Projects are typically deliver by multiple suppliers engaged through adversarial
   contract agreements

   Systems/Tools/Education
   Limited systems to support Lean Construction and limited understanding within
   the construction industry

                                          Copyright Ennova 2011

Friday, 23 September 2011
Fundamental Difference                                                  Engineering Innovation.

                                                           Unique and Project Based

                            Repeated and
                            Process Based

                                            Copyright Ennova 2011

Friday, 23 September 2011
Agile and
                      Construction

                                 Engineering Innovation.

Friday, 23 September 2011

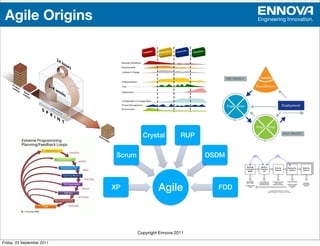

Agile Origins                                                            Engineering Innovation.

                                        Crystal!         RUP!

                             Scrum!                             DSDM!

                            XP!                Agile!              FDD!

                                      Copyright Ennova 2011

Friday, 23 September 2011
Agile                                                                              Engineering Innovation.

    Agile is an umbrella term for a set of values, principles
    and practices.

                                                                         Management!
                                                                          Practices!

                                                            Technical!                     Social/Team!
                            Increase Value                  Practices!                      Practices!

                                                                          Values &!
                                                                          Principles!
                            Reduce Risk

                                                                 Manage Complexity
                                      Empirical control, Continuous monitoring, Heuristics

                                        Copyright Ennova 2011

Friday, 23 September 2011
Agile Fundamentals                                                                  Engineering Innovation.

                                                                              AGILE TECHNICAL
               AGILE TEAM                                                           PRACTICES
               PRACTICES                                                          Test-Driven Development
                                                                                     Continuous Integration
               Colocation                                                           Automated Deployment
               Daily Stand Ups                                          Incremental Design and Architecture
               Iteration Planning                                      Acceptance Test-Driven Development
               Customer Showcase                                                                Refactoring
               Retrospective                                                               Technical Spikes
               Adaptive Release Plan                                                     Exploratory Testing
               Cross-Functional Team                                            Collective Code Ownership
               Requirements as Stories                                                    Definition of Done
               Planning/Story Wall                                                    Ubiquitous Language
               Informative Workspace           PRACTICES
               Burn Up/Down Charts
               Parking Lot Diagrams
               Success Sliders
               Planning Poker                                            AGILE PRINCIPLES
                                                                                              Simplicity
                                               PRINCIPLES                                 Transparency
                                                                                      Frequent Delivery
                                                                                 Customer Involvement
                                                                                   Technical Excellence
                                                                                            Team Work
                      AGILE VALUES                VALUES
                                                                                      Self Organisation
                                                                                      Emergent Design
                      Working Deliverables                                     Continuous Improvement
                      Human Interactions                                              Sustainable Pace
                      Customer Collaboration
                      Responding to Change

                                               Copyright Ennova 2011

Friday, 23 September 2011
Construction Complexity                                                         Engineering Innovation.

                                        Issue Plan

                                       Update Plan

                  Ideal Plan                                       Construction Site

    • Construction projects are not inherently complex - but because of the challenges
      encountered during execution they can become complex.

    • Because it is difficult to maintain an up-to-date plan - the plan rarely reflects the actual
      sequence in which tasks are completed

    • Majority of construction tasks are completed based on tacit knowledge and improvisation
      at the operational level

                                           Copyright Ennova 2011

Friday, 23 September 2011
Agile and Complexity                                                            Engineering Innovation.

    The principles and practices in Agile help reduce the risks associated
    with complexity.

            Setting and agreeing clear goals and boundaries

            Break problem into small pieces and completing in the order of greatest priority

            Defer design decisions to the last responsible moment

            Retrospection and continuous improvement

            Clear definition of done

            Measure progress and adapt plans

            Encourage group wisdom through team work and cross-functional collaboration

                                             Copyright Ennova 2011

Friday, 23 September 2011

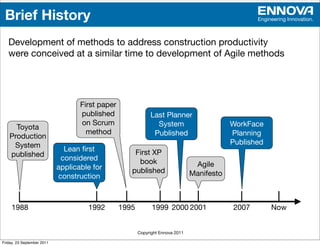

Brief History                                                                                     Engineering Innovation.

   Development of methods to address construction productivity
   were conceived at a similar time to development of Agile methods

                                   First paper
                                   published                 Last Planner
                                   on Scrum                    System                       WorkFace
     Toyota
                                     method                   Published                     Planning
   Production
    System                                                                                  Published
                              Lean first              First XP
   published                 considered               book
                            applicable for                                       Agile
                                                    published                   Manifesto
                            construction

     1988                            1992        1995         1999 2000 2001                2007        Now

                                                        Copyright Ennova 2011

Friday, 23 September 2011
Last Planner
         and
   WorkFace Planning

                            Engineering Innovation.

Friday, 23 September 2011

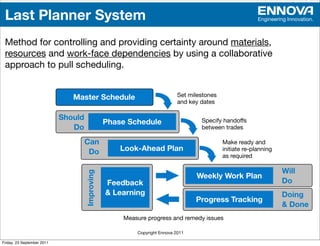

Last Planner System                                                                                      Engineering Innovation.

 Method for controlling and providing certainty around materials,
 resources and work-face dependencies by using a collaborative
 approach to pull scheduling.
                            Last Planner System
                               Master Schedule                             Set milestones
                                                                           and key dates

                            Should                                                 Specify handoffs
                                                 Phase Schedule
                               Do                                                  between trades

                                     Can                                                    Make ready and
                                      Do             Look-Ahead Plan                        initiate re-planning
                                                                                            as required

                                                                                                                   Will
                                     Improving

                                                                                 Weekly Work Plan
                                                 Feedback                                                          Do
                                                 & Learning                                                        Doing
                                                                                 Progress Tracking
                                                                                                                   & Done
                                                     Measure progress and remedy issues

                                                         Copyright Ennova 2011

Friday, 23 September 2011

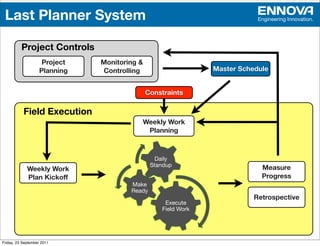

Last Planner System                                                          Engineering Innovation.

          Project Controls
                     Project   Monitoring &
                    Planning   Controlling                        Master Schedule

                                              Constraints

           Field Execution
                                           Weekly Work
                                            Planning

                                                  Daily
                                                Standup!                       Measure
             Weekly Work
             Plan Kickoff                                                      Progress
                                       Make
                                       Ready!
                                                                             Retrospective
                                                     Execute
                                                    Field Work!

                                         Copyright Ennova 2011

Friday, 23 September 2011

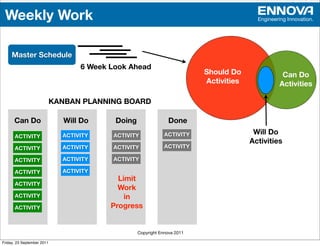

Weekly Work                                                                              Engineering Innovation.

     Master Schedule
                                   6 Week Look Ahead
                                                                           Should Do               Can Do
                                                                           Activities             Activities

                            KANBAN PLANNING BOARD

      Can Do                   Will Do     Doing                 Done
                              ACTIVITY    ACTIVITY             ACTIVITY                  Will Do
      ACTIVITY
                                                                                        Activities
      ACTIVITY                ACTIVITY    ACTIVITY             ACTIVITY

      ACTIVITY                ACTIVITY    ACTIVITY

      ACTIVITY                ACTIVITY
                                            Limit
      ACTIVITY
                                            Work
      ACTIVITY                                in
      ACTIVITY                            Progress

                                                   Copyright Ennova 2011

Friday, 23 September 2011

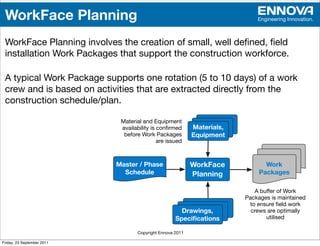

WorkFace Planning                                                           Engineering Innovation.

 WorkFace Planning involves the creation of small, well defined, field
 installation Work Packages that support the construction workforce.

 A typical Work Package supports one rotation (5 to 10 days) of a work
 crew and is based on activities that are extracted directly from the
 construction schedule/plan.

                             Material and Equipment
                             availability is confirmed       Materials,
                              before Work Packages          Equipment
                                             are issued

                            Master / Phase                  WorkFace            Work
                              Schedule                      Planning          Packages

                                                                             A buffer of Work
                                                                         Packages is maintained
                                                                          to ensure field work
                                                       Drawings,           crews are optimally
                                                     Specifications               utilised

                                    Copyright Ennova 2011

Friday, 23 September 2011

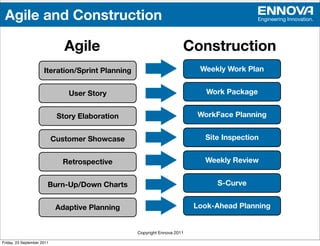

Agile and Construction                                                                   Engineering Innovation.

                               Agile                                  Construction
                      Iteration/Sprint Planning                            Weekly Work Plan

                                User Story                                   Work Package

                             Story Elaboration                            WorkFace Planning

                            Customer Showcase                               Site Inspection

                              Retrospective                                 Weekly Review

                        Burn-Up/Down Charts                                    S-Curve

                             Adaptive Planning                            Look-Ahead Planning

                                                  Copyright Ennova 2011

Friday, 23 September 2011
Thank You
            Agile and Lean
            for Construction
                                  Adrian Smith
                               Hugh Hofmeister

                                      Engineering Innovation.

Friday, 23 September 2011

Agile and Lean for Construction

  • 1.
    Agile and Lean for Construction September 2011 Engineering Innovation. Friday, 23 September 2011
  • 2.
    Construction Project Overruns Engineering Innovation. Sydney Opera Channel Tunnel Boston Arterial House Final cost 80% Tunnel Final cost 15 more than was Final cost 196% times more than originally planned more than was was originally originally planned planned Copyright Ennova 2011 Friday, 23 September 2011
  • 3.
    Project Overruns Engineering Innovation. Construction Industry Software Industry Source: 2002 Journal of the American Planning Association Source: 2009 Chaos Report - Standish Group • 90% projects exceed costs • 68% projects exceed cost or time or did not satisfy scope • Overruns of between 50% to 100% • Average overruns of 43% Copyright Ennova 2011 Friday, 23 September 2011
  • 4.
    Cause of ConstructionOverruns Engineering Innovation. • Poor or incomplete design and documentation • Client scope change during construction • Mistakes during construction • Delays in decision making or instructions • Poor communication and information dissemination • Poor planning and scheduling • Weather • Labour skills, availability or disputes • Incorrect material types or quantity Sources: Baloyi and Bekker - Causes of construction cost and time overruns 2010 Memon, Rahman and Azis - Preliminary Study on Causative Factors Leading to Construction Cost Overrun 2011 Alwi, Hampson and Sherif - Non Value-Adding Activities in Australian Construction Projects 2002 Copyright Ennova 2011 Friday, 23 September 2011
  • 5.
    Construction Productivity Engineering Innovation. Copyright Ennova 2011 Friday, 23 September 2011
  • 6.
    Construction Productivity Engineering Innovation. Manufacturing Construction 57% 26% 62% 10% 12% 33% Non-Value Added Support Activity Value Added Source: Construction Industry Institute Copyright Ennova 2011 Friday, 23 September 2011
  • 7.
    Lean and Construction Engineering Innovation. Friday, 23 September 2011
  • 8.
    Lean Fundamentals Engineering Innovation. Lean originated as an approach to improving manufacturing systems by focusing on creating value and eliminating waste. Lean has now come GOAL: Shortest Time, Best Quality, Lowest Cost, Greatest Safety and Highest Morale to represent a way of FLOW PEOPLE QUALITY thinking and a set of Continuous Leaders as Quality Control practices that can be Flow Pull Systems Coaches Collaboration Error Proofing applied to almost any Integrated Seeing the Real Root-Cause Analysis work process. Logisitics Thing Standardise Visual Continuous Process Management Improvement Philosophy / Principles Copyright Ennova 2011 Friday, 23 September 2011
  • 9.
    Lean Construction fully occupied and profitable.! This is an example of the waste of common in mass production. Engineering Innovation. These features highlight the importance of the influence of Ford’s conscious design of the production system set in place for the Empire Lean Construction is an adaption of Lean They lead us to identify it as a mass construction system4. principles and practices to the design and Empire State Building execution of construction projects. Lean Construction supplements traditional construction management approaches by focusing on: 1. Creating material and information flows 2. Maximising value generation 3. Using plan, execute and control paradigms Fig. 2: Construction of the Empire Source: Willis and Friedman 1998 State Building (Willis and Friedman THE DEVELOPMENT OF CONSTRUCTION SYSTEMS Copyright Ennova 2011 Friday, 23 September 2011 Introducing the term mass construction to define practices to create
  • 10.
    Lean Construction Engineering Innovation. Shared Principles • Optimisation of entire system through collaboration and systematic learning • Continual improvement and pursuit of perfection involving everyone in the system • Focus on delivering the value desired by the owner/client/end-user • Creating flow though systematically eliminating obstacles to value creation and elimination of processes that create no value (waste) • Creating pull production Key Differences • Construction projects are unique (one-of-a-kind) prototypes • Multiple suppliers act under different commercial arrangements • Construction environments are typically outdoors and/or difficult to control Copyright Ennova 2011 Friday, 23 September 2011
  • 11.
    Seven Wastes withinLean Engineering Innovation. 1. Waiting Extra Waste: 2. Motion 8. Under-Utilised People 3. Over Processing 4. Over Production 5. Transportation 6. Inventory 7. Correction / Defect Copyright Ennova 2011 Friday, 23 September 2011
  • 12.
    Lean Wastes inConstruction Engineering Innovation. Waiting Waste Also known as delay, waiting refers to the periods of inactivity that occur because a preceding activity didn’t deliver on time or finish completely. Waiting waste increases cycle time during which no value-added activity is performed Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/ Copyright Ennova 2011 Friday, 23 September 2011
  • 13.
    Lean Wastes inConstruction Engineering Innovation. Motion Waste This term refers to the extra steps taken by people to accommodate inefficient process layout, defects, reprocessing, overproduction or excess inventory. Motion takes time and adds no value to the product or service. To move and add value is called work. To move and not add value is called motion. Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/ Copyright Ennova 2011 Friday, 23 September 2011
  • 14.
    Lean Wastes inConstruction Engineering Innovation. Over Processing Waste This term generally refers to unnecessary steps in operations, such as reprocessing, double- handling, added communication and double-checking which adds no value to the product or service. Over-processing is often inserted into a process as a result of dealing with defects, overproduction or excess inventory. Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/ Copyright Ennova 2011 Friday, 23 September 2011
  • 15.
    Lean Wastes inConstruction Engineering Innovation. Over Production Waste Overproduction occurs when operations continue after they should have stopped.  It’s producing more than is needed, faster than needed or before it is needed. This results in product being produced in excess of what’s required, products being made too early, and excess inventory carrying costs. Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/ Copyright Ennova 2011 Friday, 23 September 2011
  • 16.
    Lean Wastes inConstruction Engineering Innovation. Transportation Waste This is unnecessary motion or movement of products or materials that does not directly support immediate production, such as materials being transported from one job-site to another or materials being transported from the job-site back to the Building Partner. Ideally transport should be minimised for two reasons: It adds time to the process during which no value-added activity is being performed, and the material is exposed to handling damage. Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/ Copyright Ennova 2011 Friday, 23 September 2011
  • 17.
    Lean Wastes inConstruction Engineering Innovation. Inventory Waste This refers to any supply (materials or goods) in excess of what is required to build the current homes under construction. Inventory includes raw materials, work-in- process and finished goods. Though not all inventory is unnecessary waste, excess inventory can quickly build-up and tie-up dollars and resources. All Inventory requires additional handling and space. Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/ Copyright Ennova 2011 Friday, 23 September 2011
  • 18.
    Lean Wastes inConstruction Engineering Innovation. Correction Waste These are products, materials or services that do not meet expectation or conform to specification. Corrections and defects are anything not done correctly the first time and must be repaired, sorted, re-made or re- done, as well as materials which are scrapped due to defects. Source: http://leanhomebuilding.wordpress.com/2010/06/27/the-7-wastes-on-the-construction-site/ Copyright Ennova 2011 Friday, 23 September 2011
  • 19.
    Challenges for Leanin Construction Engineering Innovation. Prototypes Construction projects are unique (one-of-a-kind) prototypes Environment Field environment is unpredictable - weather, access, ... Communication Teams are geographically separated adding complexity to sharing information Supply Chain Projects are typically deliver by multiple suppliers engaged through adversarial contract agreements Systems/Tools/Education Limited systems to support Lean Construction and limited understanding within the construction industry Copyright Ennova 2011 Friday, 23 September 2011
  • 20.
    Fundamental Difference Engineering Innovation. Unique and Project Based Repeated and Process Based Copyright Ennova 2011 Friday, 23 September 2011
  • 21.
    Agile and Construction Engineering Innovation. Friday, 23 September 2011
  • 22.
    Agile Origins Engineering Innovation. Crystal! RUP! Scrum! DSDM! XP! Agile! FDD! Copyright Ennova 2011 Friday, 23 September 2011
  • 23.
    Agile Engineering Innovation. Agile is an umbrella term for a set of values, principles and practices. Management! Practices! Technical! Social/Team! Increase Value Practices! Practices! Values &! Principles! Reduce Risk Manage Complexity Empirical control, Continuous monitoring, Heuristics Copyright Ennova 2011 Friday, 23 September 2011
  • 24.
    Agile Fundamentals Engineering Innovation. AGILE TECHNICAL AGILE TEAM PRACTICES PRACTICES Test-Driven Development Continuous Integration Colocation Automated Deployment Daily Stand Ups Incremental Design and Architecture Iteration Planning Acceptance Test-Driven Development Customer Showcase Refactoring Retrospective Technical Spikes Adaptive Release Plan Exploratory Testing Cross-Functional Team Collective Code Ownership Requirements as Stories Definition of Done Planning/Story Wall Ubiquitous Language Informative Workspace PRACTICES Burn Up/Down Charts Parking Lot Diagrams Success Sliders Planning Poker AGILE PRINCIPLES Simplicity PRINCIPLES Transparency Frequent Delivery Customer Involvement Technical Excellence Team Work AGILE VALUES VALUES Self Organisation Emergent Design Working Deliverables Continuous Improvement Human Interactions Sustainable Pace Customer Collaboration Responding to Change Copyright Ennova 2011 Friday, 23 September 2011
  • 25.
    Construction Complexity Engineering Innovation. Issue Plan Update Plan Ideal Plan Construction Site • Construction projects are not inherently complex - but because of the challenges encountered during execution they can become complex. • Because it is difficult to maintain an up-to-date plan - the plan rarely reflects the actual sequence in which tasks are completed • Majority of construction tasks are completed based on tacit knowledge and improvisation at the operational level Copyright Ennova 2011 Friday, 23 September 2011
  • 26.
    Agile and Complexity Engineering Innovation. The principles and practices in Agile help reduce the risks associated with complexity. Setting and agreeing clear goals and boundaries Break problem into small pieces and completing in the order of greatest priority Defer design decisions to the last responsible moment Retrospection and continuous improvement Clear definition of done Measure progress and adapt plans Encourage group wisdom through team work and cross-functional collaboration Copyright Ennova 2011 Friday, 23 September 2011
  • 27.
    Brief History Engineering Innovation. Development of methods to address construction productivity were conceived at a similar time to development of Agile methods First paper published Last Planner on Scrum System WorkFace Toyota method Published Planning Production System Published Lean first First XP published considered book applicable for Agile published Manifesto construction 1988 1992 1995 1999 2000 2001 2007 Now Copyright Ennova 2011 Friday, 23 September 2011
  • 28.
    Last Planner and WorkFace Planning Engineering Innovation. Friday, 23 September 2011
  • 29.
    Last Planner System Engineering Innovation. Method for controlling and providing certainty around materials, resources and work-face dependencies by using a collaborative approach to pull scheduling. Last Planner System Master Schedule Set milestones and key dates Should Specify handoffs Phase Schedule Do between trades Can Make ready and Do Look-Ahead Plan initiate re-planning as required Will Improving Weekly Work Plan Feedback Do & Learning Doing Progress Tracking & Done Measure progress and remedy issues Copyright Ennova 2011 Friday, 23 September 2011
  • 30.
    Last Planner System Engineering Innovation. Project Controls Project Monitoring & Planning Controlling Master Schedule Constraints Field Execution Weekly Work Planning Daily Standup! Measure Weekly Work Plan Kickoff Progress Make Ready! Retrospective Execute Field Work! Copyright Ennova 2011 Friday, 23 September 2011
  • 31.
    Weekly Work Engineering Innovation. Master Schedule 6 Week Look Ahead Should Do Can Do Activities Activities KANBAN PLANNING BOARD Can Do Will Do Doing Done ACTIVITY ACTIVITY ACTIVITY Will Do ACTIVITY Activities ACTIVITY ACTIVITY ACTIVITY ACTIVITY ACTIVITY ACTIVITY ACTIVITY ACTIVITY ACTIVITY Limit ACTIVITY Work ACTIVITY in ACTIVITY Progress Copyright Ennova 2011 Friday, 23 September 2011
  • 32.
    WorkFace Planning Engineering Innovation. WorkFace Planning involves the creation of small, well defined, field installation Work Packages that support the construction workforce. A typical Work Package supports one rotation (5 to 10 days) of a work crew and is based on activities that are extracted directly from the construction schedule/plan. Material and Equipment availability is confirmed Materials, before Work Packages Equipment are issued Master / Phase WorkFace Work Schedule Planning Packages A buffer of Work Packages is maintained to ensure field work Drawings, crews are optimally Specifications utilised Copyright Ennova 2011 Friday, 23 September 2011
  • 33.
    Agile and Construction Engineering Innovation. Agile Construction Iteration/Sprint Planning Weekly Work Plan User Story Work Package Story Elaboration WorkFace Planning Customer Showcase Site Inspection Retrospective Weekly Review Burn-Up/Down Charts S-Curve Adaptive Planning Look-Ahead Planning Copyright Ennova 2011 Friday, 23 September 2011
  • 34.
    Thank You Agile and Lean for Construction Adrian Smith Hugh Hofmeister Engineering Innovation. Friday, 23 September 2011
