[Type text]
A report on
“Affordable Housing in Jaipur”
Submitted in partial fulfilment of the requirement
For MBA course
By
XYZ
(Reg. No.:12345678)
Under the faculty guidance of:
Prof. Gagan Dharwal
Bangalore
[Type text]
Declaration
I confirm that this Report truly represent my work undertaken as a part of my course. This
work is not a replication of work done previously by any other person. I also confirm that the
contents of the Report and the views contained therein have been discussed and deliberated
with the Mentor.
Place: Bangalore XYZ
Date: 15-01-2019
Sikkim Manipal University
[Type text]
Contents
Chapter Description Page No.
1 Introduction 2
2 Research Methodology 15
Statement of problem
Data collection
Sample size.
3 Company Profile 22
4 Data Analysis & Interpretation 25
5 Findings, Suggestion & Conclusion 40
Bibliography 42
[Type text]
Chapter 1 Introduction
1.1 Executive Summary
1.2 Introduction
1.3 Growth engine of economy
1.4 Real Estate
1.5 Indian Real Estate Industry
1.6 Fundamental factors determining the value of real estate
1.6.1 Demand
1.6.2 Supply
1.7 Demand and Supply Constraints
1.8 Affordable Housing
1.9 Demand and supply constraints in India
[Type text]

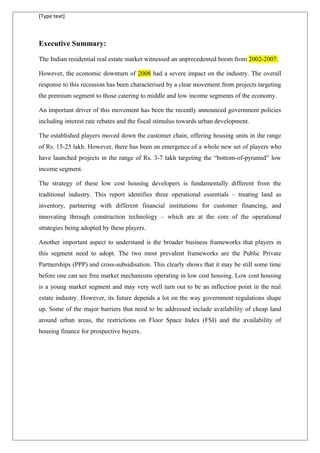

Executive Summary:
The Indian residential real estate market witnessed an unprecedented boom from 2002-2007.
However, the economic downturn of 2008 had a severe impact on the industry. The overall
response to this recession has been characterised by a clear movement from projects targeting
the premium segment to those catering to middle and low income segments of the economy.
An important driver of this movement has been the recently announced government policies
including interest rate rebates and the fiscal stimulus towards urban development.
The established players moved down the customer chain, offering housing units in the range
of Rs. 15-25 lakh. However, there has been an emergence of a whole new set of players who
have launched projects in the range of Rs. 3-7 lakh targeting the “bottom-of-pyramid” low
income segment.
The strategy of these low cost housing developers is fundamentally different from the
traditional industry. This report identifies three operational essentials – treating land as
inventory, partnering with different financial institutions for customer financing, and
innovating through construction technology – which are at the core of the operational
strategies being adopted by these players.
Another important aspect to understand is the broader business frameworks that players in
this segment need to adopt. The two most prevalent frameworks are the Public Private
Partnerships (PPP) and cross-subsidisation. This clearly shows that it may be still some time
before one can see free market mechanisms operating in low cost housing. Low cost housing
is a young market segment and may very well turn out to be an inflection point in the real
estate industry. However, its future depends a lot on the way government regulations shape
up. Some of the major barriers that need to be addressed include availability of cheap land
around urban areas, the restrictions on Floor Space Index (FSI) and the availability of
housing finance for prospective buyers.
[Type text]
Introduction:

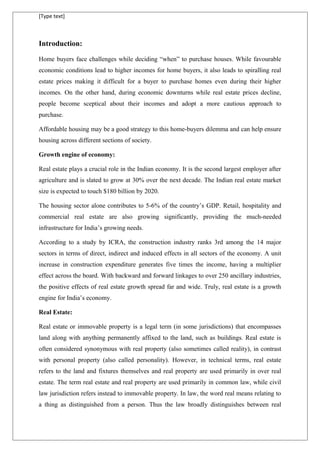

Home buyers face challenges while deciding “when” to purchase houses. While favourable
economic conditions lead to higher incomes for home buyers, it also leads to spiralling real
estate prices making it difficult for a buyer to purchase homes even during their higher
incomes. On the other hand, during economic downturns while real estate prices decline,
people become sceptical about their incomes and adopt a more cautious approach to
purchase.
Affordable housing may be a good strategy to this home-buyers dilemma and can help ensure
housing across different sections of society.
Growth engine of economy:
Real estate plays a crucial role in the Indian economy. It is the second largest employer after
agriculture and is slated to grow at 30% over the next decade. The Indian real estate market
size is expected to touch $180 billion by 2020.
The housing sector alone contributes to 5-6% of the country’s GDP. Retail, hospitality and
commercial real estate are also growing significantly, providing the much-needed
infrastructure for India’s growing needs.
According to a study by ICRA, the construction industry ranks 3rd among the 14 major
sectors in terms of direct, indirect and induced effects in all sectors of the economy. A unit
increase in construction expenditure generates five times the income, having a multiplier
effect across the board. With backward and forward linkages to over 250 ancillary industries,
the positive effects of real estate growth spread far and wide. Truly, real estate is a growth
engine for India’s economy.
Real Estate:
Real estate or immovable property is a legal term (in some jurisdictions) that encompasses
land along with anything permanently affixed to the land, such as buildings. Real estate is
often considered synonymous with real property (also sometimes called reality), in contrast
with personal property (also called personality). However, in technical terms, real estate
refers to the land and fixtures themselves and real property are used primarily in over real
estate. The term real estate and real property are used primarily in common law, while civil
law jurisdiction refers instead to immovable property. In law, the word real means relating to
a thing as distinguished from a person. Thus the law broadly distinguishes between real
[Type text]
property (land and anything affixed to it) and personal property (everything else e.g. clothing,
furniture, money).

Real Estate Business Includes: With the development of private property ownership, real
estate has become a major area of business. Purchasing real estate requires a significant
investment and each parcel of land has unique characteristics, so real estate industry has
evolved into several distinct fields. Some kind of real estate businesses include-
• Appraisal – Professional valuation services
• Brokerage – Assisting buyers and sellers in transactions
• Development – Improving land for use by adding or replacing buildings
• Property Management – Managing a property for its owner(s)
• Real Estate Marketing – Managing the sale side of the property business
• Relocation Services – Relocating people or business to difficult country
Types of Ownership Interests: Real property (immovable property) can refer to the real estate
itself or to various types of ownership interests in real estate, including:
• Freehold: Provides the owner the right to use the real estate for any lawful purpose and sell
when and to whom the owner wishes.
• Life estate: An interest in real estate which is granted to a life tenant until that person dies.
The interest terminates upon the death of the life tenant.
• Estate for years: Similar to life estate but term are a specified number of years.
• Leasehold: The right to posses and use real estate pursuant to the terms of a use.
• Reversion: The right to posses the free interest in real estate after the expiration of a life
estate, estate for years or leasehold.
• Concurrent or co-tenancy: The ownership of an interest in real property by more than one
party. Rights of any single party may be limited in various ways depending on the jurisdiction
and type of concurrency.
Participants of Real Estate Market: The main participants in the real estate markets are
Owner/User: These people are both owners and tenants. They purchase houses or
commercial property as an investment and also to live in or utilize as a business.
[Type text]

Owner: These people are pure investors. They do not consume but rent out or lease the
property to someone else.
Renter: These people are pure consumers.
Developers: These people prepare raw land for building which results in new product or the
market.
Renovators: These people supply refurbished buildings to the market.
Facilitators: This includes banks, real estate grocers, lawyers and others that facilitate the
purchase and sale of real estate. The owner/user, owner and renter comprise the demand side
of the market, while the developers and renovators constitute the supply side. In order to
apply the simple demand and supply analysis to real estate markets a number of
modifications need to be made to standard microeconomic assumptions and procedures.
Real estate can divided into three categories: These are
• Commercial
• Residential
• Agricultural
We can invest into all the given areas and can make return by capital appreciation, rental
income, agricultural produce, lease and commercial use.
The following factors influence the price and cost of the real estate:
1. The physical characteristics of the property
2. The property rights
3. The time horizon of holding the property
4. Geographical area
5. The development rate
Features of Real Estate Markets: In particular, the unique features of the real estate market
must be accommodated. These include:
• Durability
• Heterogeneous
• High transaction costs
[Type text]

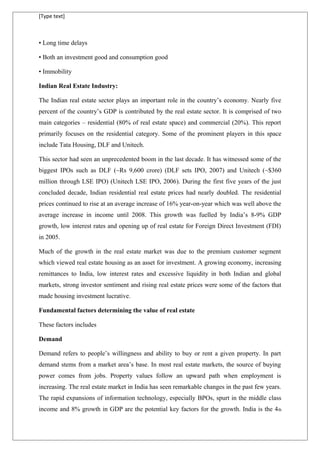

• Long time delays
• Both an investment good and consumption good
• Immobility
Indian Real Estate Industry:
The Indian real estate sector plays an important role in the country’s economy. Nearly five
percent of the country’s GDP is contributed by the real estate sector. It is comprised of two
main categories – residential (80% of real estate space) and commercial (20%). This report
primarily focuses on the residential category. Some of the prominent players in this space
include Tata Housing, DLF and Unitech.
This sector had seen an unprecedented boom in the last decade. It has witnessed some of the
biggest IPOs such as DLF (~Rs 9,600 crore) (DLF sets IPO, 2007) and Unitech (~$360
million through LSE IPO) (Unitech LSE IPO, 2006). During the first five years of the just
concluded decade, Indian residential real estate prices had nearly doubled. The residential
prices continued to rise at an average increase of 16% year-on-year which was well above the
average increase in income until 2008. This growth was fuelled by India’s 8-9% GDP
growth, low interest rates and opening up of real estate for Foreign Direct Investment (FDI)
in 2005.
Much of the growth in the real estate market was due to the premium customer segment
which viewed real estate housing as an asset for investment. A growing economy, increasing
remittances to India, low interest rates and excessive liquidity in both Indian and global
markets, strong investor sentiment and rising real estate prices were some of the factors that
made housing investment lucrative.
Fundamental factors determining the value of real estate
These factors includes
Demand
Demand refers to people’s willingness and ability to buy or rent a given property. In part
demand stems from a market area’s base. In most real estate markets, the source of buying
power comes from jobs. Property values follow an upward path when employment is
increasing. The real estate market in India has seen remarkable changes in the past few years.
The rapid expansions of information technology, especially BPOs, spurt in the middle class
income and 8% growth in GDP are the potential key factors for the growth. India is the 4th
[Type text]
largest economy in the world, and has the 2nd highest GDP among the developing countries
based on purchasing power parity. IT and IT enable services sector in India is still in its
growing stage due to increasing demand for business processing units in India and is
estimated to grow by 107% to $583 million in revenue. This could lead to a space
requirement of 20-25 million sq. ft. per annum, according to a Merrill Lynch report. Taking
this factor into consideration, the Total value of real estate created by the IT and ITES sector
in the next three years will be Rs.1,32,000 crore.
Supply Analysis
Supply analysis means sizing up the competition. Nobody wants to pay more for a property
than the price they can pay for competing property. An integral part of value analysis requires
identifying sources of potential competition and then inventorying them by price and
features. An analysis of supply should not limit potential competitors to geographically and
physically similar properties. In some markets, for example, low priced single family houses
might compete with condominium units, manufactured homes and even with rental
apartments.

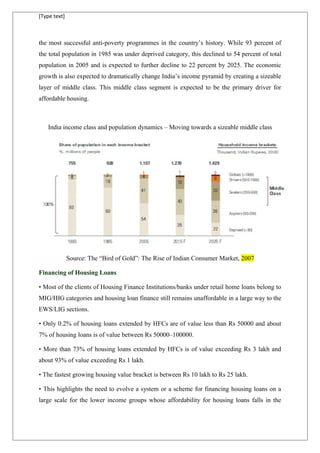

Demand and Supply Constraints:
The demand drivers for affordable housing are as below:
Urbanization: Urbanization is an index of transformation from traditional rural economies to
modern industrial one. India’s urban population is increasing at a faster rate than its total
population. At 28 percent, the pace of urbanization in India has been slower than average
pace of urbanization in Asia. However, the absolute number of people in urban cities and
towns has gone up substantially. In India, urbanization can be described as a product of
demographic explosion and poverty included rural-urban migration. This situation has
resulted in pressure on urban infrastructure and in an increase in the number of homeless
people living on the streets. As per the 2001 census the total urban homeless population was
7,78,599 people, which would be much more currently given the inadequate availability of
affordable / low-cost housing.
Rising income levels leading to a sizeable middle class segment. The past few years have
been tremendous economic growth in the country and one of the implementation of one of
[Type text]
the most successful anti-poverty programmes in the country’s history. While 93 percent of
the total population in 1985 was under deprived category, this declined to 54 percent of total
population in 2005 and is expected to further decline to 22 percent by 2025. The economic
growth is also expected to dramatically change India’s income pyramid by creating a sizeable
layer of middle class. This middle class segment is expected to be the primary driver for
affordable housing.
India income class and population dynamics – Moving towards a sizeable middle class
Source: The “Bird of Gold”: The Rise of Indian Consumer Market, 2007
Financing of Housing Loans
• Most of the clients of Housing Finance Institutions/banks under retail home loans belong to
MIG/HIG categories and housing loan finance still remains unaffordable in a large way to the
EWS/LIG sections.
• Only 0.2% of housing loans extended by HFCs are of value less than Rs 50000 and about
7% of housing loans is of value between Rs 50000–100000.
• More than 73% of housing loans extended by HFCs is of value exceeding Rs 3 lakh and
about 93% of value exceeding Rs 1 lakh.
• The fastest growing housing value bracket is between Rs 10 lakh to Rs 25 lakh.
• This highlights the need to evolve a system or a scheme for financing housing loans on a
large scale for the lower income groups whose affordability for housing loans falls in the
[Type text]
range below Rs 3 lakh, as over 90% of the housing shortage is on account of EWS/LIG.
multiple counting and resale of properties, in the sense that cross-funding/bulk borrowing is
involved among the various institutions. It is, therefore, assumed that the net flow of funds to
the housing sector from formal sector institutions would be 50% of the gross flow of funds
for construction of new houses. This comes to approximately Rs 2.90 lakh crore, which is
80% of the total investment requirements for urban housing for the Eleventh Plan.
Affordable Housing:
Affordable Housing as a concept is very generic and could have different meanings for
different people based on differences in income levels.
It refers to any housing that meets some low cost criterion. Different countries have defined
affordable housing to present the economic potential of an individual buying a house.
Defining affordable housing in India is a difficult task giving that at every square kilometre
of the country, the dynamics of the market are different. At KPMG and The Confederation of
Real Estate Developers' Associations of India (CREDAI), we have therefore broadly defined
affordable housing in India for Tier I, II and III cities based on two key parameters:
1 Income Level 2 Size of Dweeling Unit
EWS* <INR 1.5 lacs per annum Upto 300 sq.ft
LIG** 1.5 to 3 lacs per annum 300 to 600 sq.ft
MIG*** INR 3 to 10 lacs per annum 600 to 1200 sq.ft
*Economically Weaker Sections
**Lower Income Group
***Higher Income Group
Source KPMG Analysis
Affordable housing can be defined using two key parameters viz. income level and size of
dwelling unit. These parameters are independent of each other. While the above definition is
a generic representation at an all India level, the actual definition of affordable housing may
vary with regions and income levels.
Affordable and low-cost housing are often interchangeably used, but are quite different from
each other. Low-cost housing is generally meant for EWS category and comprises bare
minimum housing facilities while affordable housing is mostly meant for LIG and MIG and
includes basic amenities like school, hospitals and other community facilities and services.
[Type text]
Parameters Low-Cost Housing Affordable Housing
Amenities Bare minimum to none Basic
Target Income Class EWS & LIG LIG & MIG
Size of Dwelling Unit <=300 sq.ft 300-1200 sq.ft
Location Generally with in city but can
also be located on city
peripheries due to high cost of
land
Within city
Project Developer Mostly Government agencies Private Developers and
Government
Moostly available source of finance Micro finance institutions Traditional banking system
EMI to Monthly Income Not exceeding 30% of gross
monthly income
Not exceeding 40% of gross
monthly income
Source: KPMG Analysis
So what has led to the sudden spurt in affordable / low-cost housing/
While the real estate industry across developed countries went through one of its worst
downturns, the Indian real estate industry, which was considered “shock-proof”, was also
badly hit. The tremors of the global liquidity crises led to price corrections in the domestic
real estate industry leaving developers with land parcels acquired at peak prices and with
considerable stress on their balance sheet.
Source: Report on India Strategy, Motilal Oswal, 30th Sep 2009
[Type text]

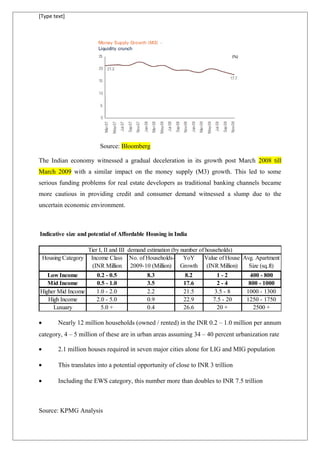

Source: Bloomberg
The Indian economy witnessed a gradual deceleration in its growth post March 2008 till
March 2009 with a similar impact on the money supply (M3) growth. This led to some
serious funding problems for real estate developers as traditional banking channels became
more cautious in providing credit and consumer demand witnessed a slump due to the
uncertain economic environment.
Indicative size and potential of Affordable Housing in India
Housing Category Income Class
(INR Million
p.a)
No. of Households-
2009-10 (Million)
YoY
Growth
(%)
Value of House
(INR Million)
Avg. Apartment
Size (sq.ft)
Low Income 0.2 - 0.5 8.3 8.2 1 - 2 400 - 800
Mid Income 0.5 - 1.0 3.5 17.6 2 - 4 800 - 1000
Higher Mid Income 1.0 - 2.0 2.2 21.5 3.5 - 8 1000 - 1300
High Income 2.0 - 5.0 0.9 22.9 7.5 - 20 1250 - 1750
Luxuary 5.0 + 0.4 26.6 20 + 2500 +
Tier I, II and III demand estimation (by number of households)
• Nearly 12 million households (owned / rented) in the INR 0.2 – 1.0 million per annum
category, 4 – 5 million of these are in urban areas assuming 34 – 40 percent urbanization rate
• 2.1 million houses required in seven major cities alone for LIG and MIG population
• This translates into a potential opportunity of close to INR 3 trillion
• Including the EWS category, this number more than doubles to INR 7.5 trillion
Source: KPMG Analysis
[Type text]
The real estate business in India
underwent considerable changes post
the global liquidity crisis. Prior to the
crisis, developers bought land with part
payment and launched projects; this
meant regular cash flows from upfront
payments was required to fund chain of
projects. The developers continued with
this practice and acquired huge land
parcels by leveraging their balance
sheets. With the liquidity crisis,
availability of construction finance
became a challenge and muted
consumer demand meant very little
upfront payments due to concerns on
timely project completion, thereby
affecting regular cash inflows for
developers. All these factors resulted in
developers resorting to alternative
revenue generation strategies such as
stake sale, sale of non-core assets and
even freebie offers like cars, gold
medallions etc. To improve the cash
flows further many developers across
India reduced property prices on an
average by 20-30 percent.
The correction in prices was a boon for
people who wanted to purchase houses
for a long time but could not earlier due
to steep property prices and high costs
of finance. It is interesting to note this
section of the population is actually
willing to pay and make necessary
sacrifices for owning a home even in
present economic scenario.
Past Present
Acquire land with part
payment
Acquired land with part
payment
Start construction, avail
construction finance
Launch of projects,
collection of customer
advances, and payment
of land dues
Use surplus funds as
down payment for
additional land
Deleveraging, stake sale
to private equity at
distress valuations
Deferment of project
launches
Developer stuck with
high leverage
Construction finance not
readily available
Weak launches with
muted response
[Type text]
Demand drivers and supply constraints for affordable housing in India
The key supply constraints for affordable housing are as follows:
Availability of land: One of the biggest questions that India needs to answer going forward
is with respect to adequate supply of land for housing purpose. The Government’s vision of
“affordable Housing for All” will require acquisition / supply of large land parcels on a
regular basis. As per 2001 census, the country’s urban land mass (2.4 percent of total land
mass) houses approximately 28 percent of the country’s population, excluding people who
live on the streets. According to calculations made by the Town and Country Planning
Organization (TCPO), to cater to the demand of EWS and LIG category alone would require
84,724 to 1,20,882 hectares of additional land.
Land Cost: Land cost is another crucial factor affecting supply of land. Given limited
availability of land in urban areas, it becomes unavailable for developers to provide
affordable housing without Government support. On the other hand, the Government holds
substantial amount of urban land and ownership of port trusts, the Railways, the Ministry of
Defence, land acquired under the Urban Land (Ceiling and Regulation) Act, the Airports
Authority of India and other government departments.
Financial and Regulatory Support: Financial and regulatory constraints have plagued the
housing sector in India. Current financing mechanism prevalent in the country mostly targets
MIG and HIG sections of the society while the households falling under LIG and EWS
category find it difficult to secure formal housing finance. Commercial banks and traditional
means of housing finance typically do not serve low-income groups, whose income may be
vary with crop seasons, or below the ‘viable’ threshold to ensure repayment, or who cannot
provide collateral for loans. Microfinance institutions are considered to be the next best

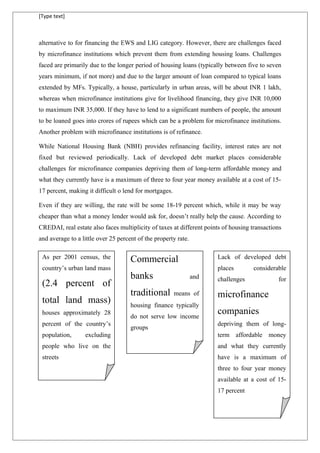

[Type text]
alternative to for financing the EWS and LIG category. However, there are challenges faced
by microfinance institutions which prevent them from extending housing loans. Challenges
faced are primarily due to the longer period of housing loans (typically between five to seven
years minimum, if not more) and due to the larger amount of loan compared to typical loans
extended by MFs. Typically, a house, particularly in urban areas, will be about INR 1 lakh,
whereas when microfinance institutions give for livelihood financing, they give INR 10,000
to maximum INR 35,000. If they have to lend to a significant numbers of people, the amount
to be loaned goes into crores of rupees which can be a problem for microfinance institutions.
Another problem with microfinance institutions is of refinance.
While National Housing Bank (NBH) provides refinancing facility, interest rates are not
fixed but reviewed periodically. Lack of developed debt market places considerable
challenges for microfinance companies depriving them of long-term affordable money and
what they currently have is a maximum of three to four year money available at a cost of 15-
17 percent, making it difficult o lend for mortgages.
Even if they are willing, the rate will be some 18-19 percent which, while it may be way
cheaper than what a money lender would ask for, doesn’t really help the cause. According to
CREDAI, real estate also faces multiplicity of taxes at different points of housing transactions
and average to a little over 25 percent of the property rate.
As per 2001 census, the
country’s urban land mass
(2.4 percent of
total land mass)
houses approximately 28
percent of the country’s
population, excluding
people who live on the
streets
Commercial
banks and
traditional means of
housing finance typically
do not serve low income
groups
Lack of developed debt
places considerable
challenges for
microfinance
companies
depriving them of long-
term affordable money
and what they currently
have is a maximum of
three to four year money
available at a cost of 15-
17 percent
[Type text]
Chapter 2 Research Methodology
2.1 Objective of the study
2.2 Title of the study
2.3 Statement of the problem
2.4 Scope of the study
2.5 Research Methodology
2.5.1 Market Research
2.5.2 Methodology
2.5.3 Research Approach
2.5.4 Research Design
2.6 Questionnarie

[Type text]

Objectives of the study:
1. Understand the business model.
2. Understand the concept of Affordable Housing.
3. Understand the techniques and ways to develop Affordable Housing.
4. To find out the different parameters that affects the demand for affordable housing in
Jaipur.
5. Learn to efficiently select different parameters.
6. Establish the scope for construction of affordable housing.
Title of the study:
The title of my study is “Demand for Affordable Housing In Jaipur”.
Statement of the problem:
In the process of study, the first and foremost step happens to be that of selecting and
properly defining the subject. To start any new business it is necessary to find the total cash
inflow needed and the revenue that will be generated overtime. Other important information
that an investor needs to know before making an investment in any project is when it will
reach its breakeven point. Only when the investor is aware of all the above information that
he can make the informed decisions.
So the problem selected is “To find if there is demand for affordable housing projects in
Jaipur”.
Scope of the study:
The study on the demand for construction of affordable housing covers multiple avenues of
learning.
1. It then deals with the budget estimates of the project i.e. the cost of the project.
2. It also estimates the quantity of the apartments to be produced for a predefined
amount of sales generation.
[Type text]
3. It covers estimated cash inflow, working capital requirement, profitability statement
and projected balance sheet.
Research Methodology:
Market Research
Marketing research has become most important tool for decision making in the field
of finance due to the following reasons.
• Business environment is changes very rapidly which needs to continuous
modification and improvement.
• It provides correct and reliable information about customer, competitors and one’s
own activities to the manager, so that the huge amount spent on marketing
activities to be utilized properly.
• Since modern business is customer oriented, it (MR) provides the producer a
systematic and analytical approach based on assessment on customer
requirements, which helps the producer in maximization of net profit by
producing such products that fulfill the customer’s utmost level of satisfaction.
Thus, the study is a systematic gathering, recording and analysis of data about the problem
facing the company. It helps the marketing manager to develop and analyze new information,
which is further helpful in developing marketing strategy. Now it can be said that marketing
research covers a very wide variety of activities ranging from analysis of financial potential
and market share to studies of customers satisfaction and purchase intention.
Methodology:
The data for the study has been collected from both the primary source and the secondary
source.
Primary source:
In case of the above study primary source of data was collected with the survey done by
using a suitable questionnaire. The primary data includes the data collected from different
parts of Jaipur city. On geographical basis city is divided into five zones i.e. north, south,
east, west and central. A total of 125 households were interviewed in order to know the
demand for housing in general and analysing them on the basis of their affordability.
Secondary source:
These data are generally the data which support the primary data and hold an important
position in the analysis of the study. The secondary data includes information from the
[Type text]
internet, CREDAI, and documents from Purvanchal Group. To get more idea and information
related to the real estate industry, various journals and websites were used.
Research Approach:
Quantitative approach i.e. use of statistical tools for quantifying the data and analyzing the
data pattern. The basic needs of any research are data and method of collecting it. Data is an
information on the basis of which inference are drawn, therefore, data become a very
important and vital factor in research study. The main purpose behind framing a methodology
is to desirable the research procedure which includes data sources, data collection method,
research instructions.
DATA COLLECTION METHOD
The following method is widely used for collecting data.
Contact Methods:
The respondents were contacted directly (Personal Interviewing). It is the most versatile
method. The interview was of intercept type in which respondents were asked to answer the
questions on the spot. For this purpose questionnaires were prepared in such that all
necessary data would be collected.
Sample Description:
Sample size: 125
Sampling Frame: Jaipur
Sampling Elements: Households
[Type text]

QUESTIONNAIRE ON AFFORDABLE HOUSING IN JAIPUR
Dear Sir/Madam
I am a student of SIKKIM MANIPAL UNIVERSITY. As a part of my research study I am
conducting a survey regarding the demand for affordable housing in Jaipur.
The purpose of this questionnaire is to provide supporting evidence for:
a) Applicants submitting planning applications for any form of affordable housing.
b) Determining the eligibility of successive households to occupy an existing affordable
dwelling
1. Name, gender and age group of all household members (including children) to occupy
the dwelling
Household member Name Male/Female 0-15 16-24 25-60 60+
1
2
3
4
5
6
7
8
Age Group
2. Present address of all applicants listed in Question 1
3. Contact name and phone number
4. What is your current form of tenure? (Please tick)
[Type text]
Owners
Rental
Others
5. Do you want to shift from your current dwelling as an owner?
Least
Interested
Disinterested Neutral Interested
Very
interested
6. If yes, then what type of accommodation would you prefer?
Self owned
Rented
Others
7. If you rent a property, how much per month is your household able to pay? (Please
tick)
<3000
3000 - 5000
5000 - 10000
10000 - 15000
15000 - 20000
>20000
8. If buying a property, how much in monthly mortgage payment is your household able
to pay? (Please tick)
.
7000 - 12000
12000 - 16000
16000 - 20000
20000 - 25000
25000 - 30000
>30000

9. What type of accommodation is required / proposed? (Please tick)
[Type text]
Supported / sheltered housing
Flat
Detached House
Semi-detached house
Terraced house
Bungalow
Other
10. How long have you lived at your present address?
Years Months
11. What is the households’ total annual gross income? (Please tick)
<180000
180000 - 215000
215000 - 250000
250000 - 350000
350000 - 450000
450000 - 600000
>600000
12. Does your household require separate accommodation for existing residents within
your household?
Yes No
13. Do you or any other household members already have a mortgage, own a property or
have you recently sold a property?
Yes No
14. Name the locality or settlement area you want to live in
15. Why is the above location preferred?
16. How many bedrooms do you require / wish to build? (Please tick)
1
2
3
4
5
[Type text]
17. If you have a specific site or property which you would like to occupy in mind, please
give the site / property name and address below:
18. Further comments / additional information
Chapter 3 Company Profile
3.1 Company Overview
3.2 Company’s Excellence in Construction
3.3 Capabilities
3.4 Certificates
[Type text]

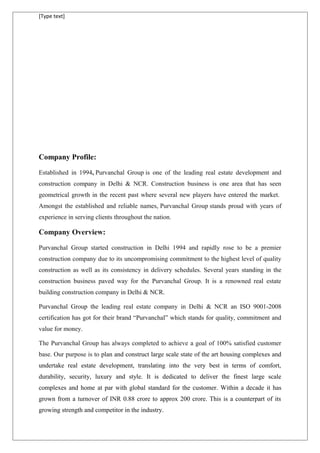

Company Profile:
Established in 1994, Purvanchal Group is one of the leading real estate development and
construction company in Delhi & NCR. Construction business is one area that has seen
geometrical growth in the recent past where several new players have entered the market.
Amongst the established and reliable names, Purvanchal Group stands proud with years of
experience in serving clients throughout the nation.
Company Overview:
Purvanchal Group started construction in Delhi 1994 and rapidly rose to be a premier
construction company due to its uncompromising commitment to the highest level of quality
construction as well as its consistency in delivery schedules. Several years standing in the
construction business paved way for the Purvanchal Group. It is a renowned real estate
building construction company in Delhi & NCR.
Purvanchal Group the leading real estate company in Delhi & NCR an ISO 9001-2008
certification has got for their brand “Purvanchal” which stands for quality, commitment and
value for money.
The Purvanchal Group has always completed to achieve a goal of 100% satisfied customer
base. Our purpose is to plan and construct large scale state of the art housing complexes and
undertake real estate development, translating into the very best in terms of comfort,
durability, security, luxury and style. It is dedicated to deliver the finest large scale
complexes and home at par with global standard for the customer. Within a decade it has
grown from a turnover of INR 0.88 crore to approx 200 crore. This is a counterpart of its
growing strength and competitor in the industry.
[Type text]
Company’s Excellence in Construction:
With an excellent track record of delivering numerous housing projects of the highest quality,
it has been consistent in its performance. Purvanchal Group style of construction is instantly
distinguished for its most modern, state-of-the art design, inclusion of luxurious amenities,
excellent planning of usable space, and finished interiors. Its achievements are demonstrated
by their highly successful projects - some of them are completed while others are under
construction or nearing to completion.
As a mark of excellence, our clients have invested more than INR 500 crore in the past
decade in housing projects. Most of the development took place in the areas of New Delhi,
Noida& Greater Noida through Purvanchal Group. Since their inception, it has delivered over
three thousand five hundred flats in various housing complexes.
It’s Capabilities:
With strategic focus on each department, it has developed wide expertise and strengths in the
sector of mass housing. It has the capability to incorporate the complexities, comforts as well
as the convenience in their world-class multiplex housing projects. From three-storied
apartments to multi-storeyed, it can design and develop projects of every size and
complexity. Its strong capabilities are reflected in the 50 projects that it has completed in and
around Delhi.
Certificates:
Company has acquired the ISO 9001: 2008 on 20th
march, 2009 and all our construction and
project related activities conform to the ISO standards.
[Type text]
Chapter 4 Data Analysis and Interpretation
1.1 Analysis and Interpretation
1.2 Stakeholder’s Perspective - Key initiatives and concerns
1.3 Stakeholders Concern
1.4 Role of PPP in Affordable Housing
1.5 Hypothesis Testing

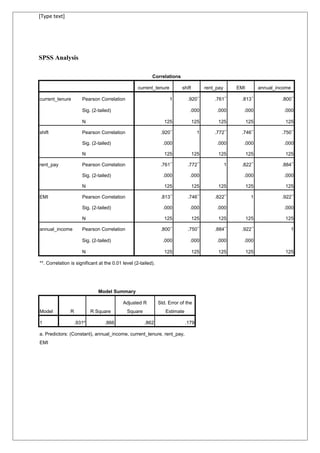

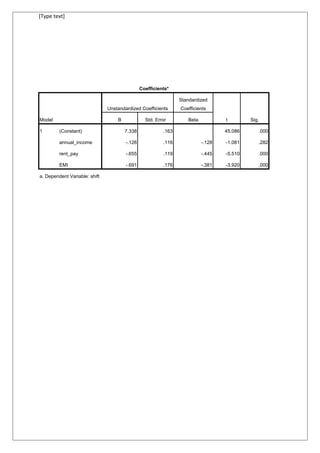

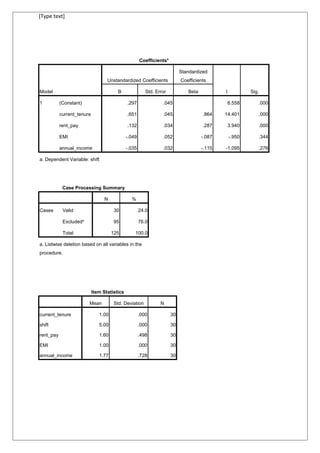

1.6 SPSS Analysis
[Type text]

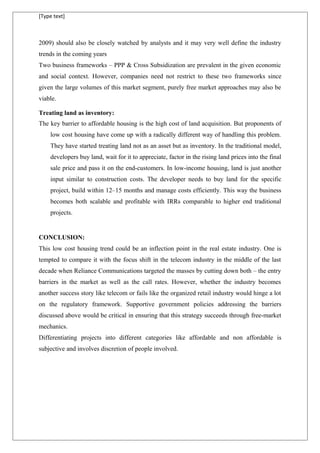

Analysis and Interpretation:
The analysis includes estimation of the demand for the affordable housing, current form of
household tenure, their ability to spend on rent and EMI and also to know total cost of the
project, estimation of various expenses, finding cost of capital, revenues streams, estimation
of working capital requirement, expected cash inflows and finding breakeven point.
Interpretations are made by observing the data analyzed. Based on the projections made, it
can be recommended to invest in developing affordable housing and go ahead with it. It is
because there is great demand of the product in the market which will generate adequate cash
inflows.
[Type text]

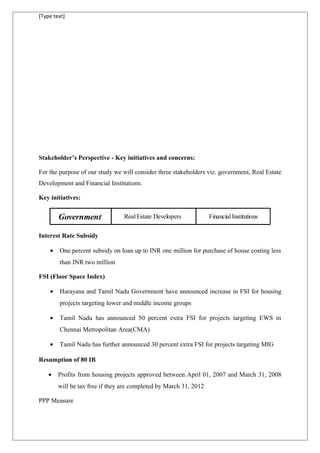

Stakeholder’s Perspective - Key initiatives and concerns:
For the purpose of our study we will consider three stakeholders viz. government, Real Estate
Development and Financial Institutions.

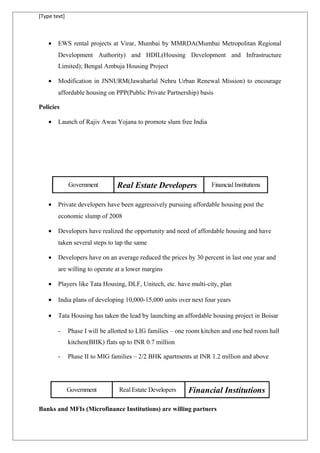

Key initiatives:
Government Real Estate Developers Financial Institutions
Interest Rate Subsidy
• One percent subsidy on loan up to INR one million for purchase of house costing less
than INR two million
FSI (Floor Space Index)
• Harayana and Tamil Nadu Government have announced increase in FSI for housing
projects targeting lower and middle income groups
• Tamil Nadu has announced 50 percent extra FSI for projects targeting EWS in
Chennai Metropolitan Area(CMA)
• Tamil Nadu has further announced 30 percent extra FSI for projects targeting MIG
Resumption of 80 IB
• Profits from housing projects approved between April 01, 2007 and March 31, 2008
will be tax free if they are completed by March 31, 2012
PPP Measure
[Type text]
• EWS rental projects at Virar, Mumbai by MMRDA(Mumbai Metropolitan Regional
Development Authority) and HDIL(Housing Development and Infrastructure
Limited); Bengal Ambuja Housing Project
• Modification in JNNURM(Jawaharlal Nehru Urban Renewal Mission) to encourage
affordable housing on PPP(Public Private Partnership) basis
Policies
• Launch of Rajiv Awas Yojana to promote slum free India
Government Real Estate Developers Financial Institutions
• Private developers have been aggressively pursuing affordable housing post the
economic slump of 2008
• Developers have realized the opportunity and need of affordable housing and have
taken several steps to tap the same
• Developers have on an average reduced the prices by 30 percent in last one year and
are willing to operate at a lower margins
• Players like Tata Housing, DLF, Unitech, etc. have multi-city, plan
• India plans of developing 10,000-15,000 units over next four years
• Tata Housing has taken the lead by launching an affordable housing project in Boisar
- Phase I will be allotted to LIG families – one room kitchen and one bed room hall
kitchen(BHK) flats up to INR 0.7 million
- Phase II to MIG families – 2/2 BHK apartments at INR 1.2 million and above
Government Real Estate Developers Financial Institutions
Banks and MFIs (Microfinance Institutions) are willing partners
[Type text]
• Banks are willing to fund suitable projects, provided that adequate checks are in
place to monitor credit risk
• MFIs have expressed interest in funding EWS dwelling units up to INR 0.5
million
• Micro Housing Finance Corporation is an MFI that is exclusively focused on
housing finance
Stakeholders Concern:
[Type text]
* 'Ghettoization' ofmarginalpopulation
* Speculative interest
* Timely completion of projects
* Delivery of flats to target segments without cost escalations
* Diversion ofland / funds by developer
* Volume off-take
* Profitability
* Availability of cheap land
* Hassles in land acquisition
* Delay due to regulatory approvals
* Restrictive density norms
* Access to low-cost funds
* Government support to lower cost of capital
* Credit risk
* profitability
Government
Real Estate
Developers
Financial
Institutions
Source: (National Real Estate Development Council), KPMG Analysis

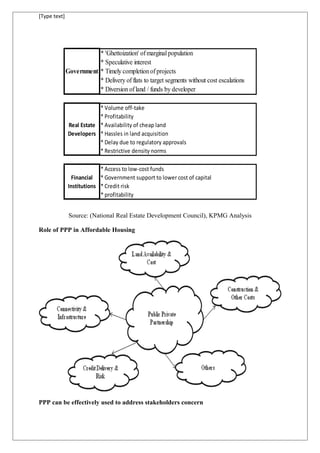

Role of PPP in Affordable Housing
PPP can be effectively used to address stakeholders concern
[Type text]

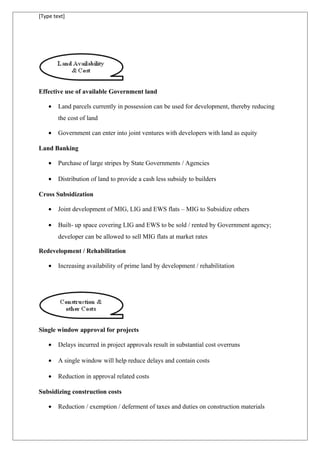

Effective use of available Government land
• Land parcels currently in possession can be used for development, thereby reducing
the cost of land
• Government can enter into joint ventures with developers with land as equity
Land Banking
• Purchase of large stripes by State Governments / Agencies
• Distribution of land to provide a cash less subsidy to builders
Cross Subsidization
• Joint development of MIG, LIG and EWS flats – MIG to Subsidize others
• Built- up space covering LIG and EWS to be sold / rented by Government agency;
developer can be allowed to sell MIG flats at market rates
Redevelopment / Rehabilitation
• Increasing availability of prime land by development / rehabilitation
Single window approval for projects
• Delays incurred in project approvals result in substantial cost overruns
• A single window will help reduce delays and contain costs
• Reduction in approval related costs

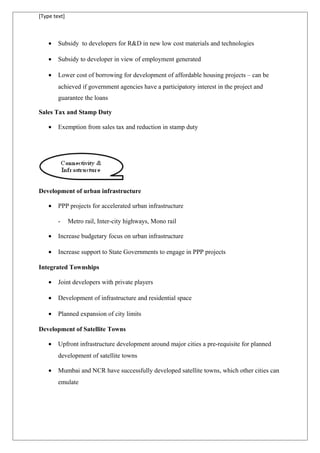

Subsidizing construction costs
• Reduction / exemption / deferment of taxes and duties on construction materials
[Type text]
• Subsidy to developers for R&D in new low cost materials and technologies
• Subsidy to developer in view of employment generated
• Lower cost of borrowing for development of affordable housing projects – can be
achieved if government agencies have a participatory interest in the project and
guarantee the loans
Sales Tax and Stamp Duty
• Exemption from sales tax and reduction in stamp duty
Development of urban infrastructure
• PPP projects for accelerated urban infrastructure
- Metro rail, Inter-city highways, Mono rail
• Increase budgetary focus on urban infrastructure
• Increase support to State Governments to engage in PPP projects
Integrated Townships
• Joint developers with private players
• Development of infrastructure and residential space
• Planned expansion of city limits
Development of Satellite Towns
• Upfront infrastructure development around major cities a pre-requisite for planned
development of satellite towns
• Mumbai and NCR have successfully developed satellite towns, which other cities can
emulate
[Type text]

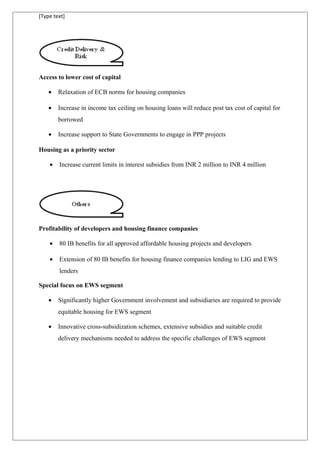

Access to lower cost of capital
• Relaxation of ECB norms for housing companies
• Increase in income tax ceiling on housing loans will reduce post tax cost of capital for
borrowed
• Increase support to State Governments to engage in PPP projects
Housing as a priority sector
• Increase current limits in interest subsidies from INR 2 million to INR 4 million
Profitability of developers and housing finance companies
• 80 IB benefits for all approved affordable housing projects and developers
• Extension of 80 IB benefits for housing finance companies lending to LIG and EWS
lenders
Special focus on EWS segment
• Significantly higher Government involvement and subsidiaries are required to provide
equitable housing for EWS segment
• Innovative cross-subsidization schemes, extensive subsidies and suitable credit
delivery mechanisms needed to address the specific challenges of EWS segment
[Type text]
Current form of tenure:
Interpretation:
40% of the respondents belong to the rental and others category. So there is a high probability
that they would be interested in buying a residential property. Also some of the respondents
belonging to the owner’s category have shown their interest in buying a new residential
property.
Demand for housing in Jaipur:
[Type text]
Interpretation:
64 % of the respondents have shown positive interest in buying residential property.
Demand for housing:
Interpretation:
Maximum number of repondents are interested in buying a property rather than stayin in a
rental accomodation.
[Type text]
How much rent households willing to pay:
Interpretation:
Maximum percentage of the respondents dont prefer to indulge in paying anything above Rs.
5000 as rent. It shows that most of the respondents are looking for low or moderate standard
accomodation.

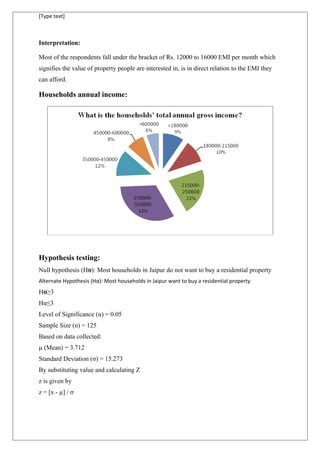

How much EMI households willing to pay per month:
[Type text]
Interpretation:
Most of the respondents fall under the bracket of Rs. 12000 to 16000 EMI per month which
signifies the value of property people are interested in, is in direct relation to the EMI they
can afford.
Households annual income:
Hypothesis testing:
Null hypothesis (H ):ѳ Most households in Jaipur do not want to buy a residential property
Alternate Hypothesis (Hα): Most households in Jaipur want to buy a residential property
H ≥3ѳ
Hα≤3
Level of Significance (α) = 0.05
Sample Size (n) = 125
Based on data collected:
µ (Mean) = 3.712
Standard Deviation (σ) = 15.273
By substituting value and calculating Z
z is given by
z = [x - µ] / σ
[Type text]

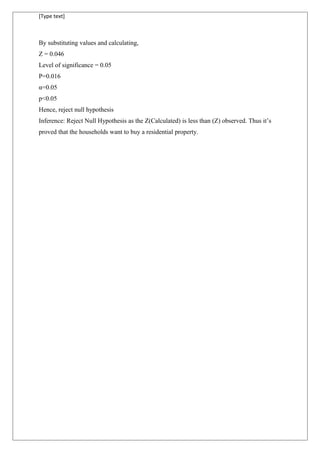

By substituting values and calculating,
Z = 0.046
Level of significance = 0.05
P=0.016
α=0.05
p<0.05
Hence, reject null hypothesis
Inference: Reject Null Hypothesis as the Z(Calculated) is less than (Z) observed. Thus it’s
proved that the households want to buy a residential property.
[Type text]
SPSS Analysis
Correlations
current_tenure shift rent_pay EMI annual_income
current_tenure Pearson Correlation 1 .920**
.761**
.813**
.800**
Sig. (2-tailed) .000 .000 .000 .000
N 125 125 125 125 125
shift Pearson Correlation .920**
1 .772**
.746**
.750**
Sig. (2-tailed) .000 .000 .000 .000
N 125 125 125 125 125
rent_pay Pearson Correlation .761**
.772**
1 .822**
.884**
Sig. (2-tailed) .000 .000 .000 .000
N 125 125 125 125 125
EMI Pearson Correlation .813**
.746**
.822**
1 .922**
Sig. (2-tailed) .000 .000 .000 .000
N 125 125 125 125 125
annual_income Pearson Correlation .800**
.750**
.884**
.922**
1
Sig. (2-tailed) .000 .000 .000 .000
N 125 125 125 125 125
**. Correlation is significant at the 0.01 level (2-tailed).
Model Summary
Model R R Square
Adjusted R
Square
Std. Error of the
Estimate
1 .931a
.866 .862 .179
a. Predictors: (Constant), annual_income, current_tenure, rent_pay,
EMI
[Type text]
Coefficientsa
Model
Unstandardized Coefficients
Standardized
Coefficients
t Sig.B Std. Error Beta
1 (Constant) .297 .045 6.558 .000
current_tenure .651 .045 .864 14.401 .000
rent_pay .132 .034 .287 3.940 .000
EMI -.049 .052 -.087 -.950 .344
annual_income -.035 .032 -.115 -1.095 .276
a. Dependent Variable: shift
Case Processing Summary
N %
Cases Valid 30 24.0
Excludeda
95 76.0
Total 125 100.0
a. Listwise deletion based on all variables in the
procedure.
Item Statistics
Mean Std. Deviation N
current_tenure 1.00 .000 30
shift 5.00 .000 30
rent_pay 1.60 .498 30
EMI 1.00 .000 30
annual_income 1.77 .728 30
[Type text]
Coefficientsa
Model
Unstandardized Coefficients
Standardized
Coefficients
t Sig.B Std. Error Beta
1 (Constant) 7.338 .163 45.086 .000
annual_income -.126 .116 -.128 -1.081 .282
rent_pay -.655 .119 -.445 -5.510 .000
EMI -.691 .176 -.381 -3.920 .000
a. Dependent Variable: shift
[Type text]

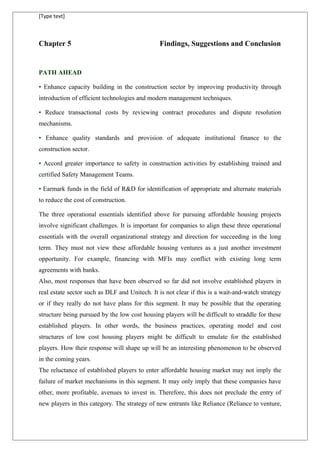

Chapter 5 Findings, Suggestions and Conclusion
PATH AHEAD
• Enhance capacity building in the construction sector by improving productivity through
introduction of efficient technologies and modern management techniques.
• Reduce transactional costs by reviewing contract procedures and dispute resolution
mechanisms.
• Enhance quality standards and provision of adequate institutional finance to the
construction sector.
• Accord greater importance to safety in construction activities by establishing trained and
certified Safety Management Teams.
• Earmark funds in the field of R&D for identification of appropriate and alternate materials
to reduce the cost of construction.
The three operational essentials identified above for pursuing affordable housing projects
involve significant challenges. It is important for companies to align these three operational
essentials with the overall organizational strategy and direction for succeeding in the long
term. They must not view these affordable housing ventures as a just another investment
opportunity. For example, financing with MFIs may conflict with existing long term
agreements with banks.
Also, most responses that have been observed so far did not involve established players in
real estate sector such as DLF and Unitech. It is not clear if this is a wait-and-watch strategy
or if they really do not have plans for this segment. It may be possible that the operating
structure being pursued by the low cost housing players will be difficult to straddle for these
established players. In other words, the business practices, operating model and cost
structures of low cost housing players might be difficult to emulate for the established
players. How their response will shape up will be an interesting phenomenon to be observed
in the coming years.
The reluctance of established players to enter affordable housing market may not imply the
failure of market mechanisms in this segment. It may only imply that these companies have
other, more profitable, avenues to invest in. Therefore, this does not preclude the entry of
new players in this category. The strategy of new entrants like Reliance (Reliance to venture,
[Type text]
2009) should also be closely watched by analysts and it may very well define the industry
trends in the coming years
Two business frameworks – PPP & Cross Subsidization are prevalent in the given economic
and social context. However, companies need not restrict to these two frameworks since
given the large volumes of this market segment, purely free market approaches may also be
viable.
Treating land as inventory:
The key barrier to affordable housing is the high cost of land acquisition. But proponents of
low cost housing have come up with a radically different way of handling this problem.
They have started treating land not as an asset but as inventory. In the traditional model,
developers buy land, wait for it to appreciate, factor in the rising land prices into the final
sale price and pass it on the end-customers. In low-income housing, land is just another
input similar to construction costs. The developer needs to buy land for the specific
project, build within 12–15 months and manage costs efficiently. This way the business
becomes both scalable and profitable with IRRs comparable to higher end traditional
projects.
CONCLUSION:
This low cost housing trend could be an inflection point in the real estate industry. One is
tempted to compare it with the focus shift in the telecom industry in the middle of the last
decade when Reliance Communications targeted the masses by cutting down both – the entry
barriers in the market as well as the call rates. However, whether the industry becomes
another success story like telecom or fails like the organized retail industry would hinge a lot
on the regulatory framework. Supportive government policies addressing the barriers
discussed above would be critical in ensuring that this strategy succeeds through free-market
mechanics.
Differentiating projects into different categories like affordable and non affordable is
subjective and involves discretion of people involved.
[Type text]
Bibliography
1. International Research Journal of Finance and Economics - Issue 24 (2009)
2. Indian Economic Outlook 2010
3. Cuchman Wakefield
4. KPMG
5. Bloomberg
6. Indian Journal of Commerce & Management Studies
7. Purvanchal Group
8. CREDAI

Affordable Housing in Jaipur

  • 1.
    [Type text] A reporton “Affordable Housing in Jaipur” Submitted in partial fulfilment of the requirement For MBA course By XYZ (Reg. No.:12345678) Under the faculty guidance of: Prof. Gagan Dharwal Bangalore
  • 2.
    [Type text] Declaration I confirmthat this Report truly represent my work undertaken as a part of my course. This work is not a replication of work done previously by any other person. I also confirm that the contents of the Report and the views contained therein have been discussed and deliberated with the Mentor. Place: Bangalore XYZ Date: 15-01-2019 Sikkim Manipal University
  • 3.
    [Type text] Contents Chapter DescriptionPage No. 1 Introduction 2 2 Research Methodology 15 Statement of problem Data collection Sample size. 3 Company Profile 22 4 Data Analysis & Interpretation 25 5 Findings, Suggestion & Conclusion 40 Bibliography 42
  • 4.
    [Type text] Chapter 1Introduction 1.1 Executive Summary 1.2 Introduction 1.3 Growth engine of economy 1.4 Real Estate 1.5 Indian Real Estate Industry 1.6 Fundamental factors determining the value of real estate 1.6.1 Demand 1.6.2 Supply 1.7 Demand and Supply Constraints 1.8 Affordable Housing 1.9 Demand and supply constraints in India
  • 5.
    [Type text] Executive Summary: TheIndian residential real estate market witnessed an unprecedented boom from 2002-2007. However, the economic downturn of 2008 had a severe impact on the industry. The overall response to this recession has been characterised by a clear movement from projects targeting the premium segment to those catering to middle and low income segments of the economy. An important driver of this movement has been the recently announced government policies including interest rate rebates and the fiscal stimulus towards urban development. The established players moved down the customer chain, offering housing units in the range of Rs. 15-25 lakh. However, there has been an emergence of a whole new set of players who have launched projects in the range of Rs. 3-7 lakh targeting the “bottom-of-pyramid” low income segment. The strategy of these low cost housing developers is fundamentally different from the traditional industry. This report identifies three operational essentials – treating land as inventory, partnering with different financial institutions for customer financing, and innovating through construction technology – which are at the core of the operational strategies being adopted by these players. Another important aspect to understand is the broader business frameworks that players in this segment need to adopt. The two most prevalent frameworks are the Public Private Partnerships (PPP) and cross-subsidisation. This clearly shows that it may be still some time before one can see free market mechanisms operating in low cost housing. Low cost housing is a young market segment and may very well turn out to be an inflection point in the real estate industry. However, its future depends a lot on the way government regulations shape up. Some of the major barriers that need to be addressed include availability of cheap land around urban areas, the restrictions on Floor Space Index (FSI) and the availability of housing finance for prospective buyers.
  • 6.
    [Type text] Introduction: Home buyersface challenges while deciding “when” to purchase houses. While favourable economic conditions lead to higher incomes for home buyers, it also leads to spiralling real estate prices making it difficult for a buyer to purchase homes even during their higher incomes. On the other hand, during economic downturns while real estate prices decline, people become sceptical about their incomes and adopt a more cautious approach to purchase. Affordable housing may be a good strategy to this home-buyers dilemma and can help ensure housing across different sections of society. Growth engine of economy: Real estate plays a crucial role in the Indian economy. It is the second largest employer after agriculture and is slated to grow at 30% over the next decade. The Indian real estate market size is expected to touch $180 billion by 2020. The housing sector alone contributes to 5-6% of the country’s GDP. Retail, hospitality and commercial real estate are also growing significantly, providing the much-needed infrastructure for India’s growing needs. According to a study by ICRA, the construction industry ranks 3rd among the 14 major sectors in terms of direct, indirect and induced effects in all sectors of the economy. A unit increase in construction expenditure generates five times the income, having a multiplier effect across the board. With backward and forward linkages to over 250 ancillary industries, the positive effects of real estate growth spread far and wide. Truly, real estate is a growth engine for India’s economy. Real Estate: Real estate or immovable property is a legal term (in some jurisdictions) that encompasses land along with anything permanently affixed to the land, such as buildings. Real estate is often considered synonymous with real property (also sometimes called reality), in contrast with personal property (also called personality). However, in technical terms, real estate refers to the land and fixtures themselves and real property are used primarily in over real estate. The term real estate and real property are used primarily in common law, while civil law jurisdiction refers instead to immovable property. In law, the word real means relating to a thing as distinguished from a person. Thus the law broadly distinguishes between real
  • 7.
    [Type text] property (landand anything affixed to it) and personal property (everything else e.g. clothing, furniture, money). Real Estate Business Includes: With the development of private property ownership, real estate has become a major area of business. Purchasing real estate requires a significant investment and each parcel of land has unique characteristics, so real estate industry has evolved into several distinct fields. Some kind of real estate businesses include- • Appraisal – Professional valuation services • Brokerage – Assisting buyers and sellers in transactions • Development – Improving land for use by adding or replacing buildings • Property Management – Managing a property for its owner(s) • Real Estate Marketing – Managing the sale side of the property business • Relocation Services – Relocating people or business to difficult country Types of Ownership Interests: Real property (immovable property) can refer to the real estate itself or to various types of ownership interests in real estate, including: • Freehold: Provides the owner the right to use the real estate for any lawful purpose and sell when and to whom the owner wishes. • Life estate: An interest in real estate which is granted to a life tenant until that person dies. The interest terminates upon the death of the life tenant. • Estate for years: Similar to life estate but term are a specified number of years. • Leasehold: The right to posses and use real estate pursuant to the terms of a use. • Reversion: The right to posses the free interest in real estate after the expiration of a life estate, estate for years or leasehold. • Concurrent or co-tenancy: The ownership of an interest in real property by more than one party. Rights of any single party may be limited in various ways depending on the jurisdiction and type of concurrency. Participants of Real Estate Market: The main participants in the real estate markets are Owner/User: These people are both owners and tenants. They purchase houses or commercial property as an investment and also to live in or utilize as a business.
  • 8.
    [Type text] Owner: Thesepeople are pure investors. They do not consume but rent out or lease the property to someone else. Renter: These people are pure consumers. Developers: These people prepare raw land for building which results in new product or the market. Renovators: These people supply refurbished buildings to the market. Facilitators: This includes banks, real estate grocers, lawyers and others that facilitate the purchase and sale of real estate. The owner/user, owner and renter comprise the demand side of the market, while the developers and renovators constitute the supply side. In order to apply the simple demand and supply analysis to real estate markets a number of modifications need to be made to standard microeconomic assumptions and procedures. Real estate can divided into three categories: These are • Commercial • Residential • Agricultural We can invest into all the given areas and can make return by capital appreciation, rental income, agricultural produce, lease and commercial use. The following factors influence the price and cost of the real estate: 1. The physical characteristics of the property 2. The property rights 3. The time horizon of holding the property 4. Geographical area 5. The development rate Features of Real Estate Markets: In particular, the unique features of the real estate market must be accommodated. These include: • Durability • Heterogeneous • High transaction costs
  • 9.
    [Type text] • Longtime delays • Both an investment good and consumption good • Immobility Indian Real Estate Industry: The Indian real estate sector plays an important role in the country’s economy. Nearly five percent of the country’s GDP is contributed by the real estate sector. It is comprised of two main categories – residential (80% of real estate space) and commercial (20%). This report primarily focuses on the residential category. Some of the prominent players in this space include Tata Housing, DLF and Unitech. This sector had seen an unprecedented boom in the last decade. It has witnessed some of the biggest IPOs such as DLF (~Rs 9,600 crore) (DLF sets IPO, 2007) and Unitech (~$360 million through LSE IPO) (Unitech LSE IPO, 2006). During the first five years of the just concluded decade, Indian residential real estate prices had nearly doubled. The residential prices continued to rise at an average increase of 16% year-on-year which was well above the average increase in income until 2008. This growth was fuelled by India’s 8-9% GDP growth, low interest rates and opening up of real estate for Foreign Direct Investment (FDI) in 2005. Much of the growth in the real estate market was due to the premium customer segment which viewed real estate housing as an asset for investment. A growing economy, increasing remittances to India, low interest rates and excessive liquidity in both Indian and global markets, strong investor sentiment and rising real estate prices were some of the factors that made housing investment lucrative. Fundamental factors determining the value of real estate These factors includes Demand Demand refers to people’s willingness and ability to buy or rent a given property. In part demand stems from a market area’s base. In most real estate markets, the source of buying power comes from jobs. Property values follow an upward path when employment is increasing. The real estate market in India has seen remarkable changes in the past few years. The rapid expansions of information technology, especially BPOs, spurt in the middle class income and 8% growth in GDP are the potential key factors for the growth. India is the 4th
  • 10.
    [Type text] largest economyin the world, and has the 2nd highest GDP among the developing countries based on purchasing power parity. IT and IT enable services sector in India is still in its growing stage due to increasing demand for business processing units in India and is estimated to grow by 107% to $583 million in revenue. This could lead to a space requirement of 20-25 million sq. ft. per annum, according to a Merrill Lynch report. Taking this factor into consideration, the Total value of real estate created by the IT and ITES sector in the next three years will be Rs.1,32,000 crore. Supply Analysis Supply analysis means sizing up the competition. Nobody wants to pay more for a property than the price they can pay for competing property. An integral part of value analysis requires identifying sources of potential competition and then inventorying them by price and features. An analysis of supply should not limit potential competitors to geographically and physically similar properties. In some markets, for example, low priced single family houses might compete with condominium units, manufactured homes and even with rental apartments. Demand and Supply Constraints: The demand drivers for affordable housing are as below: Urbanization: Urbanization is an index of transformation from traditional rural economies to modern industrial one. India’s urban population is increasing at a faster rate than its total population. At 28 percent, the pace of urbanization in India has been slower than average pace of urbanization in Asia. However, the absolute number of people in urban cities and towns has gone up substantially. In India, urbanization can be described as a product of demographic explosion and poverty included rural-urban migration. This situation has resulted in pressure on urban infrastructure and in an increase in the number of homeless people living on the streets. As per the 2001 census the total urban homeless population was 7,78,599 people, which would be much more currently given the inadequate availability of affordable / low-cost housing. Rising income levels leading to a sizeable middle class segment. The past few years have been tremendous economic growth in the country and one of the implementation of one of
  • 11.
    [Type text] the mostsuccessful anti-poverty programmes in the country’s history. While 93 percent of the total population in 1985 was under deprived category, this declined to 54 percent of total population in 2005 and is expected to further decline to 22 percent by 2025. The economic growth is also expected to dramatically change India’s income pyramid by creating a sizeable layer of middle class. This middle class segment is expected to be the primary driver for affordable housing. India income class and population dynamics – Moving towards a sizeable middle class Source: The “Bird of Gold”: The Rise of Indian Consumer Market, 2007 Financing of Housing Loans • Most of the clients of Housing Finance Institutions/banks under retail home loans belong to MIG/HIG categories and housing loan finance still remains unaffordable in a large way to the EWS/LIG sections. • Only 0.2% of housing loans extended by HFCs are of value less than Rs 50000 and about 7% of housing loans is of value between Rs 50000–100000. • More than 73% of housing loans extended by HFCs is of value exceeding Rs 3 lakh and about 93% of value exceeding Rs 1 lakh. • The fastest growing housing value bracket is between Rs 10 lakh to Rs 25 lakh. • This highlights the need to evolve a system or a scheme for financing housing loans on a large scale for the lower income groups whose affordability for housing loans falls in the
  • 12.
    [Type text] range belowRs 3 lakh, as over 90% of the housing shortage is on account of EWS/LIG. multiple counting and resale of properties, in the sense that cross-funding/bulk borrowing is involved among the various institutions. It is, therefore, assumed that the net flow of funds to the housing sector from formal sector institutions would be 50% of the gross flow of funds for construction of new houses. This comes to approximately Rs 2.90 lakh crore, which is 80% of the total investment requirements for urban housing for the Eleventh Plan. Affordable Housing: Affordable Housing as a concept is very generic and could have different meanings for different people based on differences in income levels. It refers to any housing that meets some low cost criterion. Different countries have defined affordable housing to present the economic potential of an individual buying a house. Defining affordable housing in India is a difficult task giving that at every square kilometre of the country, the dynamics of the market are different. At KPMG and The Confederation of Real Estate Developers' Associations of India (CREDAI), we have therefore broadly defined affordable housing in India for Tier I, II and III cities based on two key parameters: 1 Income Level 2 Size of Dweeling Unit EWS* <INR 1.5 lacs per annum Upto 300 sq.ft LIG** 1.5 to 3 lacs per annum 300 to 600 sq.ft MIG*** INR 3 to 10 lacs per annum 600 to 1200 sq.ft *Economically Weaker Sections **Lower Income Group ***Higher Income Group Source KPMG Analysis Affordable housing can be defined using two key parameters viz. income level and size of dwelling unit. These parameters are independent of each other. While the above definition is a generic representation at an all India level, the actual definition of affordable housing may vary with regions and income levels. Affordable and low-cost housing are often interchangeably used, but are quite different from each other. Low-cost housing is generally meant for EWS category and comprises bare minimum housing facilities while affordable housing is mostly meant for LIG and MIG and includes basic amenities like school, hospitals and other community facilities and services.
  • 13.
    [Type text] Parameters Low-CostHousing Affordable Housing Amenities Bare minimum to none Basic Target Income Class EWS & LIG LIG & MIG Size of Dwelling Unit <=300 sq.ft 300-1200 sq.ft Location Generally with in city but can also be located on city peripheries due to high cost of land Within city Project Developer Mostly Government agencies Private Developers and Government Moostly available source of finance Micro finance institutions Traditional banking system EMI to Monthly Income Not exceeding 30% of gross monthly income Not exceeding 40% of gross monthly income Source: KPMG Analysis So what has led to the sudden spurt in affordable / low-cost housing/ While the real estate industry across developed countries went through one of its worst downturns, the Indian real estate industry, which was considered “shock-proof”, was also badly hit. The tremors of the global liquidity crises led to price corrections in the domestic real estate industry leaving developers with land parcels acquired at peak prices and with considerable stress on their balance sheet. Source: Report on India Strategy, Motilal Oswal, 30th Sep 2009
  • 14.
    [Type text] Source: Bloomberg TheIndian economy witnessed a gradual deceleration in its growth post March 2008 till March 2009 with a similar impact on the money supply (M3) growth. This led to some serious funding problems for real estate developers as traditional banking channels became more cautious in providing credit and consumer demand witnessed a slump due to the uncertain economic environment. Indicative size and potential of Affordable Housing in India Housing Category Income Class (INR Million p.a) No. of Households- 2009-10 (Million) YoY Growth (%) Value of House (INR Million) Avg. Apartment Size (sq.ft) Low Income 0.2 - 0.5 8.3 8.2 1 - 2 400 - 800 Mid Income 0.5 - 1.0 3.5 17.6 2 - 4 800 - 1000 Higher Mid Income 1.0 - 2.0 2.2 21.5 3.5 - 8 1000 - 1300 High Income 2.0 - 5.0 0.9 22.9 7.5 - 20 1250 - 1750 Luxuary 5.0 + 0.4 26.6 20 + 2500 + Tier I, II and III demand estimation (by number of households) • Nearly 12 million households (owned / rented) in the INR 0.2 – 1.0 million per annum category, 4 – 5 million of these are in urban areas assuming 34 – 40 percent urbanization rate • 2.1 million houses required in seven major cities alone for LIG and MIG population • This translates into a potential opportunity of close to INR 3 trillion • Including the EWS category, this number more than doubles to INR 7.5 trillion Source: KPMG Analysis
  • 15.
    [Type text] The realestate business in India underwent considerable changes post the global liquidity crisis. Prior to the crisis, developers bought land with part payment and launched projects; this meant regular cash flows from upfront payments was required to fund chain of projects. The developers continued with this practice and acquired huge land parcels by leveraging their balance sheets. With the liquidity crisis, availability of construction finance became a challenge and muted consumer demand meant very little upfront payments due to concerns on timely project completion, thereby affecting regular cash inflows for developers. All these factors resulted in developers resorting to alternative revenue generation strategies such as stake sale, sale of non-core assets and even freebie offers like cars, gold medallions etc. To improve the cash flows further many developers across India reduced property prices on an average by 20-30 percent. The correction in prices was a boon for people who wanted to purchase houses for a long time but could not earlier due to steep property prices and high costs of finance. It is interesting to note this section of the population is actually willing to pay and make necessary sacrifices for owning a home even in present economic scenario. Past Present Acquire land with part payment Acquired land with part payment Start construction, avail construction finance Launch of projects, collection of customer advances, and payment of land dues Use surplus funds as down payment for additional land Deleveraging, stake sale to private equity at distress valuations Deferment of project launches Developer stuck with high leverage Construction finance not readily available Weak launches with muted response
  • 16.
    [Type text] Demand driversand supply constraints for affordable housing in India The key supply constraints for affordable housing are as follows: Availability of land: One of the biggest questions that India needs to answer going forward is with respect to adequate supply of land for housing purpose. The Government’s vision of “affordable Housing for All” will require acquisition / supply of large land parcels on a regular basis. As per 2001 census, the country’s urban land mass (2.4 percent of total land mass) houses approximately 28 percent of the country’s population, excluding people who live on the streets. According to calculations made by the Town and Country Planning Organization (TCPO), to cater to the demand of EWS and LIG category alone would require 84,724 to 1,20,882 hectares of additional land. Land Cost: Land cost is another crucial factor affecting supply of land. Given limited availability of land in urban areas, it becomes unavailable for developers to provide affordable housing without Government support. On the other hand, the Government holds substantial amount of urban land and ownership of port trusts, the Railways, the Ministry of Defence, land acquired under the Urban Land (Ceiling and Regulation) Act, the Airports Authority of India and other government departments. Financial and Regulatory Support: Financial and regulatory constraints have plagued the housing sector in India. Current financing mechanism prevalent in the country mostly targets MIG and HIG sections of the society while the households falling under LIG and EWS category find it difficult to secure formal housing finance. Commercial banks and traditional means of housing finance typically do not serve low-income groups, whose income may be vary with crop seasons, or below the ‘viable’ threshold to ensure repayment, or who cannot provide collateral for loans. Microfinance institutions are considered to be the next best
  • 17.
    [Type text] alternative tofor financing the EWS and LIG category. However, there are challenges faced by microfinance institutions which prevent them from extending housing loans. Challenges faced are primarily due to the longer period of housing loans (typically between five to seven years minimum, if not more) and due to the larger amount of loan compared to typical loans extended by MFs. Typically, a house, particularly in urban areas, will be about INR 1 lakh, whereas when microfinance institutions give for livelihood financing, they give INR 10,000 to maximum INR 35,000. If they have to lend to a significant numbers of people, the amount to be loaned goes into crores of rupees which can be a problem for microfinance institutions. Another problem with microfinance institutions is of refinance. While National Housing Bank (NBH) provides refinancing facility, interest rates are not fixed but reviewed periodically. Lack of developed debt market places considerable challenges for microfinance companies depriving them of long-term affordable money and what they currently have is a maximum of three to four year money available at a cost of 15- 17 percent, making it difficult o lend for mortgages. Even if they are willing, the rate will be some 18-19 percent which, while it may be way cheaper than what a money lender would ask for, doesn’t really help the cause. According to CREDAI, real estate also faces multiplicity of taxes at different points of housing transactions and average to a little over 25 percent of the property rate. As per 2001 census, the country’s urban land mass (2.4 percent of total land mass) houses approximately 28 percent of the country’s population, excluding people who live on the streets Commercial banks and traditional means of housing finance typically do not serve low income groups Lack of developed debt places considerable challenges for microfinance companies depriving them of long- term affordable money and what they currently have is a maximum of three to four year money available at a cost of 15- 17 percent
  • 18.
    [Type text] Chapter 2Research Methodology 2.1 Objective of the study 2.2 Title of the study 2.3 Statement of the problem 2.4 Scope of the study 2.5 Research Methodology 2.5.1 Market Research 2.5.2 Methodology 2.5.3 Research Approach 2.5.4 Research Design 2.6 Questionnarie
  • 19.
    [Type text] Objectives ofthe study: 1. Understand the business model. 2. Understand the concept of Affordable Housing. 3. Understand the techniques and ways to develop Affordable Housing. 4. To find out the different parameters that affects the demand for affordable housing in Jaipur. 5. Learn to efficiently select different parameters. 6. Establish the scope for construction of affordable housing. Title of the study: The title of my study is “Demand for Affordable Housing In Jaipur”. Statement of the problem: In the process of study, the first and foremost step happens to be that of selecting and properly defining the subject. To start any new business it is necessary to find the total cash inflow needed and the revenue that will be generated overtime. Other important information that an investor needs to know before making an investment in any project is when it will reach its breakeven point. Only when the investor is aware of all the above information that he can make the informed decisions. So the problem selected is “To find if there is demand for affordable housing projects in Jaipur”. Scope of the study: The study on the demand for construction of affordable housing covers multiple avenues of learning. 1. It then deals with the budget estimates of the project i.e. the cost of the project. 2. It also estimates the quantity of the apartments to be produced for a predefined amount of sales generation.
  • 20.
    [Type text] 3. Itcovers estimated cash inflow, working capital requirement, profitability statement and projected balance sheet. Research Methodology: Market Research Marketing research has become most important tool for decision making in the field of finance due to the following reasons. • Business environment is changes very rapidly which needs to continuous modification and improvement. • It provides correct and reliable information about customer, competitors and one’s own activities to the manager, so that the huge amount spent on marketing activities to be utilized properly. • Since modern business is customer oriented, it (MR) provides the producer a systematic and analytical approach based on assessment on customer requirements, which helps the producer in maximization of net profit by producing such products that fulfill the customer’s utmost level of satisfaction. Thus, the study is a systematic gathering, recording and analysis of data about the problem facing the company. It helps the marketing manager to develop and analyze new information, which is further helpful in developing marketing strategy. Now it can be said that marketing research covers a very wide variety of activities ranging from analysis of financial potential and market share to studies of customers satisfaction and purchase intention. Methodology: The data for the study has been collected from both the primary source and the secondary source. Primary source: In case of the above study primary source of data was collected with the survey done by using a suitable questionnaire. The primary data includes the data collected from different parts of Jaipur city. On geographical basis city is divided into five zones i.e. north, south, east, west and central. A total of 125 households were interviewed in order to know the demand for housing in general and analysing them on the basis of their affordability. Secondary source: These data are generally the data which support the primary data and hold an important position in the analysis of the study. The secondary data includes information from the
  • 21.
    [Type text] internet, CREDAI,and documents from Purvanchal Group. To get more idea and information related to the real estate industry, various journals and websites were used. Research Approach: Quantitative approach i.e. use of statistical tools for quantifying the data and analyzing the data pattern. The basic needs of any research are data and method of collecting it. Data is an information on the basis of which inference are drawn, therefore, data become a very important and vital factor in research study. The main purpose behind framing a methodology is to desirable the research procedure which includes data sources, data collection method, research instructions. DATA COLLECTION METHOD The following method is widely used for collecting data. Contact Methods: The respondents were contacted directly (Personal Interviewing). It is the most versatile method. The interview was of intercept type in which respondents were asked to answer the questions on the spot. For this purpose questionnaires were prepared in such that all necessary data would be collected. Sample Description: Sample size: 125 Sampling Frame: Jaipur Sampling Elements: Households
  • 22.
    [Type text] QUESTIONNAIRE ONAFFORDABLE HOUSING IN JAIPUR Dear Sir/Madam I am a student of SIKKIM MANIPAL UNIVERSITY. As a part of my research study I am conducting a survey regarding the demand for affordable housing in Jaipur. The purpose of this questionnaire is to provide supporting evidence for: a) Applicants submitting planning applications for any form of affordable housing. b) Determining the eligibility of successive households to occupy an existing affordable dwelling 1. Name, gender and age group of all household members (including children) to occupy the dwelling Household member Name Male/Female 0-15 16-24 25-60 60+ 1 2 3 4 5 6 7 8 Age Group 2. Present address of all applicants listed in Question 1 3. Contact name and phone number 4. What is your current form of tenure? (Please tick)
  • 23.
    [Type text] Owners Rental Others 5. Doyou want to shift from your current dwelling as an owner? Least Interested Disinterested Neutral Interested Very interested 6. If yes, then what type of accommodation would you prefer? Self owned Rented Others 7. If you rent a property, how much per month is your household able to pay? (Please tick) <3000 3000 - 5000 5000 - 10000 10000 - 15000 15000 - 20000 >20000 8. If buying a property, how much in monthly mortgage payment is your household able to pay? (Please tick) . 7000 - 12000 12000 - 16000 16000 - 20000 20000 - 25000 25000 - 30000 >30000 9. What type of accommodation is required / proposed? (Please tick)
  • 24.
    [Type text] Supported /sheltered housing Flat Detached House Semi-detached house Terraced house Bungalow Other 10. How long have you lived at your present address? Years Months 11. What is the households’ total annual gross income? (Please tick) <180000 180000 - 215000 215000 - 250000 250000 - 350000 350000 - 450000 450000 - 600000 >600000 12. Does your household require separate accommodation for existing residents within your household? Yes No 13. Do you or any other household members already have a mortgage, own a property or have you recently sold a property? Yes No 14. Name the locality or settlement area you want to live in 15. Why is the above location preferred? 16. How many bedrooms do you require / wish to build? (Please tick) 1 2 3 4 5
  • 25.
    [Type text] 17. Ifyou have a specific site or property which you would like to occupy in mind, please give the site / property name and address below: 18. Further comments / additional information Chapter 3 Company Profile 3.1 Company Overview 3.2 Company’s Excellence in Construction 3.3 Capabilities 3.4 Certificates
  • 26.
    [Type text] Company Profile: Establishedin 1994, Purvanchal Group is one of the leading real estate development and construction company in Delhi & NCR. Construction business is one area that has seen geometrical growth in the recent past where several new players have entered the market. Amongst the established and reliable names, Purvanchal Group stands proud with years of experience in serving clients throughout the nation. Company Overview: Purvanchal Group started construction in Delhi 1994 and rapidly rose to be a premier construction company due to its uncompromising commitment to the highest level of quality construction as well as its consistency in delivery schedules. Several years standing in the construction business paved way for the Purvanchal Group. It is a renowned real estate building construction company in Delhi & NCR. Purvanchal Group the leading real estate company in Delhi & NCR an ISO 9001-2008 certification has got for their brand “Purvanchal” which stands for quality, commitment and value for money. The Purvanchal Group has always completed to achieve a goal of 100% satisfied customer base. Our purpose is to plan and construct large scale state of the art housing complexes and undertake real estate development, translating into the very best in terms of comfort, durability, security, luxury and style. It is dedicated to deliver the finest large scale complexes and home at par with global standard for the customer. Within a decade it has grown from a turnover of INR 0.88 crore to approx 200 crore. This is a counterpart of its growing strength and competitor in the industry.
  • 27.
    [Type text] Company’s Excellencein Construction: With an excellent track record of delivering numerous housing projects of the highest quality, it has been consistent in its performance. Purvanchal Group style of construction is instantly distinguished for its most modern, state-of-the art design, inclusion of luxurious amenities, excellent planning of usable space, and finished interiors. Its achievements are demonstrated by their highly successful projects - some of them are completed while others are under construction or nearing to completion. As a mark of excellence, our clients have invested more than INR 500 crore in the past decade in housing projects. Most of the development took place in the areas of New Delhi, Noida& Greater Noida through Purvanchal Group. Since their inception, it has delivered over three thousand five hundred flats in various housing complexes. It’s Capabilities: With strategic focus on each department, it has developed wide expertise and strengths in the sector of mass housing. It has the capability to incorporate the complexities, comforts as well as the convenience in their world-class multiplex housing projects. From three-storied apartments to multi-storeyed, it can design and develop projects of every size and complexity. Its strong capabilities are reflected in the 50 projects that it has completed in and around Delhi. Certificates: Company has acquired the ISO 9001: 2008 on 20th march, 2009 and all our construction and project related activities conform to the ISO standards.
  • 28.
    [Type text] Chapter 4Data Analysis and Interpretation 1.1 Analysis and Interpretation 1.2 Stakeholder’s Perspective - Key initiatives and concerns 1.3 Stakeholders Concern 1.4 Role of PPP in Affordable Housing 1.5 Hypothesis Testing 1.6 SPSS Analysis
  • 29.
    [Type text] Analysis andInterpretation: The analysis includes estimation of the demand for the affordable housing, current form of household tenure, their ability to spend on rent and EMI and also to know total cost of the project, estimation of various expenses, finding cost of capital, revenues streams, estimation of working capital requirement, expected cash inflows and finding breakeven point. Interpretations are made by observing the data analyzed. Based on the projections made, it can be recommended to invest in developing affordable housing and go ahead with it. It is because there is great demand of the product in the market which will generate adequate cash inflows.
  • 30.
    [Type text] Stakeholder’s Perspective- Key initiatives and concerns: For the purpose of our study we will consider three stakeholders viz. government, Real Estate Development and Financial Institutions. Key initiatives: Government Real Estate Developers Financial Institutions Interest Rate Subsidy • One percent subsidy on loan up to INR one million for purchase of house costing less than INR two million FSI (Floor Space Index) • Harayana and Tamil Nadu Government have announced increase in FSI for housing projects targeting lower and middle income groups • Tamil Nadu has announced 50 percent extra FSI for projects targeting EWS in Chennai Metropolitan Area(CMA) • Tamil Nadu has further announced 30 percent extra FSI for projects targeting MIG Resumption of 80 IB • Profits from housing projects approved between April 01, 2007 and March 31, 2008 will be tax free if they are completed by March 31, 2012 PPP Measure
  • 31.
    [Type text] • EWSrental projects at Virar, Mumbai by MMRDA(Mumbai Metropolitan Regional Development Authority) and HDIL(Housing Development and Infrastructure Limited); Bengal Ambuja Housing Project • Modification in JNNURM(Jawaharlal Nehru Urban Renewal Mission) to encourage affordable housing on PPP(Public Private Partnership) basis Policies • Launch of Rajiv Awas Yojana to promote slum free India Government Real Estate Developers Financial Institutions • Private developers have been aggressively pursuing affordable housing post the economic slump of 2008 • Developers have realized the opportunity and need of affordable housing and have taken several steps to tap the same • Developers have on an average reduced the prices by 30 percent in last one year and are willing to operate at a lower margins • Players like Tata Housing, DLF, Unitech, etc. have multi-city, plan • India plans of developing 10,000-15,000 units over next four years • Tata Housing has taken the lead by launching an affordable housing project in Boisar - Phase I will be allotted to LIG families – one room kitchen and one bed room hall kitchen(BHK) flats up to INR 0.7 million - Phase II to MIG families – 2/2 BHK apartments at INR 1.2 million and above Government Real Estate Developers Financial Institutions Banks and MFIs (Microfinance Institutions) are willing partners
  • 32.
    [Type text] • Banksare willing to fund suitable projects, provided that adequate checks are in place to monitor credit risk • MFIs have expressed interest in funding EWS dwelling units up to INR 0.5 million • Micro Housing Finance Corporation is an MFI that is exclusively focused on housing finance Stakeholders Concern:
  • 33.
    [Type text] * 'Ghettoization'ofmarginalpopulation * Speculative interest * Timely completion of projects * Delivery of flats to target segments without cost escalations * Diversion ofland / funds by developer * Volume off-take * Profitability * Availability of cheap land * Hassles in land acquisition * Delay due to regulatory approvals * Restrictive density norms * Access to low-cost funds * Government support to lower cost of capital * Credit risk * profitability Government Real Estate Developers Financial Institutions Source: (National Real Estate Development Council), KPMG Analysis Role of PPP in Affordable Housing PPP can be effectively used to address stakeholders concern
  • 34.
    [Type text] Effective useof available Government land • Land parcels currently in possession can be used for development, thereby reducing the cost of land • Government can enter into joint ventures with developers with land as equity Land Banking • Purchase of large stripes by State Governments / Agencies • Distribution of land to provide a cash less subsidy to builders Cross Subsidization • Joint development of MIG, LIG and EWS flats – MIG to Subsidize others • Built- up space covering LIG and EWS to be sold / rented by Government agency; developer can be allowed to sell MIG flats at market rates Redevelopment / Rehabilitation • Increasing availability of prime land by development / rehabilitation Single window approval for projects • Delays incurred in project approvals result in substantial cost overruns • A single window will help reduce delays and contain costs • Reduction in approval related costs Subsidizing construction costs • Reduction / exemption / deferment of taxes and duties on construction materials
  • 35.
    [Type text] • Subsidyto developers for R&D in new low cost materials and technologies • Subsidy to developer in view of employment generated • Lower cost of borrowing for development of affordable housing projects – can be achieved if government agencies have a participatory interest in the project and guarantee the loans Sales Tax and Stamp Duty • Exemption from sales tax and reduction in stamp duty Development of urban infrastructure • PPP projects for accelerated urban infrastructure - Metro rail, Inter-city highways, Mono rail • Increase budgetary focus on urban infrastructure • Increase support to State Governments to engage in PPP projects Integrated Townships • Joint developers with private players • Development of infrastructure and residential space • Planned expansion of city limits Development of Satellite Towns • Upfront infrastructure development around major cities a pre-requisite for planned development of satellite towns • Mumbai and NCR have successfully developed satellite towns, which other cities can emulate
  • 36.
    [Type text] Access tolower cost of capital • Relaxation of ECB norms for housing companies • Increase in income tax ceiling on housing loans will reduce post tax cost of capital for borrowed • Increase support to State Governments to engage in PPP projects Housing as a priority sector • Increase current limits in interest subsidies from INR 2 million to INR 4 million Profitability of developers and housing finance companies • 80 IB benefits for all approved affordable housing projects and developers • Extension of 80 IB benefits for housing finance companies lending to LIG and EWS lenders Special focus on EWS segment • Significantly higher Government involvement and subsidiaries are required to provide equitable housing for EWS segment • Innovative cross-subsidization schemes, extensive subsidies and suitable credit delivery mechanisms needed to address the specific challenges of EWS segment
  • 37.
    [Type text] Current formof tenure: Interpretation: 40% of the respondents belong to the rental and others category. So there is a high probability that they would be interested in buying a residential property. Also some of the respondents belonging to the owner’s category have shown their interest in buying a new residential property. Demand for housing in Jaipur:
  • 38.
    [Type text] Interpretation: 64 %of the respondents have shown positive interest in buying residential property. Demand for housing: Interpretation: Maximum number of repondents are interested in buying a property rather than stayin in a rental accomodation.
  • 39.
    [Type text] How muchrent households willing to pay: Interpretation: Maximum percentage of the respondents dont prefer to indulge in paying anything above Rs. 5000 as rent. It shows that most of the respondents are looking for low or moderate standard accomodation. How much EMI households willing to pay per month:
  • 40.
    [Type text] Interpretation: Most ofthe respondents fall under the bracket of Rs. 12000 to 16000 EMI per month which signifies the value of property people are interested in, is in direct relation to the EMI they can afford. Households annual income: Hypothesis testing: Null hypothesis (H ):ѳ Most households in Jaipur do not want to buy a residential property Alternate Hypothesis (Hα): Most households in Jaipur want to buy a residential property H ≥3ѳ Hα≤3 Level of Significance (α) = 0.05 Sample Size (n) = 125 Based on data collected: µ (Mean) = 3.712 Standard Deviation (σ) = 15.273 By substituting value and calculating Z z is given by z = [x - µ] / σ
  • 41.
    [Type text] By substitutingvalues and calculating, Z = 0.046 Level of significance = 0.05 P=0.016 α=0.05 p<0.05 Hence, reject null hypothesis Inference: Reject Null Hypothesis as the Z(Calculated) is less than (Z) observed. Thus it’s proved that the households want to buy a residential property.
  • 42.
    [Type text] SPSS Analysis Correlations current_tenureshift rent_pay EMI annual_income current_tenure Pearson Correlation 1 .920** .761** .813** .800** Sig. (2-tailed) .000 .000 .000 .000 N 125 125 125 125 125 shift Pearson Correlation .920** 1 .772** .746** .750** Sig. (2-tailed) .000 .000 .000 .000 N 125 125 125 125 125 rent_pay Pearson Correlation .761** .772** 1 .822** .884** Sig. (2-tailed) .000 .000 .000 .000 N 125 125 125 125 125 EMI Pearson Correlation .813** .746** .822** 1 .922** Sig. (2-tailed) .000 .000 .000 .000 N 125 125 125 125 125 annual_income Pearson Correlation .800** .750** .884** .922** 1 Sig. (2-tailed) .000 .000 .000 .000 N 125 125 125 125 125 **. Correlation is significant at the 0.01 level (2-tailed). Model Summary Model R R Square Adjusted R Square Std. Error of the Estimate 1 .931a .866 .862 .179 a. Predictors: (Constant), annual_income, current_tenure, rent_pay, EMI
  • 43.
    [Type text] Coefficientsa Model Unstandardized Coefficients Standardized Coefficients tSig.B Std. Error Beta 1 (Constant) .297 .045 6.558 .000 current_tenure .651 .045 .864 14.401 .000 rent_pay .132 .034 .287 3.940 .000 EMI -.049 .052 -.087 -.950 .344 annual_income -.035 .032 -.115 -1.095 .276 a. Dependent Variable: shift Case Processing Summary N % Cases Valid 30 24.0 Excludeda 95 76.0 Total 125 100.0 a. Listwise deletion based on all variables in the procedure. Item Statistics Mean Std. Deviation N current_tenure 1.00 .000 30 shift 5.00 .000 30 rent_pay 1.60 .498 30 EMI 1.00 .000 30 annual_income 1.77 .728 30
  • 44.
    [Type text] Coefficientsa Model Unstandardized Coefficients Standardized Coefficients tSig.B Std. Error Beta 1 (Constant) 7.338 .163 45.086 .000 annual_income -.126 .116 -.128 -1.081 .282 rent_pay -.655 .119 -.445 -5.510 .000 EMI -.691 .176 -.381 -3.920 .000 a. Dependent Variable: shift
  • 45.
    [Type text] Chapter 5Findings, Suggestions and Conclusion PATH AHEAD • Enhance capacity building in the construction sector by improving productivity through introduction of efficient technologies and modern management techniques. • Reduce transactional costs by reviewing contract procedures and dispute resolution mechanisms. • Enhance quality standards and provision of adequate institutional finance to the construction sector. • Accord greater importance to safety in construction activities by establishing trained and certified Safety Management Teams. • Earmark funds in the field of R&D for identification of appropriate and alternate materials to reduce the cost of construction. The three operational essentials identified above for pursuing affordable housing projects involve significant challenges. It is important for companies to align these three operational essentials with the overall organizational strategy and direction for succeeding in the long term. They must not view these affordable housing ventures as a just another investment opportunity. For example, financing with MFIs may conflict with existing long term agreements with banks. Also, most responses that have been observed so far did not involve established players in real estate sector such as DLF and Unitech. It is not clear if this is a wait-and-watch strategy or if they really do not have plans for this segment. It may be possible that the operating structure being pursued by the low cost housing players will be difficult to straddle for these established players. In other words, the business practices, operating model and cost structures of low cost housing players might be difficult to emulate for the established players. How their response will shape up will be an interesting phenomenon to be observed in the coming years. The reluctance of established players to enter affordable housing market may not imply the failure of market mechanisms in this segment. It may only imply that these companies have other, more profitable, avenues to invest in. Therefore, this does not preclude the entry of new players in this category. The strategy of new entrants like Reliance (Reliance to venture,
  • 46.
    [Type text] 2009) shouldalso be closely watched by analysts and it may very well define the industry trends in the coming years Two business frameworks – PPP & Cross Subsidization are prevalent in the given economic and social context. However, companies need not restrict to these two frameworks since given the large volumes of this market segment, purely free market approaches may also be viable. Treating land as inventory: The key barrier to affordable housing is the high cost of land acquisition. But proponents of low cost housing have come up with a radically different way of handling this problem. They have started treating land not as an asset but as inventory. In the traditional model, developers buy land, wait for it to appreciate, factor in the rising land prices into the final sale price and pass it on the end-customers. In low-income housing, land is just another input similar to construction costs. The developer needs to buy land for the specific project, build within 12–15 months and manage costs efficiently. This way the business becomes both scalable and profitable with IRRs comparable to higher end traditional projects. CONCLUSION: This low cost housing trend could be an inflection point in the real estate industry. One is tempted to compare it with the focus shift in the telecom industry in the middle of the last decade when Reliance Communications targeted the masses by cutting down both – the entry barriers in the market as well as the call rates. However, whether the industry becomes another success story like telecom or fails like the organized retail industry would hinge a lot on the regulatory framework. Supportive government policies addressing the barriers discussed above would be critical in ensuring that this strategy succeeds through free-market mechanics. Differentiating projects into different categories like affordable and non affordable is subjective and involves discretion of people involved.
  • 47.
    [Type text] Bibliography 1. InternationalResearch Journal of Finance and Economics - Issue 24 (2009) 2. Indian Economic Outlook 2010 3. Cuchman Wakefield 4. KPMG 5. Bloomberg 6. Indian Journal of Commerce & Management Studies 7. Purvanchal Group 8. CREDAI
