1
© Jerome Kehrli @ niceideas.ch
A proposed framework for
Agile Roadmap Design and Maintenance
2
1. An Agile Roadmap
3
We are not going to end up with this…
(I
am
not
saying
this
doesn’t
work,
but
it
definitely
doesn’t
work
for
us)
4

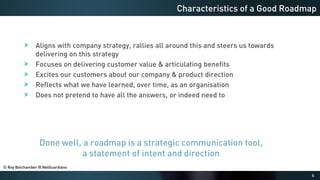

Aligns with company strategy, rallies all around this and steers us towards
delivering on this strategy
Focuses on delivering customer value & articulating benefits
Excites our customers about our company & product direction
Reflects what we have learned, over time, as an organisation
Does not pretend to have all the answers, or indeed need to
Characteristics of a Good Roadmap
Done well, a roadmap is a strategic communication tool,
a statement of intent and direction
© Roy Belchamber @ NetGuardians

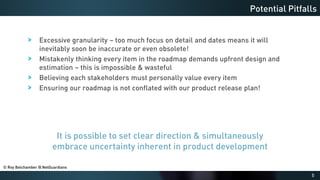

5
Excessive granularity – too much focus on detail and dates means it will
inevitably soon be inaccurate or even obsolete!
Mistakenly thinking every item in the roadmap demands upfront design and
estimation – this is impossible & wasteful
Believing each stakeholders must personally value every item
Ensuring our roadmap is not conflated with our product release plan!
Potential Pitfalls
It is possible to set clear direction & simultaneously
embrace uncertainty inherent in product development
© Roy Belchamber @ NetGuardians
6
The Roadmap as a Strategic Tool
Elements
Product Vision
Timeframes
Themes
Business Objectives
* Disclaimer
Focus on
outcomes
(strategic)
not on
outputs
(tactical)
A good roadmap starts
with a vision of where we
are going, guides us there
and explains the stops
along the way… Outcomes
Roadmap
Now Next Later
Backlog
Outputs
Backlog
Backlog
Backlog
Inspired from Roy Belchamber @ NetGuardians
7

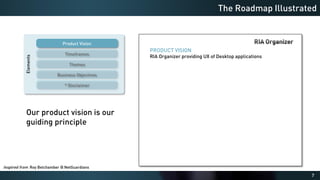

The Roadmap Illustrated
Elements
Product Vision
Timeframes
Themes
Business Objectives
* Disclaimer
PRODUCT VISION
RIA Organizer providing UX of Desktop applications
Our product vision is our
guiding principle
Inspired from Roy Belchamber @ NetGuardians

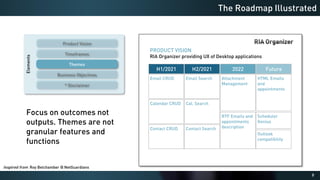

8
Elements
Business Objectives
Timeframes
The Roadmap Illustrated
Product Vision
Themes
* Disclaimer
PRODUCT VISION
RIA Organizer providing UX of Desktop applications
H1/2021 H2/2021 2022 Future
Broad timeframes avoid
overcommitment -
It is the sequence that
matters (now, next,
future)
Inspired from Roy Belchamber @ NetGuardians

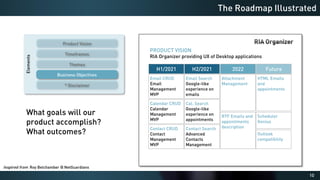

9
The Roadmap Illustrated
Elements
Product Vision
Timeframes
* Disclaimer
PRODUCT VISION
RIA Organizer providing UX of Desktop applications
H1/2021 H2/2021 2022 Future
Email CRUD
Focus on outcomes not
outputs. Themes are not
granular features and
functions
Email Search Attachment
Management
RTF Emails and
appointments
description
HTML Emails
and
appointments
Scheduler
Genius
Cal. Search
Contact Search
Contact CRUD
Calendar CRUD
Business Objectives
Themes
Outlook
compatibility
Inspired from Roy Belchamber @ NetGuardians
10
The Roadmap Illustrated
Elements
Product Vision
Timeframes
Themes
Business Objectives
* Disclaimer
PRODUCT VISION
RIA Organizer providing UX of Desktop applications
H1/2021 H2/2021 2022 Future
What goals will our
product accomplish?
What outcomes?
Email CRUD
Email
Management
MVP
Email Search
Google-like
experience on
emails
Cal. Search
Google-like
experience on
appointments
Contact Search
Advanced
Contacts
Management
Contact CRUD
Contact
Management
MVP
Calendar CRUD
Calendar
Management
MVP
Attachment
Management
RTF Emails and
appointments
description
HTML Emails
and
appointments
Scheduler
Genius
Outlook
compatibility
Inspired from Roy Belchamber @ NetGuardians

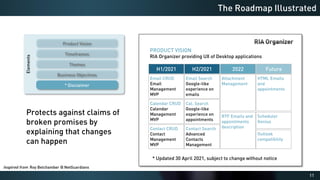

11
The Roadmap Illustrated
PRODUCT VISION
RIA Organizer providing UX of Desktop applications
H1/2021 H2/2021 2022 Future
Protects against claims of
broken promises by
explaining that changes
can happen
Email CRUD
Email
Management
MVP
Email Search
Google-like
experience on
emails
Cal. Search
Google-like
experience on
appointments
Contact Search
Advanced
Contacts
Management
Contact CRUD
Contact
Management
MVP
Calendar CRUD
Calendar
Management
MVP
Attachment
Management
RTF Emails and
appointments
description
HTML Emails
and
appointments
Scheduler
Genius
Outlook
compatibility
Elements
Product Vision
Timeframes
Themes
Business Objectives
* Disclaimer
* Updated 30 April 2021, subject to change without notice
Inspired from Roy Belchamber @ NetGuardians
12
R&D

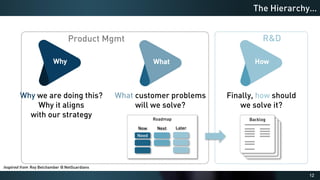

The Hierarchy…
What
Why How
Why we are doing this?
Why it aligns
with our strategy
What customer problems
will we solve?
Finally, how should
we solve it?
Roadmap
Now
Need
Next Later
Product Mgmt
Backlog
Backlog
Backlog
Inspired from Roy Belchamber @ NetGuardians
13
Let’s have a look at something more realistic
14

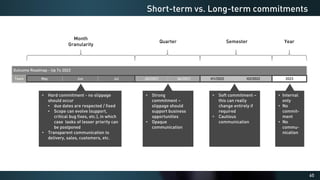

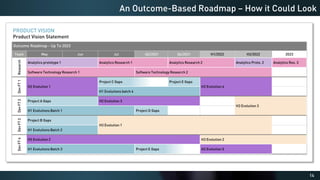

An Outcome-Based Roadmap – How it Could Look
PRODUCT VISION
Product Vision Statement
* Updated 30 April 2021, subject to change without notice
Outcome Roadmap - Up To 2023
Team May Jun Jul -Q3/2021 Q4/2021 H1/2022 H2/2022 2023
Research
Analytics prototype 1 Analytics Research 1 Analytics Research 2 Analytics Proto. 2 Analytics Res. 3
Software Technology Research 1 Software Technology Research 2
Dev
FT
1
H2 Evolution 1
Project C Gaps Project E Gaps
H2 Evolution 4
H1 Evolutions batch 4
Dev
FT
2
Project A Gaps H2 Evolution 3
H3 Evolution 3
H1 Evolutions Batch 1 Project D Gaps
Dev
FT
3
Project B Gaps
H3 Evolution 1
H1 Evolutions Batch 2
Dev
FT
4
H2 Evolution 2 H3 Evolution 2
H1 Evolutions Batch 3 Project E Gaps H2 Evolution 5
15

An Outcome-Based Roadmap – How it Could Look
PRODUCT VISION
Product Vision Statement
* Updated 30 April 2021, subject to change without notice
Outcome Roadmap - Up To 2023
Team May Jun Jul -Q3/2021 Q4/2021 H1/2022 H2/2022 2023
Research
Analytics prototype 1 Analytics Research 1 Analytics Research 2 Analytics Proto. 2 Analytics Res. 3
Software Technology Research 1 Software Technology Research 2
Dev
FT
1
H2 Evolution 1
Project C Gaps Project E Gaps
H2 Evolution 4
H1 Evolutions batch 4
Dev
FT
2
Project A Gaps H2 Evolution 3
H3 Evolution 3
H1 Evolutions Batch 1 Project D Gaps
Dev
FT
3
Project B Gaps
H3 Evolution 1
H1 Evolutions Batch 2
Dev
FT
4
H2 Evolution 2 H3 Evolution 2
H1 Evolutions Batch 3 Project E Gaps H2 Evolution 5
CERTAINTY &
CONFIDENCE
DISCOVERY /
UNSCHEDULED
16
What we will be discussing now …
•
What
are
these
teams
?
•
How
are
they
organized
?
• How is the Roadmap managed and evolved ?
• What is a good update frequency ?
• What is the level of commitment ?
• What are these items on the Roadmap
• What is H1 / H2 / H3 ?
• How are epics estimated ?
D
A
B
C
18
2.A - Agile Software Development Teams
19

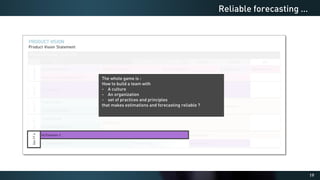

Reliable forecasting …
The whole game is :
How to build a team with
- A culture
- An organization
- set of practices and principles
that makes estimations and forecasting reliable ?
20

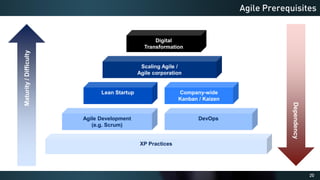

Agile Prerequisites
Maturity
/
Difficulty
Agile Development
(e.g. Scrum)
DevOps
Lean Startup Company-wide
Kanban / Kaizen
Scaling Agile /
Agile corporation
XP Practices
Digital
Transformation
Dependency
21

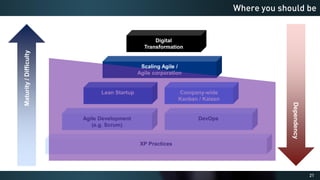

Where you should be
Maturity
/
Difficulty
Agile Development
(e.g. Scrum)
DevOps
Lean Startup Company-wide
Kanban / Kaizen
Scaling Agile /
Agile corporation
XP Practices
Digital
Transformation
Dependency
22

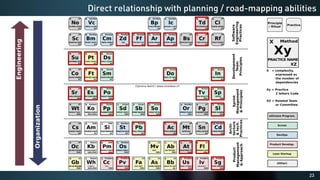

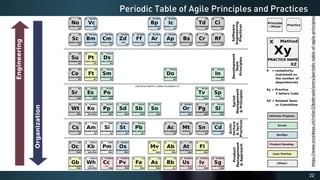

Periodic Table of Agile Principles and Practices
https://www.niceideas.ch/roller2/badtrash/entry/periodic-table-of-agile-principles
23
Direct relationship with planning / road-mapping abilities
24
Well actually you need them all
➔ Even only within XP, they all depend on each others

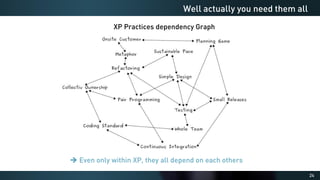

XP Practices dependency Graph
25

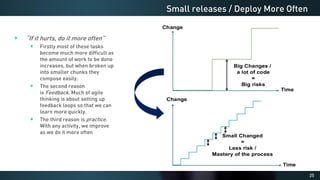

“If it hurts, do it more often”
Firstly most of these tasks
become much more difficult as
the amount of work to be done
increases, but when broken up
into smaller chunks they
compose easily.
The second reason
is Feedback. Much of agile
thinking is about setting up
feedback loops so that we can
learn more quickly.
The third reason is practice.
With any activity, we improve
as we do it more often
Small releases / Deploy More Often
26

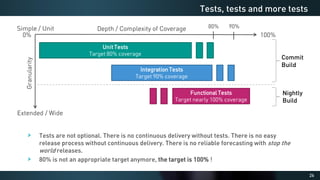

Tests are not optional. There is no continuous delivery without tests. There is no easy
release process without continuous delivery. There is no reliable forecasting with stop the
world releases.
80% is not an appropriate target anymore, the target is 100% !
Tests, tests and more tests
Commit
Build
Nightly
Build
27

Why TDD ?
This can be
estimated (SP)
We need to be able to predict the time things will take. Story Points and the whole Scrum approach are terrific for this.
However none of it works if most of the development workload is fundamentally unpredictable
Here comes TDD !
This can be
estimated (SP)
https://www.niceideas.ch/roller2/badtrash/entry/tdd-test-driven-development-is
28

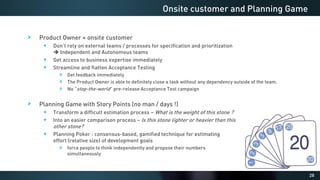

Product Owner = onsite customer
Don’t rely on external teams / processes for specification and prioritization
➔ Independent and Autonomous teams
Get access to business expertise immediately
Streamline and flatten Acceptance Testing
Get feedback immediately
The Product Owner is able to definitely close a task without any dependency outside of the team.
No “stop-the-world” pre-release Acceptance Test campaign
Planning Game with Story Points (no man / days !)
Transform a difficult estimation process – What is the weight of this stone ?
Into an easier comparison process – Is this stone lighter or heavier than this
other stone?
Planning Poker : consensus-based, gamified technique for estimating
effort (relative size) of development goals
force people to think independently and propose their numbers
simultaneously
Onsite customer and Planning Game
29
XP – Take Aways
The Product Owner - on-site customer - enables the
team to be autonomous and work without interruption
by answering questions (refined specifications)
immediately and running acceptance tests continuously
Acceptance tests / Feedback
Refined specifications
(DevOps) Continuous Delivery – small releases -
enables to avoid Stop-the-world Releases breaking
teams autonomy and forcing killing synchronization
events
Stop
the
world
Release
N
Stop
the
world
Release
N
+
1
TDD enables to have reliable forecasts by bringing most
of the development team workload to actual
development time that can be estimated (vs.
unpredictable nasty debugging session, patches and
fixed round trips, etc.)
The Planning Poker Estimation Game – planning game – enables to have reliable
estimations and forecasting abilities (surprisingly much more that traditional waterfall)
X
X
30

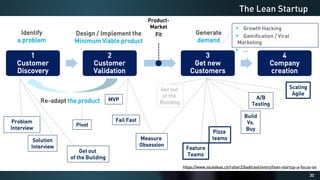

The Lean Startup
1
Customer
Discovery
2
Customer
Validation
3
Get new
Customers
4
Company
creation
Identify
a problem
Generate
demand
Design / Implement the
Minimum Viable product
Re-adapt the product
Problem
Interview
Solution
Interview
A/B
Testing
Measure
Obsession
Pizza
teams
Build
Vs.
Buy
Feature
Teams
Get out
of the
Building
Scaling
Agile
MVP
Fail Fast
Growth Hacking
Gamification / Viral
Marketing
...
Pivot
Get out
of the Building
Product-
Market
Fit
https://www.niceideas.ch/roller2/badtrash/entry/lean-startup-a-focus-on
31
Small Teams
As team size grows, the number of one-on-one communication
channels explodes, following the formula to compute number of
links between people which is n ( n - 1) / 2 .
This is O(n2) (Hello Engineers) and is really a combinatorial explosion.
32
Introducing Feature Teams
(Source : Large Scale Scrum : http://less.works/)
33
The characteristics of a feature team are :
long-lived—the team stays together so that they can ‘jell’ for higher performance; they take
on new features over time
autonomous and independent – no friction with other team
complete - support, UI/UX, DevOps
cross-functional and cross-component
ideally, co-located
work on a complete customer-centric
feature, across all components and
disciplines (analysis, programming,
testing, …)
Multi-competencies
in Scrum, typically 7 ± 2 people
Feature Teams
(Source : Large Scale Scrum : http://less.works/)
34
Star Trek
35

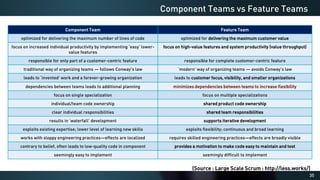

Component Teams vs Feature Teams
Component Team Feature Team
optimized for delivering the maximum number of lines of code optimized for delivering the maximum customer value
focus on increased individual productivity by implementing ‘easy’ lower-
value features
focus on high-value features and system productivity (value throughput)
responsible for only part of a customer-centric feature responsible for complete customer-centric feature
traditional way of organizing teams — follows Conway’s law ‘modern’ way of organizing teams — avoids Conway’s law
leads to ‘invented’ work and a forever-growing organization leads to customer focus, visibility, and smaller organizations
dependencies between teams leads to additional planning minimizes dependencies between teams to increase flexibility
focus on single specialization focus on multiple specializations
individual/team code ownership shared product code ownership
clear individual responsibilities shared team responsibilities
results in ‘waterfall’ development supports iterative development
exploits existing expertise; lower level of learning new skills exploits flexibility; continuous and broad learning
works with sloppy engineering practices—effects are localized requires skilled engineering practices—effects are broadly visible
contrary to belief, often leads to low-quality code in component provides a motivation to make code easy to maintain and test
seemingly easy to implement seemingly difficult to implement
(Source : Large Scale Scrum : http://less.works/)
36
Product 3
Product 1 Product 2
Component Team vs Product Teams ?
Feature teams work tremendously good … within a product !
Having different set of teams for different set of products is mandatory
(business vs. technical specialization)
Product Teams
UI / UX
Java backend
Data Science / Research
Java backend
UI / UX
Java backend
Data / DB
Data Science
Operators
Component Teams Model
Product 3
Product 1 Product 2
FT1
Data Science / Research
FT1
FT2
FT3
FT4
Feature Teams Model
FT2
FT3
Data Science
37
Squads
Equivalent to a Scrum
Team
As Autonomous as possible
Tribes
Same office < 100 FTE
Common area of the system
(product)
Organized for minimum
interdependency
Chapters
Skills community
(community of practices)
Chapter lead is line
manager
Guilds
Community of interest
Cross tribe groups
Guild unconferences
The Spotify Way
Squad Squad Squad Squad Squad Squad Squad Squad
38
Lean Startup – Take Aways
One
wants
as
many
independent
teams
as
required
to
run
independent
topics
in
parallel
Dev Teams should never ever be exposed to customers directly, they do 3rd level support
only
Custo-
mer
Deploy.
Refined
design
Most of the time, a team should have 1 or 2 core focus at a time,
typically a long term focus and some more short term fillers.
Support Functions : Customer 1st level support, 2nd level support, HR, Management, etc.
A feature being given to 1 autonomous team, and that team being able to
work without interruption, Team Sprint Velocity enables to do forecasting.
A Feature Team implements a Feature from A to Z, where Z is release / deployment to the customer,
independently and autonomously.
The rule is : as soon as a team has any dependency on another team, estimations and forecasts are not
reliable anymore ! (multi-team consolidated planning and forecasting is a much more difficult game !)
A to Z includes everything: 3rd level support, documentation, automated tests, code review, IT testing,
Acceptance Testing, Release, Deploy, Deployment automation, etc. ➔ EVERYTHING (… DoD)
Because the team is autonomous and independent, it’s own planning and forecasts are reliable.
39

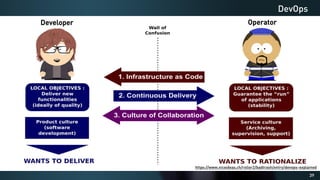

DevOps
https://www.niceideas.ch/roller2/badtrash/entry/devops-explained
Developer Operator
40
DevOps in a nutshell
Key
For
Planning
41

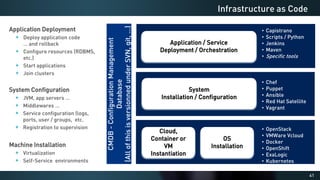

Infrastructure as Code
Cloud,
Container or
VM
Instantiation
OS
Installation
System
Installation / Configuration
Application / Service
Deployment / Orchestration
• Capistrano
• Scripts / Python
• Jenkins
• Maven
• Specific tools
• Chef
• Puppet
• Ansible
• Red Hat Satellite
• Vagrant
• OpenStack
• VMWare Vcloud
• Docker
• OpenShift
• ExaLogic
• Kubernetes
CMDB
-
Configuration
Management
Database
(All
of
this
is
versionned
under
SVN,
git,
…)
Application Deployment
Deploy application code
… and rollback
Configure resources (RDBMS,
etc.)
Start applications
Join clusters
System Configuration
JVM, app servers …
Middlewares …
Service configuration (logs,
ports, user / groups, etc.
Registration to supervision
Machine Installation
Virtualization
Self-Service environments
42
The more often you deploy, the more you master the deployment process and the better you
automate it. If you have to do something 3 times a day, you will make it bullet proof and reliable
soon enough, when you will be fed up of fixing the same issues over and over again.
The more often you deploy, the smallest will be the changesets you deploy and hence the smallest
will be the risk of something going wrong, or the chances of losing control over the changesets
The more often you deploy, the best
will be your TTR (Time to Repair /
Resolution)
Key for Planning !
You don’t want to loose time on Deployment
You want deployment to be automated
You want deployment and production release to
happen without you even noticing
Key to avoid multiple team synchronization
Continuous Delivery – “If it hurts, do it more often”
(Source : Ops Meta-Metrics: The Currency You Pay For Change -
http://fr.slideshare.net/jallspaw/ops-metametrics-the-currency-
you-pay-for-change-4608108)
43
Continuous integration of both the software components development as well
as the platform provisioning and setup.
TDD - Test Driven Development. This is questionable ... But in the end let's face
it: TDD is really the single and only way to have an acceptable coverage of the
code and branches with unit tests (and unit tests makes is so much easier to fix
issues than integration or functional tests).
Code reviews ! At least code reviews ... pair programming would be better of
course.
Continuous auditing software - such as Sonar.
Functional testing automation on production-level environment
Strong non-functional testing automation (performance, availability, etc.)
Automated packaging and deployment, independent of target environment
Continuous Delivery requirements
44
"Zero Downtime Deployment (ZDD) consists in deploying a new version of a system without any
interruption of service.“
ZDD consists in deploying an application without interruption of service
in such a way that one introduces a new version of an application to production without making the
user see that the application went down in the meantime.
From the user's and the company's point of view it's the best possible scenario of deployment since
new features can be introduced and bugs can be eliminated without any outage.
I'll mention 3 techniques:
Feature Flipping ➔ Key for Continuous Deployment
Shippable version at the end of every sprint
Multi-sprint developments become possible without harming Continuous delivery
Blue/Green Deployments
Canari release
Zero Downtime Deployments
45
Feature flipping allows to enable / disable features while the software is running. It's
really straightforward to understand and put in place: simply use a configuration properly
to entirely disable a feature from production and only activate it when its completely
polished and working well.
For instance to disable or activate a feature globally for a whole application:
Or if one wants to do it on a per-user basis:
Feature flipping
46
Blue/Green Deployments consists in building a second complete line of production for
version N + 1.
Both development and operation teams can peacefully build up version N + 1 on this second
production line.
Whenever the version N + 1 is ready to be used, the configuration is changed on the load balancer
and users are automatically and transparently redirected to the new version N + 1.
At this moment, the production line for version N is recovered and used to peacefully build version
N + 2.
And so on.
Blue/Green Deployments
(Source : Les Patterns des Géants du Web – Zero Downtime
Deployment - http://blog.octo.com/zero-downtime-
deployment/)
47
Canari release is very similar in nature to Blue/Green Deployments but it addresses the
problem to have multiple complete production lines.
The idea is to switch users to the new version in an incremental fashion : as more servers are
migrated from the version N line to the version N + 1 line, an equivalent proportion of users are
migrated as well.
At first, only a few servers are migrated to version N + 1 along with a small subset of the users. This
also allows to test the new release without risking an impact on all users.
When all servers have eventually been migrated from line N to line N + 1, the release is finished and
everything can start all over again for release N + 2.
Canari Release
(Source : Les Patterns des Géants du Web – Zero
Downtime Deployment - http://blog.octo.com/zero-
downtime-deployment/)
48

DevOps – Take Aways
Custo-
mer
Deploy.
Automated tests – End-to-End tests – on
integration and tests environment are
key to avoid debugging sessions and
production regressions.
Infrastructure as Code enables to
streamline and automated end-to-end
tests on production-like test
environments and is key to Continuous
Delivery.
Finally, Automated tests should validate
non-functional requirements.
Stop
the
world
Release
N
Stop
the
world
Release
N
+
1
Releasing / Deploying to customer has to be a marginal, one-day, push-a-button event.
Continuous Delivery techniques are absolutely key to avoid stop-the-world releases / deployments
which breaks the team independence and autonomy, which, again, is absolutely key to have accurate
forecasts.
Just as TDD eliminates unpredictable development-related tasks, Continuous Delivery and ZDD
techniques enable to eliminate unpredictable deployment-related tasks.
X
X
49
2.B – The 3 Horizon Framework
50
Business Economics
The need for innovation
Technological
Progress
Cumulative
Effort
Technology S-curve
Technology Profit Curve
Profit
Time
51
The 3 Horizon model (McKinsey)
The 3 horizons model is a growth strategy framework by McKinsey that you can use to
think about the future of your company.
Value
Time / Effort
H1
1-2 years
H2
2-4 years
H3
3-5 years
Technology
S-curve
Technology
Profit
Curve
Horizon 1
Maintain & strengthen
core business
Horizon 2
Explore & discover emerging
expansions / opportunities
Horizon 3
Create genuinely new businesses
/ competencies / possibilities
52
The 3 Horizon model (McKinsey)
Value
Time
H1
H2
H3
Horizon 1
Maintenance, functional
evolutions, Project Gaps
The first horizon involves
implementing innovations
that improve current
operations
Horizon 2
Product & Technology
Evolutions
Horizon 2 innovations are
those that extend your
current competencies into
new, related markets.
Horizon 3
Disruption, new
technologies, new product
Horizon 3 innovations are
the ones that would change
the nature of your industry
and generate new
competencies
NG : now – 18 months
NG : 6 – 24 months
NG : 1 – 3 years
53

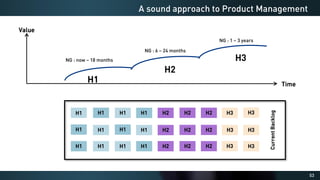

A sound approach to Product Management
Value
Time
H1
H2
H3
NG : now – 18 months
NG : 6 – 24 months
NG : 1 – 3 years
Current
Backlog
H1
H1
H1
H1
H1
H1
H1
H1
H1
H1
H1
H1
H2
H2
H2
H2
H2
H2
H2
H2
H2
H3
H3
H3
H3
H3
H3
54
3 Horizon Framework – Take Aways
Multiple
Teams
enable
to
spread
workload
among
the
3
horizons
(fair
share)
Some epics / stories - often related to projects - can
sometimes not be estimated properly because the scope is
blurry. In this case we take reserve.
Some backlog fillers - small tasks - are used to fill in the gaps
Type of Stories / Epics on the roadmap
- Product evolutions (PMC)
- Functional evolutions (PMC, BA, PO)
- Technology evolutions and maintenance (CTO)
- Projects Gaps (Delivery)
- Evolution / Improvement batches (Delivery, Sales,
R&D, etc.)
➔ Granularity has to be "large topics" or "important
topic" or customer / delivery commitments
Multiple small tasks in H1 – delivery wishes, minor bug corrections,
cosmetic changes, UX improvements, small evolutions – etc, are grouped
together by theme and scope in an Evolution batch.
The Evolution batch is then prioritized and scheduled as a consistent unit.
Have the Teams switch / rotate between H1 / H2 /
H3 to avoid frustration
55
2.C – The Estimation Process
56
Key Product-related Roles
Product Manager(s)
➔ Marketing / Corporate Function
• Product Marketing / Market
studies
• Voice of customers / market
• Animates PMC
• Roadmap Maintenance
• Story Map
Product Owner(s)
➔ Dev Team Function
• Represents / Liaise with PMC
• Business Analysis
• Acceptance Tests
• Release Management
• Backlog prioritization
• Release Notes
• Development Story Specification
Team Leader(s)
• Liaise with Product Owner
• Fill-in Team Sprint backlog
• Animates team rituals
• Dev Team Management
(People Management)
Architect(s) / UX / Data Science
• Functional / Application Architecture
• Technical / System Architecture
• User Experience
• Data Architecture
• Epic Specification
• Epic Breakdown in Dev Tasks
• Tasks Estimation
Tech Lead
• Application / Technical Design
• Developer support
• Epic Specification
• Epic Breakdown in Tasks
• Tasks Estimation
Developers…
• Full-stack development
• Operation Automation
• Deployment Automation
• Documentation
• Support
CTO
- Architecture Lead
- Voice of technology
- Software Development
Methodology guarantor
- Cloud Operations Management
- Animates ARCHCOM
+ of course 1st Level support / 2nd Level support / Scrum Master / Perhaps Cloud Operations / etc.
57
Key Rituals
Product Management Committee - PMC
Product
Manager(s)
Product
Owner(s)
Head of
Sales
CTO
Preparation: PM collects opportunities and needs
Walkthrough:
Promote / Eliminate / Prioritize
Evolutions
Offline: PM prepares User stories
Offline: later, continuously, collect estimations then
update roadmap
Architecture Committee - ARCHCOM
Preparation: CTO and Product Owner creates Epics
corresponding to stories
Walkthrough:
N: Dispatch epics to be specified
Offline: review specifications and comment / challenge
N + 1: discuss comments and amend
Offline: breakdown in tasks, tasks estimation
Product
Owner(s)
Team
Leader(s)
CTO Architect(s)
Tech
Lead
+ of course TechCom / Sprint planning / Sprint retro / Daily scrum / Delivery Rituals / Management Rituals (O3s) / etc.
58

A typical development month
Monday Tuesday Wednesday Thursday Friday Sat Sun
Sprint planning
Sprint Retro
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Daily Scrum
Sprint planning
Sprint Retro
Test Deployment
Sprint
N
Sprint
N+1
ARCHCOM
ARCHCOM
ARCHCOM
ARCHCOM
PMC
Test Deployment
Integration Depl. Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl. Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl.
Integration Depl.
UX Committee
UX Committee
Tech Committee
Tech Committee
Integration Depl.
Integration Depl.
ARCHCOM
PMC
UX
Committee
Tech Com.
Cross-team meetings (company wide):
All these rituals are prepared in advanced by all participants!
Rituals are clearly and consistently scheduled / no unforeseen interruption of sprint
Delivery Project Gaps
Review
Proj. Gaps Rev.
59
The Estimation Process
Story
Lorem ipsum dolor
sit amet, consectetur
adipiscing elit,
sed …
Detailed Story
Lorem ipsum dolor
sit amet, consectetur
adipiscing elit, sed
do eiusmod tempor
incididunt ut labore
et dolore magna
aliqua. Ut enim …
Development Epic
Lorem ipsum dolor sit amet,
consectetur adipiscing elit, sed
do eiusmod tempor incididunt ut
labore et dolore magna aliqua.
Ut enim ad minim veniam, quis
nostrud exercitation ullamco
laboris nisi ut aliquip ex ea
commodo consequat. Duis aute
irure dolor in reprehenderit in
voluptate velit esse cillum dolore
eu fugiat nulla pariatur.
Excepteur sint occaecat
cupidatat non proident, sunt in
culpa qui officia deserunt mollit
anim id est laborum.
Task
Lorem ipsum dolor
sit amet, consectetur
adipiscing elit,
sed …
Task
Lorem ipsum dolor
sit amet, consectetur
adipiscing elit,
sed …
Task
Lorem ipsum dolor
sit amet, consectetur
adipiscing elit,
sed …
Specification
&
Design
Process
Estimation
Process
PMC
PM PO
CTO
/ /
PM PO
/
Roadmap
Tm. L
PO
CTO
/
Archi.
/ /
CTO
ARCHCOM
Tm. L
Archi.
CTO
Tk. L
Delivery
wishes
Task
Task
Task
Development Epic
Story
ARCHCOM
Specification
Design
Estimations
Planning
21
34
55
110
110
Product Management R&D
Tk. L
Developers
PM
PM
PO
CTO
/
PO
CTO /
UPDATES!
60
Picking-up the extremes makes only little sense : people are sick, leaves on holidays,
some big task gets finished the next sprint, etc
➔ So we should pick up the second and last-but-one.
This gives us a lower range and an upper range
➔ Using a range addresses uncertainty

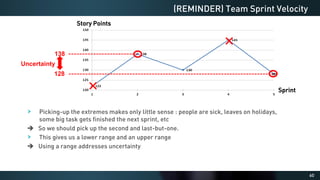

(REMINDER) Team Sprint Velocity


Uncertainty
138
128
Story Points
Sprint
61
Range is used this way:
In case of fixed time, when we
have a fixed delivery date, the
lower and upper values give us the
minimum or maximum set of
features we can have
implemented at that date.
In case of fixed scope, when we
have to release a version of the
software with a given set of
features, the lower and upper
values are used to compute earliest or latest release date
We now have everything we need for accurate estimations
(REMINDER) Forecasting
Story Points
Months
Team. L
PO
/
62

Estimation game – Take Aways
We
can
compute
the
Team
Sprint
Velocity
In this model, Project Gaps are the only items with hard
commitment.
A Delivery project being planned and with a Go-Live date, the related
deliverables due date has to be respected.
When designing the roadmap, these are put first and can’t be moved
afterwards (frozen items)
120
150
110
180
170
The estimation game tells us the total story points
for this Story. With the team capacity, it can be
planned in terms of number of sprints, assuming 2
sprints per month.
The keyword here is reserve, reserve and more
reserve.
D D
D
D
D
D
These batches are where we have some flexibility for urgent stuff popping up!
Fixed scope: keep all tasks in the batch and add new stuff.
Fixed date (fixed roadmap): add new stuff and remove an equal amount of SP
63
2.D – Roadmap timeline
64

Now about the timeline
PRODUCT VISION
Product Vision Statement
* Updated 30 April 2021, subject to change without notice
Outcome Roadmap - Up To 2023
Team May Jun Jul -Q3/2021 Q4/2021 H1/2022 H2/2022 2023
Research
Analytics prototype 1 Analytics Research 1 Analytics Research 2 Analytics Proto. 2 Analytics Res. 3
Software Technology Research 1 Software Technology Research 2
Dev
FT
1
H2 Evolution 1
Project C Gaps Project E Gaps
H2 Evolution 4
H1 Evolutions batch 4
Dev
FT
2
Project A Gaps H2 Evolution 3
H3 Evolution 3
H1 Evolutions Batch 1 Project D Gaps
Dev
FT
3
Project B Gaps
H3 Evolution 1
H1 Evolutions Batch 2
Dev
FT
4
H2 Evolution 2 H3 Evolution 2
H1 Evolutions Batch 3 Project E Gaps H2 Evolution 5
65
Short-term vs. Long-term commitments
Outcome Roadmap - Up To 2023
Team May Jun Jul -Q3/2021 Q4/2021 H1/2022 H2/2022 2023
• Hard commitment - no slippage
should occur
• due dates are respected / fixed
• Scope can evolve (support,
critical bug fixes, etc.), in which
case tasks of lesser priority can
be postponed
• Transparent communication to
delivery, sales, customers, etc.
• Strong
commitment –
slippage should
support business
opportunities
• Opaque
communication
• Soft commitment –
this can really
change entirely if
required
• Cautious
communication
• Internal
only
• No
commit-
ment
• No
commu-
nication
Month
Granularity
Quarter Semester Year
66
Timeline evolution
April Roadmap
Outcome Roadmap - Up To 2023
Team May Jun Jul -Q3/2021 Q4/2021 H1/2022 H2/2022 2023
May Roadmap
Outcome Roadmap - Up To 2023
Team Jun Jul Aug Sep Q4/2021 H1/2022 H2/2022 2023
Jun Roadmap
Outcome Roadmap - Up To 2023
Team Jul Aug Sep Q4/2021 Q1/2022 Q2/2022 H2/2022 2023
M+1
M+1
Oct Roadmap
Outcome Roadmap - Up To 2024
Team Nov Dec Jan/2022 -Q1/2022 Q2/2022 H2/2022 H1/2023 H2/2023 – H1/2024
M+4
67
“Stop the world” refactoring or technology evolutions ?
Feature flipping, API versioning, library versioning, etc.
If a “stop-the-world” refactoring or evolution can’t be avoided, it needs to be planned and accounted
in the roadmap (big vertical box)
Kaizen burst
Every end of quarter PMC starts with a Quarter retrospective
Challenge everything !
Delivery
SaaS : continuous deployment
On-premise deployment
continuous delivery, periodic end customer releases. Migration is a concern.
Specific rituals are required between PM and Delivery Teams
➔ Doesn’t change a whole lot of things for planning
Other aspects
68
SaaS / Cloud / Web deployment
Amazon
- Continuous Deployment in production
- Code is being deployed in production
every 11.7 seconds on average.
- Continuous Deployment in production
- Devs push code to production thousands
of times per day!
- Develop for failure - Chaos monkeys
randomly kills services and machines
continuously
Facebook
- Continuous Deployment in production
- Before 2016,
- Up to 3 release trains a day
- Cherry pick (manual) / periodic resync
- Since 2016
- Release train every few hours
- Push from master
69
On premise deployments
8.3-SN.
14329
8.3-SN.
14361
8.3-SN.
14398
R
8.3
8.4-SN.
14475
R
8.4
B B R
8.5
R
8.6
R
9
B B B B B B
End of Sprint Release - Internal Release / Automated deployment on Test Env.
Customer Release - Official Release / Deployable and versioned package with release notes, etc.
70
3. Take Aways and other models
71
Take Aways
XP
• TDD / Tests
Coverage
• On-site customer
(Product Owner )
• Code Reviews
• Sustainable Pace
• Small Releases
(Continuous
Delivery)
• Acceptance tests
• Planning Game
Scrum
• DoD - Definition of
Done
• Sprint planning /
Spring Retro
• Daily Scrum
• Product Increment
(Continuous Delivery)
• Estimation Game /
Planning Poker / SP
• Product Backlog
• Team Velocity
• Product Owner
Lean Startup
• Pizza Teams
• Feature Teams
• Feedback Loop
DevOps
• Automated
Provisioning
• ZDD
• Feature
Flipping
• Automated
Releases
• Continuous
Delivery
Product
Management
• Story Mapping
• PMC
• Product
Vision
• Roadmap
Maintenance
Reliable Roadmap
72
Required Tools
Need Tool Description
Collaborative source code
development
git
Need to be able to have a large number of concurrent branches and convenience for
managing them.
Feature Branches and Code
reviews
Gitlab (or gitbucket, etc.)
Enforcing code reviews Merge request / Pull requests. Comments arbitration, conflicts
resolution, etc.
Continuous Integration and
automated tests
Gitlab CI (or jenkins, etc.)
Integration test suite on every branch at every commit, full automated tests twice a day.
Deployment Automation
Integration deployment twice a day, test deployment end of every sprint, environment
promotion, etc.
Sprint backlog management
Jira
Sprint Kanban board, Sprint burndown chart, etc.
Product Backlog Management
Product backlog, Stories, Epics and task specification and relations, priorities
management, etc.
Documentation as Code ASCIIDoc Version-able documentation and editing integrated in development processes
End-to-End tests Selenium (or Protractor, etc.) Production-like environment non-regression tests
Infrastructure as Code Ansible (or Chef, Puppet) Environment provisioning, automated installation and deployment.
Database migration Liquibase Automated DB updates
Code quality Sonar Code Quality guarantee
Development Manifesto Wiki (e.g. confluence, etc.) Document your culture, values, organization, principles and practices (light !)
Planning Poker www.pointingpoker.com Distributed planning poker app
Kanban / Visual Board Trello (or MS Planner, etc.) ARCHCOM Topics, discussion topics, prioritization games, etc.
Agenda Outlook Rituals over processes
Roadmap Powerpoint / Excel
If you need more than excel or Powerpoint to draw your roadmap, then your roadmap is not
the right one.
Plenty of others …
73
Other Model : Holacracy
Every Team is a Project team - Circle (ultimate Feature Team); there are transverse projects
Every Team – Circle - has its own culture, organization, processes, rituals, tools, etc. as require to fulfill
its objectives and purpose
Governance – where dependencies and streams between Teams – Circles – are defined is key (and tricky)
(from https://www.tealschool.se/2019/07/12/holacracy-for-schools/)
74
Other models
Fixed time – fixed release dates roadmap
Flexible / variable scope
Commitment comes from identifying the subset of stories we have to stick to and the ones
that are fillers
Fixed scope – fixed content releases
Flexible release dates
Other aspects …
Management 3.0
Google-like Office space
Scaling Agile
Other aspects / final notes
75
Thanks for listening

A proposed framework for Agile Roadmap Design and Maintenance

  • 1.
    1 © Jerome Kehrli@ niceideas.ch A proposed framework for Agile Roadmap Design and Maintenance
  • 2.
  • 3.
    3 We are notgoing to end up with this… (I am not saying this doesn’t work, but it definitely doesn’t work for us)
  • 4.
    4 Aligns with companystrategy, rallies all around this and steers us towards delivering on this strategy Focuses on delivering customer value & articulating benefits Excites our customers about our company & product direction Reflects what we have learned, over time, as an organisation Does not pretend to have all the answers, or indeed need to Characteristics of a Good Roadmap Done well, a roadmap is a strategic communication tool, a statement of intent and direction © Roy Belchamber @ NetGuardians
  • 5.
    5 Excessive granularity –too much focus on detail and dates means it will inevitably soon be inaccurate or even obsolete! Mistakenly thinking every item in the roadmap demands upfront design and estimation – this is impossible & wasteful Believing each stakeholders must personally value every item Ensuring our roadmap is not conflated with our product release plan! Potential Pitfalls It is possible to set clear direction & simultaneously embrace uncertainty inherent in product development © Roy Belchamber @ NetGuardians
  • 6.
    6 The Roadmap asa Strategic Tool Elements Product Vision Timeframes Themes Business Objectives * Disclaimer Focus on outcomes (strategic) not on outputs (tactical) A good roadmap starts with a vision of where we are going, guides us there and explains the stops along the way… Outcomes Roadmap Now Next Later Backlog Outputs Backlog Backlog Backlog Inspired from Roy Belchamber @ NetGuardians
  • 7.
    7 The Roadmap Illustrated Elements ProductVision Timeframes Themes Business Objectives * Disclaimer PRODUCT VISION RIA Organizer providing UX of Desktop applications Our product vision is our guiding principle Inspired from Roy Belchamber @ NetGuardians
  • 8.
    8 Elements Business Objectives Timeframes The RoadmapIllustrated Product Vision Themes * Disclaimer PRODUCT VISION RIA Organizer providing UX of Desktop applications H1/2021 H2/2021 2022 Future Broad timeframes avoid overcommitment - It is the sequence that matters (now, next, future) Inspired from Roy Belchamber @ NetGuardians
  • 9.
    9 The Roadmap Illustrated Elements ProductVision Timeframes * Disclaimer PRODUCT VISION RIA Organizer providing UX of Desktop applications H1/2021 H2/2021 2022 Future Email CRUD Focus on outcomes not outputs. Themes are not granular features and functions Email Search Attachment Management RTF Emails and appointments description HTML Emails and appointments Scheduler Genius Cal. Search Contact Search Contact CRUD Calendar CRUD Business Objectives Themes Outlook compatibility Inspired from Roy Belchamber @ NetGuardians
  • 10.
    10 The Roadmap Illustrated Elements ProductVision Timeframes Themes Business Objectives * Disclaimer PRODUCT VISION RIA Organizer providing UX of Desktop applications H1/2021 H2/2021 2022 Future What goals will our product accomplish? What outcomes? Email CRUD Email Management MVP Email Search Google-like experience on emails Cal. Search Google-like experience on appointments Contact Search Advanced Contacts Management Contact CRUD Contact Management MVP Calendar CRUD Calendar Management MVP Attachment Management RTF Emails and appointments description HTML Emails and appointments Scheduler Genius Outlook compatibility Inspired from Roy Belchamber @ NetGuardians
  • 11.
    11 The Roadmap Illustrated PRODUCTVISION RIA Organizer providing UX of Desktop applications H1/2021 H2/2021 2022 Future Protects against claims of broken promises by explaining that changes can happen Email CRUD Email Management MVP Email Search Google-like experience on emails Cal. Search Google-like experience on appointments Contact Search Advanced Contacts Management Contact CRUD Contact Management MVP Calendar CRUD Calendar Management MVP Attachment Management RTF Emails and appointments description HTML Emails and appointments Scheduler Genius Outlook compatibility Elements Product Vision Timeframes Themes Business Objectives * Disclaimer * Updated 30 April 2021, subject to change without notice Inspired from Roy Belchamber @ NetGuardians
  • 12.
    12 R&D The Hierarchy… What Why How Whywe are doing this? Why it aligns with our strategy What customer problems will we solve? Finally, how should we solve it? Roadmap Now Need Next Later Product Mgmt Backlog Backlog Backlog Inspired from Roy Belchamber @ NetGuardians
  • 13.
    13 Let’s have alook at something more realistic
  • 14.
    14 An Outcome-Based Roadmap– How it Could Look PRODUCT VISION Product Vision Statement * Updated 30 April 2021, subject to change without notice Outcome Roadmap - Up To 2023 Team May Jun Jul -Q3/2021 Q4/2021 H1/2022 H2/2022 2023 Research Analytics prototype 1 Analytics Research 1 Analytics Research 2 Analytics Proto. 2 Analytics Res. 3 Software Technology Research 1 Software Technology Research 2 Dev FT 1 H2 Evolution 1 Project C Gaps Project E Gaps H2 Evolution 4 H1 Evolutions batch 4 Dev FT 2 Project A Gaps H2 Evolution 3 H3 Evolution 3 H1 Evolutions Batch 1 Project D Gaps Dev FT 3 Project B Gaps H3 Evolution 1 H1 Evolutions Batch 2 Dev FT 4 H2 Evolution 2 H3 Evolution 2 H1 Evolutions Batch 3 Project E Gaps H2 Evolution 5
  • 15.
    15 An Outcome-Based Roadmap– How it Could Look PRODUCT VISION Product Vision Statement * Updated 30 April 2021, subject to change without notice Outcome Roadmap - Up To 2023 Team May Jun Jul -Q3/2021 Q4/2021 H1/2022 H2/2022 2023 Research Analytics prototype 1 Analytics Research 1 Analytics Research 2 Analytics Proto. 2 Analytics Res. 3 Software Technology Research 1 Software Technology Research 2 Dev FT 1 H2 Evolution 1 Project C Gaps Project E Gaps H2 Evolution 4 H1 Evolutions batch 4 Dev FT 2 Project A Gaps H2 Evolution 3 H3 Evolution 3 H1 Evolutions Batch 1 Project D Gaps Dev FT 3 Project B Gaps H3 Evolution 1 H1 Evolutions Batch 2 Dev FT 4 H2 Evolution 2 H3 Evolution 2 H1 Evolutions Batch 3 Project E Gaps H2 Evolution 5 CERTAINTY & CONFIDENCE DISCOVERY / UNSCHEDULED
  • 16.
    16 What we willbe discussing now … • What are these teams ? • How are they organized ? • How is the Roadmap managed and evolved ? • What is a good update frequency ? • What is the level of commitment ? • What are these items on the Roadmap • What is H1 / H2 / H3 ? • How are epics estimated ? D A B C
  • 17.
    18 2.A - AgileSoftware Development Teams
  • 18.
    19 Reliable forecasting … Thewhole game is : How to build a team with - A culture - An organization - set of practices and principles that makes estimations and forecasting reliable ?
  • 19.
    20 Agile Prerequisites Maturity / Difficulty Agile Development (e.g.Scrum) DevOps Lean Startup Company-wide Kanban / Kaizen Scaling Agile / Agile corporation XP Practices Digital Transformation Dependency
  • 20.
    21 Where you shouldbe Maturity / Difficulty Agile Development (e.g. Scrum) DevOps Lean Startup Company-wide Kanban / Kaizen Scaling Agile / Agile corporation XP Practices Digital Transformation Dependency
  • 21.
    22 Periodic Table ofAgile Principles and Practices https://www.niceideas.ch/roller2/badtrash/entry/periodic-table-of-agile-principles
  • 22.
    23 Direct relationship withplanning / road-mapping abilities
  • 23.
    24 Well actually youneed them all ➔ Even only within XP, they all depend on each others XP Practices dependency Graph
  • 24.
    25 “If it hurts,do it more often” Firstly most of these tasks become much more difficult as the amount of work to be done increases, but when broken up into smaller chunks they compose easily. The second reason is Feedback. Much of agile thinking is about setting up feedback loops so that we can learn more quickly. The third reason is practice. With any activity, we improve as we do it more often Small releases / Deploy More Often
  • 25.
    26 Tests are notoptional. There is no continuous delivery without tests. There is no easy release process without continuous delivery. There is no reliable forecasting with stop the world releases. 80% is not an appropriate target anymore, the target is 100% ! Tests, tests and more tests Commit Build Nightly Build
  • 26.
    27 Why TDD ? Thiscan be estimated (SP) We need to be able to predict the time things will take. Story Points and the whole Scrum approach are terrific for this. However none of it works if most of the development workload is fundamentally unpredictable Here comes TDD ! This can be estimated (SP) https://www.niceideas.ch/roller2/badtrash/entry/tdd-test-driven-development-is
  • 27.
    28 Product Owner =onsite customer Don’t rely on external teams / processes for specification and prioritization ➔ Independent and Autonomous teams Get access to business expertise immediately Streamline and flatten Acceptance Testing Get feedback immediately The Product Owner is able to definitely close a task without any dependency outside of the team. No “stop-the-world” pre-release Acceptance Test campaign Planning Game with Story Points (no man / days !) Transform a difficult estimation process – What is the weight of this stone ? Into an easier comparison process – Is this stone lighter or heavier than this other stone? Planning Poker : consensus-based, gamified technique for estimating effort (relative size) of development goals force people to think independently and propose their numbers simultaneously Onsite customer and Planning Game
  • 28.
    29 XP – TakeAways The Product Owner - on-site customer - enables the team to be autonomous and work without interruption by answering questions (refined specifications) immediately and running acceptance tests continuously Acceptance tests / Feedback Refined specifications (DevOps) Continuous Delivery – small releases - enables to avoid Stop-the-world Releases breaking teams autonomy and forcing killing synchronization events Stop the world Release N Stop the world Release N + 1 TDD enables to have reliable forecasts by bringing most of the development team workload to actual development time that can be estimated (vs. unpredictable nasty debugging session, patches and fixed round trips, etc.) The Planning Poker Estimation Game – planning game – enables to have reliable estimations and forecasting abilities (surprisingly much more that traditional waterfall) X X
  • 29.
    30 The Lean Startup 1 Customer Discovery 2 Customer Validation 3 Getnew Customers 4 Company creation Identify a problem Generate demand Design / Implement the Minimum Viable product Re-adapt the product Problem Interview Solution Interview A/B Testing Measure Obsession Pizza teams Build Vs. Buy Feature Teams Get out of the Building Scaling Agile MVP Fail Fast Growth Hacking Gamification / Viral Marketing ... Pivot Get out of the Building Product- Market Fit https://www.niceideas.ch/roller2/badtrash/entry/lean-startup-a-focus-on
  • 30.
    31 Small Teams As teamsize grows, the number of one-on-one communication channels explodes, following the formula to compute number of links between people which is n ( n - 1) / 2 . This is O(n2) (Hello Engineers) and is really a combinatorial explosion.
  • 31.
    32 Introducing Feature Teams (Source: Large Scale Scrum : http://less.works/)
  • 32.
    33 The characteristics ofa feature team are : long-lived—the team stays together so that they can ‘jell’ for higher performance; they take on new features over time autonomous and independent – no friction with other team complete - support, UI/UX, DevOps cross-functional and cross-component ideally, co-located work on a complete customer-centric feature, across all components and disciplines (analysis, programming, testing, …) Multi-competencies in Scrum, typically 7 ± 2 people Feature Teams (Source : Large Scale Scrum : http://less.works/)
  • 33.
  • 34.
    35 Component Teams vsFeature Teams Component Team Feature Team optimized for delivering the maximum number of lines of code optimized for delivering the maximum customer value focus on increased individual productivity by implementing ‘easy’ lower- value features focus on high-value features and system productivity (value throughput) responsible for only part of a customer-centric feature responsible for complete customer-centric feature traditional way of organizing teams — follows Conway’s law ‘modern’ way of organizing teams — avoids Conway’s law leads to ‘invented’ work and a forever-growing organization leads to customer focus, visibility, and smaller organizations dependencies between teams leads to additional planning minimizes dependencies between teams to increase flexibility focus on single specialization focus on multiple specializations individual/team code ownership shared product code ownership clear individual responsibilities shared team responsibilities results in ‘waterfall’ development supports iterative development exploits existing expertise; lower level of learning new skills exploits flexibility; continuous and broad learning works with sloppy engineering practices—effects are localized requires skilled engineering practices—effects are broadly visible contrary to belief, often leads to low-quality code in component provides a motivation to make code easy to maintain and test seemingly easy to implement seemingly difficult to implement (Source : Large Scale Scrum : http://less.works/)
  • 35.
    36 Product 3 Product 1Product 2 Component Team vs Product Teams ? Feature teams work tremendously good … within a product ! Having different set of teams for different set of products is mandatory (business vs. technical specialization) Product Teams UI / UX Java backend Data Science / Research Java backend UI / UX Java backend Data / DB Data Science Operators Component Teams Model Product 3 Product 1 Product 2 FT1 Data Science / Research FT1 FT2 FT3 FT4 Feature Teams Model FT2 FT3 Data Science
  • 36.
    37 Squads Equivalent to aScrum Team As Autonomous as possible Tribes Same office < 100 FTE Common area of the system (product) Organized for minimum interdependency Chapters Skills community (community of practices) Chapter lead is line manager Guilds Community of interest Cross tribe groups Guild unconferences The Spotify Way Squad Squad Squad Squad Squad Squad Squad Squad
  • 37.
    38 Lean Startup –Take Aways One wants as many independent teams as required to run independent topics in parallel Dev Teams should never ever be exposed to customers directly, they do 3rd level support only Custo- mer Deploy. Refined design Most of the time, a team should have 1 or 2 core focus at a time, typically a long term focus and some more short term fillers. Support Functions : Customer 1st level support, 2nd level support, HR, Management, etc. A feature being given to 1 autonomous team, and that team being able to work without interruption, Team Sprint Velocity enables to do forecasting. A Feature Team implements a Feature from A to Z, where Z is release / deployment to the customer, independently and autonomously. The rule is : as soon as a team has any dependency on another team, estimations and forecasts are not reliable anymore ! (multi-team consolidated planning and forecasting is a much more difficult game !) A to Z includes everything: 3rd level support, documentation, automated tests, code review, IT testing, Acceptance Testing, Release, Deploy, Deployment automation, etc. ➔ EVERYTHING (… DoD) Because the team is autonomous and independent, it’s own planning and forecasts are reliable.
  • 38.
  • 39.
    40 DevOps in anutshell Key For Planning
  • 40.
    41 Infrastructure as Code Cloud, Containeror VM Instantiation OS Installation System Installation / Configuration Application / Service Deployment / Orchestration • Capistrano • Scripts / Python • Jenkins • Maven • Specific tools • Chef • Puppet • Ansible • Red Hat Satellite • Vagrant • OpenStack • VMWare Vcloud • Docker • OpenShift • ExaLogic • Kubernetes CMDB - Configuration Management Database (All of this is versionned under SVN, git, …) Application Deployment Deploy application code … and rollback Configure resources (RDBMS, etc.) Start applications Join clusters System Configuration JVM, app servers … Middlewares … Service configuration (logs, ports, user / groups, etc. Registration to supervision Machine Installation Virtualization Self-Service environments
  • 41.
    42 The more oftenyou deploy, the more you master the deployment process and the better you automate it. If you have to do something 3 times a day, you will make it bullet proof and reliable soon enough, when you will be fed up of fixing the same issues over and over again. The more often you deploy, the smallest will be the changesets you deploy and hence the smallest will be the risk of something going wrong, or the chances of losing control over the changesets The more often you deploy, the best will be your TTR (Time to Repair / Resolution) Key for Planning ! You don’t want to loose time on Deployment You want deployment to be automated You want deployment and production release to happen without you even noticing Key to avoid multiple team synchronization Continuous Delivery – “If it hurts, do it more often” (Source : Ops Meta-Metrics: The Currency You Pay For Change - http://fr.slideshare.net/jallspaw/ops-metametrics-the-currency- you-pay-for-change-4608108)
  • 42.
    43 Continuous integration ofboth the software components development as well as the platform provisioning and setup. TDD - Test Driven Development. This is questionable ... But in the end let's face it: TDD is really the single and only way to have an acceptable coverage of the code and branches with unit tests (and unit tests makes is so much easier to fix issues than integration or functional tests). Code reviews ! At least code reviews ... pair programming would be better of course. Continuous auditing software - such as Sonar. Functional testing automation on production-level environment Strong non-functional testing automation (performance, availability, etc.) Automated packaging and deployment, independent of target environment Continuous Delivery requirements
  • 43.
    44 "Zero Downtime Deployment(ZDD) consists in deploying a new version of a system without any interruption of service.“ ZDD consists in deploying an application without interruption of service in such a way that one introduces a new version of an application to production without making the user see that the application went down in the meantime. From the user's and the company's point of view it's the best possible scenario of deployment since new features can be introduced and bugs can be eliminated without any outage. I'll mention 3 techniques: Feature Flipping ➔ Key for Continuous Deployment Shippable version at the end of every sprint Multi-sprint developments become possible without harming Continuous delivery Blue/Green Deployments Canari release Zero Downtime Deployments
  • 44.
    45 Feature flipping allowsto enable / disable features while the software is running. It's really straightforward to understand and put in place: simply use a configuration properly to entirely disable a feature from production and only activate it when its completely polished and working well. For instance to disable or activate a feature globally for a whole application: Or if one wants to do it on a per-user basis: Feature flipping
  • 45.
    46 Blue/Green Deployments consistsin building a second complete line of production for version N + 1. Both development and operation teams can peacefully build up version N + 1 on this second production line. Whenever the version N + 1 is ready to be used, the configuration is changed on the load balancer and users are automatically and transparently redirected to the new version N + 1. At this moment, the production line for version N is recovered and used to peacefully build version N + 2. And so on. Blue/Green Deployments (Source : Les Patterns des Géants du Web – Zero Downtime Deployment - http://blog.octo.com/zero-downtime- deployment/)
  • 46.
    47 Canari release isvery similar in nature to Blue/Green Deployments but it addresses the problem to have multiple complete production lines. The idea is to switch users to the new version in an incremental fashion : as more servers are migrated from the version N line to the version N + 1 line, an equivalent proportion of users are migrated as well. At first, only a few servers are migrated to version N + 1 along with a small subset of the users. This also allows to test the new release without risking an impact on all users. When all servers have eventually been migrated from line N to line N + 1, the release is finished and everything can start all over again for release N + 2. Canari Release (Source : Les Patterns des Géants du Web – Zero Downtime Deployment - http://blog.octo.com/zero- downtime-deployment/)
  • 47.
    48 DevOps – TakeAways Custo- mer Deploy. Automated tests – End-to-End tests – on integration and tests environment are key to avoid debugging sessions and production regressions. Infrastructure as Code enables to streamline and automated end-to-end tests on production-like test environments and is key to Continuous Delivery. Finally, Automated tests should validate non-functional requirements. Stop the world Release N Stop the world Release N + 1 Releasing / Deploying to customer has to be a marginal, one-day, push-a-button event. Continuous Delivery techniques are absolutely key to avoid stop-the-world releases / deployments which breaks the team independence and autonomy, which, again, is absolutely key to have accurate forecasts. Just as TDD eliminates unpredictable development-related tasks, Continuous Delivery and ZDD techniques enable to eliminate unpredictable deployment-related tasks. X X
  • 48.
    49 2.B – The3 Horizon Framework
  • 49.
    50 Business Economics The needfor innovation Technological Progress Cumulative Effort Technology S-curve Technology Profit Curve Profit Time
  • 50.
    51 The 3 Horizonmodel (McKinsey) The 3 horizons model is a growth strategy framework by McKinsey that you can use to think about the future of your company. Value Time / Effort H1 1-2 years H2 2-4 years H3 3-5 years Technology S-curve Technology Profit Curve Horizon 1 Maintain & strengthen core business Horizon 2 Explore & discover emerging expansions / opportunities Horizon 3 Create genuinely new businesses / competencies / possibilities
  • 51.
    52 The 3 Horizonmodel (McKinsey) Value Time H1 H2 H3 Horizon 1 Maintenance, functional evolutions, Project Gaps The first horizon involves implementing innovations that improve current operations Horizon 2 Product & Technology Evolutions Horizon 2 innovations are those that extend your current competencies into new, related markets. Horizon 3 Disruption, new technologies, new product Horizon 3 innovations are the ones that would change the nature of your industry and generate new competencies NG : now – 18 months NG : 6 – 24 months NG : 1 – 3 years
  • 52.
    53 A sound approachto Product Management Value Time H1 H2 H3 NG : now – 18 months NG : 6 – 24 months NG : 1 – 3 years Current Backlog H1 H1 H1 H1 H1 H1 H1 H1 H1 H1 H1 H1 H2 H2 H2 H2 H2 H2 H2 H2 H2 H3 H3 H3 H3 H3 H3
  • 53.
    54 3 Horizon Framework– Take Aways Multiple Teams enable to spread workload among the 3 horizons (fair share) Some epics / stories - often related to projects - can sometimes not be estimated properly because the scope is blurry. In this case we take reserve. Some backlog fillers - small tasks - are used to fill in the gaps Type of Stories / Epics on the roadmap - Product evolutions (PMC) - Functional evolutions (PMC, BA, PO) - Technology evolutions and maintenance (CTO) - Projects Gaps (Delivery) - Evolution / Improvement batches (Delivery, Sales, R&D, etc.) ➔ Granularity has to be "large topics" or "important topic" or customer / delivery commitments Multiple small tasks in H1 – delivery wishes, minor bug corrections, cosmetic changes, UX improvements, small evolutions – etc, are grouped together by theme and scope in an Evolution batch. The Evolution batch is then prioritized and scheduled as a consistent unit. Have the Teams switch / rotate between H1 / H2 / H3 to avoid frustration
  • 54.
    55 2.C – TheEstimation Process
  • 55.
    56 Key Product-related Roles ProductManager(s) ➔ Marketing / Corporate Function • Product Marketing / Market studies • Voice of customers / market • Animates PMC • Roadmap Maintenance • Story Map Product Owner(s) ➔ Dev Team Function • Represents / Liaise with PMC • Business Analysis • Acceptance Tests • Release Management • Backlog prioritization • Release Notes • Development Story Specification Team Leader(s) • Liaise with Product Owner • Fill-in Team Sprint backlog • Animates team rituals • Dev Team Management (People Management) Architect(s) / UX / Data Science • Functional / Application Architecture • Technical / System Architecture • User Experience • Data Architecture • Epic Specification • Epic Breakdown in Dev Tasks • Tasks Estimation Tech Lead • Application / Technical Design • Developer support • Epic Specification • Epic Breakdown in Tasks • Tasks Estimation Developers… • Full-stack development • Operation Automation • Deployment Automation • Documentation • Support CTO - Architecture Lead - Voice of technology - Software Development Methodology guarantor - Cloud Operations Management - Animates ARCHCOM + of course 1st Level support / 2nd Level support / Scrum Master / Perhaps Cloud Operations / etc.
  • 56.
    57 Key Rituals Product ManagementCommittee - PMC Product Manager(s) Product Owner(s) Head of Sales CTO Preparation: PM collects opportunities and needs Walkthrough: Promote / Eliminate / Prioritize Evolutions Offline: PM prepares User stories Offline: later, continuously, collect estimations then update roadmap Architecture Committee - ARCHCOM Preparation: CTO and Product Owner creates Epics corresponding to stories Walkthrough: N: Dispatch epics to be specified Offline: review specifications and comment / challenge N + 1: discuss comments and amend Offline: breakdown in tasks, tasks estimation Product Owner(s) Team Leader(s) CTO Architect(s) Tech Lead + of course TechCom / Sprint planning / Sprint retro / Daily scrum / Delivery Rituals / Management Rituals (O3s) / etc.
  • 57.
    58 A typical developmentmonth Monday Tuesday Wednesday Thursday Friday Sat Sun Sprint planning Sprint Retro Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Daily Scrum Sprint planning Sprint Retro Test Deployment Sprint N Sprint N+1 ARCHCOM ARCHCOM ARCHCOM ARCHCOM PMC Test Deployment Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. Integration Depl. UX Committee UX Committee Tech Committee Tech Committee Integration Depl. Integration Depl. ARCHCOM PMC UX Committee Tech Com. Cross-team meetings (company wide): All these rituals are prepared in advanced by all participants! Rituals are clearly and consistently scheduled / no unforeseen interruption of sprint Delivery Project Gaps Review Proj. Gaps Rev.
  • 58.
    59 The Estimation Process Story Loremipsum dolor sit amet, consectetur adipiscing elit, sed … Detailed Story Lorem ipsum dolor sit amet, consectetur adipiscing elit, sed do eiusmod tempor incididunt ut labore et dolore magna aliqua. Ut enim … Development Epic Lorem ipsum dolor sit amet, consectetur adipiscing elit, sed do eiusmod tempor incididunt ut labore et dolore magna aliqua. Ut enim ad minim veniam, quis nostrud exercitation ullamco laboris nisi ut aliquip ex ea commodo consequat. Duis aute irure dolor in reprehenderit in voluptate velit esse cillum dolore eu fugiat nulla pariatur. Excepteur sint occaecat cupidatat non proident, sunt in culpa qui officia deserunt mollit anim id est laborum. Task Lorem ipsum dolor sit amet, consectetur adipiscing elit, sed … Task Lorem ipsum dolor sit amet, consectetur adipiscing elit, sed … Task Lorem ipsum dolor sit amet, consectetur adipiscing elit, sed … Specification & Design Process Estimation Process PMC PM PO CTO / / PM PO / Roadmap Tm. L PO CTO / Archi. / / CTO ARCHCOM Tm. L Archi. CTO Tk. L Delivery wishes Task Task Task Development Epic Story ARCHCOM Specification Design Estimations Planning 21 34 55 110 110 Product Management R&D Tk. L Developers PM PM PO CTO / PO CTO / UPDATES!
  • 59.
    60 Picking-up the extremesmakes only little sense : people are sick, leaves on holidays, some big task gets finished the next sprint, etc ➔ So we should pick up the second and last-but-one. This gives us a lower range and an upper range ➔ Using a range addresses uncertainty (REMINDER) Team Sprint Velocity   Uncertainty 138 128 Story Points Sprint
  • 60.
    61 Range is usedthis way: In case of fixed time, when we have a fixed delivery date, the lower and upper values give us the minimum or maximum set of features we can have implemented at that date. In case of fixed scope, when we have to release a version of the software with a given set of features, the lower and upper values are used to compute earliest or latest release date We now have everything we need for accurate estimations (REMINDER) Forecasting Story Points Months Team. L PO /
  • 61.
    62 Estimation game –Take Aways We can compute the Team Sprint Velocity In this model, Project Gaps are the only items with hard commitment. A Delivery project being planned and with a Go-Live date, the related deliverables due date has to be respected. When designing the roadmap, these are put first and can’t be moved afterwards (frozen items) 120 150 110 180 170 The estimation game tells us the total story points for this Story. With the team capacity, it can be planned in terms of number of sprints, assuming 2 sprints per month. The keyword here is reserve, reserve and more reserve. D D D D D D These batches are where we have some flexibility for urgent stuff popping up! Fixed scope: keep all tasks in the batch and add new stuff. Fixed date (fixed roadmap): add new stuff and remove an equal amount of SP
  • 62.
  • 63.
    64 Now about thetimeline PRODUCT VISION Product Vision Statement * Updated 30 April 2021, subject to change without notice Outcome Roadmap - Up To 2023 Team May Jun Jul -Q3/2021 Q4/2021 H1/2022 H2/2022 2023 Research Analytics prototype 1 Analytics Research 1 Analytics Research 2 Analytics Proto. 2 Analytics Res. 3 Software Technology Research 1 Software Technology Research 2 Dev FT 1 H2 Evolution 1 Project C Gaps Project E Gaps H2 Evolution 4 H1 Evolutions batch 4 Dev FT 2 Project A Gaps H2 Evolution 3 H3 Evolution 3 H1 Evolutions Batch 1 Project D Gaps Dev FT 3 Project B Gaps H3 Evolution 1 H1 Evolutions Batch 2 Dev FT 4 H2 Evolution 2 H3 Evolution 2 H1 Evolutions Batch 3 Project E Gaps H2 Evolution 5
  • 64.
    65 Short-term vs. Long-termcommitments Outcome Roadmap - Up To 2023 Team May Jun Jul -Q3/2021 Q4/2021 H1/2022 H2/2022 2023 • Hard commitment - no slippage should occur • due dates are respected / fixed • Scope can evolve (support, critical bug fixes, etc.), in which case tasks of lesser priority can be postponed • Transparent communication to delivery, sales, customers, etc. • Strong commitment – slippage should support business opportunities • Opaque communication • Soft commitment – this can really change entirely if required • Cautious communication • Internal only • No commit- ment • No commu- nication Month Granularity Quarter Semester Year
  • 65.
    66 Timeline evolution April Roadmap OutcomeRoadmap - Up To 2023 Team May Jun Jul -Q3/2021 Q4/2021 H1/2022 H2/2022 2023 May Roadmap Outcome Roadmap - Up To 2023 Team Jun Jul Aug Sep Q4/2021 H1/2022 H2/2022 2023 Jun Roadmap Outcome Roadmap - Up To 2023 Team Jul Aug Sep Q4/2021 Q1/2022 Q2/2022 H2/2022 2023 M+1 M+1 Oct Roadmap Outcome Roadmap - Up To 2024 Team Nov Dec Jan/2022 -Q1/2022 Q2/2022 H2/2022 H1/2023 H2/2023 – H1/2024 M+4
  • 66.
    67 “Stop the world”refactoring or technology evolutions ? Feature flipping, API versioning, library versioning, etc. If a “stop-the-world” refactoring or evolution can’t be avoided, it needs to be planned and accounted in the roadmap (big vertical box) Kaizen burst Every end of quarter PMC starts with a Quarter retrospective Challenge everything ! Delivery SaaS : continuous deployment On-premise deployment continuous delivery, periodic end customer releases. Migration is a concern. Specific rituals are required between PM and Delivery Teams ➔ Doesn’t change a whole lot of things for planning Other aspects
  • 67.
    68 SaaS / Cloud/ Web deployment Amazon - Continuous Deployment in production - Code is being deployed in production every 11.7 seconds on average. - Continuous Deployment in production - Devs push code to production thousands of times per day! - Develop for failure - Chaos monkeys randomly kills services and machines continuously Facebook - Continuous Deployment in production - Before 2016, - Up to 3 release trains a day - Cherry pick (manual) / periodic resync - Since 2016 - Release train every few hours - Push from master
  • 68.
    69 On premise deployments 8.3-SN. 14329 8.3-SN. 14361 8.3-SN. 14398 R 8.3 8.4-SN. 14475 R 8.4 BB R 8.5 R 8.6 R 9 B B B B B B End of Sprint Release - Internal Release / Automated deployment on Test Env. Customer Release - Official Release / Deployable and versioned package with release notes, etc.
  • 69.
    70 3. Take Awaysand other models
  • 70.
    71 Take Aways XP • TDD/ Tests Coverage • On-site customer (Product Owner ) • Code Reviews • Sustainable Pace • Small Releases (Continuous Delivery) • Acceptance tests • Planning Game Scrum • DoD - Definition of Done • Sprint planning / Spring Retro • Daily Scrum • Product Increment (Continuous Delivery) • Estimation Game / Planning Poker / SP • Product Backlog • Team Velocity • Product Owner Lean Startup • Pizza Teams • Feature Teams • Feedback Loop DevOps • Automated Provisioning • ZDD • Feature Flipping • Automated Releases • Continuous Delivery Product Management • Story Mapping • PMC • Product Vision • Roadmap Maintenance Reliable Roadmap
  • 71.
    72 Required Tools Need ToolDescription Collaborative source code development git Need to be able to have a large number of concurrent branches and convenience for managing them. Feature Branches and Code reviews Gitlab (or gitbucket, etc.) Enforcing code reviews Merge request / Pull requests. Comments arbitration, conflicts resolution, etc. Continuous Integration and automated tests Gitlab CI (or jenkins, etc.) Integration test suite on every branch at every commit, full automated tests twice a day. Deployment Automation Integration deployment twice a day, test deployment end of every sprint, environment promotion, etc. Sprint backlog management Jira Sprint Kanban board, Sprint burndown chart, etc. Product Backlog Management Product backlog, Stories, Epics and task specification and relations, priorities management, etc. Documentation as Code ASCIIDoc Version-able documentation and editing integrated in development processes End-to-End tests Selenium (or Protractor, etc.) Production-like environment non-regression tests Infrastructure as Code Ansible (or Chef, Puppet) Environment provisioning, automated installation and deployment. Database migration Liquibase Automated DB updates Code quality Sonar Code Quality guarantee Development Manifesto Wiki (e.g. confluence, etc.) Document your culture, values, organization, principles and practices (light !) Planning Poker www.pointingpoker.com Distributed planning poker app Kanban / Visual Board Trello (or MS Planner, etc.) ARCHCOM Topics, discussion topics, prioritization games, etc. Agenda Outlook Rituals over processes Roadmap Powerpoint / Excel If you need more than excel or Powerpoint to draw your roadmap, then your roadmap is not the right one. Plenty of others …
  • 72.
    73 Other Model :Holacracy Every Team is a Project team - Circle (ultimate Feature Team); there are transverse projects Every Team – Circle - has its own culture, organization, processes, rituals, tools, etc. as require to fulfill its objectives and purpose Governance – where dependencies and streams between Teams – Circles – are defined is key (and tricky) (from https://www.tealschool.se/2019/07/12/holacracy-for-schools/)
  • 73.
    74 Other models Fixed time– fixed release dates roadmap Flexible / variable scope Commitment comes from identifying the subset of stories we have to stick to and the ones that are fillers Fixed scope – fixed content releases Flexible release dates Other aspects … Management 3.0 Google-like Office space Scaling Agile Other aspects / final notes
  • 74.
