Construction Contracts Applied Program- CCAP Module 1010 –R1 2020

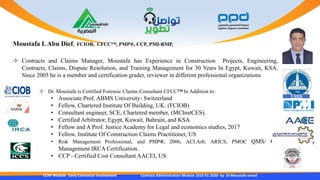

‫د‬.‫م‬/‫أبوضيف‬ ‫إسماعيل‬ ‫مصطفى‬
Dr. Eng. Moustafa I. Abu Dief, FCIOB, CFCC™, PMP®, CCP, PMI-RMP,
Construction claims mitigation through Early Contractor Involvement
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
 Contracts and Claims Manager, Moustafa has Experience in Construction Projects, Engineering,
Contracts, Claims, Dispute Resolution, and Training Management for 30 Years In Egypt, Kuwait, KSA.
Since 2005 he is a member and certification grader, reviewer in different professional organizations
Moustafa I. Abu Dief, FCIOB, CFCC™, PMP®, CCP, PMI-RMP,
 Dr. Moustafa is Certified Forensic Claims Consultant CFCC™ In Addition to:
• Associate Prof. ABMS University- Switzerland
• Fellow, Chartered Institute Of Building, UK. (FCIOB)
• Consultant engineer, SCE, Chartered member, (MCInstCES).
• Certified Arbitrator, Egypt, Kuwait, Bahrain, and KSA
• Fellow and A Prof. Justice Academy for Legal and economics studies, 2017
• Fellow, Institute Of Construction Claims Practitioner, US
• Risk Management Professional, and PMP®, 2006, ACI.Arb, ARICS, PMOC QMS/ Qa
Management IRCA Certification.
• CCP - Certified Cost Consultant AACEI, US.
1988
Early Contractor Involvement
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail

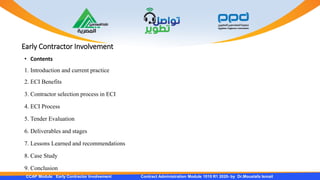

• Contents
1. Introduction and current practice
2. ECI Benefits
3. Contractor selection process in ECI
4. ECI Process
5. Tender Evaluation
6. Deliverables and stages

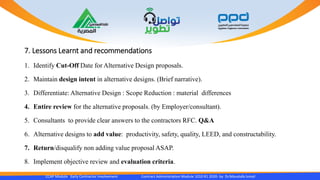

7. Lessons Learned and recommendations
8. Case Study
9. Conclusion

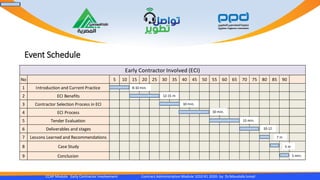

Event Schedule
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
No 5 10 15 20 25 30 35 40 45 50 55 60 65 70 75 80 85 90
1 Introduction and Current Practice
2 ECI Benefits
3 Contractor Selection Process in ECI
4 ECI Process
5 Tender Evaluation
6 Deliverables and stages
7 Lessons Learned and Recommendations
8 Case Study
9 Conclusion
Early Contractor Involved (ECI)
8-10 min.
12-15 m
10 min.
10 min.
15 min.
10-12
7 m
5 min.
5 m
Construction Industry
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail

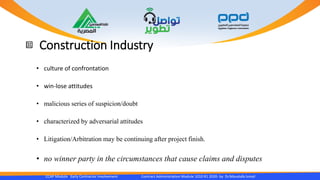

• culture of confrontation
• win-lose attitudes
• malicious series of suspicion/doubt
• characterized by adversarial attitudes
• Litigation/Arbitration may be continuing after project finish.
• no winner party in the circumstances that cause claims and disputes
Construction Industry
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
• Is It beneficial endeavor to the project stakeholders?
• OR needs for a change-to a more cooperative and collaborative approach to build
win/win, mutual trust, respect, good faith, and continuous commitment.
Claims Types in Construction Industry
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫قيمة‬ ‫انها‬ ‫علي‬ ‫الهندسية‬ ‫العقود‬ ‫في‬ ‫المطالبات‬ ‫تعريف‬‫يطالب‬
‫في‬ ‫تؤخذ‬ ‫لم‬ ‫إضافية‬ ‫أعباء‬ ‫عن‬ ‫كتعويض‬ ‫المقاول‬ ‫بها‬
‫تنفي‬ ‫جاري‬ ‫لمشروع‬ ‫المقاولة‬ ‫عقد‬ ‫توقيع‬ ‫عند‬ ‫االعتبار‬‫ذه‬.
Not Change order- Not IPC
(‫كتاب‬‫المطالبات‬‫في‬‫العقود‬‫الهندسية‬)

Claims Types according to liability
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail

Claims and Questioned Articles in Contracts
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫نماذج‬‫إللتزامات‬‫أطراف‬‫العقد‬
‫عقد‬‫األشغال‬‫السعودى‬-‫الشــــــروط‬‫العامــــــــة‬:‫فى‬‫حالة‬‫وجود‬‫مصمم‬-‫منافسة‬‫وعطاءات‬-‫مقاول‬‫تنفيذ‬
‫المادة‬‫رقم‬(10):‫معاينة‬‫الموقع‬
10/1‫على‬‫المقاول‬‫أن‬‫يقوم‬‫على‬‫حسابه‬‫الخاص‬‫بفحص‬‫ومعاينة‬‫الموقع‬‫واألماكن‬‫المحيطة‬‫به‬‫وأن‬‫يتأكد‬‫بنفسه‬‫وقبل‬‫تقديم‬‫ا‬‫لعطاء‬‫من‬‫شكل‬
‫الموقع‬‫وطبيعة‬‫تربته‬‫والقيام‬‫بعمل‬‫الحسابات‬‫والثقوب‬‫التي‬‫تمكنه‬‫من‬‫ذلك‬‫وكذلك‬‫يقوم‬‫بمراجعة‬‫كميات‬‫العمل‬‫وطبيعته‬‫والمو‬‫اد‬‫الالزمة‬‫إلنجاز‬
‫األعمال‬‫ووسائل‬‫الوصول‬‫إلى‬‫الموقع‬‫والمرافق‬‫التي‬‫يحتاج‬‫إليها‬‫وعليه‬‫بصورة‬‫عامة‬‫أن‬‫يحصل‬‫لنفسه‬‫على‬‫سائر‬‫المعلومات‬‫الضر‬‫ورية‬‫وغيرها‬
‫من‬‫العوامل‬‫التي‬‫قد‬‫تؤثر‬‫على‬‫عطائه‬.
Claims and Questioned Articles in Contracts
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫نماذج‬‫إللتزامات‬‫أطراف‬‫العقد‬
‫عقد‬‫األشغال‬‫السعودى‬-‫الشــــــروط‬‫العامــــــــة‬:‫فى‬‫حالة‬‫وجود‬‫مصمم‬-‫منافسة‬‫وعطاءات‬-‫مقاول‬‫تنفيذ‬
‫المادة‬‫رقم‬(10):‫معاينة‬‫الموقع‬
10/2‫يعتبر‬‫المقاول‬‫مسئوال‬‫عن‬‫مراجعة‬‫التصميمات‬‫الهندسية‬‫والفنية‬‫بكامل‬‫تفاصيلها‬‫وعليه‬‫إبالغ‬‫اإلستشاري‬‫أو‬‫صاحب‬‫العمل‬‫عن‬‫أية‬
‫أخطاء‬‫أو‬‫مالحظات‬‫يكتشفها‬‫في‬‫المخططات‬‫والرسومات‬‫أثناء‬‫التنفيذ‬.
‫اكتشف‬‫األمر‬:‫َف‬‫ش‬‫ك‬‫د‬ْ‫ه‬ُ‫ج‬‫ال‬ ‫من‬ ‫بشيء‬ ‫عنه‬

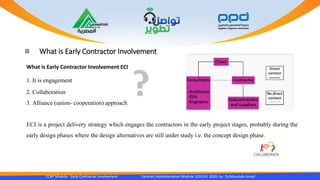

What is Early Contractor Involvement
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
What is Early Contractor Involvement ECI
1. It is engagement
2. Collaboration
3. Alliance (union- cooperation) approach
ECI is a project delivery strategy which engages the contractors in the early project stages, probably during the
early design phases where the design alternatives are still under study i.e. the concept design phase.

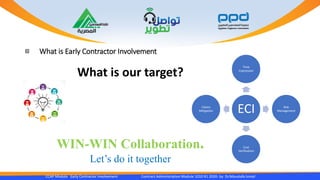

What is Early Contractor Involvement
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
What is our target?
WIN-WIN Collaboration.
Let’s do it together
ECI
Time
Copression
Risk
Management
Cost
Verification
Claims
Mitigation
What is Early Contractor Involvement
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
What is our target?
WIN-WIN Collaboration.
Let’s build the barriers together
1. Introduction and current practice
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail

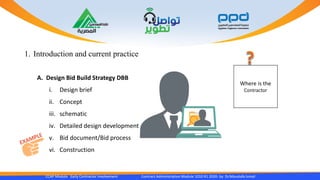

A. Design Bid Build Strategy DBB
i. Design brief
ii. Concept
iii. schematic
iv. Detailed design development
v. Bid document/Bid process
vi. Construction
Where is the
Contractor
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail

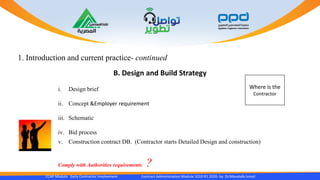

B. Design and Build Strategy
i. Design brief
ii. Concept &Employer requirement
iii. Schematic
iv. Bid process
v. Construction contract DB. (Contractor starts Detailed Design and construction)
Comply with Authorities requirements. ?
Where is the
Contractor
1. Introduction and current practice- continued
2. Purposes for ECI
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
i. Early Start V. Claims and Risk Mitigation
ii. better financing cost
iii. Lower Construction / Pricing as the contractor have lower risk and contingencies to consider in
their pricing/ Lean construction cost (no or less buffer).
iv. Design alternatives
v. Constructability management
vi. Time management- Fast track and partial start enabling.

 Estimation Buffers
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
(no or less buffer).
RITA
2.1 ECI Benefits
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
i. To utilize the Contractors experience in:
 Field of constructability
 Design alternatives
 Construction planning
 Value management and VE
 Construction alternatives and technologies
 Project sequencing, scheduling

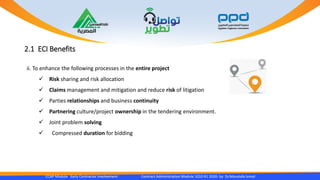

2.1 ECI Benefits
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
ii. To enhance the following processes in the entire project
 Risk sharing and risk allocation
 Claims management and mitigation and reduce risk of litigation
 Parties relationships and business continuity
 Partnering culture/project ownership in the tendering environment.
 Joint problem solving
 Compressed duration for bidding

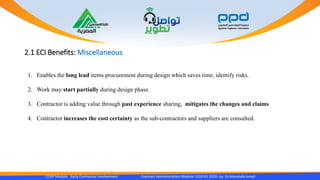

2.1 ECI Benefits: Miscellaneous
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
1. Enables the long lead items procurement during design which saves time, identify risks.
2. Work may start partially during design phase.
3. Contractor is adding value through past experience sharing, mitigates the changes and claims
4. Contractor increases the cost certainty as the sub-contractors and suppliers are consulted.

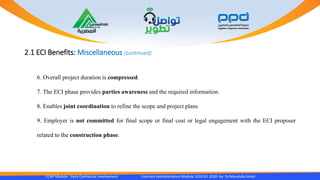

2.1 ECI Benefits: Miscellaneous (continued)
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
6. Overall project duration is compressed.
7. The ECI phase provides parties awareness and the required information.
8. Enables joint coordination to refine the scope and project plans
9. Employer is not committed for final scope or final cost or legal engagement with the ECI proposer
related to the construction phase.
2.1.1 ECI Benefits in different contract strategies
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
Model ECI Inputs by Builders
1 Design & Build (D&B) - single
point of responsibility
Develop complete design package based on employer
design requirements and concept design by the employer
2 Design Bid Build with Early
Contractor Involvement (DBB-ECI)
Provide alternative design solution(s) based on complete
design and focus missing information, discrepancies,
deficiency in design.

2.2 ECI Features in different contract strategies
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
Model ECI Advantages Disadvantages
1 Design Bid
Build with
Early
Contractor
Involvement
(DBB-ECI)
• Complete design control by the
employer
• Contractor may have inputs
into design during tender
stage.
• Tender process is controlled
by employer.
• Limited contractor
involvement. to optional
proposals.
• Potential limited cost/time
savings due to Contractor’s inputs
2.2 ECI Features in different contract strategies
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
Model ECI Advantages Disadvantages
2 Design and
built strategy-
DB
• Single point of responsibility
• Contractor is enabled to contribute to
design stages
• Effective budgeting and cost elements
utilization.
• Employer bears the responsibility of
preparing concept design, employer
requirements, tender package, and
contract administration either in
house or through a consultant.
• Time savings because of shorter
construction time, although longer
tendering time.
• Various proposals are submitted
and rigorous evaluation of bids.
• Employer has no control of detailed
design as consultants are engaged by
Contractor/design builder.
15
IN DB
employer
should not
go beyond
concept
design/
retransfer
the design
risk
3. Contractor/Contract Type Selection
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
Consequent approach

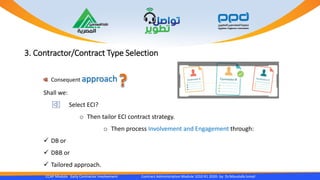

Shall we:
Select ECI?
o Then tailor ECI contract strategy.
o Then process Involvement and Engagement through:
 DB or
 DBB or
 Tailored approach.
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail

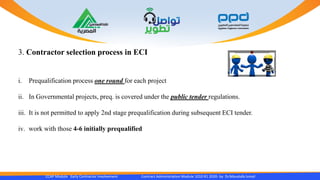

3. Contractor selection process in ECI
i. Prequalification process one round for each project
ii. In Governmental projects, preq. is covered under the public tender regulations.
iii. It is not permitted to apply 2nd stage prequalification during subsequent ECI tender.
iv. work with those 4-6 initially prequalified
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
3. Contractor selection process in ECI
iv. Certain criteria to be adopted, those may include:
 Financial Strength,, Resources & Capabilities, Relevant experience, and contractor work load.
 Claims/litigation history ( 3years)
 Ability for innovation and alternative design solution (Allocate Weightage for cost saving
attribute).
 Social values commitment
 Sustainable procurement commitment

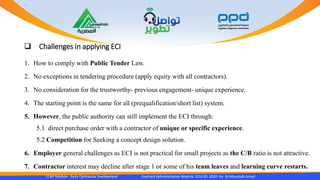

Short listed
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail

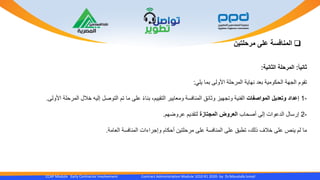

2 Stage
tendering in KSA
Procurement
Law
‫المادة‬ ‫النظام‬31
‫التنفيذية‬ ‫الالئحة‬
‫المادة‬42
For Risk Seeker only
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫مرحلتين‬ ‫على‬ ‫المنافسة‬
‫النظام‬‫الباب‬|2‫أساليب‬‫التعاقد‬31-‫الفصل‬|3‫المنافسة‬‫على‬‫مرحلتين‬
•‫للجهة‬‫الحكومية‬‫طرح‬‫المنافسة‬‫على‬‫مرحلتين‬‫إذا‬‫تعذر‬‫تحديد‬‫المواصفات‬‫الفنية‬‫والشروط‬‫التعاقدية‬‫النه‬‫ائية‬‫ًا‬‫د‬‫تحدي‬‫كام‬ً‫ال‬
‫؛‬ً‫ا‬‫ودقيق‬‫بسبب‬‫الطبيعة‬‫المعقدة‬‫والتخصصية‬‫لبعض‬‫األعمال‬‫والمشتريات‬ً‫ا‬‫وفق‬‫لما‬‫توضحه‬‫الالئحة‬.
•‫الالئحة‬:‫مع‬‫مراعاة‬‫ما‬‫ورد‬‫في‬‫المادة‬(‫الحادية‬‫والثالثين‬)‫من‬،‫النظام‬‫تتم‬‫المنافسة‬‫على‬‫مرحلتين‬‫كالتالي‬:
ً‫أوال‬:‫المرحلة‬‫األولى‬:
-1‫تحدد‬‫وثائق‬‫المنافسة‬‫حاجة‬‫الجهة‬‫الحكومية‬‫والغرض‬‫من‬‫العقد‬‫واألداء‬‫المتوقع‬‫والمؤهالت‬‫المطلوبة‬‫إلنجاز‬‫األعمال‬
‫والمعلومات‬‫العامة‬‫ذات‬‫العالقة‬‫بالشروط‬‫والمواصفات‬‫وغيرها‬‫من‬‫الخصائص‬،‫الفنية‬‫سواء‬‫لألعمال‬‫المراد‬‫تنفيذها‬‫أو‬
‫المعدات‬‫والسلع‬‫المراد‬‫الحصول‬‫عليها‬.
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫مرحلتين‬ ‫على‬ ‫المنافسة‬-ً‫أوال‬:‫األولى‬ ‫المرحلة‬
2-‫يعلن‬‫عن‬‫المرحلة‬‫األولى‬‫في‬‫البوابة‬)‫منصة‬‫إعتماد‬)ً‫ا‬‫وفق‬‫إلجراءات‬‫إعالن‬‫المنافسة‬‫العامة‬.
3-‫تقدم‬‫عروض‬‫أولية‬‫في‬‫المرحلة‬‫األولى‬‫تتضمن‬‫اقتراحات‬‫المتقدمين‬‫من‬‫دون‬‫ذكر‬‫أسعار‬‫العروض‬.
4-‫باإلضافة‬‫إلى‬‫ما‬‫ورد‬‫في‬‫الفقرة‬(3)‫من‬‫هذه‬،‫المادة‬‫يجوز‬‫للجهة‬‫الحكومية‬‫أن‬‫تطلب‬‫من‬‫المتنافسين‬–‫دون‬‫إلزامهم‬‫بذلك‬-‫تقديم‬
‫أسعار‬‫استرشادية‬‫أو‬‫حدود‬‫سعرية‬‫لألعمال‬‫المراد‬‫تنفيذها‬(‫بغرض‬‫إسترشادى‬‫للمالك‬)،‫على‬‫أال‬‫يلزموا‬‫في‬‫المرحلة‬‫الثان‬‫ية‬‫بتعديل‬
‫عروضهم‬‫بما‬‫يتفق‬‫مع‬‫ما‬‫قدموه‬‫من‬‫أسعار‬‫استرشادية‬‫وحدود‬،‫سعرية‬‫أو‬‫أن‬‫تقيم‬‫عروضهم‬‫بناء‬‫عليها‬.(‫مقاومة‬‫من‬‫المقاولين‬).
-5‫يجوز‬‫للجهة‬‫الحكومية‬‫مناقشة‬‫مقدمي‬‫العروض‬‫الستيضاح‬‫ما‬‫ورد‬‫في‬‫العروض‬‫والمواصفات‬‫المقترحة‬‫وإجراء‬‫التغيير‬‫ات‬‫الالزمة‬
‫على‬‫المواصفات‬‫لتكون‬‫مقبولة‬‫وممكنة‬‫من‬‫الناحية‬‫العملية‬((Presentation،‫على‬‫أن‬‫تنشر‬‫تلك‬‫االستفسارات‬‫والتوضيحات‬‫في‬‫البو‬‫ابة‬
‫ويتاح‬‫لجميع‬‫مقدمي‬‫العروض‬‫االطالع‬‫عليها‬.
-6‫تعلن‬‫العروض‬‫التي‬‫اجتازت‬‫المرحلة‬‫األولى‬‫في‬‫البوابة‬‫اإللكترونية‬.
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫مرحلتين‬ ‫على‬ ‫المنافسة‬
‫ثانيا‬:‫المرحلة‬‫الثانية‬:
‫تقوم‬‫الجهة‬‫الحكومية‬‫بعد‬‫نهاية‬‫المرحلة‬‫األولى‬‫بما‬‫يلي‬:
-1‫إعداد‬‫وتعديل‬‫المواصفات‬‫الفنية‬‫وتجهيز‬‫وثائق‬‫المنافسة‬‫ومعايير‬،‫التقييم‬ً‫ء‬‫بنا‬‫على‬‫ما‬‫تم‬‫التوصل‬‫إليه‬‫خال‬‫ل‬‫المرحلة‬‫األولى‬.
-2‫إرسال‬‫الدعوات‬‫إلى‬‫أصحاب‬‫العروض‬‫المجتازة‬‫لتقديم‬‫عروضهم‬.
‫ما‬‫لم‬‫ينص‬‫على‬‫خالف‬،‫ذلك‬‫تطبق‬‫على‬‫المنافسة‬‫على‬‫مرحلتين‬‫أحكام‬‫وإجراءات‬‫المنافسة‬‫العامة‬.
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr. Moustafa Ismail
2 Stage
tendering in
KSA
Procurement
Law
‫المادة‬ ‫النظام‬31
‫التنفيذية‬ ‫الالئحة‬
‫المادة‬42
2 Stage competition as per KSA Public Tender Law - 2019
‫أن‬ ‫الحكومية‬ ‫للجهة‬ ‫4يجوز‬
‫ام‬‫ز‬‫إل‬ ‫–دون‬ ‫ن‬‫المتنافسي‬ ‫من‬ ‫-تطلب‬
‫حدود‬ ‫أو‬ ‫شادية‬ ‫ر‬‫است‬ ‫أسعار‬ ‫تقديم‬
‫ي‬
‫ن‬
‫ف‬ ‫يلزموا‬ ‫ل‬
ّ
‫أ‬ ‫عىل‬ ،‫لألعمال‬ ‫سعرية‬
‫بما‬ ‫عروضهم‬ ‫بتعديل‬ 2‫المرحلة‬
‫أو‬ ، ‫أسعار‬ ‫من‬ ‫قدموه‬ ‫ما‬ ‫مع‬ ‫يتفق‬
‫بناء‬ ‫عروضهم‬ ‫تقيم‬ ‫أن‬
) ‫ن‬‫المقاولي‬ ‫من‬ ‫عليها.(مقاومة‬
‫على‬ ‫تطبق‬ ،‫ذلك‬ ‫خالف‬ ‫على‬ ‫ينص‬ ‫لم‬ ‫ما‬
‫وإجراءات‬ ‫أحكام‬ ‫مرحلتين‬ ‫على‬ ‫المنافسة‬
.‫العامة‬ ‫المنافسة‬
‫المرحلة‬
‫األوىل‬
-‫وثائق‬ ‫تحدد‬
‫الجهة‬ ‫حاجة‬ ‫المنافسة‬
‫واألداء‬ ‫العقد‬ ‫من‬ ‫والغرض‬
‫المطلوبة‬ ‫والمؤهالت‬ ‫المتوقع‬
‫إلنجا‬‫العمل‬ ‫ز‬‫والشروط‬
-‫ف‬ ‫األولى‬ ‫المرحلة‬ ‫عن‬ ‫يعلن‬‫ي‬
‫البوابة‬)‫إعتماد‬ ‫منصة‬)ً‫ا‬‫وفق‬
‫المنافسة‬ ‫إعالن‬ ‫إلجراءات‬
‫العامة‬.
-‫في‬ ‫أولية‬ ‫عروض‬ ‫تقدم‬
‫تتضمن‬ ‫األولى‬ ‫المرحلة‬
‫من‬ ‫المتقدمين‬ ‫اقتراحات‬‫أسعار‬
‫الثانية‬ ‫االمرحلة‬
‫الجهة‬ ‫تقوم‬‫عند‬‫يلي‬ ‫بما‬ ‫األولى‬ ‫المرحلة‬ ‫نهاية‬:
-‫وثائق‬ ‫وتجهيز‬ ‫الفنية‬ ‫المواصفات‬ ‫وتعديل‬ ‫إعداد‬
‫التو‬ ‫تم‬ ‫ما‬ ‫على‬ ً‫ء‬‫بنا‬ ،‫التقييم‬ ‫ومعايير‬ ‫المنافسة‬‫إليه‬ ‫صل‬
‫خالل‬‫األولى‬ ‫المرحلة‬.
-‫المجتازة‬ ‫العروض‬ ‫أصحاب‬ ‫إلى‬ ‫الدعوات‬ ‫إرسال‬
‫عروضهم‬ ‫لتقديم‬.
‫للجهة‬ ‫يجوز‬‫مناقشة‬‫المتنافس‬‫ين‬
‫ال‬‫العروض‬ ‫في‬ ‫ورد‬ ‫ما‬ ‫ستيضاح‬
‫المقترحة‬ ‫والمواصفات‬‫وتعديل‬
‫مقبولة‬ ‫لتكون‬ ‫المواصفات‬‫و‬‫عم‬‫لية‬
(Presentation(‫أن‬ ‫على‬ ،
‫االستفسارات‬ ‫تلك‬ ‫تنشر‬
‫و‬ ‫البوابة‬ ‫في‬ ‫والتوضيحات‬‫ت‬‫ت‬‫اح‬
‫ل‬‫م‬‫العروض‬ ‫قدمي‬.
-‫اجتازت‬ ‫التي‬ ‫العروض‬ ‫تعلن‬
‫البوابة‬ ‫في‬ ‫األولى‬ ‫المرحلة‬
‫اإللكترونية‬.
ECI process- Best practice
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail

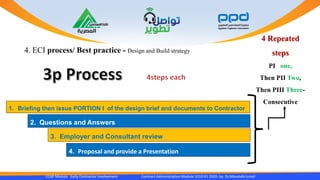

4. ECI process/ Best practice - Design and Build strategy
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
4. ECI process/ Best practice - Design and Build strategy
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
1. Briefing then issue PORTION I of the design brief and documents to Contractor
4 Repeated
steps
PI one,
Then PII Two,
Then PIII Three-
Consecutive
2. Questions and Answers
3. Employer and Consultant review
4. Proposal and provide a Presentation

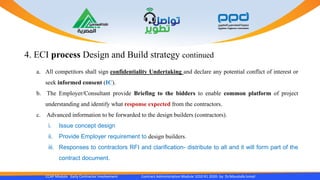

4. ECI process Design and Build strategy continued
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
a. All competitors shall sign confidentiality Undertaking and declare any potential conflict of interest or
seek informed consent (IC).
b. The Employer/Consultant provide Briefing to the bidders to enable common platform of project
understanding and identify what response expected from the contractors.
c. Advanced information to be forwarded to the design builders (contractors).
i. Issue concept design
ii. Provide Employer requirement to design builders.
iii. Responses to contractors RFI and clarification- distribute to all and it will form part of the
contract document.
4. ECI process - Design and Build strategy continued

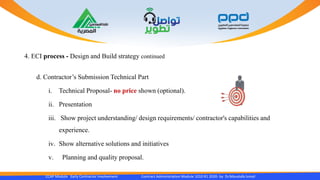

d. Contractor’s Submission Technical Part
i. Technical Proposal- no price shown (optional).
ii. Presentation
iii. Show project understanding/ design requirements/ contractor's capabilities and
experience.
iv. Show alternative solutions and initiatives
v. Planning and quality proposal.
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
5. ECI Tender Evaluation
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
Price and
Quality
Proposal are
60% and 40% of
the Combined
Score
respectively.
no Evaluation Criteria
1 Non Design Criteria
 Company/ project organization structure
 Risks and Safety management
 Social values commitment
2 Project Site
 Sustainable construction and Environment
 Site management/ traffic/ security
3 Facility/Building Layout/Design
 Functionality and efficiencies, value added.
 Internal Circulations
 Land scape external and internal
4 Building/facility envelop/ Form, Image
5 Quality of design: International codes- safety and security- expandable- maintenance concerns.
6 Structure system and constructability
7 Energy management and sustainability creative solutions
8 International accreditation i.e. LEED certified
9 Contractor presentation- effective- clear- understandable proposal
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail

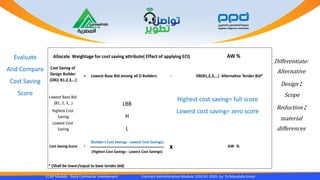

AW %
= Lowest Base Bid among all D Builders - DB(B1,2,3,…) Alternative Tender Bid*
Lowest Base Bid
(B1, 2, 3,..) LBB
Highest Cost
Saving H
Lowest Cost
Saving L
* (Shall be lower/equal to base tender bid)
Allocate Weightage for cost saving attribute( Effect of applying ECI)
x AW %=Cost Saving Score
Cost Saving of
Design Builder
(DB)( B1,2,3,…)
(Builder's Cost Savings - Lowest Cost Savings)
(Highest Cost Savings - Lowest Cost Savings)
Evaluate
And Compare
Cost Saving
Score
Differentiate:
Alternative
Design :
Scope
Reduction :
material
differences
Highest cost saving= full score
Lowest cost saving= zero score

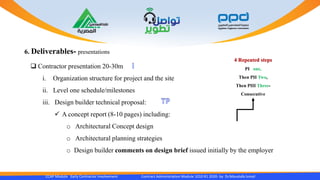

6. Deliverables- presentations
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
 Contractor presentation 20-30m
i. Organization structure for project and the site
ii. Level one schedule/milestones
iii. Design builder technical proposal:
 A concept report (8-10 pages) including:
o Architectural Concept design
o Architectural planning strategies
o Design builder comments on design brief issued initially by the employer
4 Repeated steps
PI one,
Then PII Two,
Then PIII Three-
Consecutive
6. Deliverables
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
 Contractor presentation continued
i. Contractor’s proposal which should contain:
 Schematic arc. designs including the feedback from P1 provided to the design builder.
 MEP package & structural conceptual design showing proposal constructability
 Incorporating maintenance, cost efficiency, expendability into the design concepts
 List of material and schedule of activities( high level BoQ)
 Design of functions, risk, and safety assessment
 Noise Management– internal/external
 H. Level Plan and Building Information Modeling (BIM)
 The builder comments and advice on Design Brief issued during P II
feedback from P1
6. Deliverables
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
 Contractor presentation (continued)
i. Complete over view to cape up the design topics including:
 Further Developed Design including all views and Sections
 Architectural, structural, and MEP detailed drawings (as advised) and RISK maturity.
 Design for safety, functional design, Constructability, potential value engineering.
 Table of details, windows, doors, finishes, and etc.
 Project schedule
feedback from P2
IN DB
employer
should not
go beyond
concept
design/
retransfer
the design
risk
 Two Stages contract strategy in practice (Summary)
• Employer invites (4-6) of qualified contractors for RFP based on concept design & employer requirement
• Employer selects the suitable proposals and negotiates with the potential contractors for a design and
build contract based on the contractor's screened proposal.
• Hence, employer enters with the selected contractor into an agreement for the design and build (or else
other) contract in two stages:
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
 Two Stages contract strategy (continued).
• 1st stage (cost plus agreement) is to provide descriptive Lump-sum priced proposal with a D&B
contract document and sufficient illustrative design that enables the employer for informed decision
based on their project perspective and needs, this stage is ECI.
• Further to the employer acceptance for the proposal and after due technical and commercial
negotiations, the employer may decide to enter an agreement for the second stage which
incorporates a LS- DB contract based on agreed contract document and the illustrative design where:
o the contractor develops the detailed design and construction drawings and BIM model (4D
– 5D- or else agreed).
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
 Challenges in applying ECI
1. How to comply with Public Tender Law.
2. No exceptions in tendering procedure (apply equity with all contractors).
3. No consideration for the trustworthy- previous engagement- unique experience.
4. The starting point is the same for all (prequalification/short list) system.
5. However, the public authority can still implement the ECI through:
5.1 direct purchase order with a contractor of unique or specific experience.
5.2 Competition for Seeking a concept design solution.
6. Employer general challenges as ECI is not practical for small projects as the C/B ratio is not attractive.
7. Contractor interest may decline after stage 1 or some of his team leaves and learning curve restarts.
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
7. Lessons Learnt and recommendations
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
1. Identify Cut-Off Date for Alternative Design proposals.
2. Maintain design intent in alternative designs. (Brief narrative).
3. Differentiate: Alternative Design : Scope Reduction : material differences
4. Entire review for the alternative proposals. (by Employer/consultant).
5. Consultants to provide clear answers to the contractors RFC. Q&A
6. Alternative designs to add value: productivity, safety, quality, LEED, and constructability.
7. Return/disqualify non adding value proposal ASAP.
8. Implement objective review and evaluation criteria.
7. Lessons Learnt and recommendations
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismailies
• ECI can be adopted in DBB, DB.
• Current Procurement culture needs adaptation
• Adopt to change the practice.
• Promotes Partnering in Tendering environment;
• Keep HSE, competitive, sustainable ethical tender environment
• ECI ensures:
 Enhanced greater productivity
 Higher understanding on scheduling of constructability matters
 Improves Contractors capabilities and understanding on the design & project execution
7. Lessons Learnt and recommendations (continued)
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
• Consider ECI for bigger projects ( 500.0 M SAR) and complicated projects.
• Shortlisted contractor’s 4-6.
• Mange confidentiality of the process/ design or alternative proposals to be protected.
• Reimburse the unsuccessful tenderers
• Look for incentives to attract the competent design builders for the mega and complicated
projects and change the culture of traditional bidders
A Comparison
between
Traditional
Bidders and
ECI
competitors
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
Particular Conventional Bid Competitors ECI Competitors
Information
exchange
Disputed consultant contribution for inconsistency and providing
informed decisions.
Consultants/Employer are responsible for providing
sufficient information
Project duration Time risk is identified and managed over the project phases Realistic schedule is expected as a result of ECI and joint
communication.
Demands on Time Flexible Bid time enables bidders to observe and self-
inspect their priorities.
Intensive tender documents require the bidder to allocate a
team.
Commitment Bidders’ commitments depend on the time available
(irregular commitment).
More commitment is mandated due to timely
deliverables for Bid package.
Tendering Costs Bidders have different options to select their target bids The bidders are committed to one bid- ECI- meaning high
opportunity cost; also assigned team cost.
Involve sole contractor and incentify him.
Reliability of Proprietary
Information
The bidders may need to disclose their own information
as the case may be.
The bidders are subject to disclose their own
information ( no-how and experience records) with the
stakeholders and bidders may be reluctant.
Risk Management Lower risk management Higher risk management
Design time frame Incomplete design and deficiencies are risks identified
and priced causing higher bid price.
Joint effort is carried on to develop the design.
Forecasts and expectations Construction Methodology or VE may be out of the box Gradual development and joint design
Price basis Traditional cost estimate, contingencies, and bidders
insights
Healthy pricing based on the bidder early involvement
in the design package.

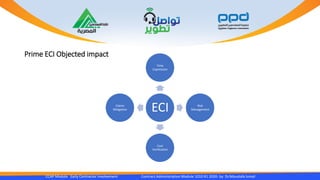

Prime ECI Objected impact
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
ECI
Time
Copression
Risk
Management
Cost
Verification
Claims
Mitigation
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
ECI
Enhanced
business
relationship
Risk
management
Cost
certainty
Time
compression
ECI : early contractor involvement
Claim : potential claims types
Design
claim
EOT
claim
Claim
Scope
claim
Termination
claim
Mitigation impact not applicable
Impact of ECI approach on construction claims
Objected Impact and Main claims interaction
Module in ECI
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
8. Case Study ‫التذكاري‬ ‫زايد‬ ‫صرح‬ ‫مشروع‬
•‫وصف‬‫المشروع‬:
•‫هو‬‫صرح‬‫تذكاري‬‫يخلد‬‫الذكرى‬‫المئوية‬‫لميالد‬‫القائد‬‫المؤسس‬‫المغفور‬‫له‬‫الشيخ‬‫زايد‬‫بن‬‫سلطان‬
‫آل‬‫نهيان‬،‫طيب‬‫هللا‬‫ثراه‬،‫ويشكل‬‫منارة‬‫لألجيال‬‫المقبلة‬،‫وذلك‬‫في‬‫إطار‬‫إعالن‬‫صاحب‬‫السمو‬
‫الشيخ‬‫خليفة‬‫بن‬‫زايد‬‫آل‬‫نهيان‬‫رئيس‬‫الدولة‬‫حفظه‬‫هللا‬‫عام‬2018(‫عام‬‫زايد‬).
•‫يقع‬‫موقع‬‫الصرح‬‫التذكاري‬‫عند‬‫تقاطع‬‫شارعي‬‫األول‬‫والثاني‬‫على‬‫طول‬‫كورنيش‬‫أبوظبي‬،‫ويضم‬
3.3‫هكتارات‬‫من‬‫المساحات‬‫العامة‬.
•‫بالقرب‬‫من‬‫الحديقة‬،‫هناك‬‫العديد‬‫من‬‫الميزات‬‫التي‬‫يمكن‬‫استكشافها‬،‫بما‬‫في‬‫ذلك‬‫قناة‬‫ما‬‫ئية‬‫ترمز‬
‫إلى‬‫الفلج‬«‫أنظمة‬‫الري‬‫القديمة‬‫التي‬‫يستخدمها‬‫سكان‬‫شبه‬‫الجزيرة‬‫العربية‬»،‫فيما‬‫تعر‬‫ض‬
‫الحديقة‬‫للزوار‬‫مجموعة‬‫من‬‫النباتات‬‫المحلية‬‫المستخدمة‬ً‫تقليديا‬‫لخصائصهم‬‫الطبية‬،‫م‬‫ثل‬‫قطن‬
‫الصحراء‬‫الحناء‬‫شجرة‬‫فرشاة‬‫األسنان‬‫األعشاب‬‫القلوية‬‫كارالوما‬‫وهرمال‬.
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
8. Case Study ‫التذكاري‬ ‫زايد‬ ‫صرح‬ ‫مشروع‬Procured under ECI:
4 Bidders,
Reimbursement and
select the H. score
proposal.
55
55
Final HINT
CONSTRUCTION CONTRACTS APPLIED PROGRAM Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫العقد‬ ‫أطراف‬ ‫إللتزامات‬ ‫نماذج‬
‫السعودى‬ ‫األشغال‬ ‫عقد‬-‫العامــــــــة‬ ‫الشــــــروط‬:‫مصمم‬ ‫وجود‬ ‫حالة‬ ‫فى‬-‫وعطاءات‬ ‫منافسة‬-‫تنفيذ‬ ‫مقاول‬
‫رقم‬ ‫المادة‬(10:)‫الموقع‬ ‫معاينة‬
10/1‫على‬‫المقاول‬‫أن‬‫يقوم‬‫على‬‫حسابه‬‫الخاص‬‫بفحص‬‫ومعاينة‬‫الموقع‬‫واألماكن‬‫المحيطة‬‫به‬‫وأن‬‫يتأكد‬‫بن‬‫فسه‬‫وقبل‬
‫تقديم‬‫العطاء‬‫من‬‫شكل‬‫الموقع‬‫وطبيعة‬‫تربته‬‫والقيام‬‫بعمل‬‫الحسابات‬‫والثقوب‬‫التي‬‫تمكنه‬‫من‬‫ذلك‬‫وكذل‬‫ك‬‫يقوم‬‫بمراجعة‬
‫كميات‬‫العمل‬‫وطبيعته‬‫والمواد‬‫الالزمة‬‫إلنجاز‬‫األعمال‬‫ووسائل‬‫الوصول‬‫إلى‬‫الموقع‬‫والمرافق‬‫التي‬‫يحتاج‬‫إل‬‫يها‬‫وعليه‬
‫بصورة‬‫عامة‬‫أن‬‫يحصل‬‫لنفسه‬‫على‬‫سائر‬‫المعلومات‬‫الضرورية‬‫وغيرها‬‫من‬‫العوامل‬‫التي‬‫قد‬‫تؤثر‬‫على‬‫عطا‬‫ئه‬.
‫يجب‬‫توضيح‬‫اإللتزامات‬‫بالشروط‬‫الخاصة‬‫بالتفصيل‬‫ألن‬‫هذا‬‫النص‬‫عام‬‫وتم‬‫صياغته‬‫بعبارات‬‫فضف‬‫اضة‬‫يؤدى‬
‫إلى‬‫الخالفات‬‫بين‬‫أطراف‬‫العقد‬.
56

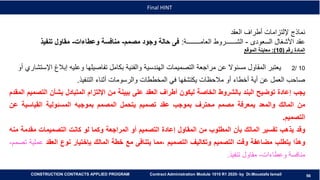

56
Final HINT
CONSTRUCTION CONTRACTS APPLIED PROGRAM Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫العقد‬ ‫أطراف‬ ‫إللتزامات‬ ‫نماذج‬
‫السعودى‬ ‫األشغال‬ ‫عقد‬-‫العامــــــــة‬ ‫الشــــــروط‬:‫مصمم‬ ‫وجود‬ ‫حالة‬ ‫فى‬-‫وعطاءات‬ ‫منافسة‬-‫تنفيذ‬ ‫مقاول‬
‫رقم‬ ‫المادة‬(10:)‫الموقع‬ ‫معاينة‬
10/2‫ا‬ ‫إبالغ‬ ‫وعليه‬ ‫تفاصيلها‬ ‫بكامل‬ ‫والفنية‬ ‫الهندسية‬ ‫التصميمات‬ ‫مراجعة‬ ‫عن‬ ‫مسئوال‬ ‫المقاول‬ ‫يعتبر‬‫أو‬ ‫إلستشاري‬
‫التنفيذ‬ ‫أثناء‬ ‫والرسومات‬ ‫المخططات‬ ‫في‬ ‫يكتشفها‬ ‫مالحظات‬ ‫أو‬ ‫أخطاء‬ ‫أية‬ ‫عن‬ ‫العمل‬ ‫صاحب‬.
‫يجب‬‫إعادة‬‫توضيح‬‫البند‬‫بالشروط‬‫الخاصة‬‫ليكون‬‫أطراف‬‫العقد‬‫على‬‫بيينة‬‫من‬‫اإللتزام‬‫المتبادل‬‫بشأن‬‫الت‬‫صميم‬‫المقدم‬
‫من‬‫المالك‬‫والمعد‬‫يمعرفة‬‫مصمم‬‫محترف‬‫بموجب‬‫عقد‬‫تصميم‬‫يتحمل‬‫المصمم‬‫بموجبه‬‫المسئولية‬‫القياسية‬‫ع‬‫ن‬
‫التصميم‬.
‫وقد‬‫يذهب‬‫تفسير‬‫المالك‬‫بأن‬‫المطلوب‬‫من‬‫المقاول‬‫إعادة‬‫التصميم‬‫أو‬‫المراجعة‬‫وكما‬‫لو‬‫كانت‬‫التصميمات‬‫مقدم‬‫ة‬‫منه‬
‫وهذا‬‫يتطلب‬‫مضاعفة‬‫وقت‬‫التصميم‬‫وتكاليف‬‫التصميم‬‫،مما‬‫يتنافى‬‫مع‬‫خطة‬‫المالك‬‫بإختيار‬‫نوع‬‫العقد‬‫ع‬‫ملية‬‫تصمم‬-
‫منافسة‬‫وعطاءات‬-‫مقاول‬‫تنفيذ‬.
57

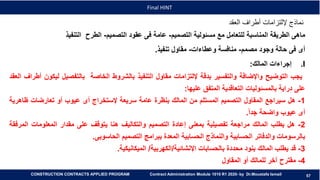

57
Final HINT
CONSTRUCTION CONTRACTS APPLIED PROGRAM Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫العقد‬ ‫أطراف‬ ‫إللتزامات‬ ‫نماذج‬
‫ماهى‬‫الطريقة‬‫المناسبة‬‫للتعامل‬‫مع‬‫مسئولية‬‫التصميم‬-‫عامة‬‫فى‬‫عقود‬‫التصميم‬-‫الطرح‬‫التنفيذ‬
‫أى‬‫فى‬‫حالة‬‫وجود‬‫مصمم‬-‫منافسة‬‫وعطاءات‬-‫مقاول‬‫تنفيذ‬.
.I‫إجراءات‬‫المالك‬:
‫يجب‬‫التوضيح‬‫واإلضافة‬‫والتفسير‬‫بدقة‬‫إللتزامات‬‫مقاول‬‫التنفيذ‬‫بالشروط‬‫الخاصة‬‫بالتفصيل‬‫لي‬‫كون‬‫أطراف‬‫العقد‬
‫على‬‫دراية‬‫بالمسئوليات‬‫التعاقدية‬‫المتفق‬‫عليها‬:
1-‫هل‬‫سيراجع‬‫المقاول‬‫التصميم‬‫المستلم‬‫من‬‫المالك‬‫بنظرة‬‫عامة‬‫سريعة‬‫إلستخراج‬‫أى‬‫عيوب‬‫أو‬‫تعارضات‬‫ظا‬‫هرية‬
‫أى‬‫عيوب‬‫واضحة‬‫جدا‬.
2-‫هل‬‫يطلب‬‫المالك‬‫مراجعة‬‫تفصيلية‬‫بمعنى‬‫إعادة‬‫التصميم‬‫والتكاليف‬‫هنا‬‫يتوقف‬‫على‬‫مقدار‬‫المعلومات‬‫ا‬‫لمرفقة‬
‫بالرسومات‬‫والدفاتر‬‫الحسابية‬‫والنماذج‬‫الحسابية‬‫المعدة‬‫ببرامج‬‫التصميم‬‫الحاسوبى‬.
3-‫قد‬‫يطلب‬‫المالك‬‫بنود‬‫محددة‬‫بالحسابات‬‫اإلنشائية‬/‫الكهربية‬/‫الميكانيكية‬.
4-‫مقترح‬‫آخر‬‫للمالك‬‫أو‬‫المقاول‬
58
58
Final HINT
CONSTRUCTION CONTRACTS APPLIED PROGRAM Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫العقد‬ ‫أطراف‬ ‫إللتزامات‬ ‫نماذج‬
‫ماهى‬‫الطريقة‬‫المناسبة‬‫للتعامل‬‫مع‬‫مسئولية‬‫التصميم‬-‫عامة‬‫فى‬‫عقود‬‫التصميم‬-‫الطرح‬‫التنفيذ‬
‫أى‬‫فى‬‫حالة‬‫وجود‬‫مصمم‬-‫منافسة‬‫وعطاءات‬-‫مقاول‬‫تنفيذ‬.
.I‫إجراءات‬‫المقاول‬
‫يجب‬‫على‬‫المقاول‬‫مراجعة‬‫كافة‬‫شروط‬‫العقد‬‫ومستندات‬‫العطاء‬‫وخاصة‬‫تعليمات‬‫تقديم‬‫العطاء‬‫والقانون‬‫الو‬‫اجب‬
‫للتطبيق‬‫ثم‬‫يراعى‬‫مايلى‬‫عن‬‫تقديم‬‫العطاء‬:
1-‫يأخذ‬‫باإلعتبار‬‫أنه‬‫سوف‬‫يراجع‬‫المقاول‬‫التصميم‬‫المستلم‬‫من‬‫المالك‬‫بنظرة‬‫عامة‬‫سريعة‬‫إلستخراج‬‫أى‬‫عيوب‬‫أو‬
‫تعارضات‬‫ظاهرية‬‫أى‬‫عيوب‬‫واضحة‬ً‫ا‬‫جد‬.(‫إعتبارات‬‫التكلفة‬‫والوقت‬).
2-‫أو‬‫يأخذ‬‫باإلعتبار‬‫أنه‬‫سوف‬‫يقوم‬‫مراجعة‬‫تفصيلية‬‫بمعنى‬‫إعادة‬‫التصميم‬‫كامال‬(‫إعتبار‬‫الوقت‬‫الت‬‫كاليف‬)‫و‬
‫تتوقف‬‫على‬‫مقدار‬‫المعلومات‬‫المرفقة‬‫بالرسومات‬‫والدفاتر‬‫الحسابية‬‫والنماذج‬‫الحسابية‬‫المعدة‬‫ببرامج‬‫ا‬‫لتصميم‬BIM
4-‫مقترح‬‫آخر‬‫للمقاول‬
5-‫فى‬‫كل‬‫الحاالت‬‫يجب‬‫أن‬‫يذكر‬‫المقاول‬‫بعطائه‬‫فهمه‬‫لمسئولياته‬‫عن‬‫التصميم‬‫بعبارات‬‫واضحة‬
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
‫مناقشة‬:
-‫الظروف‬‫الطارئة‬‫والقوى‬‫القاهرة‬
-‫اإلثراء‬‫بالسبب‬
-‫إستخدام‬‫الحق‬‫بتعسف‬
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
8. Case Study ‫مشروعًصرحًزايدًالتذكاري‬
•‫الفكرة‬‫التصميمية‬‫للمشروع‬:
•‫في‬‫عام‬2013‫تم‬‫تكليف‬‫الفنان‬‫األميركي‬‫العالمي‬‫رالف‬‫هيلمك‬‫ليكون‬ً‫مسؤول‬‫عن‬‫تصميم‬‫وبناء‬‫صرح‬‫ز‬‫ايد‬
‫المؤسس‬‫حيث‬‫استغرقت‬‫مدة‬‫دراسة‬‫وتنفيذ‬‫المشروع‬‫نحو‬6‫سنوات‬،‫ويصف‬‫الصرح‬‫الجديد‬‫تاريخ‬‫وحاضر‬
‫ومستقبل‬‫المنطقة‬،ً‫نظرا‬‫لكون‬‫األمر‬‫يتعلق‬‫بأهم‬‫وأحكم‬‫شخصية‬‫على‬‫اإلطالق‬‫تواجدت‬‫بالمنطقة‬‫في‬‫ال‬‫عقود‬
‫الماضية‬.
•‫يستند‬‫التصميم‬‫على‬‫تصور‬‫بناء‬‫صرح‬‫مبتكر‬‫ليس‬‫له‬‫مثيل‬‫في‬‫كل‬‫الكرة‬‫األرضية‬‫باستخدام‬‫المؤث‬‫رات‬‫البصرية‬
‫والديناميكية‬،‫كما‬‫أن‬‫للصرح‬‫خصوصية‬‫رمزية‬‫معينة‬‫يختلف‬‫بها‬‫عن‬‫الباقي‬‫ويحمل‬‫بصمات‬‫محلية‬‫تعك‬‫س‬‫الهوية‬
‫الثقافية‬‫للبلد‬‫الذي‬‫يوجد‬‫فيه‬‫ويمثل‬ً‫أيضا‬‫إضافة‬‫معمارية‬‫ليكون‬ً‫رمزا‬‫من‬‫رموز‬‫النهضة‬‫والنجاح‬،‫و‬‫يعكس‬‫صرح‬
‫الشيخ‬‫زايد‬‫التطور‬‫والنجاح‬‫والعصرنة‬‫التي‬‫تعيشها‬‫دولة‬‫اإلمارات‬‫التي‬‫نجحت‬‫خالل‬‫فترة‬‫زمنية‬‫بسي‬‫طة‬‫في‬‫أن‬
‫تصبح‬‫اليوم‬‫دولة‬‫رائدة‬‫على‬‫مستوى‬‫العالم‬‫في‬‫جميع‬‫المجالت‬.
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
9. Conclusion
• The ECI approach is used either with the stander forms of contracts like the “FIDIC” forms of contracts,
Yellow Book for the Plant and design built and the X22 NEC4 or in tailored contracts.
• The ECI contract may be applied in two stages and for one contractor or it may engage different
contractors one for every stage.
• The ECI approach can be used for the improvement of the project success certainty and mitigation of the
most potential construction claims.
• The influence of ECI proved to mitigate different types of claims like design claims, an extension of time
claim, scope claim, liability claims, termination claims.
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail

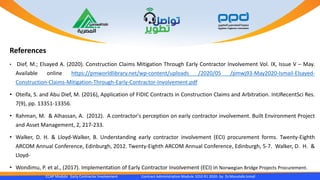

References
• Dief, M.; Elsayed A. (2020). Construction Claims Mitigation Through Early Contractor Involvement Vol. IX, Issue V – May.
Available online https://pmworldlibrary.net/wp-content/uploads /2020/05 /pmwj93-May2020-Ismail-Elsayed-
Construction-Claims-Mitigation-Through-Early-Contractor-Involvement.pdf
• Oteifa, S. and Abu Dief, M. (2016), Application of FIDIC Contracts in Construction Claims and Arbitration. IntJRecentSci Res.
7(9), pp. 13351-13356.
• Rahman, M. & Alhassan, A. (2012). A contractor's perception on early contractor involvement. Built Environment Project
and Asset Management, 2, 217-233.
• Walker, D. H. & Lloyd-Walker, B. Understanding early contractor involvement (ECI) procurement forms. Twenty-Eighth
ARCOM Annual Conference, Edinburgh, 2012. Twenty-Eighth ARCOM Annual Conference, Edinburgh, 5-7. Walker, D. H. &
Lloyd-
• Wondimu, P. et al., (2017). Implementation of Early Contractor Involvement (ECI) in Norwegian Bridge Projects Procurement.
CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
End of Lecture
Construction claims mitigation through Early Contractor Involvement
By: Moustafa I. Abu Dief
‫وبركاته‬ ‫هللا‬ ‫ورحمة‬ ‫عليكم‬ ‫السالم‬
https://www.linkedin.com/in/dr-moustafa-ismail-cfcc-mciob-rmp-
pmp-arics-93798a16/
• ‫بالمشروع‬ ‫المبكرة‬ ‫المقاول‬ ‫مشاركة‬ ‫خالل‬ ‫من‬ ‫التشييد‬ ‫مشروعات‬ ‫مطالبات‬ ‫من‬ ‫التخفيف‬
Construction Contracts Applied Program- CCAP Module 1010 –R1 2020

م.35- مبادرة#تواصل_تطوير- د.مصطفى إسماعيل - التخفيف من مطالبات مشروعات التشيد من خلال مشاركة المقاول المبكرة للمشروع

  • 2.
    ‫مشاركة‬ ‫خالل‬ ‫من‬‫التشييد‬ ‫مشروعات‬ ‫مطالبات‬ ‫من‬ ‫التخفيف‬ ‫بالمشروع‬ ‫المبكرة‬ ‫المقاول‬ Construction Contracts Applied Program- CCAP Module 1010 –R1 2020 ‫د‬.‫م‬/‫أبوضيف‬ ‫إسماعيل‬ ‫مصطفى‬ Dr. Eng. Moustafa I. Abu Dief, FCIOB, CFCC™, PMP®, CCP, PMI-RMP, Construction claims mitigation through Early Contractor Involvement
  • 3.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
  • 4.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail  Contracts and Claims Manager, Moustafa has Experience in Construction Projects, Engineering, Contracts, Claims, Dispute Resolution, and Training Management for 30 Years In Egypt, Kuwait, KSA. Since 2005 he is a member and certification grader, reviewer in different professional organizations Moustafa I. Abu Dief, FCIOB, CFCC™, PMP®, CCP, PMI-RMP,  Dr. Moustafa is Certified Forensic Claims Consultant CFCC™ In Addition to: • Associate Prof. ABMS University- Switzerland • Fellow, Chartered Institute Of Building, UK. (FCIOB) • Consultant engineer, SCE, Chartered member, (MCInstCES). • Certified Arbitrator, Egypt, Kuwait, Bahrain, and KSA • Fellow and A Prof. Justice Academy for Legal and economics studies, 2017 • Fellow, Institute Of Construction Claims Practitioner, US • Risk Management Professional, and PMP®, 2006, ACI.Arb, ARICS, PMOC QMS/ Qa Management IRCA Certification. • CCP - Certified Cost Consultant AACEI, US. 1988
  • 5.
    Early Contractor Involvement CCAPModule Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail • Contents 1. Introduction and current practice 2. ECI Benefits 3. Contractor selection process in ECI 4. ECI Process 5. Tender Evaluation 6. Deliverables and stages 7. Lessons Learned and recommendations 8. Case Study 9. Conclusion
  • 6.
    Event Schedule CCAP ModuleEarly Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail No 5 10 15 20 25 30 35 40 45 50 55 60 65 70 75 80 85 90 1 Introduction and Current Practice 2 ECI Benefits 3 Contractor Selection Process in ECI 4 ECI Process 5 Tender Evaluation 6 Deliverables and stages 7 Lessons Learned and Recommendations 8 Case Study 9 Conclusion Early Contractor Involved (ECI) 8-10 min. 12-15 m 10 min. 10 min. 15 min. 10-12 7 m 5 min. 5 m
  • 7.
    Construction Industry CCAP ModuleEarly Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail • culture of confrontation • win-lose attitudes • malicious series of suspicion/doubt • characterized by adversarial attitudes • Litigation/Arbitration may be continuing after project finish. • no winner party in the circumstances that cause claims and disputes
  • 8.
    Construction Industry CCAP ModuleEarly Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail • Is It beneficial endeavor to the project stakeholders? • OR needs for a change-to a more cooperative and collaborative approach to build win/win, mutual trust, respect, good faith, and continuous commitment.
  • 9.
    Claims Types inConstruction Industry CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫قيمة‬ ‫انها‬ ‫علي‬ ‫الهندسية‬ ‫العقود‬ ‫في‬ ‫المطالبات‬ ‫تعريف‬‫يطالب‬ ‫في‬ ‫تؤخذ‬ ‫لم‬ ‫إضافية‬ ‫أعباء‬ ‫عن‬ ‫كتعويض‬ ‫المقاول‬ ‫بها‬ ‫تنفي‬ ‫جاري‬ ‫لمشروع‬ ‫المقاولة‬ ‫عقد‬ ‫توقيع‬ ‫عند‬ ‫االعتبار‬‫ذه‬. Not Change order- Not IPC (‫كتاب‬‫المطالبات‬‫في‬‫العقود‬‫الهندسية‬)
  • 10.
    Claims Types accordingto liability CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
  • 11.
    Claims and QuestionedArticles in Contracts CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫نماذج‬‫إللتزامات‬‫أطراف‬‫العقد‬ ‫عقد‬‫األشغال‬‫السعودى‬-‫الشــــــروط‬‫العامــــــــة‬:‫فى‬‫حالة‬‫وجود‬‫مصمم‬-‫منافسة‬‫وعطاءات‬-‫مقاول‬‫تنفيذ‬ ‫المادة‬‫رقم‬(10):‫معاينة‬‫الموقع‬ 10/1‫على‬‫المقاول‬‫أن‬‫يقوم‬‫على‬‫حسابه‬‫الخاص‬‫بفحص‬‫ومعاينة‬‫الموقع‬‫واألماكن‬‫المحيطة‬‫به‬‫وأن‬‫يتأكد‬‫بنفسه‬‫وقبل‬‫تقديم‬‫ا‬‫لعطاء‬‫من‬‫شكل‬ ‫الموقع‬‫وطبيعة‬‫تربته‬‫والقيام‬‫بعمل‬‫الحسابات‬‫والثقوب‬‫التي‬‫تمكنه‬‫من‬‫ذلك‬‫وكذلك‬‫يقوم‬‫بمراجعة‬‫كميات‬‫العمل‬‫وطبيعته‬‫والمو‬‫اد‬‫الالزمة‬‫إلنجاز‬ ‫األعمال‬‫ووسائل‬‫الوصول‬‫إلى‬‫الموقع‬‫والمرافق‬‫التي‬‫يحتاج‬‫إليها‬‫وعليه‬‫بصورة‬‫عامة‬‫أن‬‫يحصل‬‫لنفسه‬‫على‬‫سائر‬‫المعلومات‬‫الضر‬‫ورية‬‫وغيرها‬ ‫من‬‫العوامل‬‫التي‬‫قد‬‫تؤثر‬‫على‬‫عطائه‬.
  • 12.
    Claims and QuestionedArticles in Contracts CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫نماذج‬‫إللتزامات‬‫أطراف‬‫العقد‬ ‫عقد‬‫األشغال‬‫السعودى‬-‫الشــــــروط‬‫العامــــــــة‬:‫فى‬‫حالة‬‫وجود‬‫مصمم‬-‫منافسة‬‫وعطاءات‬-‫مقاول‬‫تنفيذ‬ ‫المادة‬‫رقم‬(10):‫معاينة‬‫الموقع‬ 10/2‫يعتبر‬‫المقاول‬‫مسئوال‬‫عن‬‫مراجعة‬‫التصميمات‬‫الهندسية‬‫والفنية‬‫بكامل‬‫تفاصيلها‬‫وعليه‬‫إبالغ‬‫اإلستشاري‬‫أو‬‫صاحب‬‫العمل‬‫عن‬‫أية‬ ‫أخطاء‬‫أو‬‫مالحظات‬‫يكتشفها‬‫في‬‫المخططات‬‫والرسومات‬‫أثناء‬‫التنفيذ‬. ‫اكتشف‬‫األمر‬:‫َف‬‫ش‬‫ك‬‫د‬ْ‫ه‬ُ‫ج‬‫ال‬ ‫من‬ ‫بشيء‬ ‫عنه‬
  • 13.
    What is EarlyContractor Involvement CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail What is Early Contractor Involvement ECI 1. It is engagement 2. Collaboration 3. Alliance (union- cooperation) approach ECI is a project delivery strategy which engages the contractors in the early project stages, probably during the early design phases where the design alternatives are still under study i.e. the concept design phase.
  • 14.
    What is EarlyContractor Involvement CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail What is our target? WIN-WIN Collaboration. Let’s do it together ECI Time Copression Risk Management Cost Verification Claims Mitigation
  • 15.
    What is EarlyContractor Involvement CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail What is our target? WIN-WIN Collaboration. Let’s build the barriers together
  • 16.
    1. Introduction andcurrent practice CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail A. Design Bid Build Strategy DBB i. Design brief ii. Concept iii. schematic iv. Detailed design development v. Bid document/Bid process vi. Construction Where is the Contractor
  • 17.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail B. Design and Build Strategy i. Design brief ii. Concept &Employer requirement iii. Schematic iv. Bid process v. Construction contract DB. (Contractor starts Detailed Design and construction) Comply with Authorities requirements. ? Where is the Contractor 1. Introduction and current practice- continued
  • 18.
    2. Purposes forECI CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail i. Early Start V. Claims and Risk Mitigation ii. better financing cost iii. Lower Construction / Pricing as the contractor have lower risk and contingencies to consider in their pricing/ Lean construction cost (no or less buffer). iv. Design alternatives v. Constructability management vi. Time management- Fast track and partial start enabling.
  • 19.
     Estimation Buffers CCAPModule Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail (no or less buffer). RITA
  • 20.
    2.1 ECI Benefits CCAPModule Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail i. To utilize the Contractors experience in:  Field of constructability  Design alternatives  Construction planning  Value management and VE  Construction alternatives and technologies  Project sequencing, scheduling
  • 21.
    2.1 ECI Benefits CCAPModule Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ii. To enhance the following processes in the entire project  Risk sharing and risk allocation  Claims management and mitigation and reduce risk of litigation  Parties relationships and business continuity  Partnering culture/project ownership in the tendering environment.  Joint problem solving  Compressed duration for bidding
  • 22.
    2.1 ECI Benefits:Miscellaneous CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 1. Enables the long lead items procurement during design which saves time, identify risks. 2. Work may start partially during design phase. 3. Contractor is adding value through past experience sharing, mitigates the changes and claims 4. Contractor increases the cost certainty as the sub-contractors and suppliers are consulted.
  • 23.
    2.1 ECI Benefits:Miscellaneous (continued) CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 6. Overall project duration is compressed. 7. The ECI phase provides parties awareness and the required information. 8. Enables joint coordination to refine the scope and project plans 9. Employer is not committed for final scope or final cost or legal engagement with the ECI proposer related to the construction phase.
  • 24.
    2.1.1 ECI Benefitsin different contract strategies CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail Model ECI Inputs by Builders 1 Design & Build (D&B) - single point of responsibility Develop complete design package based on employer design requirements and concept design by the employer 2 Design Bid Build with Early Contractor Involvement (DBB-ECI) Provide alternative design solution(s) based on complete design and focus missing information, discrepancies, deficiency in design.
  • 25.
    2.2 ECI Featuresin different contract strategies CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail Model ECI Advantages Disadvantages 1 Design Bid Build with Early Contractor Involvement (DBB-ECI) • Complete design control by the employer • Contractor may have inputs into design during tender stage. • Tender process is controlled by employer. • Limited contractor involvement. to optional proposals. • Potential limited cost/time savings due to Contractor’s inputs
  • 26.
    2.2 ECI Featuresin different contract strategies CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail Model ECI Advantages Disadvantages 2 Design and built strategy- DB • Single point of responsibility • Contractor is enabled to contribute to design stages • Effective budgeting and cost elements utilization. • Employer bears the responsibility of preparing concept design, employer requirements, tender package, and contract administration either in house or through a consultant. • Time savings because of shorter construction time, although longer tendering time. • Various proposals are submitted and rigorous evaluation of bids. • Employer has no control of detailed design as consultants are engaged by Contractor/design builder. 15 IN DB employer should not go beyond concept design/ retransfer the design risk
  • 27.
    3. Contractor/Contract TypeSelection CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail Consequent approach Shall we: Select ECI? o Then tailor ECI contract strategy. o Then process Involvement and Engagement through:  DB or  DBB or  Tailored approach.
  • 28.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 3. Contractor selection process in ECI i. Prequalification process one round for each project ii. In Governmental projects, preq. is covered under the public tender regulations. iii. It is not permitted to apply 2nd stage prequalification during subsequent ECI tender. iv. work with those 4-6 initially prequalified
  • 29.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 3. Contractor selection process in ECI iv. Certain criteria to be adopted, those may include:  Financial Strength,, Resources & Capabilities, Relevant experience, and contractor work load.  Claims/litigation history ( 3years)  Ability for innovation and alternative design solution (Allocate Weightage for cost saving attribute).  Social values commitment  Sustainable procurement commitment Short listed
  • 30.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 2 Stage tendering in KSA Procurement Law ‫المادة‬ ‫النظام‬31 ‫التنفيذية‬ ‫الالئحة‬ ‫المادة‬42 For Risk Seeker only
  • 31.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫مرحلتين‬ ‫على‬ ‫المنافسة‬ ‫النظام‬‫الباب‬|2‫أساليب‬‫التعاقد‬31-‫الفصل‬|3‫المنافسة‬‫على‬‫مرحلتين‬ •‫للجهة‬‫الحكومية‬‫طرح‬‫المنافسة‬‫على‬‫مرحلتين‬‫إذا‬‫تعذر‬‫تحديد‬‫المواصفات‬‫الفنية‬‫والشروط‬‫التعاقدية‬‫النه‬‫ائية‬‫ًا‬‫د‬‫تحدي‬‫كام‬ً‫ال‬ ‫؛‬ً‫ا‬‫ودقيق‬‫بسبب‬‫الطبيعة‬‫المعقدة‬‫والتخصصية‬‫لبعض‬‫األعمال‬‫والمشتريات‬ً‫ا‬‫وفق‬‫لما‬‫توضحه‬‫الالئحة‬. •‫الالئحة‬:‫مع‬‫مراعاة‬‫ما‬‫ورد‬‫في‬‫المادة‬(‫الحادية‬‫والثالثين‬)‫من‬،‫النظام‬‫تتم‬‫المنافسة‬‫على‬‫مرحلتين‬‫كالتالي‬: ً‫أوال‬:‫المرحلة‬‫األولى‬: -1‫تحدد‬‫وثائق‬‫المنافسة‬‫حاجة‬‫الجهة‬‫الحكومية‬‫والغرض‬‫من‬‫العقد‬‫واألداء‬‫المتوقع‬‫والمؤهالت‬‫المطلوبة‬‫إلنجاز‬‫األعمال‬ ‫والمعلومات‬‫العامة‬‫ذات‬‫العالقة‬‫بالشروط‬‫والمواصفات‬‫وغيرها‬‫من‬‫الخصائص‬،‫الفنية‬‫سواء‬‫لألعمال‬‫المراد‬‫تنفيذها‬‫أو‬ ‫المعدات‬‫والسلع‬‫المراد‬‫الحصول‬‫عليها‬.
  • 32.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫مرحلتين‬ ‫على‬ ‫المنافسة‬-ً‫أوال‬:‫األولى‬ ‫المرحلة‬ 2-‫يعلن‬‫عن‬‫المرحلة‬‫األولى‬‫في‬‫البوابة‬)‫منصة‬‫إعتماد‬)ً‫ا‬‫وفق‬‫إلجراءات‬‫إعالن‬‫المنافسة‬‫العامة‬. 3-‫تقدم‬‫عروض‬‫أولية‬‫في‬‫المرحلة‬‫األولى‬‫تتضمن‬‫اقتراحات‬‫المتقدمين‬‫من‬‫دون‬‫ذكر‬‫أسعار‬‫العروض‬. 4-‫باإلضافة‬‫إلى‬‫ما‬‫ورد‬‫في‬‫الفقرة‬(3)‫من‬‫هذه‬،‫المادة‬‫يجوز‬‫للجهة‬‫الحكومية‬‫أن‬‫تطلب‬‫من‬‫المتنافسين‬–‫دون‬‫إلزامهم‬‫بذلك‬-‫تقديم‬ ‫أسعار‬‫استرشادية‬‫أو‬‫حدود‬‫سعرية‬‫لألعمال‬‫المراد‬‫تنفيذها‬(‫بغرض‬‫إسترشادى‬‫للمالك‬)،‫على‬‫أال‬‫يلزموا‬‫في‬‫المرحلة‬‫الثان‬‫ية‬‫بتعديل‬ ‫عروضهم‬‫بما‬‫يتفق‬‫مع‬‫ما‬‫قدموه‬‫من‬‫أسعار‬‫استرشادية‬‫وحدود‬،‫سعرية‬‫أو‬‫أن‬‫تقيم‬‫عروضهم‬‫بناء‬‫عليها‬.(‫مقاومة‬‫من‬‫المقاولين‬). -5‫يجوز‬‫للجهة‬‫الحكومية‬‫مناقشة‬‫مقدمي‬‫العروض‬‫الستيضاح‬‫ما‬‫ورد‬‫في‬‫العروض‬‫والمواصفات‬‫المقترحة‬‫وإجراء‬‫التغيير‬‫ات‬‫الالزمة‬ ‫على‬‫المواصفات‬‫لتكون‬‫مقبولة‬‫وممكنة‬‫من‬‫الناحية‬‫العملية‬((Presentation،‫على‬‫أن‬‫تنشر‬‫تلك‬‫االستفسارات‬‫والتوضيحات‬‫في‬‫البو‬‫ابة‬ ‫ويتاح‬‫لجميع‬‫مقدمي‬‫العروض‬‫االطالع‬‫عليها‬. -6‫تعلن‬‫العروض‬‫التي‬‫اجتازت‬‫المرحلة‬‫األولى‬‫في‬‫البوابة‬‫اإللكترونية‬.
  • 33.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫مرحلتين‬ ‫على‬ ‫المنافسة‬ ‫ثانيا‬:‫المرحلة‬‫الثانية‬: ‫تقوم‬‫الجهة‬‫الحكومية‬‫بعد‬‫نهاية‬‫المرحلة‬‫األولى‬‫بما‬‫يلي‬: -1‫إعداد‬‫وتعديل‬‫المواصفات‬‫الفنية‬‫وتجهيز‬‫وثائق‬‫المنافسة‬‫ومعايير‬،‫التقييم‬ً‫ء‬‫بنا‬‫على‬‫ما‬‫تم‬‫التوصل‬‫إليه‬‫خال‬‫ل‬‫المرحلة‬‫األولى‬. -2‫إرسال‬‫الدعوات‬‫إلى‬‫أصحاب‬‫العروض‬‫المجتازة‬‫لتقديم‬‫عروضهم‬. ‫ما‬‫لم‬‫ينص‬‫على‬‫خالف‬،‫ذلك‬‫تطبق‬‫على‬‫المنافسة‬‫على‬‫مرحلتين‬‫أحكام‬‫وإجراءات‬‫المنافسة‬‫العامة‬.
  • 34.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr. Moustafa Ismail 2 Stage tendering in KSA Procurement Law ‫المادة‬ ‫النظام‬31 ‫التنفيذية‬ ‫الالئحة‬ ‫المادة‬42 2 Stage competition as per KSA Public Tender Law - 2019 ‫أن‬ ‫الحكومية‬ ‫للجهة‬ ‫4يجوز‬ ‫ام‬‫ز‬‫إل‬ ‫–دون‬ ‫ن‬‫المتنافسي‬ ‫من‬ ‫-تطلب‬ ‫حدود‬ ‫أو‬ ‫شادية‬ ‫ر‬‫است‬ ‫أسعار‬ ‫تقديم‬ ‫ي‬ ‫ن‬ ‫ف‬ ‫يلزموا‬ ‫ل‬ ّ ‫أ‬ ‫عىل‬ ،‫لألعمال‬ ‫سعرية‬ ‫بما‬ ‫عروضهم‬ ‫بتعديل‬ 2‫المرحلة‬ ‫أو‬ ، ‫أسعار‬ ‫من‬ ‫قدموه‬ ‫ما‬ ‫مع‬ ‫يتفق‬ ‫بناء‬ ‫عروضهم‬ ‫تقيم‬ ‫أن‬ ) ‫ن‬‫المقاولي‬ ‫من‬ ‫عليها.(مقاومة‬ ‫على‬ ‫تطبق‬ ،‫ذلك‬ ‫خالف‬ ‫على‬ ‫ينص‬ ‫لم‬ ‫ما‬ ‫وإجراءات‬ ‫أحكام‬ ‫مرحلتين‬ ‫على‬ ‫المنافسة‬ .‫العامة‬ ‫المنافسة‬ ‫المرحلة‬ ‫األوىل‬ -‫وثائق‬ ‫تحدد‬ ‫الجهة‬ ‫حاجة‬ ‫المنافسة‬ ‫واألداء‬ ‫العقد‬ ‫من‬ ‫والغرض‬ ‫المطلوبة‬ ‫والمؤهالت‬ ‫المتوقع‬ ‫إلنجا‬‫العمل‬ ‫ز‬‫والشروط‬ -‫ف‬ ‫األولى‬ ‫المرحلة‬ ‫عن‬ ‫يعلن‬‫ي‬ ‫البوابة‬)‫إعتماد‬ ‫منصة‬)ً‫ا‬‫وفق‬ ‫المنافسة‬ ‫إعالن‬ ‫إلجراءات‬ ‫العامة‬. -‫في‬ ‫أولية‬ ‫عروض‬ ‫تقدم‬ ‫تتضمن‬ ‫األولى‬ ‫المرحلة‬ ‫من‬ ‫المتقدمين‬ ‫اقتراحات‬‫أسعار‬ ‫الثانية‬ ‫االمرحلة‬ ‫الجهة‬ ‫تقوم‬‫عند‬‫يلي‬ ‫بما‬ ‫األولى‬ ‫المرحلة‬ ‫نهاية‬: -‫وثائق‬ ‫وتجهيز‬ ‫الفنية‬ ‫المواصفات‬ ‫وتعديل‬ ‫إعداد‬ ‫التو‬ ‫تم‬ ‫ما‬ ‫على‬ ً‫ء‬‫بنا‬ ،‫التقييم‬ ‫ومعايير‬ ‫المنافسة‬‫إليه‬ ‫صل‬ ‫خالل‬‫األولى‬ ‫المرحلة‬. -‫المجتازة‬ ‫العروض‬ ‫أصحاب‬ ‫إلى‬ ‫الدعوات‬ ‫إرسال‬ ‫عروضهم‬ ‫لتقديم‬. ‫للجهة‬ ‫يجوز‬‫مناقشة‬‫المتنافس‬‫ين‬ ‫ال‬‫العروض‬ ‫في‬ ‫ورد‬ ‫ما‬ ‫ستيضاح‬ ‫المقترحة‬ ‫والمواصفات‬‫وتعديل‬ ‫مقبولة‬ ‫لتكون‬ ‫المواصفات‬‫و‬‫عم‬‫لية‬ (Presentation(‫أن‬ ‫على‬ ، ‫االستفسارات‬ ‫تلك‬ ‫تنشر‬ ‫و‬ ‫البوابة‬ ‫في‬ ‫والتوضيحات‬‫ت‬‫ت‬‫اح‬ ‫ل‬‫م‬‫العروض‬ ‫قدمي‬. -‫اجتازت‬ ‫التي‬ ‫العروض‬ ‫تعلن‬ ‫البوابة‬ ‫في‬ ‫األولى‬ ‫المرحلة‬ ‫اإللكترونية‬.
  • 35.
    ECI process- Bestpractice CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
  • 36.
    4. ECI process/Best practice - Design and Build strategy CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
  • 37.
    4. ECI process/Best practice - Design and Build strategy CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 1. Briefing then issue PORTION I of the design brief and documents to Contractor 4 Repeated steps PI one, Then PII Two, Then PIII Three- Consecutive 2. Questions and Answers 3. Employer and Consultant review 4. Proposal and provide a Presentation
  • 38.
    4. ECI processDesign and Build strategy continued CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail a. All competitors shall sign confidentiality Undertaking and declare any potential conflict of interest or seek informed consent (IC). b. The Employer/Consultant provide Briefing to the bidders to enable common platform of project understanding and identify what response expected from the contractors. c. Advanced information to be forwarded to the design builders (contractors). i. Issue concept design ii. Provide Employer requirement to design builders. iii. Responses to contractors RFI and clarification- distribute to all and it will form part of the contract document.
  • 39.
    4. ECI process- Design and Build strategy continued d. Contractor’s Submission Technical Part i. Technical Proposal- no price shown (optional). ii. Presentation iii. Show project understanding/ design requirements/ contractor's capabilities and experience. iv. Show alternative solutions and initiatives v. Planning and quality proposal. CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
  • 40.
    5. ECI TenderEvaluation CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail Price and Quality Proposal are 60% and 40% of the Combined Score respectively. no Evaluation Criteria 1 Non Design Criteria  Company/ project organization structure  Risks and Safety management  Social values commitment 2 Project Site  Sustainable construction and Environment  Site management/ traffic/ security 3 Facility/Building Layout/Design  Functionality and efficiencies, value added.  Internal Circulations  Land scape external and internal 4 Building/facility envelop/ Form, Image 5 Quality of design: International codes- safety and security- expandable- maintenance concerns. 6 Structure system and constructability 7 Energy management and sustainability creative solutions 8 International accreditation i.e. LEED certified 9 Contractor presentation- effective- clear- understandable proposal
  • 41.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail AW % = Lowest Base Bid among all D Builders - DB(B1,2,3,…) Alternative Tender Bid* Lowest Base Bid (B1, 2, 3,..) LBB Highest Cost Saving H Lowest Cost Saving L * (Shall be lower/equal to base tender bid) Allocate Weightage for cost saving attribute( Effect of applying ECI) x AW %=Cost Saving Score Cost Saving of Design Builder (DB)( B1,2,3,…) (Builder's Cost Savings - Lowest Cost Savings) (Highest Cost Savings - Lowest Cost Savings) Evaluate And Compare Cost Saving Score Differentiate: Alternative Design : Scope Reduction : material differences Highest cost saving= full score Lowest cost saving= zero score
  • 42.
    6. Deliverables- presentations CCAPModule Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail  Contractor presentation 20-30m i. Organization structure for project and the site ii. Level one schedule/milestones iii. Design builder technical proposal:  A concept report (8-10 pages) including: o Architectural Concept design o Architectural planning strategies o Design builder comments on design brief issued initially by the employer 4 Repeated steps PI one, Then PII Two, Then PIII Three- Consecutive
  • 43.
    6. Deliverables CCAP ModuleEarly Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail  Contractor presentation continued i. Contractor’s proposal which should contain:  Schematic arc. designs including the feedback from P1 provided to the design builder.  MEP package & structural conceptual design showing proposal constructability  Incorporating maintenance, cost efficiency, expendability into the design concepts  List of material and schedule of activities( high level BoQ)  Design of functions, risk, and safety assessment  Noise Management– internal/external  H. Level Plan and Building Information Modeling (BIM)  The builder comments and advice on Design Brief issued during P II feedback from P1
  • 44.
    6. Deliverables CCAP ModuleEarly Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail  Contractor presentation (continued) i. Complete over view to cape up the design topics including:  Further Developed Design including all views and Sections  Architectural, structural, and MEP detailed drawings (as advised) and RISK maturity.  Design for safety, functional design, Constructability, potential value engineering.  Table of details, windows, doors, finishes, and etc.  Project schedule feedback from P2 IN DB employer should not go beyond concept design/ retransfer the design risk
  • 45.
     Two Stagescontract strategy in practice (Summary) • Employer invites (4-6) of qualified contractors for RFP based on concept design & employer requirement • Employer selects the suitable proposals and negotiates with the potential contractors for a design and build contract based on the contractor's screened proposal. • Hence, employer enters with the selected contractor into an agreement for the design and build (or else other) contract in two stages: CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
  • 46.
     Two Stagescontract strategy (continued). • 1st stage (cost plus agreement) is to provide descriptive Lump-sum priced proposal with a D&B contract document and sufficient illustrative design that enables the employer for informed decision based on their project perspective and needs, this stage is ECI. • Further to the employer acceptance for the proposal and after due technical and commercial negotiations, the employer may decide to enter an agreement for the second stage which incorporates a LS- DB contract based on agreed contract document and the illustrative design where: o the contractor develops the detailed design and construction drawings and BIM model (4D – 5D- or else agreed). CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
  • 47.
     Challenges inapplying ECI 1. How to comply with Public Tender Law. 2. No exceptions in tendering procedure (apply equity with all contractors). 3. No consideration for the trustworthy- previous engagement- unique experience. 4. The starting point is the same for all (prequalification/short list) system. 5. However, the public authority can still implement the ECI through: 5.1 direct purchase order with a contractor of unique or specific experience. 5.2 Competition for Seeking a concept design solution. 6. Employer general challenges as ECI is not practical for small projects as the C/B ratio is not attractive. 7. Contractor interest may decline after stage 1 or some of his team leaves and learning curve restarts. CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail
  • 48.
    7. Lessons Learntand recommendations CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 1. Identify Cut-Off Date for Alternative Design proposals. 2. Maintain design intent in alternative designs. (Brief narrative). 3. Differentiate: Alternative Design : Scope Reduction : material differences 4. Entire review for the alternative proposals. (by Employer/consultant). 5. Consultants to provide clear answers to the contractors RFC. Q&A 6. Alternative designs to add value: productivity, safety, quality, LEED, and constructability. 7. Return/disqualify non adding value proposal ASAP. 8. Implement objective review and evaluation criteria.
  • 49.
    7. Lessons Learntand recommendations CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismailies • ECI can be adopted in DBB, DB. • Current Procurement culture needs adaptation • Adopt to change the practice. • Promotes Partnering in Tendering environment; • Keep HSE, competitive, sustainable ethical tender environment • ECI ensures:  Enhanced greater productivity  Higher understanding on scheduling of constructability matters  Improves Contractors capabilities and understanding on the design & project execution
  • 50.
    7. Lessons Learntand recommendations (continued) CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail • Consider ECI for bigger projects ( 500.0 M SAR) and complicated projects. • Shortlisted contractor’s 4-6. • Mange confidentiality of the process/ design or alternative proposals to be protected. • Reimburse the unsuccessful tenderers • Look for incentives to attract the competent design builders for the mega and complicated projects and change the culture of traditional bidders
  • 51.
    A Comparison between Traditional Bidders and ECI competitors CCAPModule Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail Particular Conventional Bid Competitors ECI Competitors Information exchange Disputed consultant contribution for inconsistency and providing informed decisions. Consultants/Employer are responsible for providing sufficient information Project duration Time risk is identified and managed over the project phases Realistic schedule is expected as a result of ECI and joint communication. Demands on Time Flexible Bid time enables bidders to observe and self- inspect their priorities. Intensive tender documents require the bidder to allocate a team. Commitment Bidders’ commitments depend on the time available (irregular commitment). More commitment is mandated due to timely deliverables for Bid package. Tendering Costs Bidders have different options to select their target bids The bidders are committed to one bid- ECI- meaning high opportunity cost; also assigned team cost. Involve sole contractor and incentify him. Reliability of Proprietary Information The bidders may need to disclose their own information as the case may be. The bidders are subject to disclose their own information ( no-how and experience records) with the stakeholders and bidders may be reluctant. Risk Management Lower risk management Higher risk management Design time frame Incomplete design and deficiencies are risks identified and priced causing higher bid price. Joint effort is carried on to develop the design. Forecasts and expectations Construction Methodology or VE may be out of the box Gradual development and joint design Price basis Traditional cost estimate, contingencies, and bidders insights Healthy pricing based on the bidder early involvement in the design package.
  • 52.
    Prime ECI Objectedimpact CCAP Module Early Contractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ECI Time Copression Risk Management Cost Verification Claims Mitigation
  • 53.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ECI Enhanced business relationship Risk management Cost certainty Time compression ECI : early contractor involvement Claim : potential claims types Design claim EOT claim Claim Scope claim Termination claim Mitigation impact not applicable Impact of ECI approach on construction claims Objected Impact and Main claims interaction Module in ECI
  • 54.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 8. Case Study ‫التذكاري‬ ‫زايد‬ ‫صرح‬ ‫مشروع‬ •‫وصف‬‫المشروع‬: •‫هو‬‫صرح‬‫تذكاري‬‫يخلد‬‫الذكرى‬‫المئوية‬‫لميالد‬‫القائد‬‫المؤسس‬‫المغفور‬‫له‬‫الشيخ‬‫زايد‬‫بن‬‫سلطان‬ ‫آل‬‫نهيان‬،‫طيب‬‫هللا‬‫ثراه‬،‫ويشكل‬‫منارة‬‫لألجيال‬‫المقبلة‬،‫وذلك‬‫في‬‫إطار‬‫إعالن‬‫صاحب‬‫السمو‬ ‫الشيخ‬‫خليفة‬‫بن‬‫زايد‬‫آل‬‫نهيان‬‫رئيس‬‫الدولة‬‫حفظه‬‫هللا‬‫عام‬2018(‫عام‬‫زايد‬). •‫يقع‬‫موقع‬‫الصرح‬‫التذكاري‬‫عند‬‫تقاطع‬‫شارعي‬‫األول‬‫والثاني‬‫على‬‫طول‬‫كورنيش‬‫أبوظبي‬،‫ويضم‬ 3.3‫هكتارات‬‫من‬‫المساحات‬‫العامة‬. •‫بالقرب‬‫من‬‫الحديقة‬،‫هناك‬‫العديد‬‫من‬‫الميزات‬‫التي‬‫يمكن‬‫استكشافها‬،‫بما‬‫في‬‫ذلك‬‫قناة‬‫ما‬‫ئية‬‫ترمز‬ ‫إلى‬‫الفلج‬«‫أنظمة‬‫الري‬‫القديمة‬‫التي‬‫يستخدمها‬‫سكان‬‫شبه‬‫الجزيرة‬‫العربية‬»،‫فيما‬‫تعر‬‫ض‬ ‫الحديقة‬‫للزوار‬‫مجموعة‬‫من‬‫النباتات‬‫المحلية‬‫المستخدمة‬ً‫تقليديا‬‫لخصائصهم‬‫الطبية‬،‫م‬‫ثل‬‫قطن‬ ‫الصحراء‬‫الحناء‬‫شجرة‬‫فرشاة‬‫األسنان‬‫األعشاب‬‫القلوية‬‫كارالوما‬‫وهرمال‬.
  • 55.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 8. Case Study ‫التذكاري‬ ‫زايد‬ ‫صرح‬ ‫مشروع‬Procured under ECI: 4 Bidders, Reimbursement and select the H. score proposal.
  • 56.
    55 55 Final HINT CONSTRUCTION CONTRACTSAPPLIED PROGRAM Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫العقد‬ ‫أطراف‬ ‫إللتزامات‬ ‫نماذج‬ ‫السعودى‬ ‫األشغال‬ ‫عقد‬-‫العامــــــــة‬ ‫الشــــــروط‬:‫مصمم‬ ‫وجود‬ ‫حالة‬ ‫فى‬-‫وعطاءات‬ ‫منافسة‬-‫تنفيذ‬ ‫مقاول‬ ‫رقم‬ ‫المادة‬(10:)‫الموقع‬ ‫معاينة‬ 10/1‫على‬‫المقاول‬‫أن‬‫يقوم‬‫على‬‫حسابه‬‫الخاص‬‫بفحص‬‫ومعاينة‬‫الموقع‬‫واألماكن‬‫المحيطة‬‫به‬‫وأن‬‫يتأكد‬‫بن‬‫فسه‬‫وقبل‬ ‫تقديم‬‫العطاء‬‫من‬‫شكل‬‫الموقع‬‫وطبيعة‬‫تربته‬‫والقيام‬‫بعمل‬‫الحسابات‬‫والثقوب‬‫التي‬‫تمكنه‬‫من‬‫ذلك‬‫وكذل‬‫ك‬‫يقوم‬‫بمراجعة‬ ‫كميات‬‫العمل‬‫وطبيعته‬‫والمواد‬‫الالزمة‬‫إلنجاز‬‫األعمال‬‫ووسائل‬‫الوصول‬‫إلى‬‫الموقع‬‫والمرافق‬‫التي‬‫يحتاج‬‫إل‬‫يها‬‫وعليه‬ ‫بصورة‬‫عامة‬‫أن‬‫يحصل‬‫لنفسه‬‫على‬‫سائر‬‫المعلومات‬‫الضرورية‬‫وغيرها‬‫من‬‫العوامل‬‫التي‬‫قد‬‫تؤثر‬‫على‬‫عطا‬‫ئه‬. ‫يجب‬‫توضيح‬‫اإللتزامات‬‫بالشروط‬‫الخاصة‬‫بالتفصيل‬‫ألن‬‫هذا‬‫النص‬‫عام‬‫وتم‬‫صياغته‬‫بعبارات‬‫فضف‬‫اضة‬‫يؤدى‬ ‫إلى‬‫الخالفات‬‫بين‬‫أطراف‬‫العقد‬.
  • 57.
    56 56 Final HINT CONSTRUCTION CONTRACTSAPPLIED PROGRAM Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫العقد‬ ‫أطراف‬ ‫إللتزامات‬ ‫نماذج‬ ‫السعودى‬ ‫األشغال‬ ‫عقد‬-‫العامــــــــة‬ ‫الشــــــروط‬:‫مصمم‬ ‫وجود‬ ‫حالة‬ ‫فى‬-‫وعطاءات‬ ‫منافسة‬-‫تنفيذ‬ ‫مقاول‬ ‫رقم‬ ‫المادة‬(10:)‫الموقع‬ ‫معاينة‬ 10/2‫ا‬ ‫إبالغ‬ ‫وعليه‬ ‫تفاصيلها‬ ‫بكامل‬ ‫والفنية‬ ‫الهندسية‬ ‫التصميمات‬ ‫مراجعة‬ ‫عن‬ ‫مسئوال‬ ‫المقاول‬ ‫يعتبر‬‫أو‬ ‫إلستشاري‬ ‫التنفيذ‬ ‫أثناء‬ ‫والرسومات‬ ‫المخططات‬ ‫في‬ ‫يكتشفها‬ ‫مالحظات‬ ‫أو‬ ‫أخطاء‬ ‫أية‬ ‫عن‬ ‫العمل‬ ‫صاحب‬. ‫يجب‬‫إعادة‬‫توضيح‬‫البند‬‫بالشروط‬‫الخاصة‬‫ليكون‬‫أطراف‬‫العقد‬‫على‬‫بيينة‬‫من‬‫اإللتزام‬‫المتبادل‬‫بشأن‬‫الت‬‫صميم‬‫المقدم‬ ‫من‬‫المالك‬‫والمعد‬‫يمعرفة‬‫مصمم‬‫محترف‬‫بموجب‬‫عقد‬‫تصميم‬‫يتحمل‬‫المصمم‬‫بموجبه‬‫المسئولية‬‫القياسية‬‫ع‬‫ن‬ ‫التصميم‬. ‫وقد‬‫يذهب‬‫تفسير‬‫المالك‬‫بأن‬‫المطلوب‬‫من‬‫المقاول‬‫إعادة‬‫التصميم‬‫أو‬‫المراجعة‬‫وكما‬‫لو‬‫كانت‬‫التصميمات‬‫مقدم‬‫ة‬‫منه‬ ‫وهذا‬‫يتطلب‬‫مضاعفة‬‫وقت‬‫التصميم‬‫وتكاليف‬‫التصميم‬‫،مما‬‫يتنافى‬‫مع‬‫خطة‬‫المالك‬‫بإختيار‬‫نوع‬‫العقد‬‫ع‬‫ملية‬‫تصمم‬- ‫منافسة‬‫وعطاءات‬-‫مقاول‬‫تنفيذ‬.
  • 58.
    57 57 Final HINT CONSTRUCTION CONTRACTSAPPLIED PROGRAM Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫العقد‬ ‫أطراف‬ ‫إللتزامات‬ ‫نماذج‬ ‫ماهى‬‫الطريقة‬‫المناسبة‬‫للتعامل‬‫مع‬‫مسئولية‬‫التصميم‬-‫عامة‬‫فى‬‫عقود‬‫التصميم‬-‫الطرح‬‫التنفيذ‬ ‫أى‬‫فى‬‫حالة‬‫وجود‬‫مصمم‬-‫منافسة‬‫وعطاءات‬-‫مقاول‬‫تنفيذ‬. .I‫إجراءات‬‫المالك‬: ‫يجب‬‫التوضيح‬‫واإلضافة‬‫والتفسير‬‫بدقة‬‫إللتزامات‬‫مقاول‬‫التنفيذ‬‫بالشروط‬‫الخاصة‬‫بالتفصيل‬‫لي‬‫كون‬‫أطراف‬‫العقد‬ ‫على‬‫دراية‬‫بالمسئوليات‬‫التعاقدية‬‫المتفق‬‫عليها‬: 1-‫هل‬‫سيراجع‬‫المقاول‬‫التصميم‬‫المستلم‬‫من‬‫المالك‬‫بنظرة‬‫عامة‬‫سريعة‬‫إلستخراج‬‫أى‬‫عيوب‬‫أو‬‫تعارضات‬‫ظا‬‫هرية‬ ‫أى‬‫عيوب‬‫واضحة‬‫جدا‬. 2-‫هل‬‫يطلب‬‫المالك‬‫مراجعة‬‫تفصيلية‬‫بمعنى‬‫إعادة‬‫التصميم‬‫والتكاليف‬‫هنا‬‫يتوقف‬‫على‬‫مقدار‬‫المعلومات‬‫ا‬‫لمرفقة‬ ‫بالرسومات‬‫والدفاتر‬‫الحسابية‬‫والنماذج‬‫الحسابية‬‫المعدة‬‫ببرامج‬‫التصميم‬‫الحاسوبى‬. 3-‫قد‬‫يطلب‬‫المالك‬‫بنود‬‫محددة‬‫بالحسابات‬‫اإلنشائية‬/‫الكهربية‬/‫الميكانيكية‬. 4-‫مقترح‬‫آخر‬‫للمالك‬‫أو‬‫المقاول‬
  • 59.
    58 58 Final HINT CONSTRUCTION CONTRACTSAPPLIED PROGRAM Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫العقد‬ ‫أطراف‬ ‫إللتزامات‬ ‫نماذج‬ ‫ماهى‬‫الطريقة‬‫المناسبة‬‫للتعامل‬‫مع‬‫مسئولية‬‫التصميم‬-‫عامة‬‫فى‬‫عقود‬‫التصميم‬-‫الطرح‬‫التنفيذ‬ ‫أى‬‫فى‬‫حالة‬‫وجود‬‫مصمم‬-‫منافسة‬‫وعطاءات‬-‫مقاول‬‫تنفيذ‬. .I‫إجراءات‬‫المقاول‬ ‫يجب‬‫على‬‫المقاول‬‫مراجعة‬‫كافة‬‫شروط‬‫العقد‬‫ومستندات‬‫العطاء‬‫وخاصة‬‫تعليمات‬‫تقديم‬‫العطاء‬‫والقانون‬‫الو‬‫اجب‬ ‫للتطبيق‬‫ثم‬‫يراعى‬‫مايلى‬‫عن‬‫تقديم‬‫العطاء‬: 1-‫يأخذ‬‫باإلعتبار‬‫أنه‬‫سوف‬‫يراجع‬‫المقاول‬‫التصميم‬‫المستلم‬‫من‬‫المالك‬‫بنظرة‬‫عامة‬‫سريعة‬‫إلستخراج‬‫أى‬‫عيوب‬‫أو‬ ‫تعارضات‬‫ظاهرية‬‫أى‬‫عيوب‬‫واضحة‬ً‫ا‬‫جد‬.(‫إعتبارات‬‫التكلفة‬‫والوقت‬). 2-‫أو‬‫يأخذ‬‫باإلعتبار‬‫أنه‬‫سوف‬‫يقوم‬‫مراجعة‬‫تفصيلية‬‫بمعنى‬‫إعادة‬‫التصميم‬‫كامال‬(‫إعتبار‬‫الوقت‬‫الت‬‫كاليف‬)‫و‬ ‫تتوقف‬‫على‬‫مقدار‬‫المعلومات‬‫المرفقة‬‫بالرسومات‬‫والدفاتر‬‫الحسابية‬‫والنماذج‬‫الحسابية‬‫المعدة‬‫ببرامج‬‫ا‬‫لتصميم‬BIM 4-‫مقترح‬‫آخر‬‫للمقاول‬ 5-‫فى‬‫كل‬‫الحاالت‬‫يجب‬‫أن‬‫يذكر‬‫المقاول‬‫بعطائه‬‫فهمه‬‫لمسئولياته‬‫عن‬‫التصميم‬‫بعبارات‬‫واضحة‬
  • 60.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail ‫مناقشة‬: -‫الظروف‬‫الطارئة‬‫والقوى‬‫القاهرة‬ -‫اإلثراء‬‫بالسبب‬ -‫إستخدام‬‫الحق‬‫بتعسف‬
  • 61.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 8. Case Study ‫مشروعًصرحًزايدًالتذكاري‬ •‫الفكرة‬‫التصميمية‬‫للمشروع‬: •‫في‬‫عام‬2013‫تم‬‫تكليف‬‫الفنان‬‫األميركي‬‫العالمي‬‫رالف‬‫هيلمك‬‫ليكون‬ً‫مسؤول‬‫عن‬‫تصميم‬‫وبناء‬‫صرح‬‫ز‬‫ايد‬ ‫المؤسس‬‫حيث‬‫استغرقت‬‫مدة‬‫دراسة‬‫وتنفيذ‬‫المشروع‬‫نحو‬6‫سنوات‬،‫ويصف‬‫الصرح‬‫الجديد‬‫تاريخ‬‫وحاضر‬ ‫ومستقبل‬‫المنطقة‬،ً‫نظرا‬‫لكون‬‫األمر‬‫يتعلق‬‫بأهم‬‫وأحكم‬‫شخصية‬‫على‬‫اإلطالق‬‫تواجدت‬‫بالمنطقة‬‫في‬‫ال‬‫عقود‬ ‫الماضية‬. •‫يستند‬‫التصميم‬‫على‬‫تصور‬‫بناء‬‫صرح‬‫مبتكر‬‫ليس‬‫له‬‫مثيل‬‫في‬‫كل‬‫الكرة‬‫األرضية‬‫باستخدام‬‫المؤث‬‫رات‬‫البصرية‬ ‫والديناميكية‬،‫كما‬‫أن‬‫للصرح‬‫خصوصية‬‫رمزية‬‫معينة‬‫يختلف‬‫بها‬‫عن‬‫الباقي‬‫ويحمل‬‫بصمات‬‫محلية‬‫تعك‬‫س‬‫الهوية‬ ‫الثقافية‬‫للبلد‬‫الذي‬‫يوجد‬‫فيه‬‫ويمثل‬ً‫أيضا‬‫إضافة‬‫معمارية‬‫ليكون‬ً‫رمزا‬‫من‬‫رموز‬‫النهضة‬‫والنجاح‬،‫و‬‫يعكس‬‫صرح‬ ‫الشيخ‬‫زايد‬‫التطور‬‫والنجاح‬‫والعصرنة‬‫التي‬‫تعيشها‬‫دولة‬‫اإلمارات‬‫التي‬‫نجحت‬‫خالل‬‫فترة‬‫زمنية‬‫بسي‬‫طة‬‫في‬‫أن‬ ‫تصبح‬‫اليوم‬‫دولة‬‫رائدة‬‫على‬‫مستوى‬‫العالم‬‫في‬‫جميع‬‫المجالت‬.
  • 62.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail 9. Conclusion • The ECI approach is used either with the stander forms of contracts like the “FIDIC” forms of contracts, Yellow Book for the Plant and design built and the X22 NEC4 or in tailored contracts. • The ECI contract may be applied in two stages and for one contractor or it may engage different contractors one for every stage. • The ECI approach can be used for the improvement of the project success certainty and mitigation of the most potential construction claims. • The influence of ECI proved to mitigate different types of claims like design claims, an extension of time claim, scope claim, liability claims, termination claims.
  • 63.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail References • Dief, M.; Elsayed A. (2020). Construction Claims Mitigation Through Early Contractor Involvement Vol. IX, Issue V – May. Available online https://pmworldlibrary.net/wp-content/uploads /2020/05 /pmwj93-May2020-Ismail-Elsayed- Construction-Claims-Mitigation-Through-Early-Contractor-Involvement.pdf • Oteifa, S. and Abu Dief, M. (2016), Application of FIDIC Contracts in Construction Claims and Arbitration. IntJRecentSci Res. 7(9), pp. 13351-13356. • Rahman, M. & Alhassan, A. (2012). A contractor's perception on early contractor involvement. Built Environment Project and Asset Management, 2, 217-233. • Walker, D. H. & Lloyd-Walker, B. Understanding early contractor involvement (ECI) procurement forms. Twenty-Eighth ARCOM Annual Conference, Edinburgh, 2012. Twenty-Eighth ARCOM Annual Conference, Edinburgh, 5-7. Walker, D. H. & Lloyd- • Wondimu, P. et al., (2017). Implementation of Early Contractor Involvement (ECI) in Norwegian Bridge Projects Procurement.
  • 64.
    CCAP Module EarlyContractor Involvement Contract Administration Module 1010 R1 2020- by Dr.Moustafa Ismail End of Lecture Construction claims mitigation through Early Contractor Involvement By: Moustafa I. Abu Dief ‫وبركاته‬ ‫هللا‬ ‫ورحمة‬ ‫عليكم‬ ‫السالم‬ https://www.linkedin.com/in/dr-moustafa-ismail-cfcc-mciob-rmp- pmp-arics-93798a16/ • ‫بالمشروع‬ ‫المبكرة‬ ‫المقاول‬ ‫مشاركة‬ ‫خالل‬ ‫من‬ ‫التشييد‬ ‫مشروعات‬ ‫مطالبات‬ ‫من‬ ‫التخفيف‬ Construction Contracts Applied Program- CCAP Module 1010 –R1 2020
