September 2011EdgilisProject Management Risks for Rail projects in Brazil
Introduction to EdgilisOverview of Project Risk ManagementPreliminary Findings from Brazil StudyRecommendations and Next Steps
Edgilis: Asian base, Global reachFounded in 2006 in Singapore with representative office in Paris and Doha60 staff members worldwideWide range of consulting servicesClient base includes multinationals, technology blue-chips and governmentSpecialized in transportation and infrastructure projectsFocused on emerging markets (Asia, Middle-East, Africa and Latin America)
Accolades & DistinctionsTop Finalist at Emerging Enterprise Award 2010EDB International Headquarters Award in 2009PMI Registered Education Provider since 2008ISO 9001 certifiedMember of the French Chamber of Commerce in Singapore, Singapore Business Federation, Institution of Engineers Singapore
IndustriesWe serve our clients in many industries worldwide
Introduction to EdgilisOverview of Project Risk ManagementPreliminary Findings from Brazil StudyRecommendations and Next Steps

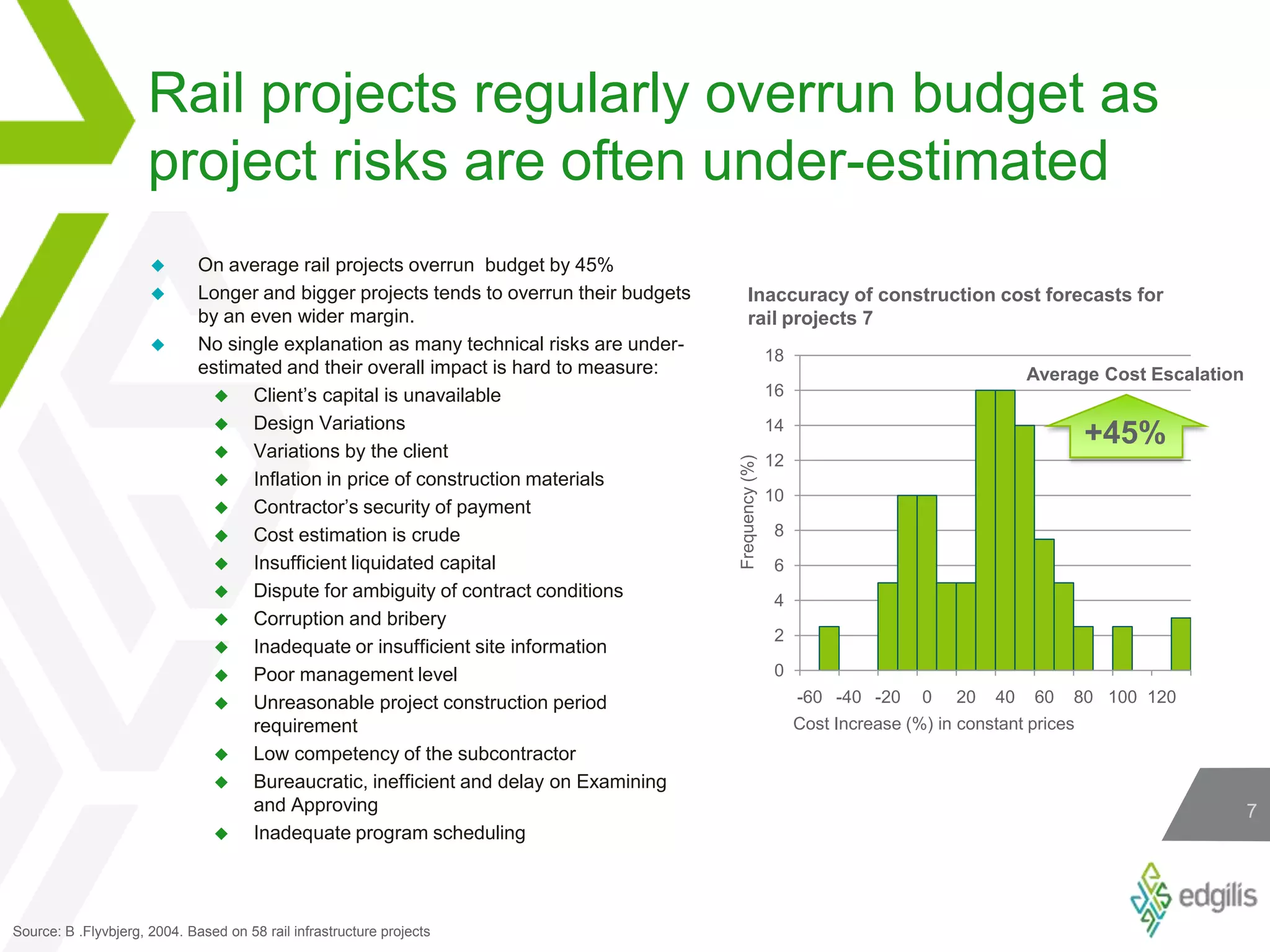

Rail projects regularly overrun budget as project risks are often under-estimatedOn average rail projects overrun  budget by 45%Longer and bigger projects tends to overrun their budgets by an even wider margin. No single explanation as many technical risks are under-estimated and their overall impact is hard to measure: Client’s capital is unavailableDesign VariationsVariations by the clientInflation in price of construction materialsContractor’s security of paymentCost estimation is crudeInsufficient liquidated capitalDispute for ambiguity of contract conditionsCorruption and briberyInadequate or insufficient site informationPoor management levelUnreasonable project construction period requirementLow competency of the subcontractorBureaucratic, inefficient and delay on Examining and ApprovingInadequate program schedulingInaccuracy of construction cost forecasts for rail projects 7Average Cost Escalation+45%Frequency (%)Cost Increase (%) in constant pricesSource: B .Flyvbjerg, 2004. Based on 58 rail infrastructure projects

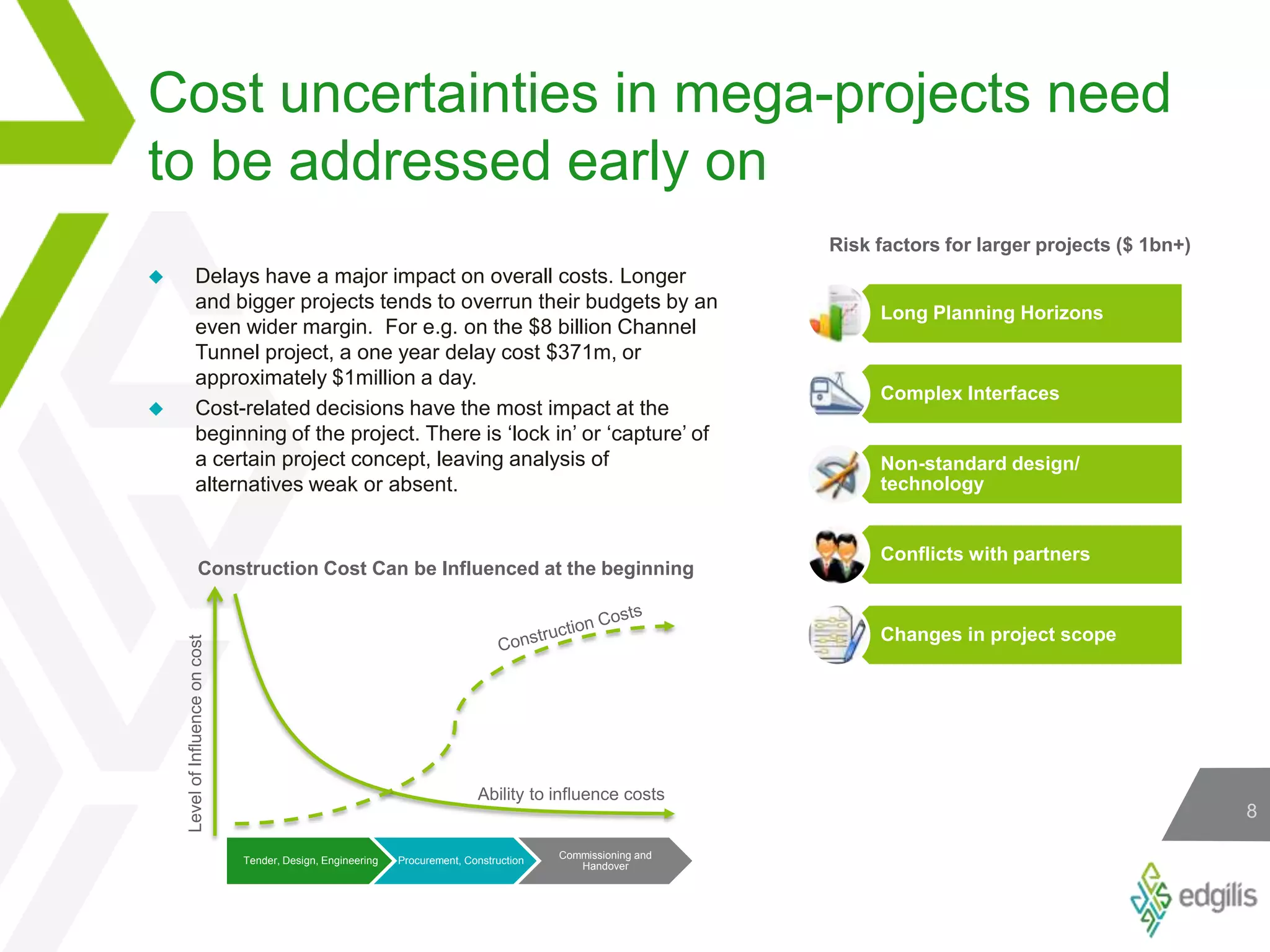

Cost uncertainties in mega-projects need to be addressed early onRisk factors for larger projects ($ 1bn+)Delays have a major impact on overall costs. Longer and bigger projects tends to overrun their budgets by an even wider margin.  For e.g. on the $8 billion Channel Tunnel project, a one year delay cost $371m, or approximately $1million a day.

Cost-related decisions have the most impact at the beginning of the project. There is ‘lock in’ or ‘capture’ of a certain project concept, leaving analysis of alternatives weak or absent. Construction Cost Can be Influenced at the beginningConstruction CostsLevel of Influence on costAbility to influence costs

Top 10 risks as per their significance in relation to project objectivesSource: Identifying Key Risks in Construction Projects: Life Cycle and Stakeholder Perspectives, Dr Patrick. X.W. Zou, Dr Guomin Zhang and Professor Jia-Yuan Wang
Risk Factors in a Consortium
Introduction to EdgilisOverview of Project Risk ManagementPreliminary Findings from Brazil StudyRecommendations and Next Steps

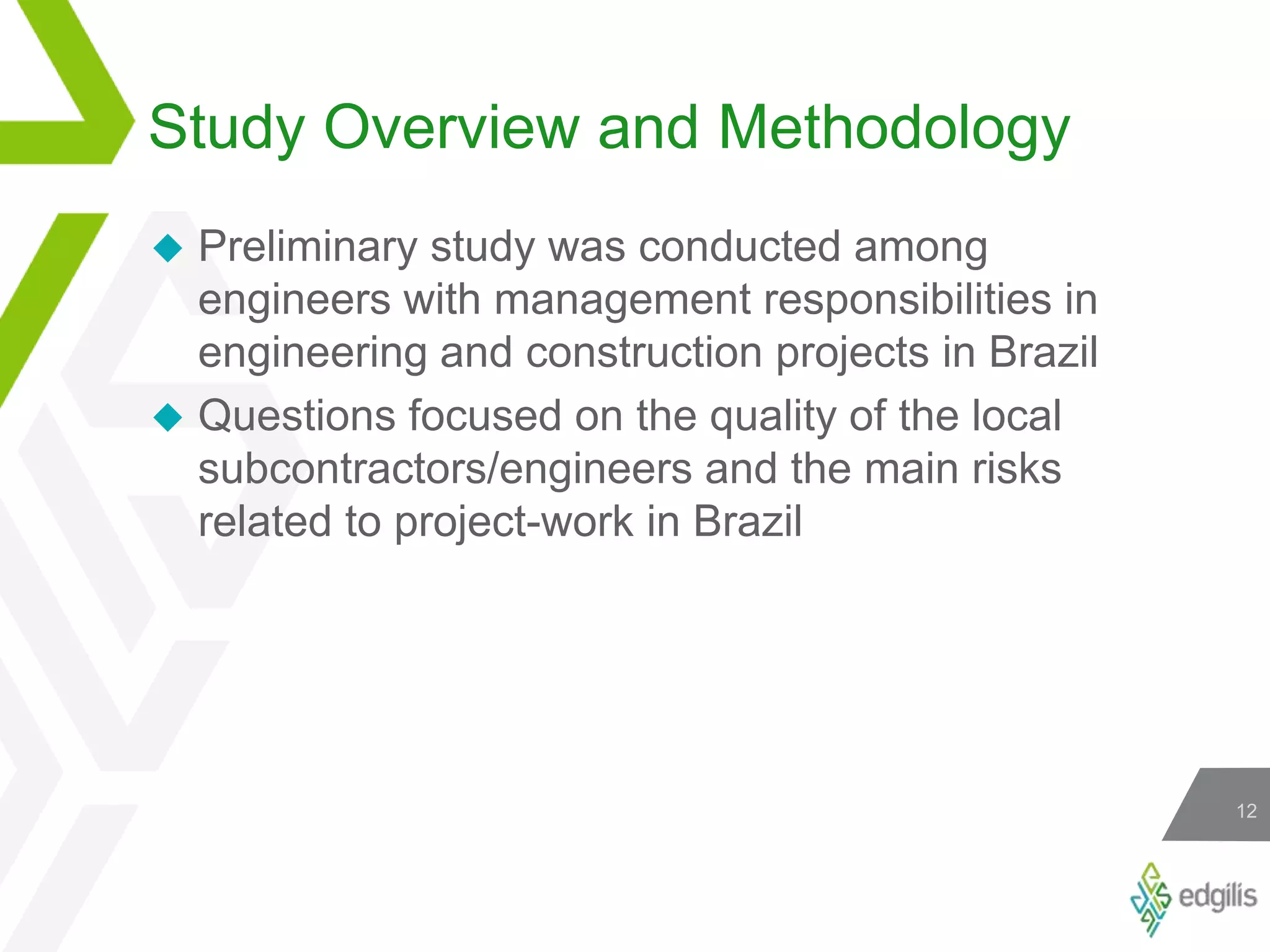

Study Overview and MethodologyPreliminary study was conducted among engineers with management responsibilities in engineering and construction projects in BrazilQuestions focused on the quality of the local subcontractors/engineers and the main risks related to project-work in Brazil

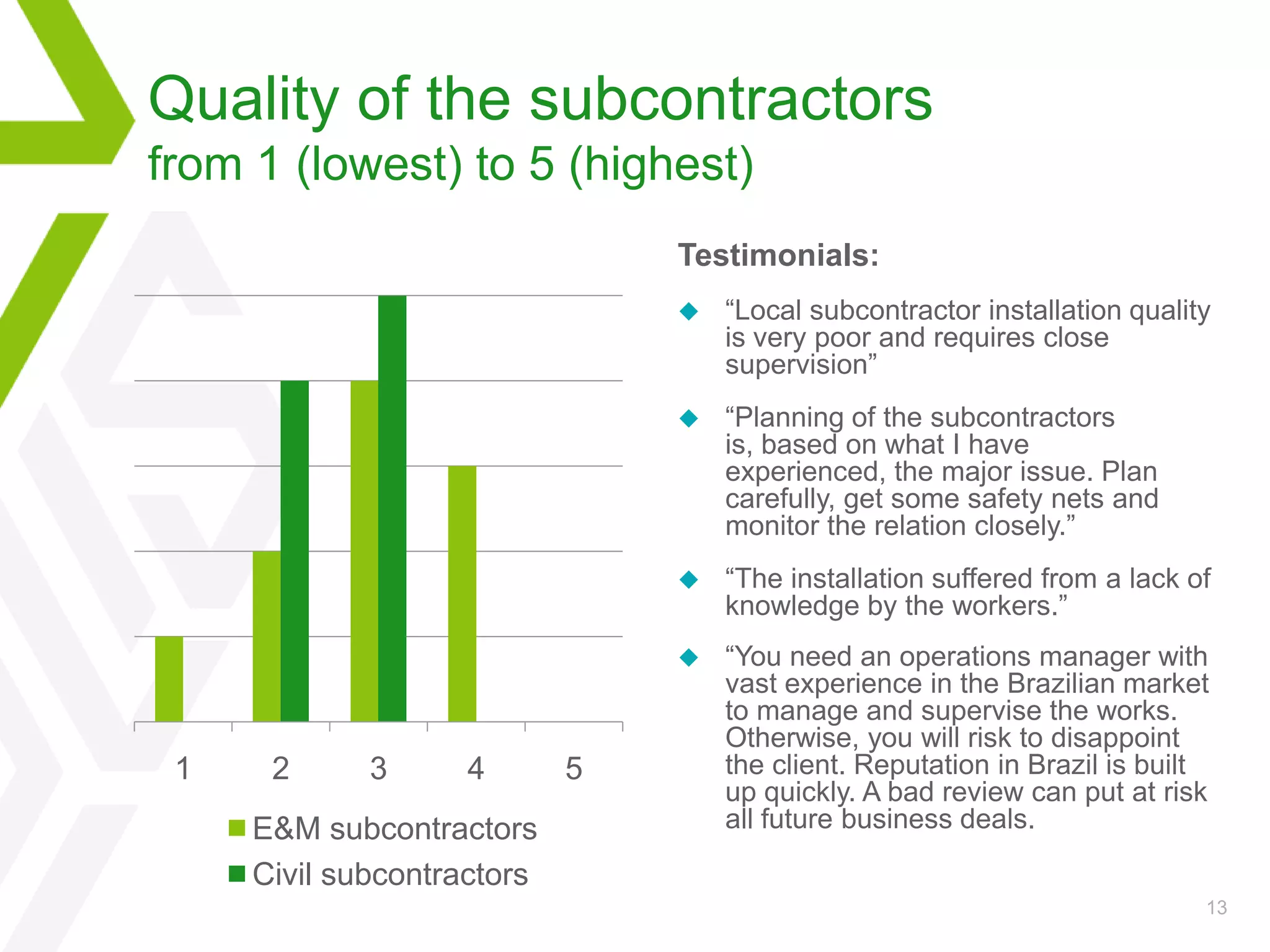

Quality of the subcontractors from 1 (lowest) to 5 (highest)Testimonials:“Local subcontractor installation quality is very poor and requires close supervision”“Planning of the subcontractors is, based on what I have experienced, the major issue. Plan carefully, get some safety nets and monitor the relation closely.”“The installation suffered from a lack of knowledge by the workers.”“You need an operations manager with vast experience in the Brazilian market to manage and supervise the works. Otherwise, you will risk to disappoint the client. Reputation in Brazil is built up quickly. A bad review can put at risk all future business deals.

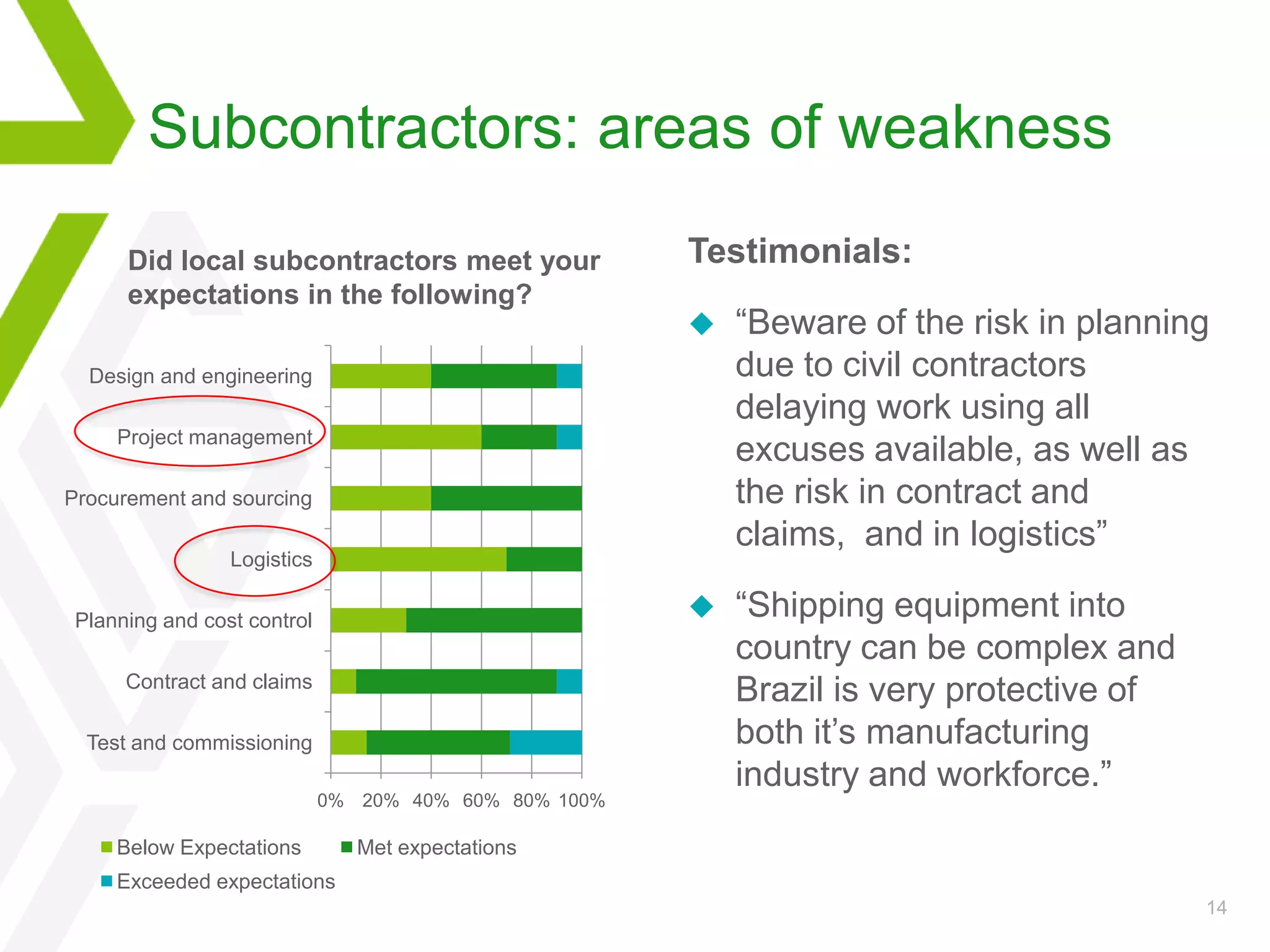

Subcontractors: areas of weaknessTestimonials:“Beware of the risk in planning due to civil contractors delaying work using all excuses available, as well as the risk in contract and claims,  and in logistics”“Shipping equipment into country can be complex and Brazil is very protective of both it’s manufacturing industry and workforce.”Did local subcontractors meet your expectations in the following?

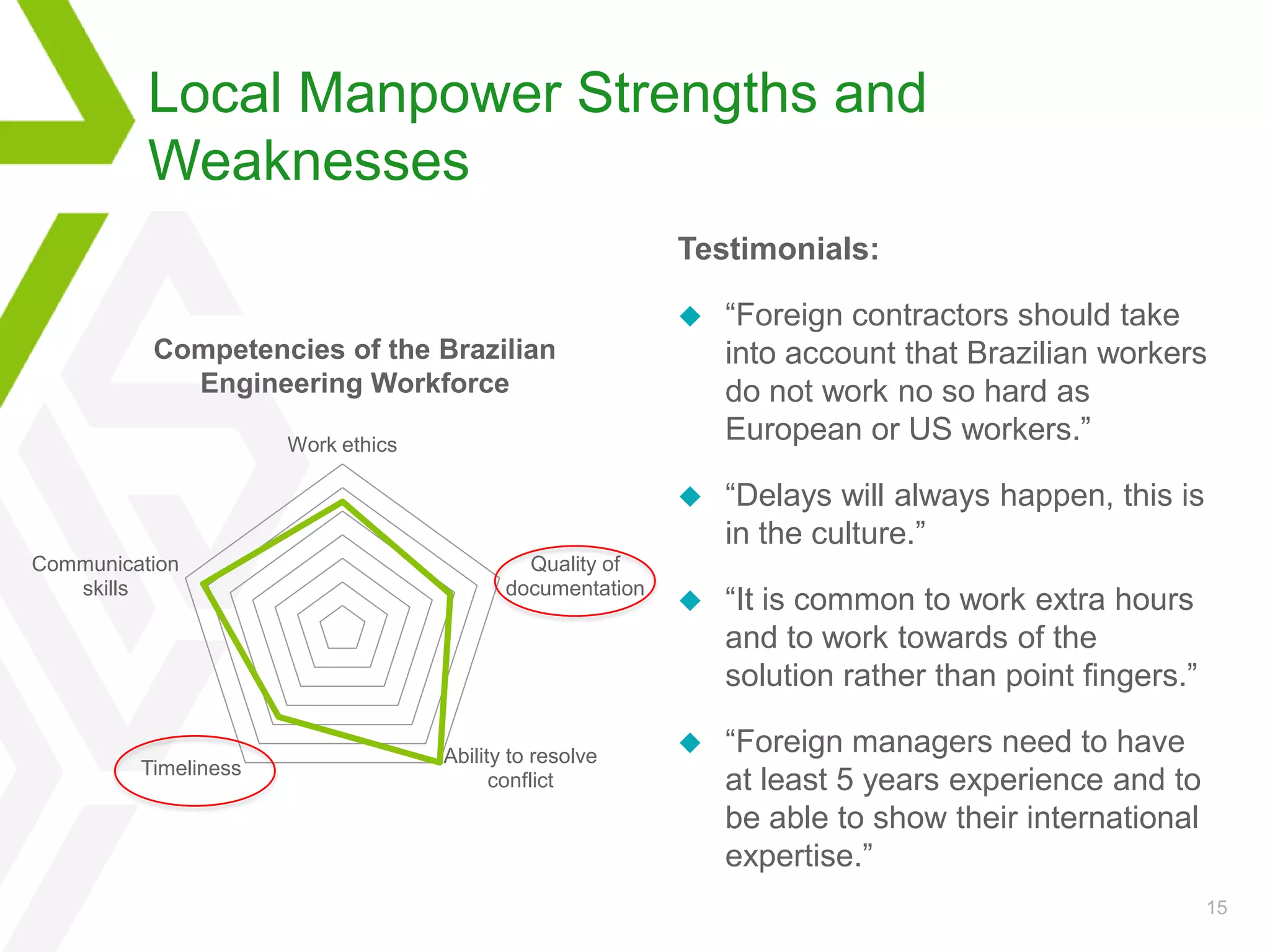

Local Manpower Strengths and WeaknessesTestimonials:“Foreign contractors should take into account that Brazilian workers do not work no so hard as European or US workers.”“Delays will always happen, this is in the culture.”“It is common to work extra hours and to work towards of the solution rather than point fingers.”“Foreign managers need to have at least 5 years experience and to be able to show their international expertise.”Competencies of the Brazilian Engineering Workforce
Introduction to EdgilisOverview of Project Risk ManagementPreliminary Findings from Brazil StudyRecommendations and Next Steps

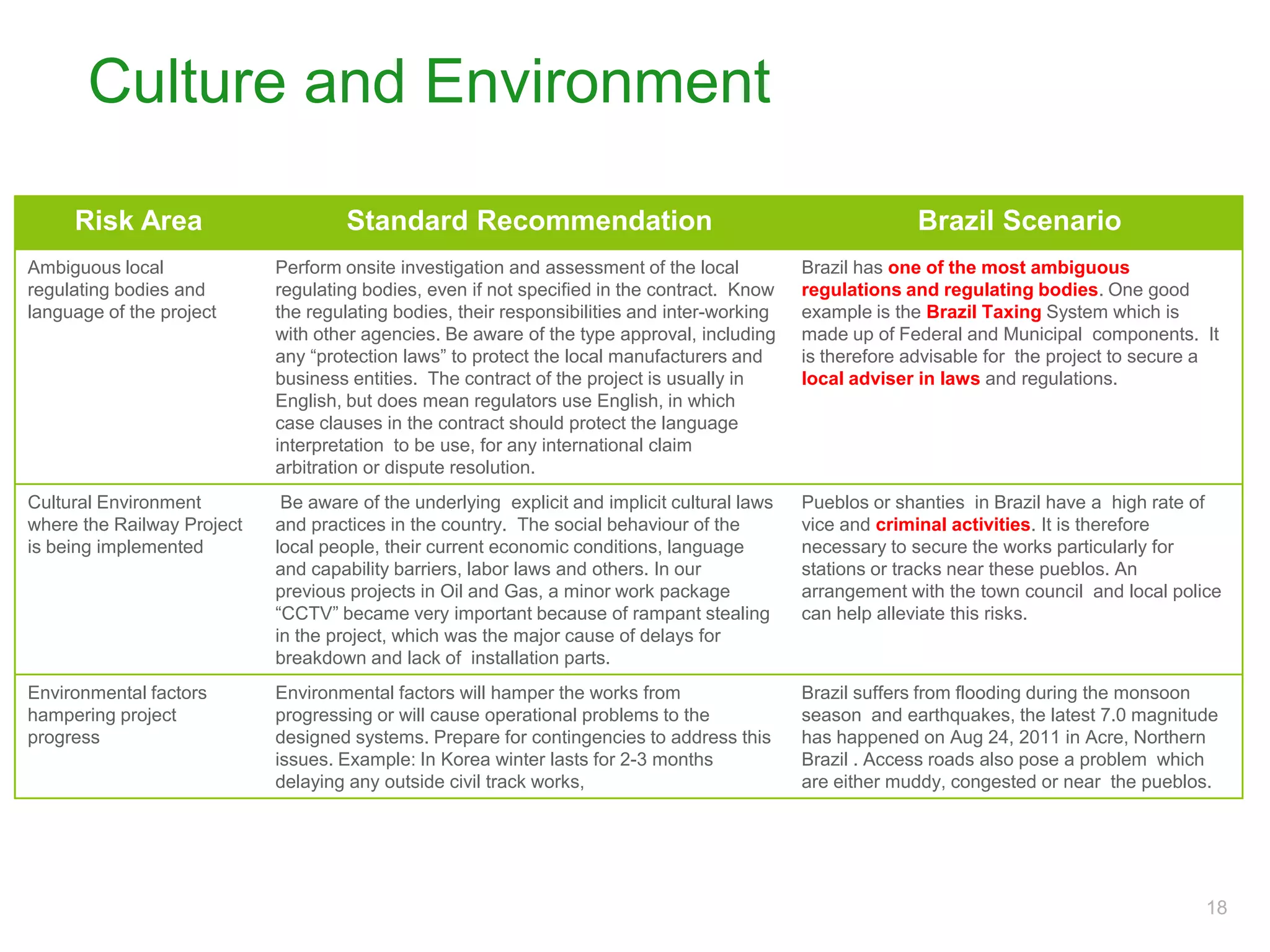

Contract Management Risks

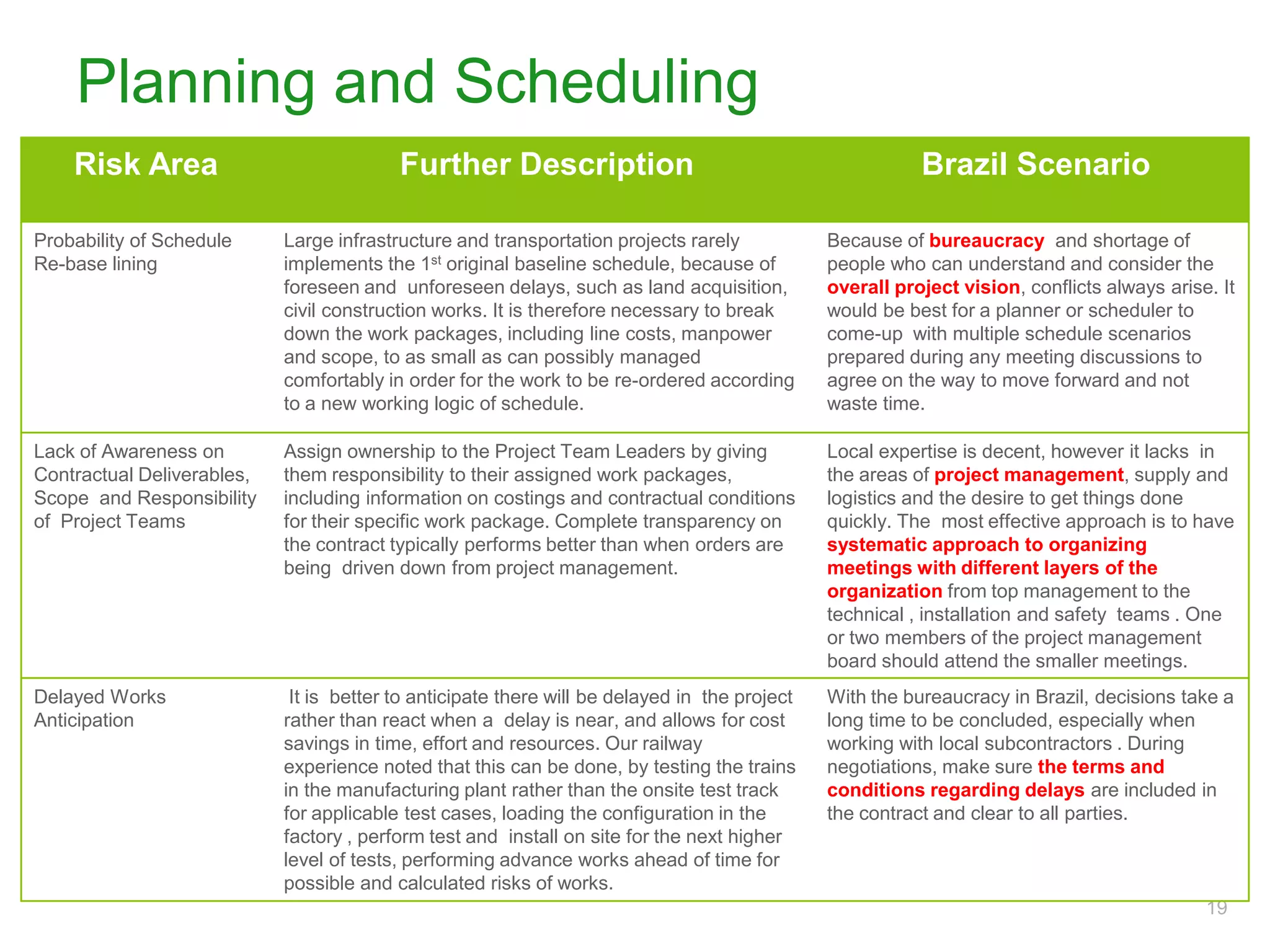

Culture and Environment

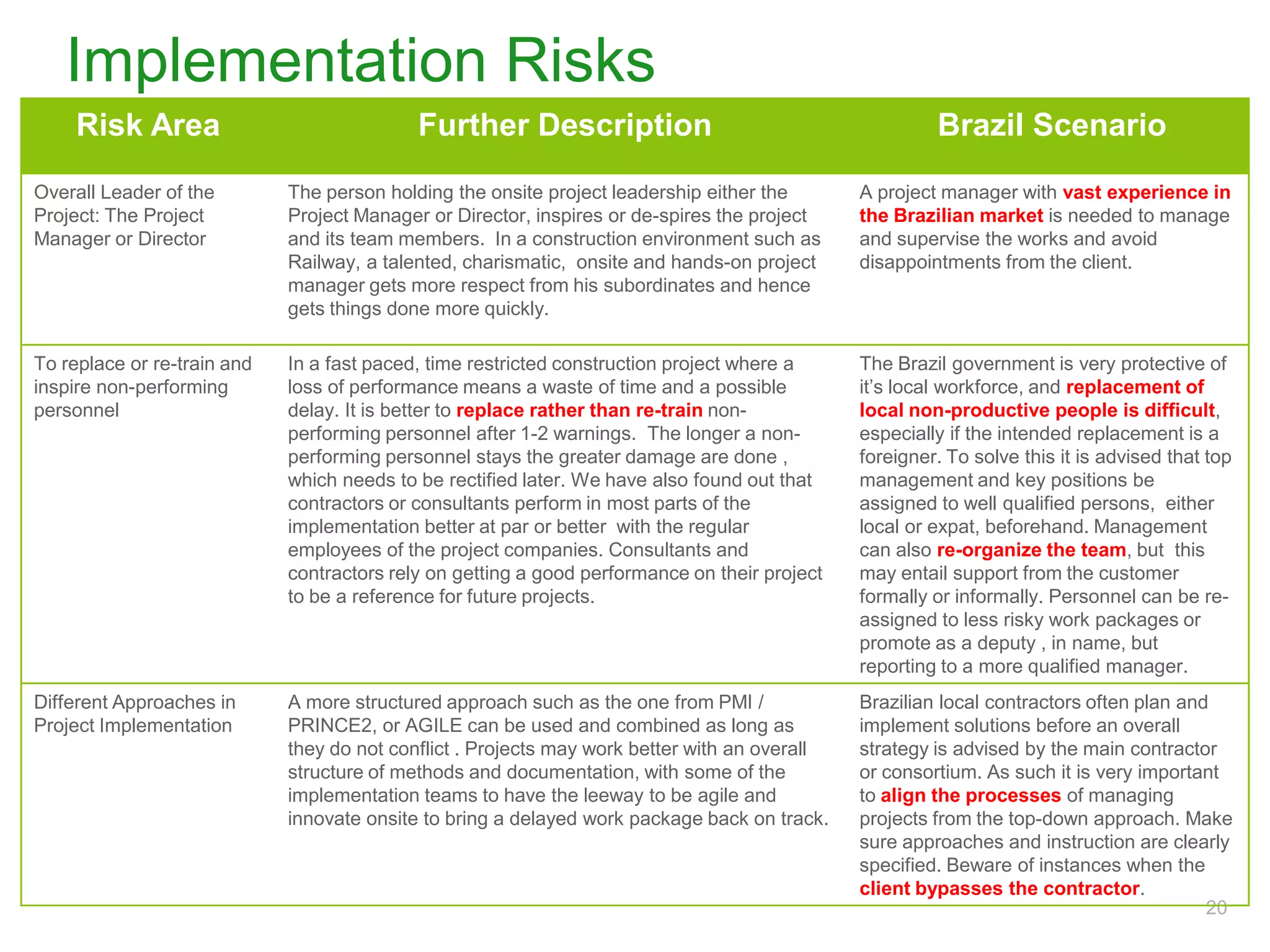

Planning and Scheduling
Implementation Risks

Project management risks for rail projects

  • 1.
    September 2011EdgilisProject ManagementRisks for Rail projects in Brazil
  • 2.
    Introduction to EdgilisOverviewof Project Risk ManagementPreliminary Findings from Brazil StudyRecommendations and Next Steps
  • 3.
    Edgilis: Asian base,Global reachFounded in 2006 in Singapore with representative office in Paris and Doha60 staff members worldwideWide range of consulting servicesClient base includes multinationals, technology blue-chips and governmentSpecialized in transportation and infrastructure projectsFocused on emerging markets (Asia, Middle-East, Africa and Latin America)
  • 4.
    Accolades & DistinctionsTopFinalist at Emerging Enterprise Award 2010EDB International Headquarters Award in 2009PMI Registered Education Provider since 2008ISO 9001 certifiedMember of the French Chamber of Commerce in Singapore, Singapore Business Federation, Institution of Engineers Singapore
  • 5.
    IndustriesWe serve ourclients in many industries worldwide
  • 6.
    Introduction to EdgilisOverviewof Project Risk ManagementPreliminary Findings from Brazil StudyRecommendations and Next Steps
  • 7.
    Rail projects regularlyoverrun budget as project risks are often under-estimatedOn average rail projects overrun budget by 45%Longer and bigger projects tends to overrun their budgets by an even wider margin. No single explanation as many technical risks are under-estimated and their overall impact is hard to measure: Client’s capital is unavailableDesign VariationsVariations by the clientInflation in price of construction materialsContractor’s security of paymentCost estimation is crudeInsufficient liquidated capitalDispute for ambiguity of contract conditionsCorruption and briberyInadequate or insufficient site informationPoor management levelUnreasonable project construction period requirementLow competency of the subcontractorBureaucratic, inefficient and delay on Examining and ApprovingInadequate program schedulingInaccuracy of construction cost forecasts for rail projects 7Average Cost Escalation+45%Frequency (%)Cost Increase (%) in constant pricesSource: B .Flyvbjerg, 2004. Based on 58 rail infrastructure projects
  • 8.
    Cost uncertainties inmega-projects need to be addressed early onRisk factors for larger projects ($ 1bn+)Delays have a major impact on overall costs. Longer and bigger projects tends to overrun their budgets by an even wider margin. For e.g. on the $8 billion Channel Tunnel project, a one year delay cost $371m, or approximately $1million a day.
  • 9.
    Cost-related decisions havethe most impact at the beginning of the project. There is ‘lock in’ or ‘capture’ of a certain project concept, leaving analysis of alternatives weak or absent. Construction Cost Can be Influenced at the beginningConstruction CostsLevel of Influence on costAbility to influence costs
  • 10.
    Top 10 risksas per their significance in relation to project objectivesSource: Identifying Key Risks in Construction Projects: Life Cycle and Stakeholder Perspectives, Dr Patrick. X.W. Zou, Dr Guomin Zhang and Professor Jia-Yuan Wang
  • 11.
    Risk Factors ina Consortium
  • 12.
    Introduction to EdgilisOverviewof Project Risk ManagementPreliminary Findings from Brazil StudyRecommendations and Next Steps
  • 13.
    Study Overview andMethodologyPreliminary study was conducted among engineers with management responsibilities in engineering and construction projects in BrazilQuestions focused on the quality of the local subcontractors/engineers and the main risks related to project-work in Brazil
  • 14.
    Quality of thesubcontractors from 1 (lowest) to 5 (highest)Testimonials:“Local subcontractor installation quality is very poor and requires close supervision”“Planning of the subcontractors is, based on what I have experienced, the major issue. Plan carefully, get some safety nets and monitor the relation closely.”“The installation suffered from a lack of knowledge by the workers.”“You need an operations manager with vast experience in the Brazilian market to manage and supervise the works. Otherwise, you will risk to disappoint the client. Reputation in Brazil is built up quickly. A bad review can put at risk all future business deals.
  • 15.
    Subcontractors: areas ofweaknessTestimonials:“Beware of the risk in planning due to civil contractors delaying work using all excuses available, as well as the risk in contract and claims, and in logistics”“Shipping equipment into country can be complex and Brazil is very protective of both it’s manufacturing industry and workforce.”Did local subcontractors meet your expectations in the following?
  • 16.
    Local Manpower Strengthsand WeaknessesTestimonials:“Foreign contractors should take into account that Brazilian workers do not work no so hard as European or US workers.”“Delays will always happen, this is in the culture.”“It is common to work extra hours and to work towards of the solution rather than point fingers.”“Foreign managers need to have at least 5 years experience and to be able to show their international expertise.”Competencies of the Brazilian Engineering Workforce
  • 17.
    Introduction to EdgilisOverviewof Project Risk ManagementPreliminary Findings from Brazil StudyRecommendations and Next Steps
  • 18.
  • 19.
  • 20.
  • 21.
  • 22.
    Edgilis Pte. Ltd.3 Fusionopolis Way, Symbiosis #05-20Singapore 138633T +65 6304 5311 F +65 6467 8900edgilis.com
