Skip to main content
SUPPLY CHAIN MANAGEMENT&
 DISTRIBUTION MANAGEMENT

Perishable Products (Restaurant Chain)
Presented by:
P.Saravanan SS10-12/Finance
        IIPM,Chennai

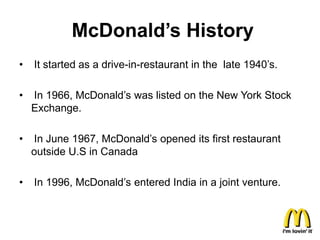

McDonald’s History
•   It started as a drive-in-restaurant in the late 1940’s.

•   In 1966, McDonald’s was listed on the New York Stock
    Exchange.

•   In June 1967, McDonald’s opened its first restaurant
    outside U.S in Canada

•   In 1996, McDonald’s entered India in a joint venture.

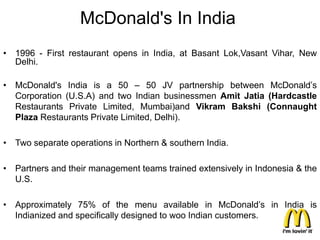

McDonald's In India
• 1996 - First restaurant opens in India, at Basant Lok,Vasant Vihar, New
  Delhi.

• McDonald's India is a 50 – 50 JV partnership between McDonald’s
  Corporation (U.S.A) and two Indian businessmen Amit Jatia (Hardcastle
  Restaurants Private Limited, Mumbai)and Vikram Bakshi (Connaught
  Plaza Restaurants Private Limited, Delhi).

• Two separate operations in Northern & southern India.

• Partners and their management teams trained extensively in Indonesia & the
  U.S.

• Approximately 75% of the menu available in McDonald’s in India is
  Indianized and specifically designed to woo Indian customers.

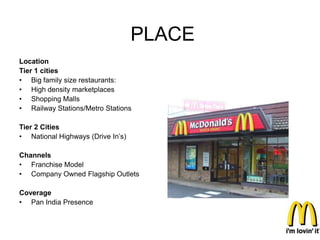

PLACE
Location
Tier 1 cities
• Big family size restaurants:
• High density marketplaces
• Shopping Malls
• Railway Stations/Metro Stations

Tier 2 Cities
• National Highways (Drive In’s)

Channels
• Franchise Model
• Company Owned Flagship Outlets

Coverage
• Pan India Presence
Co -BRANDING
• McDonald’s    has     major     tie-ups    with
  various companies as their co-branding strategy

• Few are:
   – Coco-cola
   – Barbie
   – Cadbury
   – Hotwheels
Supply Chain Management

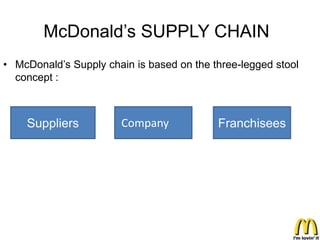

McDonald’s SUPPLY CHAIN
• McDonald’s Supply chain is based on the three-legged stool
  concept :

    Suppliers          Company             Franchisees
Vital links of Mc Donald’s cold chain.

                                 Procurement
• McDonald's spent a few
  years setting up a unique
  Cold Chain.
                                 warehousing
• The Cold Chain is necessary
  to maintain the integrity of
  food products and retain
  their freshness and            Transportation
  nutritional value.
                                  Retailing of
                                 food product

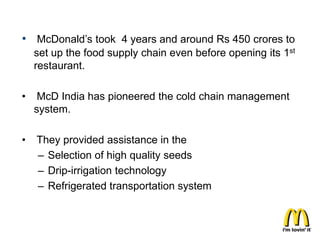

• McDonald’s took 4 years and around Rs 450 crores to
    set up the food supply chain even before opening its 1st
    restaurant.

•    McD India has pioneered the cold chain management
    system.

•   They provided assistance in the
    – Selection of high quality seeds
    – Drip-irrigation technology
    – Refrigerated transportation system

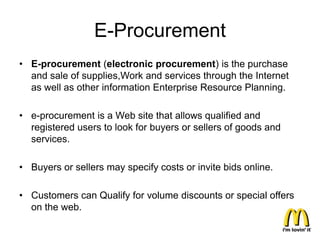

E-Procurement
• E-procurement (electronic procurement) is the purchase
  and sale of supplies,Work and services through the Internet
  as well as other information Enterprise Resource Planning.

• e-procurement is a Web site that allows qualified and
  registered users to look for buyers or sellers of goods and
  services.

• Buyers or sellers may specify costs or invite bids online.

• Customers can Qualify for volume discounts or special offers
  on the web.

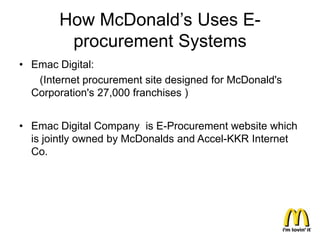

How McDonald’s Uses E-
         procurement Systems
• Emac Digital:
   (Internet procurement site designed for McDonald's
  Corporation's 27,000 franchises )

• Emac Digital Company is E-Procurement website which
  is jointly owned by McDonalds and Accel-KKR Internet
  Co.
• It is a procurement hub launched in 2001 allow all of
  McDonald's franchises across the globe to buy
  everything needed to run their restaurants.
             From uniform to HamBurger
• Aside from being faster and more convenient for
  franchisees, the procurement site also allow business
  owners to buy supplies and materials at a discounted
  price, ultimately reducing costs for McDonald's.

• E-Procurement allows 85% cut in costs according to
  McDonald’s supply chief Edwards.

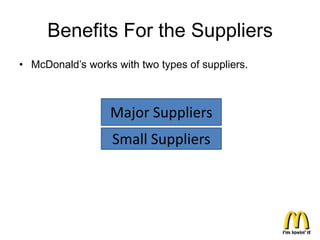

Benefits For the Suppliers
• McDonald’s works with two types of suppliers.

                  Major Suppliers
                   Small Suppliers

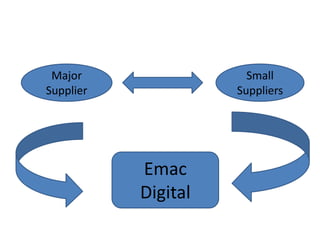

Major                 Small
Supplier             Suppliers

           Emac
           Digital

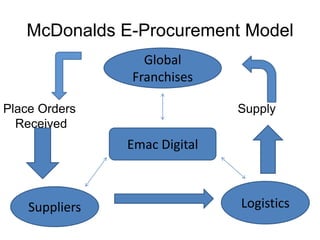

McDonalds E-Procurement Model
                  Global
                Franchises

Place Orders                   Supply
  Received
                Emac Digital

    Suppliers                  Logistics

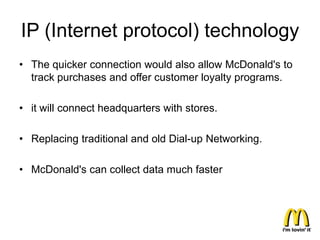

IP (Internet protocol) technology
• The quicker connection would also allow McDonald's to
  track purchases and offer customer loyalty programs.

• it will connect headquarters with stores.

• Replacing traditional and old Dial-up Networking.

• McDonald's can collect data much faster

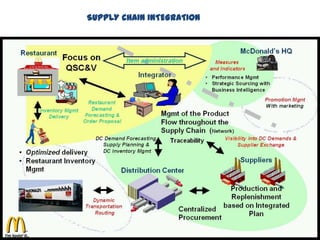

SUPPLY CHAIN INTEGRATION
Geographically Diverse suppliers: Ensuring stringent quality standards
SUPPLIERS

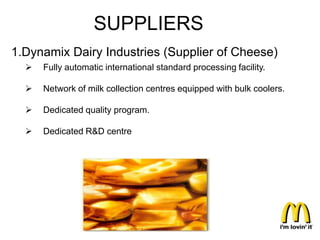

1.Dynamix Dairy Industries (Supplier of Cheese)
     Fully automatic international standard processing facility.

     Network of milk collection centres equipped with bulk coolers.

     Dedicated quality program.

     Dedicated R&D centre

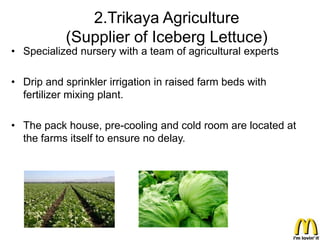

2.Trikaya Agriculture
           (Supplier of Iceberg Lettuce)
• Specialized nursery with a team of agricultural experts

• Drip and sprinkler irrigation in raised farm beds with
  fertilizer mixing plant.

• The pack house, pre-cooling and cold room are located at
  the farms itself to ensure no delay.

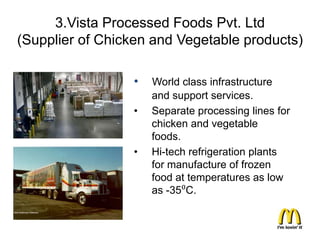

3.Vista Processed Foods Pvt. Ltd
(Supplier of Chicken and Vegetable products)

                 •   World class infrastructure
                     and support services.
                 •   Separate processing lines for
                     chicken and vegetable
                     foods.
                 •   Hi-tech refrigeration plants
                     for manufacture of frozen
                     food at temperatures as low
                     as -35⁰C.
4. Amrit Food

• Supplier of long life UHT Milk and Milk Products for
  Frozen Desserts

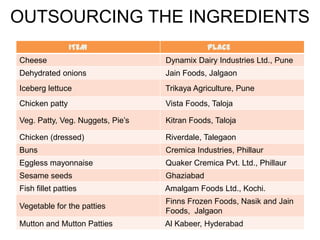

OUTSOURCING THE INGREDIENTS
                ITEM                          PLACE
Cheese                            Dynamix Dairy Industries Ltd., Pune
Dehydrated onions                 Jain Foods, Jalgaon
Iceberg lettuce                   Trikaya Agriculture, Pune
Chicken patty                     Vista Foods, Taloja

Veg. Patty, Veg. Nuggets, Pie’s   Kitran Foods, Taloja

Chicken (dressed)                 Riverdale, Talegaon
Buns                              Cremica Industries, Phillaur
Eggless mayonnaise                Quaker Cremica Pvt. Ltd., Phillaur
Sesame seeds                      Ghaziabad
Fish fillet patties               Amalgam Foods Ltd., Kochi.
                                  Finns Frozen Foods, Nasik and Jain
Vegetable for the patties
                                  Foods, Jalgaon
Mutton and Mutton Patties         Al Kabeer, Hyderabad

Logistics

• AFL Logistics – 50:50 JV between AirFreight and FX
  Coughlin of USA- McDonalds international logistics
  partner
   – 100 sales items in the restaurant
   – 400 SKUs in the warehouse
   – 200 restaurants per DC (~180 DCs globally)
   – Delivery frequency: ~3/wk, higher in urban areas
   – 2-3 stops per route
   – Exclusive distributors (3PL)
   – Strong quality focus (Cold Chain, HACCP, QIP)
Transportation
• The DC receives items from different parts of the
  country.

• The items are stored in rooms with different temperature
  zones and are finally dispatched to the McDonald's
  restaurants on the basis of their requirements.
Transportation
• The company has both cold and dry storage facilities
  with capability to store products up to -22º C as well as
  delivery trucks to transport products at temperatures
  ranging from room temperature to frozen state.

• The specially designed trucks maintained the
  temperature in the storage chamber throughout the
  journey.

Distribution
• Matching supplier production with deliveries to meet
  schedules and restaurant needs

• 3 centralized distribution centers at Mumbai, Delhi and
  Kochi

• Emphasis on economies of scale
   – High storage volumes

• QIP (Quality Inspection Program)
Distribution

• HACCP (Hazard Analysis Critical Control Point)
       – Food safety standards emphasizing prevention
  of faults rather than detection through inspection

• No Knife in restaurants

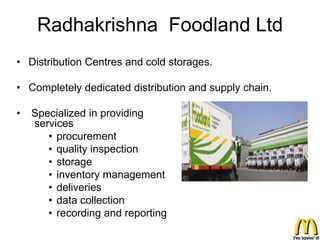

Radhakrishna Foodland Ltd
• Distribution Centres and cold storages.

• Completely dedicated distribution and supply chain.

•   Specialized in providing
    services
       • procurement
       • quality inspection
       • storage
       • inventory management
       • deliveries
       • data collection
       • recording and reporting

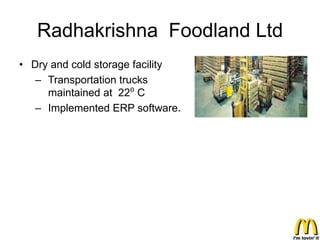

Radhakrishna Foodland Ltd
• Dry and cold storage facility
   – Transportation trucks
     maintained at 22⁰ C
   – Implemented ERP software.
McDonalds Distribution systems
McDonald uses three types of Distribution strategy
  – Franchising
  – Licensing
  – Joint ventures

Franchising

McDonald require franchising from countries on conditions like this
• The entrepreneur should be trained.
• 45000$ in franchise fees which is higher than other fast-food
  companies
• Total investment would range from 1 million to 1.8 million
• After setting the entrepreneur will have to pay 12.5 % as royalty tax
• Contract wll be for 20 years
• Cash liquidity should be around 250000

McDonalds Distribution systems
• Samsung Corby Crave Hit McDonald’s:
   – The joint promotion aims to generate excitement among
     the youth and providing them a feel of the touch phones
     and boosting their comprehension.

• McDonalds have license on Airports, Railways etc.
McDonalds Distribution systems

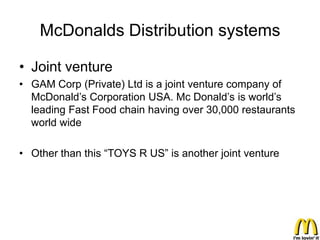

• Joint venture
• GAM Corp (Private) Ltd is a joint venture company of
  McDonald’s Corporation USA. Mc Donald’s is world’s
  leading Fast Food chain having over 30,000 restaurants
  world wide

• Other than this “TOYS R US” is another joint venture

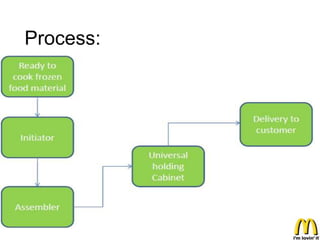

Process:
Supply chain management of McDonalds
