The document summarizes key details of a construction contract between Larsen & Toubro and a client for building construction work. It outlines the project scope and location, contract value and duration. It also describes provisions around mobilization advance, payment terms, security deposits, secured advances and site facilities to be provided. The contract is on an item rate basis with provisions for variation in scope and time extension if work exceeds 30% of contract value.
In the present day corporate environment, where there is cut-throat competition, the need for efficient time management and timely completion of projects is essential for organizations to stay competitive. Even due to the growing need for time management in construction projects, many are failing to be finished on time. This can be detrimental for any hiring company since infrastructure development project delays can lead to increase in costs and process halt for organizations. These are real life scenarios which are bound to take place in the professional life of any and every project manager. A project manager will only be considered efficient and competent when he or she knows how to manage the allotted time, and to carry out operations and activities in a manner that further reduces this time period. In order to prepare project managers for such circumstances, it is crucial for them to understand Extension of Time and delay analysis.
Course link: https://planningengineer.net/courses/claims-management-and-delays-analysis-online-workshop/
Non Destructive and Partially Destructive Testing Of Concrete StructuresGautam Chaurasia
The major non destructive and partially destructive methods of concrete testing have been discussed here. I hope it will be beneficial to everyone interested in this broad topic.
In the present day corporate environment, where there is cut-throat competition, the need for efficient time management and timely completion of projects is essential for organizations to stay competitive. Even due to the growing need for time management in construction projects, many are failing to be finished on time. This can be detrimental for any hiring company since infrastructure development project delays can lead to increase in costs and process halt for organizations. These are real life scenarios which are bound to take place in the professional life of any and every project manager. A project manager will only be considered efficient and competent when he or she knows how to manage the allotted time, and to carry out operations and activities in a manner that further reduces this time period. In order to prepare project managers for such circumstances, it is crucial for them to understand Extension of Time and delay analysis.
Course link: https://planningengineer.net/courses/claims-management-and-delays-analysis-online-workshop/
Non Destructive and Partially Destructive Testing Of Concrete StructuresGautam Chaurasia
The major non destructive and partially destructive methods of concrete testing have been discussed here. I hope it will be beneficial to everyone interested in this broad topic.
Report is about the Internship of a Civil Engineer.
This Report is for the students of civil engineering. In this report u can find the format of the Report, Mechanism of the internship report. It is very useful to understand some civil engineering terms.
CIVIL ENGINEERING INTERNSHIP REPORT, DETAILED INTERNSHIP REPORT ON A CIVIL ENGINEERING SITE , USEFUL REPORT FOR FRESHER CIVIL ENGINEERS WITH EXTRA ORDINARY DETAILS WITH IMAGES AND CHECK LIST, FOR CIVIL ENGINEERING STUDENTS FOR HOW TO MAKE INTERNSHIP REPORT
Internship Report Construction Site and Office WorkAkshathaBhandary
Absolutely good the reason behind this performance was I integrate with all workers within a short time and get involved in different site works to gain more knowledge about the working environment in the site and improve myself with more site works
and office work. Since the site work is very repetitive I have been working in different section to get involved and pass through different peace of works. Especially the work tasks I have been performing in the office work were very impressive because I didn‘t have any knowledge about the quantity works, cost and report writing etc. In general in the last four month I perform all my duties nicely and get knowledge of the practical world and relate it with the theory I have learnt in the class in the last three years. Also I transform myself to another level of skill, ethics, knowledge and leadership using this internship class and I perform it well.
Sea Port Construction, Project Execution PlanDavid H Moloney
Details of how a Sea Port is constructed, and how the progress, safety and quality will be monitored and controlled. Also the measures to ensure that the site is environmentally friendly.
Report is about the Internship of a Civil Engineer.
This Report is for the students of civil engineering. In this report u can find the format of the Report, Mechanism of the internship report. It is very useful to understand some civil engineering terms.
CIVIL ENGINEERING INTERNSHIP REPORT, DETAILED INTERNSHIP REPORT ON A CIVIL ENGINEERING SITE , USEFUL REPORT FOR FRESHER CIVIL ENGINEERS WITH EXTRA ORDINARY DETAILS WITH IMAGES AND CHECK LIST, FOR CIVIL ENGINEERING STUDENTS FOR HOW TO MAKE INTERNSHIP REPORT
Internship Report Construction Site and Office WorkAkshathaBhandary
Absolutely good the reason behind this performance was I integrate with all workers within a short time and get involved in different site works to gain more knowledge about the working environment in the site and improve myself with more site works
and office work. Since the site work is very repetitive I have been working in different section to get involved and pass through different peace of works. Especially the work tasks I have been performing in the office work were very impressive because I didn‘t have any knowledge about the quantity works, cost and report writing etc. In general in the last four month I perform all my duties nicely and get knowledge of the practical world and relate it with the theory I have learnt in the class in the last three years. Also I transform myself to another level of skill, ethics, knowledge and leadership using this internship class and I perform it well.
Sea Port Construction, Project Execution PlanDavid H Moloney
Details of how a Sea Port is constructed, and how the progress, safety and quality will be monitored and controlled. Also the measures to ensure that the site is environmentally friendly.
Looking for property in India ? LandLinker.in is One STOP " DESTINATION " for best property site in India. Buy, Sell residential and commercial properties in India. Online Property Sites in India, India on online property site, commercial properties in India. http://www.landlinker.in/project/MASCOT%20MANORATH/104.html
This ppt is a comprehensive presentation on various aspects for the entities working in the construction domain. Starting from Tendering to Budgeting and going on to indirect tax aspects like VAT and service Tax.
Mascot Manorath symbolizes the fulfillment of the primary dream of every family of acquiring a place they can call their own. Located at Sector 16 Noida Extension (Greater Noida – West), Manorath offers 2 & 3 bedroom luxury apartments that are well planned to ensure maximum utilization of space. Manorath has been created as an energy efficient “GREEN DEVELOPMENT” project, with assistance from highly qualified architects and engineers from premier institutions like SPA and IIT.
Mascot Manorath symbolizes the fulfillment of the primary dream of every family of acquiring a place they can call their own. Located at Sector 16 Noida Extension (Greater Noida – West), Manorath offers 2 & 3 bedroom luxury apartments that are well planned to ensure maximum utilization of space. Manorath has been created as an energy efficient “GREEN DEVELOPMENT” project, with assistance from highly qualified architects and engineers from premier institutions like SPA and IIT.
Mascot Manorath symbolizes the fulfillment of the primary dream of every family of acquiring a place they can call their own. Located at Sector 16 Noida Extension (Greater Noida – West), Manorath offers 2 & 3 bedroom luxury apartments that are well planned to ensure maximum utilization of space. Manorath has been created as an energy efficient “GREEN DEVELOPMENT” project, with assistance from highly qualified architects and engineers from premier institutions like SPA and IIT.
VAT Registration Outlined In UAE: Benefits and Requirementsuae taxgpt
Vat Registration is a legal obligation for businesses meeting the threshold requirement, helping companies avoid fines and ramifications. Contact now!
https://viralsocialtrends.com/vat-registration-outlined-in-uae/
Improving profitability for small businessBen Wann
In this comprehensive presentation, we will explore strategies and practical tips for enhancing profitability in small businesses. Tailored to meet the unique challenges faced by small enterprises, this session covers various aspects that directly impact the bottom line. Attendees will learn how to optimize operational efficiency, manage expenses, and increase revenue through innovative marketing and customer engagement techniques.
RMD24 | Debunking the non-endemic revenue myth Marvin Vacquier Droop | First ...BBPMedia1
Marvin neemt je in deze presentatie mee in de voordelen van non-endemic advertising op retail media netwerken. Hij brengt ook de uitdagingen in beeld die de markt op dit moment heeft op het gebied van retail media voor niet-leveranciers.
Retail media wordt gezien als het nieuwe advertising-medium en ook mediabureaus richten massaal retail media-afdelingen op. Merken die niet in de betreffende winkel liggen staan ook nog niet in de rij om op de retail media netwerken te adverteren. Marvin belicht de uitdagingen die er zijn om echt aansluiting te vinden op die markt van non-endemic advertising.
Attending a job Interview for B1 and B2 Englsih learnersErika906060
It is a sample of an interview for a business english class for pre-intermediate and intermediate english students with emphasis on the speking ability.
Personal Brand Statement:
As an Army veteran dedicated to lifelong learning, I bring a disciplined, strategic mindset to my pursuits. I am constantly expanding my knowledge to innovate and lead effectively. My journey is driven by a commitment to excellence, and to make a meaningful impact in the world.
[Note: This is a partial preview. To download this presentation, visit:
https://www.oeconsulting.com.sg/training-presentations]
Sustainability has become an increasingly critical topic as the world recognizes the need to protect our planet and its resources for future generations. Sustainability means meeting our current needs without compromising the ability of future generations to meet theirs. It involves long-term planning and consideration of the consequences of our actions. The goal is to create strategies that ensure the long-term viability of People, Planet, and Profit.
Leading companies such as Nike, Toyota, and Siemens are prioritizing sustainable innovation in their business models, setting an example for others to follow. In this Sustainability training presentation, you will learn key concepts, principles, and practices of sustainability applicable across industries. This training aims to create awareness and educate employees, senior executives, consultants, and other key stakeholders, including investors, policymakers, and supply chain partners, on the importance and implementation of sustainability.
LEARNING OBJECTIVES
1. Develop a comprehensive understanding of the fundamental principles and concepts that form the foundation of sustainability within corporate environments.
2. Explore the sustainability implementation model, focusing on effective measures and reporting strategies to track and communicate sustainability efforts.
3. Identify and define best practices and critical success factors essential for achieving sustainability goals within organizations.
CONTENTS
1. Introduction and Key Concepts of Sustainability
2. Principles and Practices of Sustainability
3. Measures and Reporting in Sustainability
4. Sustainability Implementation & Best Practices
To download the complete presentation, visit: https://www.oeconsulting.com.sg/training-presentations
Tata Group Dials Taiwan for Its Chipmaking Ambition in Gujarat’s DholeraAvirahi City Dholera
The Tata Group, a titan of Indian industry, is making waves with its advanced talks with Taiwanese chipmakers Powerchip Semiconductor Manufacturing Corporation (PSMC) and UMC Group. The goal? Establishing a cutting-edge semiconductor fabrication unit (fab) in Dholera, Gujarat. This isn’t just any project; it’s a potential game changer for India’s chipmaking aspirations and a boon for investors seeking promising residential projects in dholera sir.
Visit : https://www.avirahi.com/blog/tata-group-dials-taiwan-for-its-chipmaking-ambition-in-gujarats-dholera/
Memorandum Of Association Constitution of Company.pptseri bangash
www.seribangash.com
A Memorandum of Association (MOA) is a legal document that outlines the fundamental principles and objectives upon which a company operates. It serves as the company's charter or constitution and defines the scope of its activities. Here's a detailed note on the MOA:
Contents of Memorandum of Association:
Name Clause: This clause states the name of the company, which should end with words like "Limited" or "Ltd." for a public limited company and "Private Limited" or "Pvt. Ltd." for a private limited company.
https://seribangash.com/article-of-association-is-legal-doc-of-company/
Registered Office Clause: It specifies the location where the company's registered office is situated. This office is where all official communications and notices are sent.
Objective Clause: This clause delineates the main objectives for which the company is formed. It's important to define these objectives clearly, as the company cannot undertake activities beyond those mentioned in this clause.
www.seribangash.com
Liability Clause: It outlines the extent of liability of the company's members. In the case of companies limited by shares, the liability of members is limited to the amount unpaid on their shares. For companies limited by guarantee, members' liability is limited to the amount they undertake to contribute if the company is wound up.
https://seribangash.com/promotors-is-person-conceived-formation-company/
Capital Clause: This clause specifies the authorized capital of the company, i.e., the maximum amount of share capital the company is authorized to issue. It also mentions the division of this capital into shares and their respective nominal value.
Association Clause: It simply states that the subscribers wish to form a company and agree to become members of it, in accordance with the terms of the MOA.
Importance of Memorandum of Association:
Legal Requirement: The MOA is a legal requirement for the formation of a company. It must be filed with the Registrar of Companies during the incorporation process.
Constitutional Document: It serves as the company's constitutional document, defining its scope, powers, and limitations.
Protection of Members: It protects the interests of the company's members by clearly defining the objectives and limiting their liability.
External Communication: It provides clarity to external parties, such as investors, creditors, and regulatory authorities, regarding the company's objectives and powers.
https://seribangash.com/difference-public-and-private-company-law/
Binding Authority: The company and its members are bound by the provisions of the MOA. Any action taken beyond its scope may be considered ultra vires (beyond the powers) of the company and therefore void.
Amendment of MOA:
While the MOA lays down the company's fundamental principles, it is not entirely immutable. It can be amended, but only under specific circumstances and in compliance with legal procedures. Amendments typically require shareholder
Digital Transformation and IT Strategy Toolkit and TemplatesAurelien Domont, MBA
This Digital Transformation and IT Strategy Toolkit was created by ex-McKinsey, Deloitte and BCG Management Consultants, after more than 5,000 hours of work. It is considered the world's best & most comprehensive Digital Transformation and IT Strategy Toolkit. It includes all the Frameworks, Best Practices & Templates required to successfully undertake the Digital Transformation of your organization and define a robust IT Strategy.
Editable Toolkit to help you reuse our content: 700 Powerpoint slides | 35 Excel sheets | 84 minutes of Video training
This PowerPoint presentation is only a small preview of our Toolkits. For more details, visit www.domontconsulting.com
Buy Verified PayPal Account | Buy Google 5 Star Reviewsusawebmarket
Buy Verified PayPal Account
Looking to buy verified PayPal accounts? Discover 7 expert tips for safely purchasing a verified PayPal account in 2024. Ensure security and reliability for your transactions.
PayPal Services Features-
🟢 Email Access
🟢 Bank Added
🟢 Card Verified
🟢 Full SSN Provided
🟢 Phone Number Access
🟢 Driving License Copy
🟢 Fasted Delivery
Client Satisfaction is Our First priority. Our services is very appropriate to buy. We assume that the first-rate way to purchase our offerings is to order on the website. If you have any worry in our cooperation usually You can order us on Skype or Telegram.
24/7 Hours Reply/Please Contact
usawebmarketEmail: support@usawebmarket.com
Skype: usawebmarket
Telegram: @usawebmarket
WhatsApp: +1(218) 203-5951
USA WEB MARKET is the Best Verified PayPal, Payoneer, Cash App, Skrill, Neteller, Stripe Account and SEO, SMM Service provider.100%Satisfection granted.100% replacement Granted.
What are the main advantages of using HR recruiter services.pdfHumanResourceDimensi1
HR recruiter services offer top talents to companies according to their specific needs. They handle all recruitment tasks from job posting to onboarding and help companies concentrate on their business growth. With their expertise and years of experience, they streamline the hiring process and save time and resources for the company.
What are the main advantages of using HR recruiter services.pdf
Summer training @ L&T
1. SUMMER INTERNSHIP 2011 @
LARSEN AND TOUBRO
(ECC DIVISION)
18 APRIL 2011 – 11 JUNE 2011
Ms.Amruta Badodkar
( 241014)
2. : L & T AT A GLANCE :
Founded in 1938 by two Danish
engineers, Henning Holck-Larsen
and Soren Kristian Toubro
One of the largest engineering and
construction company in India.
L&T ranks 40 in the top 225
global contractors 2008 data,
improved from 47th (2007) &
54th (2006).
3. L & T BUSINESSES :
Projects Products Services
Construction Electrical & IT &
Electronics Technology
E&C Projects Services
Machinery &
Heavy Engg. Industrial Financial
Products Services
7. Project Highlights
Plot Area: 1.06 Lakh Sft
Substructure BUA- 6.16 Lakh Sft
Super Structure BUA : 15.31 Lakh Sft
Total BUA - 21.47 Lakh Sft
The Building consists of
Six Levels Basement
Ground Floor
4 Nos of parking Floors
16 Office Floors

8. Project Synopsis
Name of the project Construction of Commercial Building at Plot C-66, BKC
Mumbai.
Client Raghuleela Builders Pvt. Ltd.
James Law Cybertecture International Holding Ltd. – Hong
Base Build Architect
Kong
Architectural Consultant RSP Design Consultants (India) pvt. Ltd. - India
Structural Consultants J+W Consultants
Municipal Architect Space age consultants
Q.S./Cost Estimator Padghams Swett
LEEDS Certification Surmount Energy Solutions Pvt Ltd.
Type of Contract Item rate contract
Contract Value 321.3 Crore
Contract Duration 21 Months. (18 + 3)
Contractual Start (LOI)Date 9th Nov 2010
Contractual Completion
8th Aug 2012
Date
DLP/Maintenance Period 1 Year
9. Project Synopsis
C B
A
21-02-
Status Date
2011
Target
As on date Balance as
Excavation Cum Total Scope Completion
completion on date
Date
Part-A Cum 64588 60202 93% 4386 02-03-2011
Part-B Cum 64217 48571 76% 15646 10-03-2011
Part-C Cum 56085 51831 92% 4254 02-03-2011
Total 184890 160604 90% 24286 10-03-2011

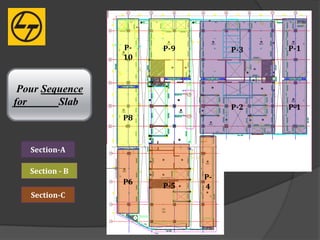

10. P- P-9 P-3 P-1
10
Pour Sequence
for Slab P-2 P-1
P8
Section-A
Section - B
P-
P6 P-5 4
Section-C

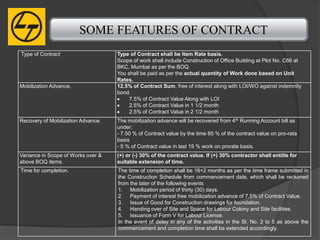

13. SOME FEATURES OF CONTRACT
Type of Contract Type of Contract shall be Item Rate basis.
Scope of work shall include Construction of Office Building at Plot No. C66 at
BKC, Mumbai as per the BOQ.
You shall be paid as per the actual quantity of Work done based on Unit
Rates.
Mobilization Advance. 12.5% of Contract Sum, free of interest along with LOI/WO against indemnity
bond.
7.5% of Contract Value Along with LOI
2.5% of Contract Value in 1 1/2 month
2.5% of Contract Value in 2 1/2 month
Recovery of Mobilization Advance. The mobilization advance will be recovered from 4 th Running Account bill as
under:
- 7.50 % of Contract value by the time 85 % of the contract value on pro-rata
basis
- 5 % of Contract value in last 15 % work on prorate basis.
Variance in Scope of Works over & (+) or (-) 30% of the contract value. If (+) 30% contractor shall entitle for
above BOQ items. suitable extension of time.
Time for completion. The time of completion shall be 16+2 months as per the time frame submitted in
the Construction Schedule from commencement date, which shall be reckoned
from the later of the following events
1. Mobilization period of thirty (30) days.
2. Payment of interest free mobilization advance of 7.5% of Contract Value.
3. Issue of Good for Construction drawings for foundation.
4. Handing over of Site and Space for Labour Colony and Site facilities.
5. Issuance of Form V for Labour License.
In the event of delay in any of the activities in the Sl. No. 2 to 5 as above the
commencement and completion time shall be extended accordingly.
14. SOME FEATURES OF CONTRACT
Advance for purchase of Formwork Contractor will be paid an interest free formwork advance (limited to 70%) of the
Material cost of the materials against Indemnity bond which shall be recovered on pro-rata
basis only after 30% of contract value.
Security Deposit & Retention Money. Contractor shall submit an Indemnity Bond signed by one of our whole time
Directors of 5% (five per cent) of the Contract Value valid till the virtual completion
of the work towards security deposit & retention money. On virtual completion this
Indemnity Bond shall be returned to us and we shall submit a fresh Indemnity Bond
equivalent to 2.5% of the value of work done valid till the end of the defects liability
period of 12 months is over. In view of the above arrangement there shall not be
any cash retention from R.A. Bills.
Terms of payment. 75 % of monthly bill irrespective of value shall be paid within 15 days of
submission and balance 25 % within 30 days from submission date including
certification
Final bill shall be scrutinized and settled in full within three (3) months of its
presentation including certification by our Engineer along with any balance
payments for extra work done during the tenure of the contract.
Secured Advance 70% of the value of Cement & Steel procured at site for the works likely to be taken
up during the next two (2) months against the paid bill/invoice and recovered fully
from the next R.A. Bill on actual supply.
Site Facilities. a) The contractor shall be provided sufficient space for setting up of the Client
Office, our Office, Re-bar yard, Carpentry Yard, stockyard and labour camp
free of cost. All operational expenses incurred for the Client Office shall be
Client’s responsibility.
b) Electricity & Water
Client shall provide electricity connection at one point at Site, Labour colony
locations for which Installation & statutory deposits shall be borne by client.
Further distribution shall be done by the contractor, Consumption charges
shall be borne by the contractor. We shall be allowed to use bore-well water
installed at site free of cost for construction purpose. For Drinking water the
condition shall be same as for Electricity.
15. SOME FEATURES OF CONTRACT
Extra Items. For such of those items for which there are no applicable rates in the schedule of
quantities or for which rates cannot be derived from the available items the
following shall be the basis for computing the rates.
Item requiring supply of materials, labour, plant, tools and tackles - Landed
cost of materials at site, Hire charges and operational charges for plant and
labour wages based on manday rates+ overheads + profit 15% plus VAT+
Service Tax.
Taxes & Duties. VAT already included in the rates plus Services Tax as applicable, at present ST is
4.12%.
Subsequent increase if any of the ST & VAT shall be reimbursed.
Assignment & Sub-Letting L&T is free to Sub-Let the works for the overall control on works including quality,
workmanship & progress & all the liabilities exclusively lies on L&T
Statutory Charges, Levy, Taxes, Fess, All statutory water / sewerage charges / Deposits etc. or any other charges as may
Deposit, Permissions, etc. be applicable for construction works shall be paid by Owner directly to the
authorities.
Liquidated Damages. Liquidated damages shall be @ 0.25% of the value of the work per week subject to
a maximum of 2.5% of the contract value for delay in completion of the work due to
reasons solely attributable to the contractor after taking into consideration the
extension of time schedule to which you may be entitled due to valid reasons. No
penalty shall be levied on the contractor for the delay in interim progress.
Insurance. The contractor shall provide the following insurance covers under Block Policy
Scheme to cover our men, machinery, equipment and materials.
Workmen Compensation Insurance for our workmen and subcontractor’s
workmen.
Group Personnel Accident Insurance to our staff.
Automobile Liability Insurance.
Third Party Liability Insurance.
Contractor’s All Risk Insurance Policy.
Any other insurance including any policy to be taken in client’s name shall be taken
by you.
16. SOME FEATURES OF CONTRACT

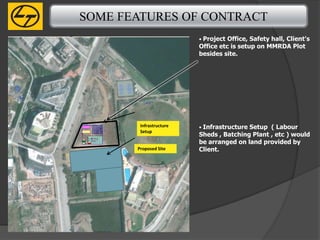

• Project Office, Safety hall, Client's
Office etc is setup on MMRDA Plot
besides site.
Infrastructure • Infrastructure Setup ( Labour
Setup
Sheds , Batching Plant , etc ) would
be arranged on land provided by
Proposed Site Client.
17. PROJECT CHALLENGES
Tight Project Schedule.
Space Constraint
Higher Volume of Work
within Stipulated time.
Mobilization of Skilled
Manpower.
18. CONSTRUCTION METHODOLOGY – TYPICAL FORMWORK SYSTEM
Section Type of Formwork Detail
Columns L&T System formwork / L&T system formwork shall have plywood as
Conventional steel formwork sheathing members / Steel shutters
Core Walls / Lift Wall L&T System formwork upto B1 Wall panel shutters with Hydraulic system for
Level Slab – Climbing(SKE) lifting
formwork for Upper Floor
Beams / Slabs L&T System formwork / Flex Plywood as sheathing member
System- Quick Deck System
Other typical section Conventional formwork with timber -
/ steel
QUICK DECK
Shear Walls
19. ENVIRONMENT ,HEALTH & SAFETY.
Preparation of Site Safety
Plan ,EHS policy.
Formation of Safety
Committee.
Emergency Response plan.
SAFETY PARK SAFETY OFFICE

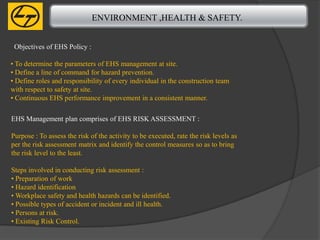

20. ENVIRONMENT ,HEALTH & SAFETY.
Objectives of EHS Policy :
• To determine the parameters of EHS management at site.
• Define a line of command for hazard prevention.
• Define roles and responsibility of every individual in the construction team
with respect to safety at site.
• Continuous EHS performance improvement in a consistent manner.
EHS Management plan comprises of EHS RISK ASSESSMENT :
Purpose : To assess the risk of the activity to be executed, rate the risk levels as
per the risk assessment matrix and identify the control measures so as to bring
the risk level to the least.
Steps involved in conducting risk assessment :
• Preparation of work
• Hazard identification
• Workplace safety and health hazards can be identified.
• Possible types of accident or incident and ill health.
• Persons at risk.
• Existing Risk Control.

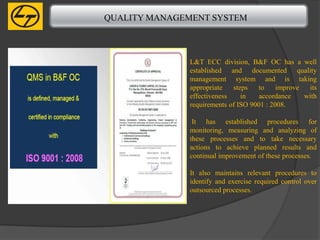

21. QUALITY MANAGEMENT SYSTEM
L&T ECC division, B&F OC has a well
established and documented quality
management system and is taking
appropriate steps to improve its
effectiveness in accordance with
requirements of ISO 9001 : 2008.
It has established procedures for
monitoring, measuring and analyzing of
these processes and to take necessary
actions to achieve planned results and
continual improvement of these processes.
It also maintains relevant procedures to
identify and exercise required control over
outsourced processes.
22. TYPICAL SLAB CYCLE
Day-6-11
Day-11-12
Concreting
of slab
Shuttering, Fixing of
12 days work cycle Reinforcement Steel
/ PT Tendons
Column , Core
Wall
Day-1-6
