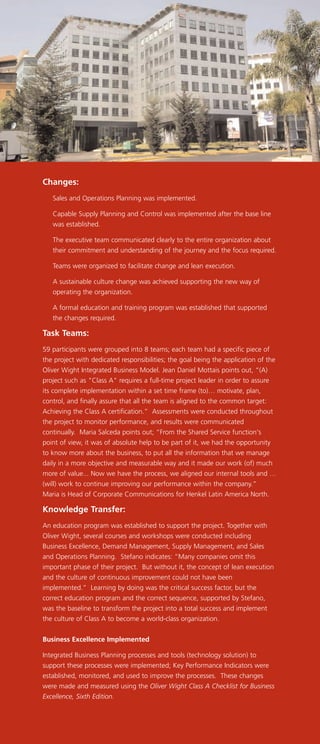

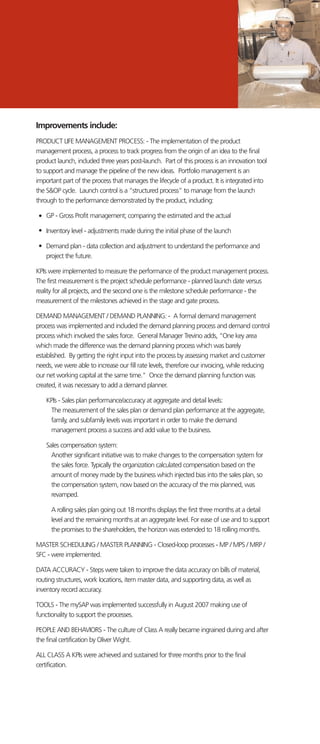

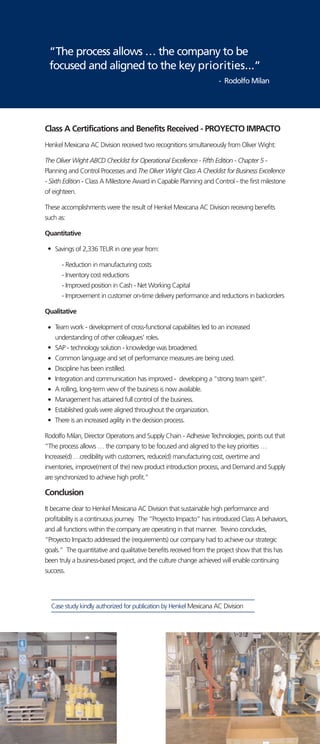

Henkel Mexicana AC Division launched "Proyecto Impacto" to implement a structured methodology for sustainable high performance and profitability. This involved adopting integrated business planning processes, tools, and key performance indicators to improve operations. As a result, customer on-time shipment performance exceeded 98%, inventory record accuracy exceeded 95%, and production efficiency increased by at least 2 percentage points, equating to millions in savings. Through establishing sales and operations planning, demand management processes, master scheduling, and other changes, Henkel Mexicana achieved over 2,300,000 Euros in quantitative savings per year and qualitative benefits like improved teamwork, communication, and business control. They received Oliver Wight certifications for achieving Class A levels
