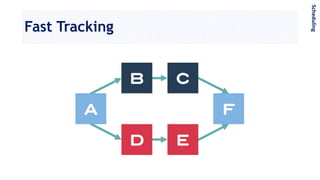

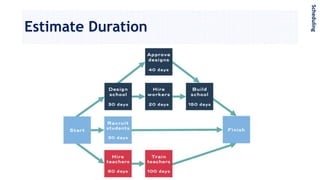

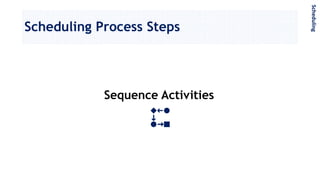

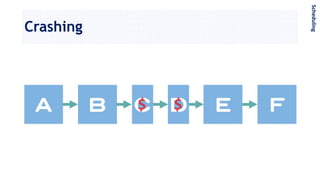

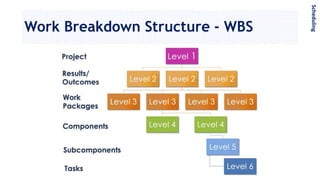

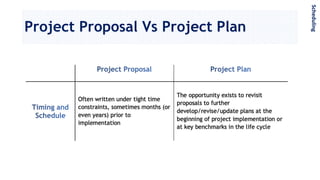

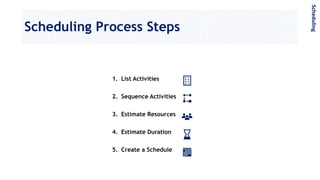

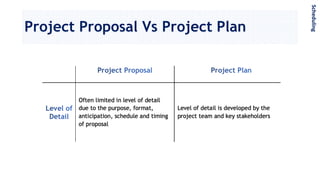

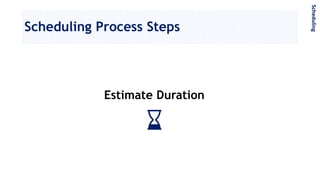

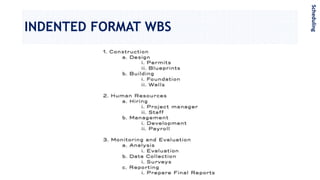

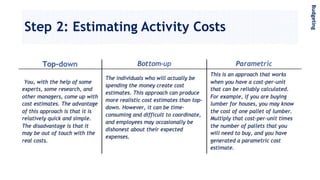

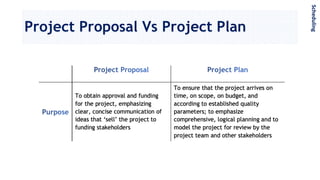

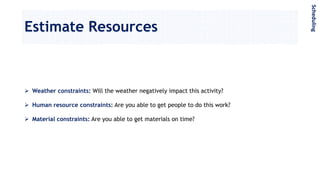

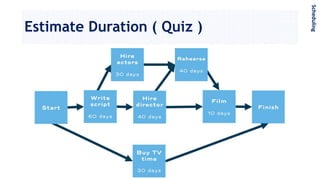

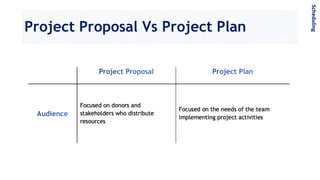

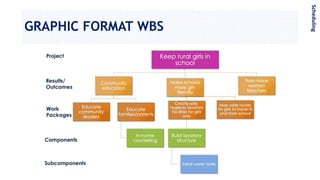

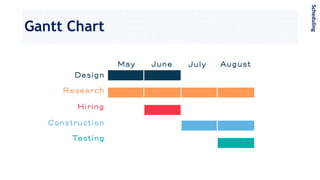

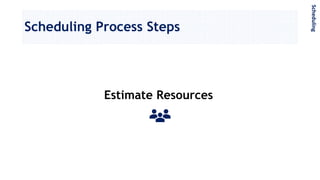

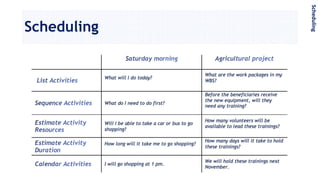

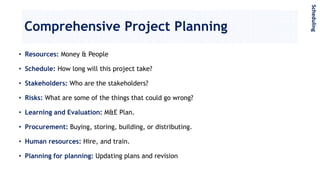

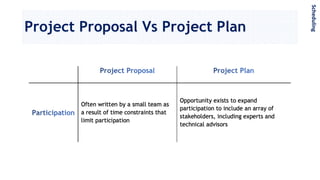

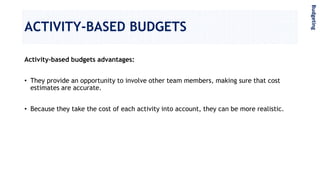

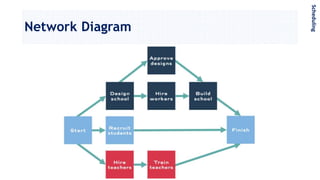

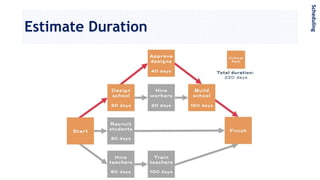

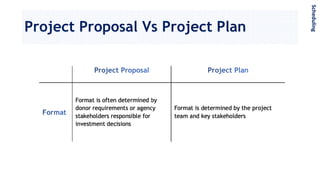

This document discusses project scheduling and budgeting. It begins by distinguishing between a project proposal and plan, noting the importance of comprehensive planning that considers resources, schedule, stakeholders, risks, evaluation, procurement, human resources, and planning revisions. It then covers the scheduling process of listing activities, sequencing them, estimating resources and duration, and creating a schedule using tools like a work breakdown structure, network diagram, Gantt chart, and adjusting the schedule through crashing or fast tracking. Finally, it discusses activity-based budgeting by listing project activities, estimating their individual costs, and implementing the budget.
