P8-Determination of Contractor’s
Employment by Employer
Ngah Yea Zhe 0323204
Than Lek Mei 0315538
Kiing Kiu Chun 0318727
Contractor himself is relieved from his contractual obligation to procced
with the work under contract due to termination of his employment due to
his own default. The determination will keep the contract alive in a
modified form.
 E.G., the dispute resolution clause will survive the determination whereas
the liquidated damages will not survive the determination, liquidated
damages charged to contractor will be up to the date of determination.
Determination of Contractor’s employment by
Employer
 Contract does not come to an end, but it will remain in force in order to
bring it to a closure.
 This matter means that both party will have to wait until the project is
finish to get the final revised contract sum, afterwards employer will
claim the excess amount from the contractor.
Upon Termination of Contractor’s Employment
Under PAM Contract 2006 clause 25.1 (a)-(f), Employer may determine the
employment of the Contractor if the Contractor are found to be default in
any of the following:-
1. Clause 25.1 (a), Contractor fails to commence the work in accordance
with the contract without reasonable reasons.
2. Clause 25.1 (b), Contractor wholly or substantially suspends the
carrying out of work without reasonable reasons.
3. Clause 25.1 (c), when the Contractor fails to proceed regularly and/or
diligently with the works in terms of time and quality.
Default by Contractor
4. Clause 25.1 (d), Contractor persistently refuses or neglect to comply
with Architect Instruction (AI).
5. Clause 25.1 (e), which stated the Contractor’s failure to comply with
clause 17.0, which defines when the Contractor assigns his rights,
interest and benefits under the contract to other parties or wholly or
substantially subcontract the works without the written consent of
Employer.
6. Clause 25.1 (f), where Contractor abandons his work with no intention
to continue the work.
Default by Contractor
 Employment of Contractor can be determined under the stated
circumstances, e.g. PAM 2006 clause 25.1 (a)-(f).
 The reason for determination must be clearly stated.
 The base Employer uses to exercise the determination need to be stated
in the notice as well, e.g. PAM 2006, Common Law and etc.
Notice of Determination
According to PAM 2006 clause 25.2, upon any occurrence of default under
Clause 25.1, and if the Employer decides to terminate the employment of
Contractor, Employer or Architect on his behalf shall give Contractor a
written notice by hand or by registered post specifying the default.
If the Contractor continue its default for fourteen (14) Days after the
receipt of such notice, the Employer may, within ten (10) Days from the
expiry of fourteen (14) Days by a further written notice, determine the
employment of Contractor under the contract.
Strict Compliance with Procedure for
Determination
a. Issue Notice of Default to the Contractor. The notice shall be issued by
Employer or Architect stating the default.
b. Upon the receipt of such notice, Contractor can take the following action:-
I. Dispute the notice;
II. Admit the notice and make good;
III. Ignore the notice and continue with the default.
c. The Contractor is given 14 Days to rectify the default.
2-Steps Procedure for Determination : Step 1
a. If Contractor continue such default after expiry of fourteen (14) Days upon the
receipt of Notice of Default, the Employer can (only) issue the Notice of
Determination within ten (10) Days from the expiry of said fourteen Days.
b. Contractor must vacate the site and return site possession to Employer within
14 Days from Notice of Determination.
c. Architect/Quantity Surveyor shall give written notice to Contractor within 28
Days of determination of the date of inspection on site to jointly record extent
of work done and materials delivered.
2-Steps Procedure for Determination : Step 2
d. Architect/Quantity Surveyor to submit Final Account to Employer/Contractor
within 6 months from the completion of the remaining works.
e. Any disputes from Employer/Contractor must be raised within 3 Months from
receipt of Final Account, otherwise the Final Account will be considered as
conclusive and agreed by both parties.
f. Where either party have disagreement over the Final Account, they shall submit
their disagreement to the Architect/Quantity Surveyor. They will then within 3
Months, go deep into the disagreement to decide whether to amend and notify
the parties. Afterwards, either party is given 3 Months to refer the disagreement
to arbitration, or else the result will be seem as conclusive and agreed by both
parties
2-Steps Procedure for Determination : Step 2
Under PAM 2006 clause 25.3, the employment of the Contractor shall be
automatically determined if:-
1. The Contractor has become insolvent;
2. Making a composition or arrangement with his creditors;
3. Have a winding up order made;
4. A resolution for voluntary winding up;
5. Having a liquidator/receiver/manager of his business of undertaking duty
appointed by the court;
6. Having possession taken by or on behalf of the holders of any debentures
secured by a floating charge.
Automatic Determination
According to PAM 2006 clause 25.4, if the Contractor’s employment is
determined under clause 25.1 or 25.3, Employer/Contractor will have
following rights and duties:-
1. If Employer himself is in breach of contract, which he fails to pay
Contractor within the Period of Honouring Certificates, then he will
lose his rights to determine the Contractor’s employment under
‘prevention principle’.
2. Employer may determine the Contractor’s employment under the
contractual procedure of Contract. If Employer has default or failed
to comply with the procedure, then he will have to rely on common
law termination.
Rights and Duties of Employer/Contractor after
Determination
After Determination, Contractor shall:-
Under clause 25.4 (a):-
1. Vacate the site peacefully,
2. Return the site possession to the Employer within 14 Days from the receipt of
Notice of Determination.
3. Remove from site any temporary buildings, plant and materials belonging to
him or hired by him, when so instructed by the Architect.
4. If required by Employer, Contractor shall within twenty one (21) Days of the
date of determination, assign to the employer the benefit of any agreement
for the continuation of the hire of construction plant and equipment already
on site.
Duties of Contractor after Determination
Under clause 25.4 (b):-
1. If required by the Employer of Architect, Contractor shall within twenty one
(21) Days of the date of determination, assign to the employer without the
payment the benefit of any agreement for the supply of materials, goods
and/or for the execution of any work.
Under Clause 25.4 (c):-
1. When instructed by the Architect, Contractor shall remove from the works any
temporary buildings, construction plant, tools, equipment, materials and
goods belonging to or hired by him. If Contractor failed to comply with, the
Employer may without liability remove and sell those property belonged to
the Contractor, except for those that are on hire.
Duties of Contractor after Determination
Under clause 25.4 (d):-
1. The Contractor shall allow or pay to the Employer all cost incurred to
complete the work, which includes the lose and/or expense suffered by
the Employer. Until the completion of work, Employer shall no make
any further payment to the Contractor. Upon the completion of work,
an account which will include the value of work carried out by the
Contractor and all lose and/or expense incurred by the Employer will be
taken into Final Account as per clause 25.6.
Duties of Contractor after Determination

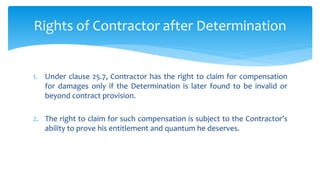

1. Under clause 25.7, Contractor has the right to claim for compensation
for damages only if the Determination is later found to be invalid or
beyond contract provision.
2. The right to claim for such compensation is subject to the Contractor’s
ability to prove his entitlement and quantum he deserves.
Rights of Contractor after Determination
Under clause 25.4(a) states that the Employer may:
 take back site possession from the contractor in a safe condition.
 employ and pay another contractor to carry out and complete the works and
to make good any defects.
 use all temporary buildings, construction plant, tools, materials and goods on
or adjacent to the site except hired construction plant.
 purchase all materials and goods necessary for the carrying out and
completion of the works.
Duties and Rights of Employer after
determination
 require the Contractor to assign without payment the benefit of any agreement
for the supply of materials, goods and for the execution of any work.
 instruct the Contractor to remove any temporary buildings, construction plant,
tools, equipment, materials and goods belonging to or hired by him; if not they
may be sold and the proceeds less all costs incurred held to the credit of the
contractor.
 the employer is entitled to be paid all cost incurred to complete the works by the
contractor including all loss and/or expense suffered by him.
 make no further payment to the contractor until after the completion of the
works when there is a final settling up.
Duties and Rights of Employer after
determination

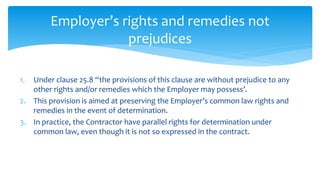

1. Under clause 25.8 “the provisions of this clause are without prejudice to any
other rights and/or remedies which the Employer may possess’.
2. This provision is aimed at preserving the Employer’s common law rights and
remedies in the event of determination.
3. In practice, the Contractor have parallel rights for determination under
common law, even though it is not so expressed in the contract.
Employer’s rights and remedies not
prejudices
4. In the event of any default by the Contractor, the Employer must exercise his
rights to determine either:
- Under the clause 25.2 of the contract for performance default; or -
- Under common law.
5. If the Employer chooses to determine the contract, then he is bound by the
contract provisions and he cannot resort to the common law rights of
determination as an alternative.
6. Common law rights can only be excluded by express term in the contract.
Employer’s rights and remedies not
prejudices
The Employer shall take immediate steps to arrange for the completion of the
remaining works:
1. Instructs the Contractor to carry out the following:
- Cease all operations on site.
- Demobilize and remove all his workers and staff.
- Leave all temporary building, plants and tools and unfixed
materials and good until they are not required.
2. Make a claim against the bank, i.e. to call on the Performance Bond.
Completion of remaining works
3. Arrange tender document, including a new BQ to be prepared and
tenders or quotations invited for the remaining works.
4. Employ a replacement contractor to complete the works and make
good any defects.
5. The Employer shall take up separate insurance coverage under fire and
Third Party policy for the completed works.
Completion of remaining works
1. The Architect shall nominate the same NSCs to the replaced contractor
provided they are agreeable to proceed with the same subcontract sum or
price, as if their employment by the first Contractor had not been terminated.
2. The new subcontract sums shall be the original subcontract sum less the
amount previously paid to the NSCs.
3. Where a NSC demands for an increase of the subcontract sum, fresh tenders or
quotations shall be invited to complete the works.
Completion of the remaining NSC’s works
1. Under clause 27.8, the Contractor can determine the NSC’s
employment only with the Architect’s written consent.
2. The rationale behind this condition is to avoid any wrongful
determination of the NSC, which would disrupt the progress of the
subcontract works and in turn delay the work works.
Determination of NSC’s Employment
1. The contractor shall give a written report stating the NSC’s default to
the Architect, with a copy extended to the NSC.
2. The architect may request the NSC to give an explanation in response
to the Contractor’s allegation of default.
3. This will also give the NSC the opportunity to rebut the Contractor’s
allegation with cogent evidence.
Procedure for the determination of NSC’s
Employment
1. When the NSC abandoned his work, the Contractor shall determine the
NSC’s employment with the Architect’s consent.
2. The Architect shall re-nominate a replacement NSC to complete the
remaining works within a reasonable time.
3. The Employer has to pay any additional amount to the Contractor if the
replacement MSC charges a higher price than what would have been
payable to the previous NSC.
How to complete remaining works ‘abandoned’
by NSC
4. The Employer is liable to bear time and cost implications unless such cost
are recoverable from the previous NSC.
5. Any such additional expenses recovered by the Contractor from the
previous NSC will have to go towards the cost of completing the remaining
subcontract works.
6. Such recoverable cost cannot be charged back to the Employer.
How to complete remaining works ‘abandoned’
by NSC
J01. JKR Form Clause 51.1 gives the rights to terminate the Contract by the
Government in the event of any of the following Contractor’s defaults:
i) fails to commence works at site within 2 weeks after Date for Possession
ii) suspends or abandons the works before Date of Completion
iii) fails to proceed regularly and diligently with the performance
iv) fails to execute the Works in accordance with the Contract
v) persistently neglects to carry out his obligations under the Contract
vi) fails to comply with clause 47
vii) fails to comply with any terms and conditions of this Contract
In comparison with JKR Form 203A (2007)
In comparison with JKR Form 203A (2007)
Officer named in the Appendix shall give written notice to Contractor specifying
the default and requiring the Contractor to remedy the default within 14 days of
receipt of the default.
J02. Clause 51.2 gives the rights to terminate the Contract by the Government In
the event that the Contractor becomes bankrupt or insolvent or an order for
winding up or a liquidator has been appointed or execution is levied against a
substantial portion of the Contractor’s assts.
J03. In the event of termination of Contract under clause 51.1 & 2, Contractor
[under clause 51.1 (c) (i)] shall:
 stop all operations of the Works
 carry out any protection works to secure the site against loss or damage
and leave the Site in a clean and tidy condition
 remove its staffs and workmen from the Site
 vacate the Site within the time stipulated by the S.O., remove all temporary
buildings and equipment and unfixed materials which are not paid.
In comparison with JKR Form 203A (2007)
 terminate all third party contracts entered into by the Contractor; or assign
to the Government if so required by the S.O.; or allow such third party to
enter into a contract with the Government to complete the Works.
 at no cost to the Government, hand over all plans, designs, relevant
documents.
 pay to the Government for any losses and damages as a result of
termination of Contract
 Not be released from any of its obligations under the Contract.
In comparison with JKR Form 203A (2007)
J04. In the event of termination of Contract under clause 51.1 & 2, the
Government, [under clause 51.1 (c) ( ii)], shall:
A) call upon the Performance Bond or forfeit the Performance Guarantee
Sum
B) enter and repossess the Site
C) be entitled to carry out and complete the Works on its own or
employed any other person to carry out and complete the Works
D) be entitled to claim against the Contractor for any losses, cost,
expenses and damages suffered as a result of termination of this
contract.
In comparison with JKR Form 203A (2007)
J05. Upon termination, Government is not liable for further payments on unpaid
certificates.
J06. Government can terminate the Contract based on national interest under
clause 52 by giving not less than 30 days written notice to Contractor. The
Government is not required to give any reason if the Government considers that
such termination is necessary for national interest, national policy or national
security.
J07. Clause 53 provides for the Government to terminate the Contract on
corruption, Clause 51.1(c)(i) and (ii) shall apply the if Contractor or its agents gives
of offers to give to any person any bribe, gift, gratuity or commission as inducement
or reward for doing or forbearing to do any actions
In comparison with JKR Form 203A (2007)
 Discuss the situations where Employer can determine the
Contractor’s Employment provided for in PAM 2006.
Question 1
Question 1 - Answer
Under PAM Contract 2006 clause 25.1 (a)-(f), Employer may determine the
employment of the Contractor if the Contractor are found to be default in
any of the following:-
1. Clause 25.1 (a), Contractor fails to commence the work in accordance
with the contract without reasonable reasons.
2. Clause 25.1 (b), Contractor wholly or substantially suspends the
carrying out of work without reasonable reasons.
3. Clause 25.1 (c), when the Contractor fails to proceed regularly and/or
diligently with the works in terms of time and quality.
4. Clause 25.1 (d), Contractor persistently refuses or neglect to comply
with Architect Instruction (AI).
5. Clause 25.1 (e), which stated the Contractor’s failure to comply with
clause 17.0, which defines when the Contractor assigns his rights,
interest and benefits under the contract to other parties or wholly or
substantially subcontract the works without the written consent of
Employer.
6. Clause 25.1 (f), where Contractor abandons his work with no intention
to continue the work.
 What must the Employer check before determining the
Contractor’s Employment? What can happen if the Employer
had failed to pay the sum due on Interim Certificate at the time
of determination?
Question 2
Employer had to make sure the Contractor had made default in any of the
following under clause 25.1:-
(a). Fails to commence the Works in accordance with the Contract without
reasonable cause;
(b). Wholly or substantially suspends the carrying out of the Works before
completion without reasonable cause;
(c). If he fails to proceed regularly and/or diligently with the Works;
(d). If he persistently refuses or neglects to comply with an AI;
(e). If he fails to comply with the provisions in Clause 17.0;
(f). If he has abandoned the Works.
Question 2-Answer (Part 1)
If Employer himself is in breach of contract, which he fails to pay
Contractor within the Period of Honoring Certificates stated in clause 26.1
(a), then he will lose his rights to determine the Contractor’s employment
under ‘prevention principle’.
Question 2-Answer (Part 2)
 Discuss the essential contents required in the Notice of Default
and Notice of Determination.
Question 3
Notice of Default:-
1. The notice must be delivered by hand or by registered post.
2. The reason of default must be specified in the Notice. E.g. clause 25.1 (a) – (f).
Notice of Determination:-
1. The notice must be delivered by hand or by registered post.
2. Comply meticulously with the time table stated in contract.
3. Make sure the notice must be clear as what is being notified, stating the
Contractor’s default and the related clauses of the contract.
4. The notice must be in writing form.
5. Such notice must not be given unreasonably or vexatiously.
Question 3-Answer
 When there is determination occur, what action should the
contract parties take in the preparation of Final Account under
PAM 2006? State the related clause and explain.
Question 4
1. Clause 25.6, Architect shall within six (6) Months on completion of the works,
submit to Employer and Contractor a final account incurring all cost to
complete works for their agreement. E.g. contractual claims, amount
previously certified, etc.
2. Clause 25.6 (a), if both parties agree with the Final Account within three (3)
Months from the receipt of the F/A from Architect, the F/A shall be conclusive
and deemed to be agreed by both parties. If the revised amount is greater
than the original sum, Employer can then claim from the Performance Bond.
Vice versa, Contractor will be able to claim the amount from the Employer.
Question 4-Answer (Part 1)
3. Clause 25.6 (b), either party disagree on the F/A, he shall then give a written
notice to another party, setting out any disagreement within three (3) Months
from the receipt of such F/A. Again the Architect within three (3) Months may
or may not amend the F/A. Either party not satisfied with the amended F/A can
refer to arbitration as per clause 34.0 within three (3) Months upon receipt of
amended F/A. Failure to do so will lead to the F/A being conclusive and agreed
by both parties.
4. Any disputes on Liquidated Damages, set-off and interest which the Employer
is entitled to make under the Contract shall be referred to arbitration.
Question 4-Answer (Part 2)
If the NSC is on default, what are the procedure can be taken by
the employer to determine the employment of NSC ?
Question 5
1. The contractor shall give a written report stating the NSC’s default to
the Architect, with a copy extended to the NSC.
2. The architect may request the NSC to give an explanation in response
to the Contractor’s allegation of default.
3. This will also give the NSC the opportunity to rebut the Contractor’s
allegation with cogent evidence.
Question 5 – Answer
What steps shall employer takes to arrange the completion of
the remaining works?
Question 6
*Instructs the Contractor to carry out the following:
- Stop all operations on site.
- Demobilize and remove all his workers and staff.
- Leave all temporary building, plants and tools and unfixed
materials and good until they are not required.
* Make a claim against the bank, i.e. to call on the Performance Bond.
Question6 - Answer
*Arrange tender document, including a new BQ to be prepared and
tenders or quotations invited for the remaining works.
*Employ a replacement contractor to complete the works and make good
any defects.
* The Employer shall take up separate insurance coverage under fire and
Third Party policy for the completed works.
Question6 - Answer

More Related Content

What's hot

Partial possession-by-employer-29052017-finalized (1)
Partial possession-by-employer-29052017-finalized (1)Partial possession-by-employer-29052017-finalized (1)
Partial possession-by-employer-29052017-finalized (1)Tee Joanne

Clause 14.9 Payment of Retention Money-Understanding Clauses in FIDIC ‘Condit...
Clause 14.9 Payment of Retention Money-Understanding Clauses in FIDIC ‘Condit...Clause 14.9 Payment of Retention Money-Understanding Clauses in FIDIC ‘Condit...
Clause 14.9 Payment of Retention Money-Understanding Clauses in FIDIC ‘Condit...Divyanshu Dayal

Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...
Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...
Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...Divyanshu Dayal

Professional Practice II (Group Assignment)
Professional Practice II (Group Assignment)Professional Practice II (Group Assignment)
Professional Practice II (Group Assignment)Yee Len Wan

Subcontract Agreement to Perform Building Work (Purchase this doc, Text: 0811...
Subcontract Agreement to Perform Building Work (Purchase this doc, Text: 0811...Subcontract Agreement to Perform Building Work (Purchase this doc, Text: 0811...
Subcontract Agreement to Perform Building Work (Purchase this doc, Text: 0811...GLC

PP2 Assignment: Group
PP2 Assignment: GroupPP2 Assignment: Group
PP2 Assignment: GroupFarah Sham

TE&A's Newsletter, April, 2019
TE&A's Newsletter, April, 2019TE&A's Newsletter, April, 2019
TE&A's Newsletter, April, 2019Cerasela Angelescu

DIFFERENCE BETWEEN CONTRACT FORM JKR 203A & PAM
DIFFERENCE BETWEEN CONTRACT FORM JKR 203A & PAMDIFFERENCE BETWEEN CONTRACT FORM JKR 203A & PAM
DIFFERENCE BETWEEN CONTRACT FORM JKR 203A & PAMAnep Botak

Clause 14.1 The Contract Price- Understanding Clauses in FIDIC ‘Conditions of...
Clause 14.1 The Contract Price- Understanding Clauses in FIDIC ‘Conditions of...Clause 14.1 The Contract Price- Understanding Clauses in FIDIC ‘Conditions of...
Clause 14.1 The Contract Price- Understanding Clauses in FIDIC ‘Conditions of...Divyanshu Dayal

Seminar - CIPAA 2012
Seminar - CIPAA 2012Seminar - CIPAA 2012
Seminar - CIPAA 2012Kai Yun Pang

Pp2 assignment
Pp2 assignmentPp2 assignment
Pp2 assignmentfareezsham

Suspensions and Delays in Construction Contract
Suspensions and Delays in Construction ContractSuspensions and Delays in Construction Contract
Suspensions and Delays in Construction ContractAvinash Kumar Gupta

Construction lawprint-final-update-21112017
Construction lawprint-final-update-21112017Construction lawprint-final-update-21112017
Construction lawprint-final-update-21112017DarrenTofu

PP2 - Group Assignment
PP2 - Group AssignmentPP2 - Group Assignment
PP2 - Group AssignmentLin Hui

Professional practice 2
Professional practice 2Professional practice 2
Professional practice 2ahmong4

DEFECTS LIABILITY AND TAKING OVER CLAUSES
DEFECTS LIABILITY AND TAKING OVER CLAUSESDEFECTS LIABILITY AND TAKING OVER CLAUSES
DEFECTS LIABILITY AND TAKING OVER CLAUSESShivam Sood

Time management in fidic red book 2017(prmg080 project)
Time management in fidic red book 2017(prmg080 project)Time management in fidic red book 2017(prmg080 project)
Time management in fidic red book 2017(prmg080 project)mohamed Ismail


What's hot (20)

Partial possession-by-employer-29052017-finalized (1)
Partial possession-by-employer-29052017-finalized (1)Partial possession-by-employer-29052017-finalized (1)
Partial possession-by-employer-29052017-finalized (1)

Clause 14.9 Payment of Retention Money-Understanding Clauses in FIDIC ‘Condit...
Clause 14.9 Payment of Retention Money-Understanding Clauses in FIDIC ‘Condit...Clause 14.9 Payment of Retention Money-Understanding Clauses in FIDIC ‘Condit...
Clause 14.9 Payment of Retention Money-Understanding Clauses in FIDIC ‘Condit...

Site Possession
Site PossessionSite Possession
Site Possession

Cl compilation
Cl compilationCl compilation
Cl compilation

Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...
Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...
Clause 14.2 Advance Payment-Understanding Clauses in FIDIC ‘Conditions of Con...

Professional Practice II (Group Assignment)
Professional Practice II (Group Assignment)Professional Practice II (Group Assignment)
Professional Practice II (Group Assignment)

Subcontract Agreement to Perform Building Work (Purchase this doc, Text: 0811...
Subcontract Agreement to Perform Building Work (Purchase this doc, Text: 0811...Subcontract Agreement to Perform Building Work (Purchase this doc, Text: 0811...
Subcontract Agreement to Perform Building Work (Purchase this doc, Text: 0811...

PP2 Assignment: Group
PP2 Assignment: GroupPP2 Assignment: Group
PP2 Assignment: Group

TE&A's Newsletter, April, 2019
TE&A's Newsletter, April, 2019TE&A's Newsletter, April, 2019
TE&A's Newsletter, April, 2019

DIFFERENCE BETWEEN CONTRACT FORM JKR 203A & PAM
DIFFERENCE BETWEEN CONTRACT FORM JKR 203A & PAMDIFFERENCE BETWEEN CONTRACT FORM JKR 203A & PAM
DIFFERENCE BETWEEN CONTRACT FORM JKR 203A & PAM

Clause 14.1 The Contract Price- Understanding Clauses in FIDIC ‘Conditions of...
Clause 14.1 The Contract Price- Understanding Clauses in FIDIC ‘Conditions of...Clause 14.1 The Contract Price- Understanding Clauses in FIDIC ‘Conditions of...
Clause 14.1 The Contract Price- Understanding Clauses in FIDIC ‘Conditions of...

Seminar - CIPAA 2012
Seminar - CIPAA 2012Seminar - CIPAA 2012
Seminar - CIPAA 2012

Pp2 assignment
Pp2 assignmentPp2 assignment
Pp2 assignment

Pp2 p5
Pp2   p5Pp2   p5
Pp2 p5

Suspensions and Delays in Construction Contract
Suspensions and Delays in Construction ContractSuspensions and Delays in Construction Contract
Suspensions and Delays in Construction Contract

Construction lawprint-final-update-21112017
Construction lawprint-final-update-21112017Construction lawprint-final-update-21112017
Construction lawprint-final-update-21112017

PP2 - Group Assignment
PP2 - Group AssignmentPP2 - Group Assignment
PP2 - Group Assignment

Professional practice 2
Professional practice 2Professional practice 2
Professional practice 2

DEFECTS LIABILITY AND TAKING OVER CLAUSES
DEFECTS LIABILITY AND TAKING OVER CLAUSESDEFECTS LIABILITY AND TAKING OVER CLAUSES
DEFECTS LIABILITY AND TAKING OVER CLAUSES

Time management in fidic red book 2017(prmg080 project)
Time management in fidic red book 2017(prmg080 project)Time management in fidic red book 2017(prmg080 project)
Time management in fidic red book 2017(prmg080 project)


Similar to Seminar p8x

Pp2 coursework 1 p10
Pp2 coursework 1 p10 Pp2 coursework 1 p10
Pp2 coursework 1 p10 Farah Sham

Suspension and Termination by Contractor Presentation.pptx
Suspension and Termination by Contractor Presentation.pptxSuspension and Termination by Contractor Presentation.pptx
Suspension and Termination by Contractor Presentation.pptxNathannielGonzales1

Lecture 8-determination-of-own-employment-by
Lecture 8-determination-of-own-employment-byLecture 8-determination-of-own-employment-by
Lecture 8-determination-of-own-employment-byseenyeeyong

Tendering clauses of contract
Tendering clauses of contractTendering clauses of contract
Tendering clauses of contractkkganimix

CONTRACTS AND CLAIMS MANAGEMENT PPT.pptx
CONTRACTS AND CLAIMS MANAGEMENT PPT.pptxCONTRACTS AND CLAIMS MANAGEMENT PPT.pptx
CONTRACTS AND CLAIMS MANAGEMENT PPT.pptxssuserb7dd601

257883989-Claim-in-Red-Book-FIdic-Presentation-ver03.pptx
257883989-Claim-in-Red-Book-FIdic-Presentation-ver03.pptx257883989-Claim-in-Red-Book-FIdic-Presentation-ver03.pptx
257883989-Claim-in-Red-Book-FIdic-Presentation-ver03.pptxssuser6d14e4

Construction Contract Issues in Nebraska
Construction Contract Issues in NebraskaConstruction Contract Issues in Nebraska
Construction Contract Issues in NebraskaWoods & Aitken LLP

A Case Study based on FIDIC and PAM Form 2006
A Case Study based on FIDIC and PAM Form 2006A Case Study based on FIDIC and PAM Form 2006
A Case Study based on FIDIC and PAM Form 2006Melvin Lim

CIPAA presentation
CIPAA presentationCIPAA presentation
CIPAA presentationDoreen Yeo

Professional Practice II - Presentation - Construction Delays & EOT
Professional Practice II - Presentation - Construction Delays & EOTProfessional Practice II - Presentation - Construction Delays & EOT
Professional Practice II - Presentation - Construction Delays & EOTYee Len Wan

Techno Engineering & Associates
Techno Engineering & AssociatesTechno Engineering & Associates
Techno Engineering & AssociatesCerasela Angelescu

CE-CONTRACTS-REPORT.pdf
CE-CONTRACTS-REPORT.pdfCE-CONTRACTS-REPORT.pdf
CE-CONTRACTS-REPORT.pdfChelDems

Subcontract Agreement Konstruksi- CLEAN DRAFT.doc
Subcontract Agreement Konstruksi- CLEAN DRAFT.docSubcontract Agreement Konstruksi- CLEAN DRAFT.doc
Subcontract Agreement Konstruksi- CLEAN DRAFT.docMeneerGultom

Fidic conditions of contract presentation
Fidic conditions of contract presentationFidic conditions of contract presentation
Fidic conditions of contract presentationJeff B

ICM.pptx
ICM.pptxICM.pptx
ICM.pptxKoul5

CONTRACT FOR SOIL INVESTIGATION_CLEAN DRAFT.docx
CONTRACT FOR SOIL INVESTIGATION_CLEAN DRAFT.docxCONTRACT FOR SOIL INVESTIGATION_CLEAN DRAFT.docx
CONTRACT FOR SOIL INVESTIGATION_CLEAN DRAFT.docxGLC


Similar to Seminar p8x (20)

Pp2 coursework 1 p10
Pp2 coursework 1 p10 Pp2 coursework 1 p10
Pp2 coursework 1 p10

Suspension and Termination by Contractor Presentation.pptx
Suspension and Termination by Contractor Presentation.pptxSuspension and Termination by Contractor Presentation.pptx
Suspension and Termination by Contractor Presentation.pptx

Lecture 8-determination-of-own-employment-by
Lecture 8-determination-of-own-employment-byLecture 8-determination-of-own-employment-by
Lecture 8-determination-of-own-employment-by

Pp2 chapter 1 cheeyong & yih shyang
Pp2 chapter 1 cheeyong & yih shyangPp2 chapter 1 cheeyong & yih shyang
Pp2 chapter 1 cheeyong & yih shyang

Tendering clauses of contract
Tendering clauses of contractTendering clauses of contract
Tendering clauses of contract

CONTRACTS AND CLAIMS MANAGEMENT PPT.pptx
CONTRACTS AND CLAIMS MANAGEMENT PPT.pptxCONTRACTS AND CLAIMS MANAGEMENT PPT.pptx
CONTRACTS AND CLAIMS MANAGEMENT PPT.pptx

257883989-Claim-in-Red-Book-FIdic-Presentation-ver03.pptx
257883989-Claim-in-Red-Book-FIdic-Presentation-ver03.pptx257883989-Claim-in-Red-Book-FIdic-Presentation-ver03.pptx
257883989-Claim-in-Red-Book-FIdic-Presentation-ver03.pptx

Construction Contract Issues in Nebraska
Construction Contract Issues in NebraskaConstruction Contract Issues in Nebraska
Construction Contract Issues in Nebraska

CIPAA Conference - 21 August 2021
CIPAA Conference - 21 August 2021CIPAA Conference - 21 August 2021
CIPAA Conference - 21 August 2021

Claims and insolvencies (1)
Claims and insolvencies (1)Claims and insolvencies (1)
Claims and insolvencies (1)

A Case Study based on FIDIC and PAM Form 2006
A Case Study based on FIDIC and PAM Form 2006A Case Study based on FIDIC and PAM Form 2006
A Case Study based on FIDIC and PAM Form 2006

CIPAA presentation
CIPAA presentationCIPAA presentation
CIPAA presentation

Professional Practice II - Presentation - Construction Delays & EOT
Professional Practice II - Presentation - Construction Delays & EOTProfessional Practice II - Presentation - Construction Delays & EOT
Professional Practice II - Presentation - Construction Delays & EOT

Techno Engineering & Associates
Techno Engineering & AssociatesTechno Engineering & Associates
Techno Engineering & Associates

CE-CONTRACTS-REPORT.pdf
CE-CONTRACTS-REPORT.pdfCE-CONTRACTS-REPORT.pdf
CE-CONTRACTS-REPORT.pdf

Cl presentation
Cl presentationCl presentation
Cl presentation

Subcontract Agreement Konstruksi- CLEAN DRAFT.doc
Subcontract Agreement Konstruksi- CLEAN DRAFT.docSubcontract Agreement Konstruksi- CLEAN DRAFT.doc
Subcontract Agreement Konstruksi- CLEAN DRAFT.doc

Fidic conditions of contract presentation
Fidic conditions of contract presentationFidic conditions of contract presentation
Fidic conditions of contract presentation

ICM.pptx
ICM.pptxICM.pptx
ICM.pptx

CONTRACT FOR SOIL INVESTIGATION_CLEAN DRAFT.docx
CONTRACT FOR SOIL INVESTIGATION_CLEAN DRAFT.docxCONTRACT FOR SOIL INVESTIGATION_CLEAN DRAFT.docx
CONTRACT FOR SOIL INVESTIGATION_CLEAN DRAFT.docx


More from Jessyca Than

Construction law lecture 10
Construction law lecture 10Construction law lecture 10
Construction law lecture 10Jessyca Than

Be assignment-presentation 0
Be assignment-presentation 0Be assignment-presentation 0
Be assignment-presentation 0Jessyca Than

Be final report (1)
Be final report (1)Be final report (1)
Be final report (1)Jessyca Than

Chapter 1-research proposal
Chapter 1-research proposalChapter 1-research proposal
Chapter 1-research proposalJessyca Than

Chap 2-literature-review (3)
Chap 2-literature-review (3)Chap 2-literature-review (3)
Chap 2-literature-review (3)Jessyca Than

Indoor environmental-quality-in-healthcare-3-2
Indoor environmental-quality-in-healthcare-3-2Indoor environmental-quality-in-healthcare-3-2
Indoor environmental-quality-in-healthcare-3-2Jessyca Than

Measurement 1 site report
Measurement 1 site reportMeasurement 1 site report
Measurement 1 site reportJessyca Than

Mural presentation
Mural presentationMural presentation
Mural presentationJessyca Than

Spiderman vs batman
Spiderman vs batman Spiderman vs batman
Spiderman vs batman Jessyca Than

Threesome love with storyline
Threesome love with storylineThreesome love with storyline
Threesome love with storylineJessyca Than

Psychology comic strip slides
Psychology comic strip slidesPsychology comic strip slides
Psychology comic strip slidesJessyca Than

Psychology journal
Psychology journal Psychology journal
Psychology journal Jessyca Than


More from Jessyca Than (18)

Vm report
Vm reportVm report
Vm report

Construction law lecture 10
Construction law lecture 10Construction law lecture 10
Construction law lecture 10

Be assignment-presentation 0
Be assignment-presentation 0Be assignment-presentation 0
Be assignment-presentation 0

Be final report (1)
Be final report (1)Be final report (1)
Be final report (1)

Fm compilation
Fm compilationFm compilation
Fm compilation

Pp2 asignment-1
Pp2 asignment-1Pp2 asignment-1
Pp2 asignment-1

Chapter 1-research proposal
Chapter 1-research proposalChapter 1-research proposal
Chapter 1-research proposal

Chap 2-literature-review (3)
Chap 2-literature-review (3)Chap 2-literature-review (3)
Chap 2-literature-review (3)

Indoor environmental-quality-in-healthcare-3-2
Indoor environmental-quality-in-healthcare-3-2Indoor environmental-quality-in-healthcare-3-2
Indoor environmental-quality-in-healthcare-3-2

Measurement 1 site report
Measurement 1 site reportMeasurement 1 site report
Measurement 1 site report

Presentation1 1
Presentation1 1Presentation1 1
Presentation1 1

Compilation
CompilationCompilation
Compilation

Mural presentation
Mural presentationMural presentation
Mural presentation

Spiderman vs batman
Spiderman vs batman Spiderman vs batman
Spiderman vs batman

Psycho report
Psycho reportPsycho report
Psycho report

Threesome love with storyline
Threesome love with storylineThreesome love with storyline
Threesome love with storyline

Psychology comic strip slides
Psychology comic strip slidesPsychology comic strip slides
Psychology comic strip slides

Psychology journal
Psychology journal Psychology journal
Psychology journal


Recently uploaded

1029-Danh muc Sach Giao Khoa khoi 6.pdf
1029-Danh muc Sach Giao Khoa khoi  6.pdf1029-Danh muc Sach Giao Khoa khoi  6.pdf
1029-Danh muc Sach Giao Khoa khoi 6.pdfQucHHunhnh

Arihant handbook biology for class 11 .pdf
Arihant handbook biology for class 11 .pdfArihant handbook biology for class 11 .pdf
Arihant handbook biology for class 11 .pdfchloefrazer622

Interactive Powerpoint_How to Master effective communication
Interactive Powerpoint_How to Master effective communicationInteractive Powerpoint_How to Master effective communication
Interactive Powerpoint_How to Master effective communicationnomboosow

Paris 2024 Olympic Geographies - an activity
Paris 2024 Olympic Geographies - an activityParis 2024 Olympic Geographies - an activity
Paris 2024 Olympic Geographies - an activityGeoBlogs

Organic Name Reactions for the students and aspirants of Chemistry12th.pptx
Organic Name Reactions  for the students and aspirants of Chemistry12th.pptxOrganic Name Reactions  for the students and aspirants of Chemistry12th.pptx
Organic Name Reactions for the students and aspirants of Chemistry12th.pptxVS Mahajan Coaching Centre

Presentation by Andreas Schleicher Tackling the School Absenteeism Crisis 30 ...
Presentation by Andreas Schleicher Tackling the School Absenteeism Crisis 30 ...Presentation by Andreas Schleicher Tackling the School Absenteeism Crisis 30 ...
Presentation by Andreas Schleicher Tackling the School Absenteeism Crisis 30 ...EduSkills OECD

A Critique of the Proposed National Education Policy Reform
A Critique of the Proposed National Education Policy ReformA Critique of the Proposed National Education Policy Reform
A Critique of the Proposed National Education Policy ReformChameera Dedduwage

SOCIAL AND HISTORICAL CONTEXT - LFTVD.pptx
SOCIAL AND HISTORICAL CONTEXT - LFTVD.pptxSOCIAL AND HISTORICAL CONTEXT - LFTVD.pptx
SOCIAL AND HISTORICAL CONTEXT - LFTVD.pptxiammrhaywood

1029 - Danh muc Sach Giao Khoa 10 . pdf
1029 -  Danh muc Sach Giao Khoa 10 . pdf1029 -  Danh muc Sach Giao Khoa 10 . pdf
1029 - Danh muc Sach Giao Khoa 10 . pdfQucHHunhnh

Q4-W6-Restating Informational Text Grade 3
Q4-W6-Restating Informational Text Grade 3Q4-W6-Restating Informational Text Grade 3
Q4-W6-Restating Informational Text Grade 3JemimahLaneBuaron

POINT- BIOCHEMISTRY SEM 2 ENZYMES UNIT 5.pptx
POINT- BIOCHEMISTRY SEM 2 ENZYMES UNIT 5.pptxPOINT- BIOCHEMISTRY SEM 2 ENZYMES UNIT 5.pptx
POINT- BIOCHEMISTRY SEM 2 ENZYMES UNIT 5.pptxSayali Powar

mini mental status format.docx
mini    mental       status     format.docxmini    mental       status     format.docx
mini mental status format.docxPoojaSen20

Call Girls in Dwarka Mor Delhi Contact Us 9654467111
Call Girls in Dwarka Mor Delhi Contact Us 9654467111Call Girls in Dwarka Mor Delhi Contact Us 9654467111
Call Girls in Dwarka Mor Delhi Contact Us 9654467111Sapana Sha

Web & Social Media Analytics Previous Year Question Paper.pdf
Web & Social Media Analytics Previous Year Question Paper.pdfWeb & Social Media Analytics Previous Year Question Paper.pdf
Web & Social Media Analytics Previous Year Question Paper.pdfJayanti Pande

Disha NEET Physics Guide for classes 11 and 12.pdf
Disha NEET Physics Guide for classes 11 and 12.pdfDisha NEET Physics Guide for classes 11 and 12.pdf
Disha NEET Physics Guide for classes 11 and 12.pdfchloefrazer622

The byproduct of sericulture in different industries.pptx
The byproduct of sericulture in different industries.pptxThe byproduct of sericulture in different industries.pptx
The byproduct of sericulture in different industries.pptxShobhayan Kirtania

Ecosystem Interactions Class Discussion Presentation in Blue Green Lined Styl...
Ecosystem Interactions Class Discussion Presentation in Blue Green Lined Styl...Ecosystem Interactions Class Discussion Presentation in Blue Green Lined Styl...
Ecosystem Interactions Class Discussion Presentation in Blue Green Lined Styl...fonyou31


Recently uploaded (20)

1029-Danh muc Sach Giao Khoa khoi 6.pdf
1029-Danh muc Sach Giao Khoa khoi  6.pdf1029-Danh muc Sach Giao Khoa khoi  6.pdf
1029-Danh muc Sach Giao Khoa khoi 6.pdf

Arihant handbook biology for class 11 .pdf
Arihant handbook biology for class 11 .pdfArihant handbook biology for class 11 .pdf
Arihant handbook biology for class 11 .pdf

Interactive Powerpoint_How to Master effective communication
Interactive Powerpoint_How to Master effective communicationInteractive Powerpoint_How to Master effective communication
Interactive Powerpoint_How to Master effective communication

Paris 2024 Olympic Geographies - an activity
Paris 2024 Olympic Geographies - an activityParis 2024 Olympic Geographies - an activity
Paris 2024 Olympic Geographies - an activity

Organic Name Reactions for the students and aspirants of Chemistry12th.pptx
Organic Name Reactions  for the students and aspirants of Chemistry12th.pptxOrganic Name Reactions  for the students and aspirants of Chemistry12th.pptx
Organic Name Reactions for the students and aspirants of Chemistry12th.pptx

Código Creativo y Arte de Software | Unidad 1
Código Creativo y Arte de Software | Unidad 1Código Creativo y Arte de Software | Unidad 1
Código Creativo y Arte de Software | Unidad 1

Advance Mobile Application Development class 07
Advance Mobile Application Development class 07Advance Mobile Application Development class 07
Advance Mobile Application Development class 07

Presentation by Andreas Schleicher Tackling the School Absenteeism Crisis 30 ...
Presentation by Andreas Schleicher Tackling the School Absenteeism Crisis 30 ...Presentation by Andreas Schleicher Tackling the School Absenteeism Crisis 30 ...
Presentation by Andreas Schleicher Tackling the School Absenteeism Crisis 30 ...

A Critique of the Proposed National Education Policy Reform
A Critique of the Proposed National Education Policy ReformA Critique of the Proposed National Education Policy Reform
A Critique of the Proposed National Education Policy Reform

SOCIAL AND HISTORICAL CONTEXT - LFTVD.pptx
SOCIAL AND HISTORICAL CONTEXT - LFTVD.pptxSOCIAL AND HISTORICAL CONTEXT - LFTVD.pptx
SOCIAL AND HISTORICAL CONTEXT - LFTVD.pptx

1029 - Danh muc Sach Giao Khoa 10 . pdf
1029 -  Danh muc Sach Giao Khoa 10 . pdf1029 -  Danh muc Sach Giao Khoa 10 . pdf
1029 - Danh muc Sach Giao Khoa 10 . pdf

Q4-W6-Restating Informational Text Grade 3
Q4-W6-Restating Informational Text Grade 3Q4-W6-Restating Informational Text Grade 3
Q4-W6-Restating Informational Text Grade 3

POINT- BIOCHEMISTRY SEM 2 ENZYMES UNIT 5.pptx
POINT- BIOCHEMISTRY SEM 2 ENZYMES UNIT 5.pptxPOINT- BIOCHEMISTRY SEM 2 ENZYMES UNIT 5.pptx
POINT- BIOCHEMISTRY SEM 2 ENZYMES UNIT 5.pptx

mini mental status format.docx
mini    mental       status     format.docxmini    mental       status     format.docx
mini mental status format.docx

Call Girls in Dwarka Mor Delhi Contact Us 9654467111
Call Girls in Dwarka Mor Delhi Contact Us 9654467111Call Girls in Dwarka Mor Delhi Contact Us 9654467111
Call Girls in Dwarka Mor Delhi Contact Us 9654467111

Web & Social Media Analytics Previous Year Question Paper.pdf
Web & Social Media Analytics Previous Year Question Paper.pdfWeb & Social Media Analytics Previous Year Question Paper.pdf
Web & Social Media Analytics Previous Year Question Paper.pdf

Mattingly "AI & Prompt Design: The Basics of Prompt Design"
Mattingly "AI & Prompt Design: The Basics of Prompt Design"Mattingly "AI & Prompt Design: The Basics of Prompt Design"
Mattingly "AI & Prompt Design: The Basics of Prompt Design"

Disha NEET Physics Guide for classes 11 and 12.pdf
Disha NEET Physics Guide for classes 11 and 12.pdfDisha NEET Physics Guide for classes 11 and 12.pdf
Disha NEET Physics Guide for classes 11 and 12.pdf

The byproduct of sericulture in different industries.pptx
The byproduct of sericulture in different industries.pptxThe byproduct of sericulture in different industries.pptx
The byproduct of sericulture in different industries.pptx

Ecosystem Interactions Class Discussion Presentation in Blue Green Lined Styl...
Ecosystem Interactions Class Discussion Presentation in Blue Green Lined Styl...Ecosystem Interactions Class Discussion Presentation in Blue Green Lined Styl...
Ecosystem Interactions Class Discussion Presentation in Blue Green Lined Styl...


Seminar p8x

  • 1. P8-Determination of Contractor’s Employment by Employer Ngah Yea Zhe 0323204 Than Lek Mei 0315538 Kiing Kiu Chun 0318727
  • 2. Contractor himself is relieved from his contractual obligation to procced with the work under contract due to termination of his employment due to his own default. The determination will keep the contract alive in a modified form.  E.G., the dispute resolution clause will survive the determination whereas the liquidated damages will not survive the determination, liquidated damages charged to contractor will be up to the date of determination. Determination of Contractor’s employment by Employer
  • 3.  Contract does not come to an end, but it will remain in force in order to bring it to a closure.  This matter means that both party will have to wait until the project is finish to get the final revised contract sum, afterwards employer will claim the excess amount from the contractor. Upon Termination of Contractor’s Employment
  • 4. Under PAM Contract 2006 clause 25.1 (a)-(f), Employer may determine the employment of the Contractor if the Contractor are found to be default in any of the following:- 1. Clause 25.1 (a), Contractor fails to commence the work in accordance with the contract without reasonable reasons. 2. Clause 25.1 (b), Contractor wholly or substantially suspends the carrying out of work without reasonable reasons. 3. Clause 25.1 (c), when the Contractor fails to proceed regularly and/or diligently with the works in terms of time and quality. Default by Contractor
  • 5. 4. Clause 25.1 (d), Contractor persistently refuses or neglect to comply with Architect Instruction (AI). 5. Clause 25.1 (e), which stated the Contractor’s failure to comply with clause 17.0, which defines when the Contractor assigns his rights, interest and benefits under the contract to other parties or wholly or substantially subcontract the works without the written consent of Employer. 6. Clause 25.1 (f), where Contractor abandons his work with no intention to continue the work. Default by Contractor
  • 6.  Employment of Contractor can be determined under the stated circumstances, e.g. PAM 2006 clause 25.1 (a)-(f).  The reason for determination must be clearly stated.  The base Employer uses to exercise the determination need to be stated in the notice as well, e.g. PAM 2006, Common Law and etc. Notice of Determination
  • 7. According to PAM 2006 clause 25.2, upon any occurrence of default under Clause 25.1, and if the Employer decides to terminate the employment of Contractor, Employer or Architect on his behalf shall give Contractor a written notice by hand or by registered post specifying the default. If the Contractor continue its default for fourteen (14) Days after the receipt of such notice, the Employer may, within ten (10) Days from the expiry of fourteen (14) Days by a further written notice, determine the employment of Contractor under the contract. Strict Compliance with Procedure for Determination
  • 8. a. Issue Notice of Default to the Contractor. The notice shall be issued by Employer or Architect stating the default. b. Upon the receipt of such notice, Contractor can take the following action:- I. Dispute the notice; II. Admit the notice and make good; III. Ignore the notice and continue with the default. c. The Contractor is given 14 Days to rectify the default. 2-Steps Procedure for Determination : Step 1
  • 9. a. If Contractor continue such default after expiry of fourteen (14) Days upon the receipt of Notice of Default, the Employer can (only) issue the Notice of Determination within ten (10) Days from the expiry of said fourteen Days. b. Contractor must vacate the site and return site possession to Employer within 14 Days from Notice of Determination. c. Architect/Quantity Surveyor shall give written notice to Contractor within 28 Days of determination of the date of inspection on site to jointly record extent of work done and materials delivered. 2-Steps Procedure for Determination : Step 2
  • 10. d. Architect/Quantity Surveyor to submit Final Account to Employer/Contractor within 6 months from the completion of the remaining works. e. Any disputes from Employer/Contractor must be raised within 3 Months from receipt of Final Account, otherwise the Final Account will be considered as conclusive and agreed by both parties. f. Where either party have disagreement over the Final Account, they shall submit their disagreement to the Architect/Quantity Surveyor. They will then within 3 Months, go deep into the disagreement to decide whether to amend and notify the parties. Afterwards, either party is given 3 Months to refer the disagreement to arbitration, or else the result will be seem as conclusive and agreed by both parties 2-Steps Procedure for Determination : Step 2
  • 11. Under PAM 2006 clause 25.3, the employment of the Contractor shall be automatically determined if:- 1. The Contractor has become insolvent; 2. Making a composition or arrangement with his creditors; 3. Have a winding up order made; 4. A resolution for voluntary winding up; 5. Having a liquidator/receiver/manager of his business of undertaking duty appointed by the court; 6. Having possession taken by or on behalf of the holders of any debentures secured by a floating charge. Automatic Determination
  • 12. According to PAM 2006 clause 25.4, if the Contractor’s employment is determined under clause 25.1 or 25.3, Employer/Contractor will have following rights and duties:- 1. If Employer himself is in breach of contract, which he fails to pay Contractor within the Period of Honouring Certificates, then he will lose his rights to determine the Contractor’s employment under ‘prevention principle’. 2. Employer may determine the Contractor’s employment under the contractual procedure of Contract. If Employer has default or failed to comply with the procedure, then he will have to rely on common law termination. Rights and Duties of Employer/Contractor after Determination
  • 13. After Determination, Contractor shall:- Under clause 25.4 (a):- 1. Vacate the site peacefully, 2. Return the site possession to the Employer within 14 Days from the receipt of Notice of Determination. 3. Remove from site any temporary buildings, plant and materials belonging to him or hired by him, when so instructed by the Architect. 4. If required by Employer, Contractor shall within twenty one (21) Days of the date of determination, assign to the employer the benefit of any agreement for the continuation of the hire of construction plant and equipment already on site. Duties of Contractor after Determination
  • 14. Under clause 25.4 (b):- 1. If required by the Employer of Architect, Contractor shall within twenty one (21) Days of the date of determination, assign to the employer without the payment the benefit of any agreement for the supply of materials, goods and/or for the execution of any work. Under Clause 25.4 (c):- 1. When instructed by the Architect, Contractor shall remove from the works any temporary buildings, construction plant, tools, equipment, materials and goods belonging to or hired by him. If Contractor failed to comply with, the Employer may without liability remove and sell those property belonged to the Contractor, except for those that are on hire. Duties of Contractor after Determination
  • 15. Under clause 25.4 (d):- 1. The Contractor shall allow or pay to the Employer all cost incurred to complete the work, which includes the lose and/or expense suffered by the Employer. Until the completion of work, Employer shall no make any further payment to the Contractor. Upon the completion of work, an account which will include the value of work carried out by the Contractor and all lose and/or expense incurred by the Employer will be taken into Final Account as per clause 25.6. Duties of Contractor after Determination
  • 16. 1. Under clause 25.7, Contractor has the right to claim for compensation for damages only if the Determination is later found to be invalid or beyond contract provision. 2. The right to claim for such compensation is subject to the Contractor’s ability to prove his entitlement and quantum he deserves. Rights of Contractor after Determination
  • 17. Under clause 25.4(a) states that the Employer may:  take back site possession from the contractor in a safe condition.  employ and pay another contractor to carry out and complete the works and to make good any defects.  use all temporary buildings, construction plant, tools, materials and goods on or adjacent to the site except hired construction plant.  purchase all materials and goods necessary for the carrying out and completion of the works. Duties and Rights of Employer after determination
  • 18.  require the Contractor to assign without payment the benefit of any agreement for the supply of materials, goods and for the execution of any work.  instruct the Contractor to remove any temporary buildings, construction plant, tools, equipment, materials and goods belonging to or hired by him; if not they may be sold and the proceeds less all costs incurred held to the credit of the contractor.  the employer is entitled to be paid all cost incurred to complete the works by the contractor including all loss and/or expense suffered by him.  make no further payment to the contractor until after the completion of the works when there is a final settling up. Duties and Rights of Employer after determination
  • 19. 1. Under clause 25.8 “the provisions of this clause are without prejudice to any other rights and/or remedies which the Employer may possess’. 2. This provision is aimed at preserving the Employer’s common law rights and remedies in the event of determination. 3. In practice, the Contractor have parallel rights for determination under common law, even though it is not so expressed in the contract. Employer’s rights and remedies not prejudices
  • 20. 4. In the event of any default by the Contractor, the Employer must exercise his rights to determine either: - Under the clause 25.2 of the contract for performance default; or - - Under common law. 5. If the Employer chooses to determine the contract, then he is bound by the contract provisions and he cannot resort to the common law rights of determination as an alternative. 6. Common law rights can only be excluded by express term in the contract. Employer’s rights and remedies not prejudices
  • 21. The Employer shall take immediate steps to arrange for the completion of the remaining works: 1. Instructs the Contractor to carry out the following: - Cease all operations on site. - Demobilize and remove all his workers and staff. - Leave all temporary building, plants and tools and unfixed materials and good until they are not required. 2. Make a claim against the bank, i.e. to call on the Performance Bond. Completion of remaining works
  • 22. 3. Arrange tender document, including a new BQ to be prepared and tenders or quotations invited for the remaining works. 4. Employ a replacement contractor to complete the works and make good any defects. 5. The Employer shall take up separate insurance coverage under fire and Third Party policy for the completed works. Completion of remaining works
  • 23. 1. The Architect shall nominate the same NSCs to the replaced contractor provided they are agreeable to proceed with the same subcontract sum or price, as if their employment by the first Contractor had not been terminated. 2. The new subcontract sums shall be the original subcontract sum less the amount previously paid to the NSCs. 3. Where a NSC demands for an increase of the subcontract sum, fresh tenders or quotations shall be invited to complete the works. Completion of the remaining NSC’s works
  • 24. 1. Under clause 27.8, the Contractor can determine the NSC’s employment only with the Architect’s written consent. 2. The rationale behind this condition is to avoid any wrongful determination of the NSC, which would disrupt the progress of the subcontract works and in turn delay the work works. Determination of NSC’s Employment
  • 25. 1. The contractor shall give a written report stating the NSC’s default to the Architect, with a copy extended to the NSC. 2. The architect may request the NSC to give an explanation in response to the Contractor’s allegation of default. 3. This will also give the NSC the opportunity to rebut the Contractor’s allegation with cogent evidence. Procedure for the determination of NSC’s Employment
  • 26. 1. When the NSC abandoned his work, the Contractor shall determine the NSC’s employment with the Architect’s consent. 2. The Architect shall re-nominate a replacement NSC to complete the remaining works within a reasonable time. 3. The Employer has to pay any additional amount to the Contractor if the replacement MSC charges a higher price than what would have been payable to the previous NSC. How to complete remaining works ‘abandoned’ by NSC
  • 27. 4. The Employer is liable to bear time and cost implications unless such cost are recoverable from the previous NSC. 5. Any such additional expenses recovered by the Contractor from the previous NSC will have to go towards the cost of completing the remaining subcontract works. 6. Such recoverable cost cannot be charged back to the Employer. How to complete remaining works ‘abandoned’ by NSC
  • 28. J01. JKR Form Clause 51.1 gives the rights to terminate the Contract by the Government in the event of any of the following Contractor’s defaults: i) fails to commence works at site within 2 weeks after Date for Possession ii) suspends or abandons the works before Date of Completion iii) fails to proceed regularly and diligently with the performance iv) fails to execute the Works in accordance with the Contract v) persistently neglects to carry out his obligations under the Contract vi) fails to comply with clause 47 vii) fails to comply with any terms and conditions of this Contract In comparison with JKR Form 203A (2007)
  • 29. In comparison with JKR Form 203A (2007) Officer named in the Appendix shall give written notice to Contractor specifying the default and requiring the Contractor to remedy the default within 14 days of receipt of the default. J02. Clause 51.2 gives the rights to terminate the Contract by the Government In the event that the Contractor becomes bankrupt or insolvent or an order for winding up or a liquidator has been appointed or execution is levied against a substantial portion of the Contractor’s assts.
  • 30. J03. In the event of termination of Contract under clause 51.1 & 2, Contractor [under clause 51.1 (c) (i)] shall:  stop all operations of the Works  carry out any protection works to secure the site against loss or damage and leave the Site in a clean and tidy condition  remove its staffs and workmen from the Site  vacate the Site within the time stipulated by the S.O., remove all temporary buildings and equipment and unfixed materials which are not paid. In comparison with JKR Form 203A (2007)
  • 31.  terminate all third party contracts entered into by the Contractor; or assign to the Government if so required by the S.O.; or allow such third party to enter into a contract with the Government to complete the Works.  at no cost to the Government, hand over all plans, designs, relevant documents.  pay to the Government for any losses and damages as a result of termination of Contract  Not be released from any of its obligations under the Contract. In comparison with JKR Form 203A (2007)
  • 32. J04. In the event of termination of Contract under clause 51.1 & 2, the Government, [under clause 51.1 (c) ( ii)], shall: A) call upon the Performance Bond or forfeit the Performance Guarantee Sum B) enter and repossess the Site C) be entitled to carry out and complete the Works on its own or employed any other person to carry out and complete the Works D) be entitled to claim against the Contractor for any losses, cost, expenses and damages suffered as a result of termination of this contract. In comparison with JKR Form 203A (2007)
  • 33. J05. Upon termination, Government is not liable for further payments on unpaid certificates. J06. Government can terminate the Contract based on national interest under clause 52 by giving not less than 30 days written notice to Contractor. The Government is not required to give any reason if the Government considers that such termination is necessary for national interest, national policy or national security. J07. Clause 53 provides for the Government to terminate the Contract on corruption, Clause 51.1(c)(i) and (ii) shall apply the if Contractor or its agents gives of offers to give to any person any bribe, gift, gratuity or commission as inducement or reward for doing or forbearing to do any actions In comparison with JKR Form 203A (2007)
  • 34.  Discuss the situations where Employer can determine the Contractor’s Employment provided for in PAM 2006. Question 1
  • 35. Question 1 - Answer Under PAM Contract 2006 clause 25.1 (a)-(f), Employer may determine the employment of the Contractor if the Contractor are found to be default in any of the following:- 1. Clause 25.1 (a), Contractor fails to commence the work in accordance with the contract without reasonable reasons. 2. Clause 25.1 (b), Contractor wholly or substantially suspends the carrying out of work without reasonable reasons. 3. Clause 25.1 (c), when the Contractor fails to proceed regularly and/or diligently with the works in terms of time and quality.
  • 36. 4. Clause 25.1 (d), Contractor persistently refuses or neglect to comply with Architect Instruction (AI). 5. Clause 25.1 (e), which stated the Contractor’s failure to comply with clause 17.0, which defines when the Contractor assigns his rights, interest and benefits under the contract to other parties or wholly or substantially subcontract the works without the written consent of Employer. 6. Clause 25.1 (f), where Contractor abandons his work with no intention to continue the work.
  • 37.  What must the Employer check before determining the Contractor’s Employment? What can happen if the Employer had failed to pay the sum due on Interim Certificate at the time of determination? Question 2
  • 38. Employer had to make sure the Contractor had made default in any of the following under clause 25.1:- (a). Fails to commence the Works in accordance with the Contract without reasonable cause; (b). Wholly or substantially suspends the carrying out of the Works before completion without reasonable cause; (c). If he fails to proceed regularly and/or diligently with the Works; (d). If he persistently refuses or neglects to comply with an AI; (e). If he fails to comply with the provisions in Clause 17.0; (f). If he has abandoned the Works. Question 2-Answer (Part 1)
  • 39. If Employer himself is in breach of contract, which he fails to pay Contractor within the Period of Honoring Certificates stated in clause 26.1 (a), then he will lose his rights to determine the Contractor’s employment under ‘prevention principle’. Question 2-Answer (Part 2)
  • 40.  Discuss the essential contents required in the Notice of Default and Notice of Determination. Question 3
  • 41. Notice of Default:- 1. The notice must be delivered by hand or by registered post. 2. The reason of default must be specified in the Notice. E.g. clause 25.1 (a) – (f). Notice of Determination:- 1. The notice must be delivered by hand or by registered post. 2. Comply meticulously with the time table stated in contract. 3. Make sure the notice must be clear as what is being notified, stating the Contractor’s default and the related clauses of the contract. 4. The notice must be in writing form. 5. Such notice must not be given unreasonably or vexatiously. Question 3-Answer
  • 42.  When there is determination occur, what action should the contract parties take in the preparation of Final Account under PAM 2006? State the related clause and explain. Question 4
  • 43. 1. Clause 25.6, Architect shall within six (6) Months on completion of the works, submit to Employer and Contractor a final account incurring all cost to complete works for their agreement. E.g. contractual claims, amount previously certified, etc. 2. Clause 25.6 (a), if both parties agree with the Final Account within three (3) Months from the receipt of the F/A from Architect, the F/A shall be conclusive and deemed to be agreed by both parties. If the revised amount is greater than the original sum, Employer can then claim from the Performance Bond. Vice versa, Contractor will be able to claim the amount from the Employer. Question 4-Answer (Part 1)
  • 44. 3. Clause 25.6 (b), either party disagree on the F/A, he shall then give a written notice to another party, setting out any disagreement within three (3) Months from the receipt of such F/A. Again the Architect within three (3) Months may or may not amend the F/A. Either party not satisfied with the amended F/A can refer to arbitration as per clause 34.0 within three (3) Months upon receipt of amended F/A. Failure to do so will lead to the F/A being conclusive and agreed by both parties. 4. Any disputes on Liquidated Damages, set-off and interest which the Employer is entitled to make under the Contract shall be referred to arbitration. Question 4-Answer (Part 2)
  • 45. If the NSC is on default, what are the procedure can be taken by the employer to determine the employment of NSC ? Question 5
  • 46. 1. The contractor shall give a written report stating the NSC’s default to the Architect, with a copy extended to the NSC. 2. The architect may request the NSC to give an explanation in response to the Contractor’s allegation of default. 3. This will also give the NSC the opportunity to rebut the Contractor’s allegation with cogent evidence. Question 5 – Answer
  • 47. What steps shall employer takes to arrange the completion of the remaining works? Question 6
  • 48. *Instructs the Contractor to carry out the following: - Stop all operations on site. - Demobilize and remove all his workers and staff. - Leave all temporary building, plants and tools and unfixed materials and good until they are not required. * Make a claim against the bank, i.e. to call on the Performance Bond. Question6 - Answer
  • 49. *Arrange tender document, including a new BQ to be prepared and tenders or quotations invited for the remaining works. *Employ a replacement contractor to complete the works and make good any defects. * The Employer shall take up separate insurance coverage under fire and Third Party policy for the completed works. Question6 - Answer
