Scrum-ban
mixing agile and lean
By Vidas Vasiliauskas
About me
• Product manager at Eylean board
• Started career as a developer
• 8 years in software industry
• Doing “lean startup”
Why you should hear this?
Why you should hear this?
• You are doing product development
Why you should hear this?
• You are doing product development
• You are in a startup
Why you should hear this?
• You are doing product development
• You are in a startup
• Your team is less or equal to 8 people
Why you should hear this?
• You are doing product development
• You are in a startup
• Your team is less or equal to 8 people
• Uncertainty is a daily thing for you
Why you should hear this?
• You are doing product development
• You are in a startup
• Your team is less or equal to 8 people
• Uncertainty is a daily thing for you
• You have heard or practiced agile and lean
Scrum vs Scrum-ban

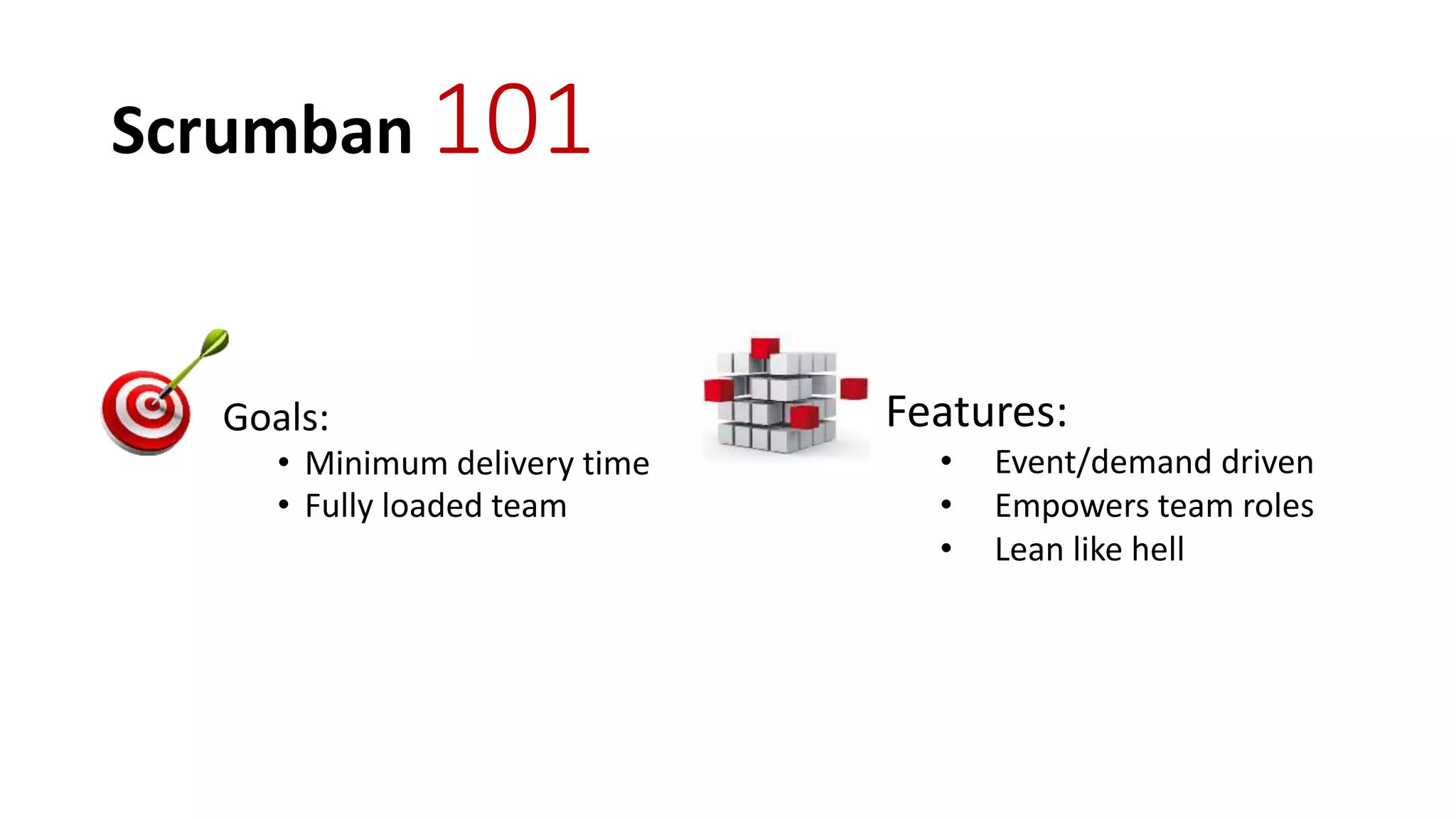

Scrumban 101
Goals:
• Minimum delivery time
• Fully loaded team
Features:
• Event/demand driven
• Empowers team roles
• Lean like hell

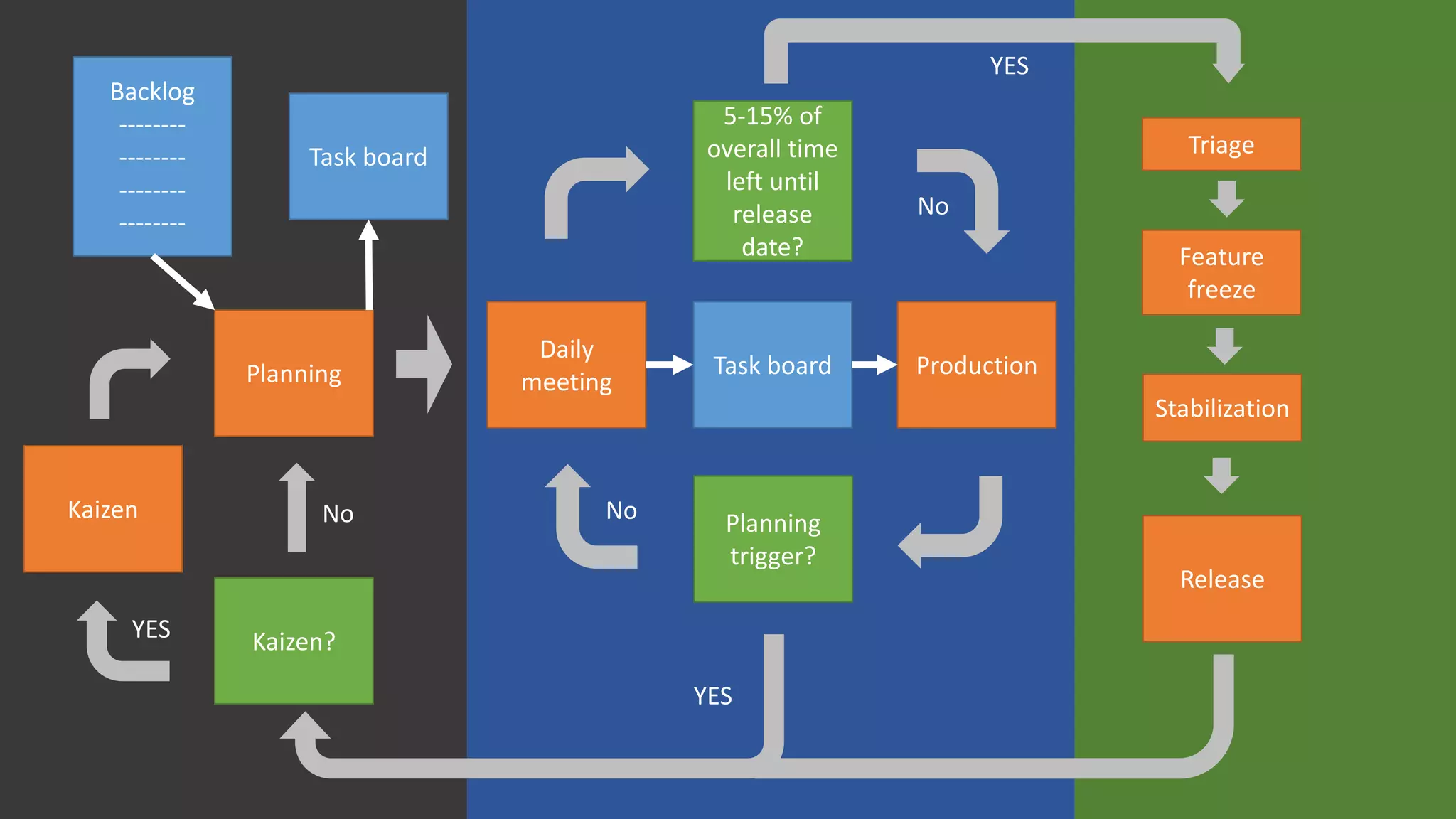

Backlog
--------
--------
--------
--------
Planning
Daily
meeting
Production
Release
Planning
trigger?
5-15% of
overall time
left until
release
date?

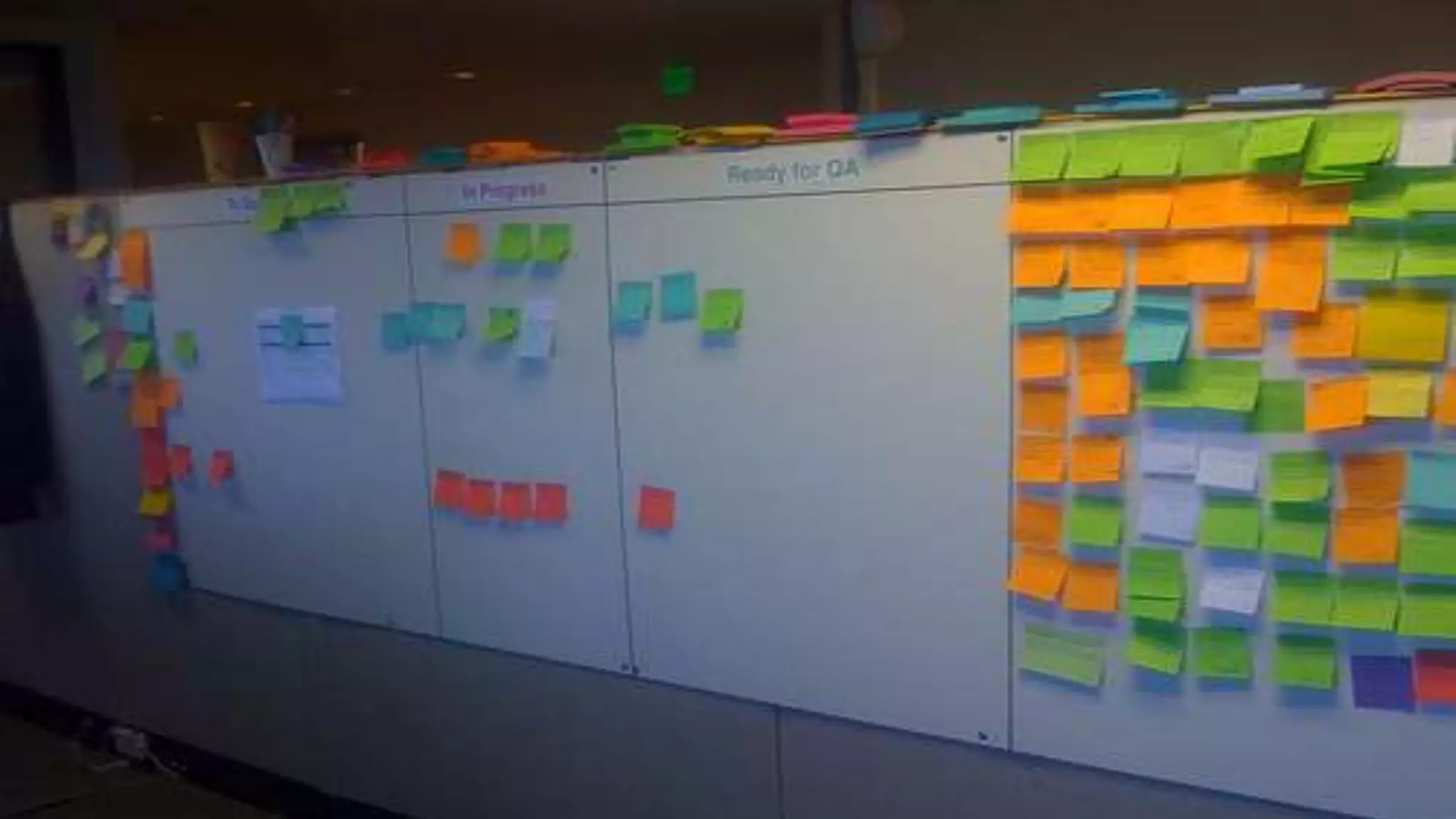

Task board
Task board Triage
Feature
freeze
Stabilization
Kaizen?
Kaizen
YES
No
YES
No
No
YES
Task board
To do Doing Done
Analyze
requirements
Develop project
plan
Develop project
plan
Initiate
agreement

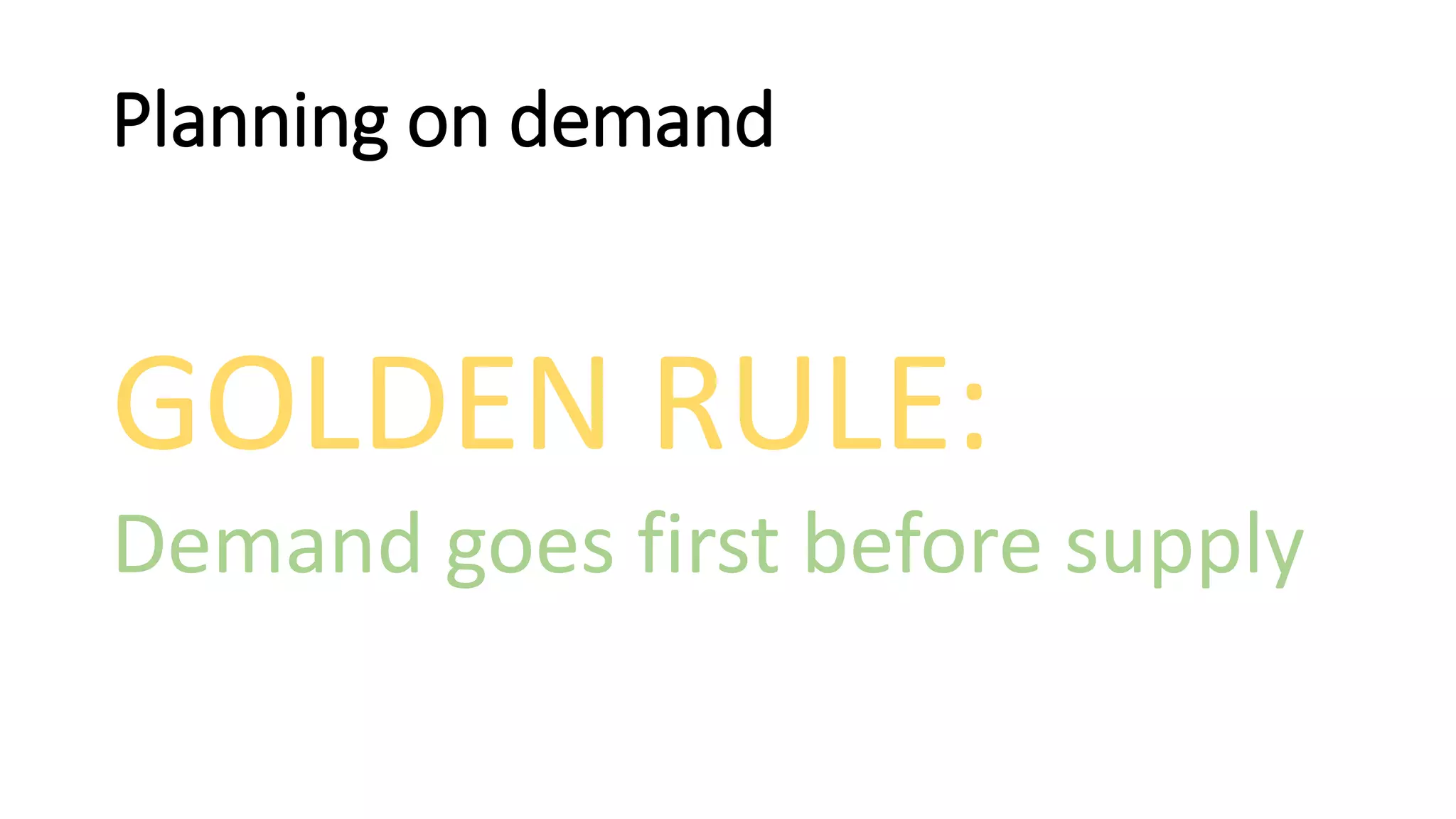

Planning on demand
GOLDEN RULE:
Demand goes first before supply
To do Doing Done
Analyze
requirements
Define
specifications
Create design
guidelines
Initiate
agreement
Create design
docs
To do Doing Done
Analyze
requirements
Define
specifications
Create design
guidelines
Initiate
agreement
Create design
docs
2
To do Doing Done
Analyze
requirements
Define
specifications
Create design
guidelines
Initiate
agreement
Create design
docs
Buffer
Develop project
plan
Transfer
documents
2

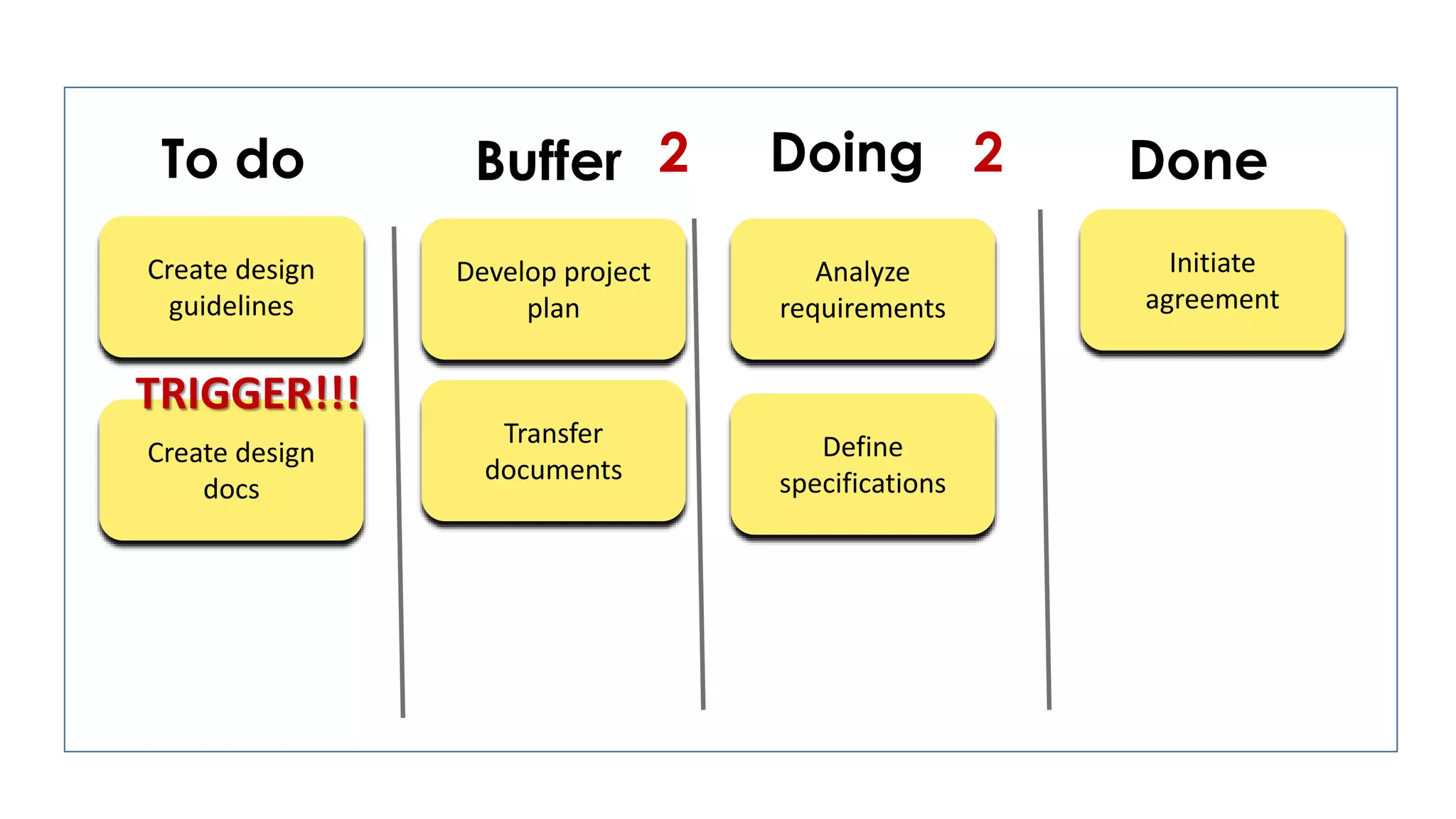

To do Doing Done
Analyze
requirements
Define
specifications
Create design
guidelines
Initiate
agreement
Create design
docs
Buffer
Develop project
plan
Transfer
documents
22
To do Doing Done
Analyze
requirements
Define
specifications
Create design
guidelines
Initiate
agreement
Create design
docs
Buffer
Develop project
plan
Transfer
documents
22
TRIGGER!!!

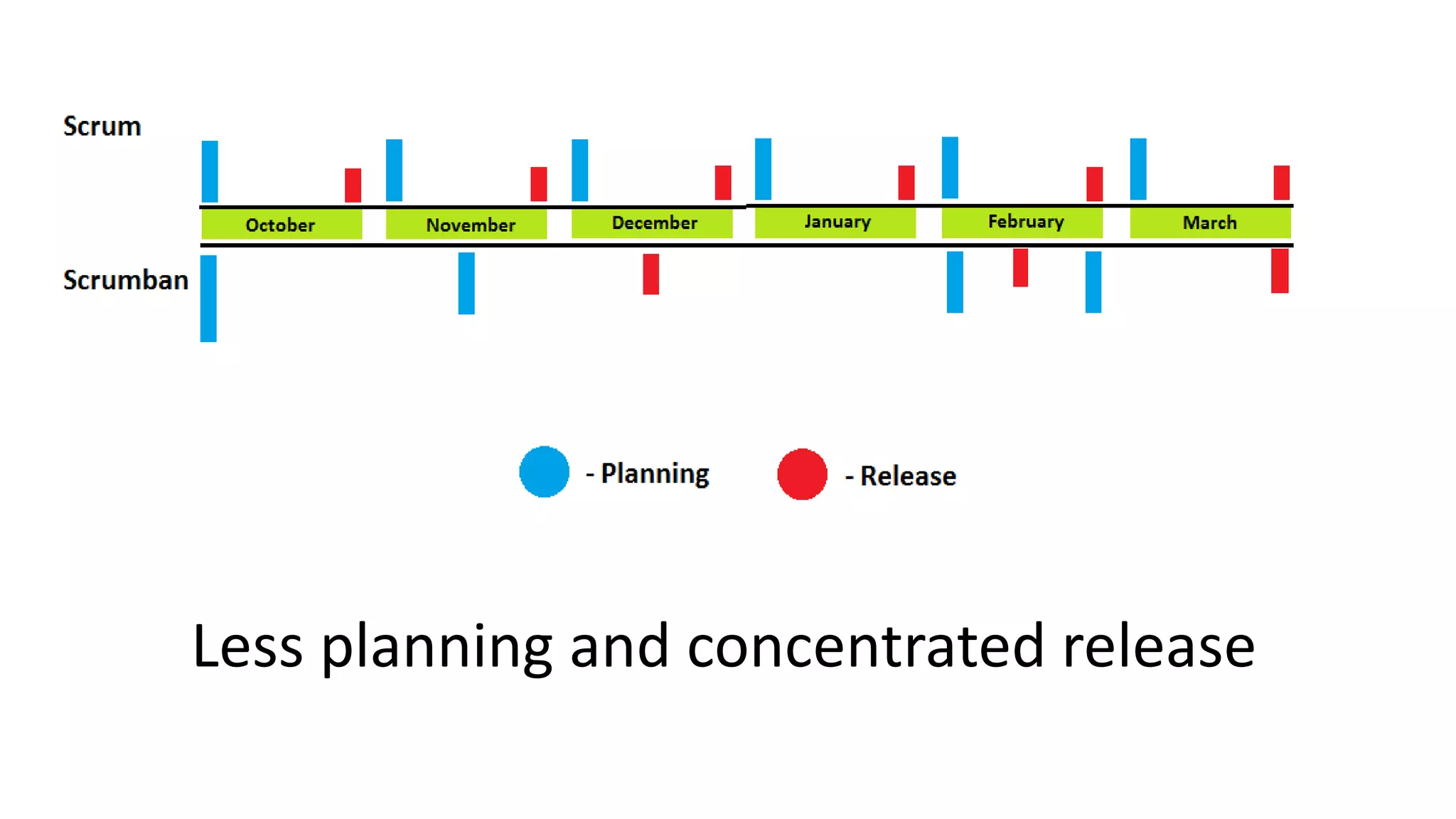

Less planning and concentrated release

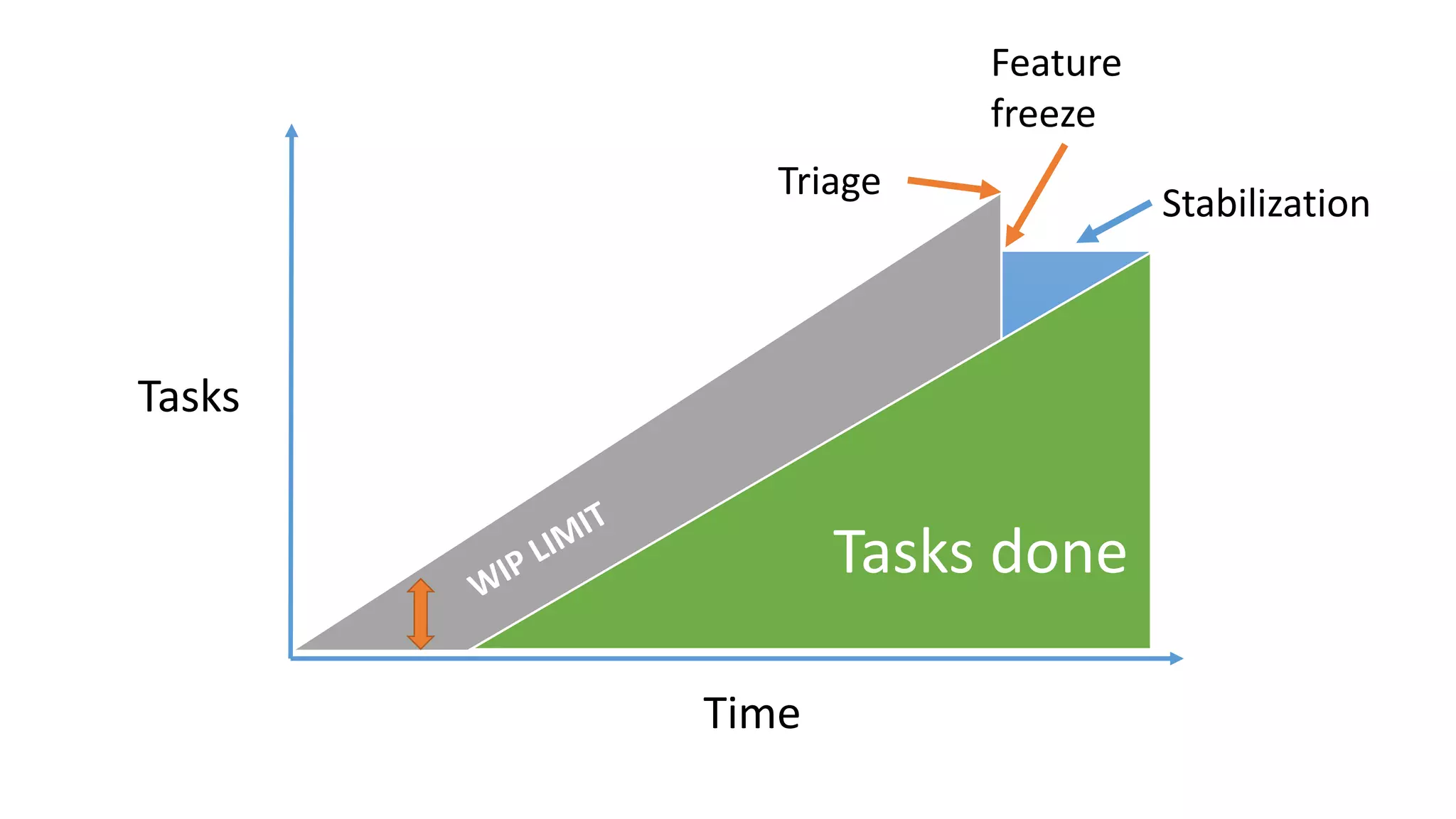

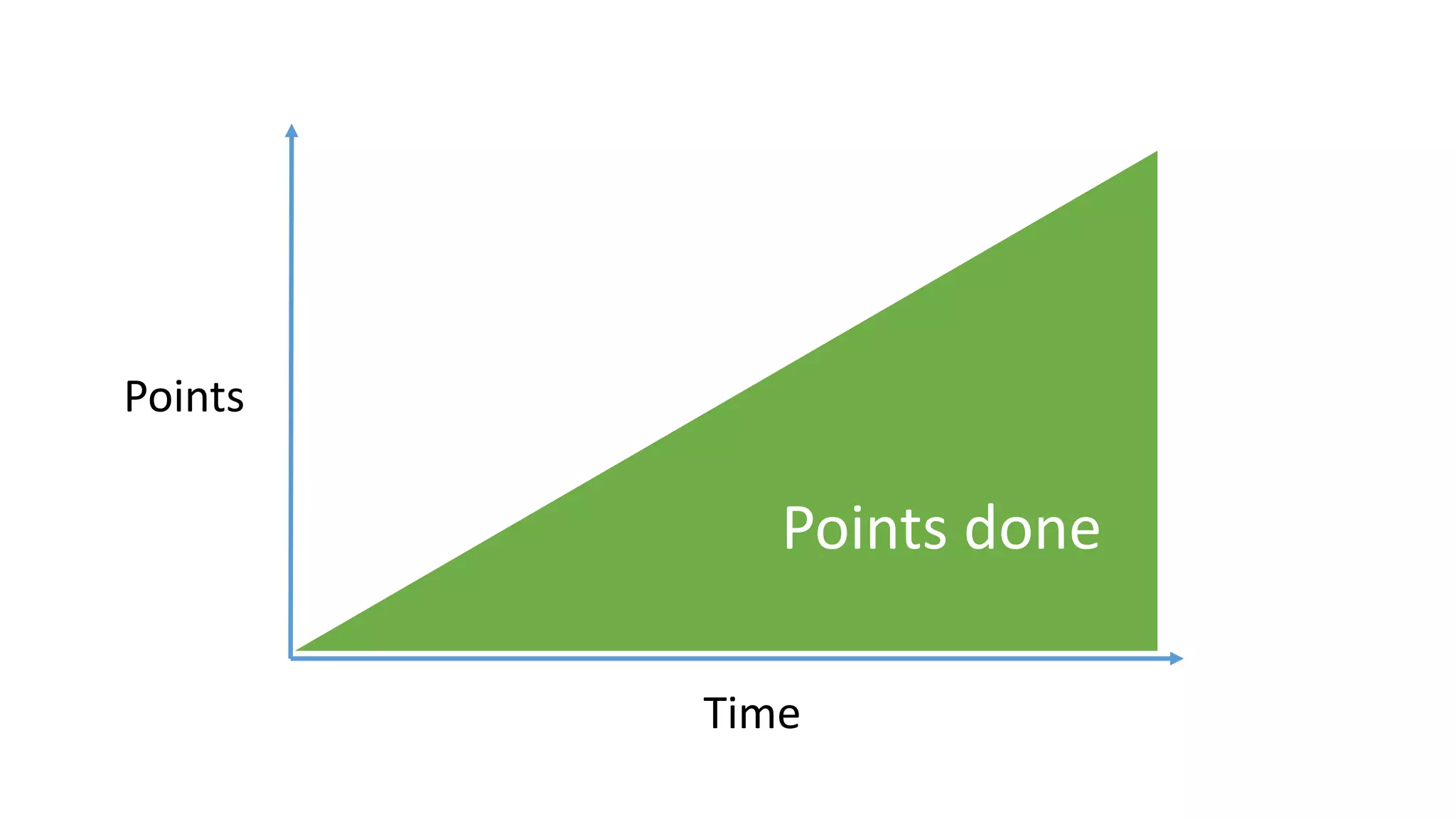

Points done
Time
Points

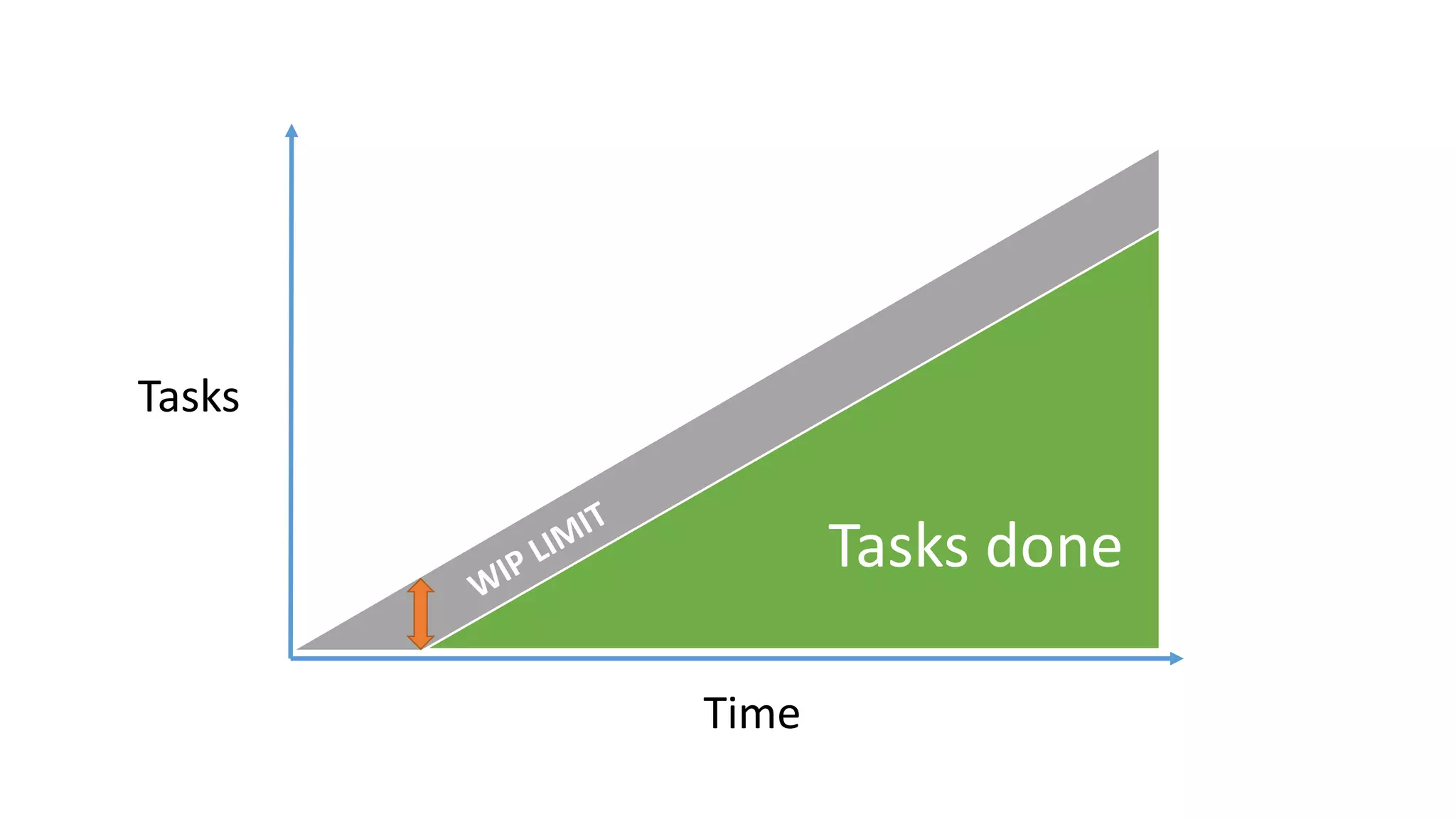

Items done
Time
Tasks
Tasks done
Time
Tasks
Tasks done
Feature
freeze
Triage
Stabilization
Estimating is easy…

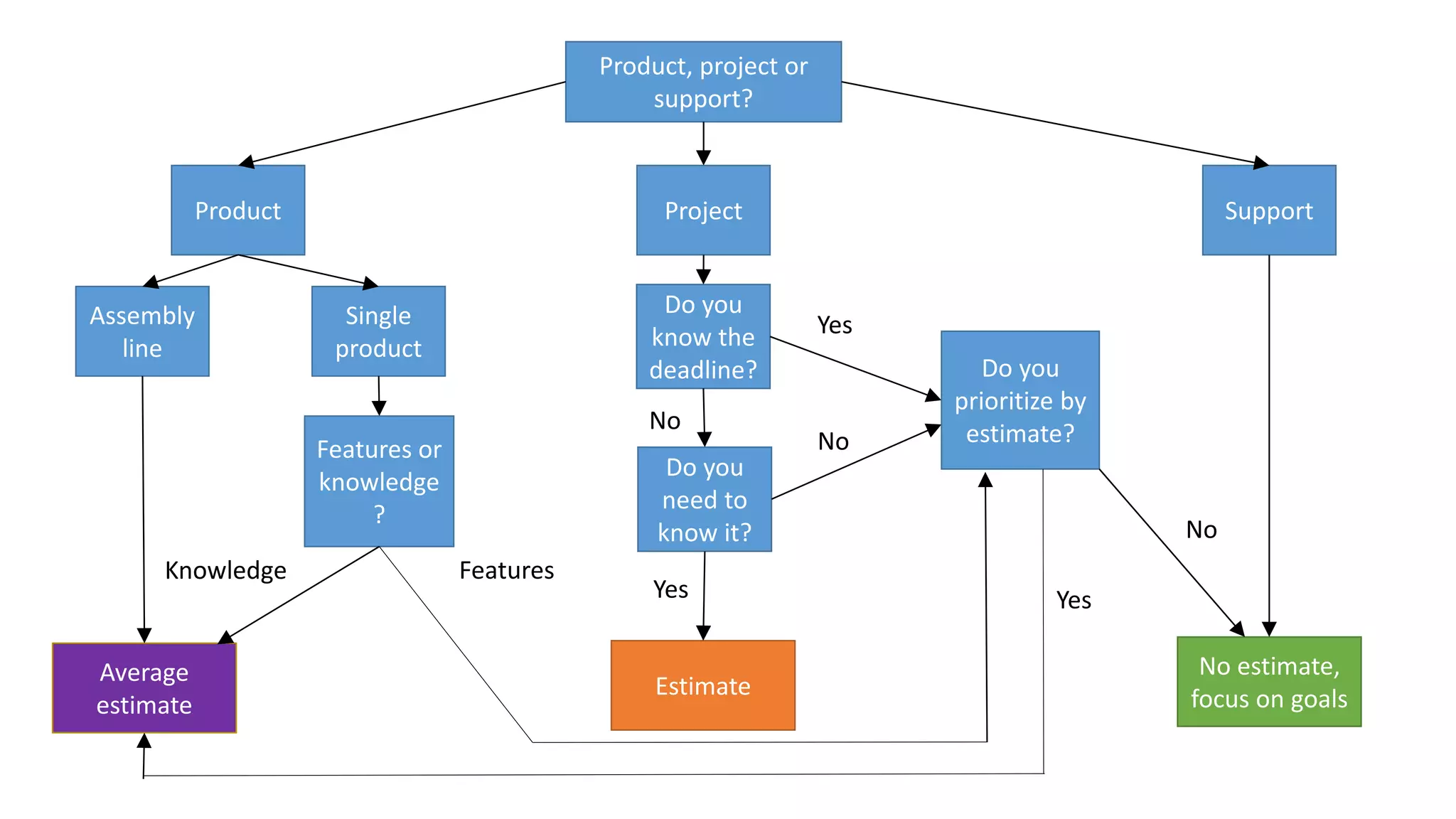

Product, project or
support?
Product Project Support
Assembly
line
Single
product
Do you
know the
deadline?
Estimate
No estimate,
focus on goals
Average
estimate
Features or
knowledge
?
FeaturesKnowledge
Do you
need to
know it?
Yes
No
Yes
No
Do you
prioritize by
estimate?
Yes
No

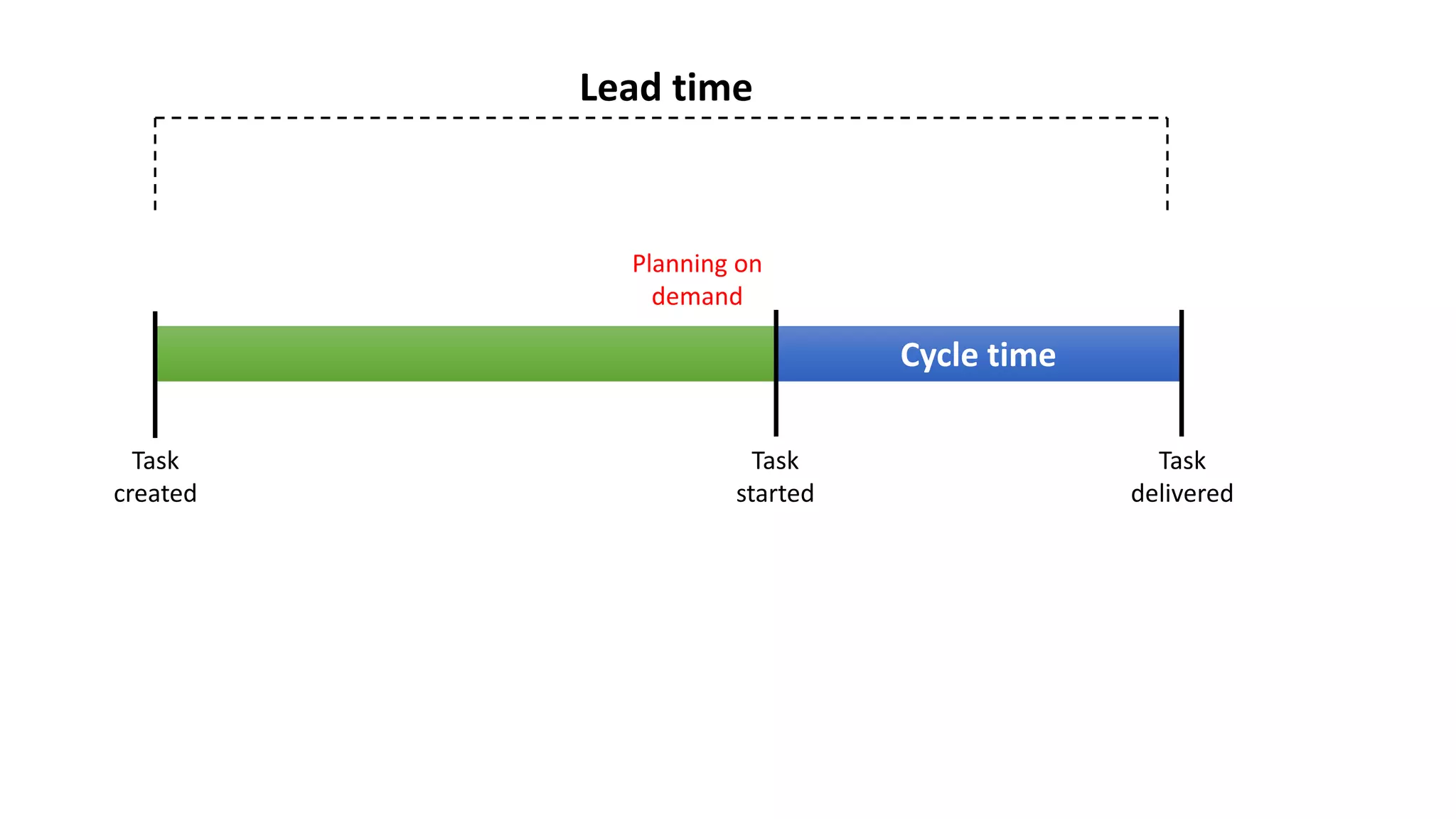

Task
created
Task
started
Task
delivered
Lead time
Planning on
demand
Cycle time

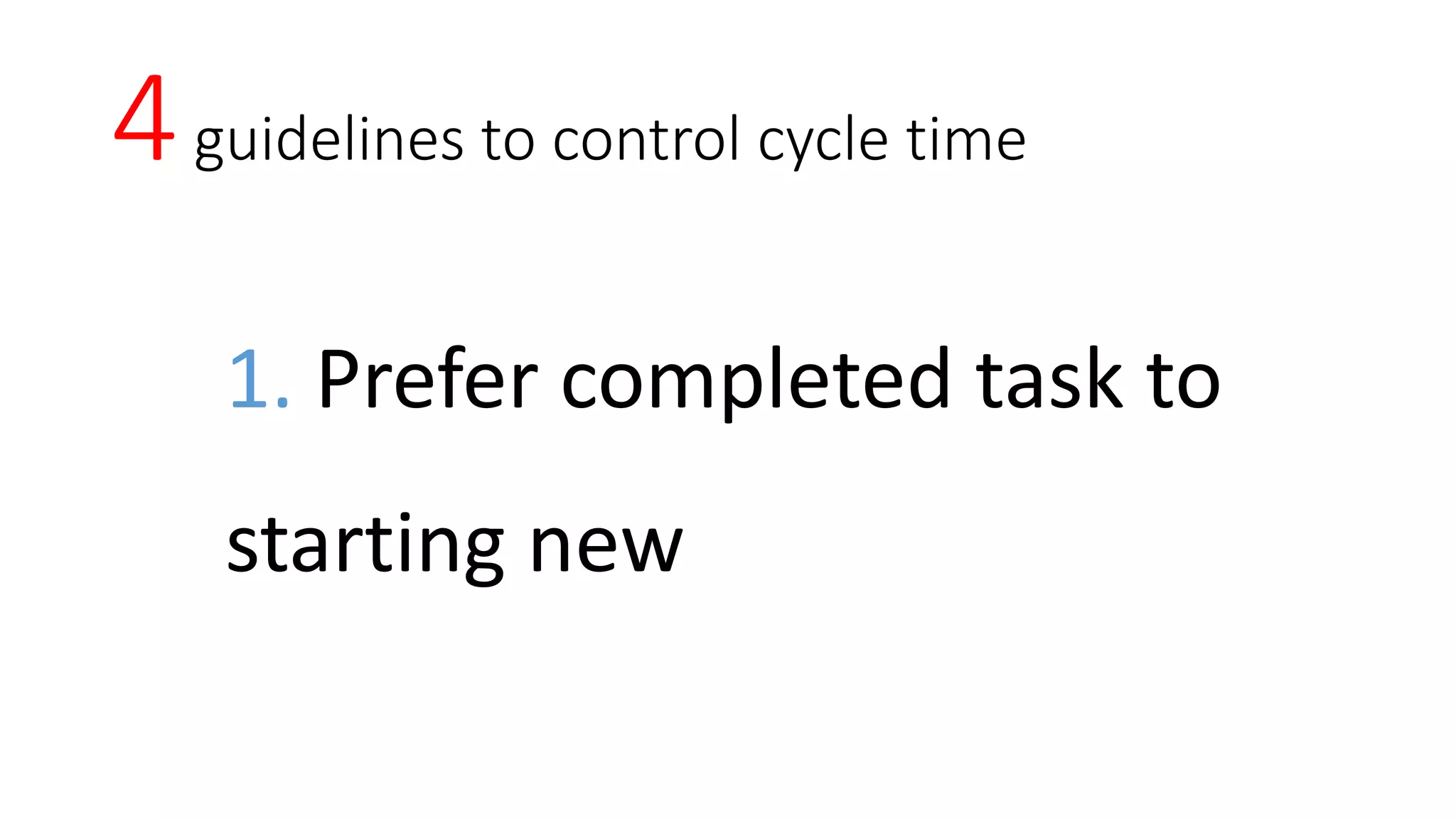

4guidelines to control cycle time
1. Prefer completed task to
starting new

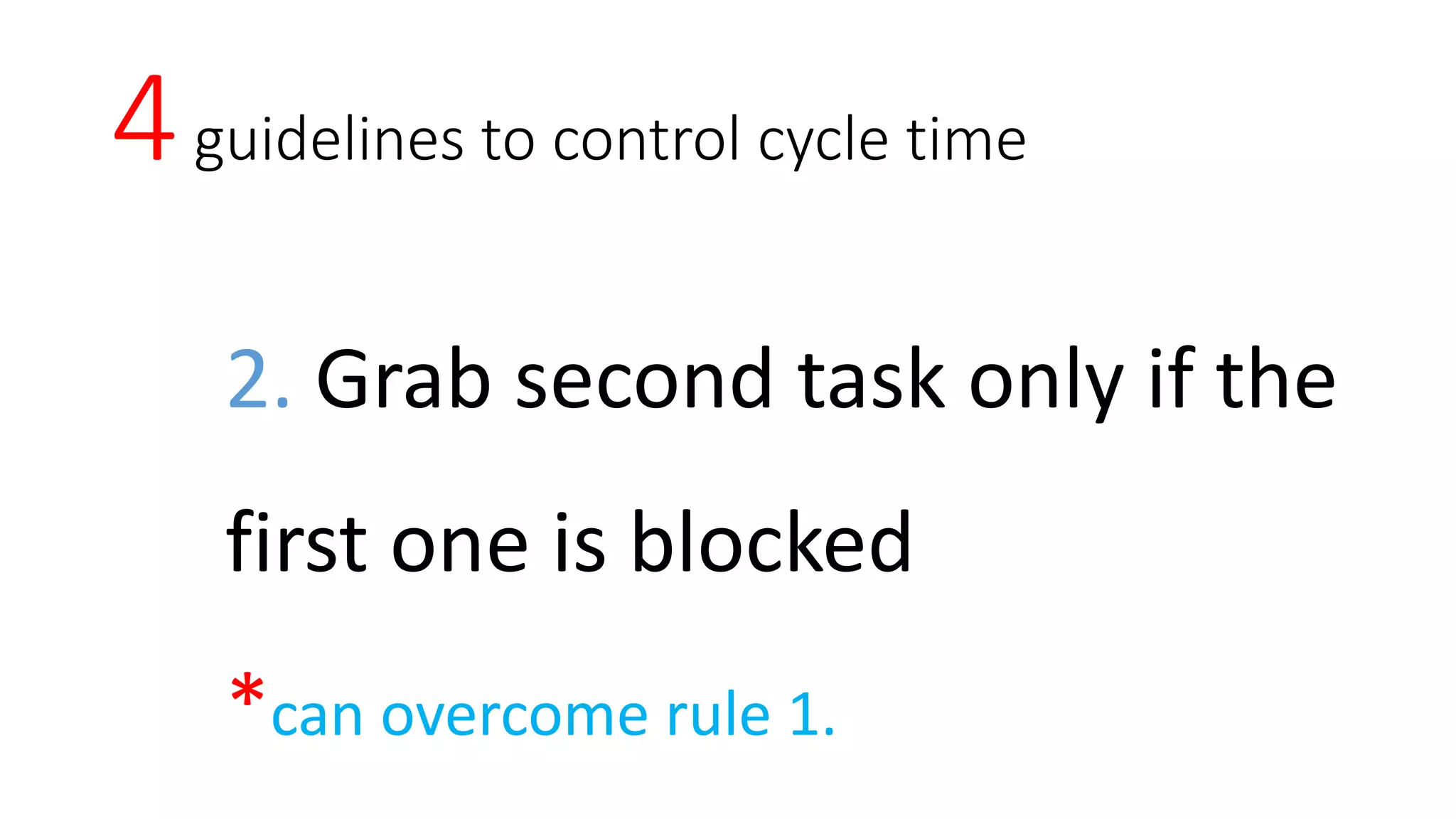

4guidelines to control cycle time
2. Grab second task only if the
first one is blocked
*can overcome rule 1.

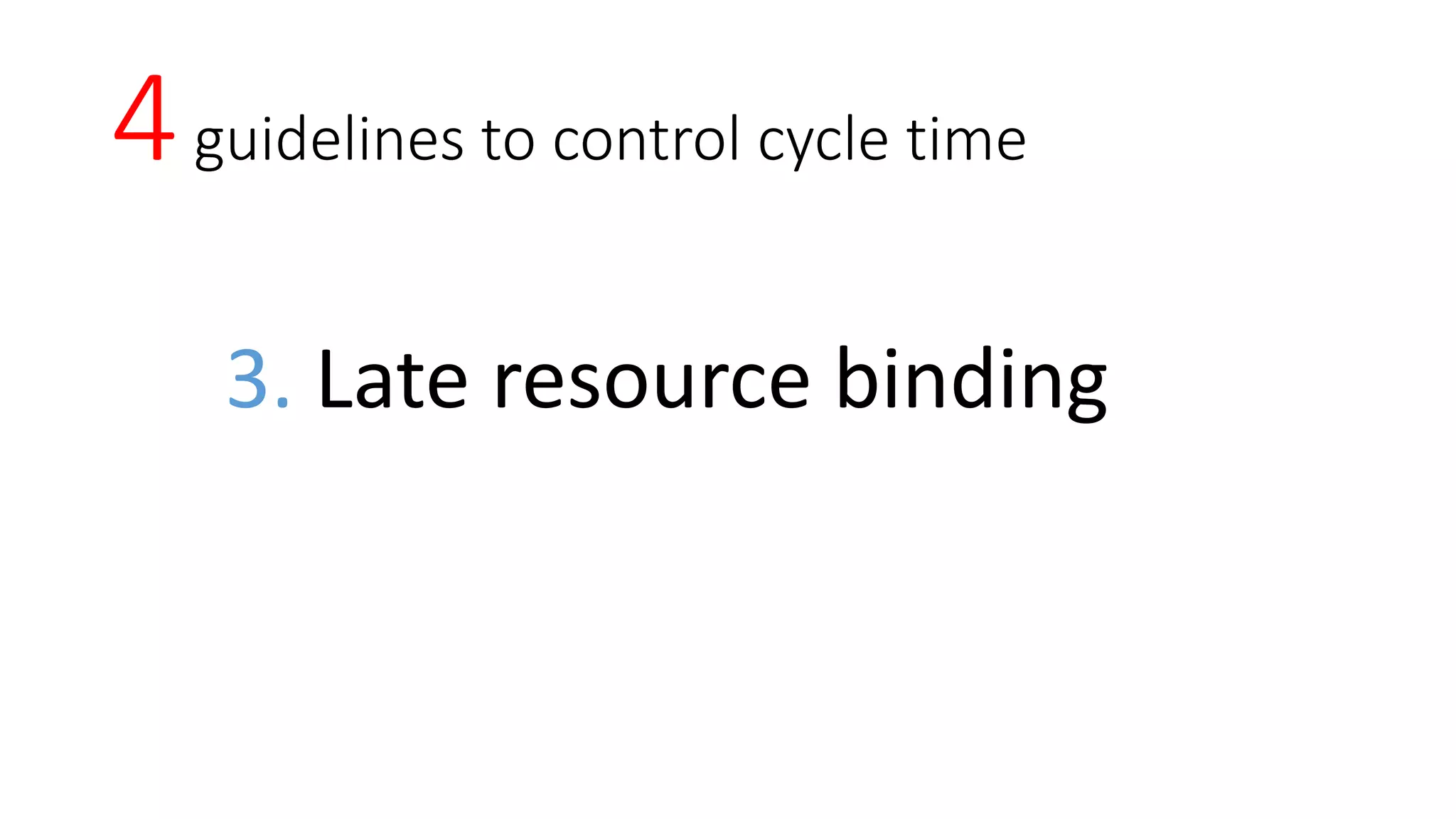

4guidelines to control cycle time
3. Late resource binding
4guidelines to control cycle time

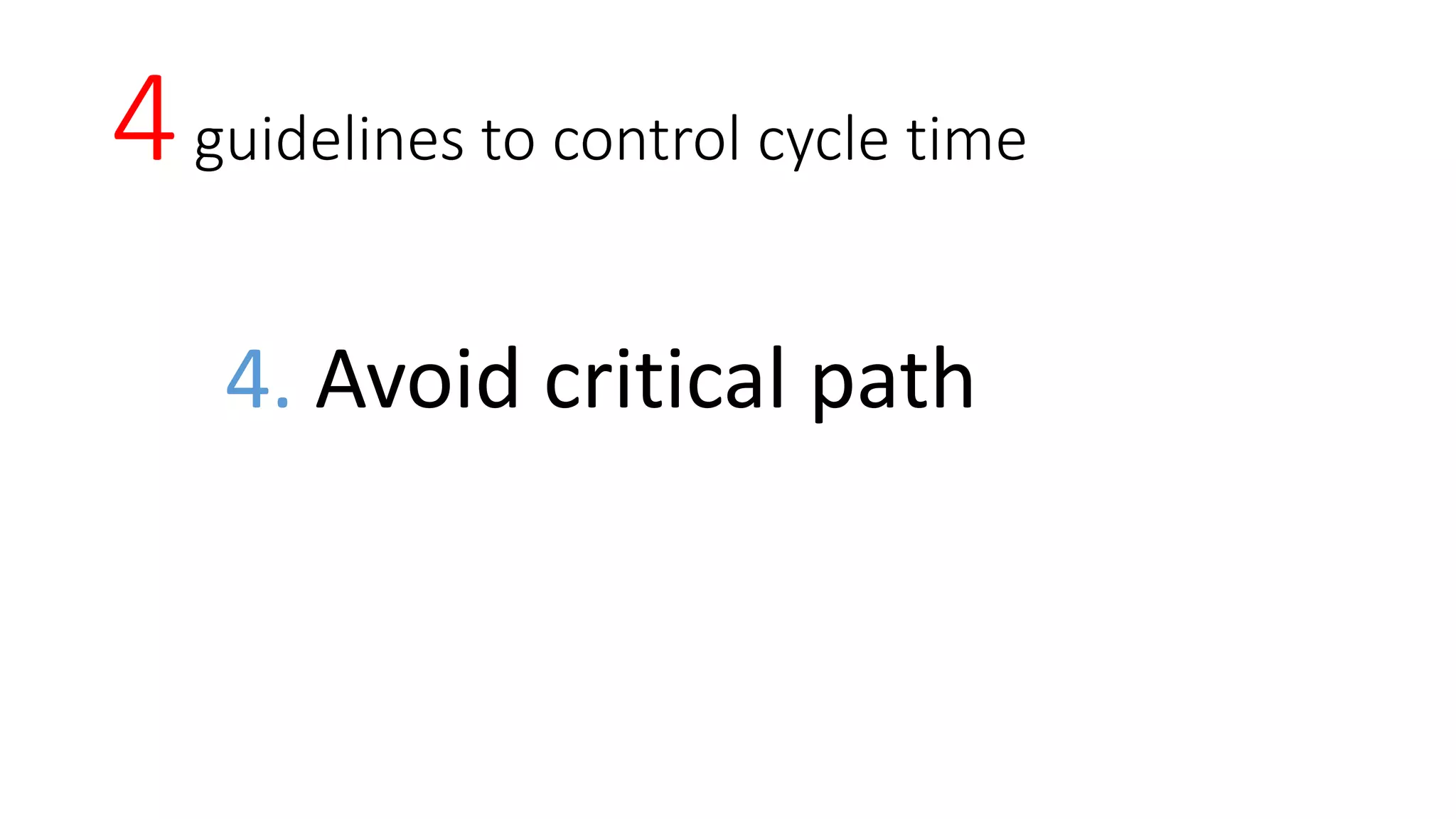

4. Avoid critical path
NO! To early binding
+STRESS
-ENERGY
-TIME

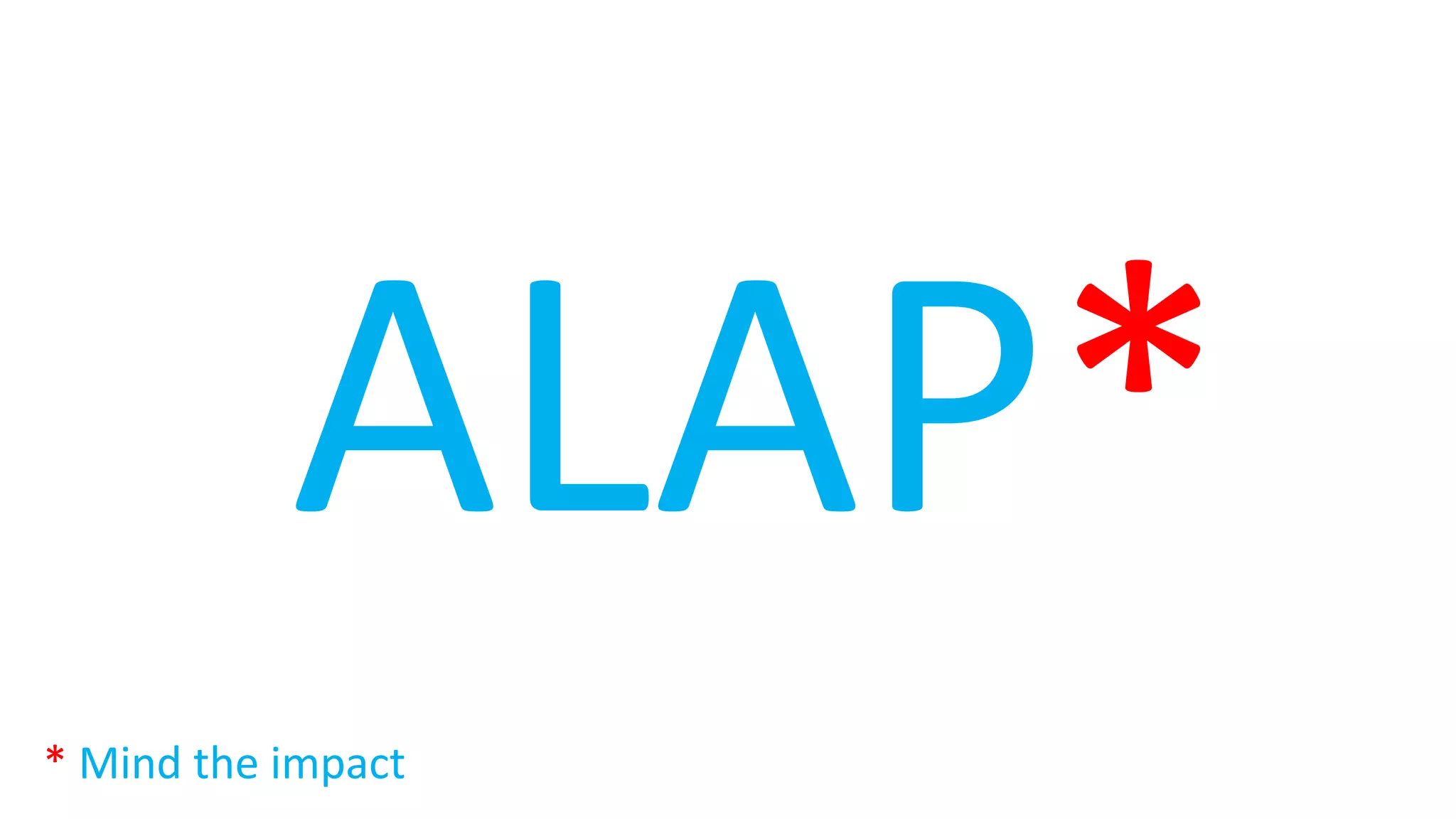

* Mind the impact
Push system Pull system

3kings to rule them all
Daily meeting
Planning meeting
(on demand)
Kaizen
Aligned vision

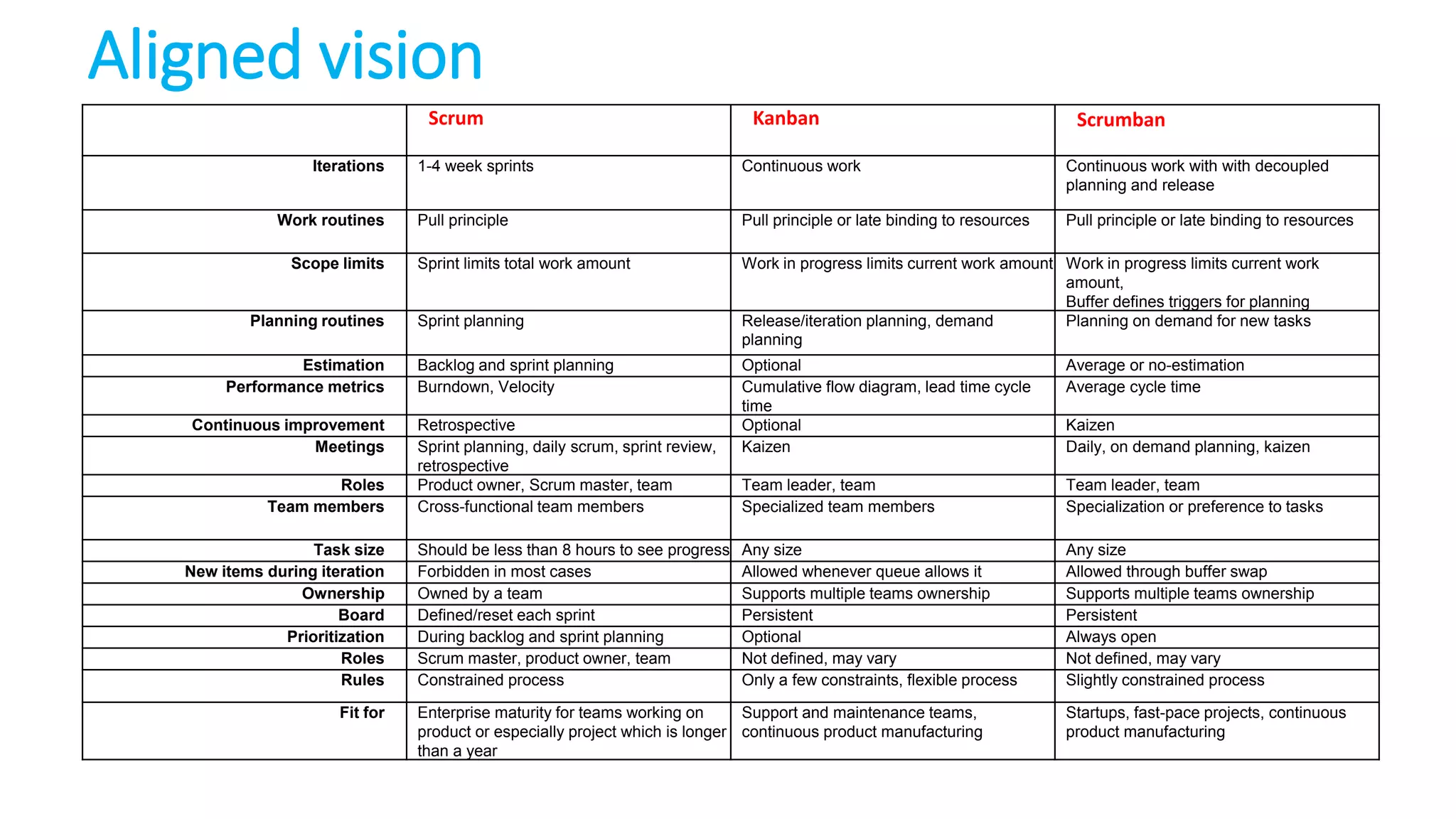

Scrum Kanban Scrumban
Iterations 1-4 week sprints Continuous work Continuous work with with decoupled
planning and release
Work routines Pull principle Pull principle or late binding to resources Pull principle or late binding to resources
Scope limits Sprint limits total work amount Work in progress limits current work amount Work in progress limits current work
amount,
Buffer defines triggers for planning
Planning routines Sprint planning Release/iteration planning, demand
planning
Planning on demand for new tasks
Estimation Backlog and sprint planning Optional Average or no-estimation
Performance metrics Burndown, Velocity Cumulative flow diagram, lead time cycle
time
Average cycle time
Continuous improvement Retrospective Optional Kaizen
Meetings Sprint planning, daily scrum, sprint review,
retrospective
Kaizen Daily, on demand planning, kaizen
Roles Product owner, Scrum master, team Team leader, team Team leader, team
Team members Cross-functional team members Specialized team members Specialization or preference to tasks
Task size Should be less than 8 hours to see progress Any size Any size
New items during iteration Forbidden in most cases Allowed whenever queue allows it Allowed through buffer swap
Ownership Owned by a team Supports multiple teams ownership Supports multiple teams ownership
Board Defined/reset each sprint Persistent Persistent
Prioritization During backlog and sprint planning Optional Always open
Roles Scrum master, product owner, team Not defined, may vary Not defined, may vary
Rules Constrained process Only a few constraints, flexible process Slightly constrained process
Fit for Enterprise maturity for teams working on
product or especially project which is longer
than a year
Support and maintenance teams,
continuous product manufacturing
Startups, fast-pace projects, continuous
product manufacturing
THANK YOU
