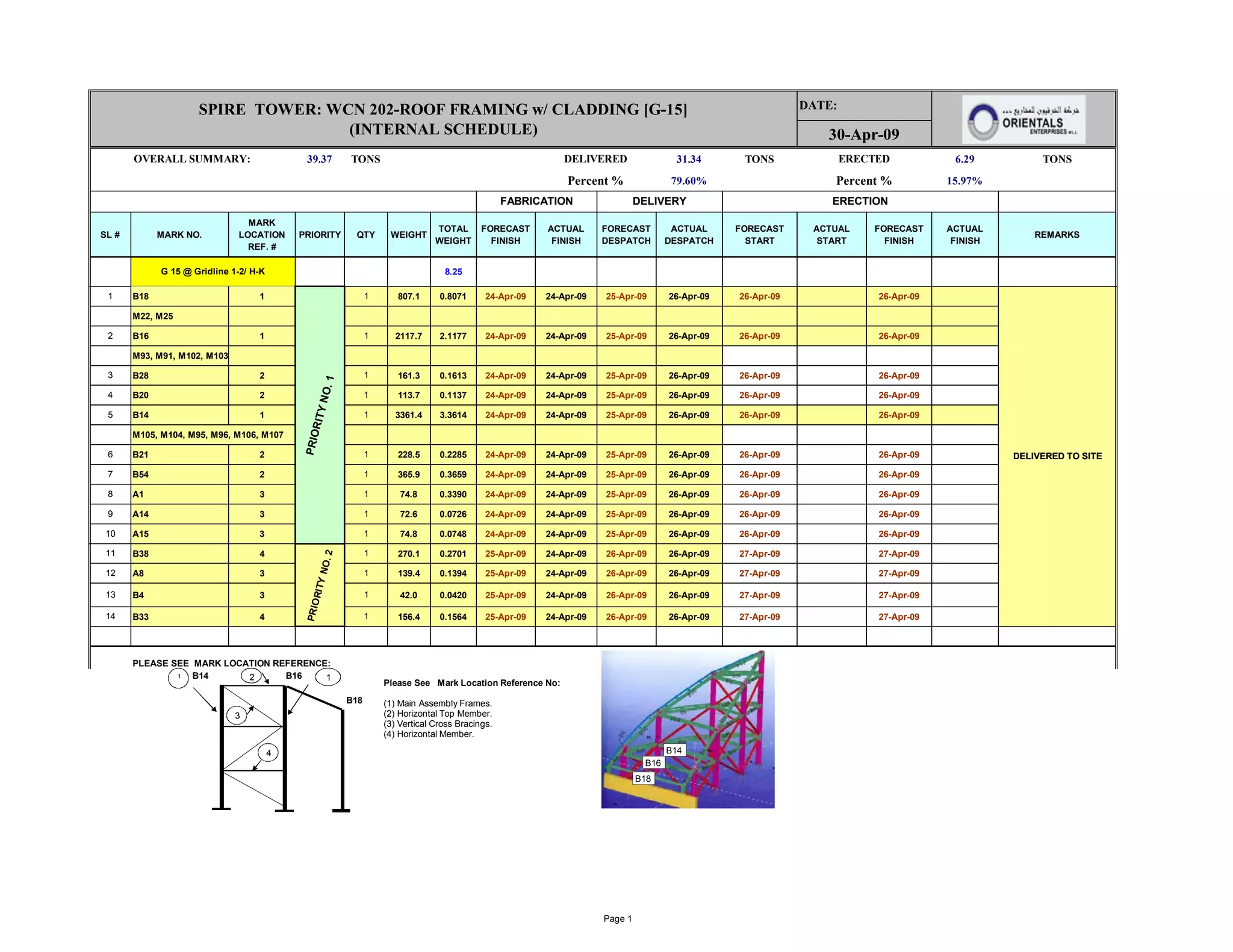

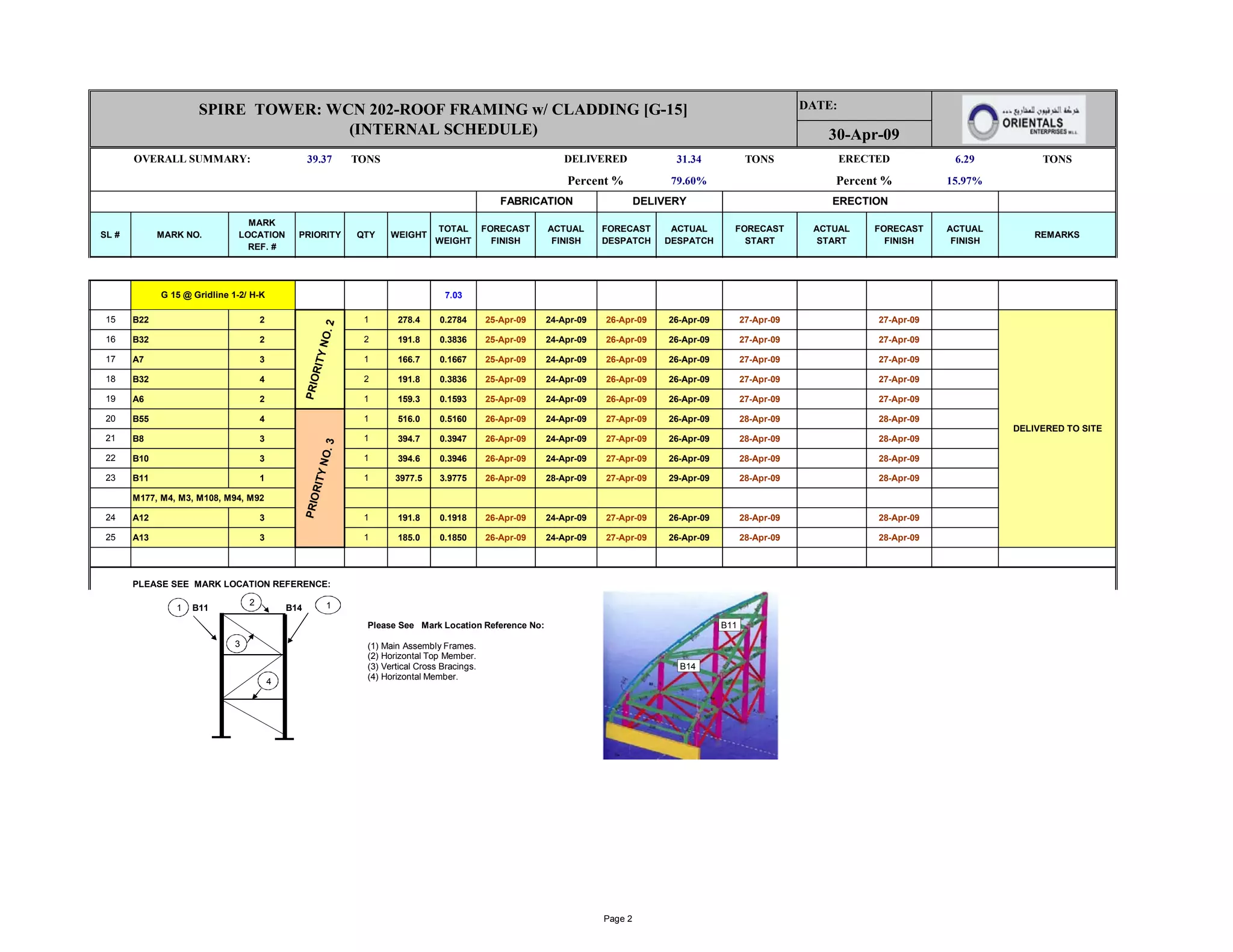

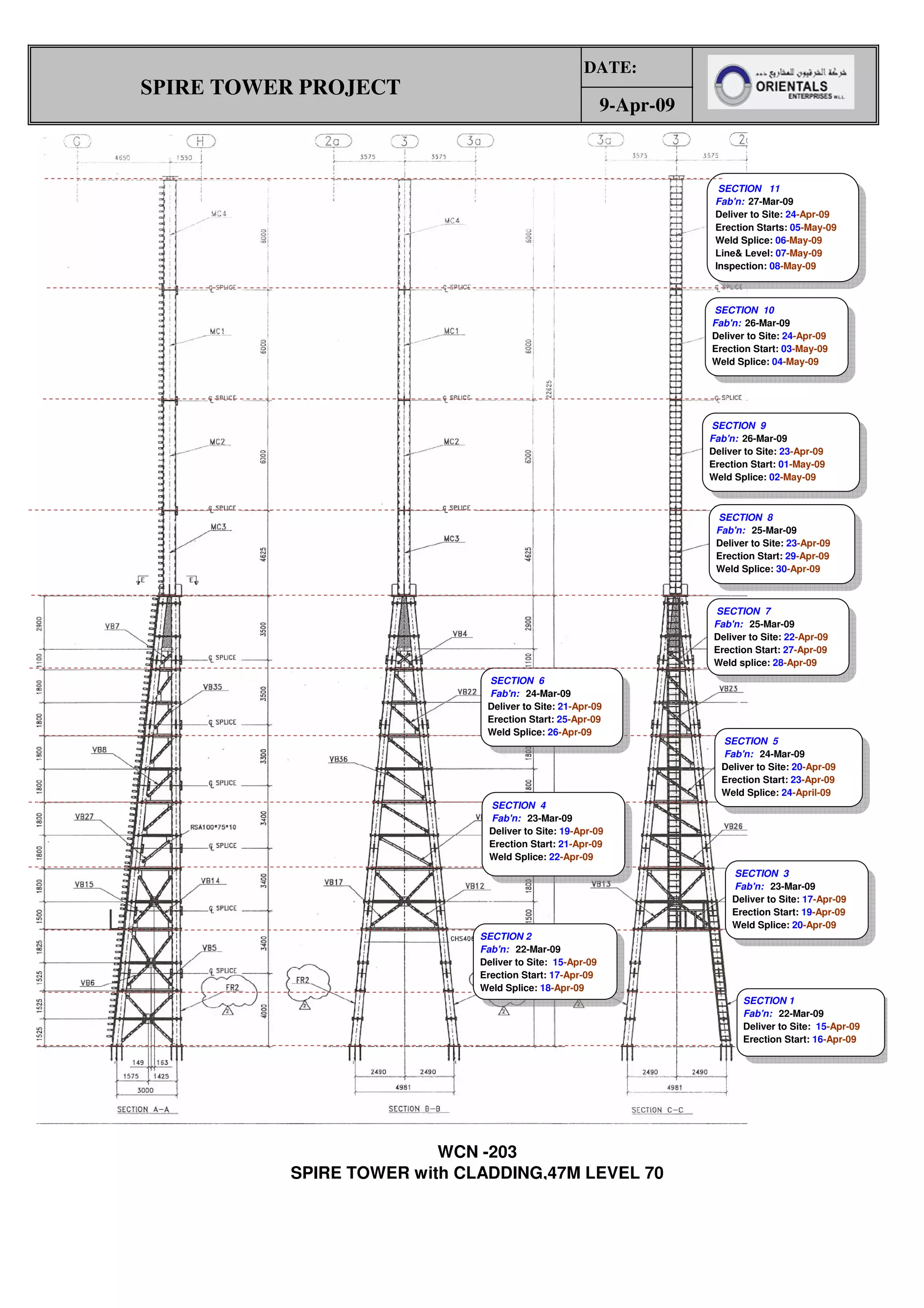

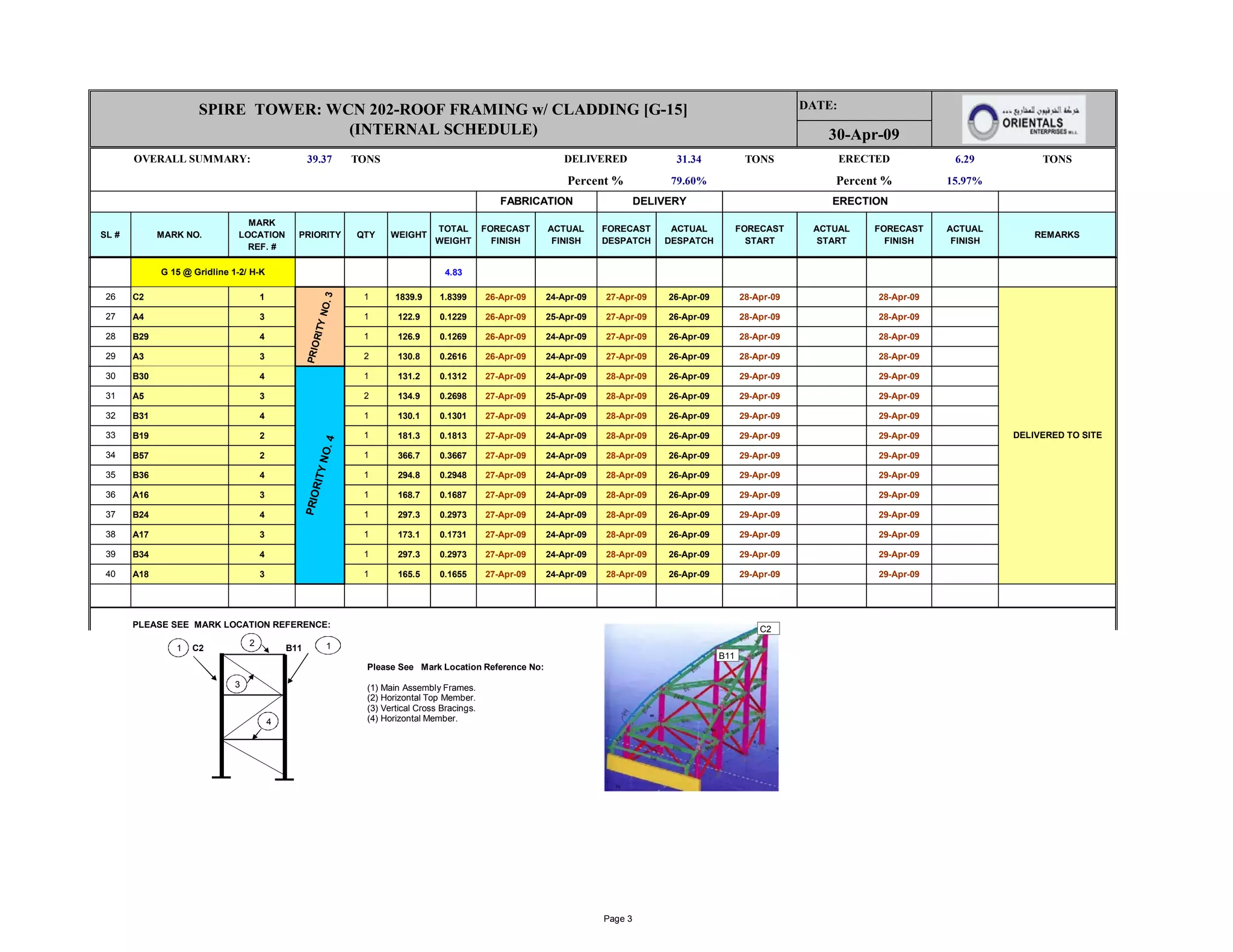

This document outlines the fabrication, delivery, erection, and inspection schedule for sections 1-11 of the Spire Tower project with cladding at the 47m level. Key details include:
- Sections 1-11 will be fabricated between March 22-27 and delivered to the site between April 15-24.
- Erection of each section will start 1-4 days after delivery and be completed through welding and inspection between April 16-May 8.
- The schedule provides specific dates for each stage of each section's completion to coordinate the multi-stage construction process.
In this document
Powered by AI
Detailed schedule and summary of components delivered and erected for the Spire Tower project, including weights, priorities, and dates.
Timeline for fabrication and delivery of various sections of the Spire Tower, including key dates and tasks.
