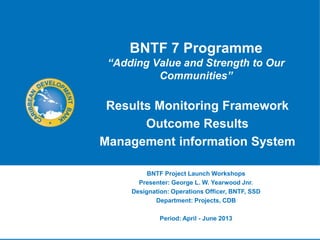

1. BNTF 7 Programme
“Adding Value and Strength to Our
Communities”

Results Monitoring Framework
Outcome Results
Management information System
BNTF Project Launch Workshops
Presenter: George L. W. Yearwood Jnr.
Designation: Operations Officer, BNTF, SSD
Department: Projects, CDB
Period: April - June 2013

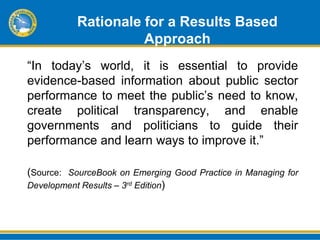

2. Rationale for a Results Based
Approach
“In today’s world, it is essential to provide
evidence-based information about public sector
performance to meet the public’s need to know,
create political transparency, and enable
governments and politicians to guide their
performance and learn ways to improve it.”
(Source: SourceBook on Emerging Good Practice in Managing for
Development Results – 3rd Edition)

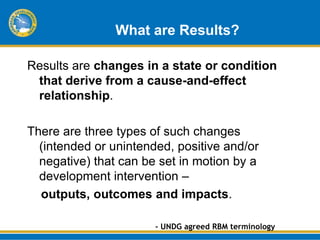

3. What are Results?
Results are changes in a state or condition
that derive from a cause-and-effect
relationship.
There are three types of such changes
(intended or unintended, positive and/or
negative) that can be set in motion by a
development intervention –
outputs, outcomes and impacts.
- UNDG agreed RBM terminology

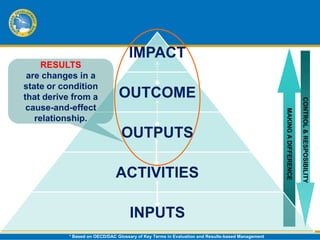

4. IMPACT
RESULTS
are changes in a
state or condition
that derive from a OUTCOME
CONTROL & RESPOSIBILITY
cause-and-effect
MAKING A DIFFERENCE
relationship.
OUTPUTS
ACTIVITIES
INPUTS
* Based on OECD/DAC Glossary of Key Terms in Evaluation and Results-based Management

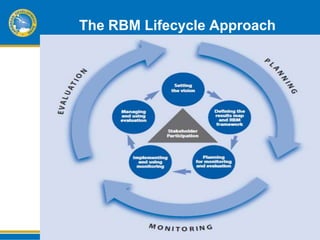

5. What is Results Based
Management?
• RBM is a management strategy by which all actors
ensure that their processes, products and
services contribute to the achievement of desired
results (outputs, outcomes and higher level goals
or impact)
• A key component of RBM is performance monitoring
which is to objectively measure how well results are
being achieved, and report on measures taken to
improve them.

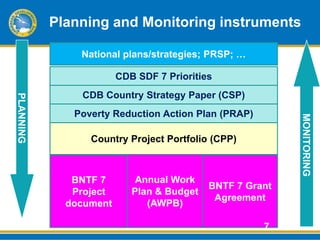

7. Planning and Monitoring instruments
National plans/strategies; PRSP; …
CDB SDF 7 Priorities
CDB Country Strategy Paper (CSP)
PLANNING
Poverty Reduction Action Plan (PRAP)
MONITORING
Country Project Portfolio (CPP)
BNTF 7 Annual Work
BNTF 7 Grant
Project Plan & Budget
Agreement
document (AWPB)
7

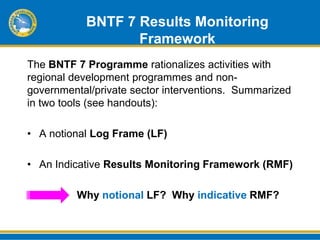

8. BNTF 7 Results Monitoring
Framework
The BNTF 7 Programme rationalizes activities with
regional development programmes and non-
governmental/private sector interventions. Summarized
in two tools (see handouts):
• A notional Log Frame (LF)
• An Indicative Results Monitoring Framework (RMF)
Why notional LF? Why indicative RMF?
9. BNTF 7 Results Monitoring
Framework
Overall BNTF 7 Programme LF and RMF
will be refined using contribution of:
– LF for each Project (BZE, DOM etc.) developed
as part of PRAP review & CPP development
– Output of CDB-funded regional TAs at start up
of BNTF 7.

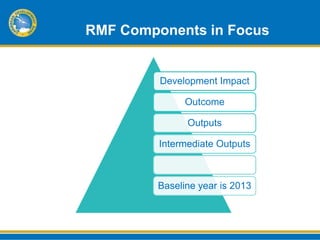

11. RMF Components in Focus
Development Impact
Outcome
Outputs
Intermediate Outputs
Baseline year is 2013

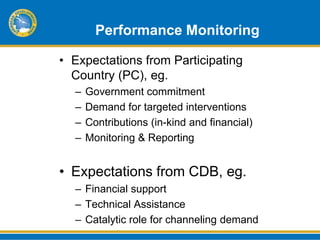

12. Performance Monitoring
• Expectations from Participating
Country (PC), eg.
– Government commitment
– Demand for targeted interventions
– Contributions (in-kind and financial)
– Monitoring & Reporting
• Expectations from CDB, eg.
– Financial support
– Technical Assistance
– Catalytic role for channeling demand

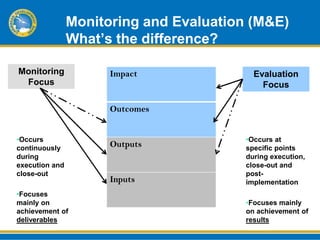

13. Monitoring and Evaluation (M&E)
What’s the difference?
Q
Monitoring Impact Evaluation
Focus Focus
Outcomes
•Occurs •Occurs at
continuously
Outputs specific points
during during execution,
execution and close-out and
close-out post-
Inputs implementation
•Focuses
mainly on •Focuses mainly
achievement of on achievement of
deliverables results

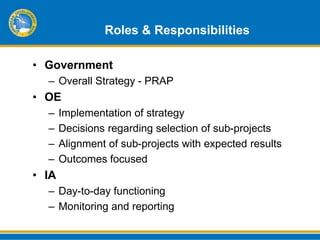

14. Roles & Responsibilities
• Government
– Overall Strategy - PRAP
• OE
– Implementation of strategy
– Decisions regarding selection of sub-projects
– Alignment of sub-projects with expected results
– Outcomes focused
• IA
– Day-to-day functioning
– Monitoring and reporting
16. Implications for Operations
• Closer collaboration with ministries’ and
agencies’ with BNTF Project.
• Clearer understanding of contribution to
– National sector priorities
– CDB Strategic Objectives
• Shared decision-making – at CDB and
at country level.

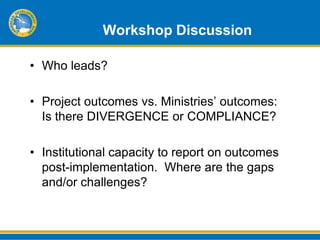

17. Workshop Discussion
• Who leads?
• Project outcomes vs. Ministries’ outcomes:
Is there DIVERGENCE or COMPLIANCE?
• Institutional capacity to report on outcomes
post-implementation. Where are the gaps
and/or challenges?

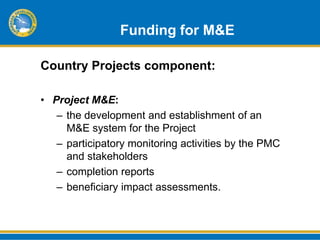

18. Funding for M&E
Country Projects component:
• Project M&E:
– the development and establishment of an
M&E system for the Project
– participatory monitoring activities by the PMC
and stakeholders
– completion reports
– beneficiary impact assessments.

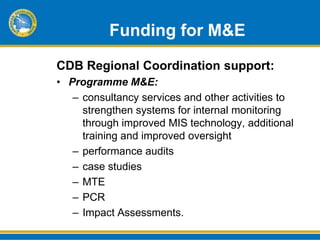

19. Funding for M&E
CDB Regional Coordination support:
• Programme M&E:
– consultancy services and other activities to
strengthen systems for internal monitoring
through improved MIS technology, additional
training and improved oversight
– performance audits
– case studies
– MTE
– PCR
– Impact Assessments.
20. The BNTF MIS
BNTF Interim Electronic
Management Information System
(MIS) Solution

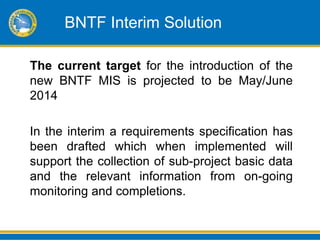

21. BNTF Interim Solution
The current target for the introduction of the
new BNTF MIS is projected to be May/June
2014
In the interim a requirements specification has
been drafted which when implemented will
support the collection of sub-project basic data
and the relevant information from on-going
monitoring and completions.
22. BNTF Interim Solution
The proposed interim solution will be built
on the principle of the SPMR and SPCR
forms which were used for National MfDR
training in Q1/Q2, 2010.
The solution will cater for capturing the
outputs and initial outcomes for respective
sectors using data from the RMF.
23. BNTF Interim Solution
Technology to be deployed:
• Web based
• Remote country office access across the
internet
• Centralized database
• Secured access with access to country
specific sub-projects
• Knowledge base
Projected delivery: July 2013 (estimated)
24. Thank You!
George L. W. Yearwood Jnr.
Operations Officer, SSD, Projects
Direct: (246) 431-1739
Skype: yearwog
yearwog@caribank.org
Editor's Notes
The Third Edition of the Sourcebook on Emerging Good Practice in Managing for Development Results – World Bank publication Managing for Development Results (MfDR) is about achieving the results of development initiatives and can have dramatic impacts on people’s lives. MfDR, as a concept, centers on holding international agencies, governments and individuals accountable for delivering results to the citizens they seek to assist. Ultimately, managing for results should lead to a sustainable improvement in country development outcomes through country systems. In today’s world, it is essential to provide evidence-based information about public sector performance to meet the public’s need to know, create political transparency, and enable governments and politicians to guide their performance and learn ways to improve it.
Want to avoid the linear view of RBM. Starting point is two-fold: Where we are now (lessons learnt, evaluation findings, SWOT analysis, feedback from other units/RBx, etc)Where we want to be in the future (i.e., the type of organisation we want to be, the way in which we want to meet the needs of our main stakeholders, and the quality and effectiveness of our services)Emphasize – setting aside enough time to plan to monitor, evaluate etc
Simplified results matrix: conflate the two outcome levels into one, with emphasis on strategic but specific enough to country context. Number of priorities & outcomes are optional.
The BNTF Programme will strive to rationalize activities with regional development programmes and non-governmental/private sector interventions. A notional Logical Framework Analysis (LFA) for the Programme is presented at Table 4.1. This will be refined on completion of the M&E framework as part of the start-up activities during the preparatory phase of the Programme. A LFA for each Project will be developed in each PC as part of the PRAP.
The establishment of specific accountability for tracking and reporting within IAs & by CDB. Intended to emphasize the importance of the collection of baseline data, and ongoing reporting on performance indicators related to outputs and outcomes throughout the project cycle.Results Management and Results Frameworks:The requirements and anticipated arrangement for results monitoring and reporting of BNTF 7 are aligned with the LFA at Table 4.1, and the establishment of an improved MIS and specific accountability for tracking and reporting within IAs. These are intended to emphasize the importance of the collection of baseline data, and ongoing reporting on performance indicators related to outputs and outcomes throughout the project cycle. Appendix 4.4 contains details of the indicative Results Monitoring Framework (RMF), including monitoring and notional performance indicators for specific sector and cross-cutting interventions. These will be developed in greater detail in the preparatory phase of the Programme. The Annual Work Plan and Budget will be drafted by November of each year and will specify the activities to be undertaken in the following year, the expected output and budgeted costs on which expenditure will be based. Annual Project Performance Reports will enable CDB staff to assess the performance of the Projects in relation to monitoring indicators. As the RMF indicates, provisions will be made for an MTE and a PCR at Project closing. Independent consultants will be contracted by CDB to conduct the MTE which will be scheduled to allow the recommendations made for enhancing the achievements of BNTF 7 to be implemented within the remaining period of the Programme. A M&E System and Impact Assessment Model will be developed to provide quantitative and qualitative information on performance of the Programme as a whole and the Country Projects. The Draft TOR for the development of a M&E System and Impact Assessment Model is at Appendix 4.5.A Participatory Community M&E is expected to identify the effects on the target beneficiaries with regard to primary welfare, social dynamics, governance, targeting and comparative effectiveness and the sustainability of programme results. The Draft TOR is at Appendix 4.6.
RBM Hand-OutPC must agree on: Development ImpactProject Outcome; and
Develop a new BNTF MIS to provide a closer fit through the use of current technology providing web-based services and the use of workflow to bring symmetry to BNTFOs and increase the collaboration and information-sharing opportunities. The coherent focus on M&E from the early stage of the PRAP development to the stages of sub-project completion will lend support to results reporting.
A M&E System and Impact Assessment Model will be developed to provide quantitative and qualitative information on performance of the Programme as a whole and each Country Project. A Participatory Community M&E to identify the effects on the target beneficiaries with regard to primary welfare, social dynamics, governance, targeting and comparative effectiveness and the sustainability of Programme results.
BNTF 7 M&E activities will enable assessments of outcomes and impacts at the overall Programme and Country Project level, with emphasis on the shared responsibility for sub-projects’ performance and development results. Monitoring activities include: community participatory monitoring; implementation monitoring; financial supervision and audits; and CDB supervision. The role of the IAs and line ministries in the contribution of ongoing data for performance management is critical. The IAs will support the new MIS which is an essential tool for the capture of all project information required for management decision-making. It is the repository of information required for reporting on key performance and development outcomes. The specifics of the M&E requirements of the Programme, including baseline collection, review of notional LFA and indicative RMF to establish performance indicators and targets, as well as costs, roles and responsibilities will be developed in the start-up period. An Impact Assessment will be designed at the start of the Programme and implemented over the Programme cycle. It is expected to identify the effects on the target beneficiaries with regard to primary welfare, social dynamics, governance, targeting and comparative effectiveness and the sustainability of Programme results. Beneficiary Assessments will also form part of project completion activities. The Programme and Project Reporting Schedule is at Appendix 4.16.
Programme Funding:Country Projects component:Project M&E: the development and establishment of an M&E system for the Project; participatory monitoring activities by the PMC and stakeholders; completion reports; and beneficiary impact assessments. Regional Coordination component:Programme M&E: consultancy services and other activities to strengthen systems for internal monitoring through improved MIS technology, additional training and improved oversight. Support will be provided for performance audits; case studies; PCR; MTE; and Impact Assessments.
Programme Funding:Country Projects component:Project M&E: the development and establishment of an M&E system for the Project; participatory monitoring activities by the PMC and stakeholders; completion reports; and beneficiary impact assessments. Regional Coordination component:Programme M&E: consultancy services and other activities to strengthen systems for internal monitoring through improved MIS technology, additional training and improved oversight. Support will be provided for performance audits; case studies; PCR; MTE; and Impact Assessments.
