PROJECT OVERVIEW

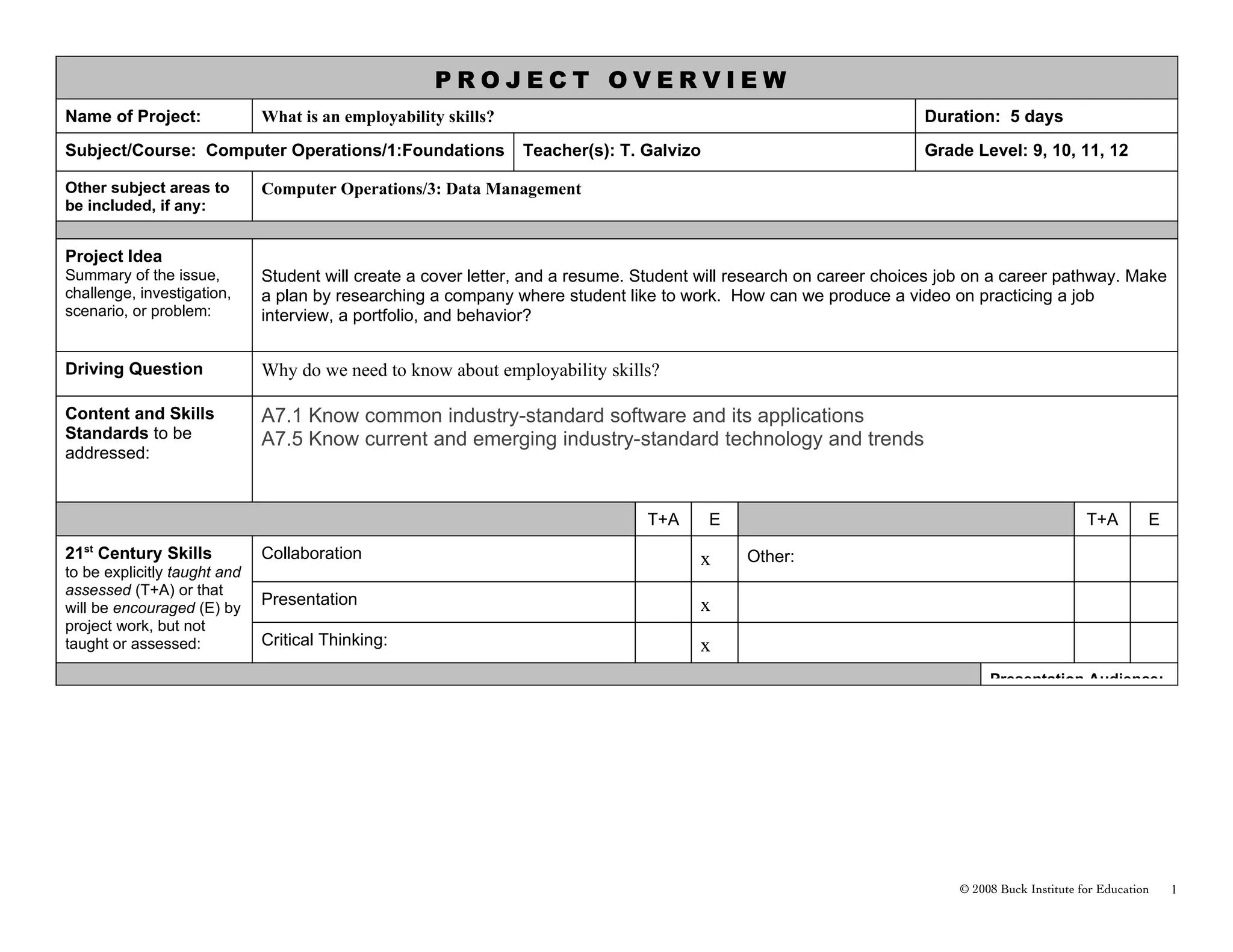

Name of Project:              What is an employability skills?                                                       Duration: 5 days
Subject/Course: Computer Operations/1:Foundations                Teacher(s): T. Galvizo                              Grade Level: 9, 10, 11, 12

Other subject areas to        Computer Operations/3: Data Management
be included, if any:


Project Idea
Summary of the issue,         Student will create a cover letter, and a resume. Student will research on career choices job on a career pathway. Make
challenge, investigation,     a plan by researching a company where student like to work. How can we produce a video on practicing a job
scenario, or problem:         interview, a portfolio, and behavior?


Driving Question              Why do we need to know about employability skills?

Content and Skills            A7.1 Know common industry-standard software and its applications
Standards to be               A7.5 Know current and emerging industry-standard technology and trends
addressed:


                                                                                T+A       E                                                     T+A        E
21st Century Skills           Collaboration                                            x      Other:
to be explicitly taught and
assessed (T+A) or that
will be encouraged (E) by
                              Presentation                                             x
project work, but not
taught or assessed:           Critical Thinking:                                       x
                                                                                                                              Presentation Audience:




                                                                                                                         © 2008 Buck Institute for Education   1

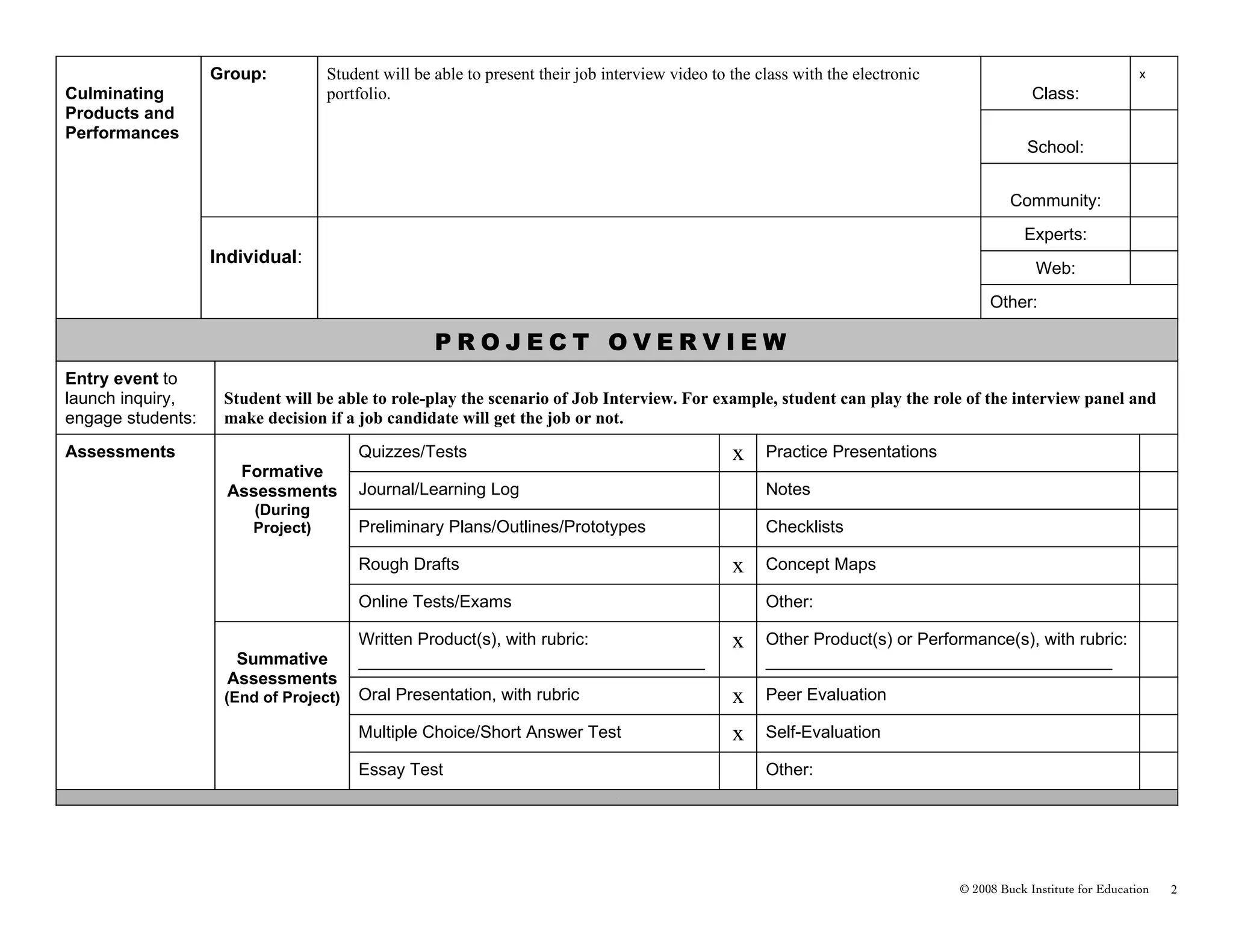

Group:          Student will be able to present their job interview video to the class with the electronic                                    x
Culminating                        portfolio.                                                                                                Class:
Products and
Performances
                                                                                                                                            School:


                                                                                                                                         Community:
                                                                                                                                           Experts:
                   Individual:
                                                                                                                                              Web:
                                                                                                                                     Other:

                                                   PROJECT OVERVIEW
Entry event to
launch inquiry,     Student will be able to role-play the scenario of Job Interview. For example, student can play the role of the interview panel and
engage students:    make decision if a job candidate will get the job or not.
Assessments                            Quizzes/Tests                                            x    Practice Presentations
                      Formative
                     Assessments       Journal/Learning Log                                          Notes
                        (During
                        Project)       Preliminary Plans/Outlines/Prototypes                         Checklists

                                       Rough Drafts                                             x    Concept Maps

                                       Online Tests/Exams                                            Other:

                                       Written Product(s), with rubric:                         x    Other Product(s) or Performance(s), with rubric:
                      Summative        __________________________________________________            __________________________________________________
                     Assessments
                    (End of Project)   Oral Presentation, with rubric                           x    Peer Evaluation

                                       Multiple Choice/Short Answer Test                        x    Self-Evaluation

                                       Essay Test                                                    Other:
                                                                              .




                                                                                                                                © 2008 Buck Institute for Education   2

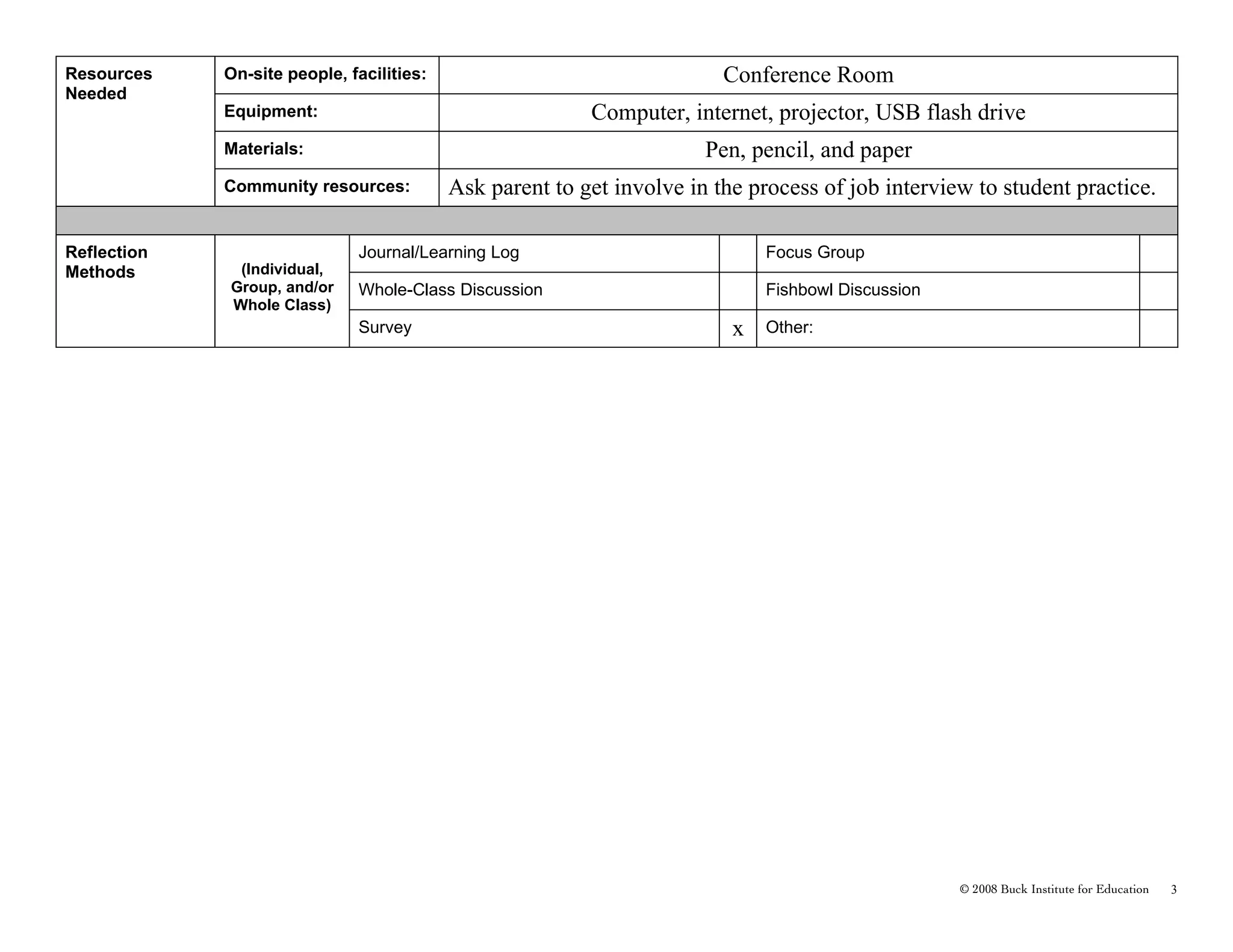

Resources    On-site people, facilities:                                 Conference Room
Needed
             Equipment:                                   Computer, internet, projector, USB flash drive
             Materials:                                                Pen, pencil, and paper
             Community resources:          Ask parent to get involve in the process of job interview to student practice.

Reflection                    Journal/Learning Log                            Focus Group
Methods       (Individual,
             Group, and/or    Whole-Class Discussion                          Fishbowl Discussion
             Whole Class)
                              Survey                                      x   Other:




                                                                                                    © 2008 Buck Institute for Education   3

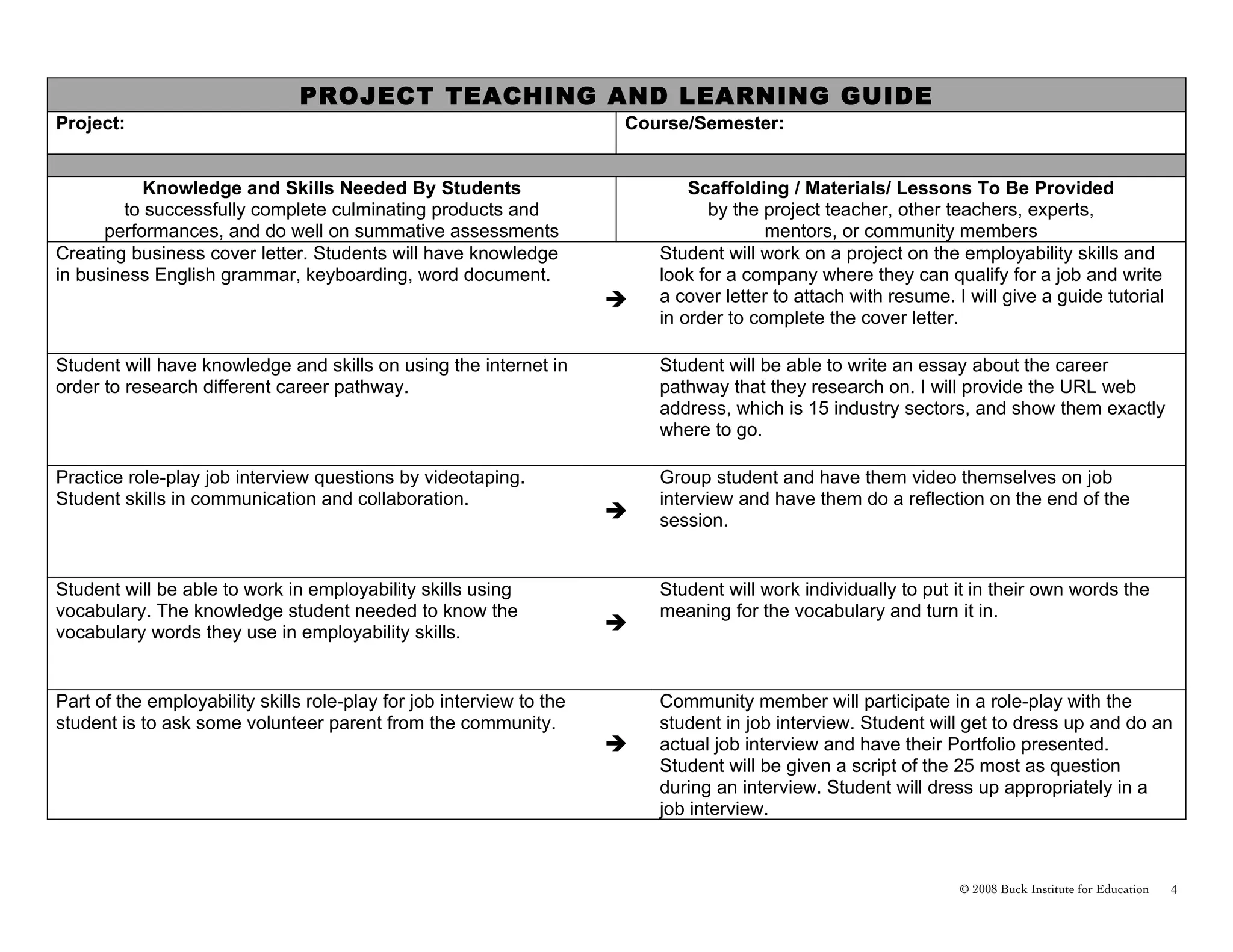

PROJECT TEACHING AND LEARNING GUIDE
Project:                                                              Course/Semester:


           Knowledge and Skills Needed By Students                            Scaffolding / Materials/ Lessons To Be Provided
        to successfully complete culminating products and                       by the project teacher, other teachers, experts,
      performances, and do well on summative assessments                                mentors, or community members
Creating business cover letter. Students will have knowledge              Student will work on a project on the employability skills and
in business English grammar, keyboarding, word document.                  look for a company where they can qualify for a job and write
                                                                         a cover letter to attach with resume. I will give a guide tutorial
                                                                          in order to complete the cover letter.

Student will have knowledge and skills on using the internet in           Student will be able to write an essay about the career
order to research different career pathway.                               pathway that they research on. I will provide the URL web
                                                                          address, which is 15 industry sectors, and show them exactly
                                                                          where to go.

Practice role-play job interview questions by videotaping.                Group student and have them video themselves on job
Student skills in communication and collaboration.                        interview and have them do a reflection on the end of the
                                                                         session.


Student will be able to work in employability skills using                Student will work individually to put it in their own words the
vocabulary. The knowledge student needed to know the                      meaning for the vocabulary and turn it in.
vocabulary words they use in employability skills.                    


Part of the employability skills role-play for job interview to the       Community member will participate in a role-play with the
student is to ask some volunteer parent from the community.               student in job interview. Student will get to dress up and do an
                                                                         actual job interview and have their Portfolio presented.
                                                                          Student will be given a script of the 25 most as question
                                                                          during an interview. Student will dress up appropriately in a
                                                                          job interview.



                                                                                                                 © 2008 Buck Institute for Education   4

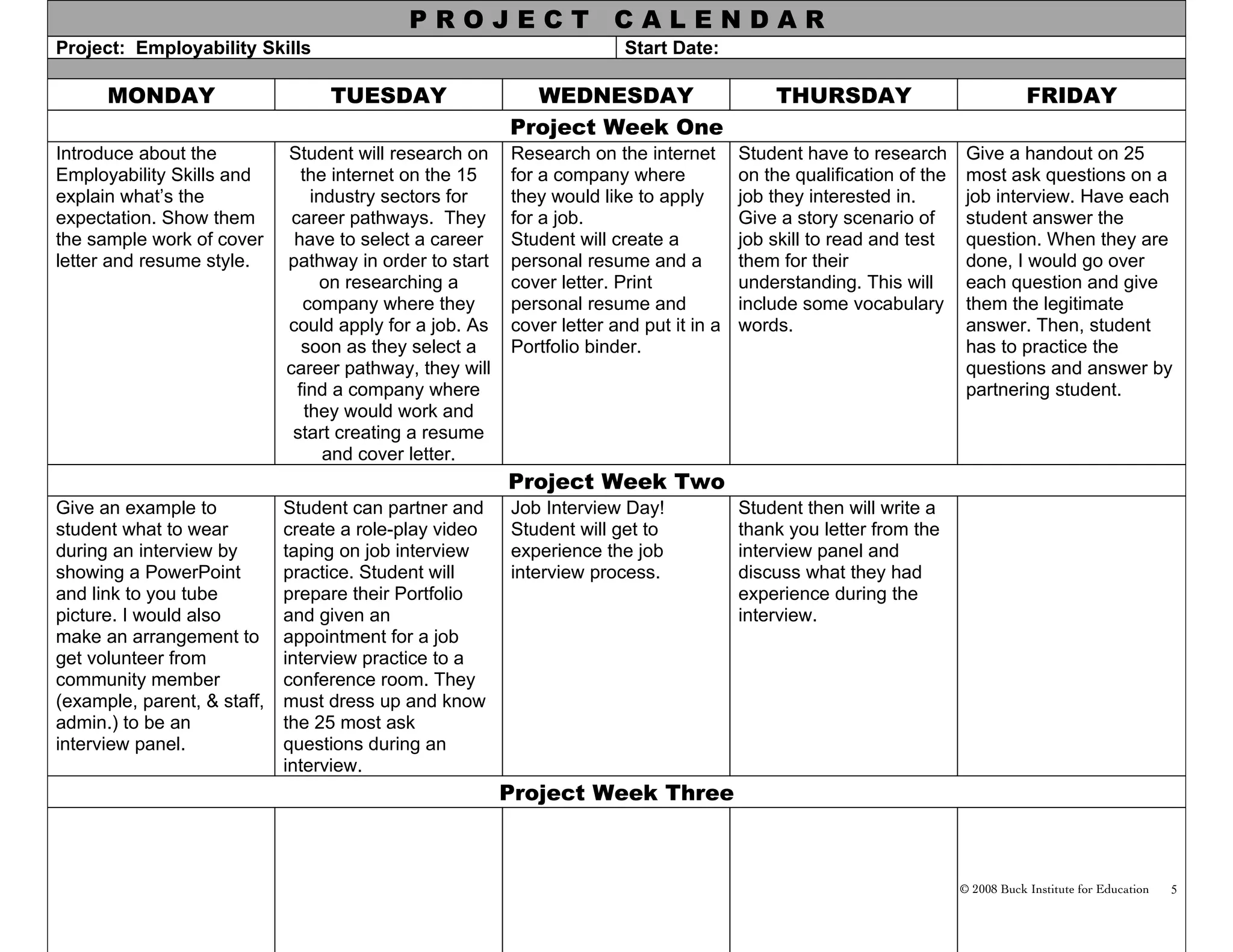

PROJECT                   CALENDAR
Project: Employability Skills                                           Start Date:

      MONDAY                      TUESDAY                  WEDNESDAY                        THURSDAY                              FRIDAY
                                                         Project Week One
Introduce about the          Student will research on    Research on the internet       Student have to research       Give a handout on 25
Employability Skills and        the internet on the 15   for a company where            on the qualification of the    most ask questions on a
explain what’s the                industry sectors for   they would like to apply       job they interested in.        job interview. Have each
expectation. Show them        career pathways. They      for a job.                     Give a story scenario of       student answer the
the sample work of cover      have to select a career    Student will create a          job skill to read and test     question. When they are
letter and resume style.     pathway in order to start   personal resume and a          them for their                 done, I would go over
                                    on researching a     cover letter. Print            understanding. This will       each question and give
                                company where they       personal resume and            include some vocabulary        them the legitimate
                             could apply for a job. As   cover letter and put it in a   words.                         answer. Then, student
                                soon as they select a    Portfolio binder.                                             has to practice the
                             career pathway, they will                                                                 questions and answer by
                               find a company where                                                                    partnering student.
                                 they would work and
                              start creating a resume
                                    and cover letter.
                                                         Project Week Two
Give an example to           Student can partner and     Job Interview Day!             Student then will write a
student what to wear         create a role-play video    Student will get to            thank you letter from the
during an interview by       taping on job interview     experience the job             interview panel and
showing a PowerPoint         practice. Student will      interview process.             discuss what they had
and link to you tube         prepare their Portfolio                                    experience during the
picture. I would also        and given an                                               interview.
make an arrangement to       appointment for a job
get volunteer from           interview practice to a
community member             conference room. They
(example, parent, & staff,   must dress up and know
admin.) to be an             the 25 most ask
interview panel.             questions during an
                             interview.
                                                         Project Week Three



                                                                                                                      © 2008 Buck Institute for Education   5
