Flexible Resources Project management Office

People, Process, Business, Technology Systems
Program Management office
Programme Management Template

3
We know what we are looking for, and it
               isn’t far away

4
Flexible Resources Associates PMO
Flexible Resources is a specialist in Program & Project Management Practices
and Resource competencies.
Irrelevant of the change topic, our Resources are second to none.
Each of them is chosen because they:
 Possess the level competencies to exceed PPM standards
 Have an incredible work ethic
 Have many years of solid experience in a wide range of areas
 Take a great deal of pride in whatever they do
 Are self-sufficient
 Are responsible
 Are excellent communicators
 Are team players

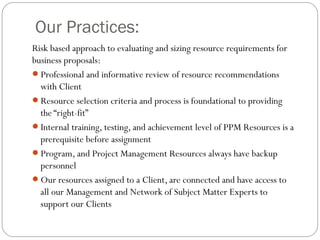

Our Practices:
Risk based approach to evaluating and sizing resource requirements for
business proposals:
Professional and informative review of resource recommendations
  with Client
Resource selection criteria and process is foundational to providing
  the “right-fit”
Internal training, testing, and achievement level of PPM Resources is a
  prerequisite before assignment
Program, and Project Management Resources always have backup
  personnel
Our resources assigned to a Client, are connected and have access to
  all our Management and Network of Subject Matter Experts to
  support our Clients
Program Office solution
 As its highest level, we believe a PMO’s mission is to support and facilitate the three
   components of an organization’s mission: strategic, tactical, and operational project
   management.
 Whether we augment your current PMO, build, or host remotely for you, our right-size
   solution is built with Risk Management as the primary PMO implementation outcome.
Program Office solution

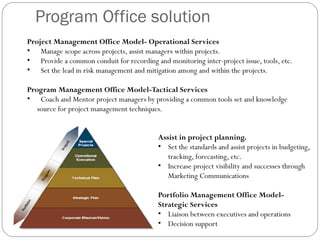

Project Management Office Model- Operational Services
• Manage scope across projects, assist managers within projects.
• Provide a common conduit for recording and monitoring inter-project issue, tools, etc.
• Set the lead in risk management and mitigation among and within the projects.

Program Management Office Model-Tactical Services
• Coach and Mentor project managers by providing a common tools set and knowledge
   source for project management techniques.

                                           Assist in project planning.
                                           • Set the standards and assist projects in budgeting,
                                              tracking, forecasting, etc.
                                           • Increase project visibility and successes through
                                              Marketing Communications

                                           Portfolio Management Office Model-
                                           Strategic Services
                                           • Liaison between executives and operations
                                           • Decision support
Our PMO Office solution addresses the key issues surrounding risk management and how the PMO directly affects the
Mitigate your mission criticalYour Bottom Line By Using FRA PMO solution
 outcome of the Risk to programs.

  Emerging growth companies without a PMO office strongly benefit
  from this controlled cost solution that impact the bottom line, such
  as:

  • Denied new revenue on the basis that potential Client lack
    confidence in Program and Project Management services for your
    solution

  • Failure to retain current Client’s from less than effective
    communication and management of services

  • Missing opportunities for additional revenue from current Client’s
    due to the lack of Account & Partnership Management to explore
    and participate in cross-referencing Client vision and your services

  • Business and revenue growth objectives missed from personnel

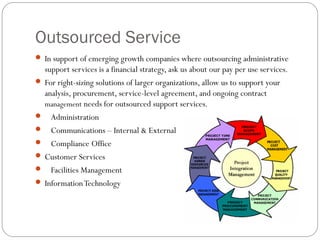

Outsourced Service
 In support of emerging growth companies where outsourcing administrative
  support services is a financial strategy, ask us about our pay per use services.
 For right-sizing solutions of larger organizations, allow us to support your
  analysis, procurement, service-level agreement, and ongoing contract
  management needs for outsourced support services.
 Administration
 Communications – Internal & External
 Compliance Office
 Customer Services
 Facilities Management
 Information Technology

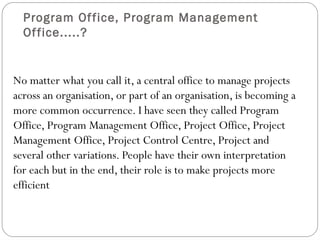

Flexible Resources Provides
Program Of fice, Program Management
  Of fice.....?

No matter what you call it, a central office to manage projects
across an organisation, or part of an organisation, is becoming a
more common occurrence. I have seen they called Program
Office, Program Management Office, Project Office, Project
Management Office, Project Control Centre, Project and
several other variations. People have their own interpretation
for each but in the end, their role is to make projects more
efficient

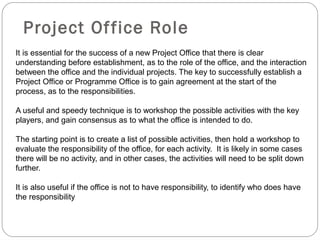

Project Of fice Role
It is essential for the success of a new Project Office that there is clear
understanding before establishment, as to the role of the office, and the interaction
between the office and the individual projects. The key to successfully establish a
Project Office or Programme Office is to gain agreement at the start of the
process, as to the responsibilities.

A useful and speedy technique is to workshop the possible activities with the key
players, and gain consensus as to what the office is intended to do.

The starting point is to create a list of possible activities, then hold a workshop to
evaluate the responsibility of the office, for each activity. It is likely in some cases
there will be no activity, and in other cases, the activities will need to be split down
further.

It is also useful if the office is not to have responsibility, to identify who does have
the responsibility
Program office matrix
                This matrix allows four conditions for each activity.

• ·     Uninvolved. The Project Office has no responsibility for the activity
• ·     Monitor. Essentially they are aware of the activity and pass on
  information.
• ·     Influence. Whilst the Project Office is not responsible for the activity,
  there is a responsibility for the project team and the Project Office to work
  together on the particular activity.
• ·     Control. The Project Office is fully responsible for the activity.
On completion of this matrix, questions such as resourcing, inputs and outputs
can be determined.

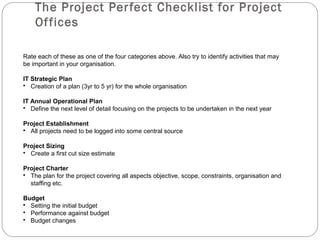

The Project Per fect Checklist for Project
    Of fices

Rate each of these as one of the four categories above. Also try to identify activities that may
be important in your organisation.

IT Strategic Plan
• Creation of a plan (3yr to 5 yr) for the whole organisation

IT Annual Operational Plan
• Define the next level of detail focusing on the projects to be undertaken in the next year

Project Establishment
• All projects need to be logged into some central source

Project Sizing
• Create a first cut size estimate

Project Charter
• The plan for the project covering all aspects objective, scope, constraints, organisation and
  staffing etc.

Budget
• Setting the initial budget
• Performance against budget
• Budget changes
The Project Per fect Checklist for Project
Of fices

Scope
Setting the initial scope (including exclusions)
Scope variations (Process for managing and management of)

Staffing
Project organisational structure
Assigning staff (who?)
Staff movements
Staff personnel management
Skills matrix and identification of gaps
Resourcing contract maintenance & negotiation
Staff training
Project roles and responsibilities
Project team terms and conditions (allowances, rates etc.)
Timesheet and payment
Exit management

The Project Per fect Checklist for Project
     Of fices

Methodology & Processes
Selection of a methodology
Maintenance of a methodology
Training
Maintenance and customisation of procedures
Maintenance of templates
Compliance with methodology
Creation of processes and procedures
Approval of processes and procedures
Standardisation and rationalisation of processes and procedures
Training of processes and procedures
Review of new methodologies

Funding
Approval of expenditure (levels?)
Gating approvals
The Project Per fect Checklist for Project
Of fices
Standards
Use of external standards (ISO 9000, CMM, SPI)
Creation of internal standards
QA services to project teams
QA approvals
Admin Support
Assist teams with logistics (rooms, travel, photocopy etc.)
Produce regular reporting
Provide facilitators to workshops
HR issues (employee leave, payment, queries)
Materials (Stationary, PC's etc.)
Planning
Compile plans (Project, phase, specific activity)
Approve plans
The Project Per fect Checklist for Project
Of fices

 Tools
 Selection of tools
 Purchase of tools
 Exemptions from using tools
 Availability to teams (IT support, upgrades etc.)
 Training
 Review of new tools
The Project Per fect Checklist for Project Of fices

Risk Management
Risk assessment and logging
Risk monitoring
Provide risk logging facilities

Issue Mgmt
Creation of issue log
Management of issue log

Dependencies
Identification of dependencies (other projects etc.)
Monitoring of dependencies
Identification of new dependencies
Liaison with other teams

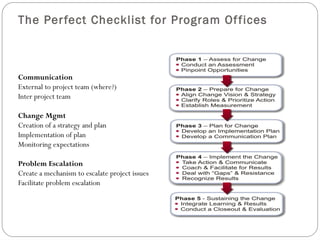

The Per fect Checklist for Program Of fices

Communication
External to project team (where?)
Inter project team

Change Mgmt
Creation of a strategy and plan
Implementation of plan
Monitoring expectations

Problem Escalation
Create a mechanism to escalate project issues
Facilitate problem escalation
The Project Per fect Checklist for
Project Of fices

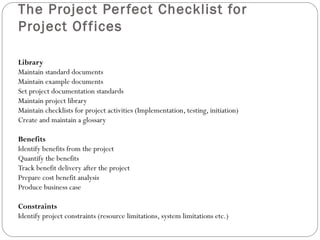

Library
Maintain standard documents
Maintain example documents
Set project documentation standards
Maintain project library
Maintain checklists for project activities (Implementation, testing, initiation)
Create and maintain a glossary

Benefits
Identify benefits from the project
Quantify the benefits
Track benefit delivery after the project
Prepare cost benefit analysis
Produce business case

Constraints
Identify project constraints (resource limitations, system limitations etc.)
The Project Per fect Checklist for
Project Of fices

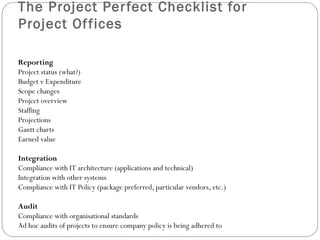

Reporting
Project status (what?)
Budget v Expenditure
Scope changes
Project overview
Staffing
Projections
Gantt charts
Earned value

Integration
Compliance with IT architecture (applications and technical)
Integration with other systems
Compliance with IT Policy (package preferred, particular vendors, etc.)

Audit
Compliance with organisational standards
Ad hoc audits of projects to ensure company policy is being adhered to
The Project Per fect Checklist for
Project Of fices

PIR
Carry out post implementation review
Generate action items from PIR
Carry out recommendations of PIR

Acceptance & Conformance
Set conditions for acceptance of deliverables
Accept deliverables
Authorise exemptions to acceptance standards

Configuration Management
Setting up Configuration Management
Managing software migration
Version control
The Project Per fect Checklist for

Project Of fices

Mentoring
• Formal mentoring programs
• Support roles in projects (e.g. supplying an experienced
  resource on a part time basis
• Special interest groups

Business Interaction:
• Carry out Business Process Re‑engineering
• User documentation
• User training
Approach
                                              Strategy

                                            Organisation

                     Implementation Plan
     Legacy Estate

                                               Process

                                                                         Future Estate
                                                             Migration
                                            Applications

                                                Data

                                            Infrastructure
                                                                                         Complete
                                    Programme Management

26
Questions?

     Dr Jason Carter – Flexible Resources Associates
     Tel: 0207 – 1177 -594.
     Mobile: 0709-230-1140
     Email: drcarter@flexibleresources.co.uk

27

Program & project management (pmo)

  • 1.
    Flexible Resources Projectmanagement Office People, Process, Business, Technology Systems
  • 2.
  • 3.
  • 4.
    We know whatwe are looking for, and it isn’t far away 4
  • 5.
    Flexible Resources AssociatesPMO Flexible Resources is a specialist in Program & Project Management Practices and Resource competencies. Irrelevant of the change topic, our Resources are second to none. Each of them is chosen because they:  Possess the level competencies to exceed PPM standards  Have an incredible work ethic  Have many years of solid experience in a wide range of areas  Take a great deal of pride in whatever they do  Are self-sufficient  Are responsible  Are excellent communicators  Are team players
  • 6.
    Our Practices: Risk basedapproach to evaluating and sizing resource requirements for business proposals: Professional and informative review of resource recommendations with Client Resource selection criteria and process is foundational to providing the “right-fit” Internal training, testing, and achievement level of PPM Resources is a prerequisite before assignment Program, and Project Management Resources always have backup personnel Our resources assigned to a Client, are connected and have access to all our Management and Network of Subject Matter Experts to support our Clients
  • 7.
    Program Office solution As its highest level, we believe a PMO’s mission is to support and facilitate the three components of an organization’s mission: strategic, tactical, and operational project management.  Whether we augment your current PMO, build, or host remotely for you, our right-size solution is built with Risk Management as the primary PMO implementation outcome.
  • 8.
    Program Office solution ProjectManagement Office Model- Operational Services • Manage scope across projects, assist managers within projects. • Provide a common conduit for recording and monitoring inter-project issue, tools, etc. • Set the lead in risk management and mitigation among and within the projects. Program Management Office Model-Tactical Services • Coach and Mentor project managers by providing a common tools set and knowledge source for project management techniques. Assist in project planning. • Set the standards and assist projects in budgeting, tracking, forecasting, etc. • Increase project visibility and successes through Marketing Communications Portfolio Management Office Model- Strategic Services • Liaison between executives and operations • Decision support
  • 9.
    Our PMO Officesolution addresses the key issues surrounding risk management and how the PMO directly affects the Mitigate your mission criticalYour Bottom Line By Using FRA PMO solution outcome of the Risk to programs. Emerging growth companies without a PMO office strongly benefit from this controlled cost solution that impact the bottom line, such as: • Denied new revenue on the basis that potential Client lack confidence in Program and Project Management services for your solution • Failure to retain current Client’s from less than effective communication and management of services • Missing opportunities for additional revenue from current Client’s due to the lack of Account & Partnership Management to explore and participate in cross-referencing Client vision and your services • Business and revenue growth objectives missed from personnel
  • 10.
    Outsourced Service  Insupport of emerging growth companies where outsourcing administrative support services is a financial strategy, ask us about our pay per use services.  For right-sizing solutions of larger organizations, allow us to support your analysis, procurement, service-level agreement, and ongoing contract management needs for outsourced support services.  Administration  Communications – Internal & External  Compliance Office  Customer Services  Facilities Management  Information Technology
  • 11.
  • 12.
    Program Of fice,Program Management Of fice.....? No matter what you call it, a central office to manage projects across an organisation, or part of an organisation, is becoming a more common occurrence. I have seen they called Program Office, Program Management Office, Project Office, Project Management Office, Project Control Centre, Project and several other variations. People have their own interpretation for each but in the end, their role is to make projects more efficient
  • 13.
    Project Of ficeRole It is essential for the success of a new Project Office that there is clear understanding before establishment, as to the role of the office, and the interaction between the office and the individual projects. The key to successfully establish a Project Office or Programme Office is to gain agreement at the start of the process, as to the responsibilities. A useful and speedy technique is to workshop the possible activities with the key players, and gain consensus as to what the office is intended to do. The starting point is to create a list of possible activities, then hold a workshop to evaluate the responsibility of the office, for each activity. It is likely in some cases there will be no activity, and in other cases, the activities will need to be split down further. It is also useful if the office is not to have responsibility, to identify who does have the responsibility
  • 14.
    Program office matrix This matrix allows four conditions for each activity. • · Uninvolved. The Project Office has no responsibility for the activity • · Monitor. Essentially they are aware of the activity and pass on information. • · Influence. Whilst the Project Office is not responsible for the activity, there is a responsibility for the project team and the Project Office to work together on the particular activity. • · Control. The Project Office is fully responsible for the activity. On completion of this matrix, questions such as resourcing, inputs and outputs can be determined.
  • 15.
    The Project Perfect Checklist for Project Of fices Rate each of these as one of the four categories above. Also try to identify activities that may be important in your organisation. IT Strategic Plan • Creation of a plan (3yr to 5 yr) for the whole organisation IT Annual Operational Plan • Define the next level of detail focusing on the projects to be undertaken in the next year Project Establishment • All projects need to be logged into some central source Project Sizing • Create a first cut size estimate Project Charter • The plan for the project covering all aspects objective, scope, constraints, organisation and staffing etc. Budget • Setting the initial budget • Performance against budget • Budget changes
  • 16.
    The Project Perfect Checklist for Project Of fices Scope Setting the initial scope (including exclusions) Scope variations (Process for managing and management of) Staffing Project organisational structure Assigning staff (who?) Staff movements Staff personnel management Skills matrix and identification of gaps Resourcing contract maintenance & negotiation Staff training Project roles and responsibilities Project team terms and conditions (allowances, rates etc.) Timesheet and payment Exit management
  • 17.
    The Project Perfect Checklist for Project Of fices Methodology & Processes Selection of a methodology Maintenance of a methodology Training Maintenance and customisation of procedures Maintenance of templates Compliance with methodology Creation of processes and procedures Approval of processes and procedures Standardisation and rationalisation of processes and procedures Training of processes and procedures Review of new methodologies Funding Approval of expenditure (levels?) Gating approvals
  • 18.
    The Project Perfect Checklist for Project Of fices Standards Use of external standards (ISO 9000, CMM, SPI) Creation of internal standards QA services to project teams QA approvals Admin Support Assist teams with logistics (rooms, travel, photocopy etc.) Produce regular reporting Provide facilitators to workshops HR issues (employee leave, payment, queries) Materials (Stationary, PC's etc.) Planning Compile plans (Project, phase, specific activity) Approve plans
  • 19.
    The Project Perfect Checklist for Project Of fices Tools Selection of tools Purchase of tools Exemptions from using tools Availability to teams (IT support, upgrades etc.) Training Review of new tools
  • 20.
    The Project Perfect Checklist for Project Of fices Risk Management Risk assessment and logging Risk monitoring Provide risk logging facilities Issue Mgmt Creation of issue log Management of issue log Dependencies Identification of dependencies (other projects etc.) Monitoring of dependencies Identification of new dependencies Liaison with other teams
  • 21.
    The Per fectChecklist for Program Of fices Communication External to project team (where?) Inter project team Change Mgmt Creation of a strategy and plan Implementation of plan Monitoring expectations Problem Escalation Create a mechanism to escalate project issues Facilitate problem escalation
  • 22.
    The Project Perfect Checklist for Project Of fices Library Maintain standard documents Maintain example documents Set project documentation standards Maintain project library Maintain checklists for project activities (Implementation, testing, initiation) Create and maintain a glossary Benefits Identify benefits from the project Quantify the benefits Track benefit delivery after the project Prepare cost benefit analysis Produce business case Constraints Identify project constraints (resource limitations, system limitations etc.)
  • 23.
    The Project Perfect Checklist for Project Of fices Reporting Project status (what?) Budget v Expenditure Scope changes Project overview Staffing Projections Gantt charts Earned value Integration Compliance with IT architecture (applications and technical) Integration with other systems Compliance with IT Policy (package preferred, particular vendors, etc.) Audit Compliance with organisational standards Ad hoc audits of projects to ensure company policy is being adhered to
  • 24.
    The Project Perfect Checklist for Project Of fices PIR Carry out post implementation review Generate action items from PIR Carry out recommendations of PIR Acceptance & Conformance Set conditions for acceptance of deliverables Accept deliverables Authorise exemptions to acceptance standards Configuration Management Setting up Configuration Management Managing software migration Version control
  • 25.
    The Project Perfect Checklist for Project Of fices Mentoring • Formal mentoring programs • Support roles in projects (e.g. supplying an experienced resource on a part time basis • Special interest groups Business Interaction: • Carry out Business Process Re‑engineering • User documentation • User training
  • 26.
    Approach Strategy Organisation Implementation Plan Legacy Estate Process Future Estate Migration Applications Data Infrastructure Complete Programme Management 26
  • 27.
    Questions? Dr Jason Carter – Flexible Resources Associates Tel: 0207 – 1177 -594. Mobile: 0709-230-1140 Email: drcarter@flexibleresources.co.uk 27
