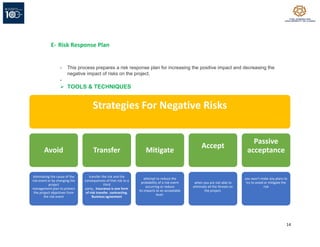

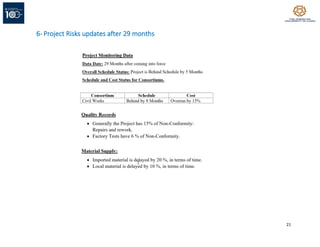

This document outlines the risk management process for a case study project. It includes:

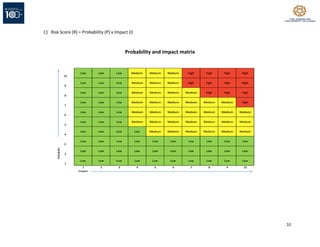

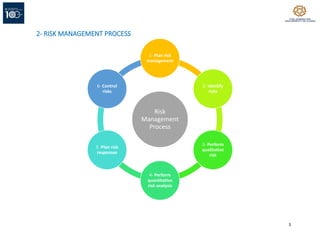

1. The risk management process with 6 steps: plan, identify, analyze qualitatively, analyze quantitatively, plan responses, and control risks.

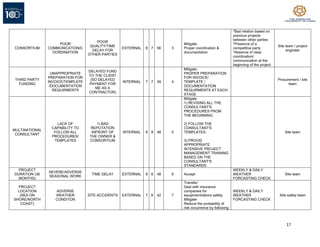

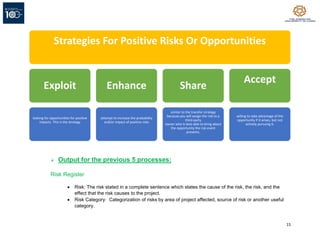

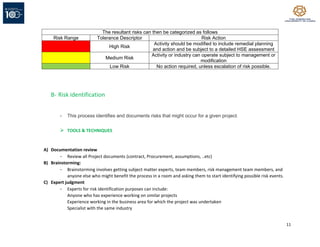

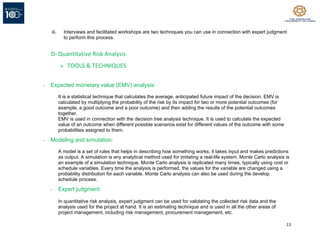

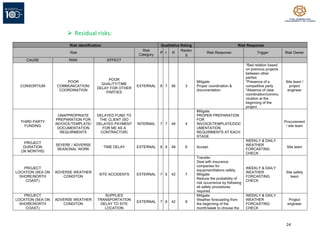

2. A risk register containing 16 identified risks for the project with details like probability, impact, risk response strategies.
3. An update to the risk register after 29 months with one risk removed.
The document provides an overview of the risk management process applied to a case study project and the resulting risk register and monitoring.
