PATIENT RECORD
     MANAGEMENT SYSTEM

      Software Engineering Project By:
                     Javeria
                  11-arid-3303
                      MIT-2
University Institute of Information Technology,
            Rawalpindi(UIIT,UAAR)
                    Pakistan

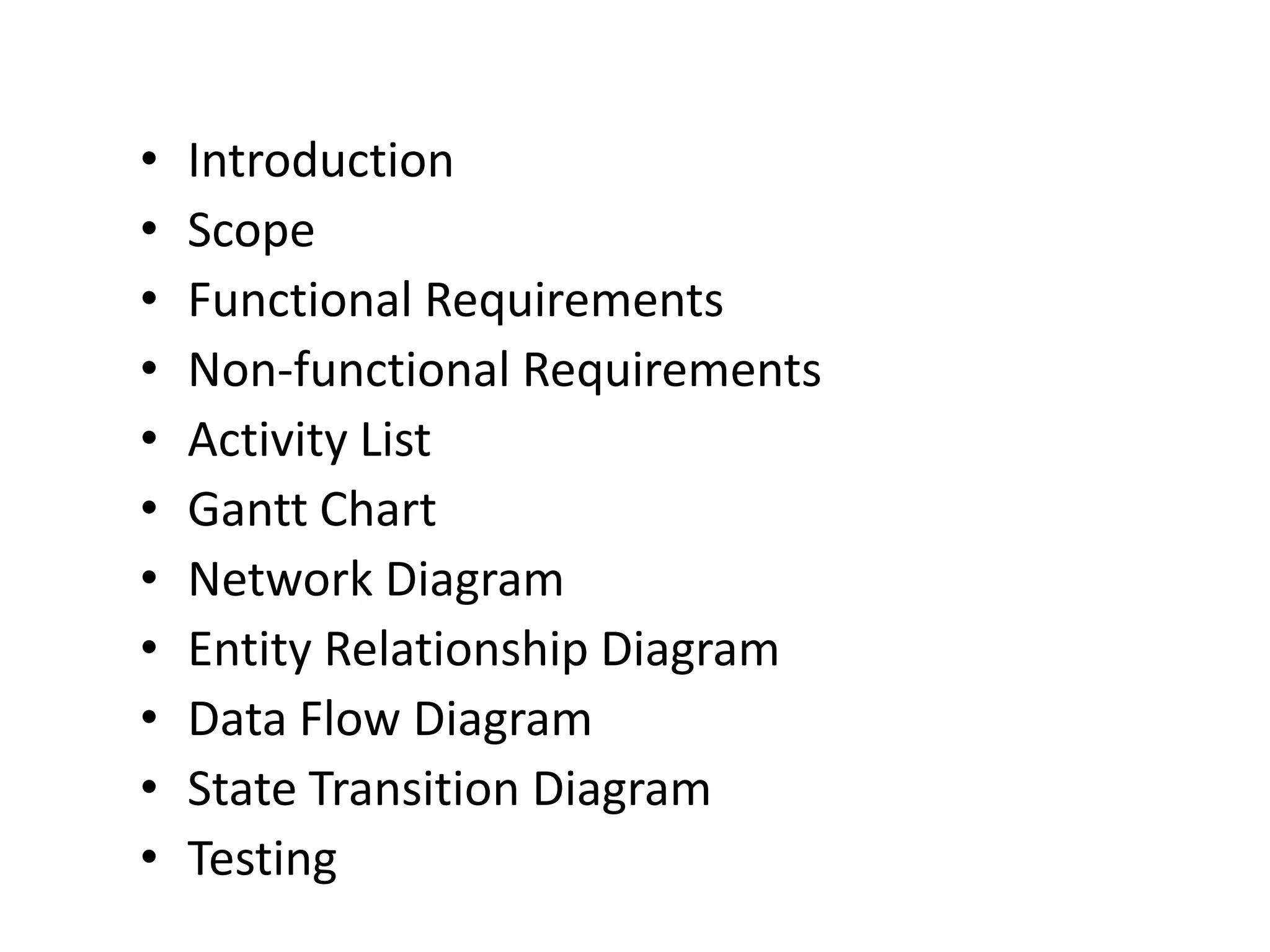

•   Introduction
•   Scope
•   Functional Requirements
•   Non-functional Requirements
•   Activity List
•   Gantt Chart
•   Network Diagram
•   Entity Relationship Diagram
•   Data Flow Diagram
•   State Transition Diagram
•   Testing

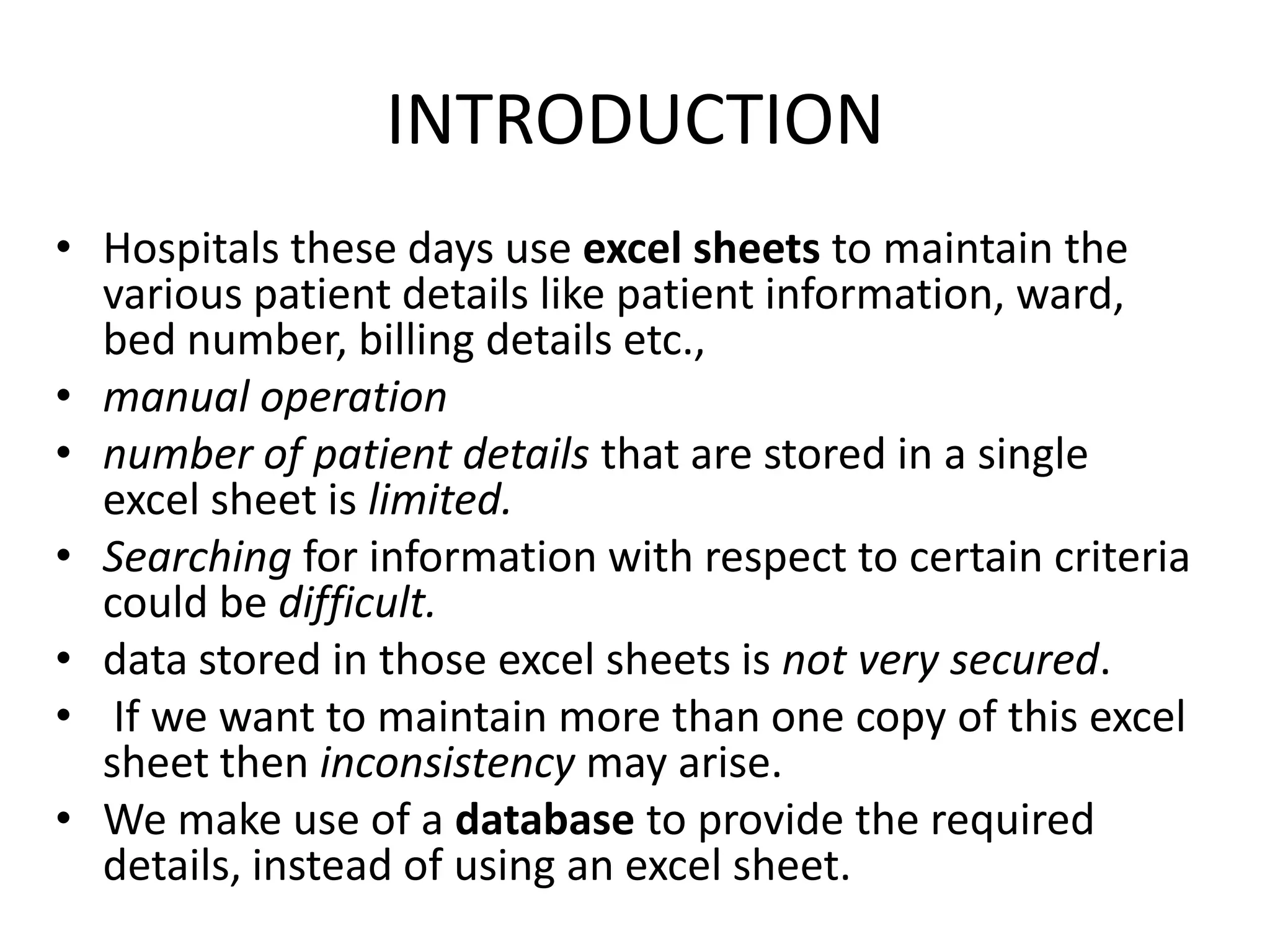

INTRODUCTION
• Hospitals these days use excel sheets to maintain the
  various patient details like patient information, ward,
  bed number, billing details etc.,
• manual operation
• number of patient details that are stored in a single
  excel sheet is limited.
• Searching for information with respect to certain criteria
  could be difficult.
• data stored in those excel sheets is not very secured.
• If we want to maintain more than one copy of this excel
  sheet then inconsistency may arise.
• We make use of a database to provide the required
  details, instead of using an excel sheet.
INTRODUCTION(Cntd..)
• The information regarding patients can be stored in database.
• It can update the table fields (patient details, the amount to be paid /
  any balance remaining, the ward number, the bed number, the
  registration number, case number, etc.) as soon as a new patient
  admits.
• Enter the ward number for the patient either in the general ward or the
  ICU.
• Settle all bills pending to be paid by a patient before the patient’s
  discharge.
• Keep a track of all beds occupied / free in both the ward and the ICU.
• Keep a track of all transfers of patients from the general ward to the ICU
  and vice versa.
• View information of all patients details, their admit time and the
  amount to be paid based on the treatment given and the ward selected.
SCOPE
• This system can be used by only team members
  and administrator of a particular hospital.
• The database can be used by team members in
  order to search, edit and add patient details.
• The database can be accessed only after
  installing the software on local system.
• This software can be used by only by a single
  user at any instant.
• The systems’ usage is confined to usage by single
  organization.

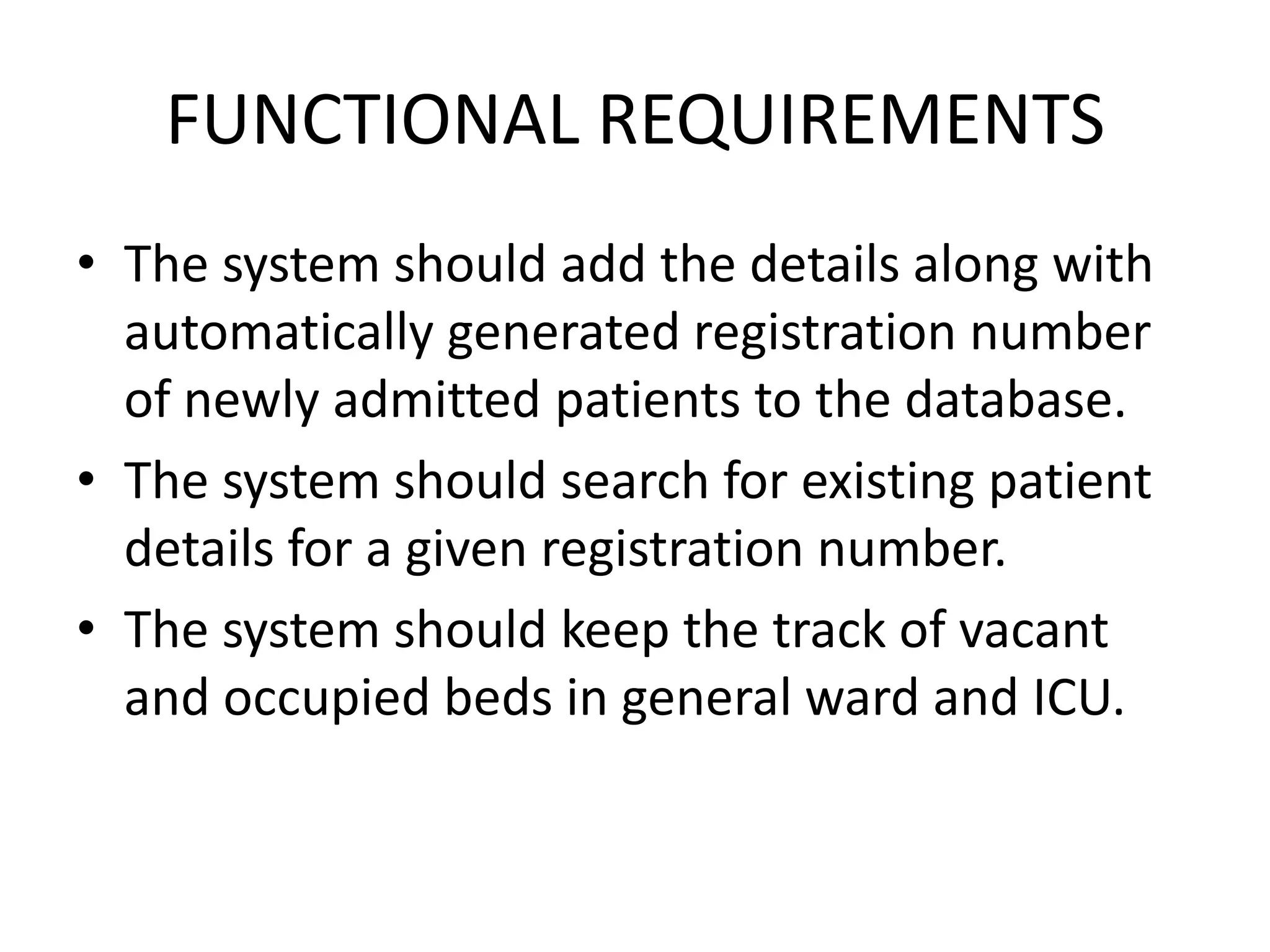

FUNCTIONAL REQUIREMENTS
• The system should add the details along with
  automatically generated registration number
  of newly admitted patients to the database.
• The system should search for existing patient
  details for a given registration number.
• The system should keep the track of vacant
  and occupied beds in general ward and ICU.
NON-FUNCTIONAL REQUIREMENTS
• Usability: The system should be user friendly and
  self-explanatory.
• Availability: The system should be available 100%
  for the user and is used 24 hrs a day. The system
  shall be operational 24 hours a day and 7 days a
  week.
• Accuracy: The accuracy of the system should be
  limited by the accuracy of the speed at which the
  users of the system use it.
• Access Reliability: The system shall provide 100%
  access reliability.

ACTIVITY LIST

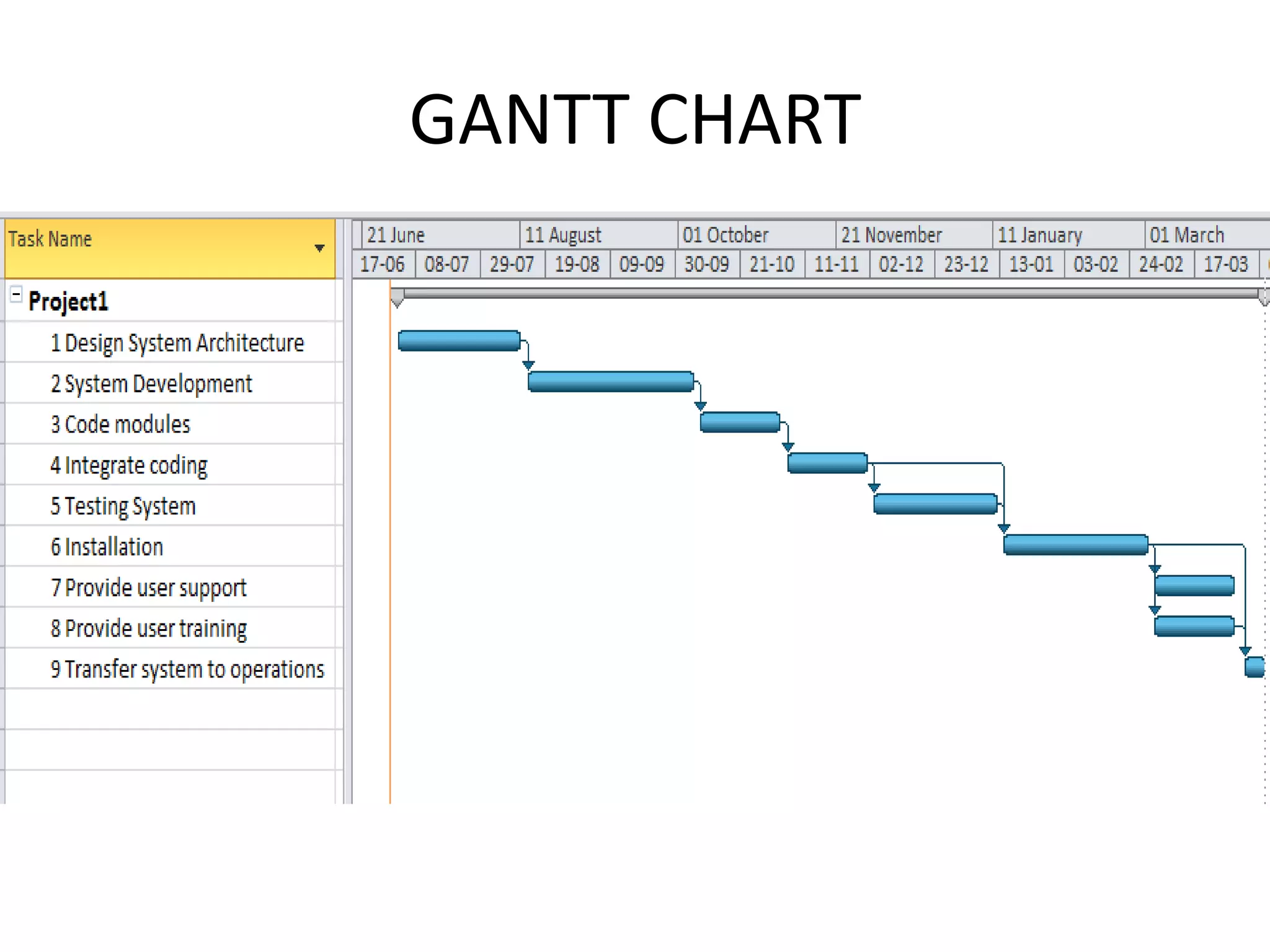

GANTT CHART

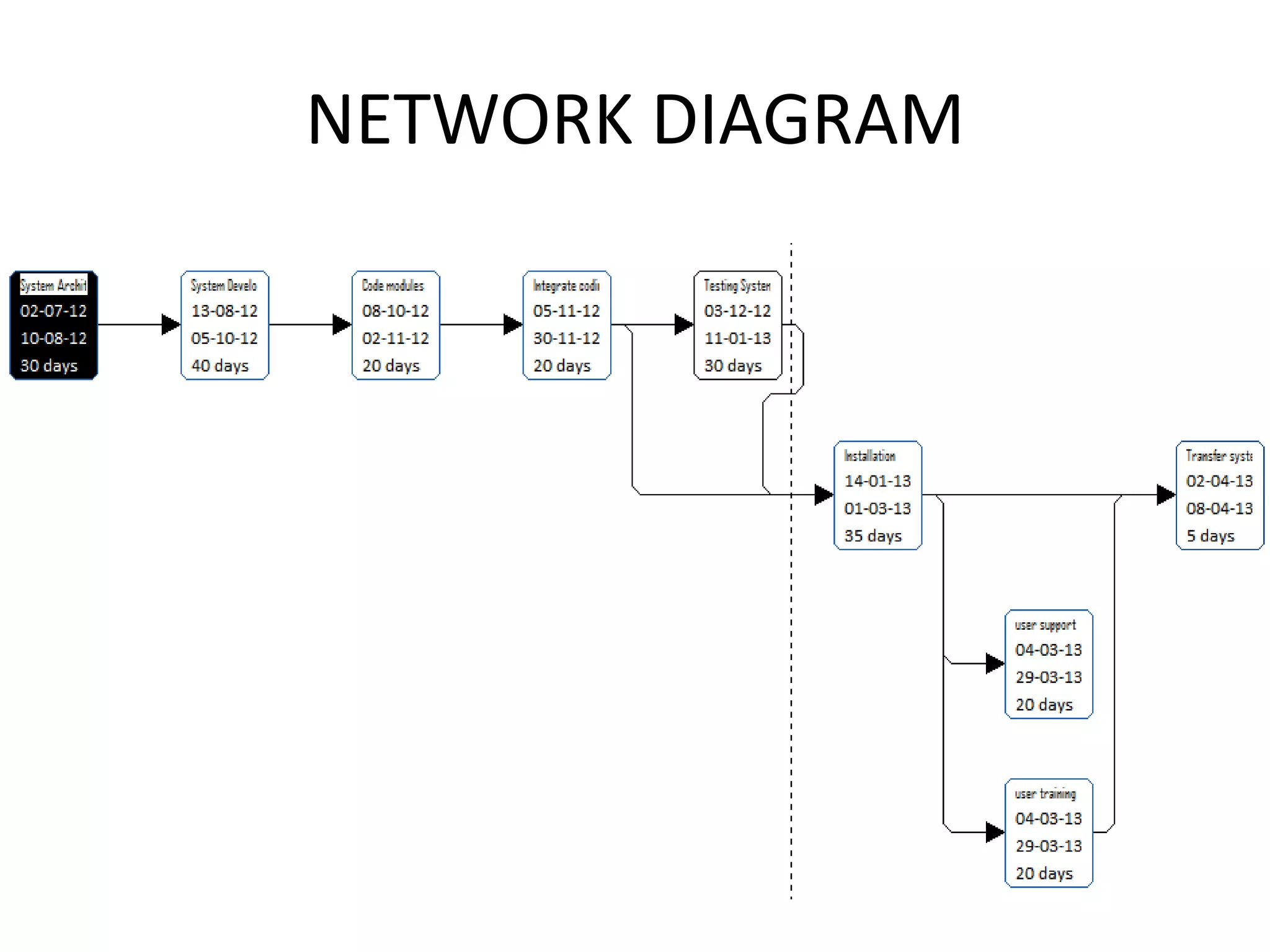

NETWORK DIAGRAM

    2

            3       4
1
                            5

    9                   6

        8
                7

Receptionist

           Patient ID
 Name                                                           Patient ID
                                   Receive
   Ward no.
                                                                   Name
                    In Patient                    Out Patient
Bed no.
                                                                  History
          History                   Record
                                   saved in

                                 Patient Record
                                   Database

   ENTITY                          Managed
RELATIONSHIP                         by

  DIAGRAM                          System
                                 Administrator

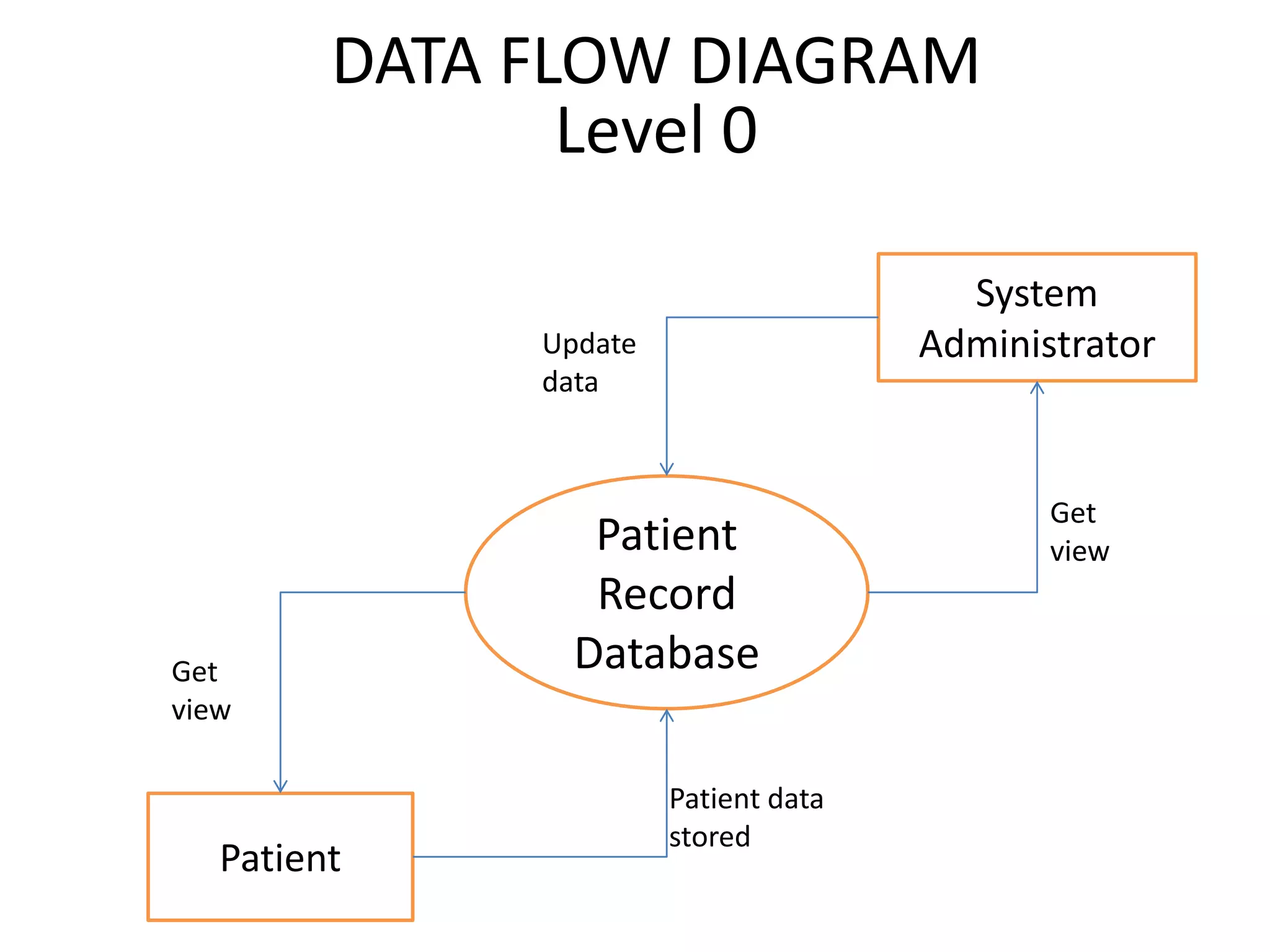

DATA FLOW DIAGRAM
                Level 0

                                        System
              Update                  Administrator
              data

                                             Get
                 Patient                     view
                 Record
Get             Database
view

                       Patient data
                       stored
   Patient

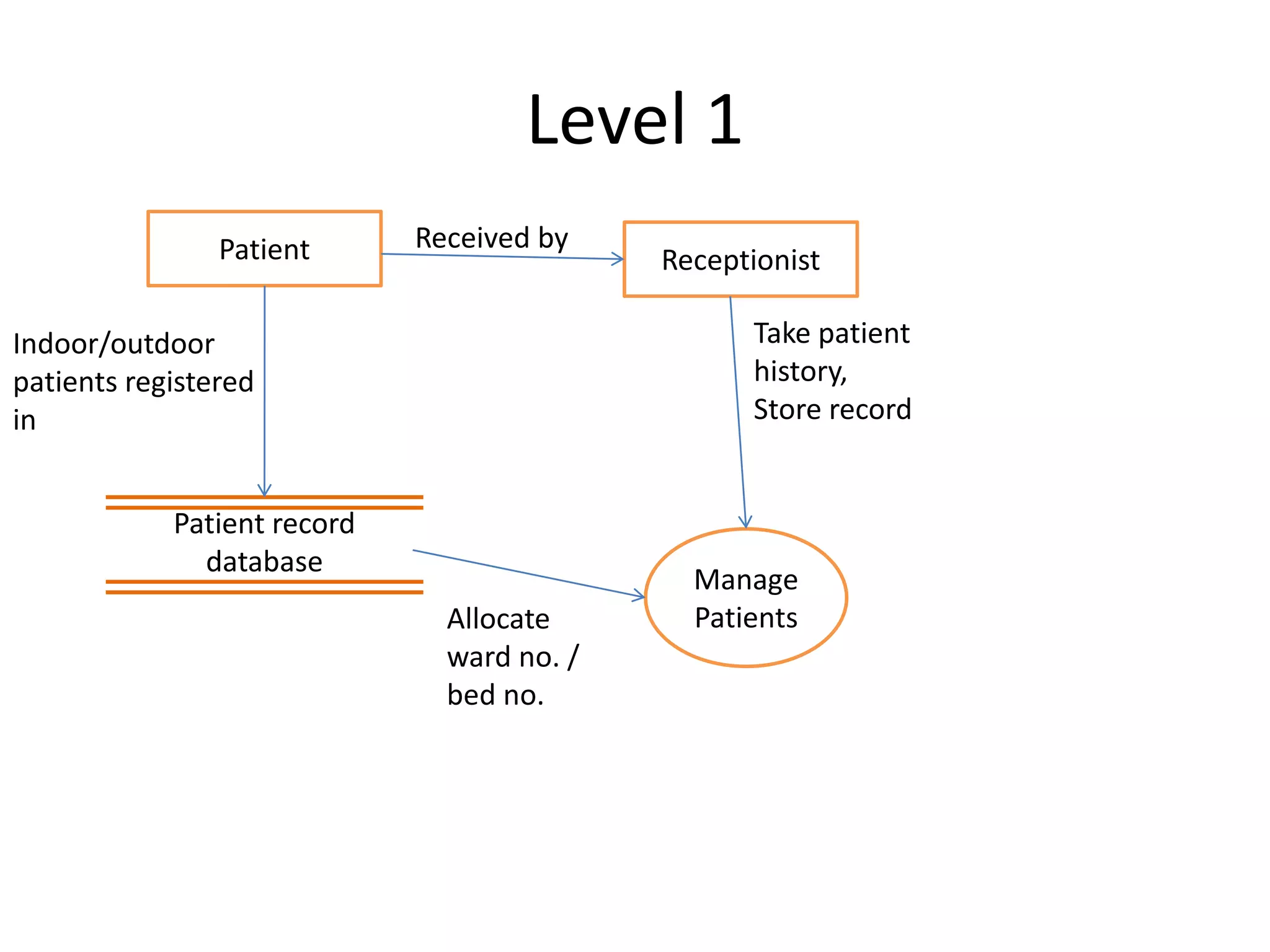

Level 1
                Patient      Received by
                                            Receptionist

Indoor/outdoor                                    Take patient
patients registered                               history,
in                                                Store record

            Patient record
              database
                                              Manage
                               Allocate       Patients
                               ward no. /
                               bed no.
Patient record
             database                                                                   Level 2
                                                   Manage
                                                   patients
                                                                                      Amount to be paid based
                       Keep track                                                     on treatment given /ward
                                       Add new
                       of free                                                        selected
                                       indoor/                   Search
                       beds            outdoor                   patient by
                                       patient                   name
     Show free                         info

      beds in                                                                                    Make
                                           Add
     ward and                             patient                                                bills
        ICU                                                   Search
                                                              patient
                                                                                                   Show in
Allocate free bed to                Allocate free bed                                              patient
new indoor patient                                               View patient
                                    to new indoor                                                  info
                                                                 registration no.,
                                    patient
                                                                 name, date
                                                                 discharged, date
               Allocate ward                                     admitted, history,
                no./bed no.                                      treatment, bills       View
                 to indoor                                                             patient
                  patients                                                             details

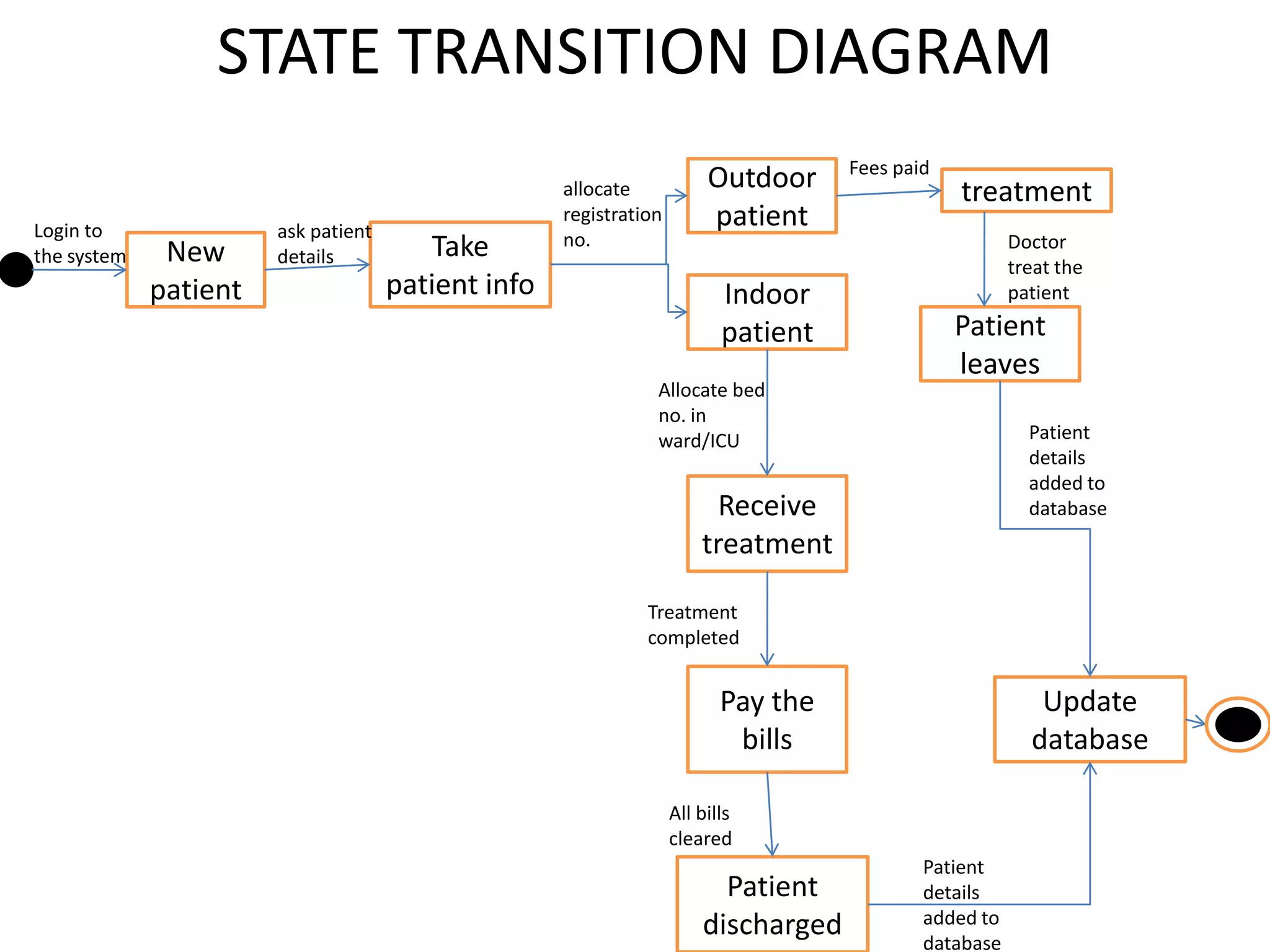

STATE TRANSITION DIAGRAM
                                                                                    Fees paid
                                                    allocate            Outdoor                 treatment
Login to               ask patient
                                                    registration        patient
                                        Take        no.                                                Doctor
the system    New      details                                                                         treat the
             patient                 patient info                         Indoor                       patient

                                                                          patient               Patient
                                                                                                leaves
                                                               Allocate bed
                                                               no. in
                                                               ward/ICU                                  Patient
                                                                                                         details
                                                                                                         added to
                                                                         Receive                         database
                                                                       treatment

                                                              Treatment
                                                              completed

                                                                          Pay the                         Update
                                                                           bills                         database

                                                                   All bills
                                                                   cleared
                                                                                            Patient
                                                                         Patient            details
                                                                       discharged           added to
                                                                                            database

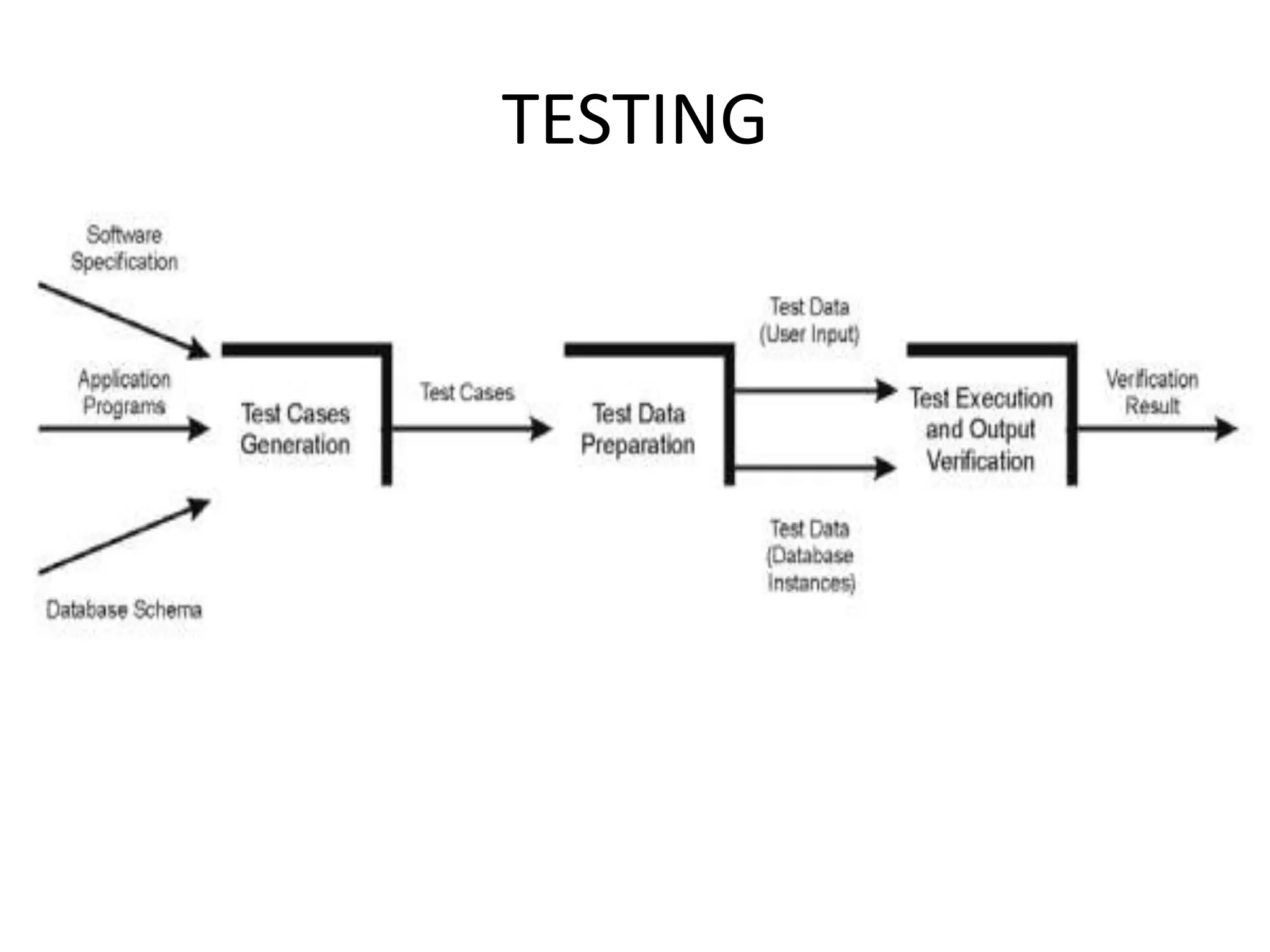

TESTING
Javeria

Patient record management system(s.e. diagrams)

  • 2.
    PATIENT RECORD MANAGEMENT SYSTEM Software Engineering Project By: Javeria 11-arid-3303 MIT-2 University Institute of Information Technology, Rawalpindi(UIIT,UAAR) Pakistan
  • 3.
    Introduction • Scope • Functional Requirements • Non-functional Requirements • Activity List • Gantt Chart • Network Diagram • Entity Relationship Diagram • Data Flow Diagram • State Transition Diagram • Testing
  • 4.
    INTRODUCTION • Hospitals thesedays use excel sheets to maintain the various patient details like patient information, ward, bed number, billing details etc., • manual operation • number of patient details that are stored in a single excel sheet is limited. • Searching for information with respect to certain criteria could be difficult. • data stored in those excel sheets is not very secured. • If we want to maintain more than one copy of this excel sheet then inconsistency may arise. • We make use of a database to provide the required details, instead of using an excel sheet.
  • 5.
    INTRODUCTION(Cntd..) • The informationregarding patients can be stored in database. • It can update the table fields (patient details, the amount to be paid / any balance remaining, the ward number, the bed number, the registration number, case number, etc.) as soon as a new patient admits. • Enter the ward number for the patient either in the general ward or the ICU. • Settle all bills pending to be paid by a patient before the patient’s discharge. • Keep a track of all beds occupied / free in both the ward and the ICU. • Keep a track of all transfers of patients from the general ward to the ICU and vice versa. • View information of all patients details, their admit time and the amount to be paid based on the treatment given and the ward selected.
  • 6.
    SCOPE • This systemcan be used by only team members and administrator of a particular hospital. • The database can be used by team members in order to search, edit and add patient details. • The database can be accessed only after installing the software on local system. • This software can be used by only by a single user at any instant. • The systems’ usage is confined to usage by single organization.
  • 7.
    FUNCTIONAL REQUIREMENTS • Thesystem should add the details along with automatically generated registration number of newly admitted patients to the database. • The system should search for existing patient details for a given registration number. • The system should keep the track of vacant and occupied beds in general ward and ICU.
  • 8.
    NON-FUNCTIONAL REQUIREMENTS • Usability:The system should be user friendly and self-explanatory. • Availability: The system should be available 100% for the user and is used 24 hrs a day. The system shall be operational 24 hours a day and 7 days a week. • Accuracy: The accuracy of the system should be limited by the accuracy of the speed at which the users of the system use it. • Access Reliability: The system shall provide 100% access reliability.
  • 9.
  • 10.
  • 11.
    NETWORK DIAGRAM 2 3 4 1 5 9 6 8 7
  • 12.
    Receptionist Patient ID Name Patient ID Receive Ward no. Name In Patient Out Patient Bed no. History History Record saved in Patient Record Database ENTITY Managed RELATIONSHIP by DIAGRAM System Administrator
  • 13.
    DATA FLOW DIAGRAM Level 0 System Update Administrator data Get Patient view Record Get Database view Patient data stored Patient
  • 14.
    Level 1 Patient Received by Receptionist Indoor/outdoor Take patient patients registered history, in Store record Patient record database Manage Allocate Patients ward no. / bed no.
  • 15.
    Patient record database Level 2 Manage patients Amount to be paid based Keep track on treatment given /ward Add new of free selected indoor/ Search beds outdoor patient by patient name Show free info beds in Make Add ward and patient bills ICU Search patient Show in Allocate free bed to Allocate free bed patient new indoor patient View patient to new indoor info registration no., patient name, date discharged, date Allocate ward admitted, history, no./bed no. treatment, bills View to indoor patient patients details
  • 16.
    STATE TRANSITION DIAGRAM Fees paid allocate Outdoor treatment Login to ask patient registration patient Take no. Doctor the system New details treat the patient patient info Indoor patient patient Patient leaves Allocate bed no. in ward/ICU Patient details added to Receive database treatment Treatment completed Pay the Update bills database All bills cleared Patient Patient details discharged added to database
  • 17.
