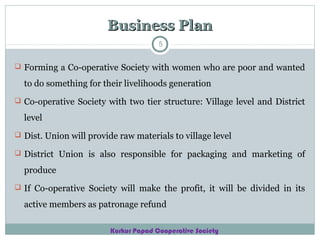

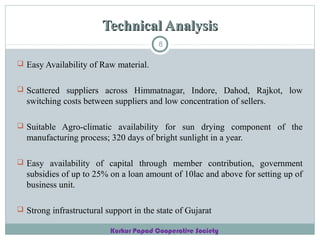

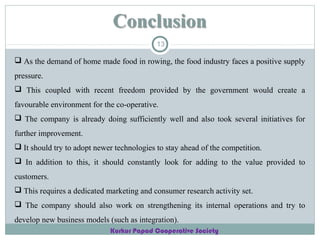

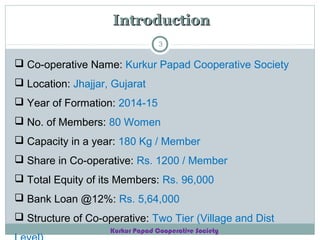

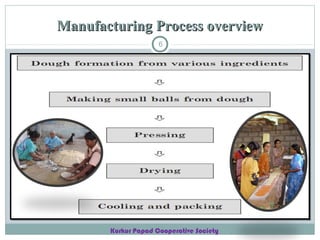

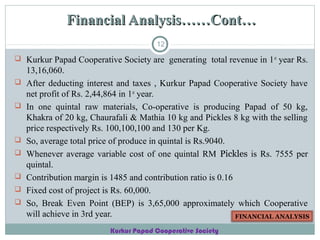

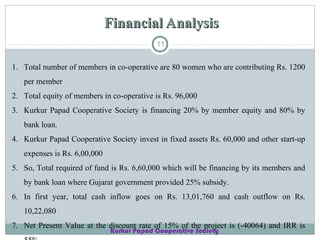

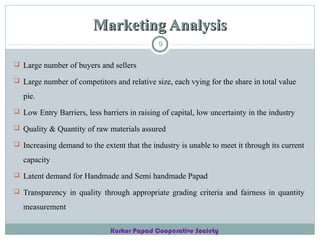

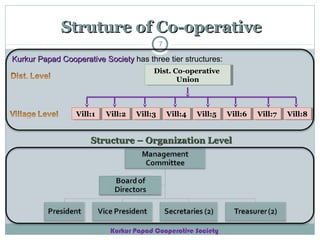

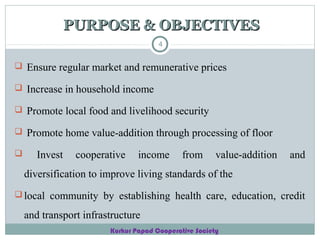

The document describes the Kurkur Papad Cooperative Society project. It discusses the formation of the cooperative with 80 women members, a total equity of Rs. 96,000, and a bank loan of Rs. 5,64,000. The cooperative's objectives are to ensure regular income for members and promote local food processing. It has a three-tier structure and manufactures papads and other snacks from raw materials supplied to village cooperatives. A financial analysis shows that in the first year the cooperative expects a net profit of Rs. 2,44,864 and will reach the break-even point of Rs. 3,65,000 in sales in the third year.
