EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 1
Function 3:
Marine Engineering at the
Management Level
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 2

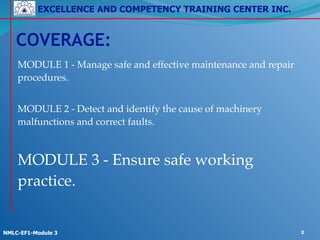

MODULE 1 - Manage safe and effective maintenance and repair
procedures.!
!
MODULE 2 - Detect and identify the cause of machinery
malfunctions and correct faults.!
!
MODULE 3 - Ensure safe working
practice.
COVERAGE:
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 3
Safe Working Practices on
Board of Vessels
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 4
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 5
Risk Assessments
• You have carefully thought out all the angles!

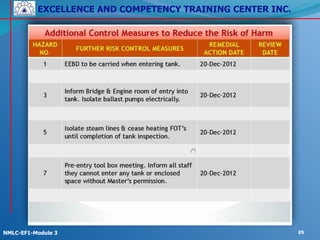

• You have done it a hundred times!
• It comes naturally to you!
• You know what you are doing, it is what you have been
trained to do all your life!
• So nothing could possibly go wrong

•Could it ??
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 6
Think Again!
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 7
No beavers were actually injured
during the creation of this slides
presentation! :-)
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 8
!
!

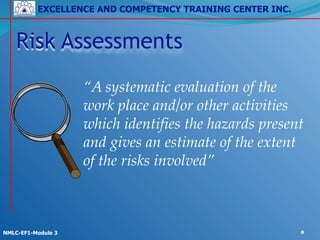

“A systematic evaluation of the
work place and/or other activities
which identifies the hazards present
and gives an estimate of the extent
of the risks involved”
Risk Assessments
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 9
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 10
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 11
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 12
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 13
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 14
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 15
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 16
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!

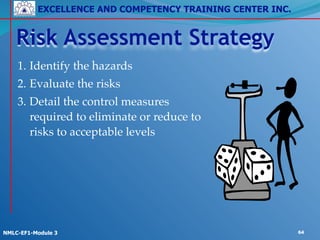

NMLC-EF1-Module 3 17
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 18
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 19
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 20
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 21
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 22
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!

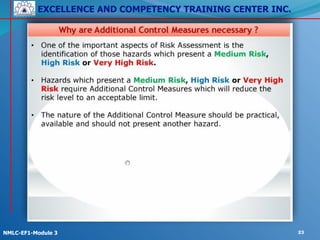

NMLC-EF1-Module 3 23
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!

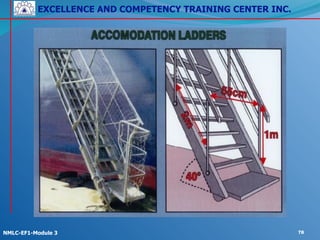

NMLC-EF1-Module 3 24
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 25
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 26
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 27
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 28

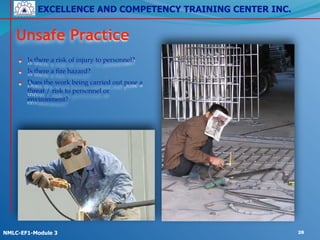

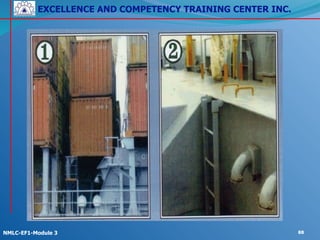

Unsafe Practice
• Is there a risk of injury to personnel?!
• Is there a fire hazard?!

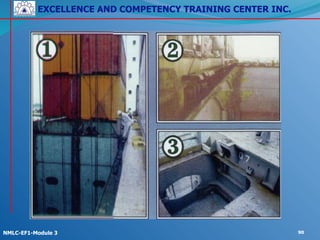

• Does the work being carried out pose a
threat / risk to personnel or
environment?

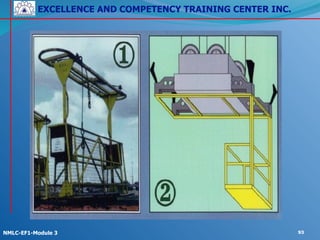

EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 29
Unsafe Practice
• Is there a risk of injury to personnel?!
• Is there a fire hazard?!
• Does the work being carried out pose a threat / risk to personnel or environment?
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 30

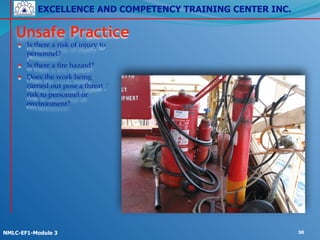

Unsafe Practice
• Is there a risk of injury to
personnel?!

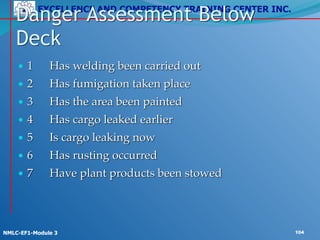

• Is there a fire hazard?!
• Does the work being
carried out pose a threat /
risk to personnel or
environment?
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 31
Unsafe Practice
• Is there a risk of injury to
personnel?!
• Is there a fire hazard?!
• Does the work being carried
out pose a threat / risk to
personnel or environment?
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 32

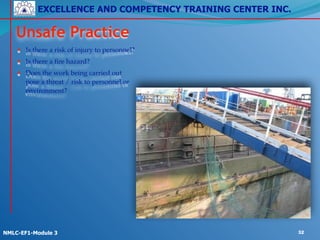

Unsafe Practice
• Is there a risk of injury to personnel?!
• Is there a fire hazard?!
• Does the work being carried out
pose a threat / risk to personnel or
environment?
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 33
Unsafe Practice
• Is there a risk of injury to personnel?!
• Is there a fire hazard?!
• Does the work being carried out
pose a threat / risk to personnel or
environment?
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!

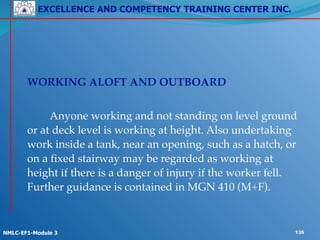

NMLC-EF1-Module 3 34
Unsafe Practice
• Is there a risk of injury to
personnel?!
• Is there a fire hazard?!
• Does the work being carried
out pose a threat / risk to
personnel or environment?
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 35
So what is the concept of Risk
Assessment?

EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3
Hazard
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 37

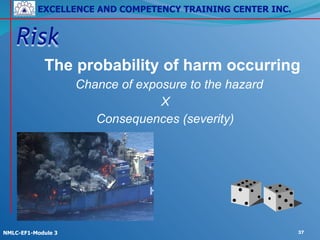

Risk
The probability of harm occurring
Chance of exposure to the hazard
X
Consequences (severity)
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 38
Task or Area Based ?
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 39

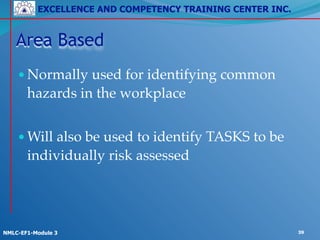

Area Based
•Normally used for identifying common
hazards in the workplace!
!
•Will also be used to identify TASKS to be
individually risk assessed
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 40

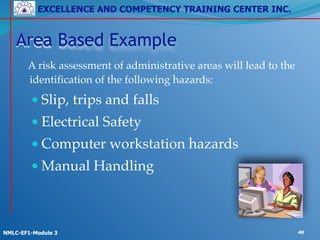

Area Based Example
A risk assessment of administrative areas will lead to the
identification of the following hazards:!
● Slip, trips and falls!
● Electrical Safety!
● Computer workstation hazards!
● Manual Handling
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 41

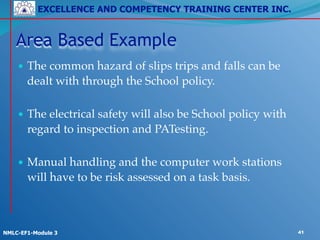

Area Based Example
• The common hazard of slips trips and falls can be
dealt with through the School policy.

• The electrical safety will also be School policy with
regard to inspection and PATesting.

• Manual handling and the computer work stations
will have to be risk assessed on a task basis.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 42

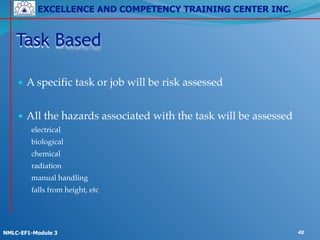

Task Based
!

• A specific task or job will be risk assessed!
!
• All the hazards associated with the task will be assessed!
electrical !
biological !
chemical !
radiation !
manual handling!
falls from height, etc
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 43
5 Steps To Risk Assessment
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3
Step One
Identify the hazards
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3

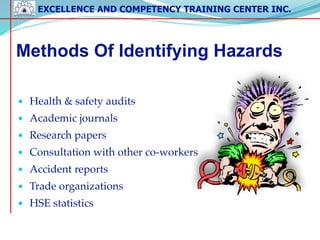

Methods Of Identifying Hazards
• Health & safety audits!
• Academic journals!
• Research papers!
• Consultation with other co-workers!
• Accident reports!
• Trade organizations!
• HSE statistics
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!

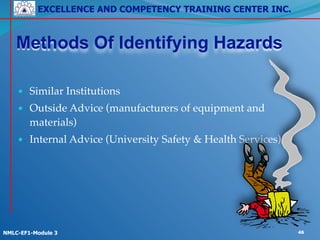

NMLC-EF1-Module 3 46
Methods Of Identifying Hazards
• Similar Institutions!
• Outside Advice (manufacturers of equipment and
materials)!
• Internal Advice (University Safety & Health Services)
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 47
Step Two
Identify who might be
harmed
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 48

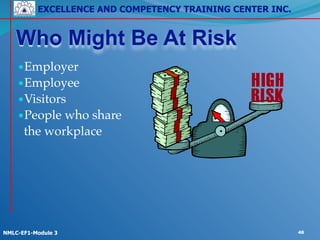

Who Might Be At Risk
•Employer!
•Employee!
•Visitors!
•People who share!
the workplace
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3
49
Step Three
Evaluate the risks
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 50

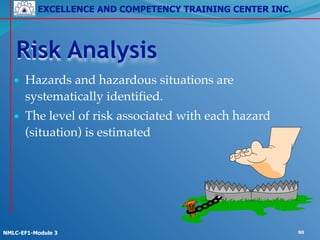

Risk Analysis
• Hazards and hazardous situations are
systematically identified.!
• The level of risk associated with each hazard
(situation) is estimated
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3
Risk Evaluation
• A judgement is made as to whether the level of risk
is acceptable or tolerable!
!
• Will include a judgement on corrective or
preventative measures
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 52

Completing the Risk assessment
Organizing actions and responsibilities to reduce the
hazards and risks to acceptable levels:!
● Elimination of hazard (do I have to do this?)
● Substitution (materials, equipment etc)!
● Physical safeguards (machinery guarding, extraction etc)!
● Personal Protective Equipment!
● Safe working procedures!
● Or any combination of above
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 53
Completing the Risk assessment
Writing safe working procedures or
instructions

●General procedures may be in local rules

●Specific procedures must be included in the risk
assessment
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3
Evaluating The Risks

-some considerations
• Industry standards!
• Legal requirements!
• Precautions already taken!
• Cost (so far as is reasonably practical)
• Different working conditions i.e. weather!
• Numbers of people at risk!
• Severity of injury!
• Probability!
• Length of exposure/frequency
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 55
Step Four
Record your findings
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 56

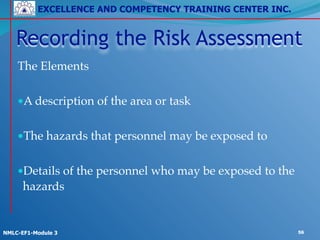

Recording the Risk Assessment
The Elements!
!
●A description of the area or task!
!
●The hazards that personnel may be exposed to!
!
●Details of the personnel who may be exposed to the
hazards
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!

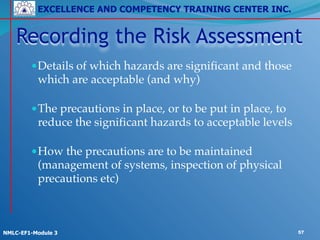

NMLC-EF1-Module 3 57
●Details of which hazards are significant and those
which are acceptable (and why)

●The precautions in place, or to be put in place, to
reduce the significant hazards to acceptable levels

●How the precautions are to be maintained
(management of systems, inspection of physical
precautions etc)
Recording the Risk Assessment
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 58

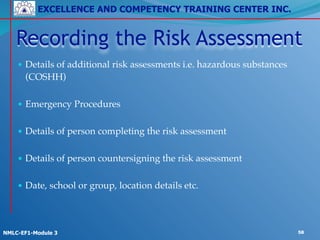

• Details of additional risk assessments i.e. hazardous substances
(COSHH)

• Emergency Procedures

• Details of person completing the risk assessment

• Details of person countersigning the risk assessment

• Date, school or group, location details etc.
Recording the Risk Assessment
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 59

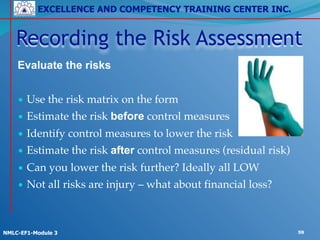

Evaluate the risks !
!
• Use the risk matrix on the form!
• Estimate the risk before control measures!
• Identify control measures to lower the risk!
• Estimate the risk after control measures (residual risk)!
• Can you lower the risk further? Ideally all LOW!
• Not all risks are injury – what about financial loss?
Recording the Risk Assessment
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 60
Consequence
Minor injury or no
apparent injury
Injury requiring first aid
Injury requiring medical
treatment, or with
possible long term
negative health effects
L
i
k
e
l
i
h
o
o
d
Will probably not occur
in most
circumstances
Low Low Medium
May occur in some
circumstances
Low Medium High
Likely to occur in most
circumstances
Medium High High
Recording the Risk Assessment
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 61

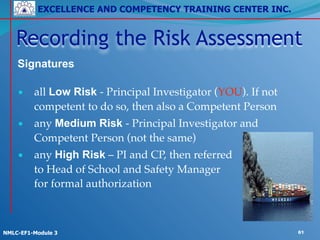

Signatures
!
• all Low Risk - Principal Investigator (YOU). If not
competent to do so, then also a Competent Person!
• any Medium Risk - Principal Investigator and

Competent Person (not the same)!
• any High Risk – PI and CP, then referred

to Head of School and Safety Manager

for formal authorization
Recording the Risk Assessment
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 62
Step Five
Review the assessment
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 63
Legal Summary
The Management of Health and Safety at Work!
Regulations 1999 (amended 2006)!
!
Risk assessment!
3.—(1) Every employer shall make a suitable and sufficient assessment of—

• (a) the risks to the health and safety of his employees to which they are exposed
whilst!
they are at work; and!
• (b) the risks to the health and safety of persons not in his employment arising
out of or!
in connection with the conduct by him of his undertaking,

for the purpose of identifying the measures he needs to take to comply with the
requirements!
and prohibitions imposed upon him by or under the relevant statutory provisions
and by Part!
II of the Fire Precautions (Workplace) Regulations 1997.

EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 64
Risk Assessment Strategy
1.!Identify the hazards!
2.!Evaluate the risks!
3.!Detail the control measures
required to eliminate or reduce to
risks to acceptable levels
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 65
Summary
Recording the significant findings of the risk assessment.!
●What the task is!
●Who is responsible/supervisor!
●Where the risk assessment applies, who is affected!
●List of hazards!
●List of precautions!
●Details of safe working procedures!
●Emergency procedures!
●Reference to other associated risk assessments i.e.
COSHH, manual handling, PPE etc.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 66
Summary
Organizing actions and responsibilities to reduce the
hazards and risks to acceptable levels:!
●Elimination of hazard!
●Reduce by substitution (materials, equipment etc)!
●Physical safeguards (machinery guarding, extraction etc)!
●Personal Protective Equipment!
●Safe working procedures!
●Combination of above
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 67
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 68
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 69
Safe Working Aboard Vessel
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 70
• 1! Dangerous environment!
!
• 2! changing environment!
!
• 3! Variable standards of safety!
!
• 4! Split responsibility!
!
• 5! Human error
Why Do Accidents Happen
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 71
• 1! Dressing for safety!
• 2! Getting aboard safety!
• 3! Reaching the work safely!
• 4! Checking ships equipment and gear!
• 5! Safe access to above-deck stacks!
• 6! Safe working on above-decks stacks!
• 7! Safe access to Holds and safe working.!
• 8! emergencies!
• 9! Finishing work and leaving vessel
Safe Working Aboard Vessel
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 72

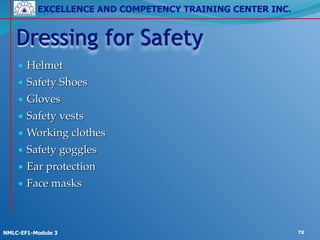

• Helmet!
• Safety Shoes!
• Gloves!
• Safety vests!
• Working clothes!
• Safety goggles!
• Ear protection!
• Face masks
Dressing for Safety
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 73
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 74
• 1! Sound construction!
!
• 2! Safe placing!
!
• 3! Adequate lighting!
!
• 4! Safeguards!
!
• 5! Correct use
Safe Means of Access
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 75

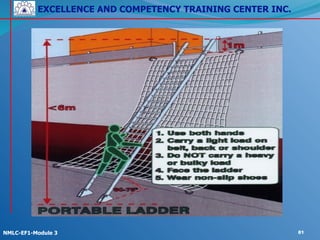

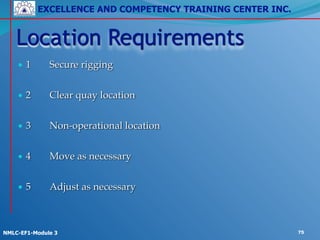

• 1! Secure rigging!
!
• 2! Clear quay location!
!
• 3! Non-operational location!
!
• 4! Move as necessary!
!
• 5! Adjust as necessary
Location Requirements
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 76
• 1! Must be used!
!
• 2! Use both hands!
!
• 3! Do not carry load!
!
• 4! Do not drink alcohol!
!
• 5! Keep clear and clean
Correct Use of Means of
Access
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 77
Various means of Access
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 78
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 79

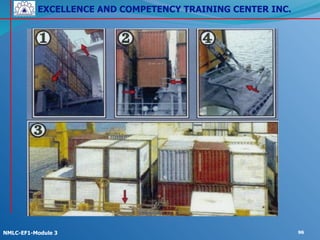

EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 80
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 81
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 82
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 83
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 84
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 85

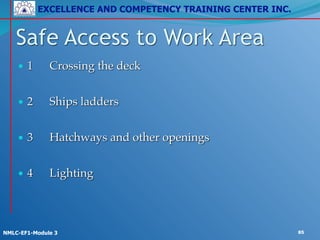

• 1! Crossing the deck!
!
• 2! Ships ladders!
!
• 3! Hatchways and other openings!
!
• 4! Lighting

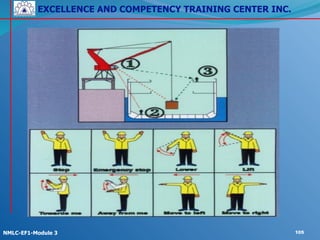

Safe Access to Work Area
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 86
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 87
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 88
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 89
• Red!Prohibition!
!
• Yellow! Warning!
!
• Blue! Mandatory!
!
• Green! Safe
Safety Signs
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 90
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 91
• 1! Lashing cage!
• 2! Gondola!
• 3! Spreader!
• 4! Ladder!
• 5! Lashing platform
Means of Access to Above-
Deck Container Stacks
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 92
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 93
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 94
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 95
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 96
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 97
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 98
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 99
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 100

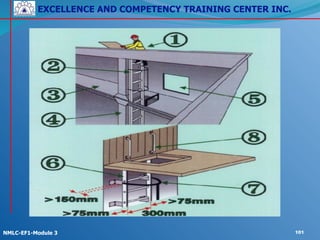

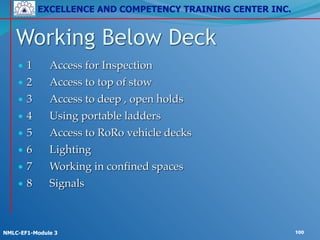

• 1! Access for Inspection!
• 2! Access to top of stow!
• 3! Access to deep , open holds!
• 4! Using portable ladders!
• 5! Access to RoRo vehicle decks!
• 6! Lighting!
• 7! Working in confined spaces!
• 8! Signals
Working Below Deck
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 101
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 102
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 103
• 1! Average level - 20 lux!
• 2! Access routes aboard - 8 lux!
• 3! Higher where necessary!
• 4! Uniform lighting!
• 5! Report defective lights!
• 6! Use temporary lighting where needed!
• 7! Care with cables
Lighting Below Deck
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 104
• 1! Has welding been carried out!
• 2! Has fumigation taken place !
• 3! Has the area been painted!
• 4! Has cargo leaked earlier!
• 5! Is cargo leaking now!
• 6! Has rusting occurred!
• 7! Have plant products been stowed
Danger Assessment Below
Deck
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 105
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 106
• 1! Illness or injury!
!
• 2! Leak of hazardous material!
!
• 3! Fire aboard ship
Emergencies
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 107
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 108
• 1! Leave the area - upwind!
• 2! Investigate the cause and assess the risk!
• 3! Tell the emergency services!
• 4! If you feel dizzy or smell fumes, GET OUT FAST!
• 5! Do NOT rush in if persons collapses!
• 6! Do NOT enter hold with leaker without permission!
• 7! Do NOT take risks
Response to Leaks and Spills
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 109
• Good housekeeping!
!
• Leave the work area!
!
• Leave the vessel
Finishing Work
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 110
!
! HAZARDOUS WORK PERMIT SYSTEMS & LOCKOUT
SYSTEMS!
!
Hazardous Work Permits!
!
! ! The purpose of this module is to provide participants
with the necessary knowledge and understanding to
effectively use Hazardous Work Permit Systems and Lockout
Systems and Lockout Systems. Representatives participating
in this module are encouraged to share their learning
experience with their workgroups in the promotion of, and
participation in, the use of Hazardous Work Permit Systems
and Lockout Systems.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 111
! LEARNING OUTCOME!
!
● Upon successful completion of this module, participants
will be able to:!
● Describe the structure, purpose and provision of both a
Hazardous Work Permit System and a Lockout System.!
● Using the organization’s workplace policies and processes,
use their Hazardous Work Permit System and their
Lockout System in the workplace.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 112

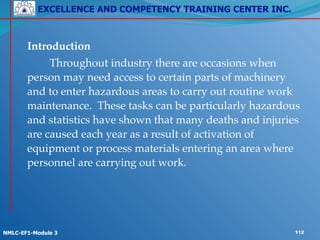

! Introduction!
! ! Throughout industry there are occasions when
person may need access to certain parts of machinery
and to enter hazardous areas to carry out routine work
maintenance. These tasks can be particularly hazardous
and statistics have shown that many deaths and injuries
are caused each year as a result of activation of
equipment or process materials entering an area where
personnel are carrying out work.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 113
! !
! APPLICATION OF THE SYSTEM!
! ! The decision to adopt a Hazardous Work Permit
system for a particular task is one that must be taken
by management and will depend upon the degree of
risk and complexity of the task. The following are
examples of activities where it may ne necessary to
use a hazardous work permit.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 114
● Repair and maintenance of machinery!
● Work on electrical equipment!
● Work in confined spaces !
● Work on chemical plants!
● Hot Work!
● Some other areas that should be considered are:!
● Working at heights!
● Working over the side!
● Working low or high temperatures!
● Working in areas subject to radiation
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 115
!
! Operation of the system!
● Preparation!
● Transfer and acceptance of responsibility!
● Return to Service!
● Responsibility for the issue of permits!
● Employees performing Hazardous Work!
● Lock Out Devices
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 116
!
! METHODS OF ISOLATION!
!
! ! Isolation devices are mechanical devices that physically
prevent the transmission or release of energy. These devices
may include but are not limited to the following!
● A manually operated electrical isolation switch;!
● A pipeline blank or blind;!
● A mechanical block or chock;!
● A manually operated isolation valve.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 117
!

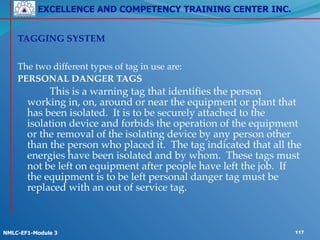

TAGGING SYSTEM!
!
The two different types of tag in use are:!
PERSONAL DANGER TAGS!
! ! This is a warning tag that identifies the person
working in, on, around or near the equipment or plant that
has been isolated. It is to be securely attached to the
isolation device and forbids the operation of the equipment
or the removal of the isolating device by any person other
than the person who placed it. The tag indicated that all the
energies have been isolated and by whom. These tags must
not be left on equipment after people have left the job. If
the equipment is to be left personal danger tag must be
replaced with an out of service tag.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 118
!
! OUT-OF-SERVICES TAGS!
!
! ! This is used to place a faulty or unsafe piece of
equipment out of service. It is also used to prevent
further damage to that plant or equipment!
!
● Note: this does not indicate that the equipment has its
energy isolated. People may not safely work on, in or
around equipment which only has an Out-Of-Service
tag attached.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 119
!
TESTING!
! ! There is a variety of testing that may be carried
out, and under some circumstances such confined
spaces atmosphere, it is mandatory to test. Other
areas of work may require energy or ingress testing.
Whatever tests are carried out is recorded on the
hazardous work permit, identifying what has been
tested, results, by whom and when.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 120
!
! EMERGENCIES!
! ! An area that should always be addressed on a
hazardous work permit is “equipment and
procedures in case of emergencies”. This should be
covered specially for the task to be carried out and
should detail equipment such as rescue procedures,
fire extinguishers and first aid kits, staffing such as
trained standby personnel and procedures.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 121
!
! CONFINED SPACE SAFETY!
!
! ! The purpose of this training module is to provide
participants with the necessary skills and resources to
identify a confined space and to effectively
implement confined space safe work procedures
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 122
! LEARNING OUTCOME!
● Upon successful completion of this module, participants
will be able to:!
● Give a detailed description of what constitutes a Confined
Space.!
● Describe the potential hazards of a confined space.!
● State the upper and lower limits of oxygen levels.!
● Understand the requirements of a confines space entry
permit.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 123
!
INTRODUCTION!
! ! Confined spaces present unique occupational health
and safety problems, because of hazards that may not be
readily apparent. Confined spaces usually have poor
ventilation and may be of small volume, allowing hazardous
atmospheres to accumulate quickly. Work in confined spaces
ca increase the risk of injury or death by making employees
work closer to hazards than they would otherwise, or by
creating additional hazards such as engulfment.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 124
! !
!
! ! Persons entering confined spaces to perform
work related tasks may be unaware that they are
entering a potentially hazardous work environment.
Many hazards, such as toxic gases and vapours, can
be concentrated in confined spaces.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 125
!

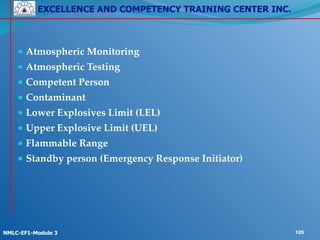

● Atmospheric Monitoring!
● Atmospheric Testing!
● Competent Person!
● Contaminant!
● Lower Explosives Limit (LEL)!
● Upper Explosive Limit (UEL)!
● Flammable Range!
● Standby person (Emergency Response Initiator)
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 126

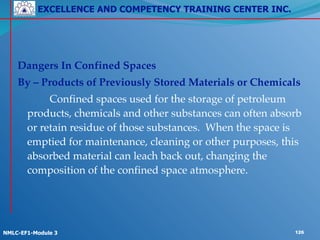

Dangers In Confined Spaces!
By – Products of Previously Stored Materials or Chemicals!
! ! Confined spaces used for the storage of petroleum
products, chemicals and other substances can often absorb
or retain residue of those substances. When the space is
emptied for maintenance, cleaning or other purposes, this
absorbed material can leach back out, changing the
composition of the confined space atmosphere.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 127
!
● Incidental leaks or spills!
● Chemical Reaction!
● Oxidation!
● Mechanical Operations!
● Inerting Activities!
● Atmospheric Hazards!
● Oxygen Deficiency!
● Oxygen Enrichment
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 128

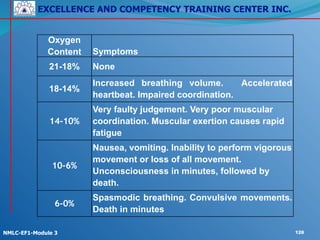

Oxygen
Content Symptoms
21-18% None
18-14%
Increased breathing volume. Accelerated
heartbeat. Impaired coordination.
14-10%
Very faulty judgement. Very poor muscular
coordination. Muscular exertion causes rapid
fatigue
10-6%
Nausea, vomiting. Inability to perform vigorous
movement or loss of all movement.
Unconsciousness in minutes, followed by
death.
6-0%
Spasmodic breathing. Convulsive movements.
Death in minutes
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 129
! !
!

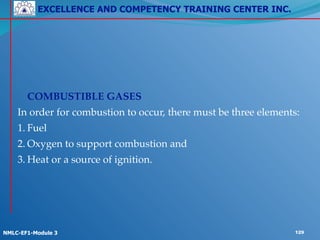

! COMBUSTIBLE GASES!
In order for combustion to occur, there must be three elements:!
1.!Fuel!
2.!Oxygen to support combustion and !
3.!Heat or a source of ignition.!

EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 130
!
● Toxic Gases !
● Carbon Monoxide (CO)!
● Hydrogen Sulphide (H2S)!
● Sulphur Dioxide (SO2)!
● Ammonia (NH3)!
● Hydrogen Cyanide or Hydrocyanic Acid (HCN)!
● Aromatic Hydrocarbons (i.e. Benzene, Toluene, Xylene)
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 131
! Confined Space Entry Permits and Hazardous Work
Permits!
!
! ! To deal with entry into, and working within a confined
space, a system has been devised where a well-planned
procedure for entering and working in each confined space
has been set out in a “permit or work” document. This
document list the work to be done, the precautions necessary,
and the sequence of actions, which will make the job safe.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 132
!
! ASSESSMENT OF RISK!
! ! In order to ensure that the hazards and risks of each
confined space entry are identified, a competent person must
always make a preliminary assessment of the space to be
entered. Previous hazard identifications contained in
documents such as planned maintenance schedules of spaces
under consideration, previously completed hazard
identification risk assessments for the activity or task in hand,
or workplace contingency plans may be of assistance in
determining the hazards for the entry under consideration.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 133
! !
! RESCUE AND FIRST AID!
! ! The most common emergency in a confined space
involves a toxic atmosphere or one that is oxygen deficient or
oxygen enriched. In these emergencies extraction of the
victim is only secondary priority. It is more important (and a
lot easier) to supply them with oxygen or at least breathable
air. Inherent in any confined space entry procedure should be
an associated program for emergency rescue and evacuation.!
! !
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 134
!

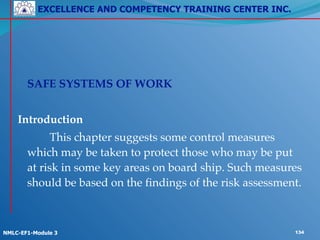

! SAFE SYSTEMS OF WORK!
!
Introduction!
! ! This chapter suggests some control measures
which may be taken to protect those who may be put
at risk in some key areas on board ship. Such measures
should be based on the findings of the risk assessment.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 135
!
! WORKING ALOFT AND OUTBOARD!
!
! ! Anyone working and not standing on level ground
or at deck level is working at height. Also undertaking
work inside a tank, near an opening, such as a hatch, or
on a fixed stairway may be regarded as working at
height if there is a danger of injury if the worker fell.
Further guidance is contained in MGN 410 (M+F).
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 136
! ! PORTABLE LADDERS!
!
! ! A portable ladder should only be used where no
safer means of access is reasonably practicable. It is
very important that the ladder is checked regularly
by a competent person. Annex A (reproduced from
MGN 410) gives further guidance.!
! !
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 137
! ! Wooden ladders should not be painted or treated
so as to hide defects and cracks. When not in use they
should be stowed safely in a dry ventilated space
away from any heat source.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 138
! ! CRADLES AND STAGES!
!
! ! Cradles should be at least 430 mm (17 inches) wide
and fitted with guard rails or stanchions with taut
ropes to a height of one metre (39 inches) from the
floor. Toe boards add safety. Annex C (reproduced from
MGN 410) gives further guidance.!
! !
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 139
! ! Planks and materials used for the construction of
ordinary plank stages must be carefully examined to
ensure adequate strength and freedom from defect.!
 ! ! Wooden components of staging should be
stowed in a dry, ventilated space and not subjected to
heat.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 140
! BOSUN’S CHAIR!
!
! ! When used with a gantline the chair should be
secured to it with a double sheet bend and the end
seized to the standing part with adequate tail. Annex
C (reproduced from MGN 410) gives further
guidance.!
! !
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 141
! ! Hooks should not be used to secure bosun’s
chairs unless they are of the type which because of
their special construction cannot be accidentally
dislodged, and have a marked safe working load
which is adequate for the purpose.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 142
! WORKING FROM PUNTS!
 !
! ! Punts should be stable and provided with suitable fencing.
Unsecured trestles and planks should not be used to give
additional height.!
! ! The duty engineer and deck officers should also be informed
by the person in charge when seamen are working below ship’s
side discharges so they are not used until the work is completed.
Notices to this effect should be attached to the relevant control
valves and not taken off until those working are reported clear.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 143

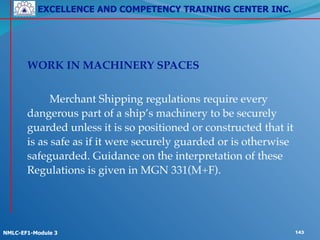

! WORK IN MACHINERY SPACES!
!
! ! Merchant Shipping regulations require every
dangerous part of a ship’s machinery to be securely
guarded unless it is so positioned or constructed that it
is as safe as if it were securely guarded or is otherwise
safeguarded. Guidance on the interpretation of these
Regulations is given in MGN 331(M+F).!
! !
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 144

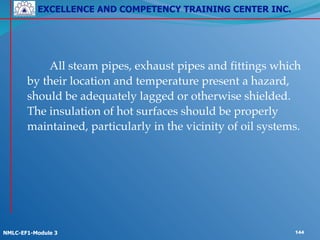

! ! All steam pipes, exhaust pipes and fittings which
by their location and temperature present a hazard,
should be adequately lagged or otherwise shielded.
The insulation of hot surfaces should be properly
maintained, particularly in the vicinity of oil systems.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 145
! !
!
BOILERS!
! ! A notice should be displayed at each boiler
setting out operating instructions. Information
provided by the manufacturers of the oil-burning
equipment should be displayed in the boiler room.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 146
! UNMANNED MACHINERY SPACES!
!
! ! Personnel should never enter or remain in an
unmanned machinery space alone, unless they have
received permission from, or been instructed by the
engineer officer in charge at the time. They may only
be sent to carry out a specific task which they may be
expected to complete in a comparatively short time.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 147
! ! Before entering the space, at regular intervals
whilst in the space and on leaving the space, they
must report by telephone, or other means provided,
to the duty deck officer. Before they enter the space
the method of reporting should be clearly explained.
Consideration should be given in appropriate
instances to using a ‘permit-to-work’
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 148
! !
REFRIGERATION MACHINERY!
!
! ! Adequate information should be available on each
vessel, laying down the operation and maintenance
safeguards of the refrigeration plant, the particular
properties of the refrigerant and the precautions for its safe
handling.!
! !
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 149
! ! Should it be known or suspected that the
refrigerant has leaked into any compartments, no
attempt should be made to enter those compartments
until a responsible officer has been advised of the
situation.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 150
! !

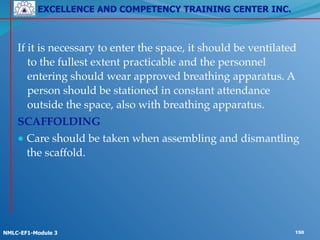

If it is necessary to enter the space, it should be ventilated
to the fullest extent practicable and the personnel
entering should wear approved breathing apparatus. A
person should be stationed in constant attendance
outside the space, also with breathing apparatus.!
SCAFFOLDING!
● Care should be taken when assembling and dismantling
the scaffold.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 151

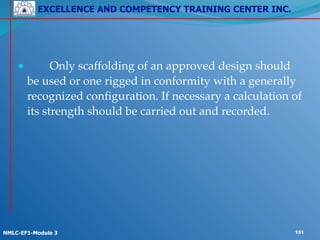

● ! Only scaffolding of an approved design should
be used or one rigged in conformity with a generally
recognized configuration. If necessary a calculation of
its strength should be carried out and recorded.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 152
● Requirements for Ladders!
● Requirements for Scaffolding!
ANNEX C!
REQUIREMENTS FOR ROPE ACCESS AND POSITIONING
TECHNIQUES!
!
CHAPTER 16!
PERMIT TO WORK SYSTEMS!
Introduction!
! ! Based on the findings of the risk assessment, appropriate control
measures should be put into place to protect those who may be
affected. This Chapter covers permits to work, which are suggested
control measures for particular operations.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 153

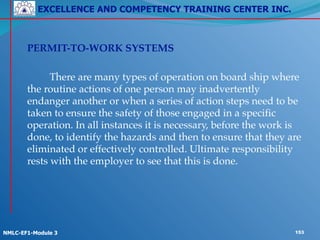

! PERMIT-TO-WORK SYSTEMS!
!
! ! There are many types of operation on board ship where
the routine actions of one person may inadvertently
endanger another or when a series of action steps need to be
taken to ensure the safety of those engaged in a specific
operation. In all instances it is necessary, before the work is
done, to identify the hazards and then to ensure that they are
eliminated or effectively controlled. Ultimate responsibility
rests with the employer to see that this is done.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 154
! SANCTIONS-TO-TEST SYSTEMS!
!
! ! A sanction-to-test shall be issued in an identical
manner to a permit-to-work. A sanction-to-test shall not be
issued on any apparatus on which a permit-to-work is still
in force, or on which another sanction-to-test is in force.!
! ! A sanction-to-test is to be issued where testing
operations require the removal of the circuit Main Earth.
Note: Maintenance and repair cannot be carried out under
a sanction-to-test.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 155
CHAPTER 17!
ENTERING ENCLOSED OR CONFINED !
SPACES!
!
INTRODUCTION!
! ! Based on the findings of the risk assessment, appropriate
control measures should be put into place to protect those
who may be affected. This Chapter highlights suggested
control measures for entry into enclosed or confined spaces.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 156
! ! !
! ! The Regulations define a “Dangerous Space” as:
“Any enclosed or confined space in which it is
foreseeable that the atmosphere may at some stage
contain toxic or flammable gases or vapours, or be
deficient in oxygen, to the extent that it may
endanger the life or health of any person entering
that space”.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 157
! ! !
!

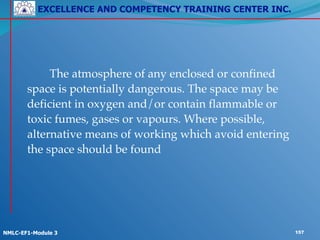

! ! The atmosphere of any enclosed or confined
space is potentially dangerous. The space may be
deficient in oxygen and/or contain flammable or
toxic fumes, gases or vapours. Where possible,
alternative means of working which avoid entering
the space should be found
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 158
!

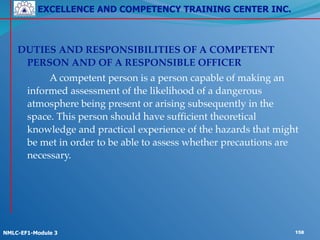

DUTIES AND RESPONSIBILITIES OF A COMPETENT
PERSON AND OF A RESPONSIBLE OFFICER!
! ! A competent person is a person capable of making an
informed assessment of the likelihood of a dangerous
atmosphere being present or arising subsequently in the
space. This person should have sufficient theoretical
knowledge and practical experience of the hazards that might
be met in order to be able to assess whether precautions are
necessary.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 159
!
IDENTIFYING POTENTIAL HAZARDS
OXYGEN DEFICIENCY!
If an empty tank or other confined space has been closed for a
time the oxygen content may have been reduced owing to a
number of reasons:!
● Rusting may have occurred due to oxygen combining with steel.!
● Oxygen absorbing chemicals may have been present.!
● Oxygen absorbing cargoes may have been carried or gases from
volatile cargoes may have displaced the oxygen in tanks.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 160
!
● Hydrogen may have been produced in a cathodically-
protected cargo tank used for ballast.!
● Oxygen may have been displaced by the use of
carbon dioxide or other fire-extinguishing or -
preventing media, or inert gas in the tanks or inter-
barrier spaces of tankers or gas carriers.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 161

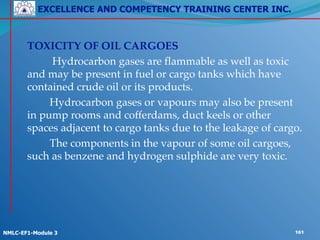

! TOXICITY OF OIL CARGOES!
! ! Hydrocarbon gases are flammable as well as toxic
and may be present in fuel or cargo tanks which have
contained crude oil or its products.!
! ! Hydrocarbon gases or vapours may also be present
in pump rooms and cofferdams, duct keels or other
spaces adjacent to cargo tanks due to the leakage of cargo.!
! ! The components in the vapour of some oil cargoes,
such as benzene and hydrogen sulphide are very toxic.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 162
! !
TOXICITY OF OTHER SUBSTANCES!
! ! Cargoes carried in chemical tankers or gas
carriers may be toxic.!
! ! There is the possibility of leakage from drums of
chemicals or other packages of dangerous goods
where there has been mishandling or incorrect
stowage or damage due to heavy weather.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 163
! ! !
! FLAMMABILITY!
!
! ! Flammable vapours may still be present in cargo or
other tanks that have contained oil products or chemical or
gas cargoes.!
! ! Cofferdams and other spaces that are adjacent to
cargo and other tanks may contain flammable vapours
should there have been leakage into the space.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 164
!
PREPARING AND SECURING THE SPACE FOR
ENTRY!
! ! When opening the entrance to a potentially
dangerous space, precautions should be taken in case
pressurized or unpressurised vapour or gases are
released from the space.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 165
! ! !
!

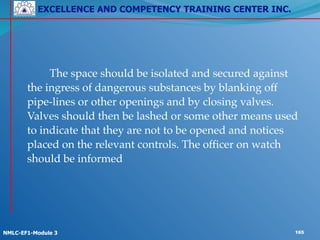

! ! The space should be isolated and secured against
the ingress of dangerous substances by blanking off
pipe-lines or other openings and by closing valves.
Valves should then be lashed or some other means used
to indicate that they are not to be opened and notices
placed on the relevant controls. The officer on watch
should be informed
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 166
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 167
! ! !
! TESTING THE ATMOSPHERE OF THE SPACE!
!
! ! Testing of a space should be carried out only by persons
trained in the use of the equipment.!
! ! Personal monitoring equipment is designed for personal use
only, to provide a warning against oxygen deficiency, toxic gases
and explosive atmospheres whilst the wearer is in the space. This
should not be used as a means of determining whether a
dangerous space is safe prior to entry.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 168
! ! !
! ! TESTING FOR OXYGEN DEFICIENCY!
!
! ! A steady reading of at least 20% oxygen by
volume on an oxygen content meter should be
obtained before entry is permitted. A combustible gas
indicator cannot be used to detect oxygen deficiency.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 169

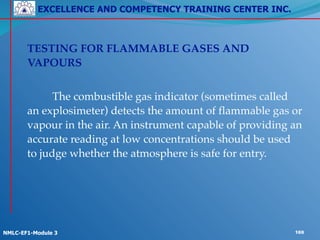

! TESTING FOR FLAMMABLE GASES AND
VAPOURS!
!
! ! The combustible gas indicator (sometimes called
an explosimeter) detects the amount of flammable gas or
vapour in the air. An instrument capable of providing an
accurate reading at low concentrations should be used
to judge whether the atmosphere is safe for entry.!
! !
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 170
! ! Combustible gas detectors are calibrated on a
standard gas. When testing for other gases and
vapors reference should be made to the calibration
curves supplied with the instrument. Particular care
is required should accumulations of hydrogen be
suspected.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 171
! TESTING FOR TOXIC GASES!
!
! ! The presence of certain gases and vapours on
chemical tankers and gas carriers is detected by fixed or
portable gas or vapour detection equipment. The
readings obtained by this equipment should be compared
with the occupational exposure limits for the contaminant
given in international industry safety guides or the latest
edition of the Health and Safety Executive Guidance Note
EH-40 Occupational Exposure Limits.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 172
! ! !
!

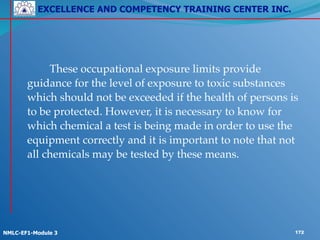

! ! These occupational exposure limits provide
guidance for the level of exposure to toxic substances
which should not be exceeded if the health of persons is
to be protected. However, it is necessary to know for
which chemical a test is being made in order to use the
equipment correctly and it is important to note that not
all chemicals may be tested by these means.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 173
!
! USE OF CONTROL SYSTEMS!
!
! For situations for which a well established safe system
of work exists a check-list may exceptionally be
accepted as an alternative to a full ‘permit-to-work’
provided that the principles of the ‘permit-to-work’
system are covered and the risks arising in the
dangerous space are low.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 174
! ! !
PROCEDURES AND ARRANGEMENTS BEFORE Entry!
! ! Before entry is permitted it should be established that
entry with breathing apparatus is possible. Any difficulty
of movement within any part of the space, or any
problems if any incapacitated person had to be removed
from the space, as a result of breathing apparatus or
lifelines or rescue harnesses being used, should be
considered and any risks minimized.!
! !
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 175
! ! Lifelines should be long enough for the purpose
and capable of being firmly attached to the harness,
but the wearer should be able to detach them easily
should they become tangled.!
Procedures and Arrangements During Entry!
! ! Ventilation should continue during the period
that the space is occupied and during temporary
breaks.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 176
!

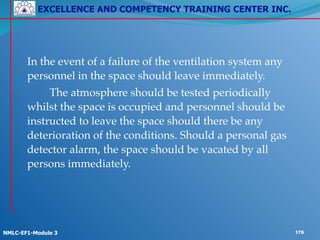

! In the event of a failure of the ventilation system any
personnel in the space should leave immediately.!
! ! The atmosphere should be tested periodically
whilst the space is occupied and personnel should be
instructed to leave the space should there be any
deterioration of the conditions. Should a personal gas
detector alarm, the space should be vacated by all
persons immediately.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 177
!

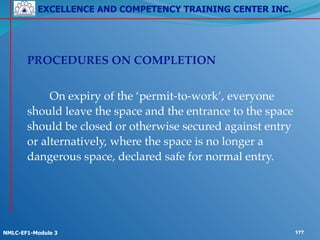

! PROCEDURES ON COMPLETION!
!
! ! On expiry of the ‘permit-to-work’, everyone
should leave the space and the entrance to the space
should be closed or otherwise secured against entry
or alternatively, where the space is no longer a
dangerous space, declared safe for normal entry.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 178
! ! !
! ! TRAINING, INSTRUCTION AND INFORMATION!
!
Employers should provide any necessary training, instruction
and information to employees in order to ensure that the
requirements of the Entry into Dangerous Spaces
Regulations are complied with. This should include:!
● recognition of the circumstances and activities likely to lead
to the presence of a dangerous atmosphere,
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 179
!
● the hazards associated with entry into dangerous
spaces, and the precautions to be taken,!
● the use and maintenance of equipment and clothing
required for entry into dangerous spaces,!
● instruction and drills in rescue from dangerous spaces.!
● instruction and drills in rescue from dangerous spaces.!
!
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 180
Breathing Apparatus and Resuscitation Equipment !
! ! No one should enter a space where the
atmosphere is unsafe or suspect without wearing
breathing apparatus which they are trained to use,
even to rescue another person.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 181
!
!

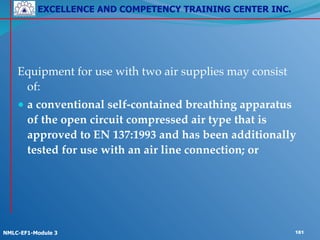

Equipment for use with two air supplies may consist
of:!
● a conventional self-contained breathing apparatus
of the open circuit compressed air type that is
approved to EN 137:1993 and has been additionally
tested for use with an air line connection; or
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 182
● ! a compressed air line breathing apparatus
incorporating an emergency self-contained supply.
The compressed air line breathing apparatus should
be of the demand valve type and should be
approved to EN 139:1995, or for self-rescue
purposes, to BS 1146: 1997 (or equivalent Standard).
The emergency self-contained supply should
comply with the relevant parts of the appropriate
Standard.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 183
! ! The capacity of the self-contained supply
should be sufficient for the wearer to escape to a
safe atmosphere. When determining this capacity it
should be recognized that, under stress or in
difficult conditions, the wearer’s breathing rate may
be in excess of the nominal breathing rate of 40
liters per minute.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 184

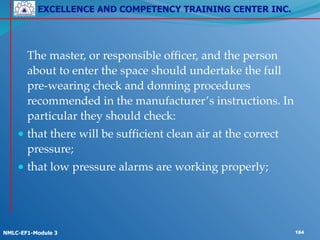

! The master, or responsible officer, and the person
about to enter the space should undertake the full
pre-wearing check and donning procedures
recommended in the manufacturer’s instructions. In
particular they should check:!
● that there will be sufficient clean air at the correct
pressure;!
● that low pressure alarms are working properly;
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 185
! !
● ! that the facemask fits correctly against the user’s
face so that, combined with pressure of the air
coming into the mask, there will not be an ingress of
oxygen deficient air or toxic vapours when the user
inhales. It should be noted that facial hair or
spectacles may prevent the formation of an air-tight
seal between a person’s face and the facemask;
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 186
● that the wearer of the breathing apparatus understands
whether or not their air supply may be shared with
another person and if so is also aware that such
procedures should only be used in an extreme
emergency;!
● that when work is being undertaken in the space the
wearer should keep the self-contained supply for use
when there is a failure of the continuous supply from
outside the space
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 187
! !
!

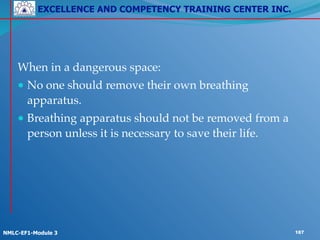

When in a dangerous space:!
● No one should remove their own breathing
apparatus.!
● Breathing apparatus should not be removed from a
person unless it is necessary to save their life.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 188
! MAINTENANCE OF EQUIPMENT FOR ENTRY INTO
DANGEROUS SPACES !
!
! ! All breathing apparatus, rescue harnesses, lifelines,
resuscitation equipment and any other equipment provided
for use in, or in connection with, entry into dangerous spaces,
or for use in emergencies, should be properly maintained,
inspected periodically and checked for correct operation by a
competent person and a record of the inspections and checks
should be kept. All items of breathing apparatus should be
inspected for correct operation before and after use.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 189
CHAPTER 4!
PERSONAL PROTECTIVE EQUIPMENT!
!
Introduction!
! ! Risks to the health and safety of workers must be
identified and assessed. It will often not be possible to
remove all risks, but attention should be given to control
measures which make the working environment and
working methods as safe as reasonably practicable.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 190
● Employer duties!
! ! It is the responsibility of the employer to ensure
that workers are provided with suitable personal
protective equipment where it is needed.!
● Worker duties!
! ! Workers must wear the protective equipment or
clothing supplied when they are carrying out a task for
which it is provided, and follow appropriate
instructions for use.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 191
TYPES OF EQUIPMENT!
! ! Overalls, gloves and suitable footwear are the proper
working dress for most work about ship but these may not
give adequate protection against particular hazards !
!
HEAD PROTECTION!
● Safety Helmets! !
● Bump caps!
● Hair nets and safety caps
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 192
!
! HEARING PROTECTION!
! ! All persons exposed to high levels of noise, eg in
machinery spaces, should wear ear protection of a type
recommended as suitable for the particular
circumstances. Protectors are of three types - ear plugs,
disposable or permanent, and ear muffs. For further
information see the Code of Practice Noise Levels in
Ships, published by the Department of Transport (1990).
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 193
!
! FACE AND EYE PROTECTION!
!
The main causes of eye injury are:!
● infra-red rays - gas welding;!
● ultra-violet rays - electric welding;!
● exposure to chemicals;!
● exposure to particles and foreign bodies
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 194
! !
RESPIRATORY PROTECTIVE EQUIPMENT!
! ! Respiratory protective equipment is essential for
protection when work has to be done in conditions of irritating,
dangerous or poisonous dust, fumes or gases. There are two
main types of equipment which perform different functions:!
● a respirator filters the air before it is inhaled;!
● breathing apparatus supplies air or oxygen from an
uncontaminated source.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 195
!
● BREATHING APPARATUS!
! ! Breathing apparatus should not be used underwater
unless the equipment is suitable for the purpose, and then
only in an emergency.!
!
● RESUSCITATORS!
! ! It is recommended that resuscitators of an appropriate
kind should be provided when any person may be required
to enter a dangerous space
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 196
!

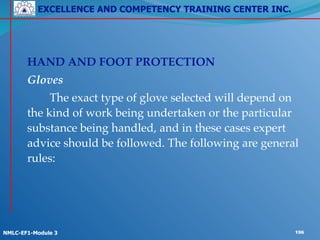

! HAND AND FOOT PROTECTION !
! Gloves!
! ! The exact type of glove selected will depend on
the kind of work being undertaken or the particular
substance being handled, and in these cases expert
advice should be followed. The following are general
rules:
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 197
● Leather gloves should generally be used when
handling rough or sharp objects.!
● Heat-resistant gloves should be used when handling
hot objects.!
● Rubber, synthetic or PVC gloves are generally best
for handling acids, alkalis, various types of oils,
solvents and chemicals in general.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 198
! !
FOOTWEAR!
! ! Foot injuries most often result from the wearing
of unsuitable footwear (e.g. sandals, plimsolls and
flip-flops) rather than from failure to wear safety
shoes and boots. It is nevertheless strongly advisable
that all personnel whilst at work on board ship wear
appropriate safety footwear.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 199
!
! PROTECTION FROM FALLS!
!
! !   All personnel who are working aloft, outboard or
below decks or in any other area where there is a risk of
falling more than two metres, should wear a safety
harness (or belt with shock absorber) attached to a lifeline.
If a vessel is shipping frequent seas, nobody should be
required to work on deck unless absolutely necessary.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 200
! ! However, where this is unavoidable, persons on
deck should wear a harness and, where practicable,
should be secured by lifeline as a protection from
falls and from being washed overboard or against the
ship’s structure.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 201
!
!

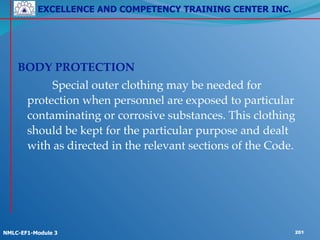

BODY PROTECTION!
! ! Special outer clothing may be needed for
protection when personnel are exposed to particular
contaminating or corrosive substances. This clothing
should be kept for the particular purpose and dealt
with as directed in the relevant sections of the Code.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 202
! PROTECTION AGAINST DROWNING!
!
! ! Where work is being carried out over-side or in an
exposed position where there is a reasonably foreseeable
risk of falling or being washed overboard or where work is
being carried out in or from a ship’s boat a lifebuoy with
sufficient line should be provided. In addition and as
appropriate a lifejacket or buoyancy aid should be provided.
Where necessary, personnel should be provided with
thermal protective clothing to reduce the risks of cold shock.
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 203
EXCELLENCE AND COMPETENCY TRAINING CENTER INC.
!
!
NMLC-EF1-Module 3 204

Nmlc ef3 module 3

  • 1.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 1 Function 3: Marine Engineering at the Management Level
  • 2.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 2 MODULE 1 - Manage safe and effective maintenance and repair procedures.! ! MODULE 2 - Detect and identify the cause of machinery malfunctions and correct faults.! ! MODULE 3 - Ensure safe working practice. COVERAGE:
  • 3.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 3 Safe Working Practices on Board of Vessels
  • 4.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 4
  • 5.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 5 Risk Assessments • You have carefully thought out all the angles! • You have done it a hundred times! • It comes naturally to you! • You know what you are doing, it is what you have been trained to do all your life! • So nothing could possibly go wrong
 •Could it ??
  • 6.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 6 Think Again!
  • 7.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 7 No beavers were actually injured during the creation of this slides presentation! :-)
  • 8.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 8 ! ! “A systematic evaluation of the work place and/or other activities which identifies the hazards present and gives an estimate of the extent of the risks involved” Risk Assessments
  • 9.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 9
  • 10.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 10
  • 11.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 11
  • 12.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 12
  • 13.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 13
  • 14.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 14
  • 15.

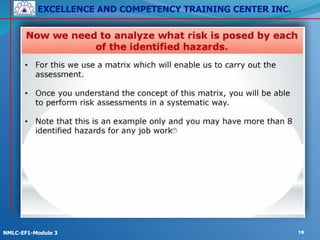

    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 15
  • 16.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 16
  • 17.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 17
  • 18.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 18
  • 19.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 19
  • 20.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 20
  • 21.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 21
  • 22.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 22
  • 23.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 23
  • 24.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 24
  • 25.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 25
  • 26.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 26
  • 27.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 27
  • 28.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 28 Unsafe Practice • Is there a risk of injury to personnel?! • Is there a fire hazard?! • Does the work being carried out pose a threat / risk to personnel or environment?
  • 29.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 29 Unsafe Practice • Is there a risk of injury to personnel?! • Is there a fire hazard?! • Does the work being carried out pose a threat / risk to personnel or environment?
  • 30.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 30 Unsafe Practice • Is there a risk of injury to personnel?! • Is there a fire hazard?! • Does the work being carried out pose a threat / risk to personnel or environment?
  • 31.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 31 Unsafe Practice • Is there a risk of injury to personnel?! • Is there a fire hazard?! • Does the work being carried out pose a threat / risk to personnel or environment?
  • 32.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 32 Unsafe Practice • Is there a risk of injury to personnel?! • Is there a fire hazard?! • Does the work being carried out pose a threat / risk to personnel or environment?
  • 33.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 33 Unsafe Practice • Is there a risk of injury to personnel?! • Is there a fire hazard?! • Does the work being carried out pose a threat / risk to personnel or environment?
  • 34.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 34 Unsafe Practice • Is there a risk of injury to personnel?! • Is there a fire hazard?! • Does the work being carried out pose a threat / risk to personnel or environment?
  • 35.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 35 So what is the concept of Risk Assessment?
  • 36.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 Hazard
  • 37.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 37 Risk The probability of harm occurring Chance of exposure to the hazard X Consequences (severity)
  • 38.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 38 Task or Area Based ?
  • 39.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 39 Area Based •Normally used for identifying common hazards in the workplace! ! •Will also be used to identify TASKS to be individually risk assessed
  • 40.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 40 Area Based Example A risk assessment of administrative areas will lead to the identification of the following hazards:! ● Slip, trips and falls! ● Electrical Safety! ● Computer workstation hazards! ● Manual Handling
  • 41.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 41 Area Based Example • The common hazard of slips trips and falls can be dealt with through the School policy.
 • The electrical safety will also be School policy with regard to inspection and PATesting.
 • Manual handling and the computer work stations will have to be risk assessed on a task basis.
  • 42.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 42 Task Based ! • A specific task or job will be risk assessed! ! • All the hazards associated with the task will be assessed! electrical ! biological ! chemical ! radiation ! manual handling! falls from height, etc
  • 43.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 43 5 Steps To Risk Assessment
  • 44.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 Step One Identify the hazards
  • 45.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 Methods Of Identifying Hazards • Health & safety audits! • Academic journals! • Research papers! • Consultation with other co-workers! • Accident reports! • Trade organizations! • HSE statistics
  • 46.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 46 Methods Of Identifying Hazards • Similar Institutions! • Outside Advice (manufacturers of equipment and materials)! • Internal Advice (University Safety & Health Services)
  • 47.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 47 Step Two Identify who might be harmed
  • 48.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 48 Who Might Be At Risk •Employer! •Employee! •Visitors! •People who share! the workplace
  • 49.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 49 Step Three Evaluate the risks
  • 50.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 50 Risk Analysis • Hazards and hazardous situations are systematically identified.! • The level of risk associated with each hazard (situation) is estimated
  • 51.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 Risk Evaluation • A judgement is made as to whether the level of risk is acceptable or tolerable! ! • Will include a judgement on corrective or preventative measures
  • 52.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 52 Completing the Risk assessment Organizing actions and responsibilities to reduce the hazards and risks to acceptable levels:! ● Elimination of hazard (do I have to do this?) ● Substitution (materials, equipment etc)! ● Physical safeguards (machinery guarding, extraction etc)! ● Personal Protective Equipment! ● Safe working procedures! ● Or any combination of above
  • 53.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 53 Completing the Risk assessment Writing safe working procedures or instructions
 ●General procedures may be in local rules
 ●Specific procedures must be included in the risk assessment
  • 54.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 Evaluating The Risks
 -some considerations • Industry standards! • Legal requirements! • Precautions already taken! • Cost (so far as is reasonably practical) • Different working conditions i.e. weather! • Numbers of people at risk! • Severity of injury! • Probability! • Length of exposure/frequency
  • 55.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 55 Step Four Record your findings
  • 56.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 56 Recording the Risk Assessment The Elements! ! ●A description of the area or task! ! ●The hazards that personnel may be exposed to! ! ●Details of the personnel who may be exposed to the hazards
  • 57.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 57 ●Details of which hazards are significant and those which are acceptable (and why)
 ●The precautions in place, or to be put in place, to reduce the significant hazards to acceptable levels
 ●How the precautions are to be maintained (management of systems, inspection of physical precautions etc) Recording the Risk Assessment
  • 58.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 58 • Details of additional risk assessments i.e. hazardous substances (COSHH)
 • Emergency Procedures
 • Details of person completing the risk assessment
 • Details of person countersigning the risk assessment
 • Date, school or group, location details etc. Recording the Risk Assessment
  • 59.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 59 Evaluate the risks ! ! • Use the risk matrix on the form! • Estimate the risk before control measures! • Identify control measures to lower the risk! • Estimate the risk after control measures (residual risk)! • Can you lower the risk further? Ideally all LOW! • Not all risks are injury – what about financial loss? Recording the Risk Assessment
  • 60.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 60 Consequence Minor injury or no apparent injury Injury requiring first aid Injury requiring medical treatment, or with possible long term negative health effects L i k e l i h o o d Will probably not occur in most circumstances Low Low Medium May occur in some circumstances Low Medium High Likely to occur in most circumstances Medium High High Recording the Risk Assessment
  • 61.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 61 Signatures ! • all Low Risk - Principal Investigator (YOU). If not competent to do so, then also a Competent Person! • any Medium Risk - Principal Investigator and
 Competent Person (not the same)! • any High Risk – PI and CP, then referred
 to Head of School and Safety Manager
 for formal authorization Recording the Risk Assessment
  • 62.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 62 Step Five Review the assessment
  • 63.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 63 Legal Summary The Management of Health and Safety at Work! Regulations 1999 (amended 2006)! ! Risk assessment! 3.—(1) Every employer shall make a suitable and sufficient assessment of—

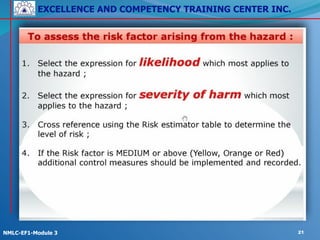

 • (a) the risks to the health and safety of his employees to which they are exposed whilst! they are at work; and! • (b) the risks to the health and safety of persons not in his employment arising out of or! in connection with the conduct by him of his undertaking,
 for the purpose of identifying the measures he needs to take to comply with the requirements! and prohibitions imposed upon him by or under the relevant statutory provisions and by Part! II of the Fire Precautions (Workplace) Regulations 1997.

  • 64.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 64 Risk Assessment Strategy 1.!Identify the hazards! 2.!Evaluate the risks! 3.!Detail the control measures required to eliminate or reduce to risks to acceptable levels
  • 65.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 65 Summary Recording the significant findings of the risk assessment.! ●What the task is! ●Who is responsible/supervisor! ●Where the risk assessment applies, who is affected! ●List of hazards! ●List of precautions! ●Details of safe working procedures! ●Emergency procedures! ●Reference to other associated risk assessments i.e. COSHH, manual handling, PPE etc.
  • 66.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 66 Summary Organizing actions and responsibilities to reduce the hazards and risks to acceptable levels:! ●Elimination of hazard! ●Reduce by substitution (materials, equipment etc)! ●Physical safeguards (machinery guarding, extraction etc)! ●Personal Protective Equipment! ●Safe working procedures! ●Combination of above
  • 67.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 67
  • 68.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 68
  • 69.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 69 Safe Working Aboard Vessel
  • 70.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 70 • 1! Dangerous environment! ! • 2! changing environment! ! • 3! Variable standards of safety! ! • 4! Split responsibility! ! • 5! Human error Why Do Accidents Happen
  • 71.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 71 • 1! Dressing for safety! • 2! Getting aboard safety! • 3! Reaching the work safely! • 4! Checking ships equipment and gear! • 5! Safe access to above-deck stacks! • 6! Safe working on above-decks stacks! • 7! Safe access to Holds and safe working.! • 8! emergencies! • 9! Finishing work and leaving vessel Safe Working Aboard Vessel
  • 72.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 72 • Helmet! • Safety Shoes! • Gloves! • Safety vests! • Working clothes! • Safety goggles! • Ear protection! • Face masks Dressing for Safety
  • 73.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 73
  • 74.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 74 • 1! Sound construction! ! • 2! Safe placing! ! • 3! Adequate lighting! ! • 4! Safeguards! ! • 5! Correct use Safe Means of Access
  • 75.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 75 • 1! Secure rigging! ! • 2! Clear quay location! ! • 3! Non-operational location! ! • 4! Move as necessary! ! • 5! Adjust as necessary Location Requirements
  • 76.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 76 • 1! Must be used! ! • 2! Use both hands! ! • 3! Do not carry load! ! • 4! Do not drink alcohol! ! • 5! Keep clear and clean Correct Use of Means of Access
  • 77.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 77 Various means of Access
  • 78.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 78
  • 79.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 79
  • 80.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 80
  • 81.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 81
  • 82.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 82
  • 83.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 83
  • 84.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 84
  • 85.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 85 • 1! Crossing the deck! ! • 2! Ships ladders! ! • 3! Hatchways and other openings! ! • 4! Lighting Safe Access to Work Area
  • 86.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 86
  • 87.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 87
  • 88.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 88
  • 89.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 89 • Red!Prohibition! ! • Yellow! Warning! ! • Blue! Mandatory! ! • Green! Safe Safety Signs
  • 90.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 90
  • 91.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 91 • 1! Lashing cage! • 2! Gondola! • 3! Spreader! • 4! Ladder! • 5! Lashing platform Means of Access to Above- Deck Container Stacks
  • 92.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 92
  • 93.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 93
  • 94.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 94
  • 95.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 95
  • 96.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 96
  • 97.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 97
  • 98.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 98
  • 99.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 99
  • 100.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 100 • 1! Access for Inspection! • 2! Access to top of stow! • 3! Access to deep , open holds! • 4! Using portable ladders! • 5! Access to RoRo vehicle decks! • 6! Lighting! • 7! Working in confined spaces! • 8! Signals Working Below Deck
  • 101.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 101
  • 102.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 102
  • 103.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 103 • 1! Average level - 20 lux! • 2! Access routes aboard - 8 lux! • 3! Higher where necessary! • 4! Uniform lighting! • 5! Report defective lights! • 6! Use temporary lighting where needed! • 7! Care with cables Lighting Below Deck
  • 104.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 104 • 1! Has welding been carried out! • 2! Has fumigation taken place ! • 3! Has the area been painted! • 4! Has cargo leaked earlier! • 5! Is cargo leaking now! • 6! Has rusting occurred! • 7! Have plant products been stowed Danger Assessment Below Deck
  • 105.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 105
  • 106.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 106 • 1! Illness or injury! ! • 2! Leak of hazardous material! ! • 3! Fire aboard ship Emergencies
  • 107.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 107
  • 108.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 108 • 1! Leave the area - upwind! • 2! Investigate the cause and assess the risk! • 3! Tell the emergency services! • 4! If you feel dizzy or smell fumes, GET OUT FAST! • 5! Do NOT rush in if persons collapses! • 6! Do NOT enter hold with leaker without permission! • 7! Do NOT take risks Response to Leaks and Spills
  • 109.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 109 • Good housekeeping! ! • Leave the work area! ! • Leave the vessel Finishing Work
  • 110.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 110 ! ! HAZARDOUS WORK PERMIT SYSTEMS & LOCKOUT SYSTEMS! ! Hazardous Work Permits! ! ! ! The purpose of this module is to provide participants with the necessary knowledge and understanding to effectively use Hazardous Work Permit Systems and Lockout Systems and Lockout Systems. Representatives participating in this module are encouraged to share their learning experience with their workgroups in the promotion of, and participation in, the use of Hazardous Work Permit Systems and Lockout Systems.
  • 111.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 111 ! LEARNING OUTCOME! ! ● Upon successful completion of this module, participants will be able to:! ● Describe the structure, purpose and provision of both a Hazardous Work Permit System and a Lockout System.! ● Using the organization’s workplace policies and processes, use their Hazardous Work Permit System and their Lockout System in the workplace.
  • 112.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 112 ! Introduction! ! ! Throughout industry there are occasions when person may need access to certain parts of machinery and to enter hazardous areas to carry out routine work maintenance. These tasks can be particularly hazardous and statistics have shown that many deaths and injuries are caused each year as a result of activation of equipment or process materials entering an area where personnel are carrying out work.
  • 113.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 113 ! ! ! APPLICATION OF THE SYSTEM! ! ! The decision to adopt a Hazardous Work Permit system for a particular task is one that must be taken by management and will depend upon the degree of risk and complexity of the task. The following are examples of activities where it may ne necessary to use a hazardous work permit.
  • 114.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 114 ● Repair and maintenance of machinery! ● Work on electrical equipment! ● Work in confined spaces ! ● Work on chemical plants! ● Hot Work! ● Some other areas that should be considered are:! ● Working at heights! ● Working over the side! ● Working low or high temperatures! ● Working in areas subject to radiation
  • 115.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 115 ! ! Operation of the system! ● Preparation! ● Transfer and acceptance of responsibility! ● Return to Service! ● Responsibility for the issue of permits! ● Employees performing Hazardous Work! ● Lock Out Devices
  • 116.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 116 ! ! METHODS OF ISOLATION! ! ! ! Isolation devices are mechanical devices that physically prevent the transmission or release of energy. These devices may include but are not limited to the following! ● A manually operated electrical isolation switch;! ● A pipeline blank or blind;! ● A mechanical block or chock;! ● A manually operated isolation valve.
  • 117.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 117 ! TAGGING SYSTEM! ! The two different types of tag in use are:! PERSONAL DANGER TAGS! ! ! This is a warning tag that identifies the person working in, on, around or near the equipment or plant that has been isolated. It is to be securely attached to the isolation device and forbids the operation of the equipment or the removal of the isolating device by any person other than the person who placed it. The tag indicated that all the energies have been isolated and by whom. These tags must not be left on equipment after people have left the job. If the equipment is to be left personal danger tag must be replaced with an out of service tag.
  • 118.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 118 ! ! OUT-OF-SERVICES TAGS! ! ! ! This is used to place a faulty or unsafe piece of equipment out of service. It is also used to prevent further damage to that plant or equipment! ! ● Note: this does not indicate that the equipment has its energy isolated. People may not safely work on, in or around equipment which only has an Out-Of-Service tag attached.
  • 119.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 119 ! TESTING! ! ! There is a variety of testing that may be carried out, and under some circumstances such confined spaces atmosphere, it is mandatory to test. Other areas of work may require energy or ingress testing. Whatever tests are carried out is recorded on the hazardous work permit, identifying what has been tested, results, by whom and when.
  • 120.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 120 ! ! EMERGENCIES! ! ! An area that should always be addressed on a hazardous work permit is “equipment and procedures in case of emergencies”. This should be covered specially for the task to be carried out and should detail equipment such as rescue procedures, fire extinguishers and first aid kits, staffing such as trained standby personnel and procedures.
  • 121.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 121 ! ! CONFINED SPACE SAFETY! ! ! ! The purpose of this training module is to provide participants with the necessary skills and resources to identify a confined space and to effectively implement confined space safe work procedures
  • 122.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 122 ! LEARNING OUTCOME! ● Upon successful completion of this module, participants will be able to:! ● Give a detailed description of what constitutes a Confined Space.! ● Describe the potential hazards of a confined space.! ● State the upper and lower limits of oxygen levels.! ● Understand the requirements of a confines space entry permit.
  • 123.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 123 ! INTRODUCTION! ! ! Confined spaces present unique occupational health and safety problems, because of hazards that may not be readily apparent. Confined spaces usually have poor ventilation and may be of small volume, allowing hazardous atmospheres to accumulate quickly. Work in confined spaces ca increase the risk of injury or death by making employees work closer to hazards than they would otherwise, or by creating additional hazards such as engulfment.
  • 124.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 124 ! ! ! ! ! Persons entering confined spaces to perform work related tasks may be unaware that they are entering a potentially hazardous work environment. Many hazards, such as toxic gases and vapours, can be concentrated in confined spaces.
  • 125.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 125 ! ● Atmospheric Monitoring! ● Atmospheric Testing! ● Competent Person! ● Contaminant! ● Lower Explosives Limit (LEL)! ● Upper Explosive Limit (UEL)! ● Flammable Range! ● Standby person (Emergency Response Initiator)
  • 126.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 126 Dangers In Confined Spaces! By – Products of Previously Stored Materials or Chemicals! ! ! Confined spaces used for the storage of petroleum products, chemicals and other substances can often absorb or retain residue of those substances. When the space is emptied for maintenance, cleaning or other purposes, this absorbed material can leach back out, changing the composition of the confined space atmosphere.
  • 127.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 127 ! ● Incidental leaks or spills! ● Chemical Reaction! ● Oxidation! ● Mechanical Operations! ● Inerting Activities! ● Atmospheric Hazards! ● Oxygen Deficiency! ● Oxygen Enrichment
  • 128.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 128 Oxygen Content Symptoms 21-18% None 18-14% Increased breathing volume. Accelerated heartbeat. Impaired coordination. 14-10% Very faulty judgement. Very poor muscular coordination. Muscular exertion causes rapid fatigue 10-6% Nausea, vomiting. Inability to perform vigorous movement or loss of all movement. Unconsciousness in minutes, followed by death. 6-0% Spasmodic breathing. Convulsive movements. Death in minutes
  • 129.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 129 ! ! ! ! COMBUSTIBLE GASES! In order for combustion to occur, there must be three elements:! 1.!Fuel! 2.!Oxygen to support combustion and ! 3.!Heat or a source of ignition.!
  • 130.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 130 ! ● Toxic Gases ! ● Carbon Monoxide (CO)! ● Hydrogen Sulphide (H2S)! ● Sulphur Dioxide (SO2)! ● Ammonia (NH3)! ● Hydrogen Cyanide or Hydrocyanic Acid (HCN)! ● Aromatic Hydrocarbons (i.e. Benzene, Toluene, Xylene)
  • 131.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 131 ! Confined Space Entry Permits and Hazardous Work Permits! ! ! ! To deal with entry into, and working within a confined space, a system has been devised where a well-planned procedure for entering and working in each confined space has been set out in a “permit or work” document. This document list the work to be done, the precautions necessary, and the sequence of actions, which will make the job safe.
  • 132.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 132 ! ! ASSESSMENT OF RISK! ! ! In order to ensure that the hazards and risks of each confined space entry are identified, a competent person must always make a preliminary assessment of the space to be entered. Previous hazard identifications contained in documents such as planned maintenance schedules of spaces under consideration, previously completed hazard identification risk assessments for the activity or task in hand, or workplace contingency plans may be of assistance in determining the hazards for the entry under consideration.
  • 133.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 133 ! ! ! RESCUE AND FIRST AID! ! ! The most common emergency in a confined space involves a toxic atmosphere or one that is oxygen deficient or oxygen enriched. In these emergencies extraction of the victim is only secondary priority. It is more important (and a lot easier) to supply them with oxygen or at least breathable air. Inherent in any confined space entry procedure should be an associated program for emergency rescue and evacuation.! ! !
  • 134.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 134 ! ! SAFE SYSTEMS OF WORK! ! Introduction! ! ! This chapter suggests some control measures which may be taken to protect those who may be put at risk in some key areas on board ship. Such measures should be based on the findings of the risk assessment.
  • 135.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 135 ! ! WORKING ALOFT AND OUTBOARD! ! ! ! Anyone working and not standing on level ground or at deck level is working at height. Also undertaking work inside a tank, near an opening, such as a hatch, or on a fixed stairway may be regarded as working at height if there is a danger of injury if the worker fell. Further guidance is contained in MGN 410 (M+F).
  • 136.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 136 ! ! PORTABLE LADDERS! ! ! ! A portable ladder should only be used where no safer means of access is reasonably practicable. It is very important that the ladder is checked regularly by a competent person. Annex A (reproduced from MGN 410) gives further guidance.! ! !
  • 137.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 137 ! ! Wooden ladders should not be painted or treated so as to hide defects and cracks. When not in use they should be stowed safely in a dry ventilated space away from any heat source.
  • 138.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 138 ! ! CRADLES AND STAGES! ! ! ! Cradles should be at least 430 mm (17 inches) wide and fitted with guard rails or stanchions with taut ropes to a height of one metre (39 inches) from the floor. Toe boards add safety. Annex C (reproduced from MGN 410) gives further guidance.! ! !
  • 139.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 139 ! ! Planks and materials used for the construction of ordinary plank stages must be carefully examined to ensure adequate strength and freedom from defect.!  ! ! Wooden components of staging should be stowed in a dry, ventilated space and not subjected to heat.
  • 140.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 140 ! BOSUN’S CHAIR! ! ! ! When used with a gantline the chair should be secured to it with a double sheet bend and the end seized to the standing part with adequate tail. Annex C (reproduced from MGN 410) gives further guidance.! ! !
  • 141.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 141 ! ! Hooks should not be used to secure bosun’s chairs unless they are of the type which because of their special construction cannot be accidentally dislodged, and have a marked safe working load which is adequate for the purpose.
  • 142.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 142 ! WORKING FROM PUNTS!  ! ! ! Punts should be stable and provided with suitable fencing. Unsecured trestles and planks should not be used to give additional height.! ! ! The duty engineer and deck officers should also be informed by the person in charge when seamen are working below ship’s side discharges so they are not used until the work is completed. Notices to this effect should be attached to the relevant control valves and not taken off until those working are reported clear.
  • 143.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 143 ! WORK IN MACHINERY SPACES! ! ! ! Merchant Shipping regulations require every dangerous part of a ship’s machinery to be securely guarded unless it is so positioned or constructed that it is as safe as if it were securely guarded or is otherwise safeguarded. Guidance on the interpretation of these Regulations is given in MGN 331(M+F).! ! !
  • 144.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 144 ! ! All steam pipes, exhaust pipes and fittings which by their location and temperature present a hazard, should be adequately lagged or otherwise shielded. The insulation of hot surfaces should be properly maintained, particularly in the vicinity of oil systems.
  • 145.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 145 ! ! ! BOILERS! ! ! A notice should be displayed at each boiler setting out operating instructions. Information provided by the manufacturers of the oil-burning equipment should be displayed in the boiler room.
  • 146.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 146 ! UNMANNED MACHINERY SPACES! ! ! ! Personnel should never enter or remain in an unmanned machinery space alone, unless they have received permission from, or been instructed by the engineer officer in charge at the time. They may only be sent to carry out a specific task which they may be expected to complete in a comparatively short time.
  • 147.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 147 ! ! Before entering the space, at regular intervals whilst in the space and on leaving the space, they must report by telephone, or other means provided, to the duty deck officer. Before they enter the space the method of reporting should be clearly explained. Consideration should be given in appropriate instances to using a ‘permit-to-work’
  • 148.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 148 ! ! REFRIGERATION MACHINERY! ! ! ! Adequate information should be available on each vessel, laying down the operation and maintenance safeguards of the refrigeration plant, the particular properties of the refrigerant and the precautions for its safe handling.! ! !
  • 149.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 149 ! ! Should it be known or suspected that the refrigerant has leaked into any compartments, no attempt should be made to enter those compartments until a responsible officer has been advised of the situation.
  • 150.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 150 ! ! If it is necessary to enter the space, it should be ventilated to the fullest extent practicable and the personnel entering should wear approved breathing apparatus. A person should be stationed in constant attendance outside the space, also with breathing apparatus.! SCAFFOLDING! ● Care should be taken when assembling and dismantling the scaffold.
  • 151.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 151 ● ! Only scaffolding of an approved design should be used or one rigged in conformity with a generally recognized configuration. If necessary a calculation of its strength should be carried out and recorded.
  • 152.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 152 ● Requirements for Ladders! ● Requirements for Scaffolding! ANNEX C! REQUIREMENTS FOR ROPE ACCESS AND POSITIONING TECHNIQUES! ! CHAPTER 16! PERMIT TO WORK SYSTEMS! Introduction! ! ! Based on the findings of the risk assessment, appropriate control measures should be put into place to protect those who may be affected. This Chapter covers permits to work, which are suggested control measures for particular operations.
  • 153.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 153 ! PERMIT-TO-WORK SYSTEMS! ! ! ! There are many types of operation on board ship where the routine actions of one person may inadvertently endanger another or when a series of action steps need to be taken to ensure the safety of those engaged in a specific operation. In all instances it is necessary, before the work is done, to identify the hazards and then to ensure that they are eliminated or effectively controlled. Ultimate responsibility rests with the employer to see that this is done.
  • 154.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 154 ! SANCTIONS-TO-TEST SYSTEMS! ! ! ! A sanction-to-test shall be issued in an identical manner to a permit-to-work. A sanction-to-test shall not be issued on any apparatus on which a permit-to-work is still in force, or on which another sanction-to-test is in force.! ! ! A sanction-to-test is to be issued where testing operations require the removal of the circuit Main Earth. Note: Maintenance and repair cannot be carried out under a sanction-to-test.
  • 155.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 155 CHAPTER 17! ENTERING ENCLOSED OR CONFINED ! SPACES! ! INTRODUCTION! ! ! Based on the findings of the risk assessment, appropriate control measures should be put into place to protect those who may be affected. This Chapter highlights suggested control measures for entry into enclosed or confined spaces.
  • 156.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 156 ! ! ! ! ! The Regulations define a “Dangerous Space” as: “Any enclosed or confined space in which it is foreseeable that the atmosphere may at some stage contain toxic or flammable gases or vapours, or be deficient in oxygen, to the extent that it may endanger the life or health of any person entering that space”.
  • 157.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 157 ! ! ! ! ! ! The atmosphere of any enclosed or confined space is potentially dangerous. The space may be deficient in oxygen and/or contain flammable or toxic fumes, gases or vapours. Where possible, alternative means of working which avoid entering the space should be found
  • 158.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 158 ! DUTIES AND RESPONSIBILITIES OF A COMPETENT PERSON AND OF A RESPONSIBLE OFFICER! ! ! A competent person is a person capable of making an informed assessment of the likelihood of a dangerous atmosphere being present or arising subsequently in the space. This person should have sufficient theoretical knowledge and practical experience of the hazards that might be met in order to be able to assess whether precautions are necessary.
  • 159.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 159 ! IDENTIFYING POTENTIAL HAZARDS OXYGEN DEFICIENCY! If an empty tank or other confined space has been closed for a time the oxygen content may have been reduced owing to a number of reasons:! ● Rusting may have occurred due to oxygen combining with steel.! ● Oxygen absorbing chemicals may have been present.! ● Oxygen absorbing cargoes may have been carried or gases from volatile cargoes may have displaced the oxygen in tanks.
  • 160.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 160 ! ● Hydrogen may have been produced in a cathodically- protected cargo tank used for ballast.! ● Oxygen may have been displaced by the use of carbon dioxide or other fire-extinguishing or - preventing media, or inert gas in the tanks or inter- barrier spaces of tankers or gas carriers.
  • 161.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 161 ! TOXICITY OF OIL CARGOES! ! ! Hydrocarbon gases are flammable as well as toxic and may be present in fuel or cargo tanks which have contained crude oil or its products.! ! ! Hydrocarbon gases or vapours may also be present in pump rooms and cofferdams, duct keels or other spaces adjacent to cargo tanks due to the leakage of cargo.! ! ! The components in the vapour of some oil cargoes, such as benzene and hydrogen sulphide are very toxic.
  • 162.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 162 ! ! TOXICITY OF OTHER SUBSTANCES! ! ! Cargoes carried in chemical tankers or gas carriers may be toxic.! ! ! There is the possibility of leakage from drums of chemicals or other packages of dangerous goods where there has been mishandling or incorrect stowage or damage due to heavy weather.
  • 163.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 163 ! ! ! ! FLAMMABILITY! ! ! ! Flammable vapours may still be present in cargo or other tanks that have contained oil products or chemical or gas cargoes.! ! ! Cofferdams and other spaces that are adjacent to cargo and other tanks may contain flammable vapours should there have been leakage into the space.
  • 164.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 164 ! PREPARING AND SECURING THE SPACE FOR ENTRY! ! ! When opening the entrance to a potentially dangerous space, precautions should be taken in case pressurized or unpressurised vapour or gases are released from the space.
  • 165.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 165 ! ! ! ! ! ! The space should be isolated and secured against the ingress of dangerous substances by blanking off pipe-lines or other openings and by closing valves. Valves should then be lashed or some other means used to indicate that they are not to be opened and notices placed on the relevant controls. The officer on watch should be informed
  • 166.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 166
  • 167.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 167 ! ! ! ! TESTING THE ATMOSPHERE OF THE SPACE! ! ! ! Testing of a space should be carried out only by persons trained in the use of the equipment.! ! ! Personal monitoring equipment is designed for personal use only, to provide a warning against oxygen deficiency, toxic gases and explosive atmospheres whilst the wearer is in the space. This should not be used as a means of determining whether a dangerous space is safe prior to entry.
  • 168.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 168 ! ! ! ! ! TESTING FOR OXYGEN DEFICIENCY! ! ! ! A steady reading of at least 20% oxygen by volume on an oxygen content meter should be obtained before entry is permitted. A combustible gas indicator cannot be used to detect oxygen deficiency.
  • 169.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 169 ! TESTING FOR FLAMMABLE GASES AND VAPOURS! ! ! ! The combustible gas indicator (sometimes called an explosimeter) detects the amount of flammable gas or vapour in the air. An instrument capable of providing an accurate reading at low concentrations should be used to judge whether the atmosphere is safe for entry.! ! !
  • 170.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 170 ! ! Combustible gas detectors are calibrated on a standard gas. When testing for other gases and vapors reference should be made to the calibration curves supplied with the instrument. Particular care is required should accumulations of hydrogen be suspected.
  • 171.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 171 ! TESTING FOR TOXIC GASES! ! ! ! The presence of certain gases and vapours on chemical tankers and gas carriers is detected by fixed or portable gas or vapour detection equipment. The readings obtained by this equipment should be compared with the occupational exposure limits for the contaminant given in international industry safety guides or the latest edition of the Health and Safety Executive Guidance Note EH-40 Occupational Exposure Limits.
  • 172.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 172 ! ! ! ! ! ! These occupational exposure limits provide guidance for the level of exposure to toxic substances which should not be exceeded if the health of persons is to be protected. However, it is necessary to know for which chemical a test is being made in order to use the equipment correctly and it is important to note that not all chemicals may be tested by these means.
  • 173.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 173 ! ! USE OF CONTROL SYSTEMS! ! ! For situations for which a well established safe system of work exists a check-list may exceptionally be accepted as an alternative to a full ‘permit-to-work’ provided that the principles of the ‘permit-to-work’ system are covered and the risks arising in the dangerous space are low.
  • 174.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 174 ! ! ! PROCEDURES AND ARRANGEMENTS BEFORE Entry! ! ! Before entry is permitted it should be established that entry with breathing apparatus is possible. Any difficulty of movement within any part of the space, or any problems if any incapacitated person had to be removed from the space, as a result of breathing apparatus or lifelines or rescue harnesses being used, should be considered and any risks minimized.! ! !
  • 175.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 175 ! ! Lifelines should be long enough for the purpose and capable of being firmly attached to the harness, but the wearer should be able to detach them easily should they become tangled.! Procedures and Arrangements During Entry! ! ! Ventilation should continue during the period that the space is occupied and during temporary breaks.
  • 176.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 176 ! ! In the event of a failure of the ventilation system any personnel in the space should leave immediately.! ! ! The atmosphere should be tested periodically whilst the space is occupied and personnel should be instructed to leave the space should there be any deterioration of the conditions. Should a personal gas detector alarm, the space should be vacated by all persons immediately.
  • 177.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 177 ! ! PROCEDURES ON COMPLETION! ! ! ! On expiry of the ‘permit-to-work’, everyone should leave the space and the entrance to the space should be closed or otherwise secured against entry or alternatively, where the space is no longer a dangerous space, declared safe for normal entry.
  • 178.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 178 ! ! ! ! ! TRAINING, INSTRUCTION AND INFORMATION! ! Employers should provide any necessary training, instruction and information to employees in order to ensure that the requirements of the Entry into Dangerous Spaces Regulations are complied with. This should include:! ● recognition of the circumstances and activities likely to lead to the presence of a dangerous atmosphere,
  • 179.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 179 ! ● the hazards associated with entry into dangerous spaces, and the precautions to be taken,! ● the use and maintenance of equipment and clothing required for entry into dangerous spaces,! ● instruction and drills in rescue from dangerous spaces.! ● instruction and drills in rescue from dangerous spaces.! !
  • 180.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 180 Breathing Apparatus and Resuscitation Equipment ! ! ! No one should enter a space where the atmosphere is unsafe or suspect without wearing breathing apparatus which they are trained to use, even to rescue another person.
  • 181.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 181 ! ! Equipment for use with two air supplies may consist of:! ● a conventional self-contained breathing apparatus of the open circuit compressed air type that is approved to EN 137:1993 and has been additionally tested for use with an air line connection; or
  • 182.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 182 ● ! a compressed air line breathing apparatus incorporating an emergency self-contained supply. The compressed air line breathing apparatus should be of the demand valve type and should be approved to EN 139:1995, or for self-rescue purposes, to BS 1146: 1997 (or equivalent Standard). The emergency self-contained supply should comply with the relevant parts of the appropriate Standard.
  • 183.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 183 ! ! The capacity of the self-contained supply should be sufficient for the wearer to escape to a safe atmosphere. When determining this capacity it should be recognized that, under stress or in difficult conditions, the wearer’s breathing rate may be in excess of the nominal breathing rate of 40 liters per minute.
  • 184.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 184 ! The master, or responsible officer, and the person about to enter the space should undertake the full pre-wearing check and donning procedures recommended in the manufacturer’s instructions. In particular they should check:! ● that there will be sufficient clean air at the correct pressure;! ● that low pressure alarms are working properly;
  • 185.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 185 ! ! ● ! that the facemask fits correctly against the user’s face so that, combined with pressure of the air coming into the mask, there will not be an ingress of oxygen deficient air or toxic vapours when the user inhales. It should be noted that facial hair or spectacles may prevent the formation of an air-tight seal between a person’s face and the facemask;
  • 186.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 186 ● that the wearer of the breathing apparatus understands whether or not their air supply may be shared with another person and if so is also aware that such procedures should only be used in an extreme emergency;! ● that when work is being undertaken in the space the wearer should keep the self-contained supply for use when there is a failure of the continuous supply from outside the space
  • 187.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 187 ! ! ! When in a dangerous space:! ● No one should remove their own breathing apparatus.! ● Breathing apparatus should not be removed from a person unless it is necessary to save their life.
  • 188.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 188 ! MAINTENANCE OF EQUIPMENT FOR ENTRY INTO DANGEROUS SPACES ! ! ! ! All breathing apparatus, rescue harnesses, lifelines, resuscitation equipment and any other equipment provided for use in, or in connection with, entry into dangerous spaces, or for use in emergencies, should be properly maintained, inspected periodically and checked for correct operation by a competent person and a record of the inspections and checks should be kept. All items of breathing apparatus should be inspected for correct operation before and after use.
  • 189.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 189 CHAPTER 4! PERSONAL PROTECTIVE EQUIPMENT! ! Introduction! ! ! Risks to the health and safety of workers must be identified and assessed. It will often not be possible to remove all risks, but attention should be given to control measures which make the working environment and working methods as safe as reasonably practicable.
  • 190.

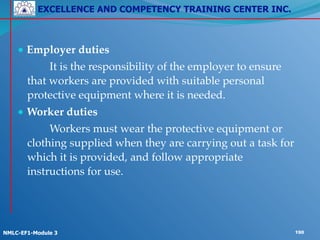

    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 190 ● Employer duties! ! ! It is the responsibility of the employer to ensure that workers are provided with suitable personal protective equipment where it is needed.! ● Worker duties! ! ! Workers must wear the protective equipment or clothing supplied when they are carrying out a task for which it is provided, and follow appropriate instructions for use.
  • 191.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 191 TYPES OF EQUIPMENT! ! ! Overalls, gloves and suitable footwear are the proper working dress for most work about ship but these may not give adequate protection against particular hazards ! ! HEAD PROTECTION! ● Safety Helmets! ! ● Bump caps! ● Hair nets and safety caps
  • 192.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 192 ! ! HEARING PROTECTION! ! ! All persons exposed to high levels of noise, eg in machinery spaces, should wear ear protection of a type recommended as suitable for the particular circumstances. Protectors are of three types - ear plugs, disposable or permanent, and ear muffs. For further information see the Code of Practice Noise Levels in Ships, published by the Department of Transport (1990).
  • 193.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 193 ! ! FACE AND EYE PROTECTION! ! The main causes of eye injury are:! ● infra-red rays - gas welding;! ● ultra-violet rays - electric welding;! ● exposure to chemicals;! ● exposure to particles and foreign bodies
  • 194.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 194 ! ! RESPIRATORY PROTECTIVE EQUIPMENT! ! ! Respiratory protective equipment is essential for protection when work has to be done in conditions of irritating, dangerous or poisonous dust, fumes or gases. There are two main types of equipment which perform different functions:! ● a respirator filters the air before it is inhaled;! ● breathing apparatus supplies air or oxygen from an uncontaminated source.
  • 195.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 195 ! ● BREATHING APPARATUS! ! ! Breathing apparatus should not be used underwater unless the equipment is suitable for the purpose, and then only in an emergency.! ! ● RESUSCITATORS! ! ! It is recommended that resuscitators of an appropriate kind should be provided when any person may be required to enter a dangerous space
  • 196.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 196 ! ! HAND AND FOOT PROTECTION ! ! Gloves! ! ! The exact type of glove selected will depend on the kind of work being undertaken or the particular substance being handled, and in these cases expert advice should be followed. The following are general rules:
  • 197.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 197 ● Leather gloves should generally be used when handling rough or sharp objects.! ● Heat-resistant gloves should be used when handling hot objects.! ● Rubber, synthetic or PVC gloves are generally best for handling acids, alkalis, various types of oils, solvents and chemicals in general.
  • 198.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 198 ! ! FOOTWEAR! ! ! Foot injuries most often result from the wearing of unsuitable footwear (e.g. sandals, plimsolls and flip-flops) rather than from failure to wear safety shoes and boots. It is nevertheless strongly advisable that all personnel whilst at work on board ship wear appropriate safety footwear.
  • 199.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 199 ! ! PROTECTION FROM FALLS! ! ! !   All personnel who are working aloft, outboard or below decks or in any other area where there is a risk of falling more than two metres, should wear a safety harness (or belt with shock absorber) attached to a lifeline. If a vessel is shipping frequent seas, nobody should be required to work on deck unless absolutely necessary.
  • 200.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 200 ! ! However, where this is unavoidable, persons on deck should wear a harness and, where practicable, should be secured by lifeline as a protection from falls and from being washed overboard or against the ship’s structure.
  • 201.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 201 ! ! BODY PROTECTION! ! ! Special outer clothing may be needed for protection when personnel are exposed to particular contaminating or corrosive substances. This clothing should be kept for the particular purpose and dealt with as directed in the relevant sections of the Code.
  • 202.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 202 ! PROTECTION AGAINST DROWNING! ! ! ! Where work is being carried out over-side or in an exposed position where there is a reasonably foreseeable risk of falling or being washed overboard or where work is being carried out in or from a ship’s boat a lifebuoy with sufficient line should be provided. In addition and as appropriate a lifejacket or buoyancy aid should be provided. Where necessary, personnel should be provided with thermal protective clothing to reduce the risks of cold shock.
  • 203.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 203
  • 204.
    EXCELLENCE AND COMPETENCYTRAINING CENTER INC. ! ! NMLC-EF1-Module 3 204
