MULTIPLE TEAM
FORECASTING
Troy Magennis
Troy.magennis@focusedobjective.com
WELCOME
• The problem of multiple team forecasts
• How “leaders” feel the problem
• How “tech” feels the problem
• This history of “forecasting”
• Single piece of work by a team
• Batch of pieces of work by a team
• Single piece of work by multiple teams
• Batch of pieces of work by multiple teams
• What can we do…
THE PROBLEM
TECH FEELS…
• Reliable estimation of new stuff impossible
• They will be held accountable for unknowns
• That leadership doesn’t understand difficulties

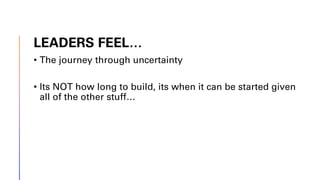

LEADERS FEEL…
• The journey through uncertainty
• Its NOT how long to build, its when it can be started given
all of the other stuff…
When can we
start this work?
If I said we needed it now,
what gets dropped?
A 1-minute dev change
that wont be started for
3 months takes -
3 months and 1 minute

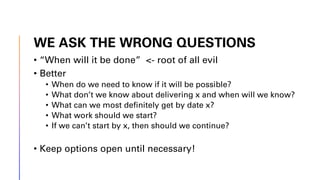

WE ASK THE WRONG QUESTIONS
• “When will it be done” <- root of all evil
• Better
• When do we need to know if it will be possible?
• What don’t we know about delivering x and when will we know?
• What can we most definitely get by date x?
• What work should we start?
• If we can’t start by x, then should we continue?
• Keep options open until necessary!

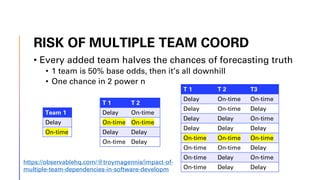

RISK OF MULTIPLE TEAM COORD
• Every added team halves the chances of forecasting truth
• 1 team is 50% base odds, then it’s all downhill
• One chance in 2 power n
Team 1
Delay
On-time
T 1 T 2
Delay On-time
On-time On-time
Delay Delay
On-time Delay
T 1 T 2 T3
Delay On-time On-time
Delay On-time Delay
Delay Delay On-time
Delay Delay Delay
On-time On-time On-time
On-time On-time Delay
On-time Delay On-time
On-time Delay Delay
https://observablehq.com/@troymagennis/impact-of-
multiple-team-dependencies-in-software-developm

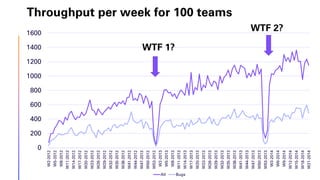

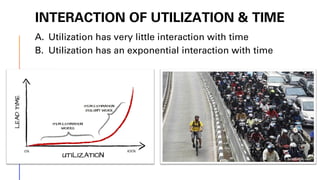

INTERACTION OF UTILIZATION & TIME
A. Utilization has very little interaction with time
B. Utilization has an exponential interaction with time
0
200
400
600
800
1000
1200
1400
1600
W2-2012
W5-2012
W8-2012
W11-2012
W14-2012
W17-2012
W20-2012
W23-2012
W26-2012
W29-2012
W32-2012
W35-2012
W38-2012
W41-2012
W44-2012
W47-2012
W50-2012
W53-2012
W2-2013
W5-2013
W8-2013
W11-2013
W14-2013
W17-2013
W20-2013
W23-2013
W26-2013
W29-2013
W32-2013
W35-2013
W38-2013
W41-2013
W44-2013
W47-2013
W50-2013
W53-2013
W3-2014
W6-2014
W9-2014
W12-2014
W15-2014
W18-2014
W21-2014
All Bugs
Throughput per week for 100 teams
WTF 1?
WTF 2?

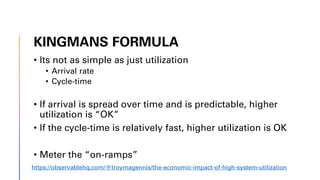

KINGMANS FORMULA
• Its not as simple as just utilization
• Arrival rate
• Cycle-time
• If arrival is spread over time and is predictable, higher
utilization is “OK”
• If the cycle-time is relatively fast, higher utilization is OK
• Meter the “on-ramps”
https://observablehq.com/@troymagennis/the-economic-impact-of-high-system-utilization
WHERE DO WE TRADE IDLE FOR
RESPONSE TIME?
• Where do we pay for “something” we may not need?
• Something mostly idle or unused until …
• Firefighting / Police
• Insurance
• WHERE COST IS HUGE
• WHERE COST GROWS FAST WITH ELAPSED TIME
It’s not that they are 10x
firefighters; it’s that they
have a near-immediate
START

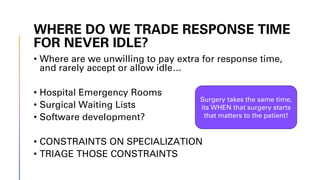

WHERE DO WE TRADE RESPONSE TIME
FOR NEVER IDLE?
• Where are we unwilling to pay extra for response time,
and rarely accept or allow idle…
• Hospital Emergency Rooms
• Surgical Waiting Lists
• Software development?
• CONSTRAINTS ON SPECIALIZATION
• TRIAGE THOSE CONSTRAINTS
Surgery takes the same time,
its WHEN that surgery starts
that matters to the patient!
Problem –
We think planning is
about “how long
something will take”
(tooling, taught process, typical planning, etc)
WE CANNOT KNOW
“when will it be done”
unless we know
“when will it start”
HISTORY

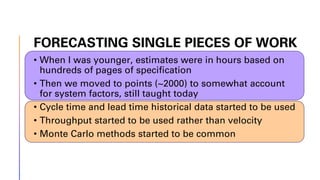

FORECASTING SINGLE PIECES OF WORK
• When I was younger, estimates were in hours based on
hundreds of pages of specification
• Then we moved to points (~2000) to somewhat account
for system factors, still taught today
• Cycle time and lead time historical data started to be used
• Throughput started to be used rather than velocity
• Monte Carlo methods started to be common

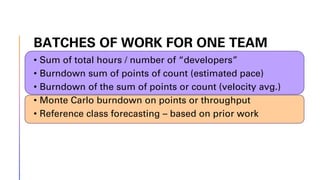

BATCHES OF WORK FOR ONE TEAM
• Sum of total hours / number of “developers”
• Burndown sum of points of count (estimated pace)
• Burndown of the sum of points or count (velocity avg.)
• Monte Carlo burndown on points or throughput
• Reference class forecasting – based on prior work
DEMO
https://www.focusedobjective.com/

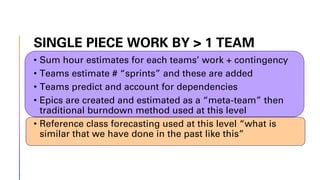

SINGLE PIECE WORK BY > 1 TEAM
• Sum hour estimates for each teams’ work + contingency
• Teams estimate # “sprints” and these are added
• Teams predict and account for dependencies
• Epics are created and estimated as a “meta-team” then
traditional burndown method used at this level
• Reference class forecasting used at this level “what is
similar that we have done in the past like this”
BATCHES WORK BY > 1 TEAM (REALITY)
• Quarterly planning
• Big room planning
• …
• We look to understand what we “might get” completed in
a period of time.
• Regular planning swarming…
SOLUTIONS
DO DEPENDENCIES MATTER?
• Not “all” (stop the red string)
• Define dependencies….
None Some All
DO DEPENDENCIES MATTER?
None Some All
Longest

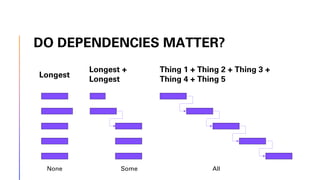

Longest +
Longest
Thing 1 + Thing 2 + Thing 3 +
Thing 4 + Thing 5

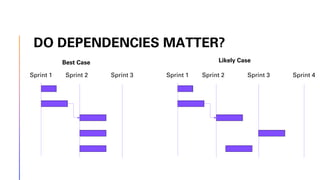

DO DEPENDENCIES MATTER?
Sprint 1 Sprint 2 Sprint 3 Sprint 1 Sprint 2 Sprint 3 Sprint 4
Best Case Likely Case

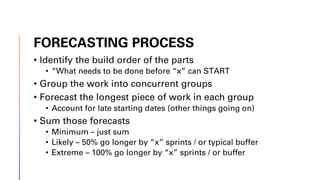

FORECASTING PROCESS
• Identify the build order of the parts
• “What needs to be done before “x” can START
• Group the work into concurrent groups
• Forecast the longest piece of work in each group
• Account for late starting dates (other things going on)
• Sum those forecasts
• Minimum – just sum
• Likely – 50% go longer by “x” sprints / or typical buffer
• Extreme – 100% go longer by “x” sprints / or buffer
DEMO

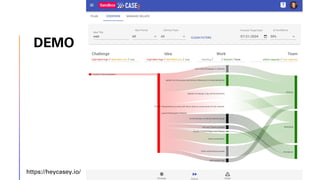

https://heycasey.io/
DEMO
https://heycasey.io/

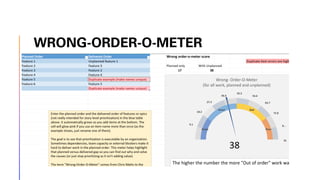

WRONG-ORDER-O-METER

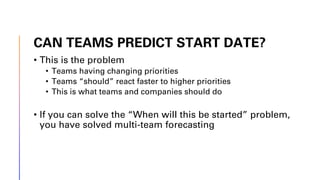

CAN TEAMS PREDICT START DATE?
• This is the problem
• Teams having changing priorities
• Teams “should” react faster to higher priorities
• This is what teams and companies should do
• If you can solve the “When will this be started” problem,
you have solved multi-team forecasting

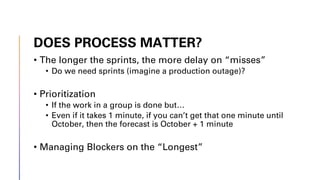

DOES PROCESS MATTER?
• The longer the sprints, the more delay on “misses”
• Do we need sprints (imagine a production outage)?
• Prioritization
• If the work in a group is done but…
• Even if it takes 1 minute, if you can’t get that one minute until
October, then the forecast is October + 1 minute
• Managing Blockers on the “Longest”
WHAT CHANGES THE ORDER WE
“SHOULD” START THINGS
HOW CAN WE GET TEAMS TO KNOW
WHAT TO START NEXT
WRAP UP
Troy.Magennis@focusedobjective.com
troy@heycasey.io
focusedobjective.com
heycasey.io
