2
• Presentation
• Project Review
• Transit Center Needs
• Transit Center Concepts
• Q&A and Feedback on Concept Elements
• Next Steps
• Q&A

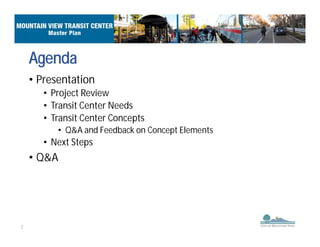

Agenda
3

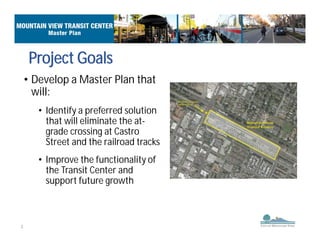

Project Goals
• Develop a Master Plan that
will:
• Identify a preferred solution
that will eliminate the at-
grade crossing at Castro
Street and the railroad tracks
• Improve the functionality of
the Transit Center and
support future growth
4
• Accommodate the expected growth in train service and
station usage
• Train service to more than double over the next 10–15 years
• Relieve delays at the railroad crossing on Castro
• Railroad gate blockages in peak hours to double
• Improve safety and access for pedestrians and bicyclists
• Support the economic vitality and future growth of
downtown Mountain View
• Accommodate changes in transportation patterns and
services
Why Is It Needed?
5

Re-direct Castro at Tracks
6
Where we are now
7

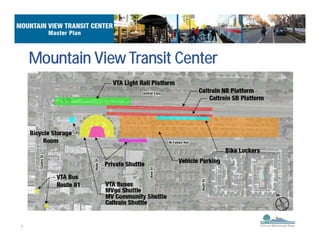

Mountain View Transit Center
8
• Almost 9,000 daily Caltrain boardings and alightings
• Almost 3,000 daily VTA bus and LRT boardings and
alightings
• Almost 1,500 daily shuttle boardings and alightings
Existing Activity
9

AM Activity at Transit Center
10
PM Activity at Transit Center

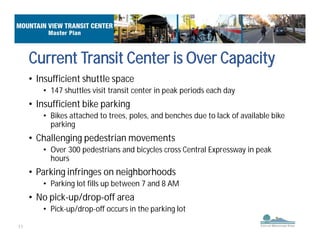

11
• Insufficient shuttle space
• 147 shuttles visit transit center in peak periods each day
• Insufficient bike parking
• Bikes attached to trees, poles, and benches due to lack of available bike
parking
• Challenging pedestrian movements
• Over 300 pedestrians and bicycles cross Central Expressway in peak
hours
• Parking infringes on neighborhoods
• Parking lot fills up between 7 and 8 AM
• No pick-up/drop-off area
• Pick-up/drop-off occurs in the parking lot
Current Transit Center is Over Capacity

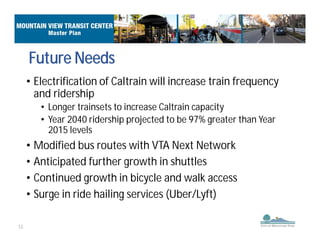

12
• Electrification of Caltrain will increase train frequency
and ridership
• Longer trainsets to increase Caltrain capacity
• Year 2040 ridership projected to be 97% greater than Year
2015 levels
• Modified bus routes with VTA Next Network
• Anticipated further growth in shuttles
• Continued growth in bicycle and walk access
• Surge in ride hailing services (Uber/Lyft)
Future Needs
13

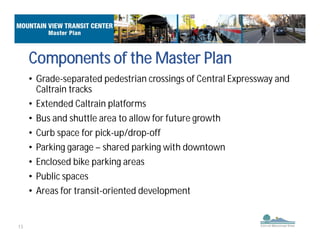

• Grade-separated pedestrian crossings of Central Expressway and
Caltrain tracks
• Extended Caltrain platforms
• Bus and shuttle area to allow for future growth
• Curb space for pick-up/drop-off
• Parking garage – shared parking with downtown
• Enclosed bike parking areas
• Public spaces
• Areas for transit-oriented development
Components of the Master Plan
14
• Developed 4 concepts
• Differ in the following ways:
• Location of platforms
• Configuration of bus/shuttle area
• Location of pick-up/drop-off areas
• Location and configuration of parking garage
• Parking garage access
• Plaza configuration and size
• Concept 1 reflected least change from existing. Council Study
Session suggested focusing on Concepts 2-4 as they best achieve
project objectives
Development of Concepts

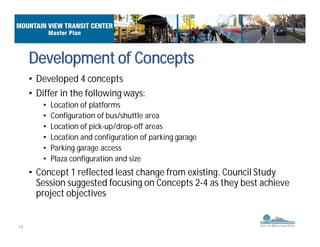

15

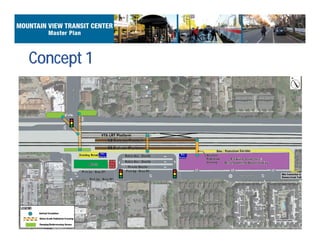

Concept 1
16

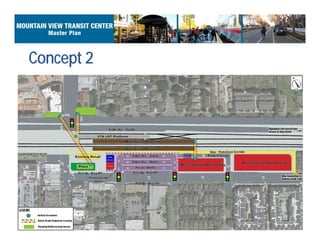

Concept 2
17

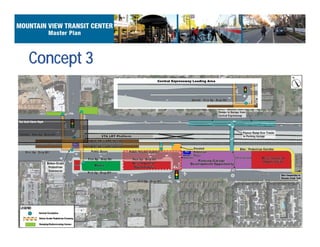

Concept 3
18
Concept 4

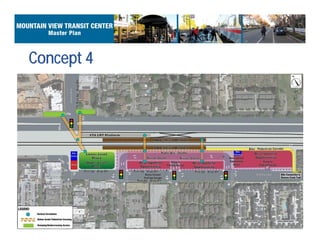

19

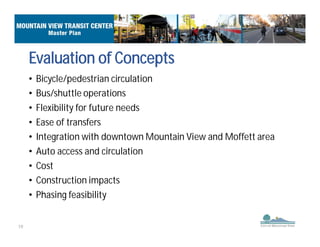

Evaluation of Concepts
• Bicycle/pedestrian circulation
• Bus/shuttle operations
• Flexibility for future needs
• Ease of transfers
• Integration with downtown Mountain View and Moffett area
• Auto access and circulation
• Cost
• Construction impacts
• Phasing feasibility
20

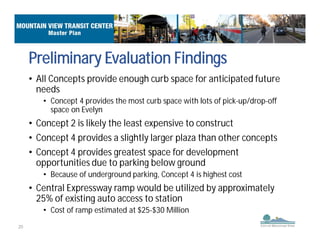

• All Concepts provide enough curb space for anticipated future
needs
• Concept 4 provides the most curb space with lots of pick-up/drop-off
space on Evelyn
• Concept 2 is likely the least expensive to construct
• Concept 4 provides a slightly larger plaza than other concepts
• Concept 4 provides greatest space for development
opportunities due to parking below ground
• Because of underground parking, Concept 4 is highest cost
• Central Expressway ramp would be utilized by approximately
25% of existing auto access to station
• Cost of ramp estimated at $25-$30 Million
Preliminary Evaluation Findings

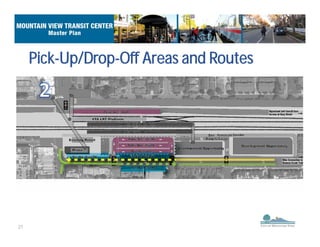

21
Pick-Up/Drop-Off Areas and Routes

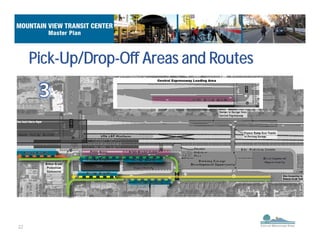

22
Pick-Up/Drop-Off Areas and Routes

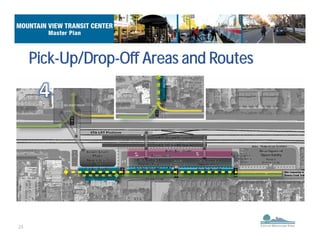

23
Pick-Up/Drop-Off Areas and Routes
24

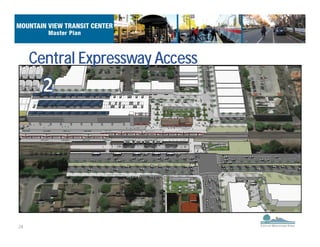

Central Expressway Access

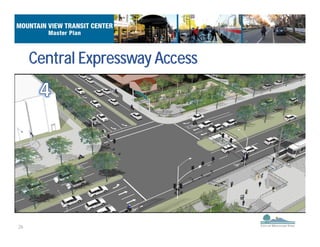

25
Central Expressway Access
26
Central Expressway Access
27

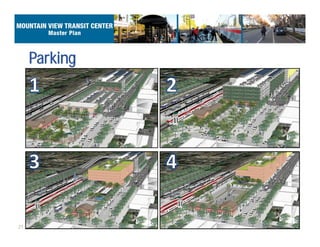

Parking
28

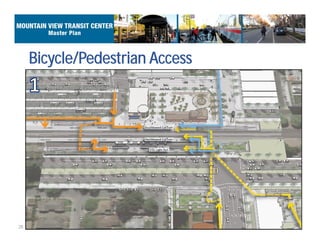

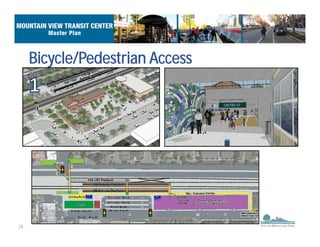

Bicycle/Pedestrian Access
29
Bicycle/Pedestrian Access

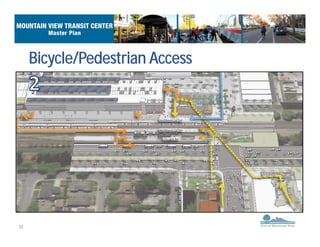

30
Bicycle/Pedestrian Access
31

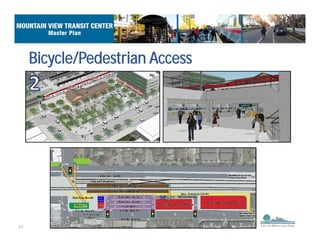

Bicycle/Pedestrian Access
32

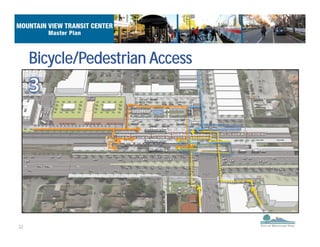

Bicycle/Pedestrian Access
33

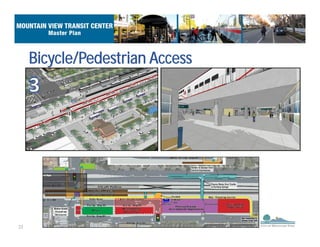

Bicycle/Pedestrian Access

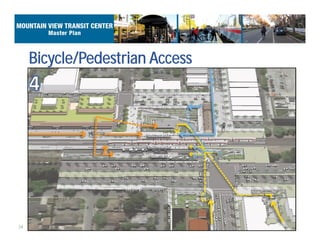

34
Bicycle/Pedestrian Access
35

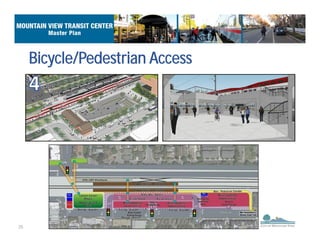

Bicycle/Pedestrian Access
36

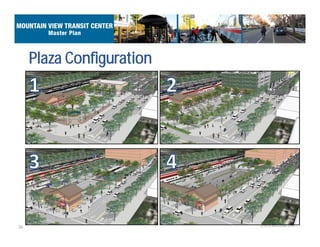

Plaza Configuration
37

Transit-Oriented Development
38

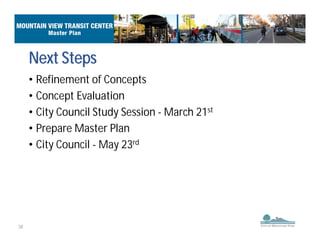

Next Steps
• Refinement of Concepts
• Concept Evaluation
• City Council Study Session - March 21st
• Prepare Master Plan
• City Council - May 23rd
39

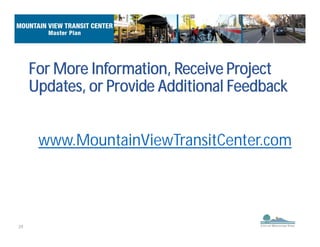

www.MountainViewTransitCenter.com
For More Information, Receive Project
Updates, or Provide Additional Feedback

Mt view tcmp community_meeting_2-02-17
