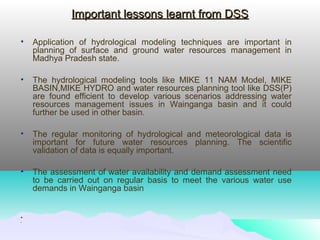

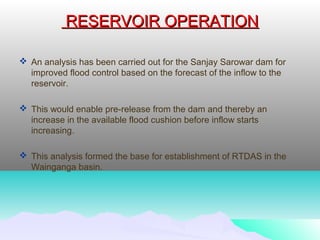

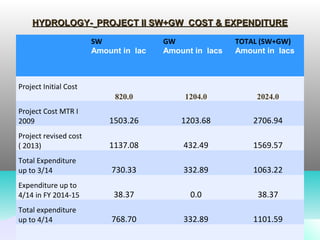

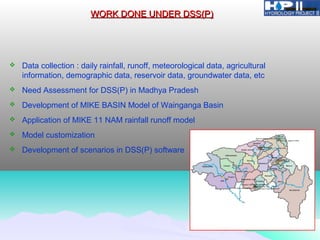

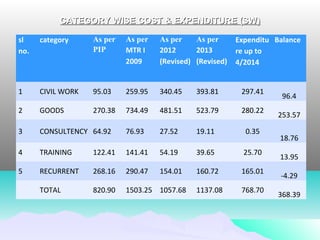

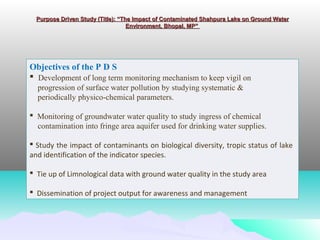

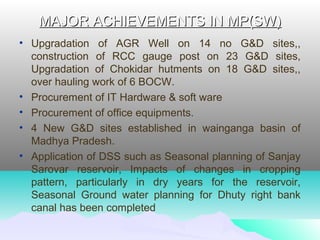

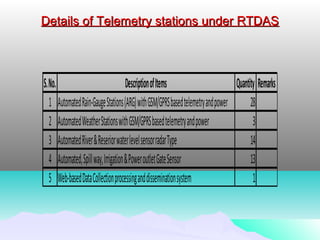

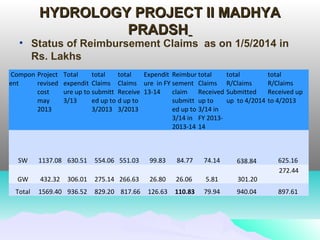

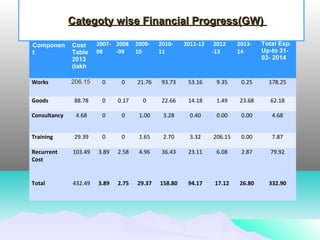

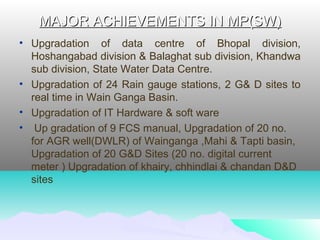

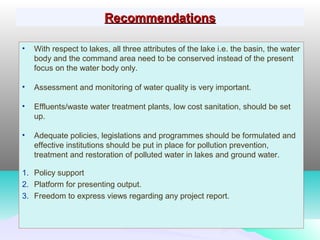

The document summarizes a review meeting for the Hydrology Project Phase II in Madhya Pradesh, India. The project involves establishing surface water and groundwater monitoring stations. For surface water, 24 river gauge stations and 52 meteorological stations were set up across three river basins. For groundwater, 3750 observation wells and 625 piezometer wells were established. The project period was from 2004-2014 with a total cost of Rs. 24.67 crores. Major achievements included upgrading monitoring stations, establishing new stations, and developing decision support systems for reservoir management and groundwater planning. Lessons learned and plans for continuing activities after the project are also discussed.
