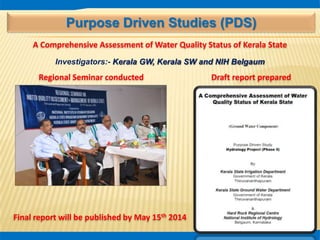

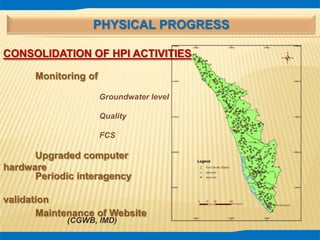

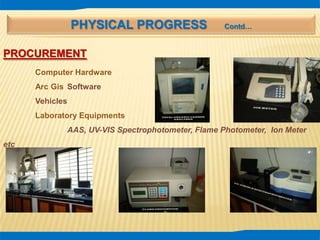

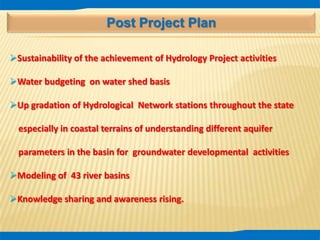

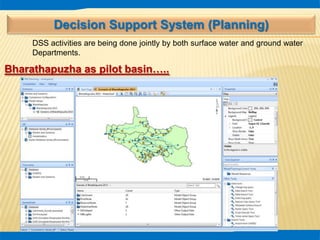

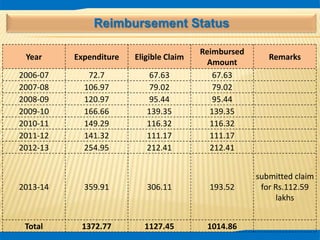

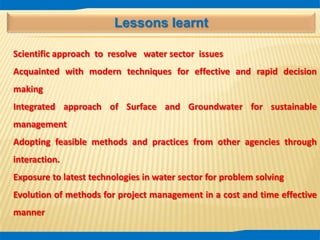

The document summarizes two hydrology projects in Kerala, India from 1996-2004 and 2006-2014. It provides financial details and physical progress updates on the projects, including building construction, staff hiring, equipment procurement, and the establishment of data dissemination and decision support systems. Key accomplishments include the development of applications to study conjunctive use, artificial recharge, reservoir operation, and more. Lessons learned include the benefits of integrated surface and groundwater management and adopting techniques from other agencies.
