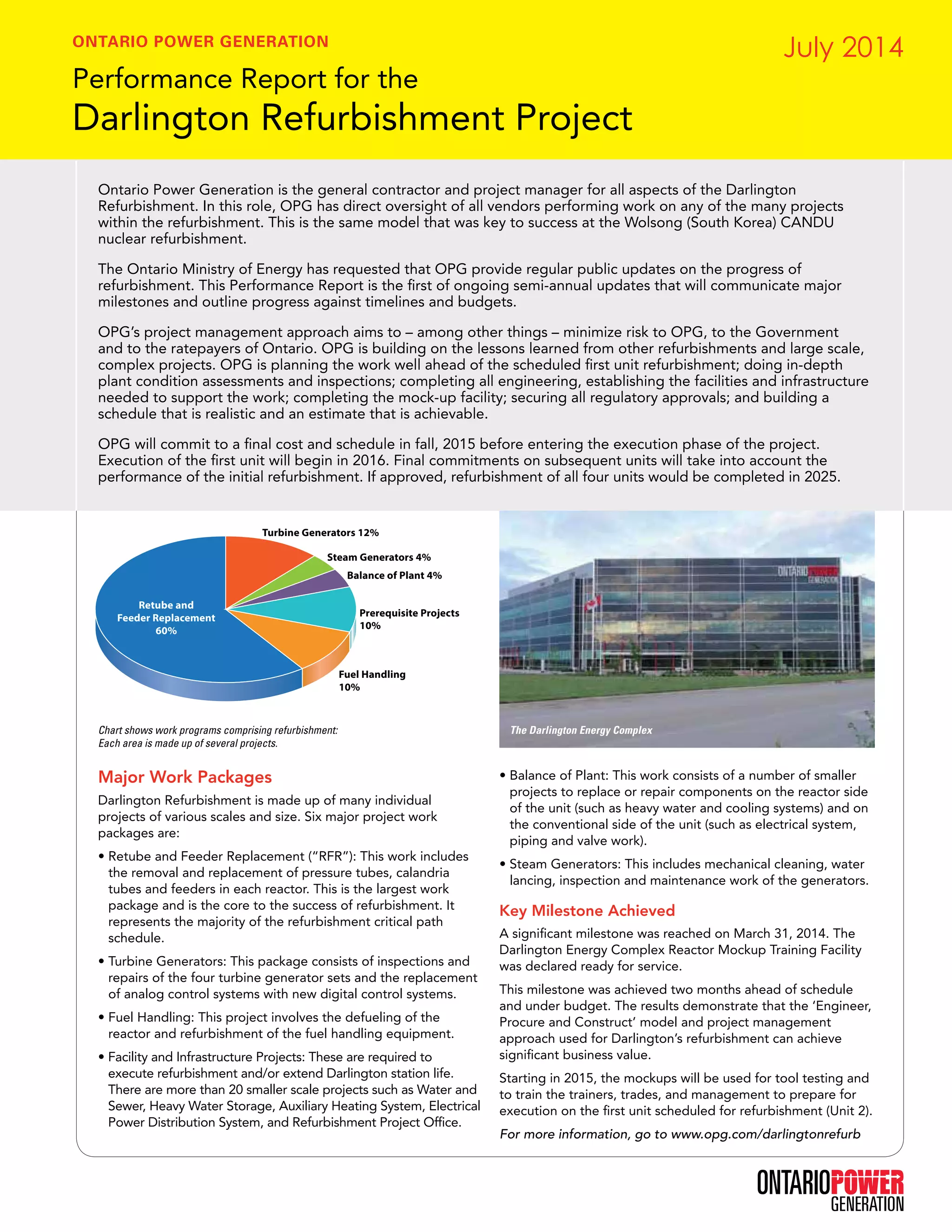

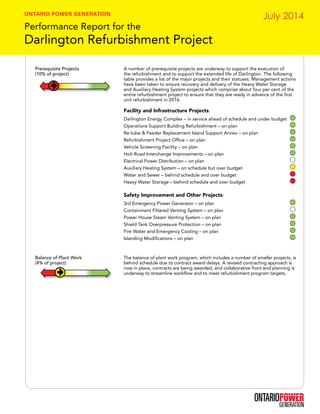

The document provides an update on the progress of Ontario Power Generation's Darlington Refurbishment Project. It reports that the project is currently in the definition and preparation phase ahead of beginning the first unit refurbishment in October 2016. While some prerequisite projects are behind schedule, overall the project remains on schedule and on budget, with safety performance exceeding targets. The reactor mockup training facility was completed ahead of schedule and under budget.
