CONSTRUCTION MANAGEMENT AND
ENGINEERING ECONOMICS
Module-1
Dr.Vinay Kumar B M
Syllabus
Construction Management
It is a professional service that uses
specialized, project management
techniques to oversee the planning,
design, and construction of a project,
from its beginning to its end.
Engineering Economics
It is the application of economic
techniques to the evaluation of design
and engineering alternatives.
The role of engineering economics is
to assess the appropriateness of a
given project, estimate its value, and
justify it from an engineering
standpoint.
Seven principles of Engineering Economics
1. Develop the alternatives
2. Focus on the differences
3. Use a consistent viewpoint
4. Use a common unit of measure
5. Consider all relevant criteria
6. Make uncertainty explicit
7. Revisit your decision
Basic Terminologies
Present Worth
Present worth, Present Value and Principal all represent the value of money at
time zero, which is the beginning of the engineering economic analysis period
under investigation.
In formulas, the present sum of money may be labeled as PW, PV, P or P0. All
four of these symbols represent the same initial time frame, which is time
zero.
Future Worth
• Future worth (FW), future value (F) or (F0) represent the future sum of
money including principal plus interest.
• Future values occur at any point in time in the future and they are usually
designated as the end of the engineering economic analysis period if they
are the last activity to occur in the analysis period.
Annuities: Uniform Series
• Annuities represent a payment or disbursement stream deposited or
withdrawn at equal set intervals such as daily, weekly, monthly, or yearly.
• As each annuity is deposited into an interest bearing account, it begins to
draw interest at the end of each compounding period.
Salvage value
• The salvage value is what an asset is worth at the end: of its useful life. In
engineering economic analysis, the salvage value is represented by a
future value occurring at the end of the analysis period.
• It is not always possible to accurately determine what a future salvage
value of an asset will be; therefore, for the purpose of an analysis, a
reasonable salvage value is assumed and included· in the calculations.
Sunk Cost
• Sunk cost is a difficult concept to understand when performing engineering
economic analysis.
• Sunk cost represents funds not recoverable because they have already
been expended sometime in the past. This is known as the past cost of an
equipment/asset.
• An example of a sunk cost would be spending $5 million on building a factory that is projected to cost $10 million. The $5 million already
spent—the sunk cost—should not be taken into account when deciding whether the factory should be completed
Marginal Cost
• Marginal cost of a product is the cost of producing an additional unit of that
product
• What is marginal cost example?
• Marginal cost refers to the additional cost to produce each additional unit. For example, it may cost $10 to make 10 cups of Coffee. To make another
would cost $0.80. Therefore, that is the marginal cost – the additional cost to produce one extra unit of output.
Marginal Revenue
• Marginal revenue of a product is the incremental revenue of selling an additional
unit of that product.
Opportunity Cost
• In practice, if an alternative (A) is selected from a set of competing alternatives
(A,B), then the corresponding investment in the selected alternative is not
available for any other purpose.
• If the same money is invested in some other alternative (B), it may fetch some
return. Since the money is invested in the selected alternative (A), one has to
forego the return from the other alternative (B).
• The amount that is foregone by not investing in the other alternative (B) is
known as the opportunity cost of the selected alternative (A).
Capitalized cost
• Capitalized cost is a term used in engineering economics and it refers to the
present worth of a project with an infinite life.
• In other words, capitalized cost is a lump sum of money needed today (t = 0)
to support an infinite life project simply on earned interest only.
• The concept of capitalized cost usually applies to public projects such as
airports, bridges, dams, and long term private projects such as hospitals and
private airports
Time value of money
• The time value of money (TVM) is the idea that money available at the
present time is worth more than the same amount in the future due to its
potential earning capacity.
• This core principle of finance holds that, money can earn interest, any
amount of money is worth more the sooner it is received.
• Time Value of Money (TVM) is an important concept in financial
management.

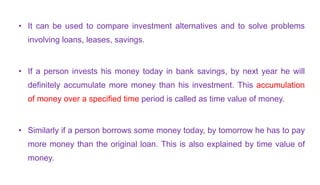

• It can be used to compare investment alternatives and to solve problems
involving loans, leases, savings.
• If a person invests his money today in bank savings, by next year he will
definitely accumulate more money than his investment. This accumulation
of money over a specified time period is called as time value of money.
• Similarly if a person borrows some money today, by tomorrow he has to pay
more money than the original loan. This is also explained by time value of
money.
• The time value of money is generally expressed by interest amount.
• The original investment or the borrowed amount (i.e. loan) is known as
the principal.
• The amount of interest indicates the increase between principal amount
invested or borrowed and the final amount received or owed.
• In case of an investment made in the past, the total amount of
interest accumulated till now is given by;
• Similarly in case of a loan taken in past, the total amount of interest is
given by;
In both the cases there is a net increase over the amount of money that
was originally invested or borrowed.

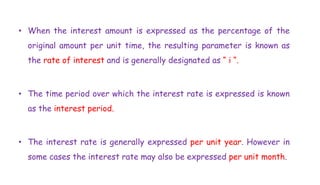

• When the interest amount is expressed as the percentage of the
original amount per unit time, the resulting parameter is known as
the rate of interest and is generally designated as “ i “.
• The time period over which the interest rate is expressed is known
as the interest period.
• The interest rate is generally expressed per unit year. However in
some cases the interest rate may also be expressed per unit month.

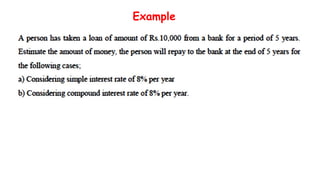

Example
Simple interest
• The interest is said to simple, when the interest is charged only on
the principal amount for the interest period.
• No interest is charged on the interest amount accrued during the
preceding interest periods.
• In case of simple interest, the total amount of interest accumulated
for a given interest period is simply a product of the principal
amount, the rate of interest and the number of interest periods.
• It is given by the following expression.
Simple interest reflects the effect of time value of money
only on the principal amount
Compound interest
• The interest is said to be compound, when the interest for any
interest period is charged on principal amount plus the interest
amount accrued in all the previous interest periods.
• Compound interest takes into account the effect of time value of
money on both principal as well as on the accrued interest also.
Example
Cash flow diagram
• The graphical representation of the cash flows i.e. both cash
outflows and cash inflows with respect to a time scale is generally
referred as cash flow diagram.
• The cash outflows (i.e. costs or expense) are generally represented by
vertically downward arrows whereas the cash inflows (i.e. revenue or
income) are represented by vertically upward arrows.
• In the cash flow diagram, number of interest periods is shown on the
time scale.
• The interest period may be a quarter, a month or a year.
• Since the cash flows generally occur at different time intervals within
an interest period, for ease of calculation, all the cash flows are
assumed to occur at the end of an interest period.

• In Fig. the cash outflows are Rs.100000, Rs.15000 and Rs.25000
occurring at end of year (EOY) “0” i.e. at the beginning, EOY “4” and
EOY “7” respectively.
• Similarly the cash inflows Rs.35000, Rs.80000 and Rs.45000 are
occurring at EOY “3”, EOY “6” and EOY “10” respectively.
Compound interest factors
• The compound interest factors and the corresponding formulas are
used to find out the unknown amounts at a given interest rate
continued for certain interest periods from the known values of
varying cash flows.
• The following are the notations used for deriving the compound
interest factors.
Unless otherwise stated, the rate of interest is compound interest
and is for the entire number of interest periods i.e. for “n” interest
periods.
• The present worth (P), future worth (F) and uniform annual worth (A)
are shown in Fig.
• In this figure the present worth, P is at the beginning and the uniform
annual series with annual value “A” is from end of year 1 till end of year
5.
• Both “P” and “A” are cash outflows.
• It may be noted that the uniform annual series with annual value “A”
may be also continued throughout the entire interest periods i.e. from
beginning till end of year 10 or for some intermediate interest periods
like commencing from end of year 3 till end of year 8.
• The future worth “F” is occurring at end of year 4 (cash outflow), at
end of year 6 (cash inflow) and at the end of year 10 (cash inflow).
Single payment compound amount factor (SPCAF)
• The single payment compound amount factor is used to compute the
future worth (F) accumulated after “n” years from the known
present worth (P) at a given interest rate ‘i’ per interest period.
• It is assumed that the interest period is in years and the interest is
compounded once per interest period.

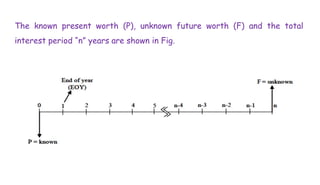

The known present worth (P), unknown future worth (F) and the total
interest period “n” years are shown in Fig.

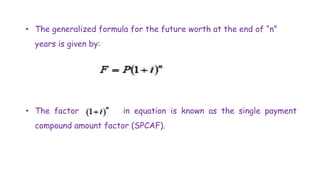

• The generalized formula for the future worth at the end of “n”
years is given by:
• The factor in equation is known as the single payment
compound amount factor (SPCAF).
Single payment present worth factor (SPPWF)
• The single payment present worth factor is used to determine the
present worth of a known future worth (F) at the end of “n” years
at a given interest rate ‘i’ per interest period.
• The present worth (P), future worth (F) and the total interest
period “n” years are shown in Fig.
• From the previous equation, the expression for the present worth
(P) can be written as follows;
• The factor in equation is known as single payment present
worth factor (SPPWF).
Uniform series present worth factor (USPWF)
• The uniform-series present worth factor is used to determine the
present worth of a known uniform series.
• Let “A” be the uniform annual amount at the end of each year,
beginning from end of year “1” till end of year “n”.
• The known “A”, unknown “P”, and the total interest period “n” years
are shown in Fig.

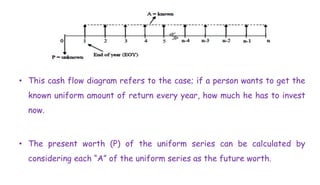

• This cash flow diagram refers to the case; if a person wants to get the
known uniform amount of return every year, how much he has to invest
now.
• The present worth (P) of the uniform series can be calculated by
considering each “A” of the uniform series as the future worth.

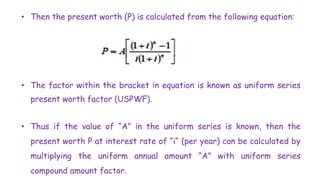

• Then the present worth (P) is calculated from the following equation:
• The factor within the bracket in equation is known as uniform series
present worth factor (USPWF).
• Thus if the value of “A” in the uniform series is known, then the
present worth P at interest rate of “i“ (per year) can be calculated by
multiplying the uniform annual amount “A” with uniform series
compound amount factor.
Capital recovery factor (CRF)
• The capital recovery factor is generally used to find out the
uniform annual amount “A” of a uniform series from the known
present worth at a given interest rate ‘i’ per interest period.
• The cash flow diagram is shown in Fig.
• This cash flow diagram indicates, if a person invests a certain amount
now, how much he will get as return by an equal amount each year.
• The expression for the uniform annual amount (A) can be written as
follows;
• The factor within bracket in equation is known as the capital recovery
factor (CRF).
Uniform series compound amount factor
• The uniform series compound amount factor is used to determine the
future sum (F) of a known uniform annual series with uniform amount
“A”.
• The cash flow diagram is shown in Fig.
• This cash flow diagram states that, if a person invests a uniform
amount at the end of each year continued for “n” years at interest rate
of “i” per year, how much he will get at the end of “n” years.
• This can be calculated from the following equation:
• The factor within bracket in equation is known as uniform series
compound amount factor (USCAF).
Sinking fund factor
• The sinking fund factor is used to calculate the annual amount “A‟ of a
uniform series from the known future sum “F”.
• The cash flow diagram is shown in Fig.
• This cash flow diagram indicates that, if a person wants to get a known
future sum at the end of “n” years at interest rate of “i” per year, how
much he has to invest every year by an equal amount.
• The expression for the uniform annual amount (A) can be written as
follows;
• The factor within bracket in equation is known as sinking fund factor
(SFF).
Interest factors with rate of interest ‘i’ (%) and number of
interest periods ‘n’
Problems
1. A person is investing 7,500/- every year in a recurring deposit of 8
years. What is the amount you can expect to receive if the
interest rate is 10%.
Ans: 85770/-
2. What amount a person should invest every year in order to get lumsum
of 1 lakh at the end of 5 years. If the interest rate is 12%.
Ans : 15740/-
3.If a person borrows Rs.2,50,000/- now what is the uniform amount he is
expected to pay every year for next 7 years in order to repay the capital
amount borrowed? i = 10%
Ans : 51,160/-
4. A person secures a loan of Rs.2,00,000 at a interest of 10%
compounded annually and starts an industry. The bank allows an free
period of 3 years. Calculate uniform end of payment to liquidate the debt
for a period of 9 years. What will be the total amount paid to the bank

5. A person borrows Rs 1 lakh from a bank to start a enterprise. For first
four years he doesn’t repay the loan. But at the end of 4 years he
obtains a further loan of Rs.1 lakh from the bank. After 6 years he
starts repayment of both loans and clears them in a further period of 10
years. Calculate the yearly installment that he has to pay uniformly at 8%
interest rate.
6. A Person takes a loan of 5 lakhs to start a industry at a rate of 15%. He
starts liquidating for 3 years after borrowing and opts for uniform period
of 16 years. Find out amount of each payment : (a) Yearly (b) Monthly.
Nominal and Effective Interest

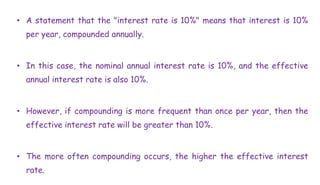

• An interest rate takes two forms: nominal interest rate and effective
interest rate.
• The nominal interest rate does not take into account the compounding
period.
• The effective interest rate does take the compounding period into
account and thus is a more accurate measure of interest charges.
• A statement that the "interest rate is 10%" means that interest is 10%
per year, compounded annually.
• In this case, the nominal annual interest rate is 10%, and the effective
annual interest rate is also 10%.
• However, if compounding is more frequent than once per year, then the
effective interest rate will be greater than 10%.
• The more often compounding occurs, the higher the effective interest
rate.

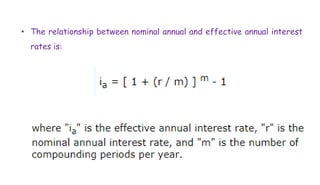

• The relationship between nominal annual and effective annual interest
rates is:
Comparison of Alternatives
• For most of the engineering projects, equipments etc., there are
more than one feasible alternative.
• It is the duty of the project management team (comprising of
engineers, designers, project managers etc.) of the client
organization to select the best alternative that involves less cost and
results more revenue.
• For this purpose, the economic comparison of the alternatives is
made.
• The different cost elements and other parameters to be considered
while making the economic comparison of the alternatives are initial
cost, annual operating and maintenance cost, annual income or receipts,
expected salvage value, income tax benefit and the useful life.
• When only one, among the feasible alternatives is selected, the
alternatives are said to be mutually exclusive.
• In the economic comparison of alternatives, cost or expenses are
considered as negative cash flows, whereas the income or revenues are
considered as positive cash flows.
• From the view point of expenditure incurred and revenue generated, some
projects involve initial capital investment i.e. cash outflow at the beginning
and show increased income or revenue i.e. cash inflow in the subsequent
years.
• The alternatives having this type of cash flow are known as investment
alternatives.

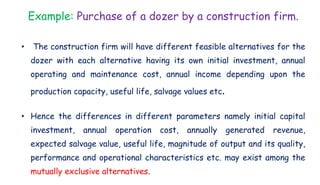

Example: Purchase of a dozer by a construction firm.
• The construction firm will have different feasible alternatives for the
dozer with each alternative having its own initial investment, annual
operating and maintenance cost, annual income depending upon the
production capacity, useful life, salvage values etc.
• Hence the differences in different parameters namely initial capital
investment, annual operation cost, annually generated revenue,
expected salvage value, useful life, magnitude of output and its quality,
performance and operational characteristics etc. may exist among the
mutually exclusive alternatives.
Methods of Comparison of alternatives
1. Present worth method
2. Future worth method
3. Annual worth method
In these methods all the cash flows i.e. cash outflows and cash inflows
are converted into equivalent present worth, future worth or annual
worth considering the time value of money at a given interest rate per
interest period.
Comparison of alternatives by present worth
method
• In the present worth method for comparison of mutually exclusive
alternatives, the future amounts i.e. expenditures and incomes
occurring at future periods of time are converted into equivalent
present worth values at a certain rate of interest per interest
period and are added to present worth occurring at “0” time.
• The converted equivalent present worth values are always less than
the respective future amounts since the rate of interest is normally
greater than zero.
• Thus the cash flow of the mutually exclusive alternatives may consist of
future expenditures and incomes in different forms namely randomly
placed single amounts, uniform amount series commencing from end of
year 1, randomly placed uniform amount series i.e. commencing at time
period other than end of year 1.

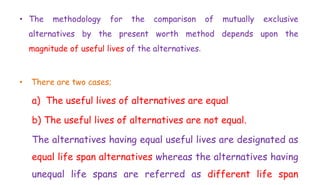

• The methodology for the comparison of mutually exclusive
alternatives by the present worth method depends upon the
magnitude of useful lives of the alternatives.
• There are two cases;
a) The useful lives of alternatives are equal

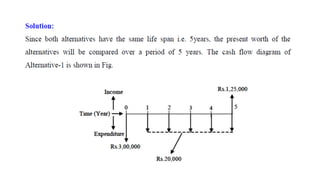

b) The useful lives of alternatives are not equal.
The alternatives having equal useful lives are designated as
equal life span alternatives whereas the alternatives having
unequal life spans are referred as different life span
Equal life span alternatives
• The comparison of mutually exclusive alternatives having equal life
spans by present worth method is comparatively simpler than those
having different life spans.
• In case of equal life span mutually exclusive alternatives, the future
amounts as already stated are converted into the equivalent present
worth values and are added to the present worth occurring at time
zero
• Then the alternative that exhibits maximum positive equivalent
present worth or minimum negative equivalent present worth is

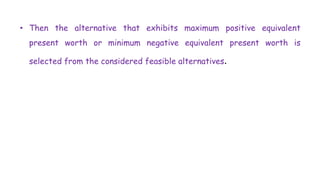

selected from the considered feasible alternatives.
Different life span alternatives
• In case of mutually exclusive alternatives, those have different life
spans, the comparison is generally made over the same number of
years i.e. a common study period.
• This is because; the comparison of the mutually exclusive
alternatives over same period of time is required for unbiased
economic evaluation of the alternatives.

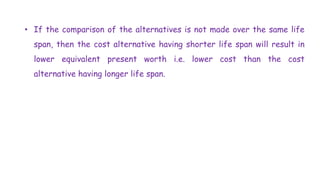

• If the comparison of the alternatives is not made over the same life
span, then the cost alternative having shorter life span will result in
lower equivalent present worth i.e. lower cost than the cost
alternative having longer life span.
The two approaches used for economic comparison of different life span
alternatives are as follows:
1. Comparison of mutually exclusive alternatives over a time period that
is equal to least common multiple (LCM) of the individual life spans.
2. Comparison of mutually exclusive alternatives over a study period
which is not necessarily equal to the life span of any of the
alternatives.

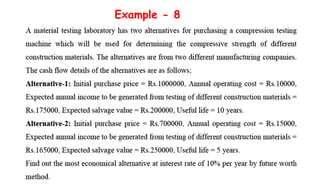

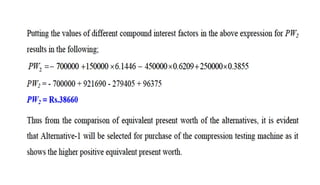

Example -1
Example -2

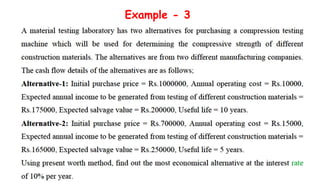

Example - 3
Comparison of alternatives by future worth method
• In the future worth method for comparison of mutually exclusive
alternatives, the equivalent future worth (i.e. value at the end of the
useful lives of alternatives) of all the expenditures and incomes
occurring at different periods of time are determined at the given
interest rate per interest period.
• The equivalent future worth of these expenditures and incomes will
be determined using different compound interest factors namely
single payment compound amount factor and uniform series compound
amount factor
Example -4 (Using data of Example-1)
Example -7
Example - 8
Comparison of alternatives by annual worth
method
• In this method, the mutually exclusive alternatives are compared on
the basis of equivalent uniform annual worth.
• The equivalent uniform annual worth represents the annual equivalent
value of all the cash inflows and cash outflows of the alternatives at
the given rate of interest per interest period.
• In this method of comparison, the equivalent uniform annual worth of
all expenditures and incomes of the alternatives are determined
using different compound interest factors
• Since equivalent uniform annual worth of the alternatives over the
useful life are determined, same procedure is followed irrespective of
the life spans of the alternatives i.e. whether it is the comparison of
equal life span alternatives or that of different life span alternatives.
• In other words, in case of comparison of different life span
alternatives by annual worth method, the comparison is not made over
the least common multiple of the life spans as is done in case of
present worth and future worth method.
• The reason is that even if the comparison is made over the least
common multiple of years, the equivalent uniform annual worth of the
alternative for more than one cycle of cash flow will be exactly same
as that of the first cycle provided the cash flow i.e. the costs and
incomes of the alternative in the successive cycles is exactly same as
that in the first cycle.
• Thus the comparison is made only for one cycle of cash flow of the
alternatives

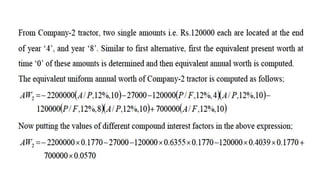

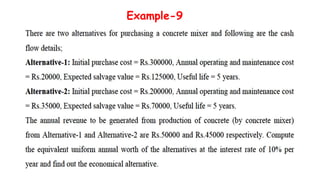

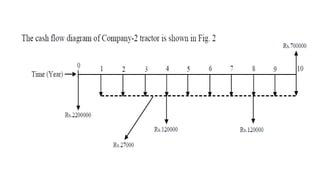

Example-9
Example -10
Module_1.pptx
Module_1.pptx
Module_1.pptx
Module_1.pptx
Module_1.pptx

More Related Content

Similar to Module_1.pptx

Unit 6 Project Financial Analysis Methods.pptx
Unit 6 Project Financial Analysis Methods.pptxUnit 6 Project Financial Analysis Methods.pptx
Unit 6 Project Financial Analysis Methods.pptx
vipulkhalati

1
11
Engineering economics
Engineering economicsEngineering economics
Engineering economics
Deepak Kumar

Capital Investment Analysis
Capital Investment AnalysisCapital Investment Analysis
Capital Investment Analysis
Flevy.com Best Practices

2.8 skill financial analysis
2.8 skill financial analysis2.8 skill financial analysis
2.8 skill financial analysis
NigestAbebaw1

PPT PM - Chapter 4 & 5.pdf
PPT PM - Chapter 4 & 5.pdfPPT PM - Chapter 4 & 5.pdf
PPT PM - Chapter 4 & 5.pdf
jitendramane8

Investment appraisal techniques
Investment appraisal techniquesInvestment appraisal techniques
Investment appraisal techniques
N A M COLLEGE KALLIKKANDY

Unit 4 economic analysis of enterprises.pptx
Unit 4 economic analysis of enterprises.pptxUnit 4 economic analysis of enterprises.pptx
Unit 4 economic analysis of enterprises.pptx
NabarajUpadhaya

Engineering economics Slides for Postgraduates
Engineering economics Slides for PostgraduatesEngineering economics Slides for Postgraduates
Engineering economics Slides for Postgraduates
ssuser50050d1

Lecture 4 Economic Assessment EDIT.pptx
Lecture 4 Economic Assessment EDIT.pptxLecture 4 Economic Assessment EDIT.pptx
Lecture 4 Economic Assessment EDIT.pptx
MuhammadZuhdiIbrahim

Chapter 4 : Time Value of money part 1 & 2
Chapter 4 : Time Value of money part 1 & 2Chapter 4 : Time Value of money part 1 & 2
Chapter 4 : Time Value of money part 1 & 2
maniarasan8

7. capitalbudgeting
7. capitalbudgeting7. capitalbudgeting
7. capitalbudgeting
Minnie Flores

FM Ch6 Capital Budgeting.pptx
FM Ch6 Capital Budgeting.pptxFM Ch6 Capital Budgeting.pptx
FM Ch6 Capital Budgeting.pptx
BarzalaCarcar

Time value of money 1
Time value of money 1Time value of money 1
Time value of money 1
Sandeep Surya

Time Value Of Money F F M
Time  Value Of  Money   F F MTime  Value Of  Money   F F M
Time Value Of Money F F M
Zoha Qureshi

2023 Capital Budgeting.pptx
2023 Capital Budgeting.pptx2023 Capital Budgeting.pptx
2023 Capital Budgeting.pptx
Rohit164330

COST OF CAPITAL.pptx
COST OF CAPITAL.pptxCOST OF CAPITAL.pptx
COST OF CAPITAL.pptx
G.S.S.D.G.S. KHALSA COLLEGE

The analysis and valuation of bonds copy
The analysis and valuation of bonds   copyThe analysis and valuation of bonds   copy
The analysis and valuation of bonds copy
Kristelle Borres

The Discounted Cash Flow Valuation.pptx
The Discounted Cash Flow Valuation.pptxThe Discounted Cash Flow Valuation.pptx
The Discounted Cash Flow Valuation.pptx
asde13

Financial and economic analysis
Financial and economic analysisFinancial and economic analysis
Financial and economic analysis
Siladitya Bag

Similar to Module_1.pptx (20)

Unit 6 Project Financial Analysis Methods.pptx
Unit 6 Project Financial Analysis Methods.pptxUnit 6 Project Financial Analysis Methods.pptx
Unit 6 Project Financial Analysis Methods.pptx

1
11
1

Engineering economics
Engineering economicsEngineering economics
Engineering economics

Capital Investment Analysis
Capital Investment AnalysisCapital Investment Analysis
Capital Investment Analysis

2.8 skill financial analysis
2.8 skill financial analysis2.8 skill financial analysis
2.8 skill financial analysis

PPT PM - Chapter 4 & 5.pdf
PPT PM - Chapter 4 & 5.pdfPPT PM - Chapter 4 & 5.pdf
PPT PM - Chapter 4 & 5.pdf

Investment appraisal techniques
Investment appraisal techniquesInvestment appraisal techniques
Investment appraisal techniques

Unit 4 economic analysis of enterprises.pptx
Unit 4 economic analysis of enterprises.pptxUnit 4 economic analysis of enterprises.pptx
Unit 4 economic analysis of enterprises.pptx

Engineering economics Slides for Postgraduates
Engineering economics Slides for PostgraduatesEngineering economics Slides for Postgraduates
Engineering economics Slides for Postgraduates

Lecture 4 Economic Assessment EDIT.pptx
Lecture 4 Economic Assessment EDIT.pptxLecture 4 Economic Assessment EDIT.pptx
Lecture 4 Economic Assessment EDIT.pptx

Chapter 4 : Time Value of money part 1 & 2
Chapter 4 : Time Value of money part 1 & 2Chapter 4 : Time Value of money part 1 & 2
Chapter 4 : Time Value of money part 1 & 2

7. capitalbudgeting
7. capitalbudgeting7. capitalbudgeting
7. capitalbudgeting

FM Ch6 Capital Budgeting.pptx
FM Ch6 Capital Budgeting.pptxFM Ch6 Capital Budgeting.pptx
FM Ch6 Capital Budgeting.pptx

Time value of money 1
Time value of money 1Time value of money 1
Time value of money 1

Time Value Of Money F F M
Time  Value Of  Money   F F MTime  Value Of  Money   F F M
Time Value Of Money F F M

2023 Capital Budgeting.pptx
2023 Capital Budgeting.pptx2023 Capital Budgeting.pptx
2023 Capital Budgeting.pptx

COST OF CAPITAL.pptx
COST OF CAPITAL.pptxCOST OF CAPITAL.pptx
COST OF CAPITAL.pptx

The analysis and valuation of bonds copy
The analysis and valuation of bonds   copyThe analysis and valuation of bonds   copy
The analysis and valuation of bonds copy

The Discounted Cash Flow Valuation.pptx
The Discounted Cash Flow Valuation.pptxThe Discounted Cash Flow Valuation.pptx
The Discounted Cash Flow Valuation.pptx

Financial and economic analysis
Financial and economic analysisFinancial and economic analysis
Financial and economic analysis

Recently uploaded

AI assisted telemedicine KIOSK for Rural India.pptx
AI assisted telemedicine KIOSK for Rural India.pptxAI assisted telemedicine KIOSK for Rural India.pptx
AI assisted telemedicine KIOSK for Rural India.pptx
architagupta876

Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
shadow0702a

Engineering Drawings Lecture Detail Drawings 2014.pdf
Engineering Drawings Lecture Detail Drawings 2014.pdfEngineering Drawings Lecture Detail Drawings 2014.pdf
Engineering Drawings Lecture Detail Drawings 2014.pdf
abbyasa1014

Null Bangalore | Pentesters Approach to AWS IAM
Null Bangalore | Pentesters Approach to AWS IAMNull Bangalore | Pentesters Approach to AWS IAM
Null Bangalore | Pentesters Approach to AWS IAM
Divyanshu

The Python for beginners. This is an advance computer language.
The Python for beginners. This is an advance computer language.The Python for beginners. This is an advance computer language.
The Python for beginners. This is an advance computer language.
sachin chaurasia

原版制作(Humboldt毕业证书)柏林大学毕业证学位证一模一样
原版制作(Humboldt毕业证书)柏林大学毕业证学位证一模一样原版制作(Humboldt毕业证书)柏林大学毕业证学位证一模一样
原版制作(Humboldt毕业证书)柏林大学毕业证学位证一模一样
ydzowc

Software Quality Assurance-se412-v11.ppt
Software Quality Assurance-se412-v11.pptSoftware Quality Assurance-se412-v11.ppt
Software Quality Assurance-se412-v11.ppt
TaghreedAltamimi

Mechanical Engineering on AAI Summer Training Report-003.pdf
Mechanical Engineering on AAI Summer Training Report-003.pdfMechanical Engineering on AAI Summer Training Report-003.pdf
Mechanical Engineering on AAI Summer Training Report-003.pdf
21UME003TUSHARDEB

Manufacturing Process of molasses based distillery ppt.pptx
Manufacturing Process of molasses based distillery ppt.pptxManufacturing Process of molasses based distillery ppt.pptx
Manufacturing Process of molasses based distillery ppt.pptx
Madan Karki

Material for memory and display system h
Material for memory and display system hMaterial for memory and display system h
Material for memory and display system h
gowrishankartb2005

Certificates - Mahmoud Mohamed Moursi Ahmed
Certificates - Mahmoud Mohamed Moursi AhmedCertificates - Mahmoud Mohamed Moursi Ahmed
Certificates - Mahmoud Mohamed Moursi Ahmed
Mahmoud Morsy

john krisinger-the science and history of the alcoholic beverage.pptx
john krisinger-the science and history of the alcoholic beverage.pptxjohn krisinger-the science and history of the alcoholic beverage.pptx
john krisinger-the science and history of the alcoholic beverage.pptx
Madan Karki

4. Mosca vol I -Fisica-Tipler-5ta-Edicion-Vol-1.pdf
4. Mosca vol I -Fisica-Tipler-5ta-Edicion-Vol-1.pdf4. Mosca vol I -Fisica-Tipler-5ta-Edicion-Vol-1.pdf
4. Mosca vol I -Fisica-Tipler-5ta-Edicion-Vol-1.pdf
Gino153088

KuberTENes Birthday Bash Guadalajara - K8sGPT first impressions
KuberTENes Birthday Bash Guadalajara - K8sGPT first impressionsKuberTENes Birthday Bash Guadalajara - K8sGPT first impressions
KuberTENes Birthday Bash Guadalajara - K8sGPT first impressions
Victor Morales

学校原版美国波士顿大学毕业证学历学位证书原版一模一样
学校原版美国波士顿大学毕业证学历学位证书原版一模一样学校原版美国波士顿大学毕业证学历学位证书原版一模一样
学校原版美国波士顿大学毕业证学历学位证书原版一模一样
171ticu

官方认证美国密歇根州立大学毕业证学位证书原版一模一样
官方认证美国密歇根州立大学毕业证学位证书原版一模一样官方认证美国密歇根州立大学毕业证学位证书原版一模一样
官方认证美国密歇根州立大学毕业证学位证书原版一模一样
171ticu

Unit-III-ELECTROCHEMICAL STORAGE DEVICES.ppt
Unit-III-ELECTROCHEMICAL STORAGE DEVICES.pptUnit-III-ELECTROCHEMICAL STORAGE DEVICES.ppt
Unit-III-ELECTROCHEMICAL STORAGE DEVICES.ppt
KrishnaveniKrishnara1

Electric vehicle and photovoltaic advanced roles in enhancing the financial p...
Electric vehicle and photovoltaic advanced roles in enhancing the financial p...Electric vehicle and photovoltaic advanced roles in enhancing the financial p...
Electric vehicle and photovoltaic advanced roles in enhancing the financial p...
IJECEIAES

Transformers design and coooling methods
Transformers design and coooling methodsTransformers design and coooling methods
Transformers design and coooling methods
Roger Rozario

Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024
Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024
Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024
Sinan KOZAK

Recently uploaded (20)

AI assisted telemedicine KIOSK for Rural India.pptx
AI assisted telemedicine KIOSK for Rural India.pptxAI assisted telemedicine KIOSK for Rural India.pptx
AI assisted telemedicine KIOSK for Rural India.pptx

Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...

Engineering Drawings Lecture Detail Drawings 2014.pdf
Engineering Drawings Lecture Detail Drawings 2014.pdfEngineering Drawings Lecture Detail Drawings 2014.pdf
Engineering Drawings Lecture Detail Drawings 2014.pdf

Null Bangalore | Pentesters Approach to AWS IAM
Null Bangalore | Pentesters Approach to AWS IAMNull Bangalore | Pentesters Approach to AWS IAM
Null Bangalore | Pentesters Approach to AWS IAM

The Python for beginners. This is an advance computer language.
The Python for beginners. This is an advance computer language.The Python for beginners. This is an advance computer language.
The Python for beginners. This is an advance computer language.

原版制作(Humboldt毕业证书)柏林大学毕业证学位证一模一样
原版制作(Humboldt毕业证书)柏林大学毕业证学位证一模一样原版制作(Humboldt毕业证书)柏林大学毕业证学位证一模一样
原版制作(Humboldt毕业证书)柏林大学毕业证学位证一模一样

Software Quality Assurance-se412-v11.ppt
Software Quality Assurance-se412-v11.pptSoftware Quality Assurance-se412-v11.ppt
Software Quality Assurance-se412-v11.ppt

Mechanical Engineering on AAI Summer Training Report-003.pdf
Mechanical Engineering on AAI Summer Training Report-003.pdfMechanical Engineering on AAI Summer Training Report-003.pdf
Mechanical Engineering on AAI Summer Training Report-003.pdf

Manufacturing Process of molasses based distillery ppt.pptx
Manufacturing Process of molasses based distillery ppt.pptxManufacturing Process of molasses based distillery ppt.pptx
Manufacturing Process of molasses based distillery ppt.pptx

Material for memory and display system h
Material for memory and display system hMaterial for memory and display system h
Material for memory and display system h

Certificates - Mahmoud Mohamed Moursi Ahmed
Certificates - Mahmoud Mohamed Moursi AhmedCertificates - Mahmoud Mohamed Moursi Ahmed
Certificates - Mahmoud Mohamed Moursi Ahmed

john krisinger-the science and history of the alcoholic beverage.pptx
john krisinger-the science and history of the alcoholic beverage.pptxjohn krisinger-the science and history of the alcoholic beverage.pptx
john krisinger-the science and history of the alcoholic beverage.pptx

4. Mosca vol I -Fisica-Tipler-5ta-Edicion-Vol-1.pdf
4. Mosca vol I -Fisica-Tipler-5ta-Edicion-Vol-1.pdf4. Mosca vol I -Fisica-Tipler-5ta-Edicion-Vol-1.pdf
4. Mosca vol I -Fisica-Tipler-5ta-Edicion-Vol-1.pdf

KuberTENes Birthday Bash Guadalajara - K8sGPT first impressions
KuberTENes Birthday Bash Guadalajara - K8sGPT first impressionsKuberTENes Birthday Bash Guadalajara - K8sGPT first impressions
KuberTENes Birthday Bash Guadalajara - K8sGPT first impressions

学校原版美国波士顿大学毕业证学历学位证书原版一模一样
学校原版美国波士顿大学毕业证学历学位证书原版一模一样学校原版美国波士顿大学毕业证学历学位证书原版一模一样
学校原版美国波士顿大学毕业证学历学位证书原版一模一样

官方认证美国密歇根州立大学毕业证学位证书原版一模一样
官方认证美国密歇根州立大学毕业证学位证书原版一模一样官方认证美国密歇根州立大学毕业证学位证书原版一模一样
官方认证美国密歇根州立大学毕业证学位证书原版一模一样

Unit-III-ELECTROCHEMICAL STORAGE DEVICES.ppt
Unit-III-ELECTROCHEMICAL STORAGE DEVICES.pptUnit-III-ELECTROCHEMICAL STORAGE DEVICES.ppt
Unit-III-ELECTROCHEMICAL STORAGE DEVICES.ppt

Electric vehicle and photovoltaic advanced roles in enhancing the financial p...
Electric vehicle and photovoltaic advanced roles in enhancing the financial p...Electric vehicle and photovoltaic advanced roles in enhancing the financial p...
Electric vehicle and photovoltaic advanced roles in enhancing the financial p...

Transformers design and coooling methods
Transformers design and coooling methodsTransformers design and coooling methods
Transformers design and coooling methods

Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024
Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024
Optimizing Gradle Builds - Gradle DPE Tour Berlin 2024

Module_1.pptx

  • 1. CONSTRUCTION MANAGEMENT AND ENGINEERING ECONOMICS Module-1 Dr.Vinay Kumar B M
  • 3. Construction Management It is a professional service that uses specialized, project management techniques to oversee the planning, design, and construction of a project, from its beginning to its end. Engineering Economics It is the application of economic techniques to the evaluation of design and engineering alternatives. The role of engineering economics is to assess the appropriateness of a given project, estimate its value, and justify it from an engineering standpoint.
  • 4. Seven principles of Engineering Economics 1. Develop the alternatives 2. Focus on the differences 3. Use a consistent viewpoint 4. Use a common unit of measure 5. Consider all relevant criteria 6. Make uncertainty explicit 7. Revisit your decision
  • 5. Basic Terminologies Present Worth Present worth, Present Value and Principal all represent the value of money at time zero, which is the beginning of the engineering economic analysis period under investigation. In formulas, the present sum of money may be labeled as PW, PV, P or P0. All four of these symbols represent the same initial time frame, which is time zero.
  • 6. Future Worth • Future worth (FW), future value (F) or (F0) represent the future sum of money including principal plus interest. • Future values occur at any point in time in the future and they are usually designated as the end of the engineering economic analysis period if they are the last activity to occur in the analysis period.
  • 7. Annuities: Uniform Series • Annuities represent a payment or disbursement stream deposited or withdrawn at equal set intervals such as daily, weekly, monthly, or yearly. • As each annuity is deposited into an interest bearing account, it begins to draw interest at the end of each compounding period.
  • 8. Salvage value • The salvage value is what an asset is worth at the end: of its useful life. In engineering economic analysis, the salvage value is represented by a future value occurring at the end of the analysis period. • It is not always possible to accurately determine what a future salvage value of an asset will be; therefore, for the purpose of an analysis, a reasonable salvage value is assumed and included· in the calculations.
  • 9. Sunk Cost • Sunk cost is a difficult concept to understand when performing engineering economic analysis. • Sunk cost represents funds not recoverable because they have already been expended sometime in the past. This is known as the past cost of an equipment/asset. • An example of a sunk cost would be spending $5 million on building a factory that is projected to cost $10 million. The $5 million already spent—the sunk cost—should not be taken into account when deciding whether the factory should be completed
  • 10. Marginal Cost • Marginal cost of a product is the cost of producing an additional unit of that product • What is marginal cost example? • Marginal cost refers to the additional cost to produce each additional unit. For example, it may cost $10 to make 10 cups of Coffee. To make another would cost $0.80. Therefore, that is the marginal cost – the additional cost to produce one extra unit of output. Marginal Revenue • Marginal revenue of a product is the incremental revenue of selling an additional unit of that product.
  • 11. Opportunity Cost • In practice, if an alternative (A) is selected from a set of competing alternatives (A,B), then the corresponding investment in the selected alternative is not available for any other purpose. • If the same money is invested in some other alternative (B), it may fetch some return. Since the money is invested in the selected alternative (A), one has to forego the return from the other alternative (B). • The amount that is foregone by not investing in the other alternative (B) is known as the opportunity cost of the selected alternative (A).
  • 12. Capitalized cost • Capitalized cost is a term used in engineering economics and it refers to the present worth of a project with an infinite life. • In other words, capitalized cost is a lump sum of money needed today (t = 0) to support an infinite life project simply on earned interest only. • The concept of capitalized cost usually applies to public projects such as airports, bridges, dams, and long term private projects such as hospitals and private airports
  • 13. Time value of money
  • 14. • The time value of money (TVM) is the idea that money available at the present time is worth more than the same amount in the future due to its potential earning capacity. • This core principle of finance holds that, money can earn interest, any amount of money is worth more the sooner it is received. • Time Value of Money (TVM) is an important concept in financial management.
  • 15. • It can be used to compare investment alternatives and to solve problems involving loans, leases, savings. • If a person invests his money today in bank savings, by next year he will definitely accumulate more money than his investment. This accumulation of money over a specified time period is called as time value of money. • Similarly if a person borrows some money today, by tomorrow he has to pay more money than the original loan. This is also explained by time value of money.
  • 16. • The time value of money is generally expressed by interest amount. • The original investment or the borrowed amount (i.e. loan) is known as the principal. • The amount of interest indicates the increase between principal amount invested or borrowed and the final amount received or owed.
  • 17. • In case of an investment made in the past, the total amount of interest accumulated till now is given by; • Similarly in case of a loan taken in past, the total amount of interest is given by; In both the cases there is a net increase over the amount of money that was originally invested or borrowed.
  • 18. • When the interest amount is expressed as the percentage of the original amount per unit time, the resulting parameter is known as the rate of interest and is generally designated as “ i “. • The time period over which the interest rate is expressed is known as the interest period. • The interest rate is generally expressed per unit year. However in some cases the interest rate may also be expressed per unit month.
  • 20.

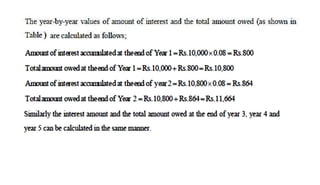

  • 21. Simple interest • The interest is said to simple, when the interest is charged only on the principal amount for the interest period. • No interest is charged on the interest amount accrued during the preceding interest periods. • In case of simple interest, the total amount of interest accumulated for a given interest period is simply a product of the principal amount, the rate of interest and the number of interest periods.
  • 22. • It is given by the following expression. Simple interest reflects the effect of time value of money only on the principal amount
  • 23. Compound interest • The interest is said to be compound, when the interest for any interest period is charged on principal amount plus the interest amount accrued in all the previous interest periods. • Compound interest takes into account the effect of time value of money on both principal as well as on the accrued interest also.
  • 25.
  • 26.
  • 27.
  • 28. Cash flow diagram • The graphical representation of the cash flows i.e. both cash outflows and cash inflows with respect to a time scale is generally referred as cash flow diagram.
  • 29. • The cash outflows (i.e. costs or expense) are generally represented by vertically downward arrows whereas the cash inflows (i.e. revenue or income) are represented by vertically upward arrows. • In the cash flow diagram, number of interest periods is shown on the time scale. • The interest period may be a quarter, a month or a year.
  • 30. • Since the cash flows generally occur at different time intervals within an interest period, for ease of calculation, all the cash flows are assumed to occur at the end of an interest period. • In Fig. the cash outflows are Rs.100000, Rs.15000 and Rs.25000 occurring at end of year (EOY) “0” i.e. at the beginning, EOY “4” and EOY “7” respectively. • Similarly the cash inflows Rs.35000, Rs.80000 and Rs.45000 are occurring at EOY “3”, EOY “6” and EOY “10” respectively.
  • 31. Compound interest factors • The compound interest factors and the corresponding formulas are used to find out the unknown amounts at a given interest rate continued for certain interest periods from the known values of varying cash flows. • The following are the notations used for deriving the compound interest factors.
  • 32. Unless otherwise stated, the rate of interest is compound interest and is for the entire number of interest periods i.e. for “n” interest periods.
  • 33. • The present worth (P), future worth (F) and uniform annual worth (A) are shown in Fig.
  • 34. • In this figure the present worth, P is at the beginning and the uniform annual series with annual value “A” is from end of year 1 till end of year 5. • Both “P” and “A” are cash outflows. • It may be noted that the uniform annual series with annual value “A” may be also continued throughout the entire interest periods i.e. from beginning till end of year 10 or for some intermediate interest periods like commencing from end of year 3 till end of year 8.
  • 35. • The future worth “F” is occurring at end of year 4 (cash outflow), at end of year 6 (cash inflow) and at the end of year 10 (cash inflow).
  • 36. Single payment compound amount factor (SPCAF) • The single payment compound amount factor is used to compute the future worth (F) accumulated after “n” years from the known present worth (P) at a given interest rate ‘i’ per interest period. • It is assumed that the interest period is in years and the interest is compounded once per interest period.
  • 37. The known present worth (P), unknown future worth (F) and the total interest period “n” years are shown in Fig.
  • 38. • The generalized formula for the future worth at the end of “n” years is given by: • The factor in equation is known as the single payment compound amount factor (SPCAF).
  • 39. Single payment present worth factor (SPPWF) • The single payment present worth factor is used to determine the present worth of a known future worth (F) at the end of “n” years at a given interest rate ‘i’ per interest period. • The present worth (P), future worth (F) and the total interest period “n” years are shown in Fig.
  • 40. • From the previous equation, the expression for the present worth (P) can be written as follows; • The factor in equation is known as single payment present worth factor (SPPWF).
  • 41. Uniform series present worth factor (USPWF) • The uniform-series present worth factor is used to determine the present worth of a known uniform series. • Let “A” be the uniform annual amount at the end of each year, beginning from end of year “1” till end of year “n”. • The known “A”, unknown “P”, and the total interest period “n” years are shown in Fig.
  • 42. • This cash flow diagram refers to the case; if a person wants to get the known uniform amount of return every year, how much he has to invest now. • The present worth (P) of the uniform series can be calculated by considering each “A” of the uniform series as the future worth.
  • 43. • Then the present worth (P) is calculated from the following equation: • The factor within the bracket in equation is known as uniform series present worth factor (USPWF). • Thus if the value of “A” in the uniform series is known, then the present worth P at interest rate of “i“ (per year) can be calculated by multiplying the uniform annual amount “A” with uniform series compound amount factor.
  • 44. Capital recovery factor (CRF) • The capital recovery factor is generally used to find out the uniform annual amount “A” of a uniform series from the known present worth at a given interest rate ‘i’ per interest period. • The cash flow diagram is shown in Fig.
  • 45. • This cash flow diagram indicates, if a person invests a certain amount now, how much he will get as return by an equal amount each year. • The expression for the uniform annual amount (A) can be written as follows; • The factor within bracket in equation is known as the capital recovery factor (CRF).
  • 46. Uniform series compound amount factor • The uniform series compound amount factor is used to determine the future sum (F) of a known uniform annual series with uniform amount “A”. • The cash flow diagram is shown in Fig.
  • 47. • This cash flow diagram states that, if a person invests a uniform amount at the end of each year continued for “n” years at interest rate of “i” per year, how much he will get at the end of “n” years. • This can be calculated from the following equation: • The factor within bracket in equation is known as uniform series compound amount factor (USCAF).
  • 48. Sinking fund factor • The sinking fund factor is used to calculate the annual amount “A‟ of a uniform series from the known future sum “F”. • The cash flow diagram is shown in Fig.
  • 49. • This cash flow diagram indicates that, if a person wants to get a known future sum at the end of “n” years at interest rate of “i” per year, how much he has to invest every year by an equal amount. • The expression for the uniform annual amount (A) can be written as follows; • The factor within bracket in equation is known as sinking fund factor (SFF).
  • 50. Interest factors with rate of interest ‘i’ (%) and number of interest periods ‘n’
  • 51. Problems 1. A person is investing 7,500/- every year in a recurring deposit of 8 years. What is the amount you can expect to receive if the interest rate is 10%. Ans: 85770/-
  • 52. 2. What amount a person should invest every year in order to get lumsum of 1 lakh at the end of 5 years. If the interest rate is 12%. Ans : 15740/- 3.If a person borrows Rs.2,50,000/- now what is the uniform amount he is expected to pay every year for next 7 years in order to repay the capital amount borrowed? i = 10% Ans : 51,160/-
  • 53. 4. A person secures a loan of Rs.2,00,000 at a interest of 10% compounded annually and starts an industry. The bank allows an free period of 3 years. Calculate uniform end of payment to liquidate the debt for a period of 9 years. What will be the total amount paid to the bank
  • 54.
  • 55. 5. A person borrows Rs 1 lakh from a bank to start a enterprise. For first four years he doesn’t repay the loan. But at the end of 4 years he obtains a further loan of Rs.1 lakh from the bank. After 6 years he starts repayment of both loans and clears them in a further period of 10 years. Calculate the yearly installment that he has to pay uniformly at 8% interest rate.
  • 56.
  • 57. 6. A Person takes a loan of 5 lakhs to start a industry at a rate of 15%. He starts liquidating for 3 years after borrowing and opts for uniform period of 16 years. Find out amount of each payment : (a) Yearly (b) Monthly.
  • 58.
  • 59. Nominal and Effective Interest • An interest rate takes two forms: nominal interest rate and effective interest rate. • The nominal interest rate does not take into account the compounding period. • The effective interest rate does take the compounding period into account and thus is a more accurate measure of interest charges.
  • 60. • A statement that the "interest rate is 10%" means that interest is 10% per year, compounded annually. • In this case, the nominal annual interest rate is 10%, and the effective annual interest rate is also 10%. • However, if compounding is more frequent than once per year, then the effective interest rate will be greater than 10%. • The more often compounding occurs, the higher the effective interest rate.
  • 61. • The relationship between nominal annual and effective annual interest rates is:
  • 63. • For most of the engineering projects, equipments etc., there are more than one feasible alternative. • It is the duty of the project management team (comprising of engineers, designers, project managers etc.) of the client organization to select the best alternative that involves less cost and results more revenue. • For this purpose, the economic comparison of the alternatives is made.
  • 64. • The different cost elements and other parameters to be considered while making the economic comparison of the alternatives are initial cost, annual operating and maintenance cost, annual income or receipts, expected salvage value, income tax benefit and the useful life. • When only one, among the feasible alternatives is selected, the alternatives are said to be mutually exclusive.
  • 65. • In the economic comparison of alternatives, cost or expenses are considered as negative cash flows, whereas the income or revenues are considered as positive cash flows. • From the view point of expenditure incurred and revenue generated, some projects involve initial capital investment i.e. cash outflow at the beginning and show increased income or revenue i.e. cash inflow in the subsequent years. • The alternatives having this type of cash flow are known as investment alternatives.
  • 66. Example: Purchase of a dozer by a construction firm. • The construction firm will have different feasible alternatives for the dozer with each alternative having its own initial investment, annual operating and maintenance cost, annual income depending upon the production capacity, useful life, salvage values etc. • Hence the differences in different parameters namely initial capital investment, annual operation cost, annually generated revenue, expected salvage value, useful life, magnitude of output and its quality, performance and operational characteristics etc. may exist among the mutually exclusive alternatives.
  • 67. Methods of Comparison of alternatives 1. Present worth method 2. Future worth method 3. Annual worth method In these methods all the cash flows i.e. cash outflows and cash inflows are converted into equivalent present worth, future worth or annual worth considering the time value of money at a given interest rate per interest period.

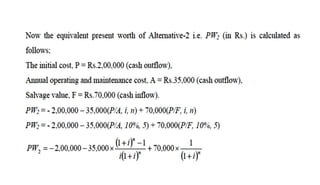

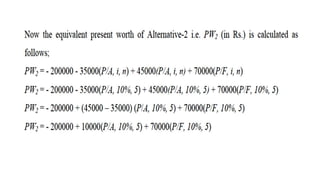

  • 68. Comparison of alternatives by present worth method • In the present worth method for comparison of mutually exclusive alternatives, the future amounts i.e. expenditures and incomes occurring at future periods of time are converted into equivalent present worth values at a certain rate of interest per interest period and are added to present worth occurring at “0” time. • The converted equivalent present worth values are always less than the respective future amounts since the rate of interest is normally greater than zero.
  • 69. • Thus the cash flow of the mutually exclusive alternatives may consist of future expenditures and incomes in different forms namely randomly placed single amounts, uniform amount series commencing from end of year 1, randomly placed uniform amount series i.e. commencing at time period other than end of year 1.
  • 70. • The methodology for the comparison of mutually exclusive alternatives by the present worth method depends upon the magnitude of useful lives of the alternatives. • There are two cases; a) The useful lives of alternatives are equal b) The useful lives of alternatives are not equal. The alternatives having equal useful lives are designated as equal life span alternatives whereas the alternatives having unequal life spans are referred as different life span
  • 71. Equal life span alternatives • The comparison of mutually exclusive alternatives having equal life spans by present worth method is comparatively simpler than those having different life spans. • In case of equal life span mutually exclusive alternatives, the future amounts as already stated are converted into the equivalent present worth values and are added to the present worth occurring at time zero
  • 72. • Then the alternative that exhibits maximum positive equivalent present worth or minimum negative equivalent present worth is selected from the considered feasible alternatives.
  • 73. Different life span alternatives • In case of mutually exclusive alternatives, those have different life spans, the comparison is generally made over the same number of years i.e. a common study period. • This is because; the comparison of the mutually exclusive alternatives over same period of time is required for unbiased economic evaluation of the alternatives.
  • 74. • If the comparison of the alternatives is not made over the same life span, then the cost alternative having shorter life span will result in lower equivalent present worth i.e. lower cost than the cost alternative having longer life span.

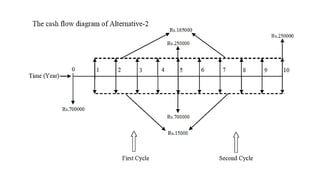

  • 75. The two approaches used for economic comparison of different life span alternatives are as follows: 1. Comparison of mutually exclusive alternatives over a time period that is equal to least common multiple (LCM) of the individual life spans. 2. Comparison of mutually exclusive alternatives over a study period which is not necessarily equal to the life span of any of the alternatives.
  • 77.
  • 78.
  • 79.
  • 80.
  • 81.
  • 82.
  • 84.
  • 85.
  • 86.
  • 87.
  • 88.
  • 89.
  • 91.
  • 92.
  • 93.
  • 94.
  • 95.
  • 96.

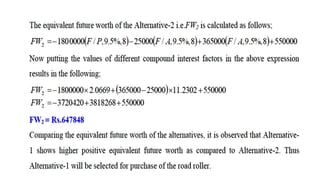

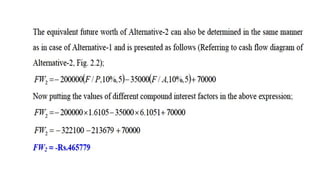

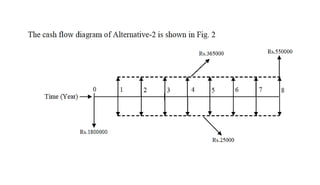

  • 97. Comparison of alternatives by future worth method • In the future worth method for comparison of mutually exclusive alternatives, the equivalent future worth (i.e. value at the end of the useful lives of alternatives) of all the expenditures and incomes occurring at different periods of time are determined at the given interest rate per interest period. • The equivalent future worth of these expenditures and incomes will be determined using different compound interest factors namely single payment compound amount factor and uniform series compound amount factor
  • 98. Example -4 (Using data of Example-1)
  • 99.
  • 100.
  • 102.
  • 103.
  • 104.
  • 105.
  • 106.
  • 108.
  • 109.
  • 110.
  • 111.
  • 112. Comparison of alternatives by annual worth method • In this method, the mutually exclusive alternatives are compared on the basis of equivalent uniform annual worth. • The equivalent uniform annual worth represents the annual equivalent value of all the cash inflows and cash outflows of the alternatives at the given rate of interest per interest period. • In this method of comparison, the equivalent uniform annual worth of all expenditures and incomes of the alternatives are determined using different compound interest factors
  • 113. • Since equivalent uniform annual worth of the alternatives over the useful life are determined, same procedure is followed irrespective of the life spans of the alternatives i.e. whether it is the comparison of equal life span alternatives or that of different life span alternatives. • In other words, in case of comparison of different life span alternatives by annual worth method, the comparison is not made over the least common multiple of the life spans as is done in case of present worth and future worth method.
  • 114. • The reason is that even if the comparison is made over the least common multiple of years, the equivalent uniform annual worth of the alternative for more than one cycle of cash flow will be exactly same as that of the first cycle provided the cash flow i.e. the costs and incomes of the alternative in the successive cycles is exactly same as that in the first cycle. • Thus the comparison is made only for one cycle of cash flow of the alternatives
  • 116.
  • 117.
  • 118.
  • 119.
