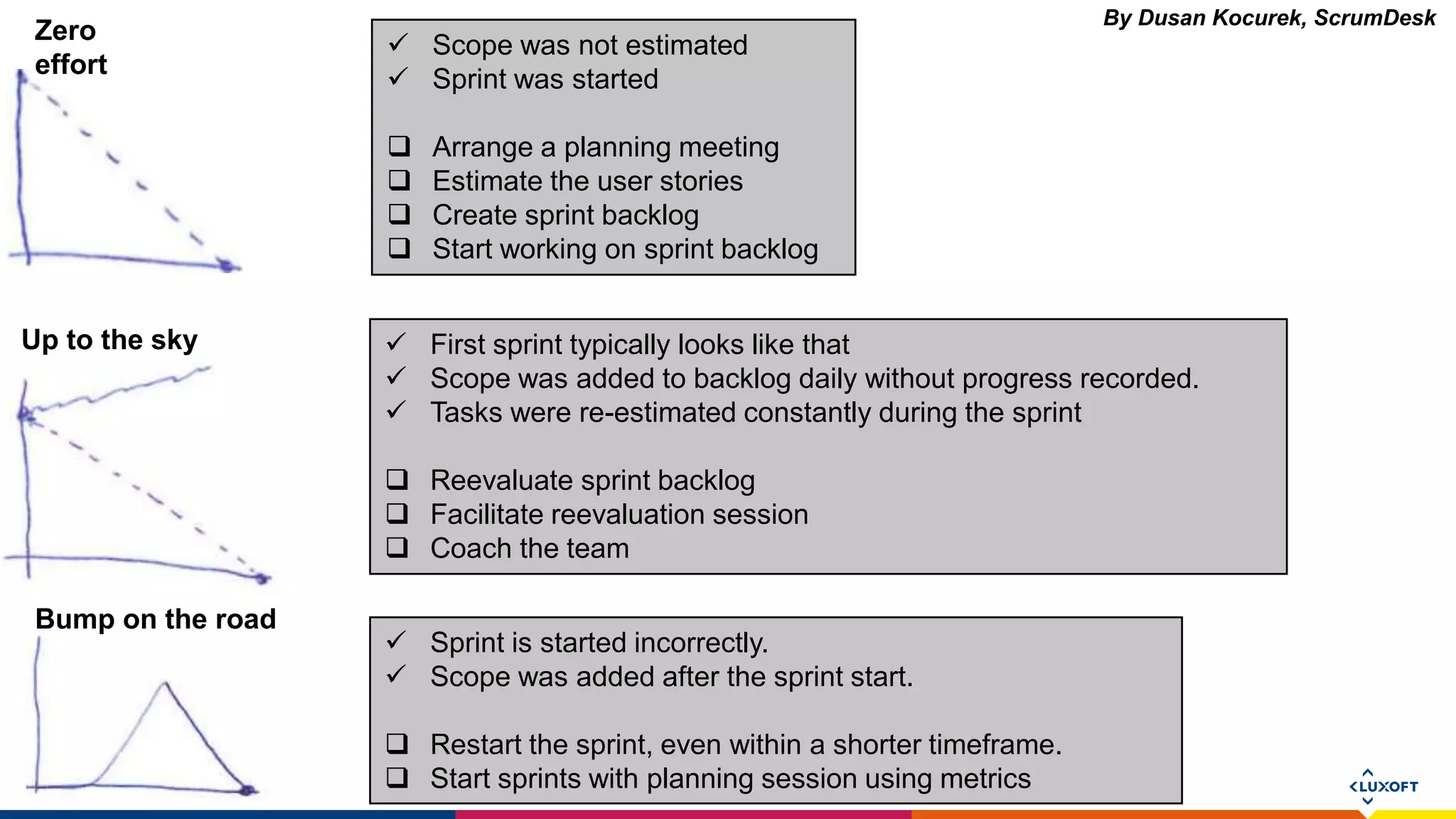

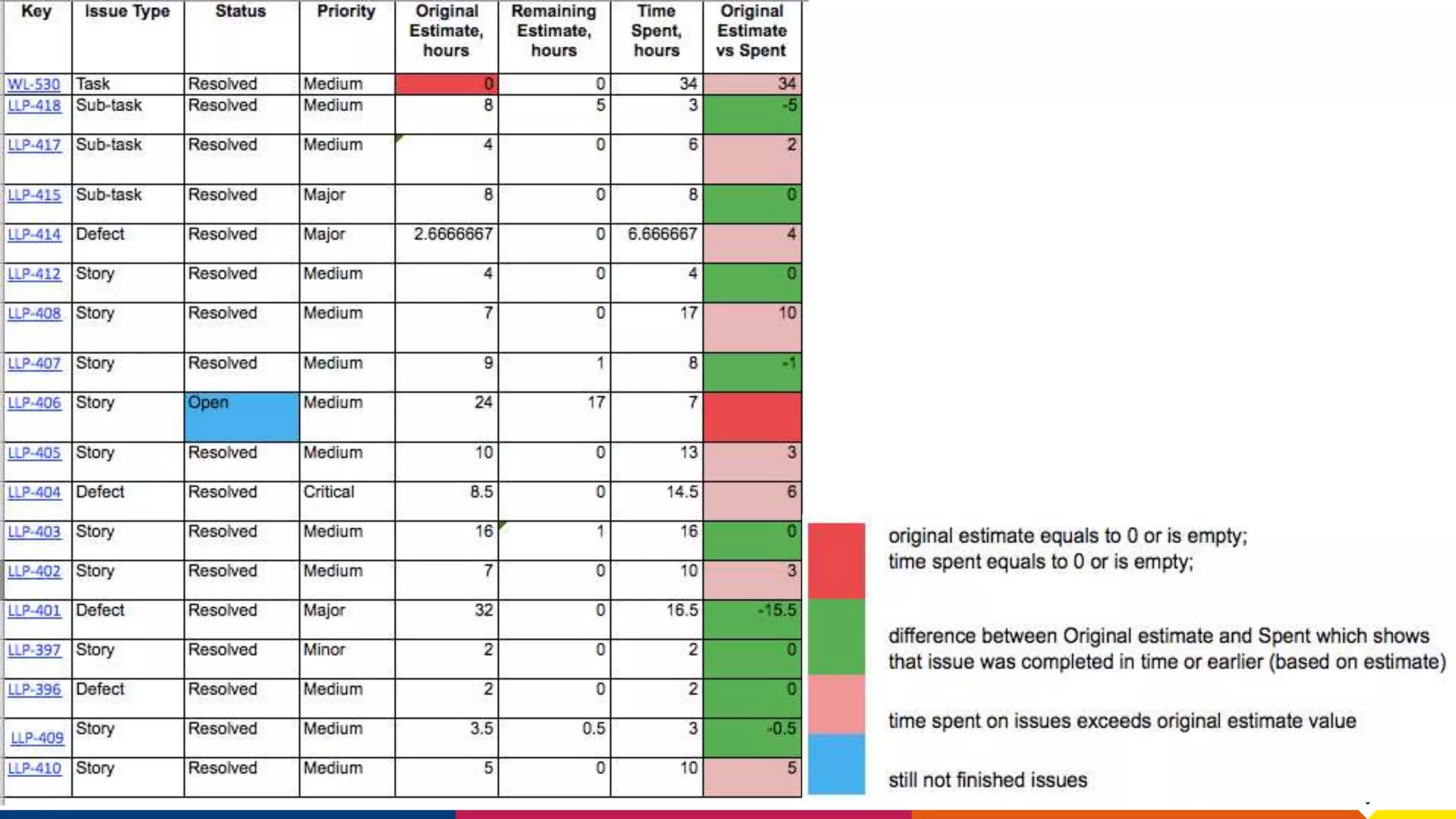

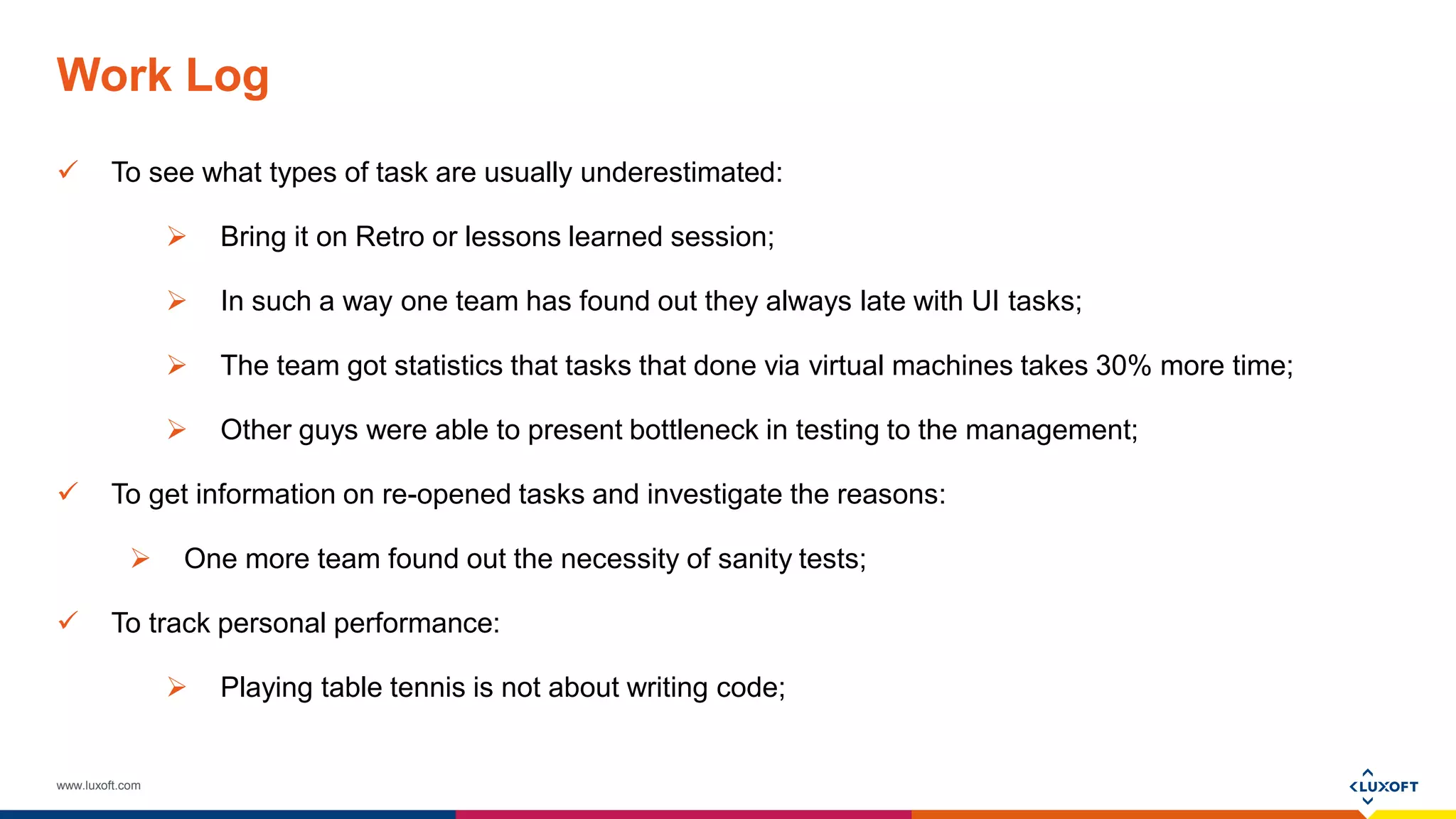

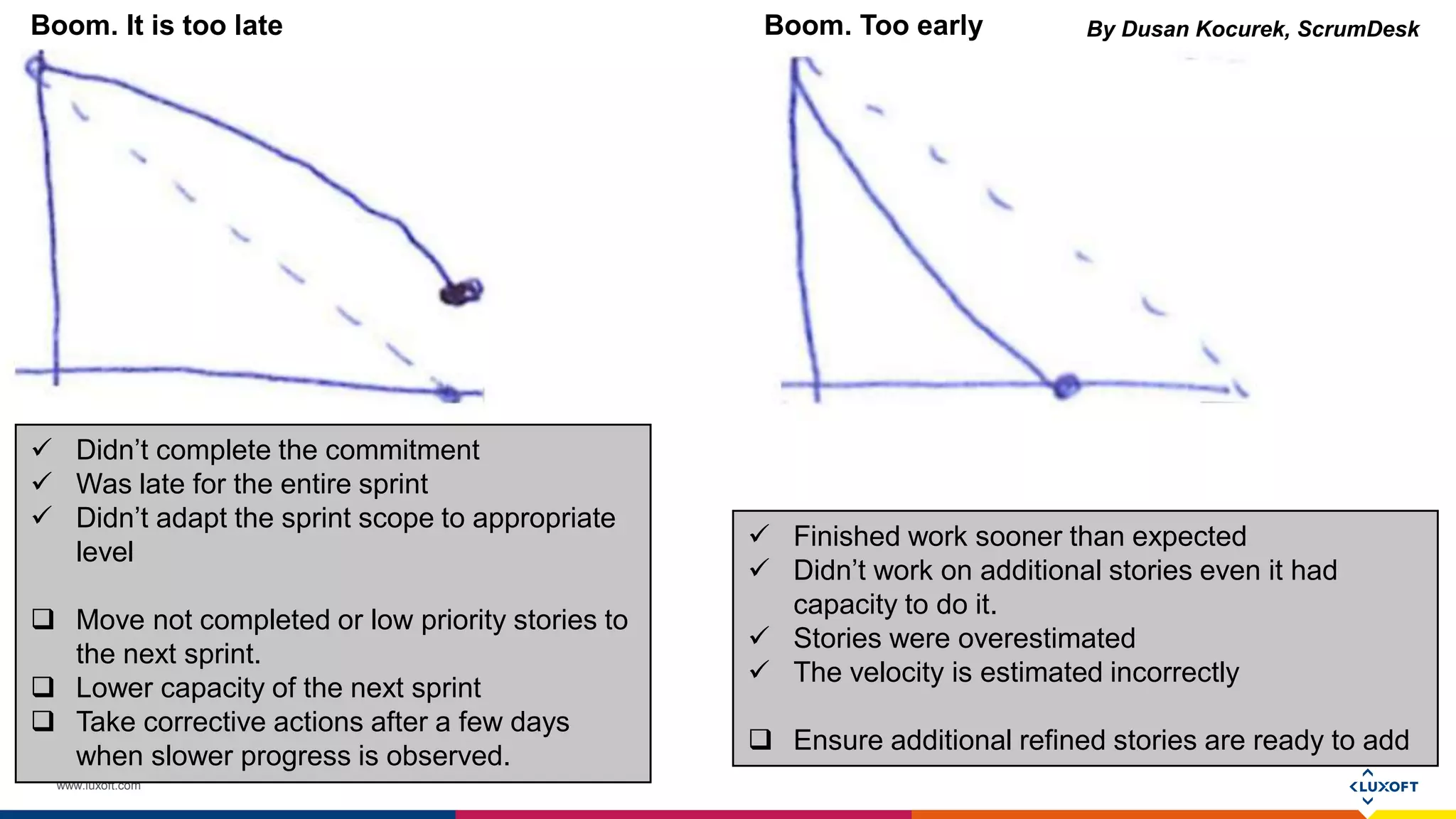

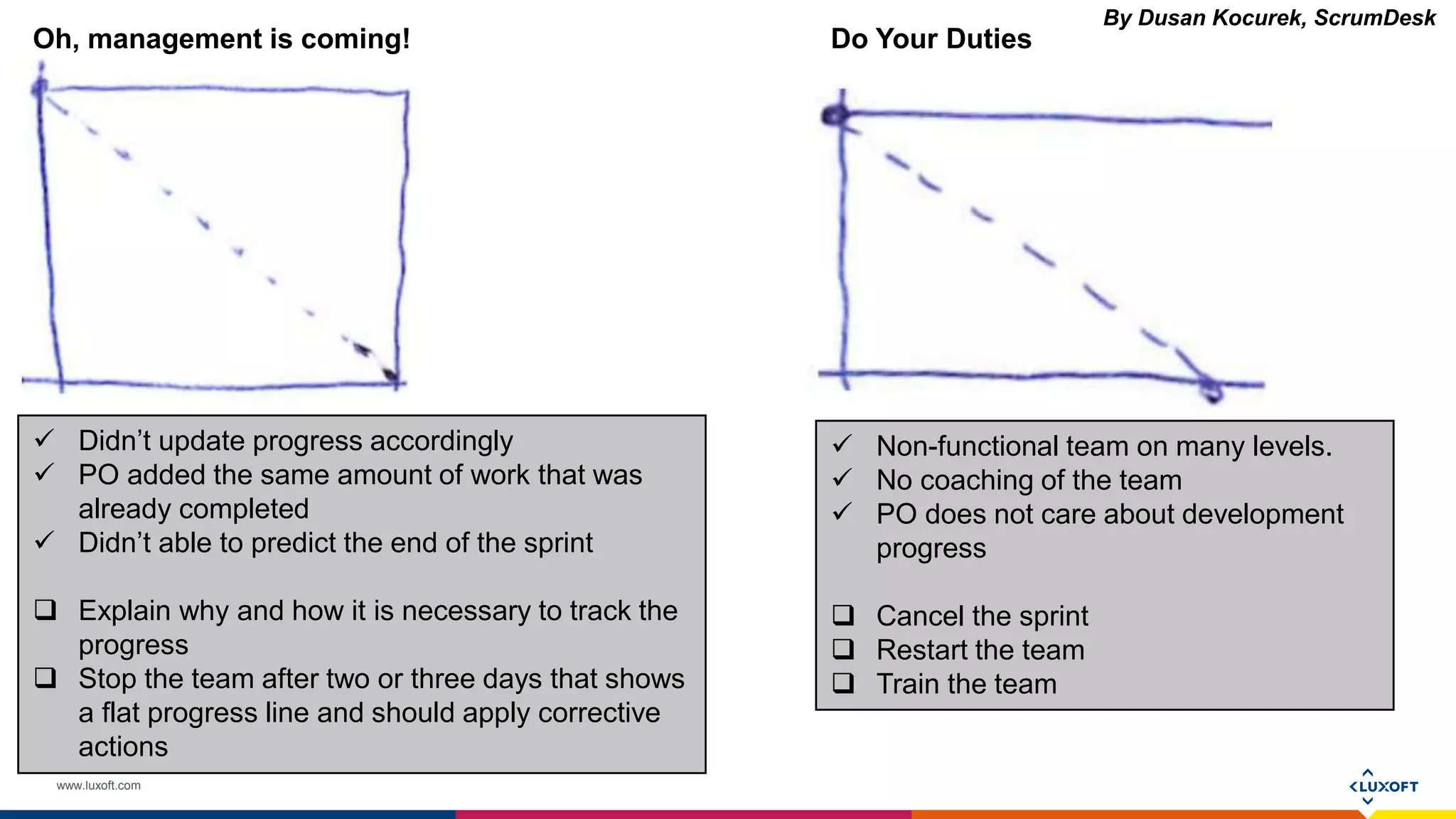

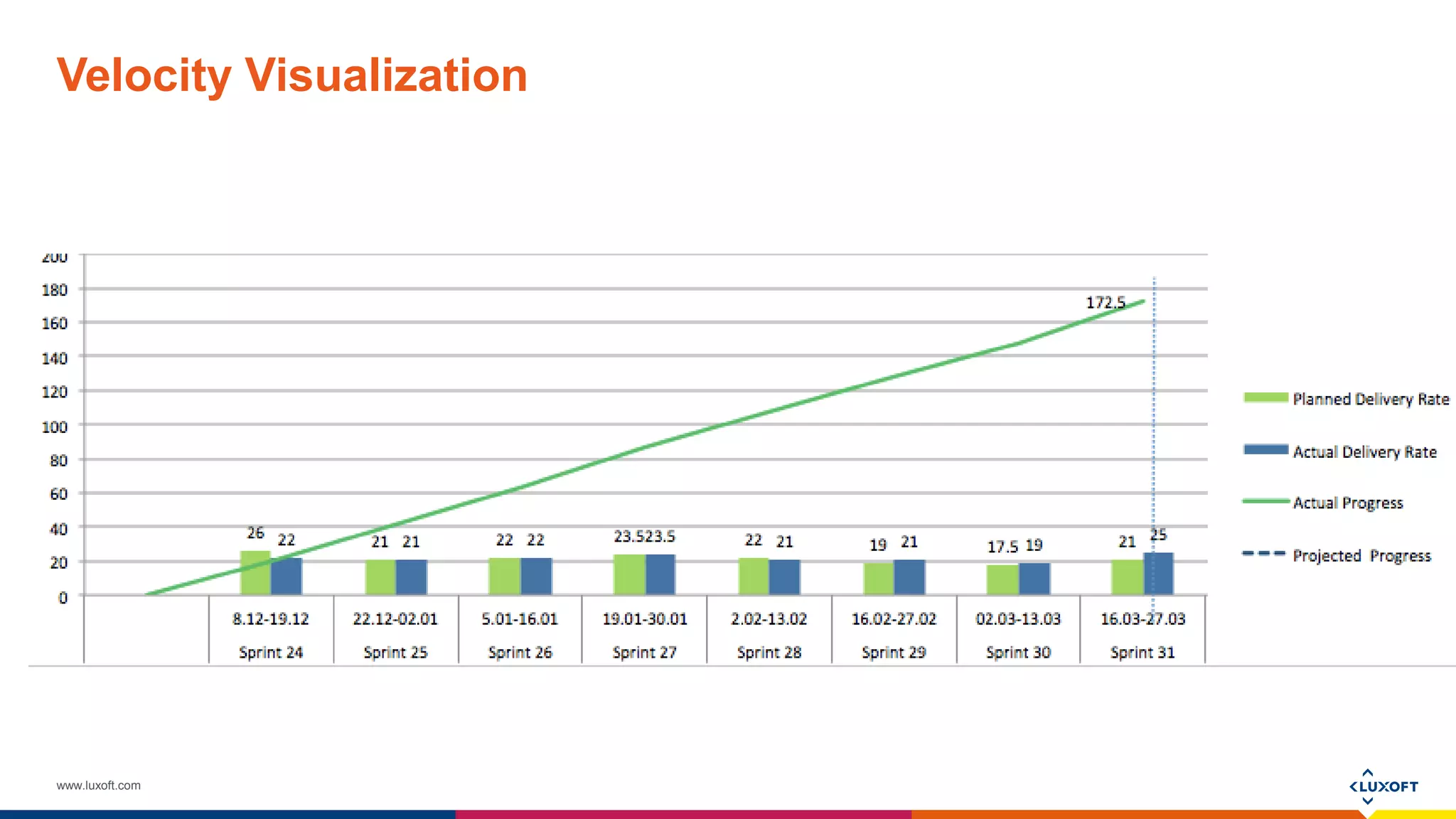

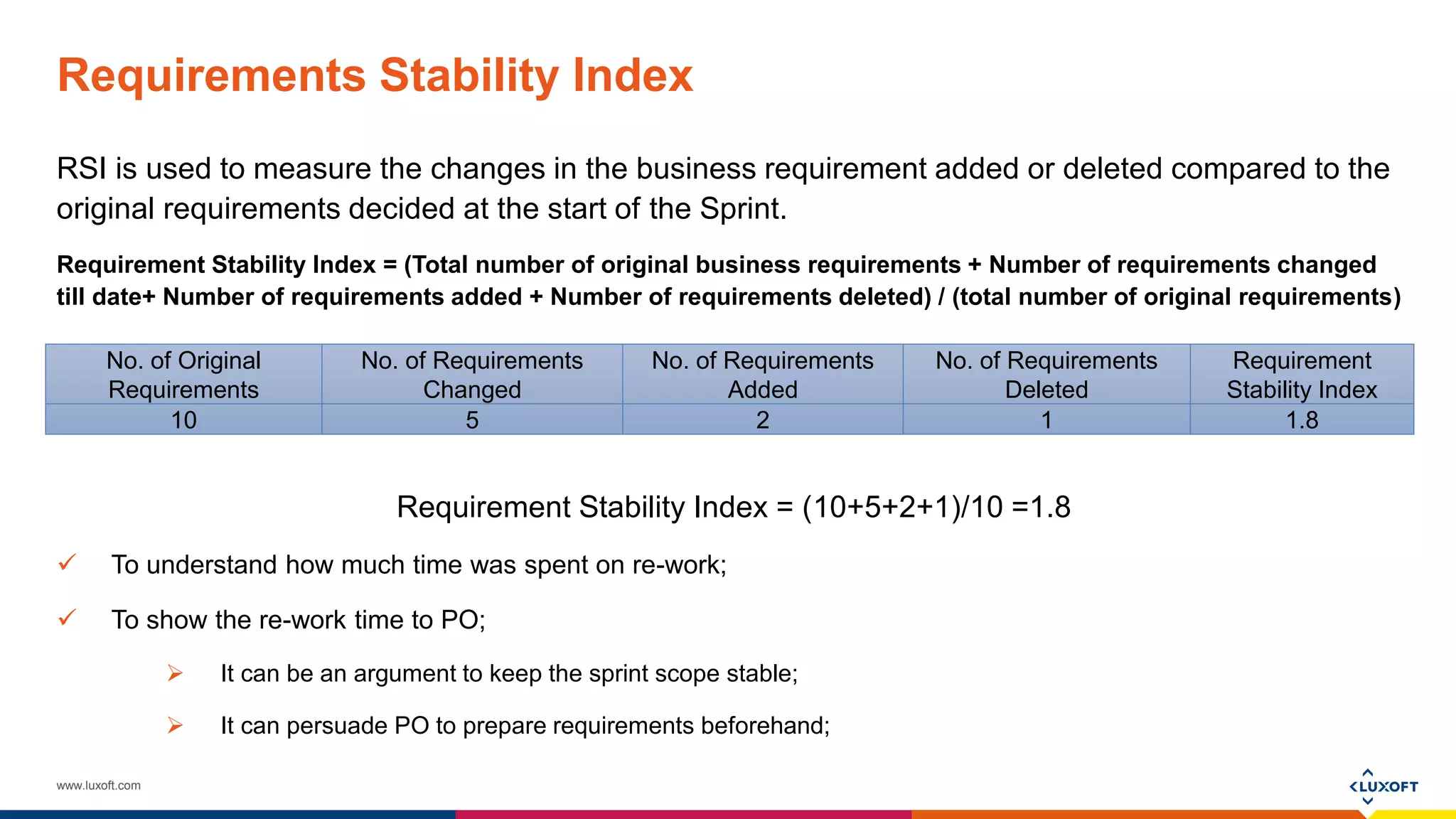

The document outlines key metrics used in project management at Luxoft, including capacity, velocity, requirements stability index, and burn-down charts. It emphasizes the importance of these metrics for effective planning, tracking performance, and managing project scope. Additionally, it provides insights into the roles of teams and individual members in maintaining productivity and adapting to changes during the sprint process.
