LEADING AGILE
PRODUCT DEVELOPMENT
                        By Arto Saari
                              v. 1.0 beta5

 It has been my sincere aim to respect all copyrights and reference the
 authors as appropriate. If however you feel I’ve not succeeded in some
    aspect of this, kindly contact me and allow to me correct my error.
                                 Thank you.

                       Used by permission

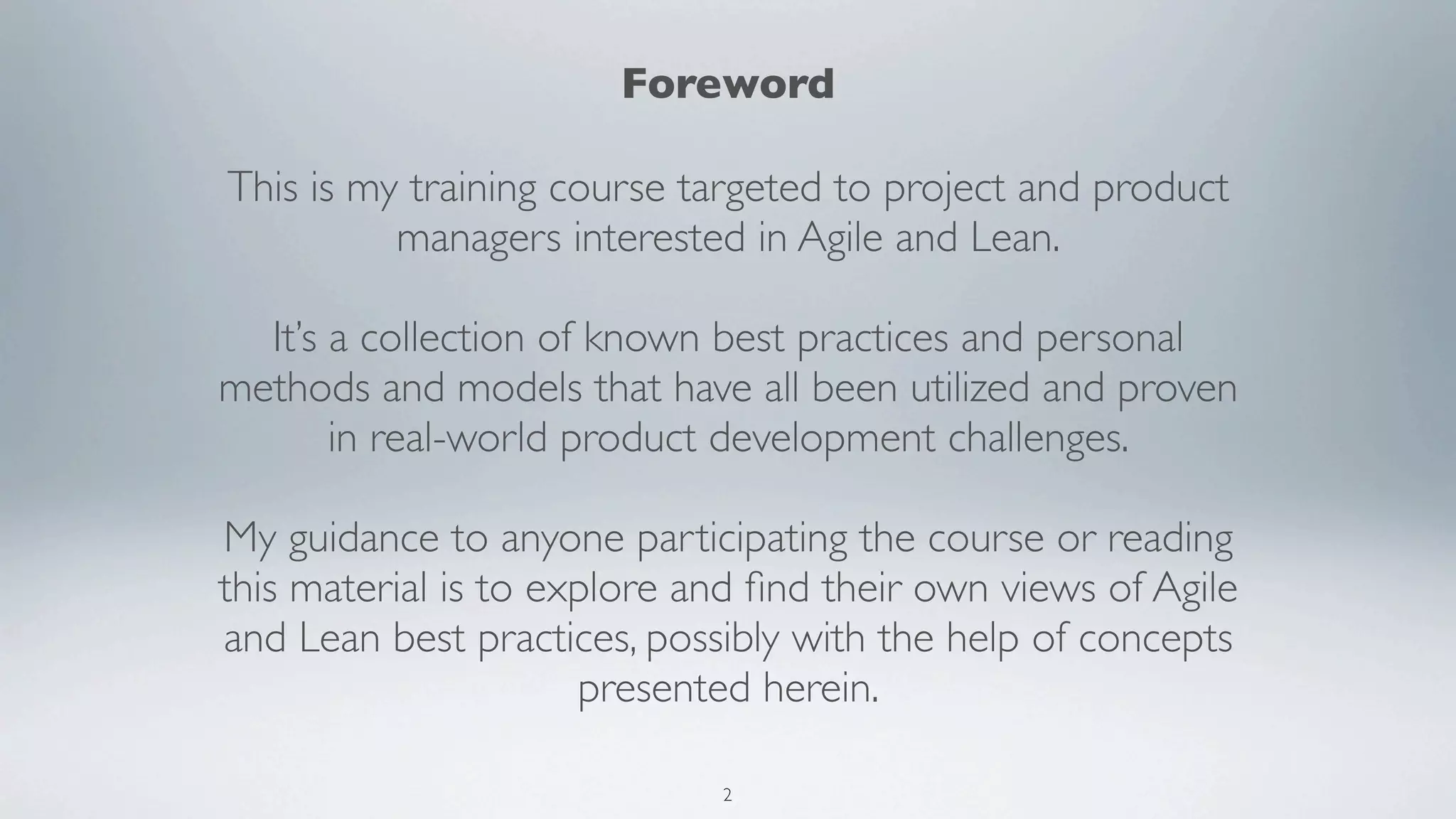

Foreword

This is my training course targeted to project and product
          managers interested in Agile and Lean.

  It’s a collection of known best practices and personal
methods and models that have all been utilized and proven
       in real-world product development challenges.

My guidance to anyone participating the course or reading
this material is to explore and find their own views of Agile
and Lean best practices, possibly with the help of concepts
                      presented herein.

                             2
MOVING TO AGILE & LEAN
"Don't know what I want, but I know how to get it."
           - Johnny Rotten, Sex Pistols

       http://www.agileproductdesign.com/blog/dont_know_what_i_want.html
                                       4
Agile
                                             Lean
                                                                           Fit

iStock royalty-free photo

                            iStock royalty-free photo
Dealing with complexity
                                                        iStock royalty-free photo
                                  Focusing on Value
                                                            Re-innovating Value

                                                 5

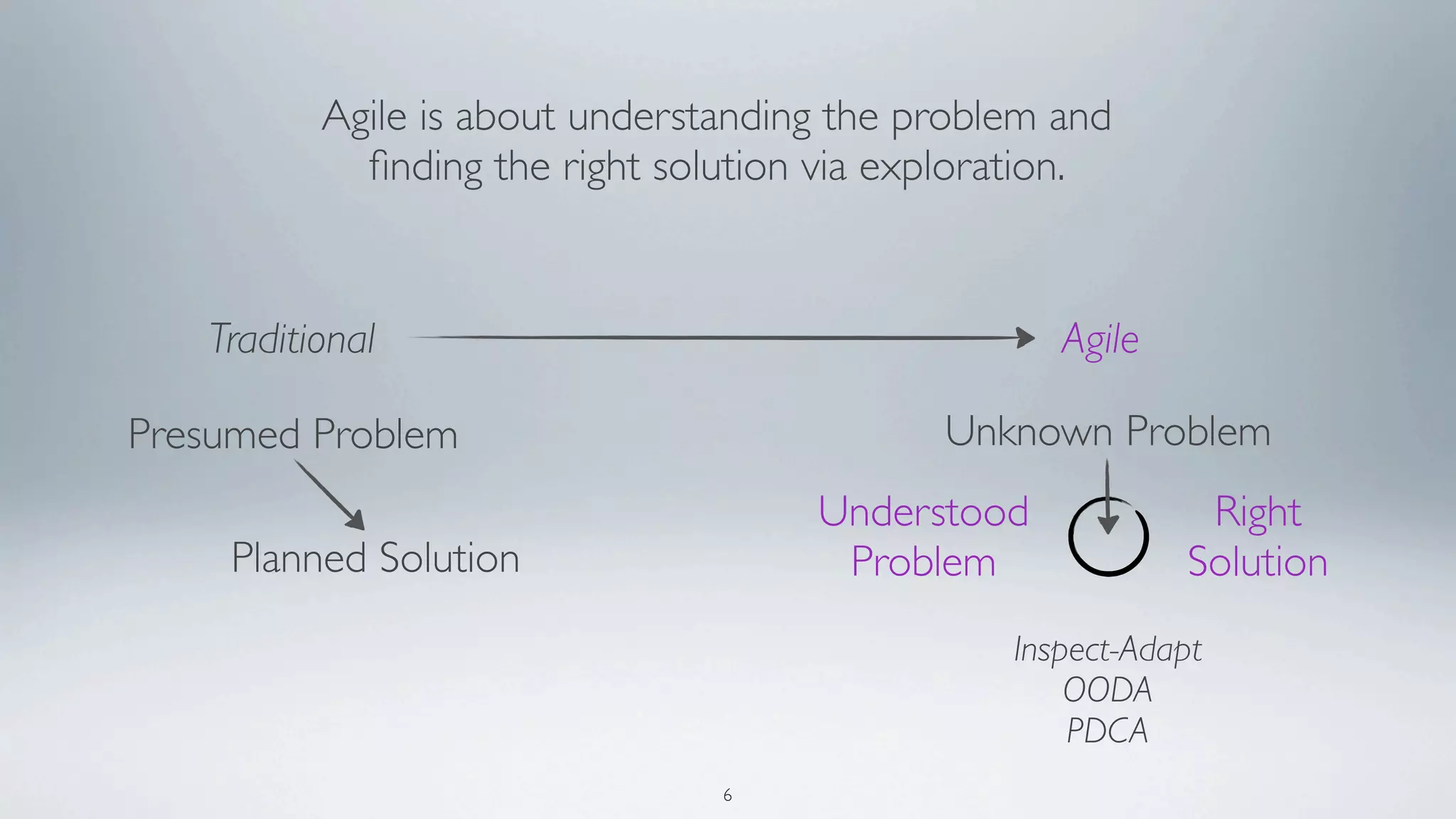

Agile is about understanding the problem and
            finding the right solution via exploration.

   Traditional                                     Agile

Presumed Problem                            Unknown Problem
                                     Understood              Right
    Planned Solution                  Problem               Solution
                                                Inspect-Adapt
                                                    OODA
                                                    PDCA
                                6

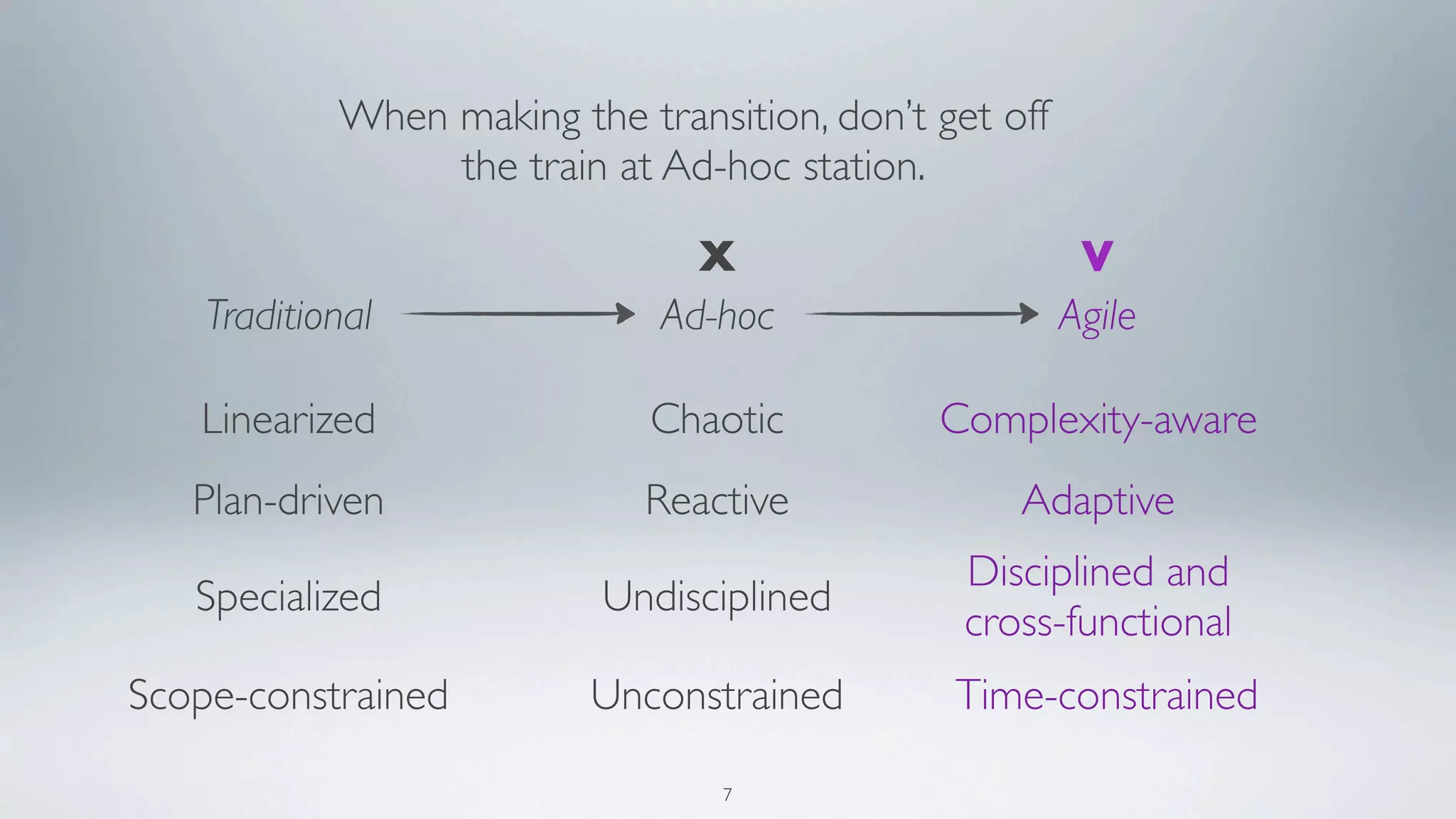

When making the transition, don’t get off
                 the train at Ad-hoc station.

                                X                        V
    Traditional               Ad-hoc                    Agile

   Linearized                Chaotic          Complexity-aware
   Plan-driven               Reactive              Adaptive
                                                Disciplined and
   Specialized             Undisciplined
                                                cross-functional
Scope-constrained         Unconstrained        Time-constrained

                                  7

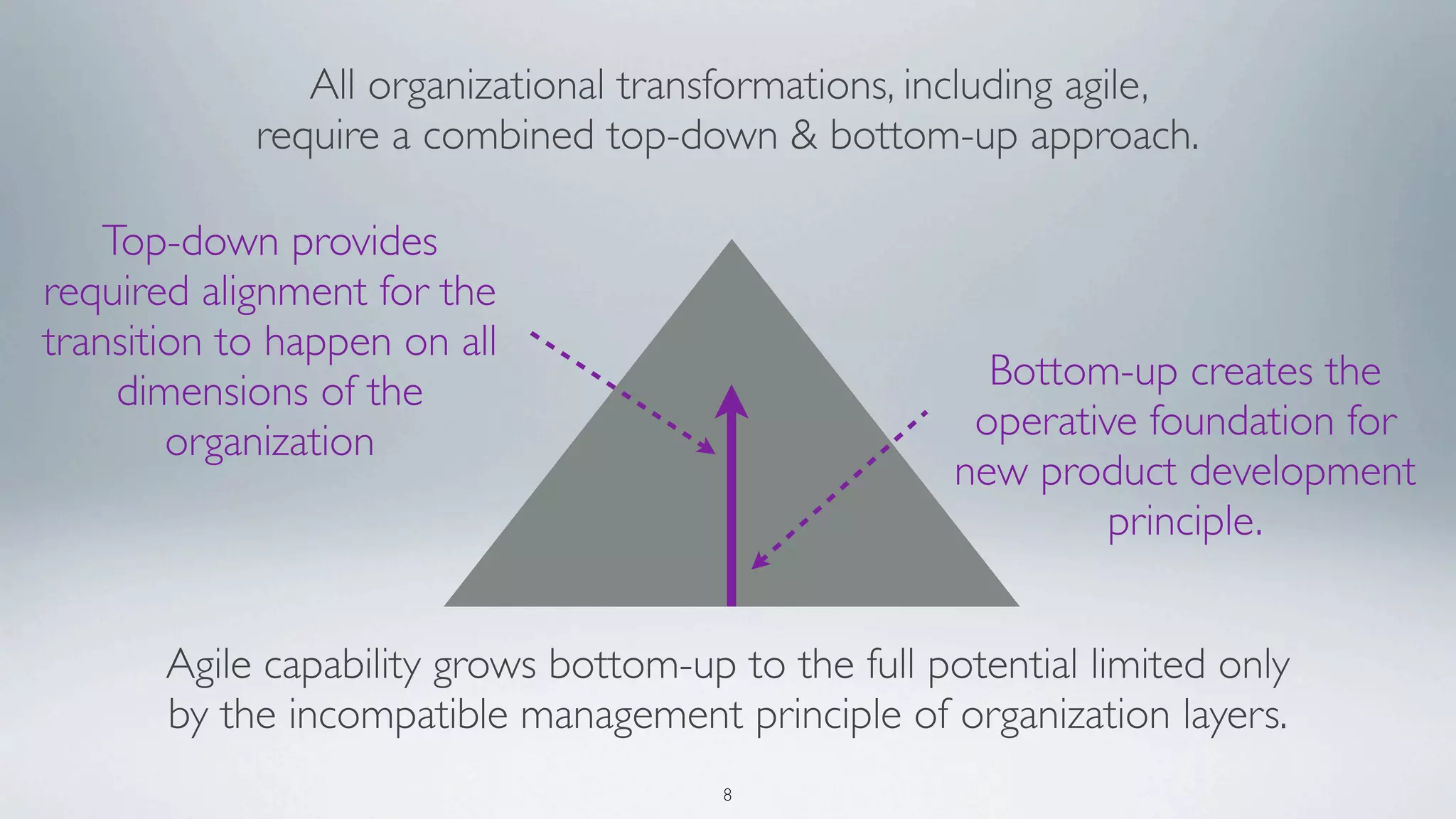

All organizational transformations, including agile,
            require a combined top-down & bottom-up approach.

    Top-down provides
required alignment for the
transition to happen on all
     dimensions of the                                  Bottom-up creates the
        organization                                   operative foundation for
                                                      new product development
                                                               principle.

       Agile capability grows bottom-up to the full potential limited only
       by the incompatible management principle of organization layers.
                                        8

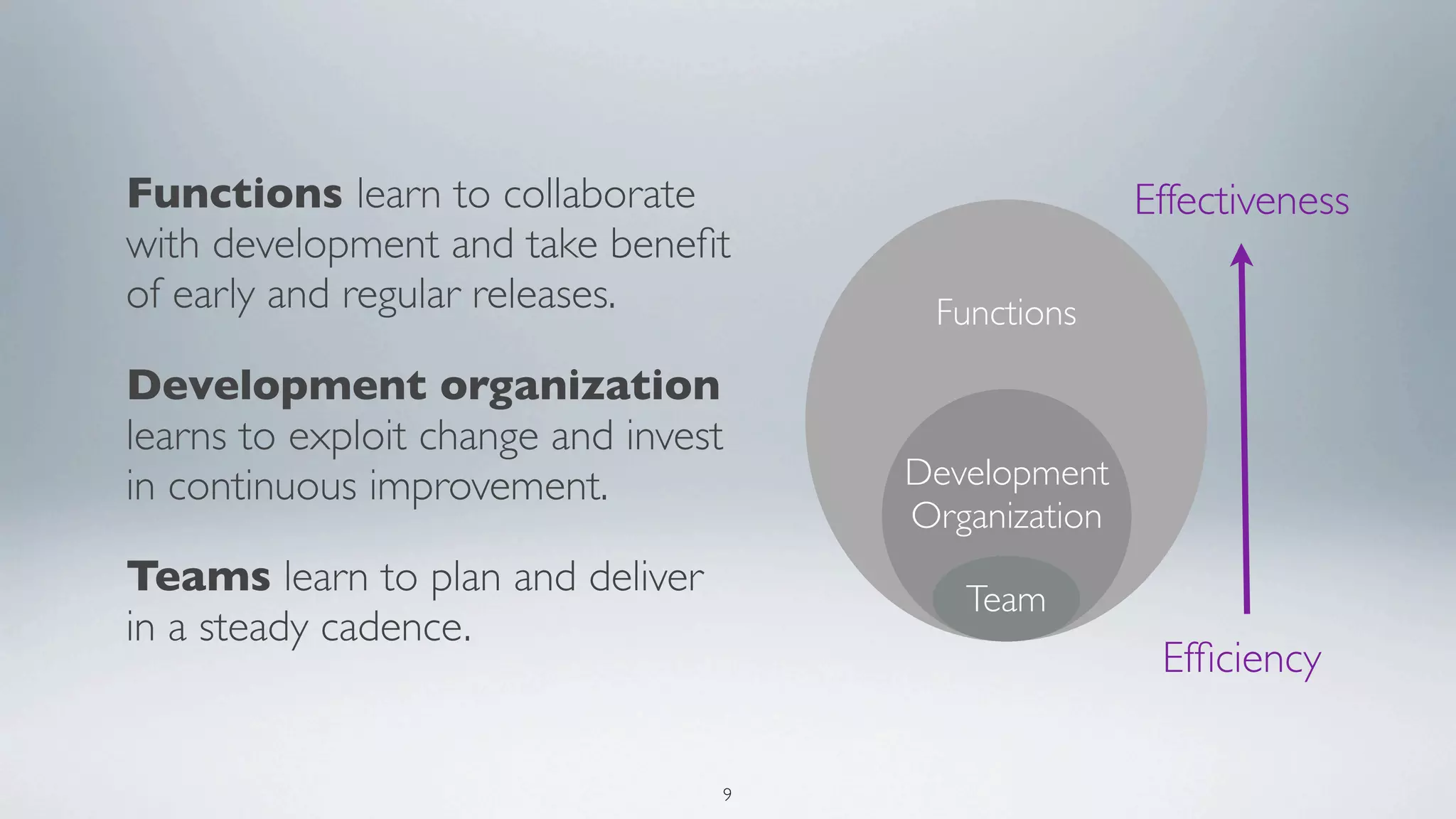

Functions learn to collaborate                       Effectiveness
with development and take benefit
of early and regular releases.         Functions
Development organization
learns to exploit change and invest
in continuous improvement.            Development
                                      Organization
Teams learn to plan and deliver          Team
in a steady cadence.
                                                      Efficiency

                                  9

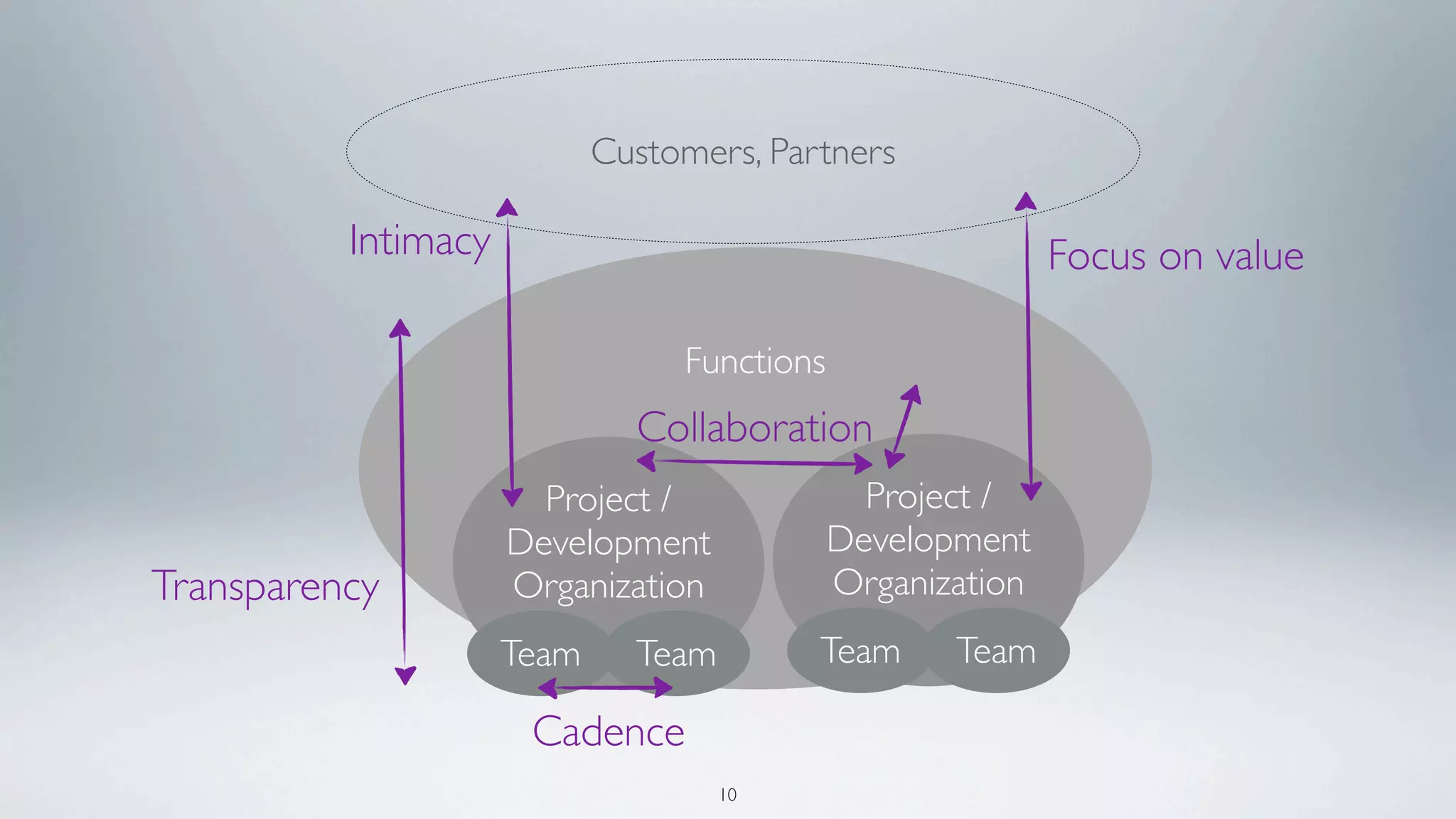

Customers, Partners

          Intimacy                                          Focus on value

                                 Functions
                              Collaboration
                       Project /               Project /
                     Development             Development
Transparency         Organization            Organization
                     Team     Team        Team      Team

                      Cadence
                                     10

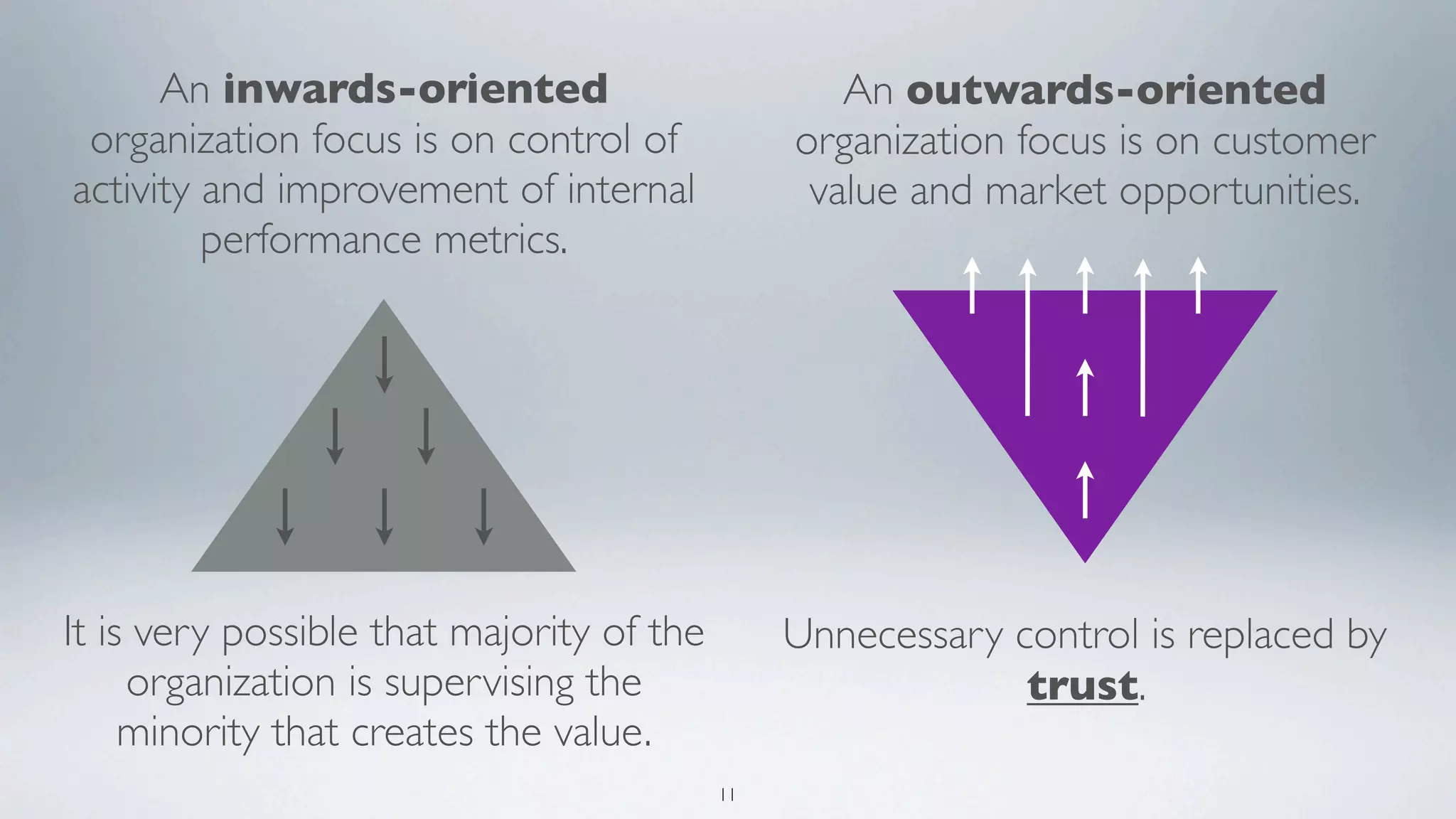

An inwards-oriented                          An outwards-oriented
 organization focus is on control of            organization focus is on customer
activity and improvement of internal             value and market opportunities.
         performance metrics.

It is very possible that majority of the        Unnecessary control is replaced by
     organization is supervising the                         trust.
     minority that creates the value.
                                           11

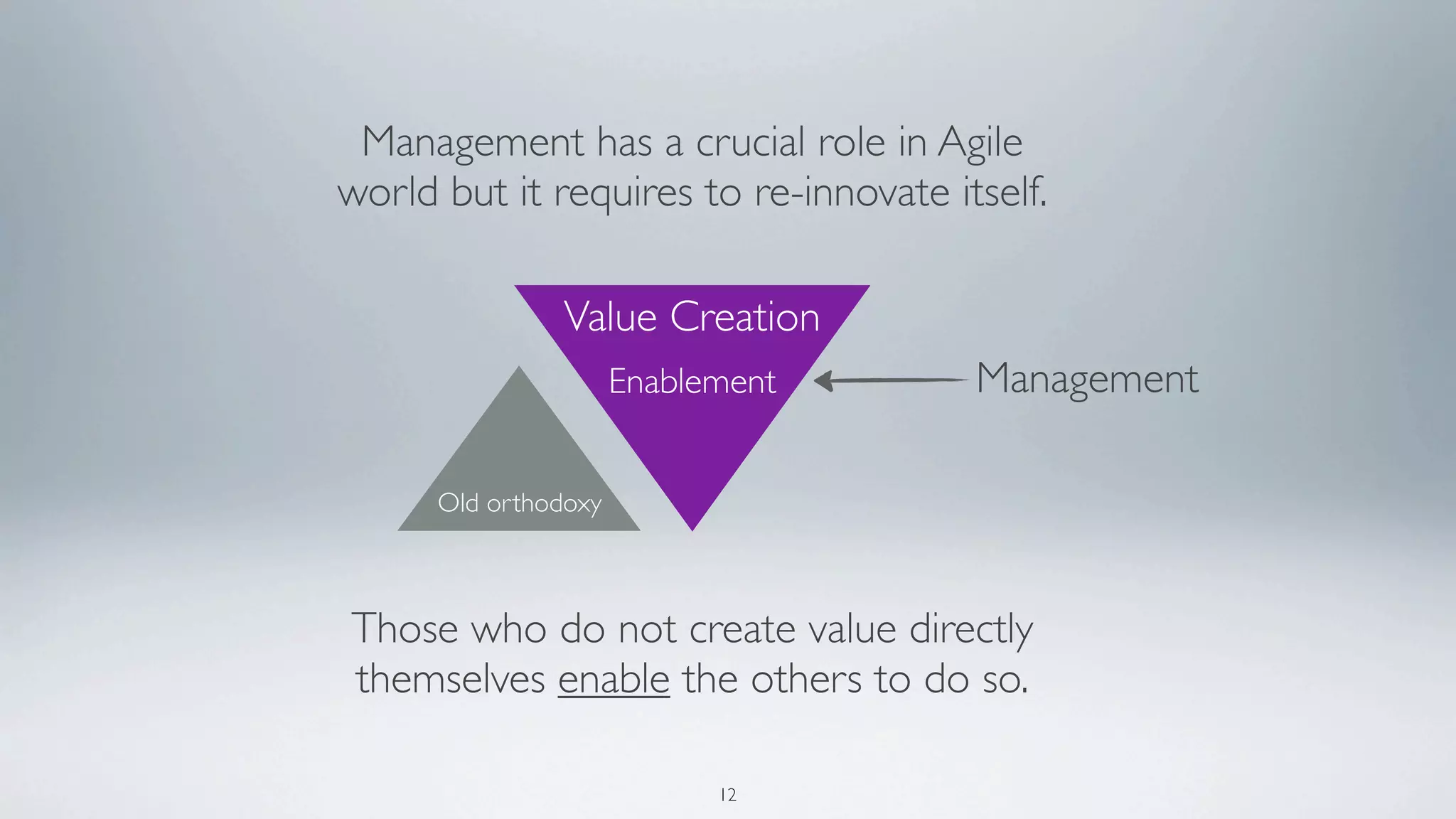

Management has a crucial role in Agile
world but it requires to re-innovate itself.

               Value Creation
                      Enablement       Management

      Old orthodoxy

Those who do not create value directly
themselves enable the others to do so.

                            12

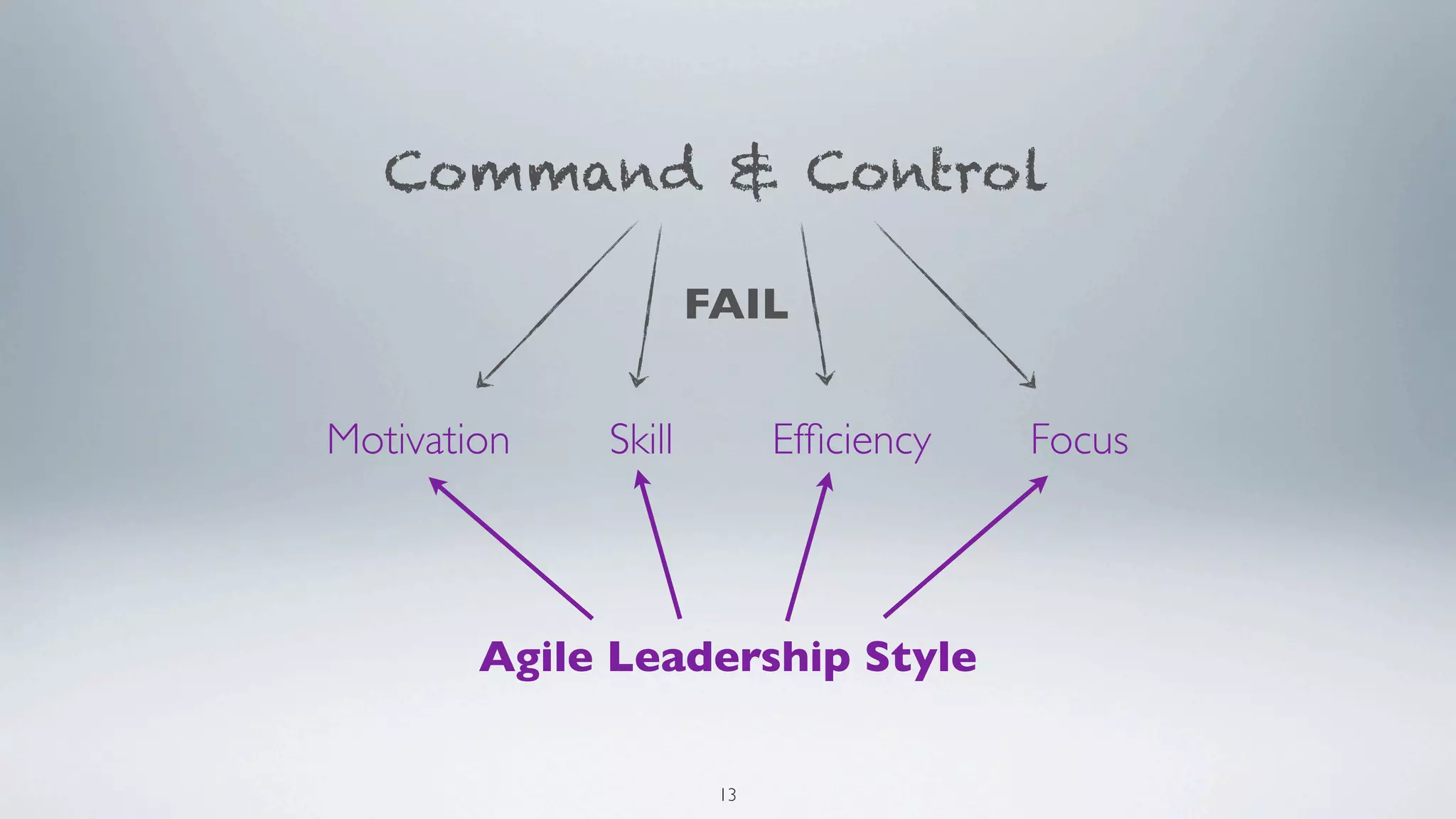

Command & Control

                     FAIL

Motivation   Skill         Efficiency   Focus

        Agile Leadership Style

                      13

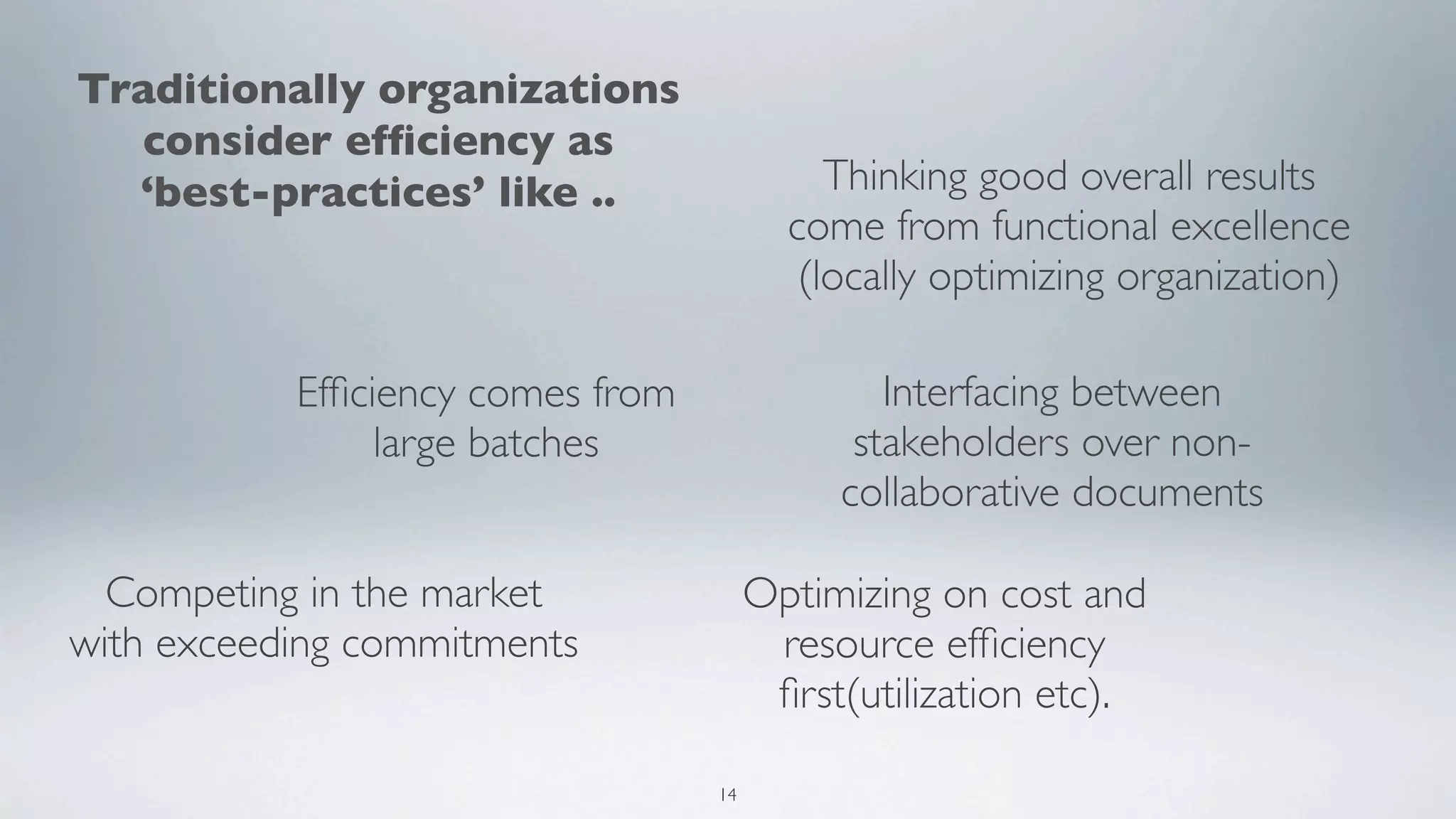

Traditionally organizations
  consider efficiency as
  ‘best-practices’ like ..                  Thinking good overall results
                                         come from functional excellence
                                          (locally optimizing organization)

           Efficiency comes from                Interfacing between
                large batches                stakeholders over non-
                                            collaborative documents

  Competing in the market              Optimizing on cost and
with exceeding commitments              resource efficiency
                                        first(utilization etc).

                                  14
My definition of business/organization agility..

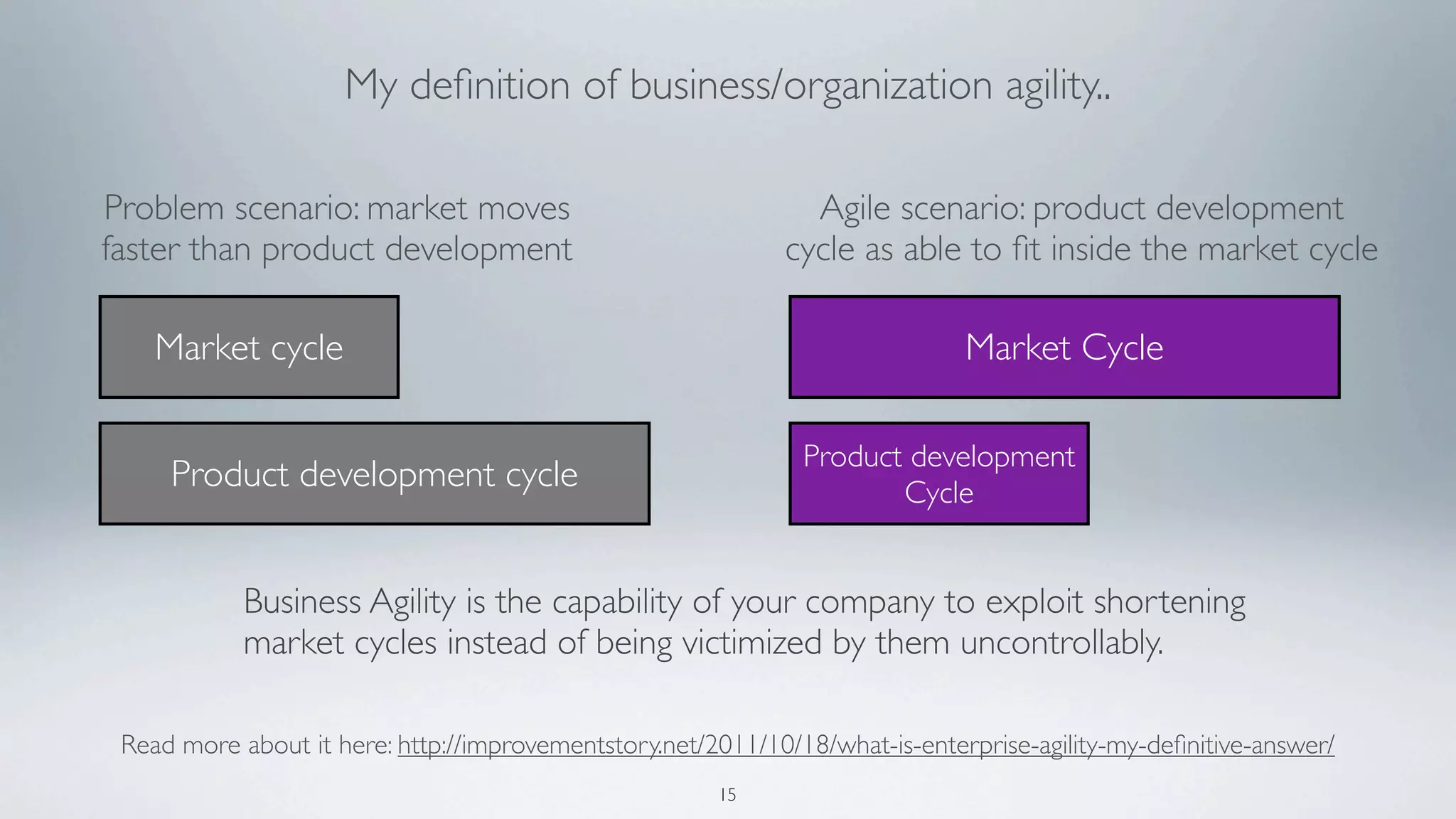

Problem scenario: market moves                                 Agile scenario: product development
faster than product development                              cycle as able to fit inside the market cycle

    Market cycle                                                              Market Cycle

                                                               Product development
     Product development cycle                                        Cycle

            Business Agility is the capability of your company to exploit shortening
            market cycles instead of being victimized by them uncontrollably.

 Read more about it here: http://improvementstory.net/2011/10/18/what-is-enterprise-agility-my-definitive-answer/
                                                       15

DIFFERENCE OF AGILE & WATERFALL
Whether your next project is a success or a failure
          is not a matter of change
           but the matter of choice

      (Mentioned by Bill Gaiennie as a quote by “Anonymous wise agile coach”)
                                        17

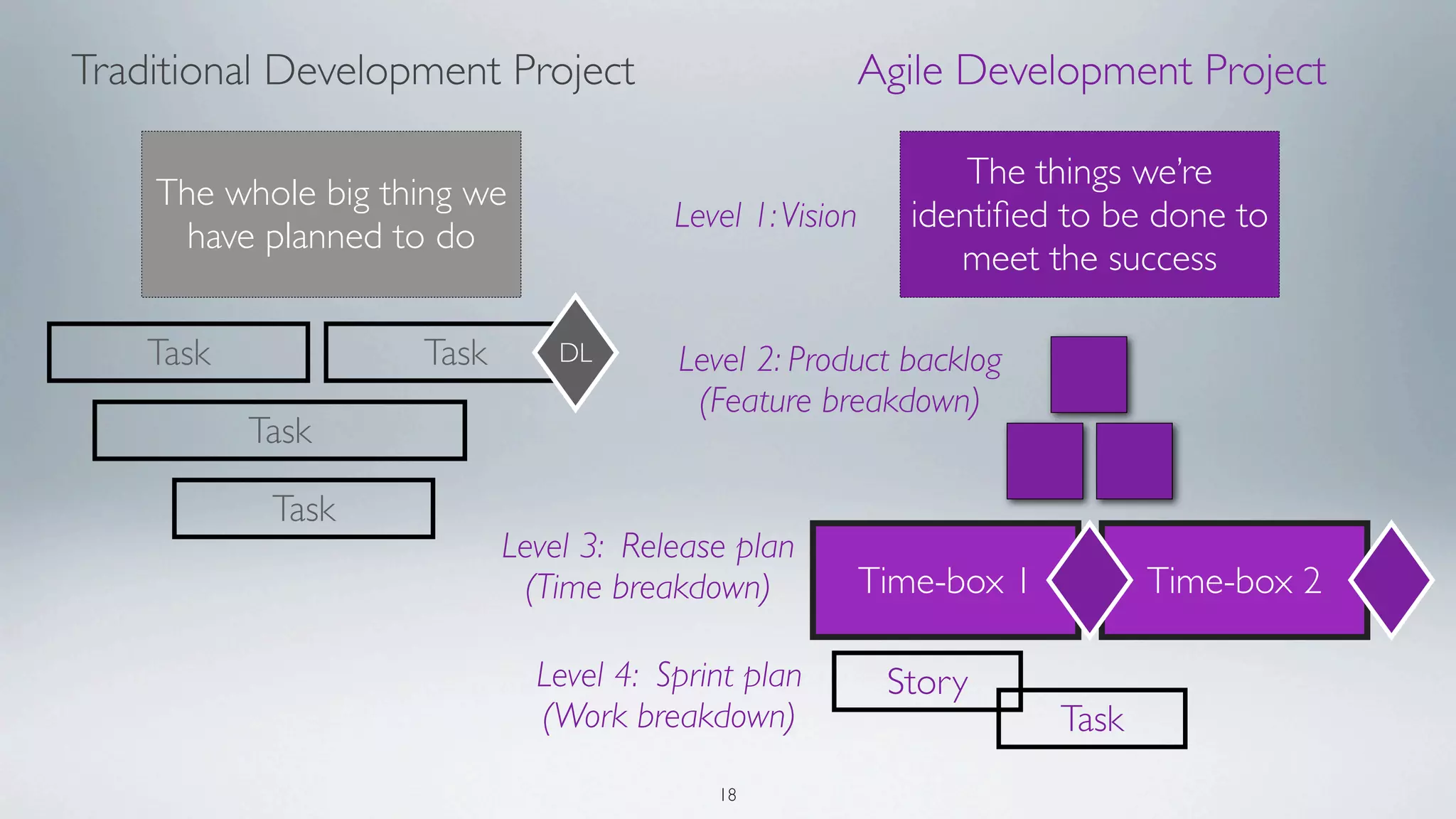

Traditional Development Project                          Agile Development Project

                                                                The things we’re
    The whole big thing we
                                       Level 1: Vision      identified to be done to
      have planned to do
                                                               meet the success

    Task            Task       DL      Level 2: Product backlog
                                        (Feature breakdown)
           Task

            Task
                           Level 3: Release plan
                             (Time breakdown)            Time-box 1          Time-box 2

                             Level 4: Sprint plan         Story
                             (Work breakdown)                         Task
                                          18

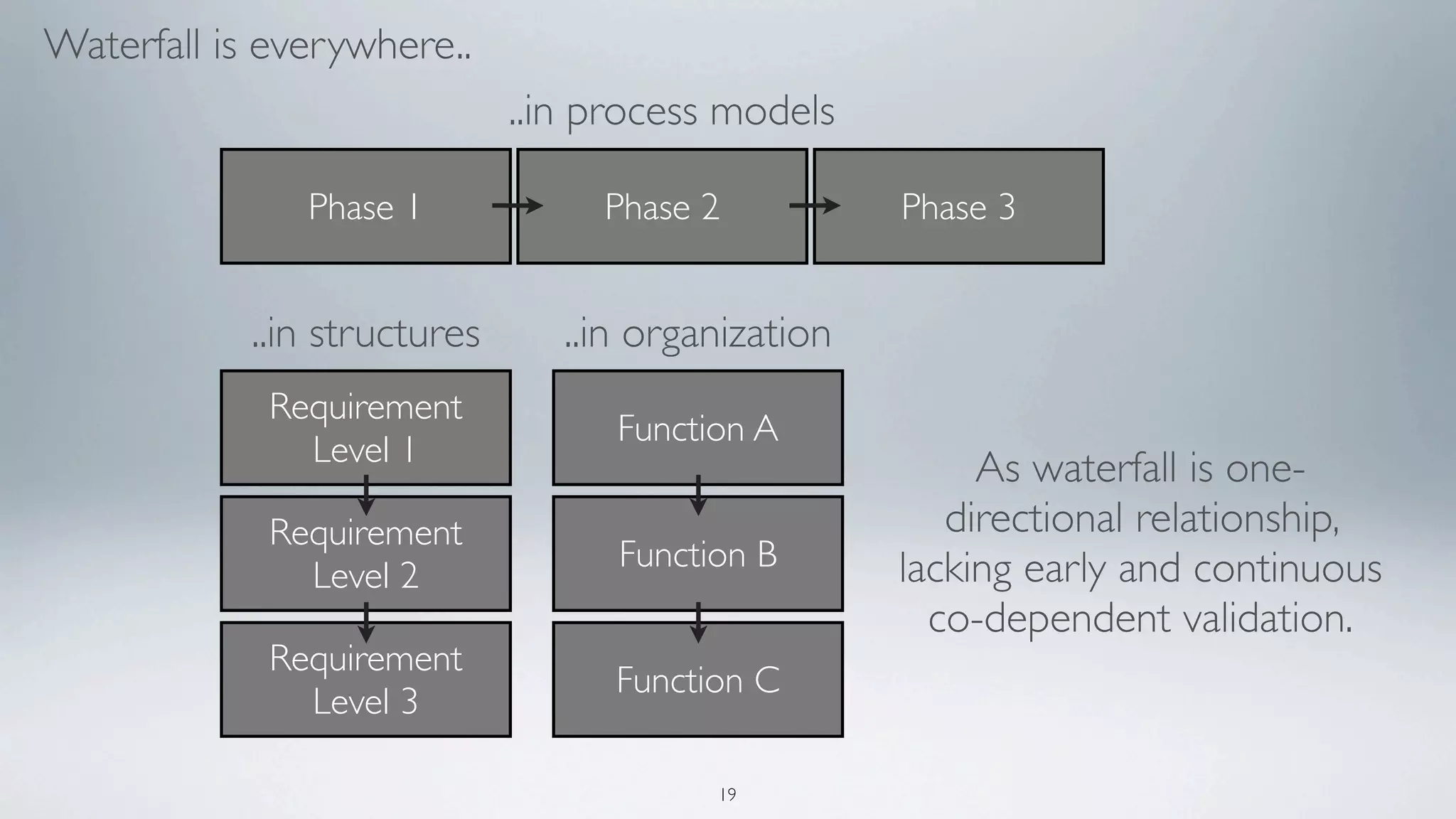

Waterfall is everywhere..
                              ..in process models

               Phase 1             Phase 2           Phase 3

            ..in structures      ..in organization
             Requirement
                                    Function A
               Level 1
                                                          As waterfall is one-
             Requirement                                directional relationship,
                                    Function B       lacking early and continuous
               Level 2
                                                       co-dependent validation.
             Requirement
                                    Function C
               Level 3

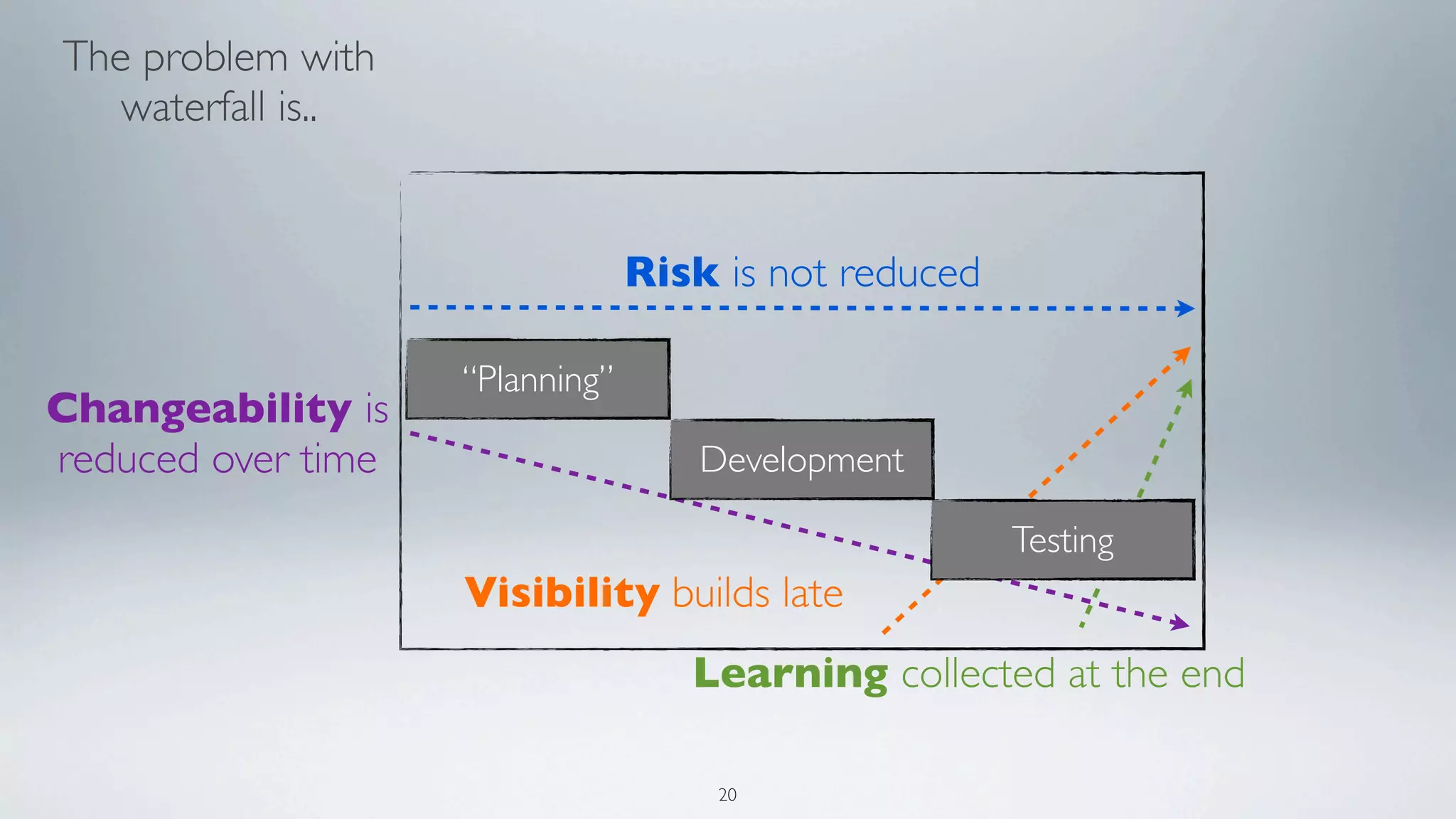

                                          19
The problem with
   waterfall is..

                                 Risk is not reduced

                    “Planning”
Changeability is
reduced over time                    Development

                                                       Testing
                    Visibility builds late
                                    Learning collected at the end

                                      20

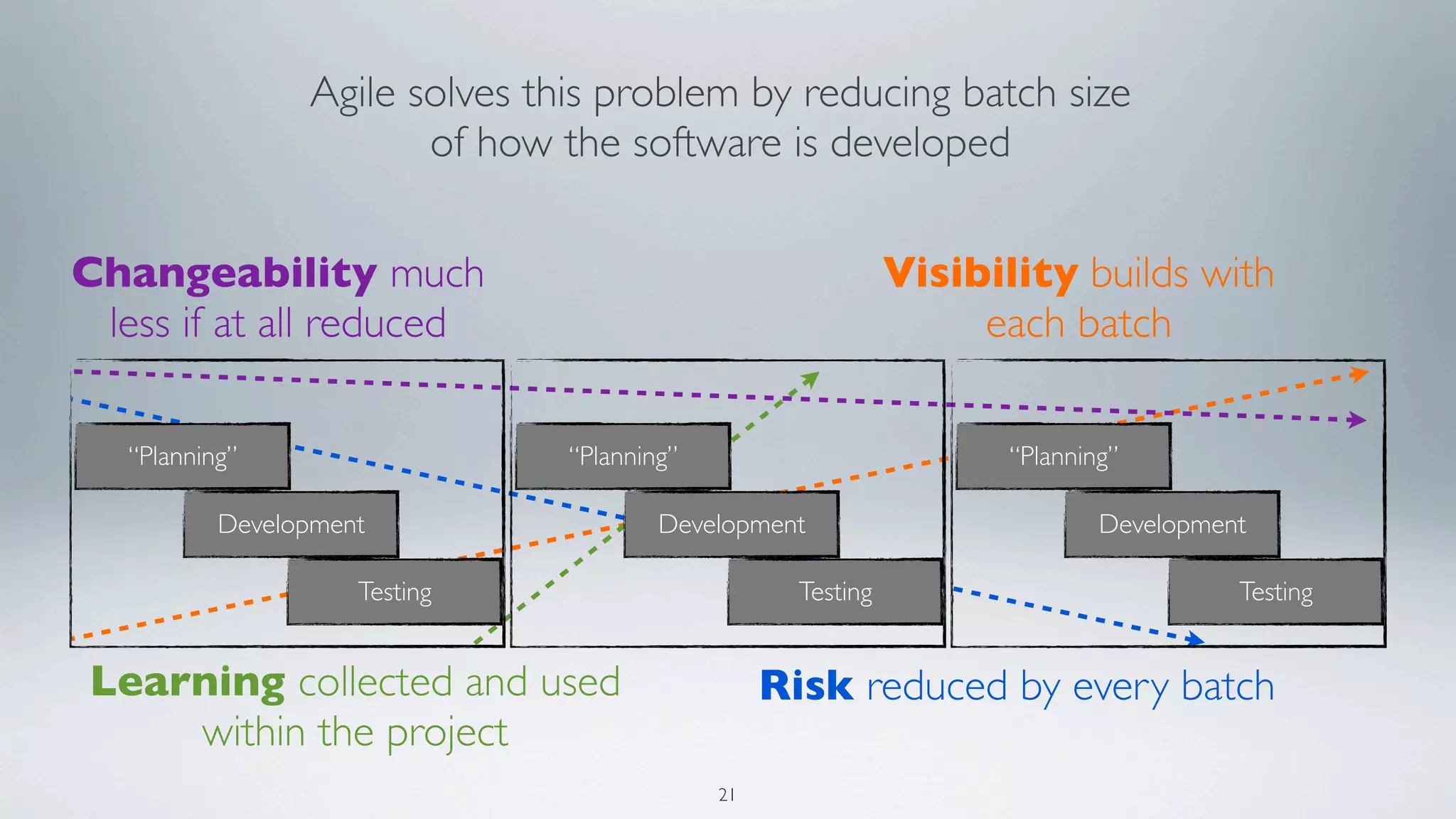

Agile solves this problem by reducing batch size
                        of how the software is developed

Changeability much                                            Visibility builds with
 less if at all reduced                                            each batch

   “Planning”                   “Planning”                           “Planning”

           Development                  Development                          Development

                     Testing                        Testing                            Testing

 Learning collected and used                      Risk reduced by every batch
     within the project
                                             21

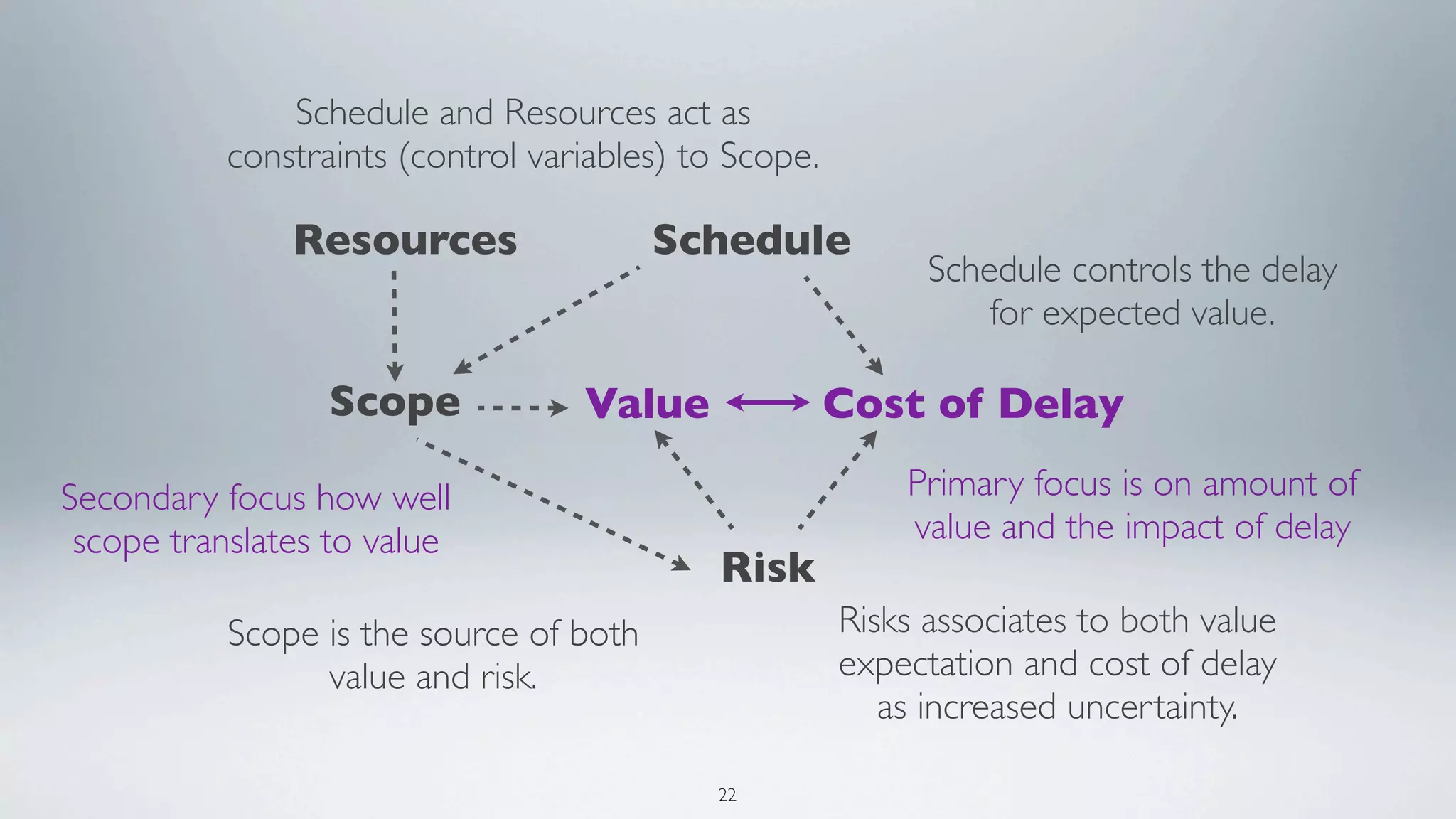

Schedule and Resources act as
           constraints (control variables) to Scope.

               Resources                 Schedule
                                                             Schedule controls the delay
                                                                 for expected value.

                  Scope            Value               Cost of Delay

Secondary focus how well                                   Primary focus is on amount of
 scope translates to value                                 value and the impact of delay
                                             Risk
           Scope is the source of both                 Risks associates to both value
                 value and risk.                       expectation and cost of delay
                                                          as increased uncertainty.

                                             22

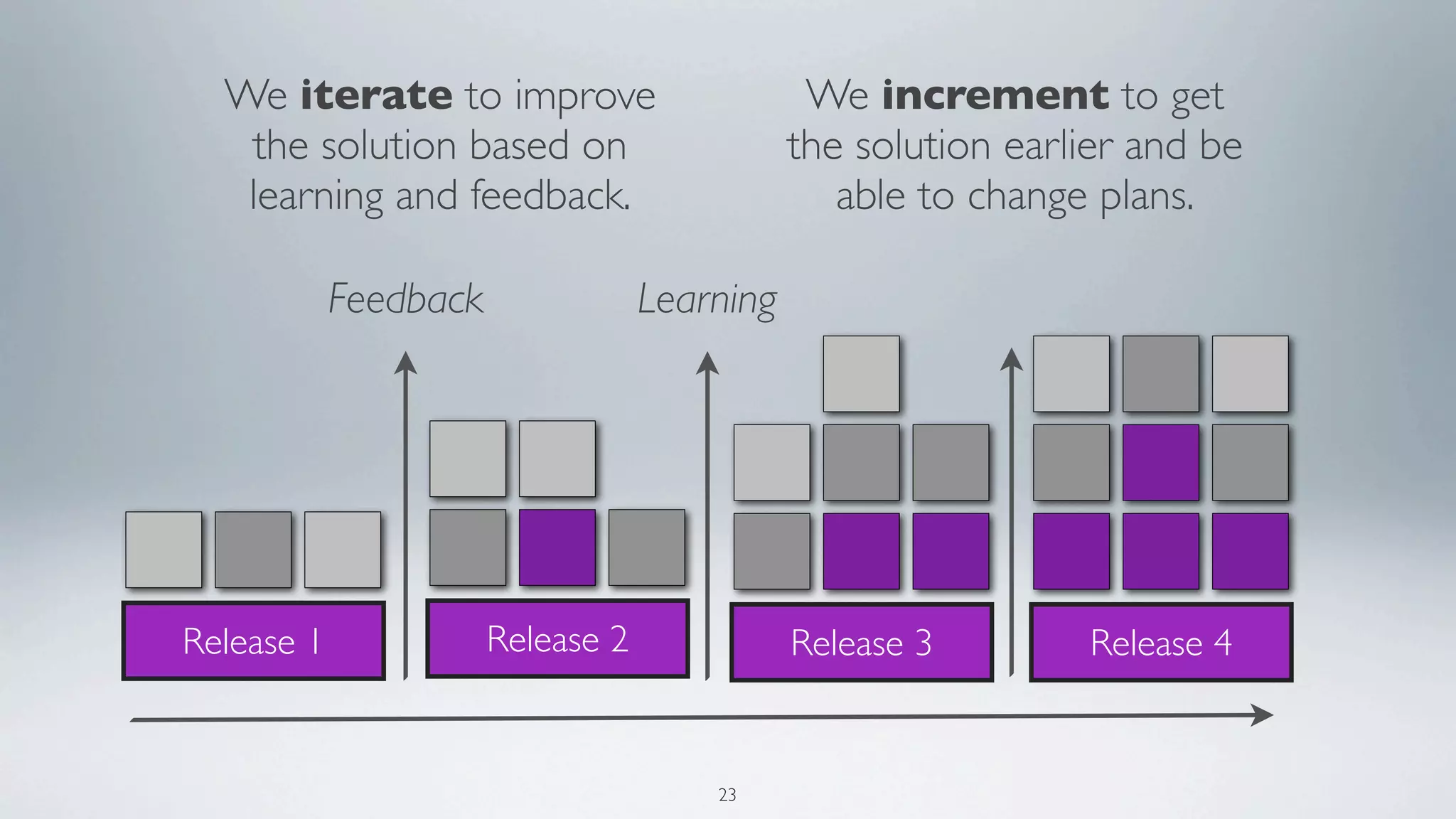

We iterate to improve                        We increment to get
   the solution based on                      the solution earlier and be
   learning and feedback.                        able to change plans.

            Feedback               Learning

Release 1              Release 2              Release 3        Release 4

                                       23

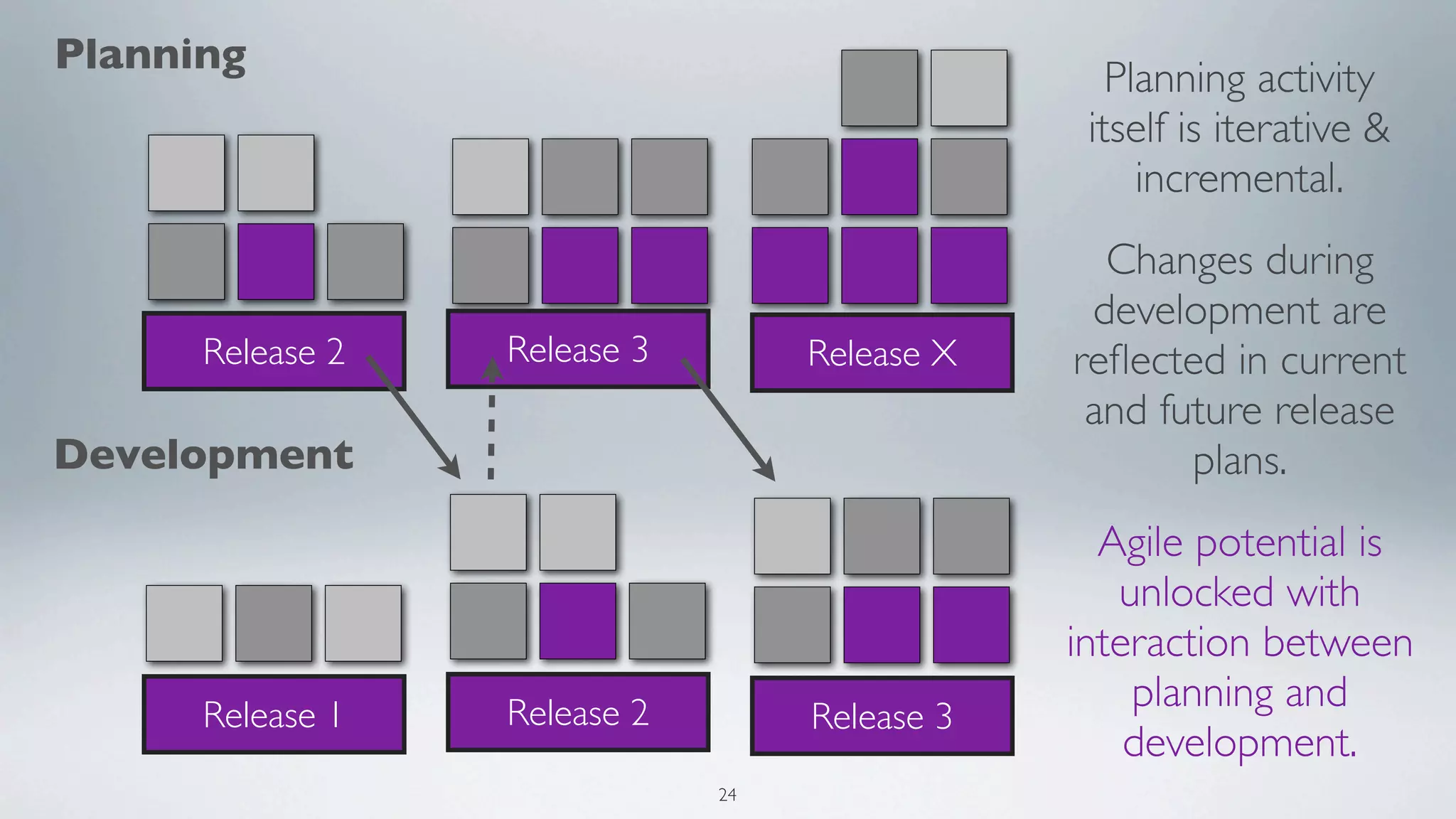

Planning
                                                  Planning activity
                                                itself is iterative &
                                                    incremental.
                                                 Changes during
                                                development are
      Release 2   Release 3        Release X   reflected in current
                                                and future release
Development                                           plans.
                                                 Agile potential is
                                                  unlocked with
                                               interaction between
      Release 1   Release 2                        planning and
                                   Release 3
                                                   development.
                              24
CONTINUOUSLY IMPROVING
 (BY ELIMINATING WASTE)
Waste                                As listed by Mary & Tom Poppendieck:
                                Extra steps
                            Information finding
                          Handovers
                           Task-switching
                              Defects (not caught)
                     Extra Features
                              Waiting

 Photo by Crimson (Pieter Janssen), used by Creative Commons license on site www.dreamstime.com
                                                   26

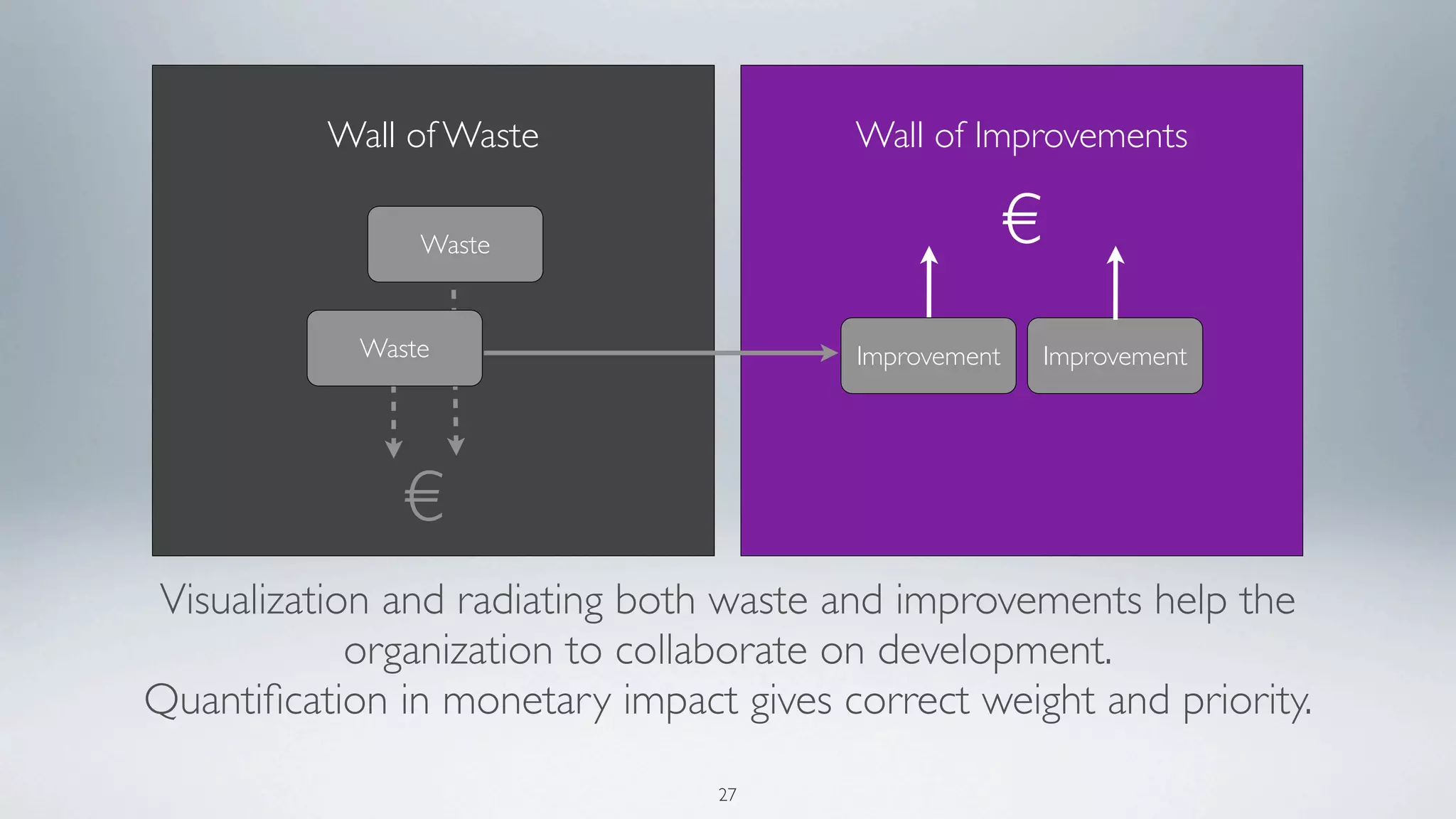

Wall of Waste                 Wall of Improvements

                Waste                                 €
            Waste                       Improvement       Improvement

               €
Visualization and radiating both waste and improvements help the
            organization to collaborate on development.
Quantification in monetary impact gives correct weight and priority.
                                27
CREATING A FLOW

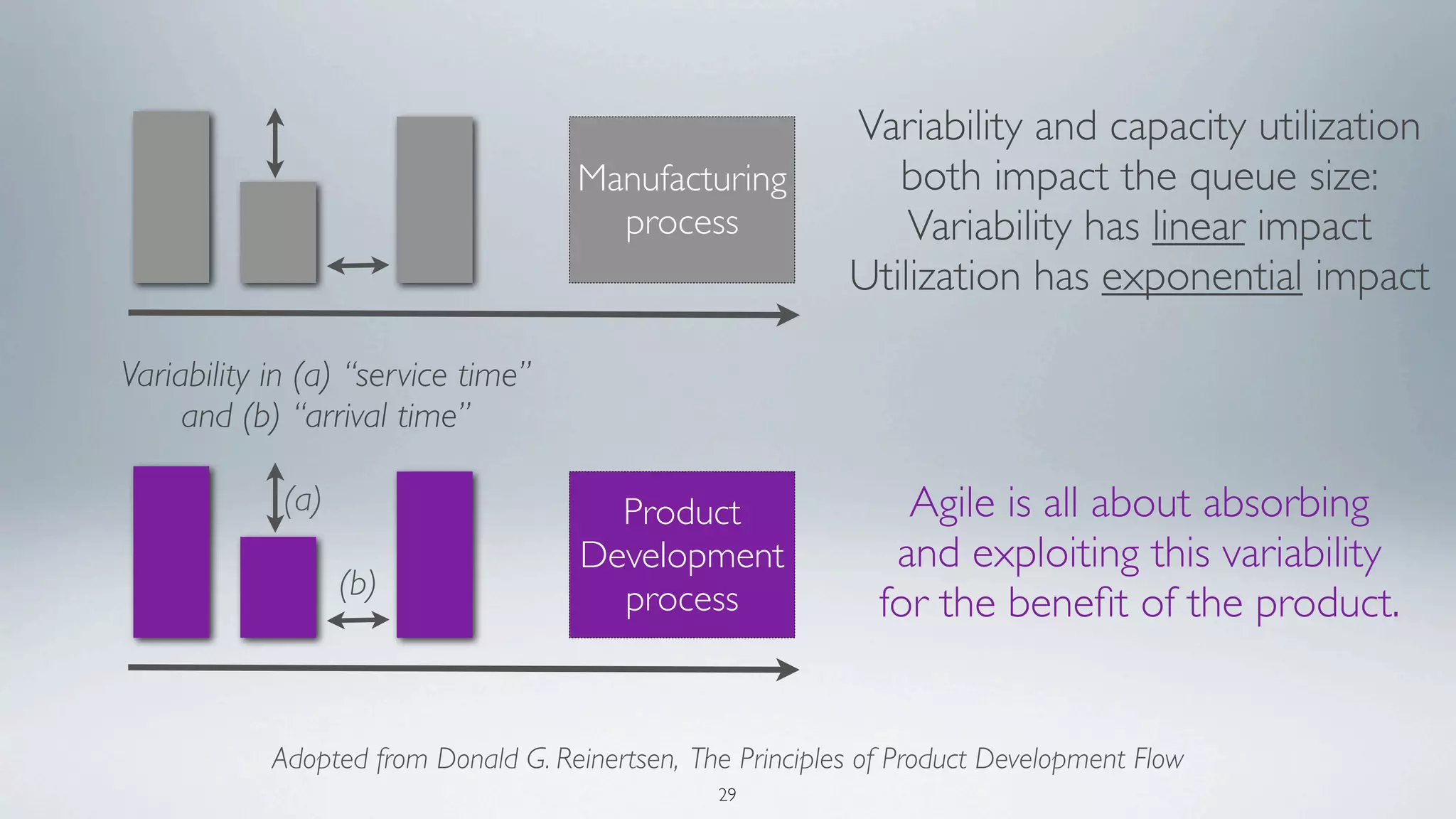

Variability and capacity utilization
                                     Manufacturing             both impact the queue size:
                                       process                  Variability has linear impact
                                                            Utilization has exponential impact

Variability in (a) “service time”
     and (b) “arrival time”

             (a)                       Product                   Agile is all about absorbing
                                     Development                and exploiting this variability
                   (b)                 process                 for the benefit of the product.

            Adopted from Donald G. Reinertsen, The Principles of Product Development Flow
                                                 29

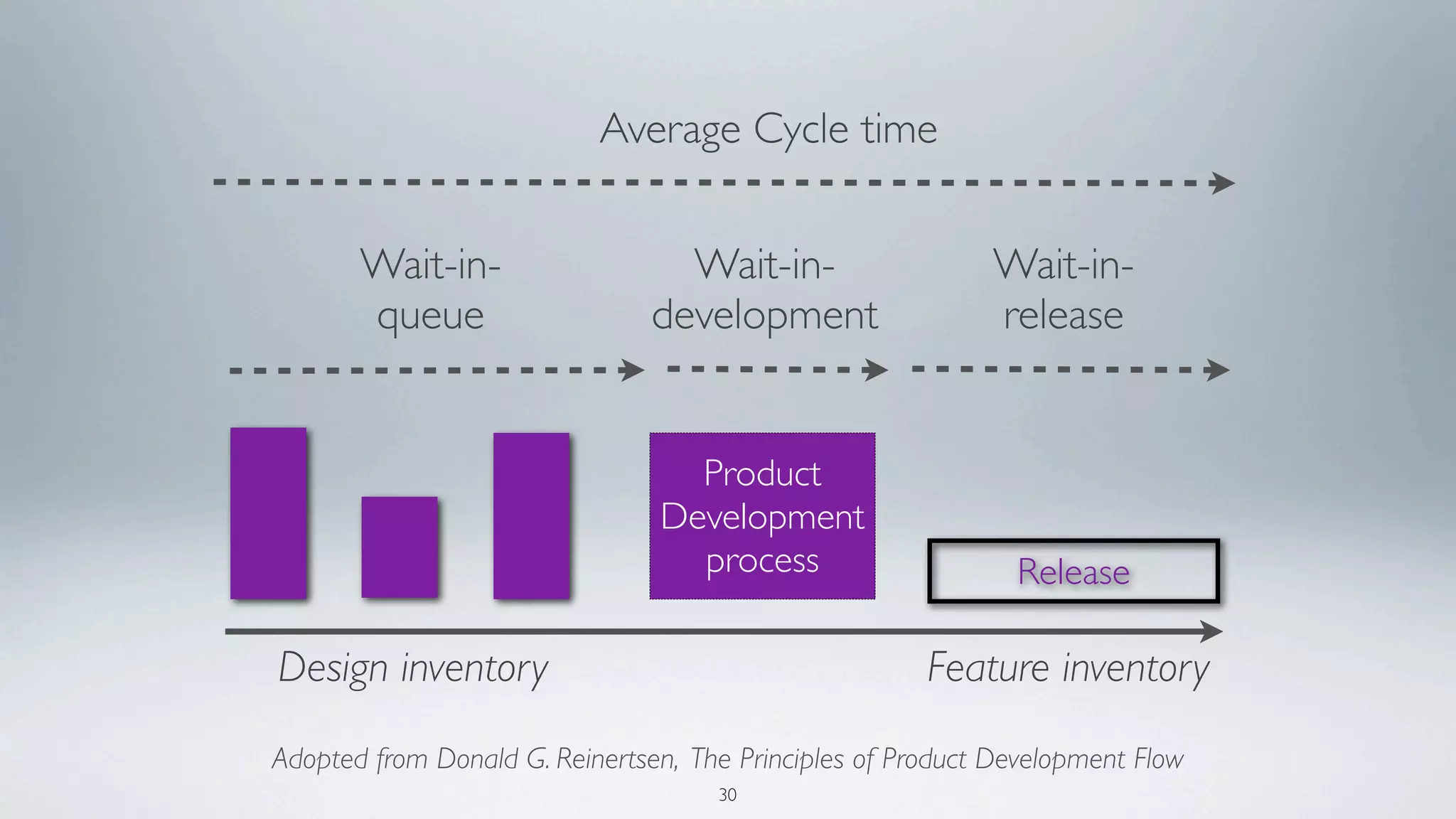

Average Cycle time

       Wait-in-                   Wait-in-                  Wait-in-
       queue                    development                 release

                                  Product
                                Development
                                  process                     Release

Design inventory                                       Feature inventory
Adopted from Donald G. Reinertsen, The Principles of Product Development Flow
                                     30

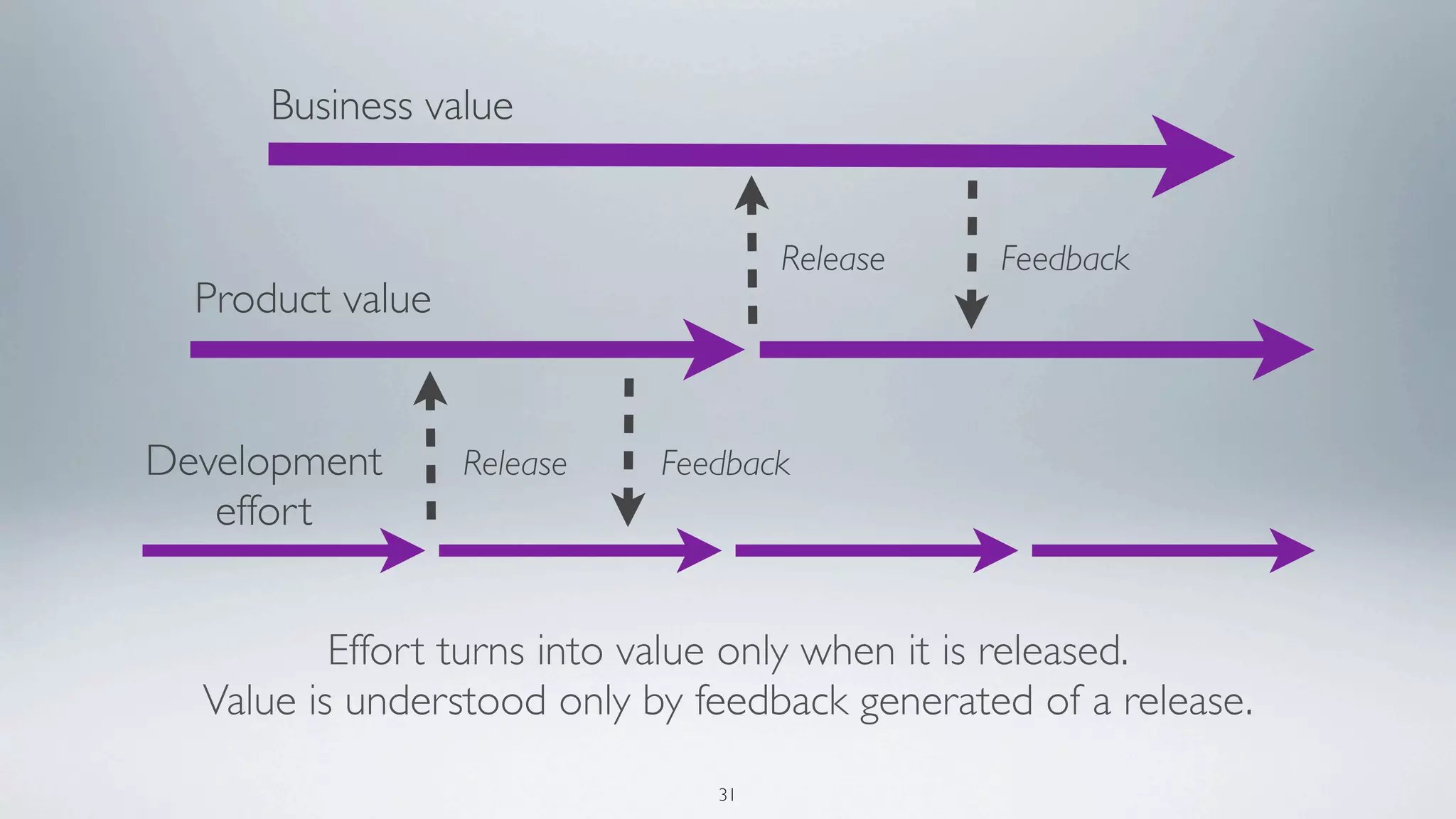

Business value

                                    Release    Feedback
  Product value

Development       Release   Feedback
   effort

          Effort turns into value only when it is released.
  Value is understood only by feedback generated of a release.
                               31

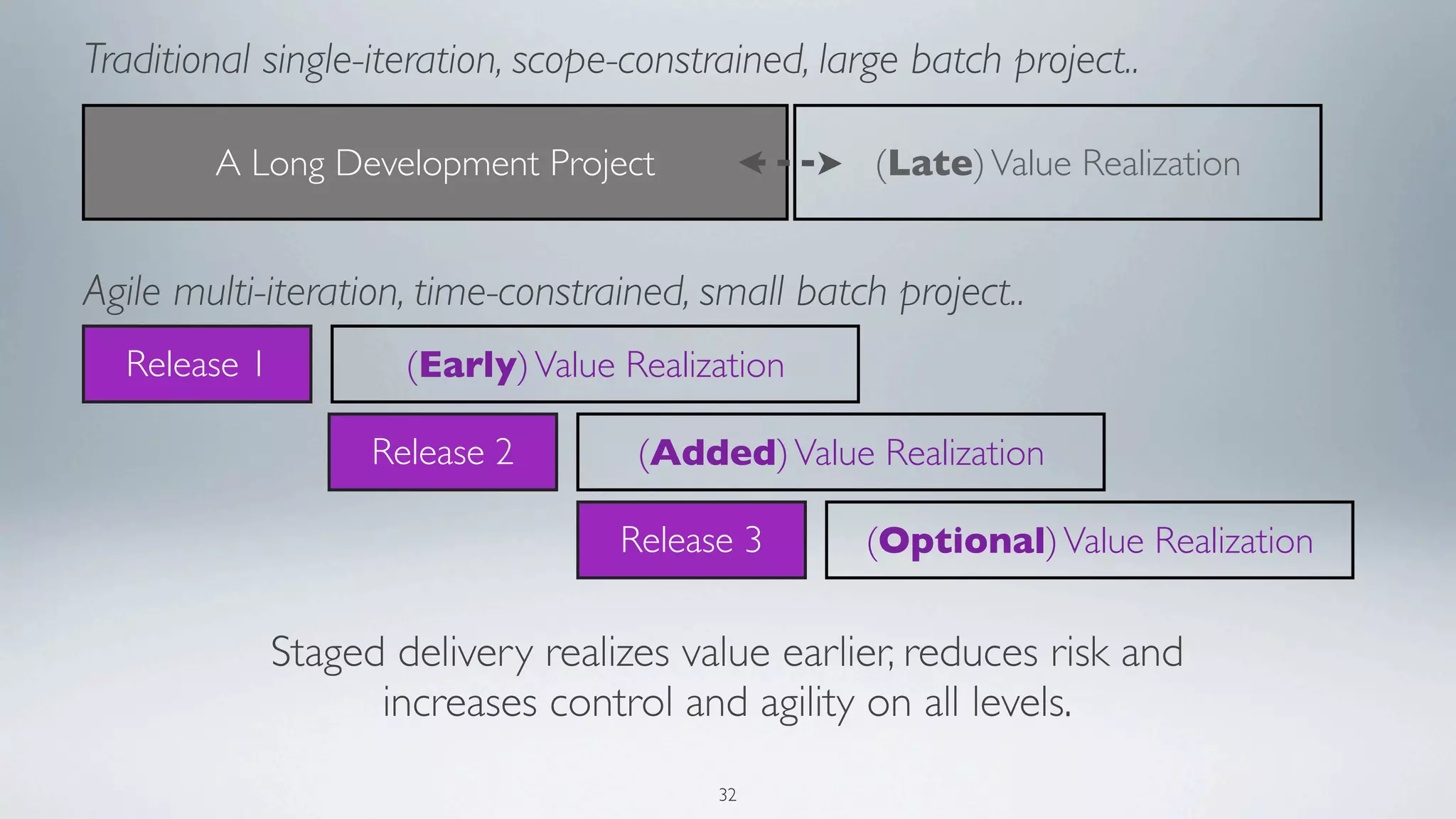

Traditional single-iteration, scope-constrained, large batch project..

        A Long Development Project                  (Late) Value Realization

Agile multi-iteration, time-constrained, small batch project..
  Release 1           (Early) Value Realization

                    Release 2        (Added) Value Realization

                                    Release 3      (Optional) Value Realization

              Staged delivery realizes value earlier, reduces risk and
                    increases control and agility on all levels.
                                          32
PLANNING PRODUCTS
Leffingwell’s product abstraction defined three abstraction levels:

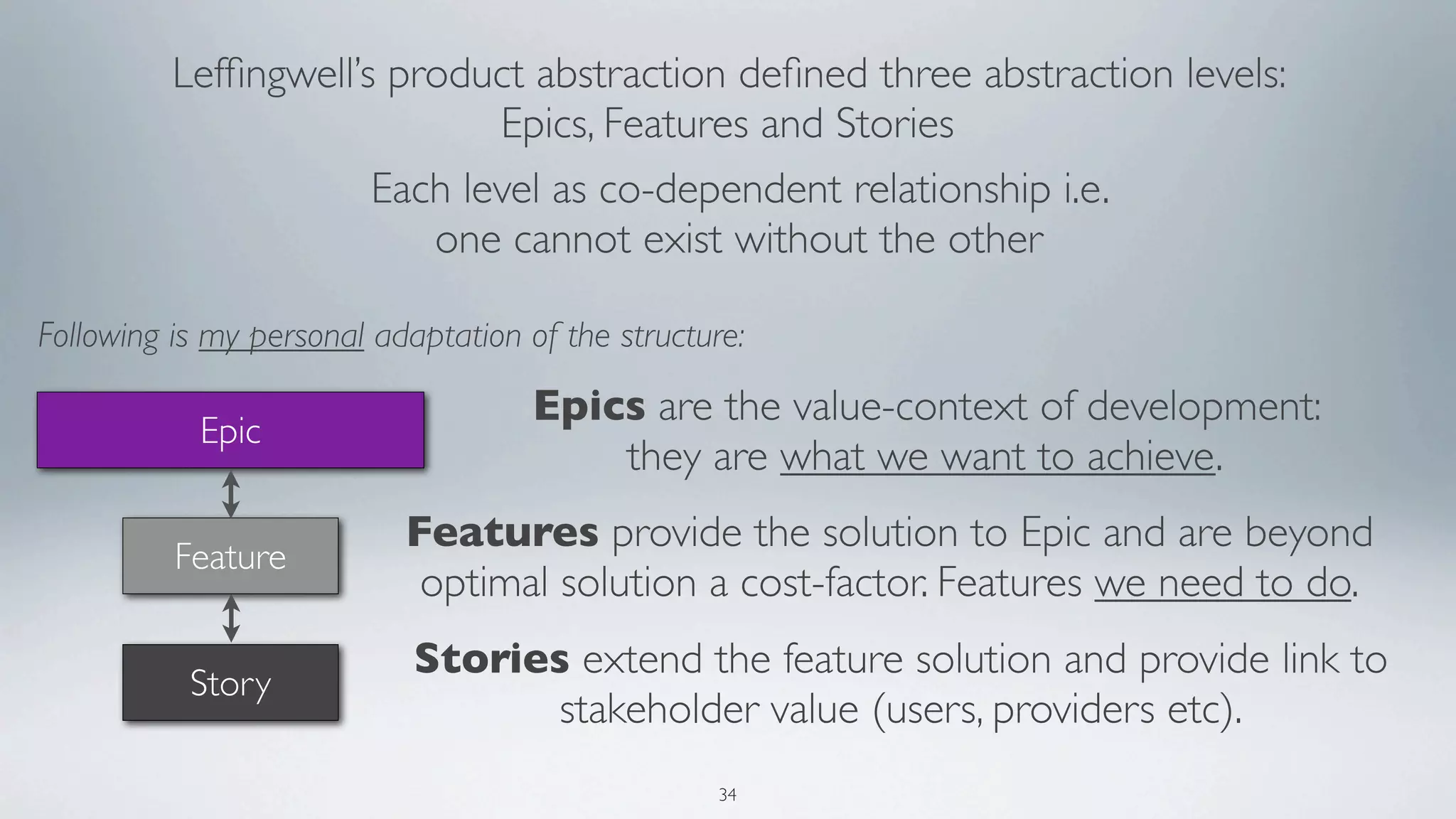

                             Epics, Features and Stories
                      Each level as co-dependent relationship i.e.
                         one cannot exist without the other

Following is my personal adaptation of the structure:

                                     Epics are the value-context of development:
            Epic
                                         they are what we want to achieve.
                           Features provide the solution to Epic and are beyond
          Feature
                            optimal solution a cost-factor. Features we need to do.
                            Stories extend the feature solution and provide link to
           Story
                                  stakeholder value (users, providers etc).
                                                   34

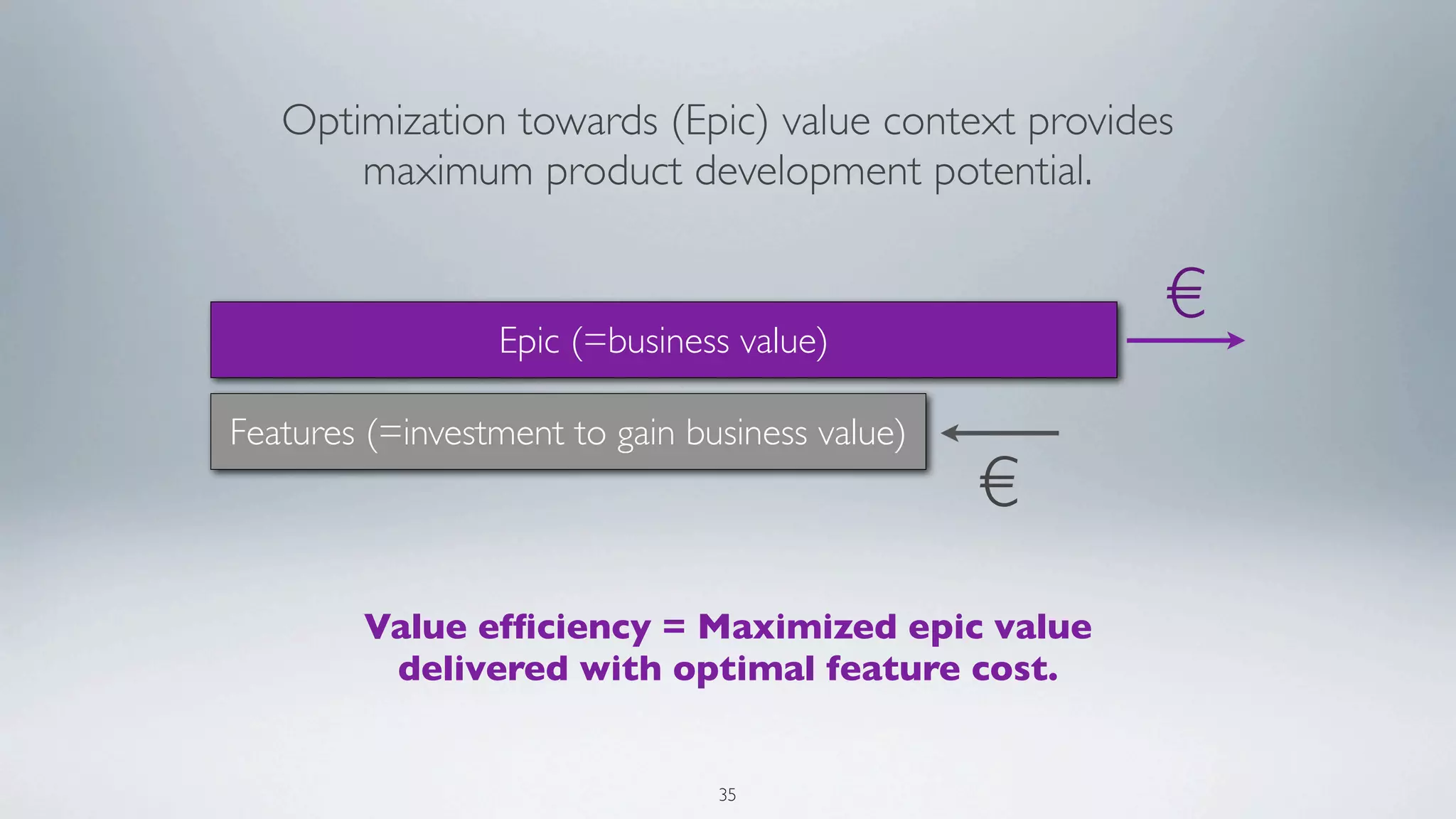

Optimization towards (Epic) value context provides
       maximum product development potential.

                 Epic (=business value)
                                                    €
Features (=investment to gain business value)
                                                €
        Value efficiency = Maximized epic value
         delivered with optimal feature cost.

                                35

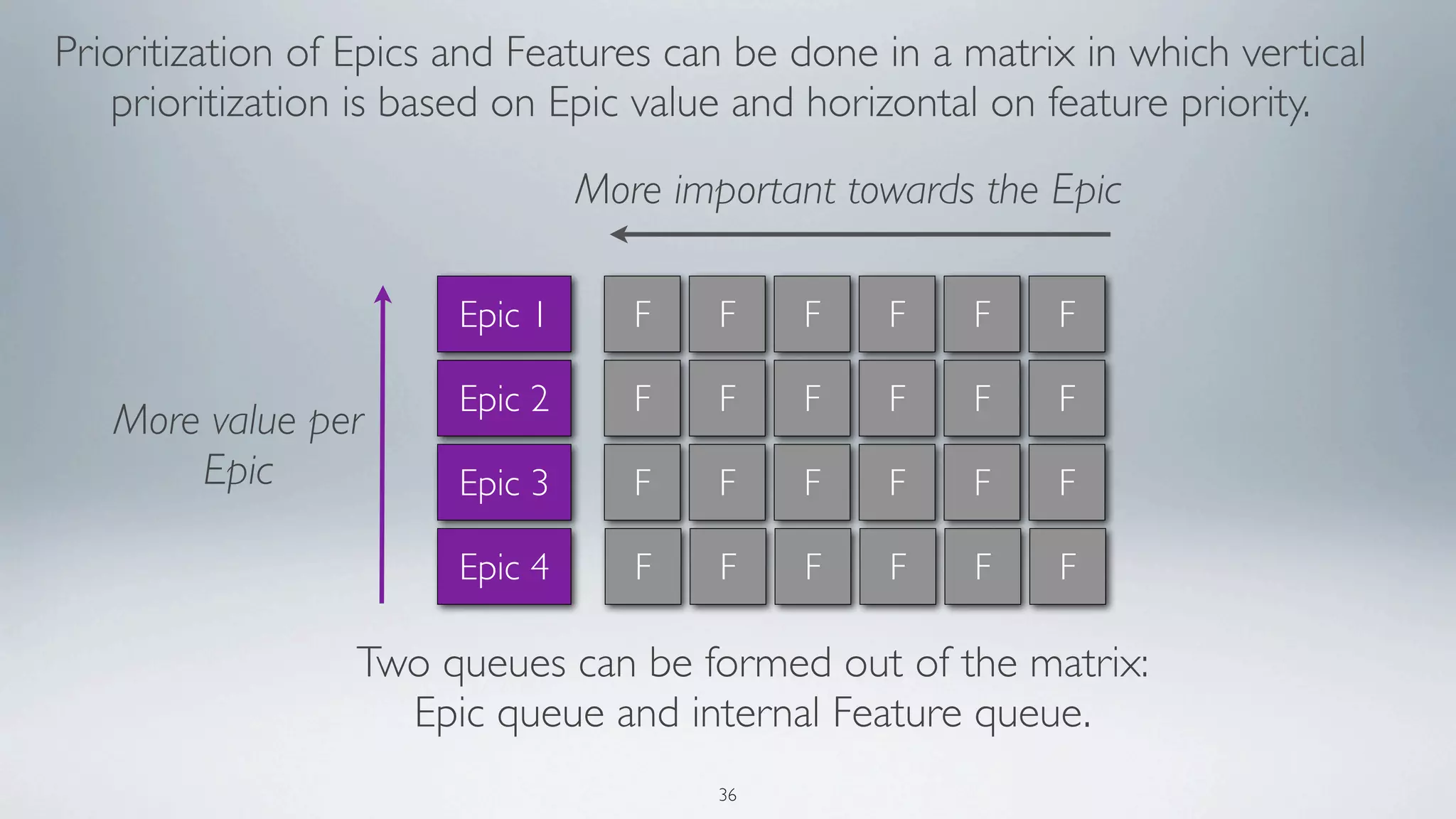

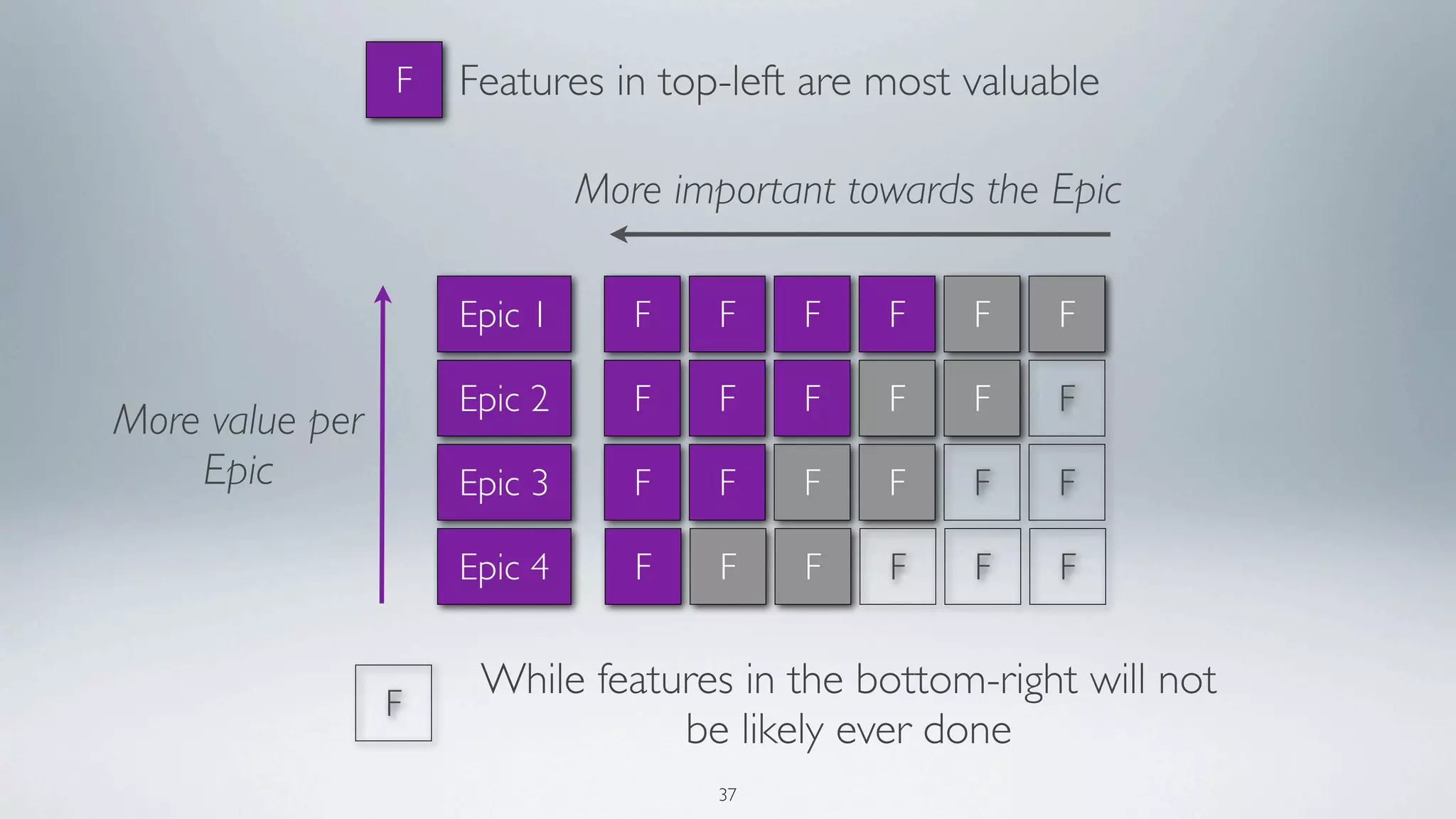

Prioritization of Epics and Features can be done in a matrix in which vertical
   prioritization is based on Epic value and horizontal on feature priority.
                                 More important towards the Epic

                        Epic 1      F    F    F   F    F    F

                        Epic 2      F    F    F   F    F    F
   More value per
       Epic             Epic 3      F    F    F   F    F    F

                        Epic 4      F    F    F   F    F    F

                 Two queues can be formed out of the matrix:
                   Epic queue and internal Feature queue.
                                         36
F   Features in top-left are most valuable

                              More important towards the Epic

                     Epic 1      F    F    F   F    F    F

                     Epic 2      F    F    F   F    F    F
More value per
    Epic             Epic 3      F    F    F   F    F    F

                     Epic 4      F    F    F   F    F    F

                      While features in the bottom-right will not
                 F
                                 be likely ever done
                                      37

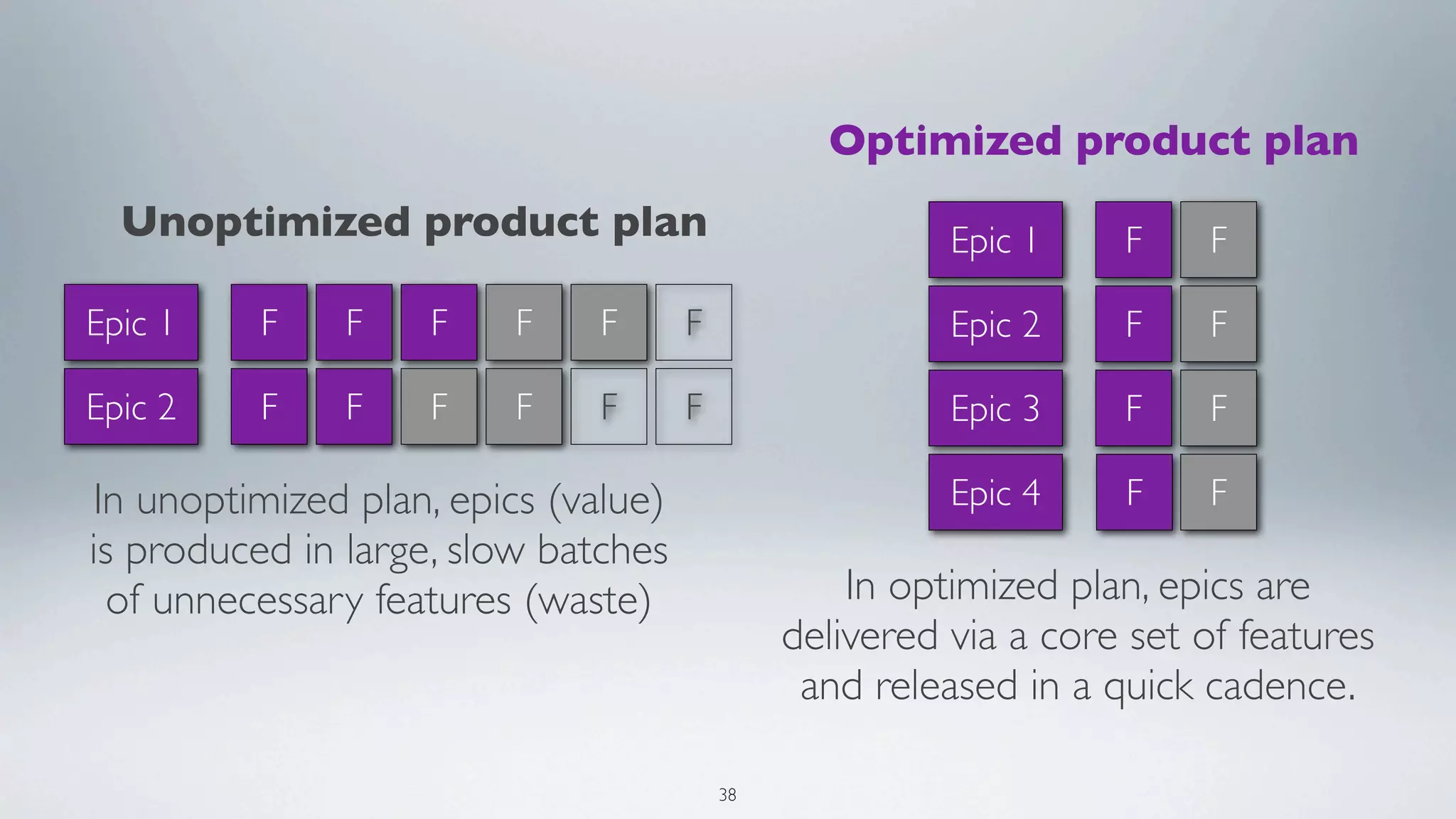

Optimized product plan
  Unoptimized product plan                              Epic 1    F     F

Epic 1    F    F    F    F    F      F                  Epic 2    F     F

Epic 2    F    F    F    F    F      F                  Epic 3    F     F

In unoptimized plan, epics (value)                      Epic 4    F     F
is produced in large, slow batches
  of unnecessary features (waste)                 In optimized plan, epics are
                                              delivered via a core set of features
                                               and released in a quick cadence.

                                         38
Level 1: Unorganized backlog                             Level 2: Prioritized backlog

                                                                             Top-priority

                    Level 3: Groomed backlog
                                   loren         loren
                                  impsum        impsum
                                   loren         loren
                                  impsum        impsum

                          loren    loren         loren
                         impsum   impsum        impsum
                          loren    loren         loren
                         impsum   impsum        impsum

                 loren
                impsum
                 loren
                impsum

                                           39
Backlog prioritization is an on-going
                                             Prioritization model should be both
   process on all backlog levels,
                                                 simple and meaningful
  peaking at the start of a cycle.

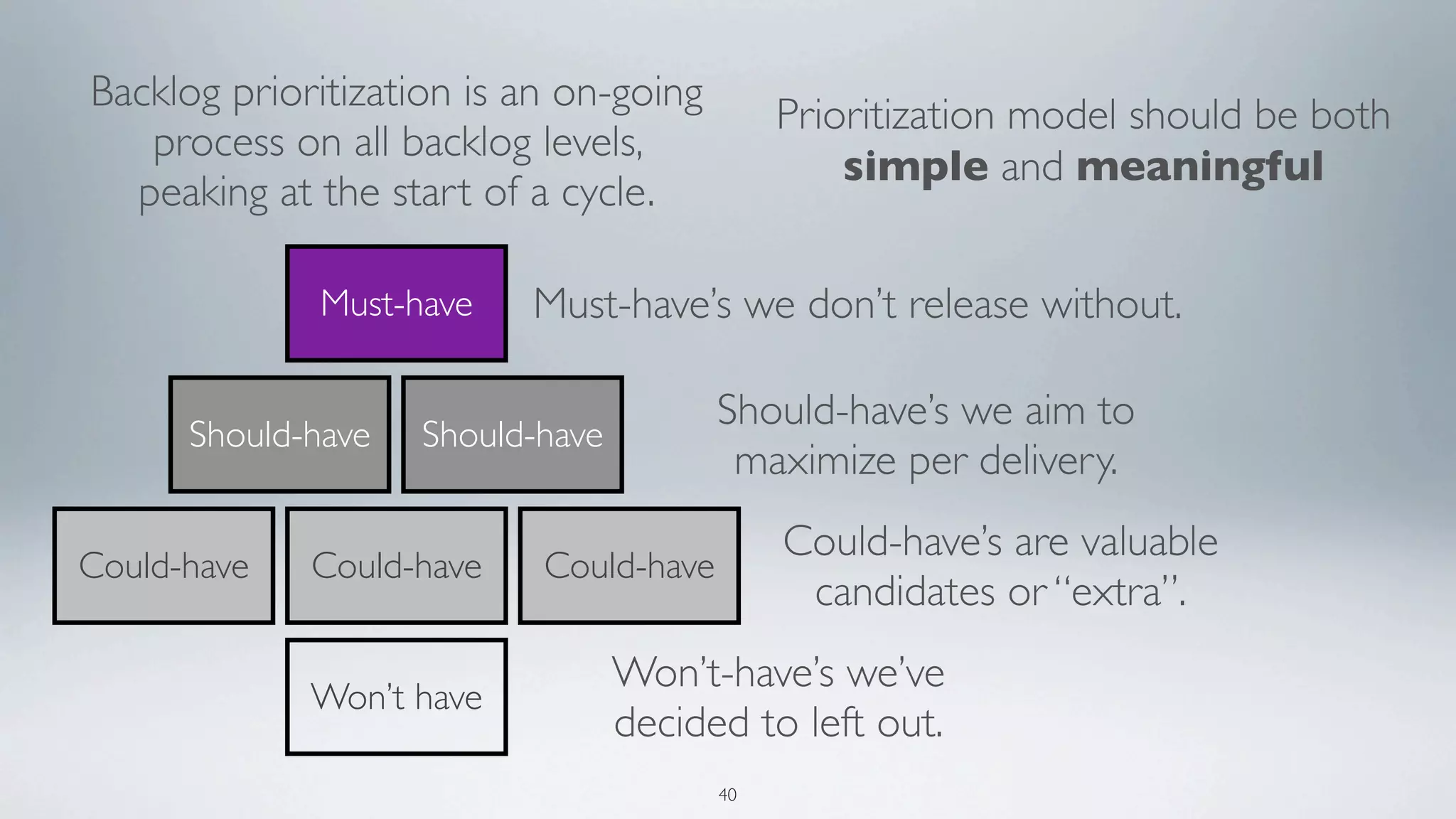

             Must-have    Must-have’s we don’t release without.

                                        Should-have’s we aim to
      Should-have   Should-have
                                         maximize per delivery.
                                             Could-have’s are valuable
Could-have   Could-have    Could-have
                                              candidates or “extra”.
                                  Won’t-have’s we’ve
             Won’t have
                                  decided to left out.
                                        40

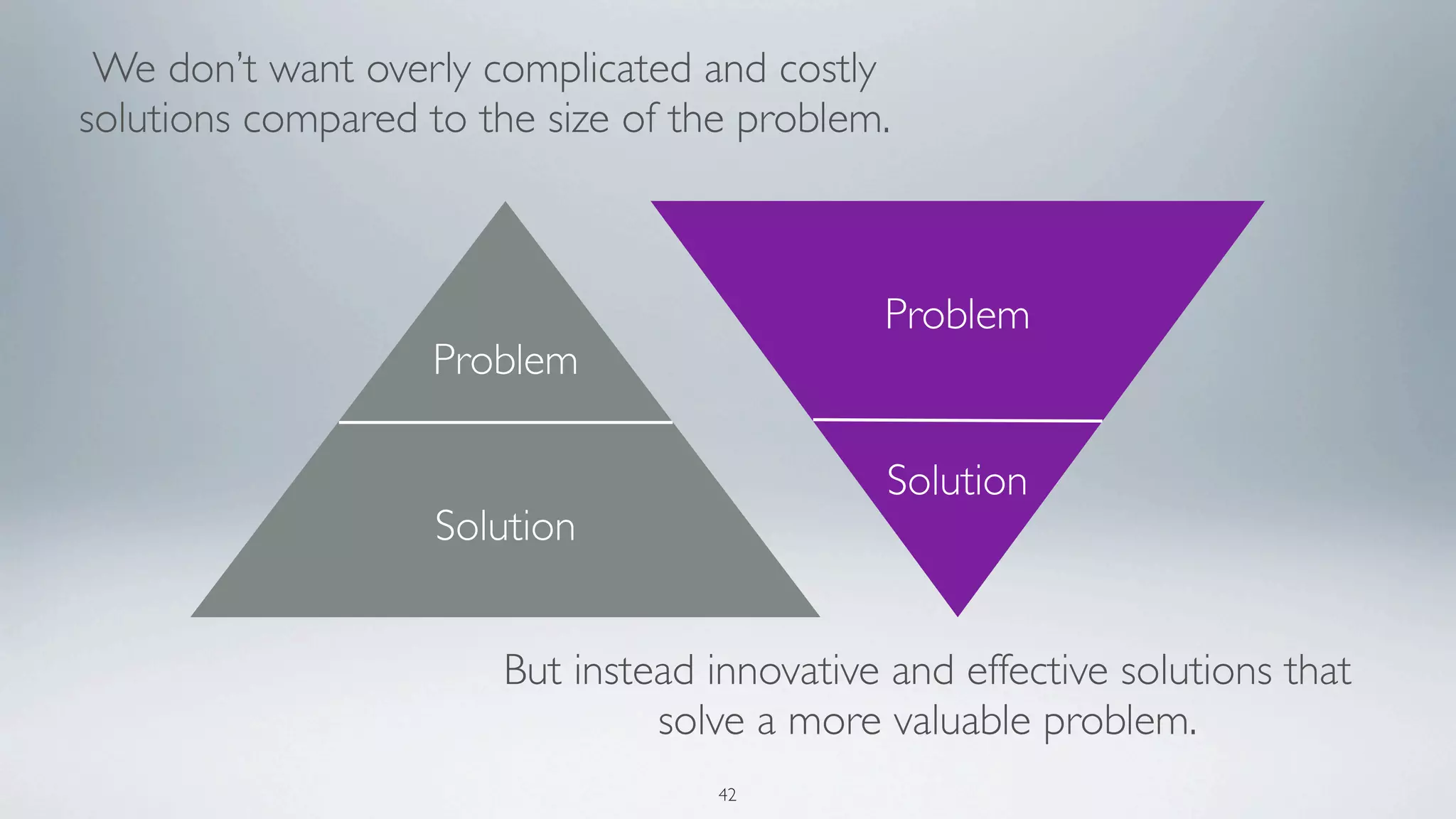

OPTIMIZING BACKLOG
We don’t want overly complicated and costly
solutions compared to the size of the problem.

                                              Problem
                    Problem

                                               Solution
                    Solution

                        But instead innovative and effective solutions that
                                 solve a more valuable problem.
                                    42

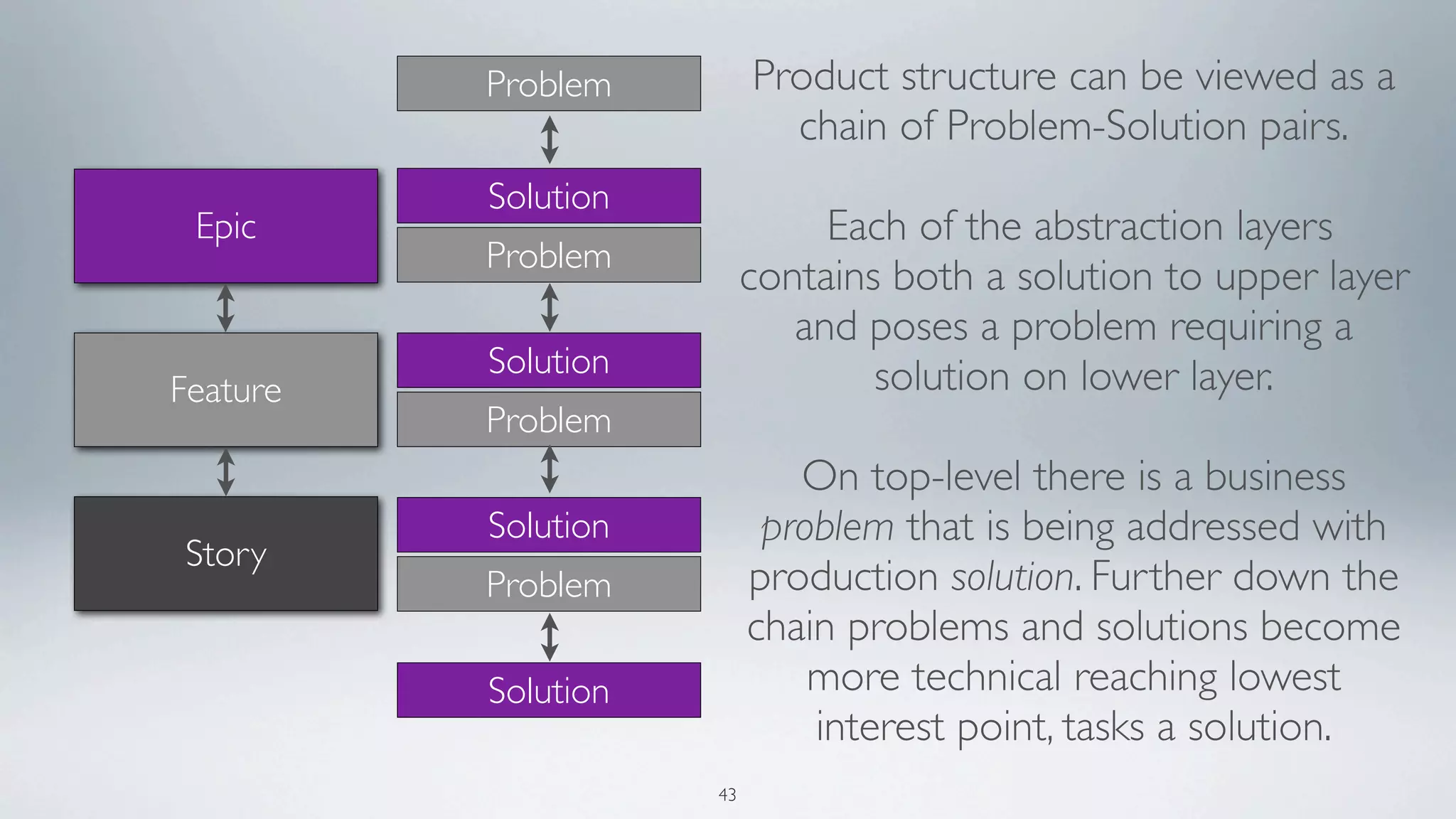

Problem         Product structure can be viewed as a
                            chain of Problem-Solution pairs.
          Solution
 Epic                          Each of the abstraction layers
          Problem
                          contains both a solution to upper layer
                             and poses a problem requiring a
          Solution                solution on lower layer.
Feature
          Problem
                             On top-level there is a business
          Solution         problem that is being addressed with
Story
          Problem         production solution. Further down the
                          chain problems and solutions become
          Solution            more technical reaching lowest
                              interest point, tasks a solution.
                     43

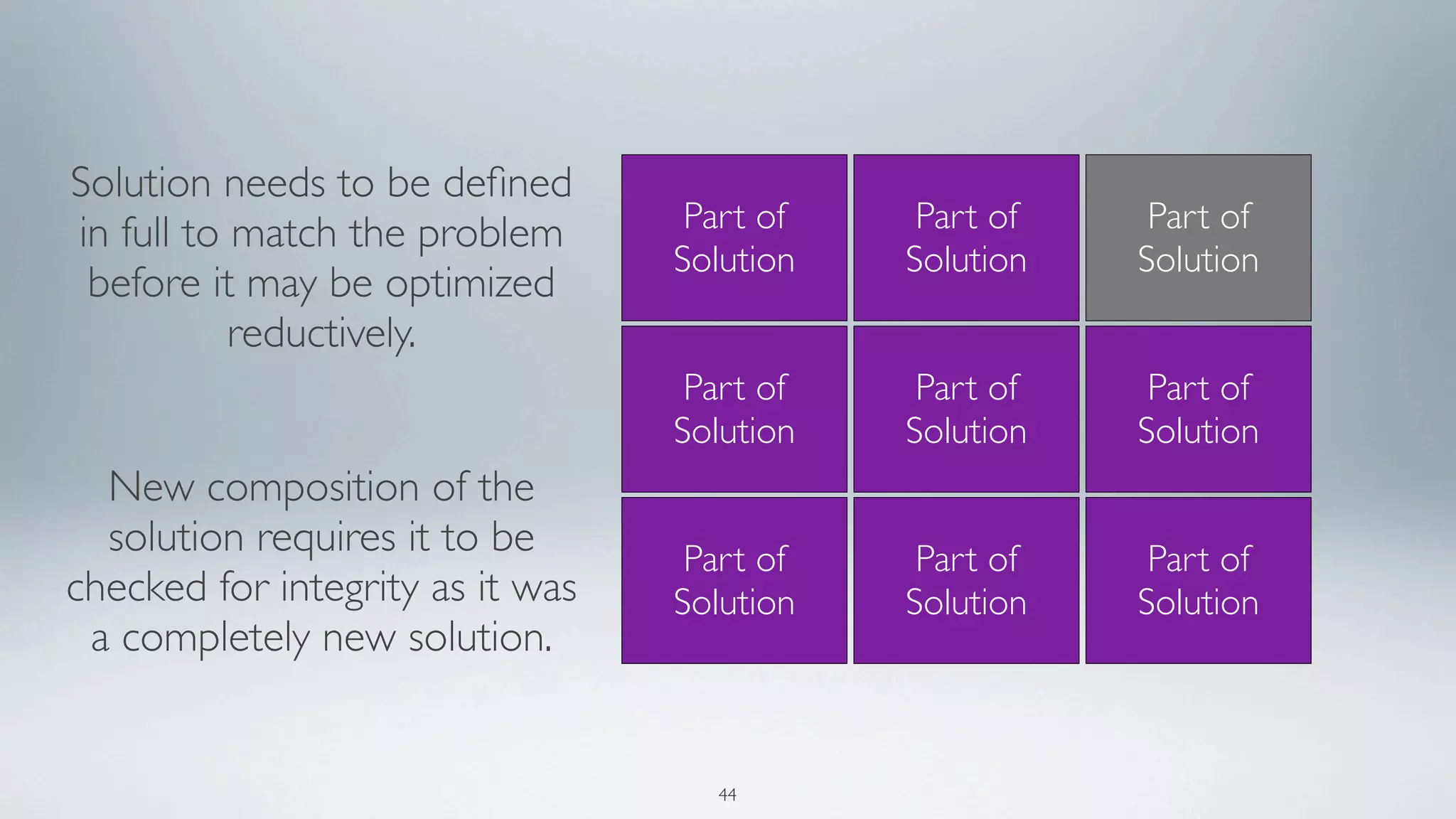

Solution needs to be defined
in full to match the problem       Part of    Part of    Part of
                                  Solution   Solution   Solution
 before it may be optimized
           reductively.
                                   Part of    Part of    Part of
                                  Solution   Solution   Solution
  New composition of the
  solution requires it to be       Part of    Part of    Part of
checked for integrity as it was   Solution   Solution   Solution
 a completely new solution.

                                    44

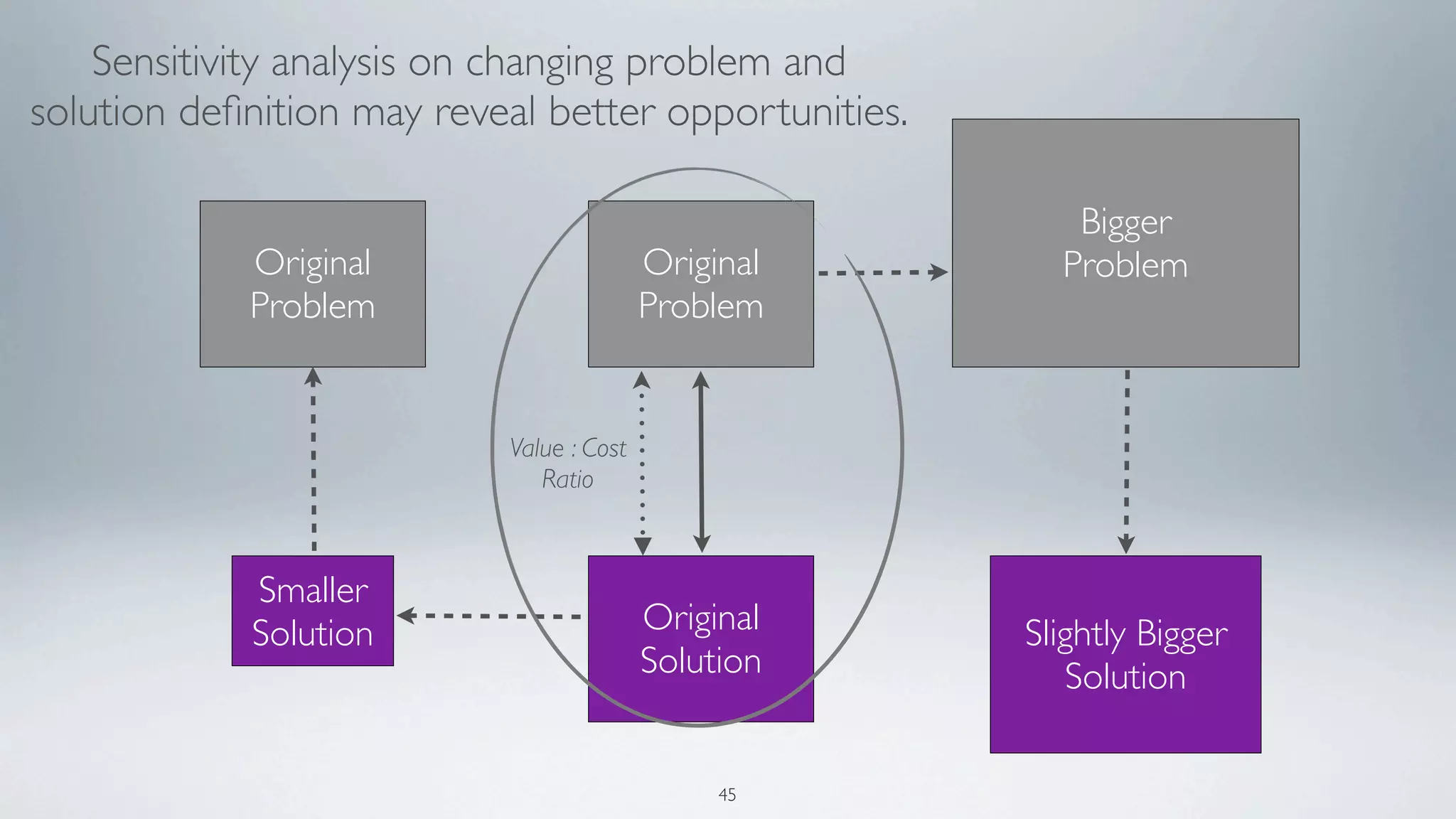

Sensitivity analysis on changing problem and
solution definition may reveal better opportunities.

                                                         Bigger
            Original                      Original      Problem
            Problem                       Problem

                           Value : Cost
                              Ratio

            Smaller
            Solution                      Original    Slightly Bigger
                                          Solution       Solution

                                               45
time
   PDCA-cycle

  Original          Better                         Problem-Solution
  Problem          Defined           Correct    definition evolves over
                   Problem          Problem     time and requires full
                                                 recheck periodically
                                                 (preferably between
                                    Optimal    sprints) to validate the
                   Improved
  Original                          Solution      optimal solution to
                    Solution
  Solution                                         correct problem.

CHECK           CHECK          CHECK
                               46
PLANNING RELEASES AND ROADMAPS

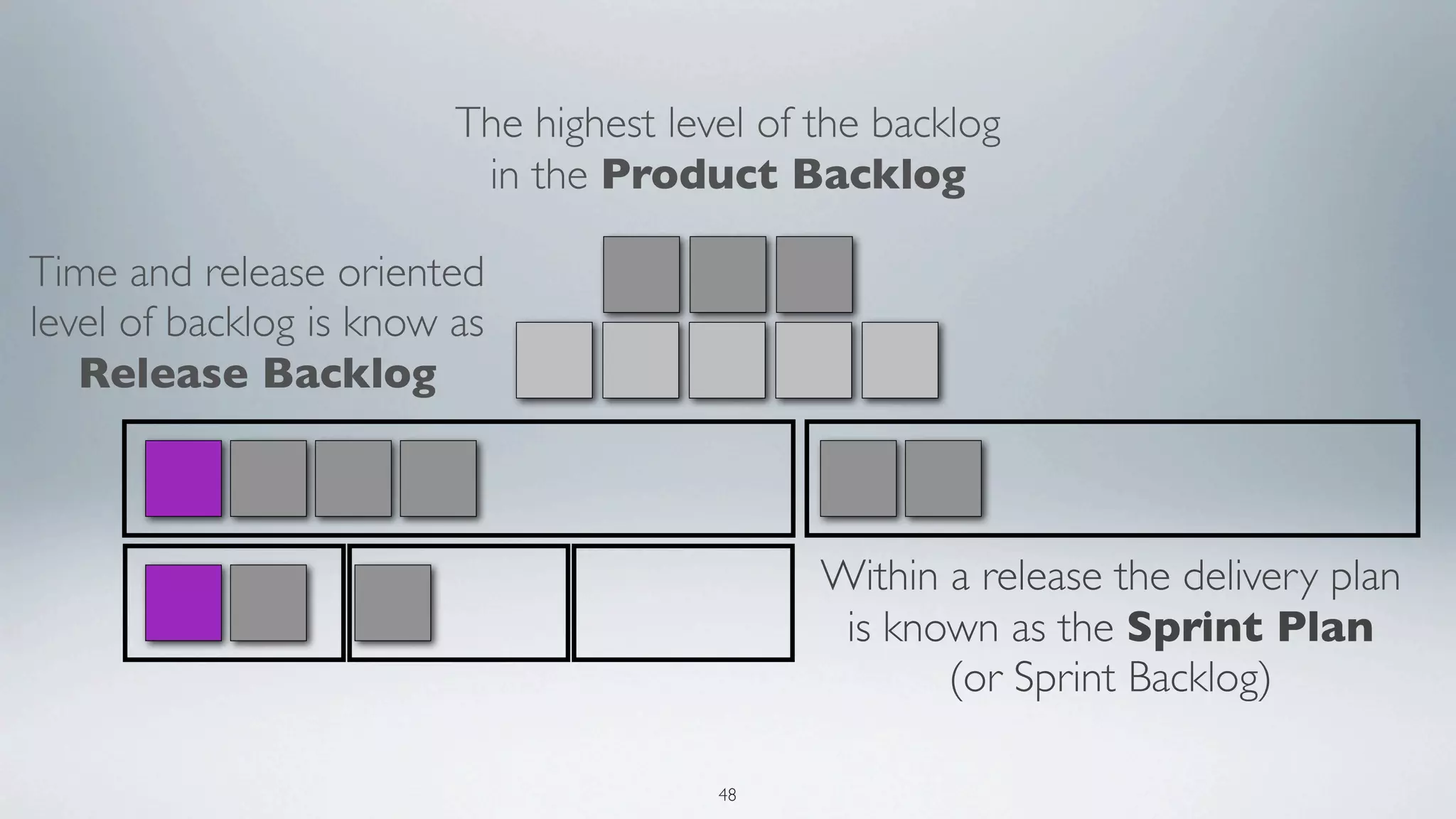

The highest level of the backlog
                          in the Product Backlog

Time and release oriented
level of backlog is know as
   Release Backlog

                                              Within a release the delivery plan
                                               is known as the Sprint Plan
                                                     (or Sprint Backlog)

                                        48

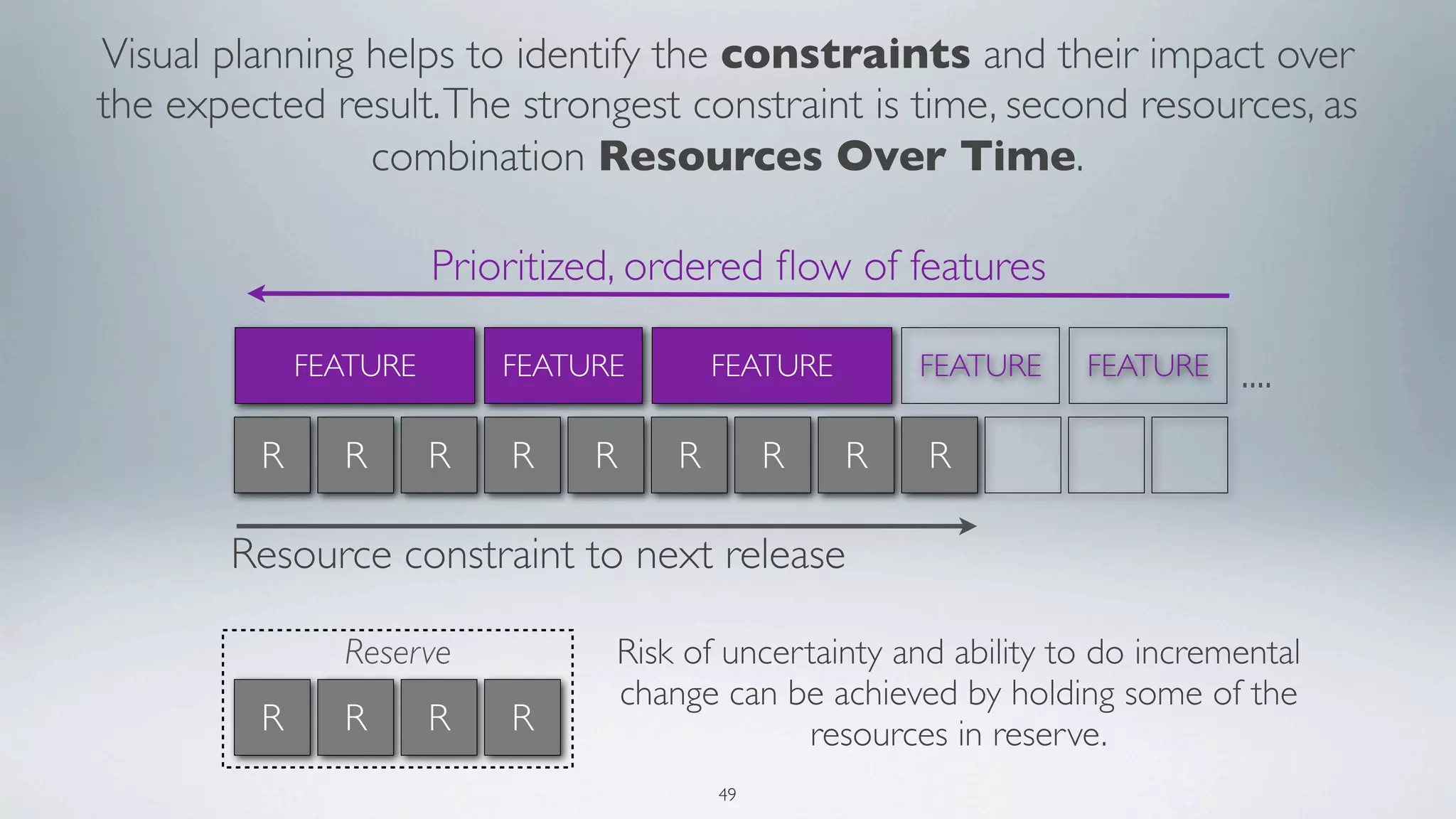

Visual planning helps to identify the constraints and their impact over
the expected result. The strongest constraint is time, second resources, as
                combination Resources Over Time.

                       Prioritized, ordered flow of features

             FEATURE       FEATURE       FEATURE       FEATURE    FEATURE    ....
         R     R       R   R    R    R        R    R   R

       Resource constraint to next release

               Reserve           Risk of uncertainty and ability to do incremental
                                 change can be achieved by holding some of the
         R     R       R   R                  resources in reserve.
                                         49

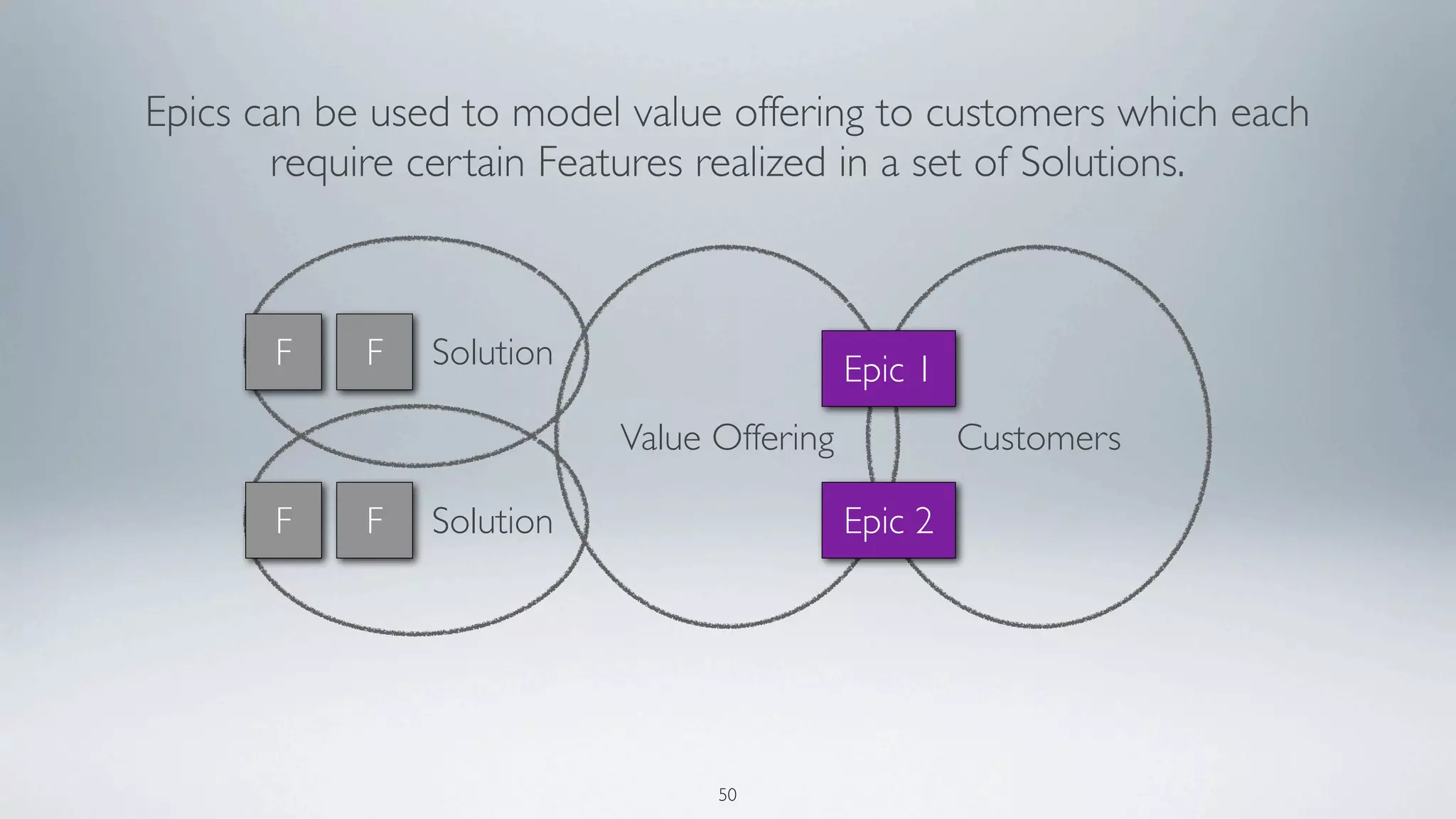

Epics can be used to model value offering to customers which each
       require certain Features realized in a set of Solutions.

       F    F   Solution                    Epic 1
                           Value Offering            Customers

       F    F   Solution                    Epic 2

                                 50

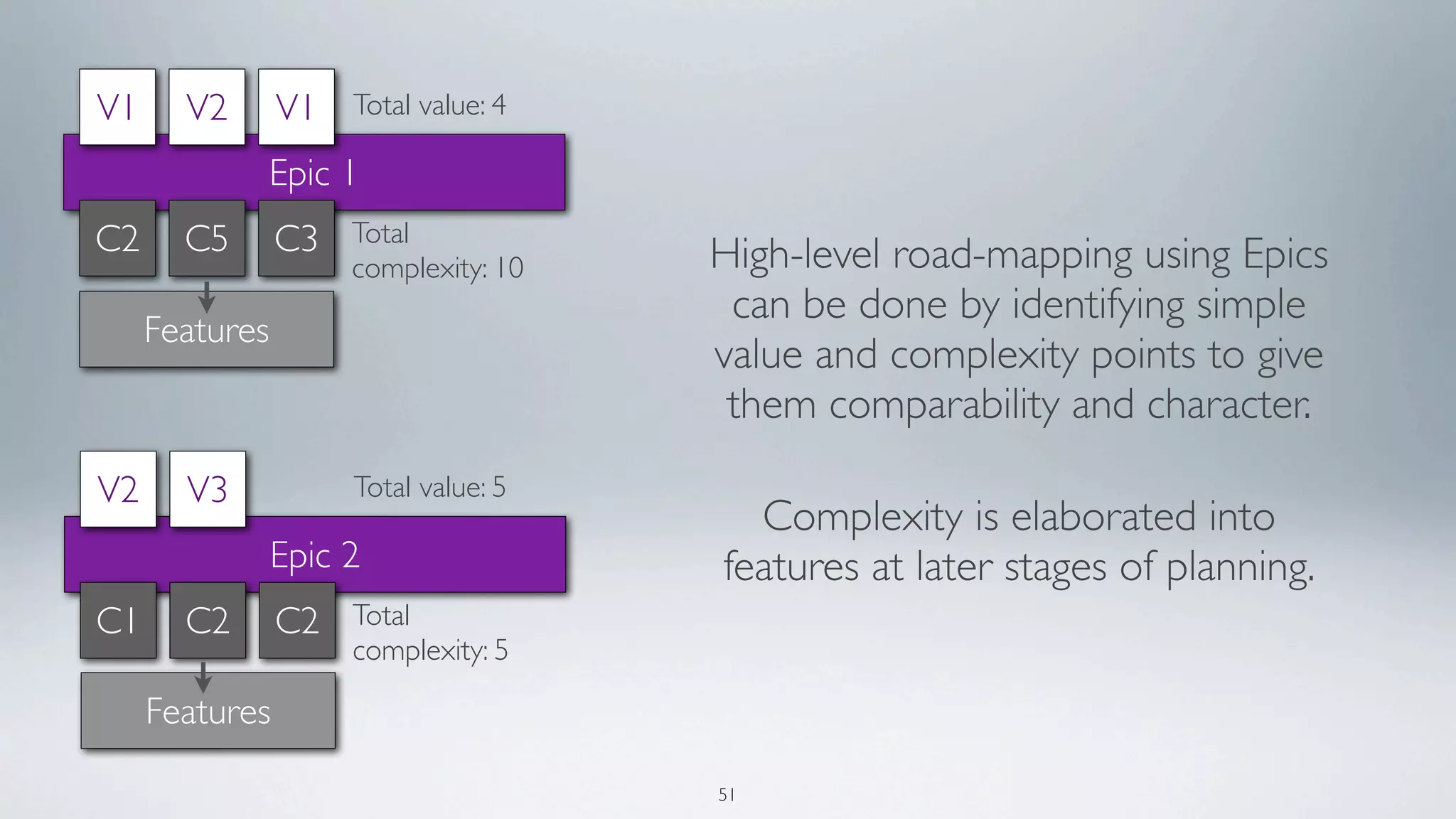

V1     V2       V1 Total value: 4
            Epic 1
C2     C5       C3 Total              High-level road-mapping using Epics
                     complexity: 10
                                       can be done by identifying simple
     Features
                                      value and complexity points to give
                                       them comparability and character.
V2     V3            Total value: 5
                                        Complexity is elaborated into
                Epic 2                features at later stages of planning.
C1     C2       C2 Total
                     complexity: 5

     Features

                                      51

AGILE ROLES & OWNERSHIP
Transfers the
                                    product vision
                                                            Team
         Product Owner

           Grooms backlog           Plans releases
                   loren    loren
                  impsum   impsum
                   loren    loren
                  impsum   impsum
                                                        Release 1
          loren    loren    loren
         impsum   impsum   impsum
          loren    loren    loren
         impsum   impsum   impsum

 loren
impsum
                                             Sprint 1   Sprint 2    Sprint 3
 loren
impsum

                                        53

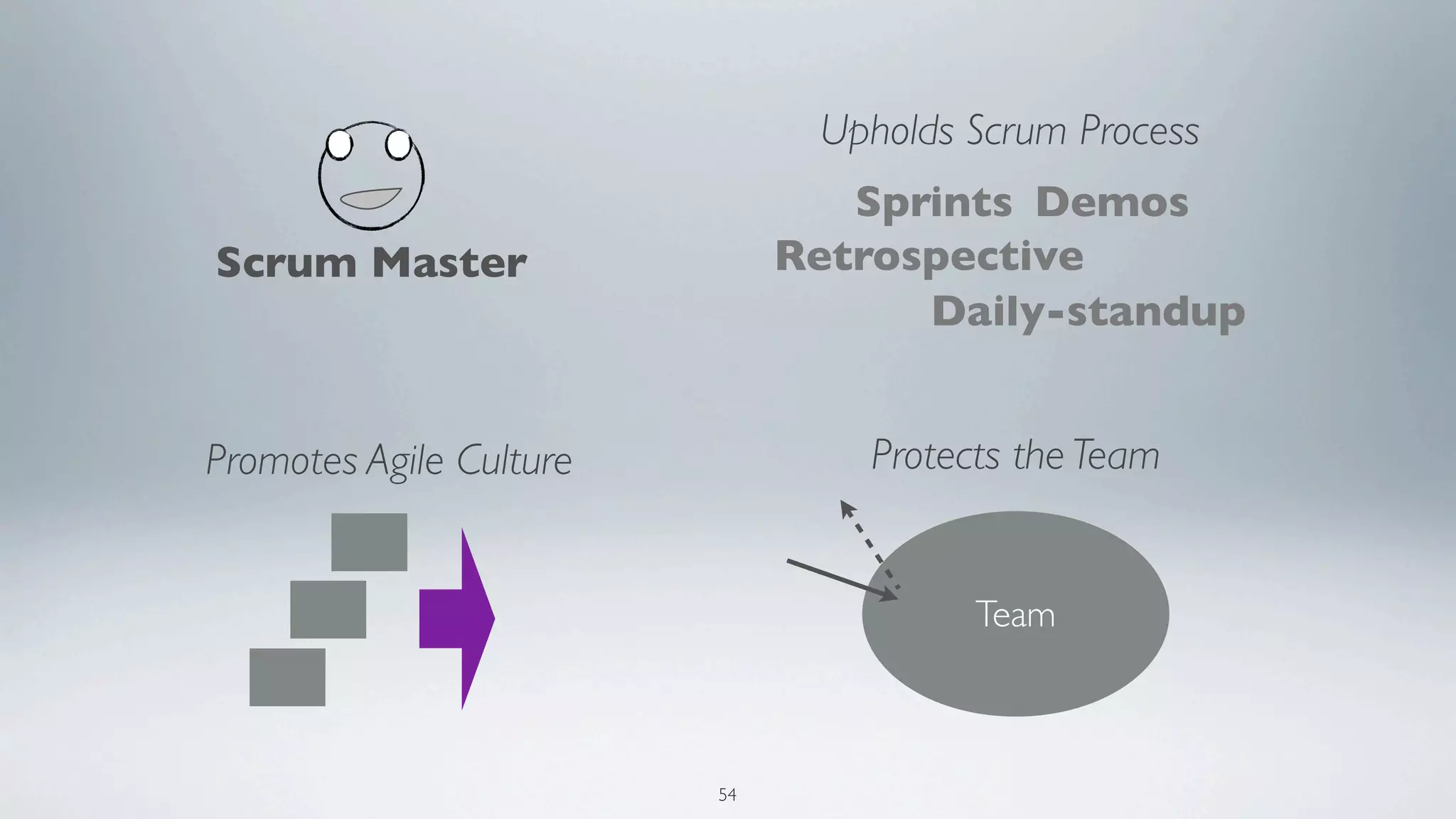

Upholds Scrum Process
                                 Sprints Demos
Scrum Master                  Retrospective
                                    Daily-standup

Promotes Agile Culture           Protects the Team

                                       Team

                         54
Seeks to maximize the
                                          product value
          Team                                          loren
                                                       impsum
                                                        loren
                                                       impsum
                                               loren
                                              impsum    loren
                                               loren   impsum
                                              impsum    loren
                                                       impsum

                                     Continuously analyzes and
Self-organizes the tasks to
                                   improves the working practices
     meet Sprint goals

                                       Team                     Team

                              55

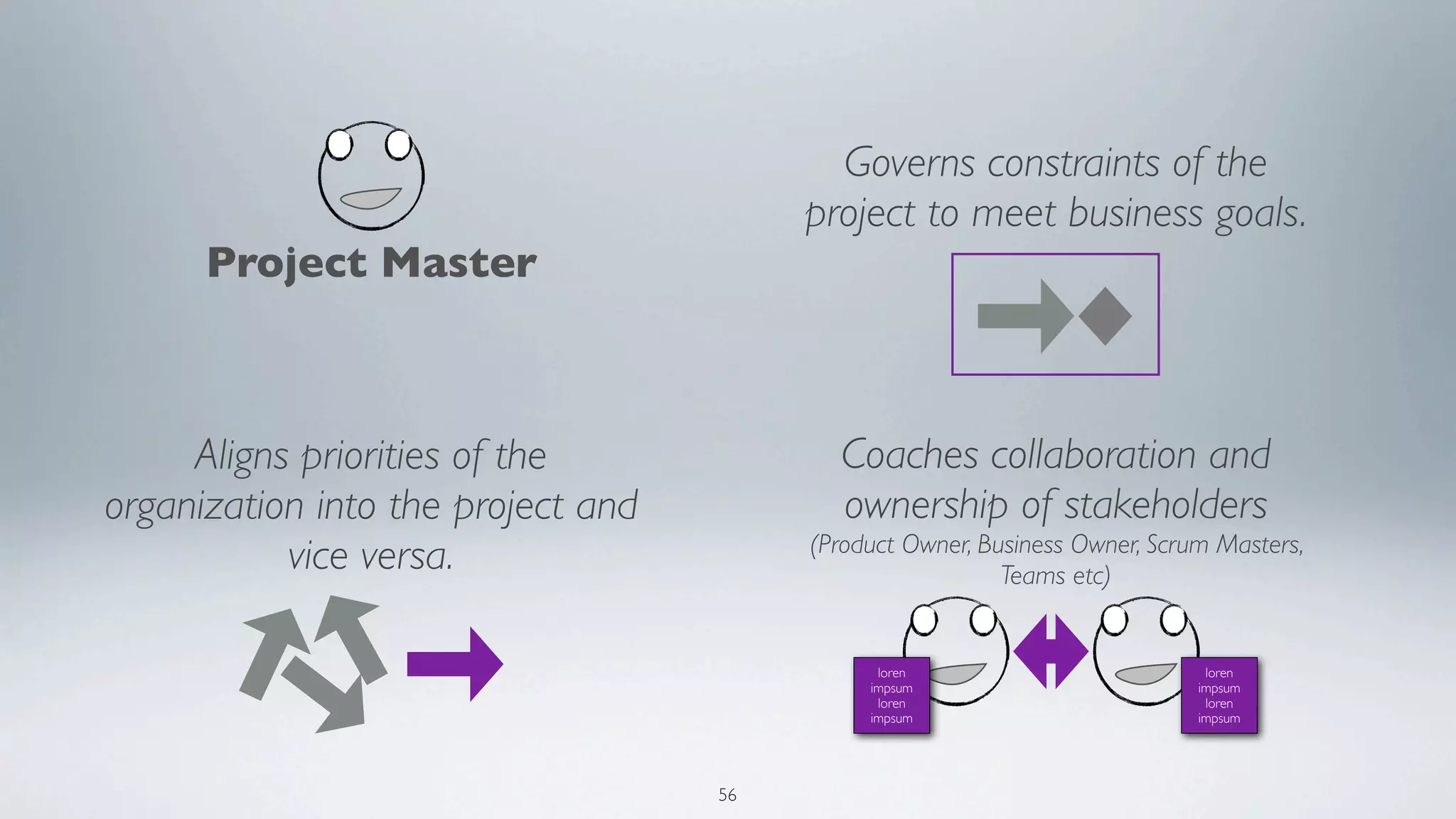

Governs constraints of the
                                         project to meet business goals.
      Project Master

     Aligns priorities of the              Coaches collaboration and
organization into the project and          ownership of stakeholders
                                         (Product Owner, Business Owner, Scrum Masters,
           vice versa.                                     Teams etc)

                                               loren                          loren
                                              impsum                         impsum
                                               loren                          loren
                                              impsum                         impsum

                                    56
CREATING AGILE TEAMS

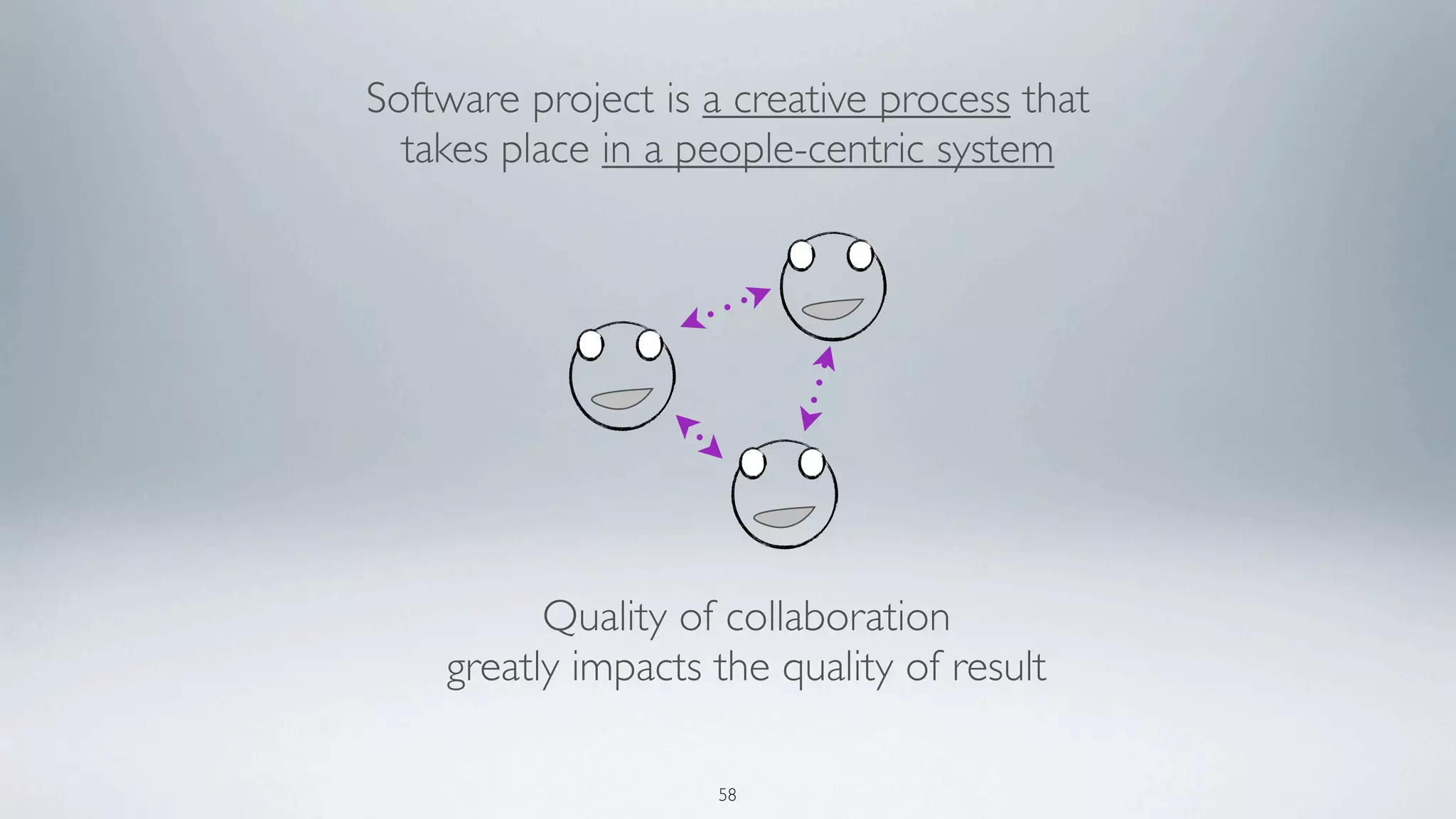

Software project is a creative process that
  takes place in a people-centric system

          Quality of collaboration
    greatly impacts the quality of result

                    58
Putting random people together and
               calling it “a team” is a management fallacy

   Also, individual                        ?
competences do not          ?                          Fundamentally,
  add up to team                                   teams build them selves.
  competence 1:1

                 As managers, we create the hot-bed
                     for great teams to emerge.

                                   59

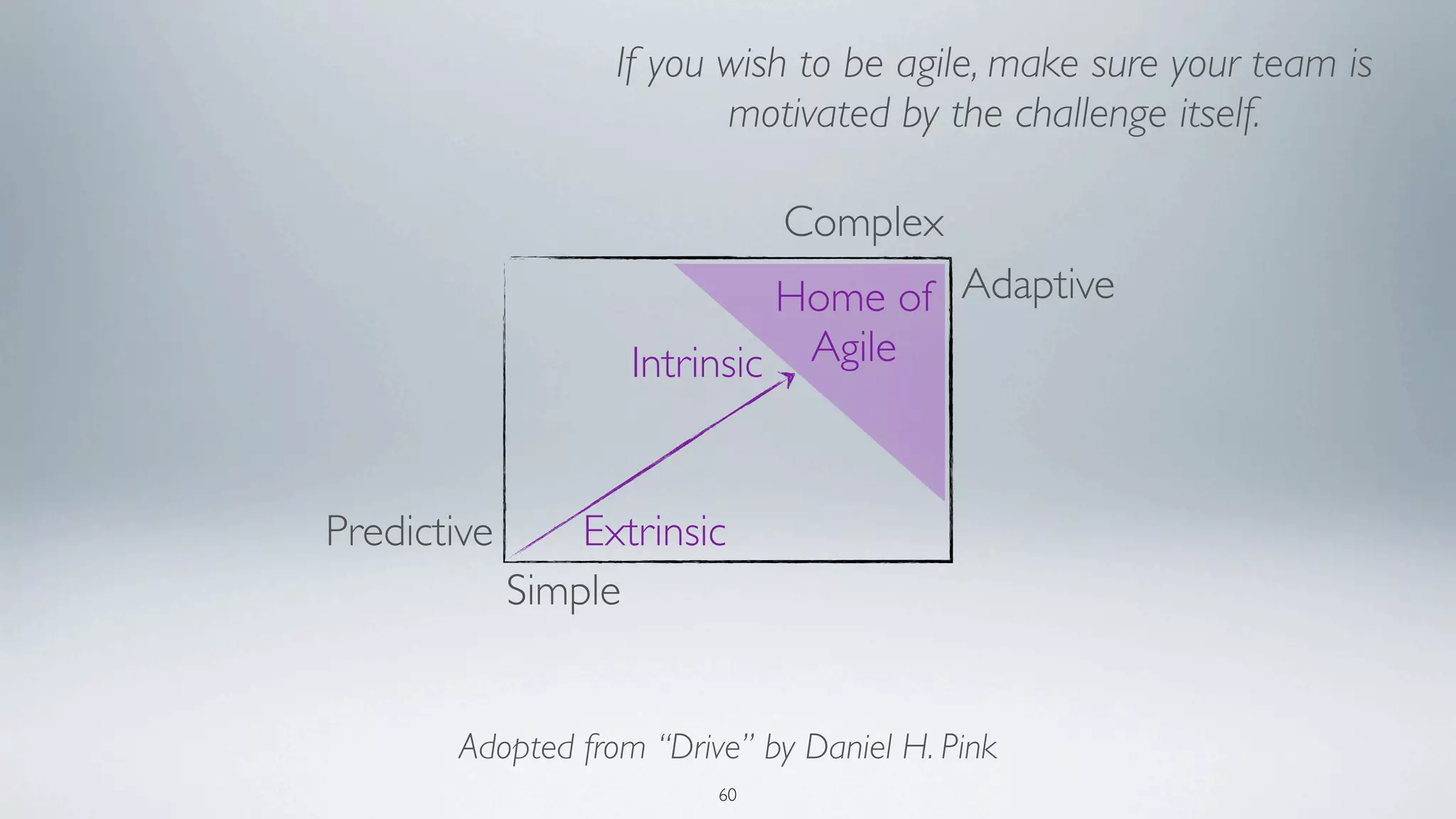

If you wish to be agile, make sure your team is
                          motivated by the challenge itself.

                              Complex
                              Home of Adaptive
                    Intrinsic  Agile

Predictive       Extrinsic
             Simple

       Adopted from “Drive” by Daniel H. Pink
                         60
Self-organizing is an agile principle in which the
 team finds the necessary tasks and processes
               to reach the goal.

            Boundaries (Constraints)

    Self-organizing
                                   Goal
          Team

However, for self-organizing to be effective, clear
 boundaries in a form of constraints are
         required to steer the efforts.
                        61
Self-organizing
                   Team

Autonomy        Mastery              Purpose
               Craftsmanship

    Adopted from “Drive” by Daniel H. Pink
                      62

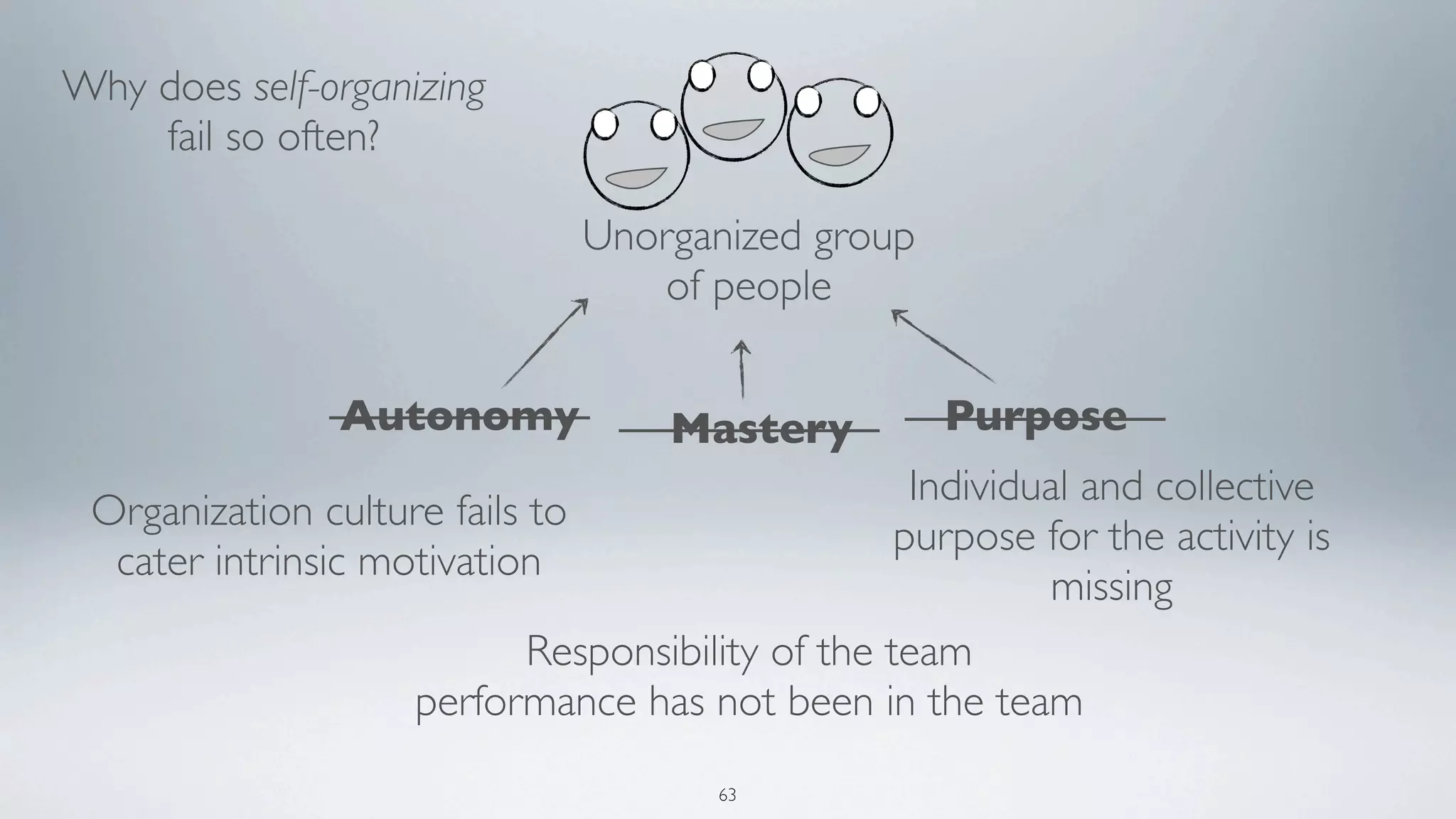

Why does self-organizing
    fail so often?

                               Unorganized group
                                  of people

                Autonomy            Mastery           Purpose
                                                    Individual and collective
 Organization culture fails to
                                                   purpose for the activity is
  cater intrinsic motivation
                                                            missing
                            Responsibility of the team
                    performance has not been in the team
                                       63

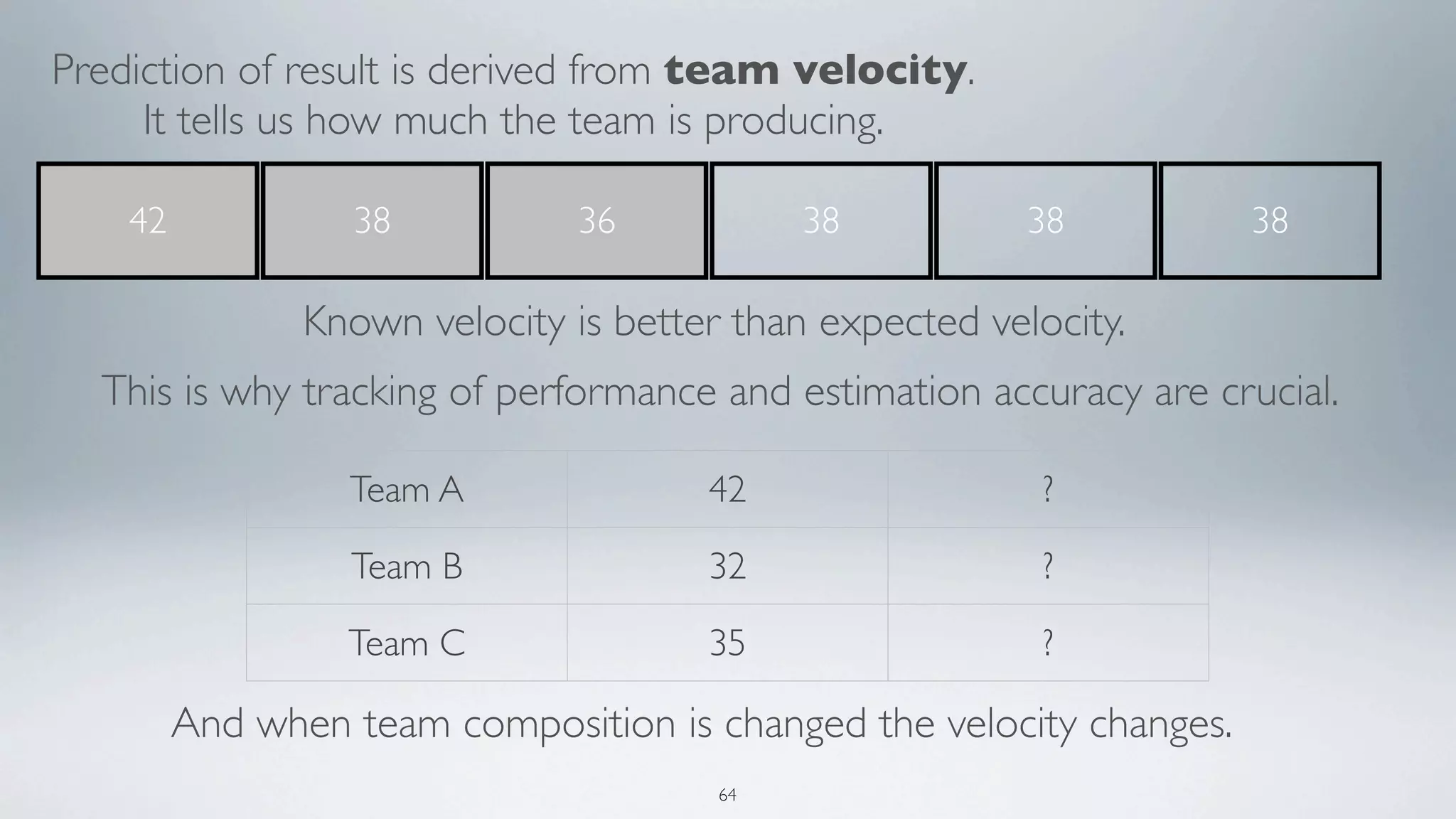

Prediction of result is derived from team velocity.
     It tells us how much the team is producing.

    42            38            36           38           38          38

                Known velocity is better than expected velocity.
  This is why tracking of performance and estimation accuracy are crucial.

                  Team A               42                  ?

                  Team B               32                  ?

                  Team C               35                  ?

         And when team composition is changed the velocity changes.
                                        64

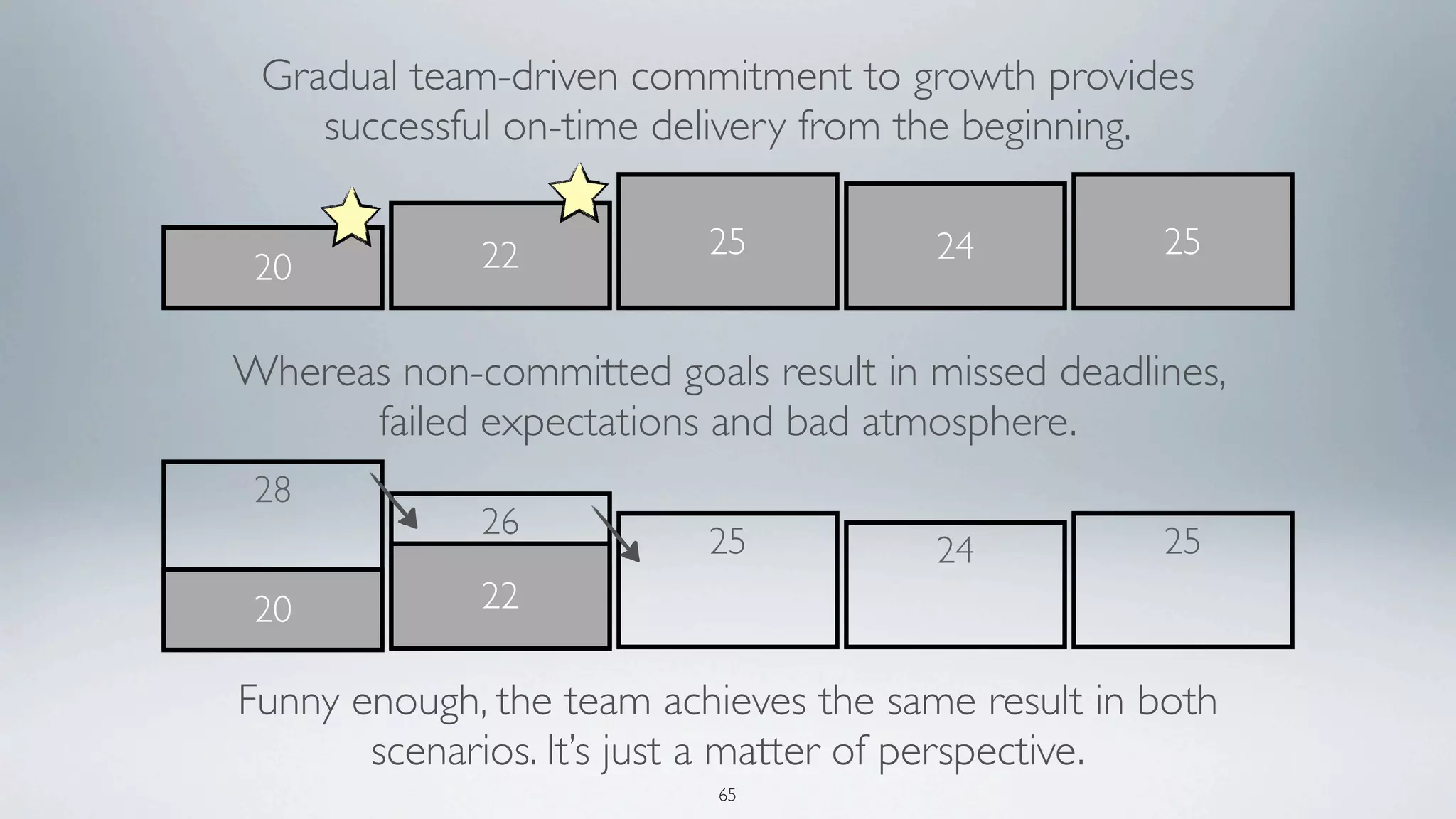

Gradual team-driven commitment to growth provides
    successful on-time delivery from the beginning.

             22           25           24          25
 20

Whereas non-committed goals result in missed deadlines,
      failed expectations and bad atmosphere.
 28
             26
                          25           24          25
 20          22

Funny enough, the team achieves the same result in both
       scenarios. It’s just a matter of perspective.
                          65
AGILE DEVELOPMENT PROCESSES
Product Owner

 Definition of Workable                           Definition of Done
Acceptance criteria that a backlog          Acceptance criteria that a backlog
 item must pass before it can be             item must pass before it can be
     worked on by the Team.                     delivered to Product Owner.

                                     Team
                                      67

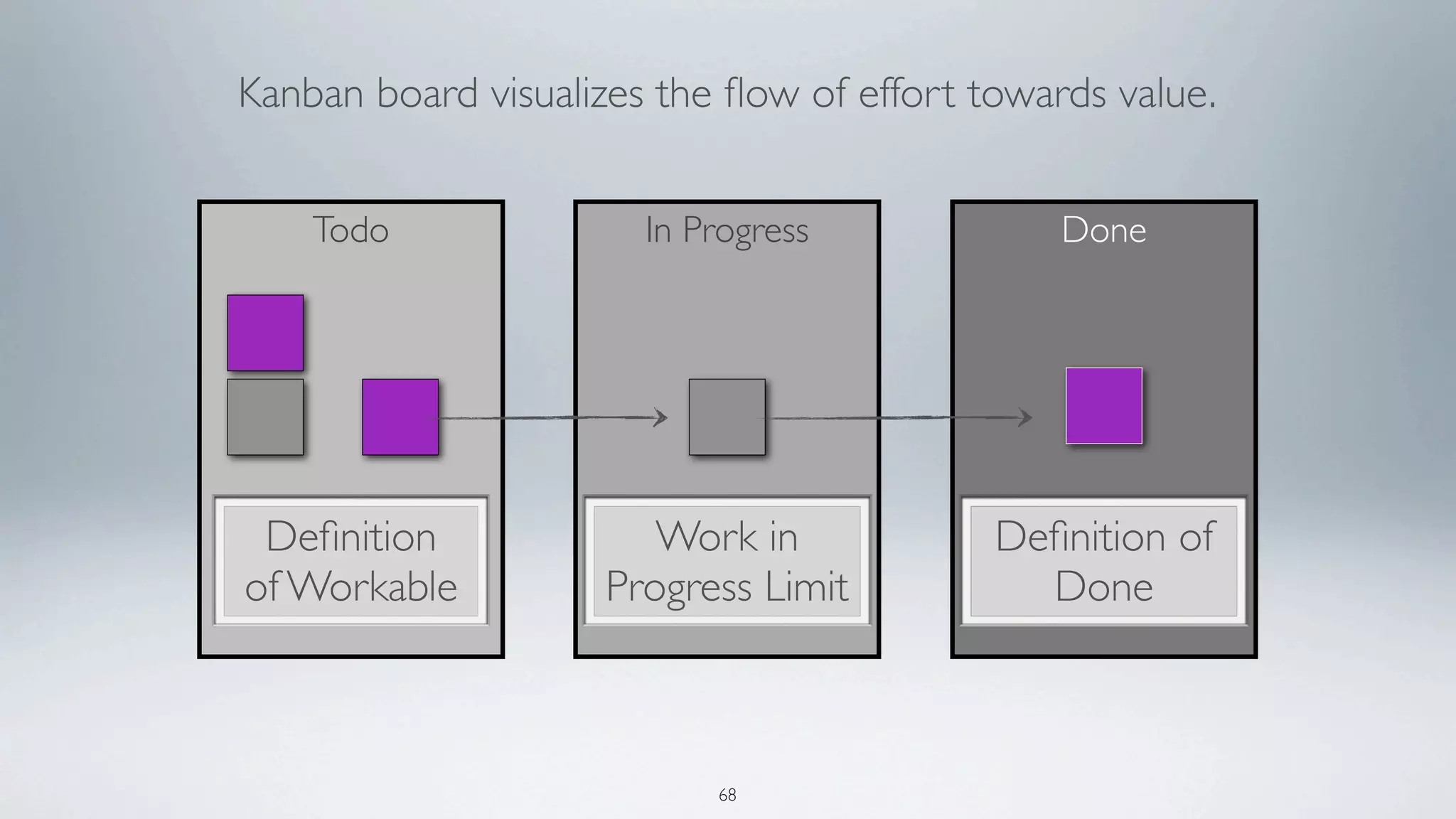

Kanban board visualizes the flow of effort towards value.

    Todo               In Progress             Done

 Definition              Work in            Definition of
of Workable          Progress Limit          Done

                           68
Work progress is monitored in a
     form of a burn-down chart

           Remaining effort

Start of Sprint               End of Sprint
                   69
Scrum of
                       Scrums
                     (2nd level)

     Scrum of
      Scrums
     (1st level)

Daily Scrum

              Team           Team    Team   Team   Team

                                    70

Between sprints, team shows demonstration of the product based
         on sprint results & performs a retrospective on working methods.

     Demo provides a             loren                        loren

  feedback loop allowing
                                impsum                       impsum
                                 loren                        loren
                                impsum                       impsum

   the product to grow
iteratively & incrementally.

                   Sprint 1                   Sprint 2

                                                               Retro provides a
                                                           feedback loop allowing
                     Team                      Team
                                                              the team to grow
                                                         iteratively & incrementally.
                                         71
SCALING AGILE

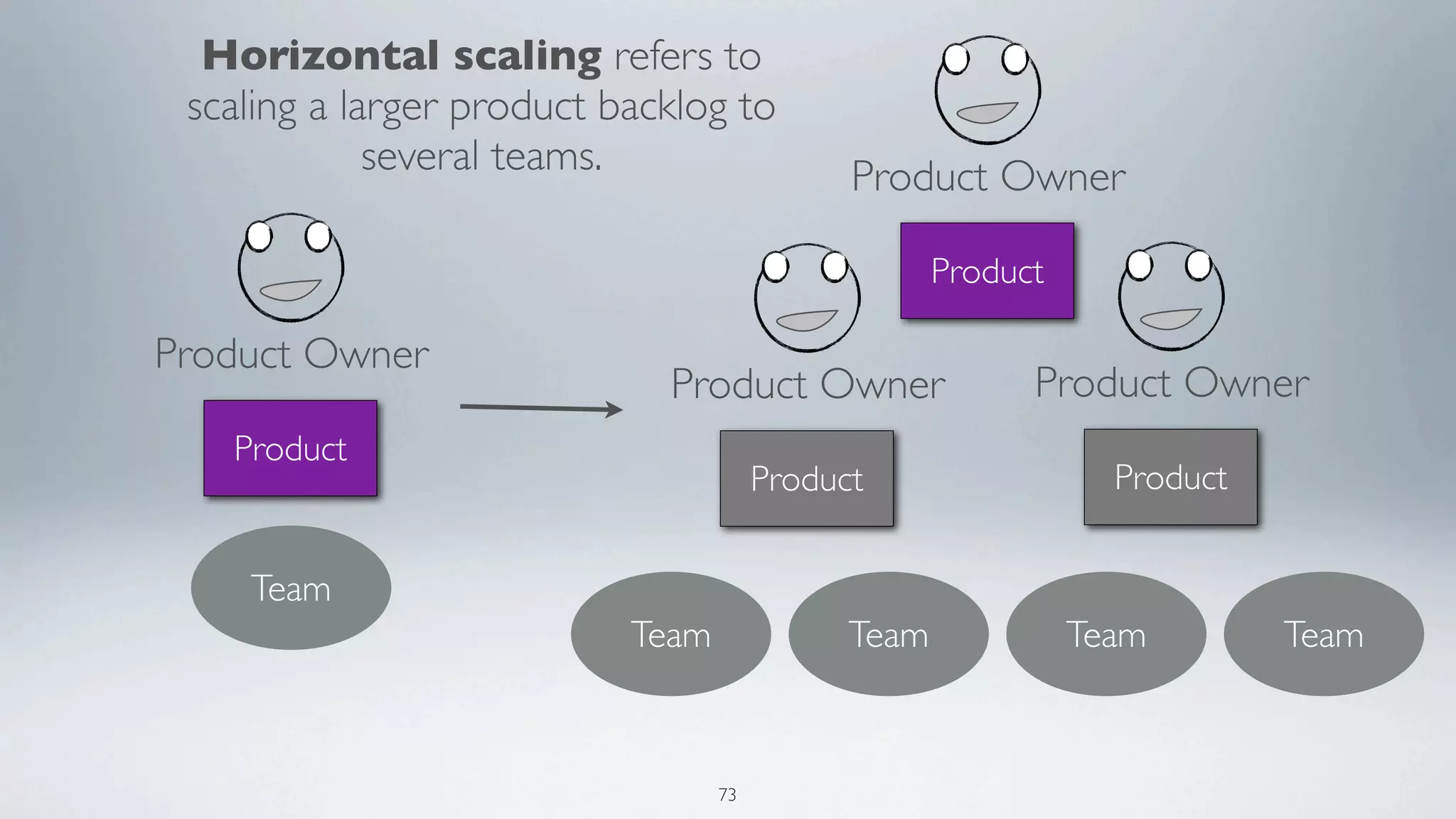

Horizontal scaling refers to
 scaling a larger product backlog to
             several teams.                  Product Owner

                                                    Product

Product Owner
                             Product Owner                Product Owner
   Product
                                       Product                  Product

    Team
                           Team              Team             Team        Team

                                  73

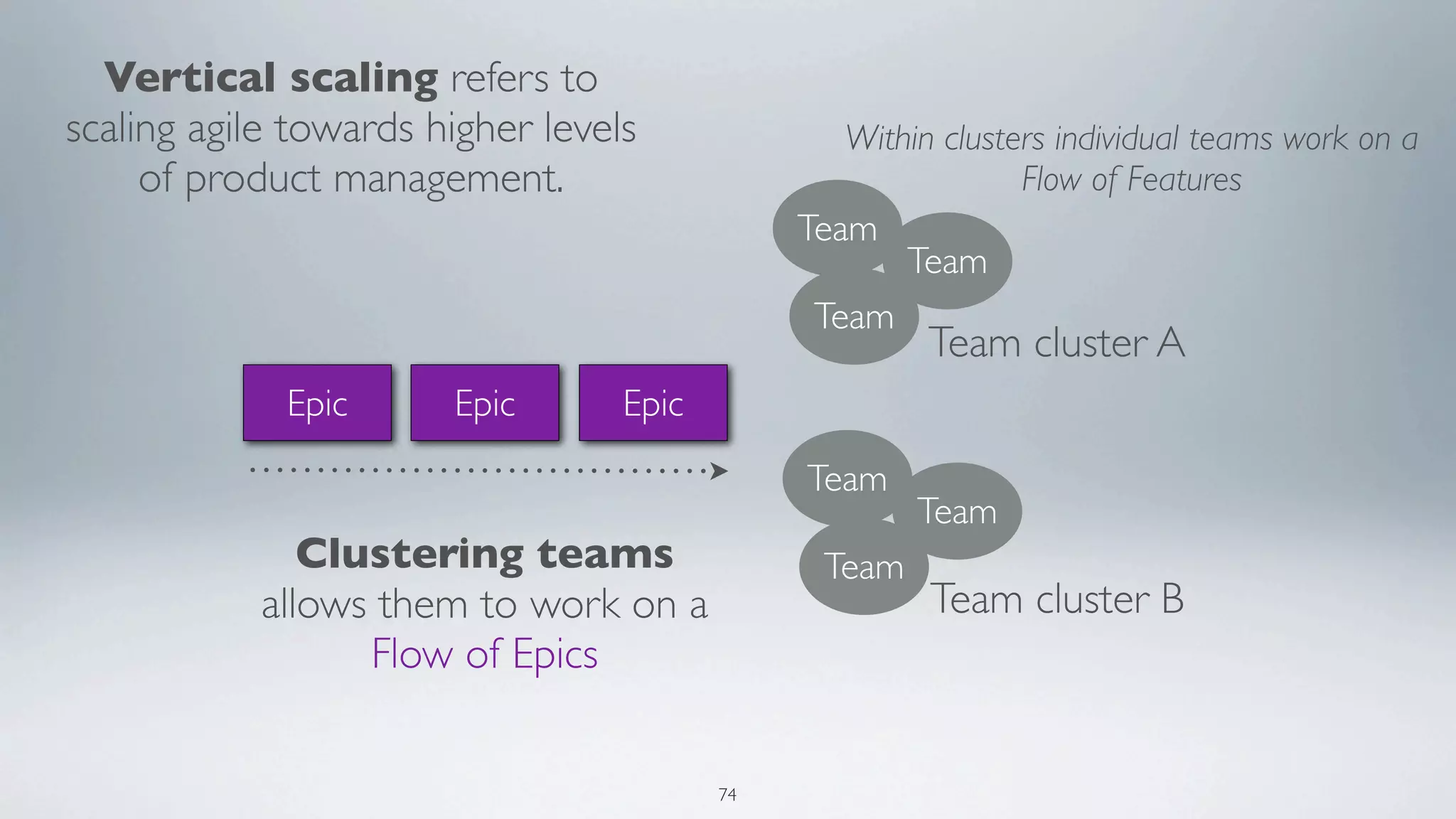

Vertical scaling refers to
scaling agile towards higher levels              Within clusters individual teams work on a
     of product management.                                   Flow of Features
                                              Team
                                                     Team
                                               Team
                                                       Team cluster A
             Epic      Epic       Epic
                                              Team
                                                      Team
              Clustering teams                 Team
           allows them to work on a                    Team cluster B
                 Flow of Epics

                                         74
One product = One Product Backlog
                        One product = Synchronized Cadence
    Team
                            Scrum Master is in the Team
                        Product Owners are close to Business

Scrum Master

               Product Owner(s)
                    Product                    Team
    Team            Backlog

Scrum Master                               Scrum Master
                        75
Hierarchical, Separated                                  Nonhierarchical, Separated
  Product
Architecture
   driven                      1

                   1.1                 1.2

               1.1.1   1.1.2       1.2.1   1.2.2               Feature
                                                              Specialists

                Hierarchical, Joint                                         Nonhierarchical, Joint
Top-level
 driven                                                 “Product Council”
                               1

                   1.1                 1.2

               1.1.1   1.1.2       1.2.1   1.2.2

                                                   76
QUALITY IN AGILE
Product owner is responsible of the product
                         - and its level of quality.
Product Owner
                  The expected level of quality is agreed
                between the product owner and the team.

                   Quality principles may be embedded to
    Team        backlog items in a form of acceptance criteria..

                 ..and by the team in their definition of done.

                        78

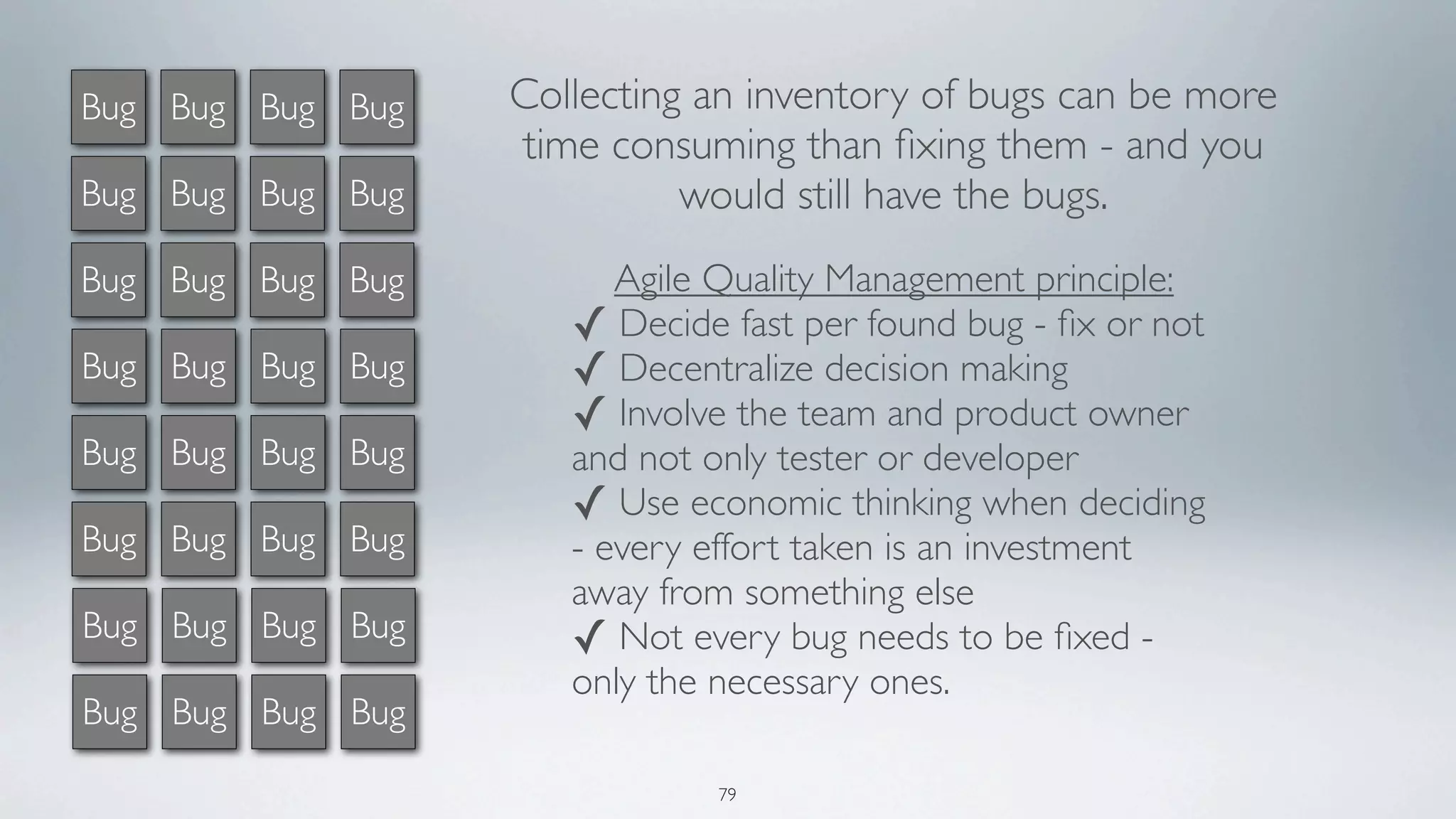

Bug Bug Bug Bug   Collecting an inventory of bugs can be more
                  time consuming than fixing them - and you
Bug Bug Bug Bug             would still have the bugs.
Bug Bug Bug Bug         Agile Quality Management principle:
                     ✓ Decide fast per found bug - fix or not
Bug Bug Bug Bug      ✓ Decentralize decision making
                     ✓ Involve the team and product owner
Bug Bug Bug Bug      and not only tester or developer
                     ✓ Use economic thinking when deciding
Bug Bug Bug Bug      - every effort taken is an investment
                     away from something else
Bug Bug Bug Bug      ✓ Not every bug needs to be fixed -
                     only the necessary ones.
Bug Bug Bug Bug

                              79

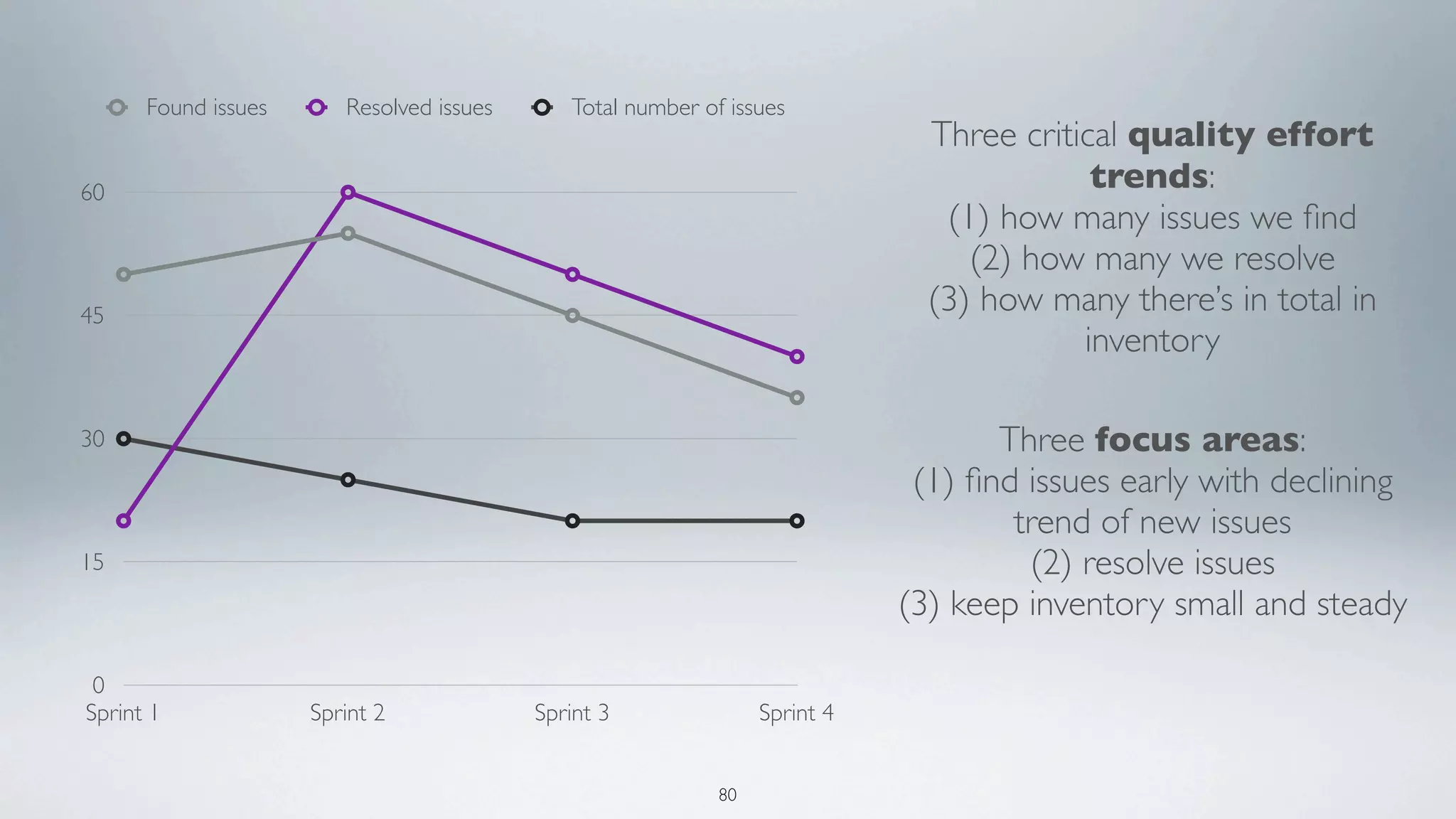

Found issues      Resolved issues      Total number of issues
                                                                              Three critical quality effort
60
                                                                                          trends:
                                                                               (1) how many issues we find
                                                                                 (2) how many we resolve
45
                                                                              (3) how many there’s in total in
                                                                                         inventory

30                                                                                 Three focus areas:
                                                                             (1) find issues early with declining
                                                                                    trend of new issues
15                                                                                   (2) resolve issues
                                                                            (3) keep inventory small and steady

 0
Sprint 1             Sprint 2             Sprint 3               Sprint 4

                                                            80
AGILE GOVERNANCE
   (COMING UP)
AGILE LEADERSHIP STYLE
     (COMING UP)
METRICS IN AGILE
 (COMING UP)
Arto Saari

LinkedIn:
http://fi.linkedin.com/pub/arto-saari/b/b03/546

Blog:
http://improvementstory.net

Twitter:
http://twitter.com/#!/ImprovStory

       84

Leading agile product development

  • 1.
    LEADING AGILE PRODUCT DEVELOPMENT By Arto Saari v. 1.0 beta5 It has been my sincere aim to respect all copyrights and reference the authors as appropriate. If however you feel I’ve not succeeded in some aspect of this, kindly contact me and allow to me correct my error. Thank you. Used by permission
  • 2.
    Foreword This is mytraining course targeted to project and product managers interested in Agile and Lean. It’s a collection of known best practices and personal methods and models that have all been utilized and proven in real-world product development challenges. My guidance to anyone participating the course or reading this material is to explore and find their own views of Agile and Lean best practices, possibly with the help of concepts presented herein. 2
  • 3.
  • 4.
    "Don't know whatI want, but I know how to get it." - Johnny Rotten, Sex Pistols http://www.agileproductdesign.com/blog/dont_know_what_i_want.html 4
  • 5.
    Agile Lean Fit iStock royalty-free photo iStock royalty-free photo Dealing with complexity iStock royalty-free photo Focusing on Value Re-innovating Value 5
  • 6.
    Agile is aboutunderstanding the problem and finding the right solution via exploration. Traditional Agile Presumed Problem Unknown Problem Understood Right Planned Solution Problem Solution Inspect-Adapt OODA PDCA 6
  • 7.
    When making thetransition, don’t get off the train at Ad-hoc station. X V Traditional Ad-hoc Agile Linearized Chaotic Complexity-aware Plan-driven Reactive Adaptive Disciplined and Specialized Undisciplined cross-functional Scope-constrained Unconstrained Time-constrained 7
  • 8.
    All organizational transformations,including agile, require a combined top-down & bottom-up approach. Top-down provides required alignment for the transition to happen on all dimensions of the Bottom-up creates the organization operative foundation for new product development principle. Agile capability grows bottom-up to the full potential limited only by the incompatible management principle of organization layers. 8
  • 9.
    Functions learn tocollaborate Effectiveness with development and take benefit of early and regular releases. Functions Development organization learns to exploit change and invest in continuous improvement. Development Organization Teams learn to plan and deliver Team in a steady cadence. Efficiency 9
  • 10.
    Customers, Partners Intimacy Focus on value Functions Collaboration Project / Project / Development Development Transparency Organization Organization Team Team Team Team Cadence 10
  • 11.
    An inwards-oriented An outwards-oriented organization focus is on control of organization focus is on customer activity and improvement of internal value and market opportunities. performance metrics. It is very possible that majority of the Unnecessary control is replaced by organization is supervising the trust. minority that creates the value. 11
  • 12.
    Management has acrucial role in Agile world but it requires to re-innovate itself. Value Creation Enablement Management Old orthodoxy Those who do not create value directly themselves enable the others to do so. 12
  • 13.
    Command & Control FAIL Motivation Skill Efficiency Focus Agile Leadership Style 13
  • 14.
    Traditionally organizations consider efficiency as ‘best-practices’ like .. Thinking good overall results come from functional excellence (locally optimizing organization) Efficiency comes from Interfacing between large batches stakeholders over non- collaborative documents Competing in the market Optimizing on cost and with exceeding commitments resource efficiency first(utilization etc). 14
  • 15.
    My definition ofbusiness/organization agility.. Problem scenario: market moves Agile scenario: product development faster than product development cycle as able to fit inside the market cycle Market cycle Market Cycle Product development Product development cycle Cycle Business Agility is the capability of your company to exploit shortening market cycles instead of being victimized by them uncontrollably. Read more about it here: http://improvementstory.net/2011/10/18/what-is-enterprise-agility-my-definitive-answer/ 15
  • 16.
  • 17.
    Whether your nextproject is a success or a failure is not a matter of change but the matter of choice (Mentioned by Bill Gaiennie as a quote by “Anonymous wise agile coach”) 17
  • 18.
    Traditional Development Project Agile Development Project The things we’re The whole big thing we Level 1: Vision identified to be done to have planned to do meet the success Task Task DL Level 2: Product backlog (Feature breakdown) Task Task Level 3: Release plan (Time breakdown) Time-box 1 Time-box 2 Level 4: Sprint plan Story (Work breakdown) Task 18
  • 19.
    Waterfall is everywhere.. ..in process models Phase 1 Phase 2 Phase 3 ..in structures ..in organization Requirement Function A Level 1 As waterfall is one- Requirement directional relationship, Function B lacking early and continuous Level 2 co-dependent validation. Requirement Function C Level 3 19
  • 20.
    The problem with waterfall is.. Risk is not reduced “Planning” Changeability is reduced over time Development Testing Visibility builds late Learning collected at the end 20
  • 21.
    Agile solves thisproblem by reducing batch size of how the software is developed Changeability much Visibility builds with less if at all reduced each batch “Planning” “Planning” “Planning” Development Development Development Testing Testing Testing Learning collected and used Risk reduced by every batch within the project 21
  • 22.
    Schedule and Resourcesact as constraints (control variables) to Scope. Resources Schedule Schedule controls the delay for expected value. Scope Value Cost of Delay Secondary focus how well Primary focus is on amount of scope translates to value value and the impact of delay Risk Scope is the source of both Risks associates to both value value and risk. expectation and cost of delay as increased uncertainty. 22
  • 23.
    We iterate toimprove We increment to get the solution based on the solution earlier and be learning and feedback. able to change plans. Feedback Learning Release 1 Release 2 Release 3 Release 4 23
  • 24.
    Planning Planning activity itself is iterative & incremental. Changes during development are Release 2 Release 3 Release X reflected in current and future release Development plans. Agile potential is unlocked with interaction between Release 1 Release 2 planning and Release 3 development. 24
  • 25.
    CONTINUOUSLY IMPROVING (BYELIMINATING WASTE)
  • 26.
    Waste As listed by Mary & Tom Poppendieck: Extra steps Information finding Handovers Task-switching Defects (not caught) Extra Features Waiting Photo by Crimson (Pieter Janssen), used by Creative Commons license on site www.dreamstime.com 26
  • 27.
    Wall of Waste Wall of Improvements Waste € Waste Improvement Improvement € Visualization and radiating both waste and improvements help the organization to collaborate on development. Quantification in monetary impact gives correct weight and priority. 27
  • 28.
  • 29.
    Variability and capacityutilization Manufacturing both impact the queue size: process Variability has linear impact Utilization has exponential impact Variability in (a) “service time” and (b) “arrival time” (a) Product Agile is all about absorbing Development and exploiting this variability (b) process for the benefit of the product. Adopted from Donald G. Reinertsen, The Principles of Product Development Flow 29
  • 30.
    Average Cycle time Wait-in- Wait-in- Wait-in- queue development release Product Development process Release Design inventory Feature inventory Adopted from Donald G. Reinertsen, The Principles of Product Development Flow 30
  • 31.
    Business value Release Feedback Product value Development Release Feedback effort Effort turns into value only when it is released. Value is understood only by feedback generated of a release. 31
  • 32.
    Traditional single-iteration, scope-constrained,large batch project.. A Long Development Project (Late) Value Realization Agile multi-iteration, time-constrained, small batch project.. Release 1 (Early) Value Realization Release 2 (Added) Value Realization Release 3 (Optional) Value Realization Staged delivery realizes value earlier, reduces risk and increases control and agility on all levels. 32
  • 33.
  • 34.
    Leffingwell’s product abstractiondefined three abstraction levels: Epics, Features and Stories Each level as co-dependent relationship i.e. one cannot exist without the other Following is my personal adaptation of the structure: Epics are the value-context of development: Epic they are what we want to achieve. Features provide the solution to Epic and are beyond Feature optimal solution a cost-factor. Features we need to do. Stories extend the feature solution and provide link to Story stakeholder value (users, providers etc). 34
  • 35.
    Optimization towards (Epic)value context provides maximum product development potential. Epic (=business value) € Features (=investment to gain business value) € Value efficiency = Maximized epic value delivered with optimal feature cost. 35
  • 36.
    Prioritization of Epicsand Features can be done in a matrix in which vertical prioritization is based on Epic value and horizontal on feature priority. More important towards the Epic Epic 1 F F F F F F Epic 2 F F F F F F More value per Epic Epic 3 F F F F F F Epic 4 F F F F F F Two queues can be formed out of the matrix: Epic queue and internal Feature queue. 36
  • 37.
    F Features in top-left are most valuable More important towards the Epic Epic 1 F F F F F F Epic 2 F F F F F F More value per Epic Epic 3 F F F F F F Epic 4 F F F F F F While features in the bottom-right will not F be likely ever done 37
  • 38.
    Optimized product plan Unoptimized product plan Epic 1 F F Epic 1 F F F F F F Epic 2 F F Epic 2 F F F F F F Epic 3 F F In unoptimized plan, epics (value) Epic 4 F F is produced in large, slow batches of unnecessary features (waste) In optimized plan, epics are delivered via a core set of features and released in a quick cadence. 38
  • 39.
    Level 1: Unorganizedbacklog Level 2: Prioritized backlog Top-priority Level 3: Groomed backlog loren loren impsum impsum loren loren impsum impsum loren loren loren impsum impsum impsum loren loren loren impsum impsum impsum loren impsum loren impsum 39
  • 40.
    Backlog prioritization isan on-going Prioritization model should be both process on all backlog levels, simple and meaningful peaking at the start of a cycle. Must-have Must-have’s we don’t release without. Should-have’s we aim to Should-have Should-have maximize per delivery. Could-have’s are valuable Could-have Could-have Could-have candidates or “extra”. Won’t-have’s we’ve Won’t have decided to left out. 40
  • 41.
  • 42.
    We don’t wantoverly complicated and costly solutions compared to the size of the problem. Problem Problem Solution Solution But instead innovative and effective solutions that solve a more valuable problem. 42
  • 43.
    Problem Product structure can be viewed as a chain of Problem-Solution pairs. Solution Epic Each of the abstraction layers Problem contains both a solution to upper layer and poses a problem requiring a Solution solution on lower layer. Feature Problem On top-level there is a business Solution problem that is being addressed with Story Problem production solution. Further down the chain problems and solutions become Solution more technical reaching lowest interest point, tasks a solution. 43
  • 44.
    Solution needs tobe defined in full to match the problem Part of Part of Part of Solution Solution Solution before it may be optimized reductively. Part of Part of Part of Solution Solution Solution New composition of the solution requires it to be Part of Part of Part of checked for integrity as it was Solution Solution Solution a completely new solution. 44
  • 45.
    Sensitivity analysis onchanging problem and solution definition may reveal better opportunities. Bigger Original Original Problem Problem Problem Value : Cost Ratio Smaller Solution Original Slightly Bigger Solution Solution 45
  • 46.
    time PDCA-cycle Original Better Problem-Solution Problem Defined Correct definition evolves over Problem Problem time and requires full recheck periodically (preferably between Optimal sprints) to validate the Improved Original Solution optimal solution to Solution Solution correct problem. CHECK CHECK CHECK 46
  • 47.
  • 48.
    The highest levelof the backlog in the Product Backlog Time and release oriented level of backlog is know as Release Backlog Within a release the delivery plan is known as the Sprint Plan (or Sprint Backlog) 48
  • 49.
    Visual planning helpsto identify the constraints and their impact over the expected result. The strongest constraint is time, second resources, as combination Resources Over Time. Prioritized, ordered flow of features FEATURE FEATURE FEATURE FEATURE FEATURE .... R R R R R R R R R Resource constraint to next release Reserve Risk of uncertainty and ability to do incremental change can be achieved by holding some of the R R R R resources in reserve. 49
  • 50.
    Epics can beused to model value offering to customers which each require certain Features realized in a set of Solutions. F F Solution Epic 1 Value Offering Customers F F Solution Epic 2 50
  • 51.
    V1 V2 V1 Total value: 4 Epic 1 C2 C5 C3 Total High-level road-mapping using Epics complexity: 10 can be done by identifying simple Features value and complexity points to give them comparability and character. V2 V3 Total value: 5 Complexity is elaborated into Epic 2 features at later stages of planning. C1 C2 C2 Total complexity: 5 Features 51
  • 52.
    AGILE ROLES &OWNERSHIP
  • 53.
    Transfers the product vision Team Product Owner Grooms backlog Plans releases loren loren impsum impsum loren loren impsum impsum Release 1 loren loren loren impsum impsum impsum loren loren loren impsum impsum impsum loren impsum Sprint 1 Sprint 2 Sprint 3 loren impsum 53
  • 54.
    Upholds Scrum Process Sprints Demos Scrum Master Retrospective Daily-standup Promotes Agile Culture Protects the Team Team 54
  • 55.
    Seeks to maximizethe product value Team loren impsum loren impsum loren impsum loren loren impsum impsum loren impsum Continuously analyzes and Self-organizes the tasks to improves the working practices meet Sprint goals Team Team 55
  • 56.
    Governs constraints ofthe project to meet business goals. Project Master Aligns priorities of the Coaches collaboration and organization into the project and ownership of stakeholders (Product Owner, Business Owner, Scrum Masters, vice versa. Teams etc) loren loren impsum impsum loren loren impsum impsum 56
  • 57.
  • 58.
    Software project isa creative process that takes place in a people-centric system Quality of collaboration greatly impacts the quality of result 58
  • 59.
    Putting random peopletogether and calling it “a team” is a management fallacy Also, individual ? competences do not ? Fundamentally, add up to team teams build them selves. competence 1:1 As managers, we create the hot-bed for great teams to emerge. 59
  • 60.
    If you wishto be agile, make sure your team is motivated by the challenge itself. Complex Home of Adaptive Intrinsic Agile Predictive Extrinsic Simple Adopted from “Drive” by Daniel H. Pink 60
  • 61.
    Self-organizing is anagile principle in which the team finds the necessary tasks and processes to reach the goal. Boundaries (Constraints) Self-organizing Goal Team However, for self-organizing to be effective, clear boundaries in a form of constraints are required to steer the efforts. 61
  • 62.
    Self-organizing Team Autonomy Mastery Purpose Craftsmanship Adopted from “Drive” by Daniel H. Pink 62
  • 63.
    Why does self-organizing fail so often? Unorganized group of people Autonomy Mastery Purpose Individual and collective Organization culture fails to purpose for the activity is cater intrinsic motivation missing Responsibility of the team performance has not been in the team 63
  • 64.
    Prediction of resultis derived from team velocity. It tells us how much the team is producing. 42 38 36 38 38 38 Known velocity is better than expected velocity. This is why tracking of performance and estimation accuracy are crucial. Team A 42 ? Team B 32 ? Team C 35 ? And when team composition is changed the velocity changes. 64
  • 65.
    Gradual team-driven commitmentto growth provides successful on-time delivery from the beginning. 22 25 24 25 20 Whereas non-committed goals result in missed deadlines, failed expectations and bad atmosphere. 28 26 25 24 25 20 22 Funny enough, the team achieves the same result in both scenarios. It’s just a matter of perspective. 65
  • 66.
  • 67.
    Product Owner Definitionof Workable Definition of Done Acceptance criteria that a backlog Acceptance criteria that a backlog item must pass before it can be item must pass before it can be worked on by the Team. delivered to Product Owner. Team 67
  • 68.
    Kanban board visualizesthe flow of effort towards value. Todo In Progress Done Definition Work in Definition of of Workable Progress Limit Done 68
  • 69.
    Work progress ismonitored in a form of a burn-down chart Remaining effort Start of Sprint End of Sprint 69
  • 70.
    Scrum of Scrums (2nd level) Scrum of Scrums (1st level) Daily Scrum Team Team Team Team Team 70
  • 71.
    Between sprints, teamshows demonstration of the product based on sprint results & performs a retrospective on working methods. Demo provides a loren loren feedback loop allowing impsum impsum loren loren impsum impsum the product to grow iteratively & incrementally. Sprint 1 Sprint 2 Retro provides a feedback loop allowing Team Team the team to grow iteratively & incrementally. 71
  • 72.
  • 73.
    Horizontal scaling refersto scaling a larger product backlog to several teams. Product Owner Product Product Owner Product Owner Product Owner Product Product Product Team Team Team Team Team 73
  • 74.
    Vertical scaling refersto scaling agile towards higher levels Within clusters individual teams work on a of product management. Flow of Features Team Team Team Team cluster A Epic Epic Epic Team Team Clustering teams Team allows them to work on a Team cluster B Flow of Epics 74
  • 75.
    One product =One Product Backlog One product = Synchronized Cadence Team Scrum Master is in the Team Product Owners are close to Business Scrum Master Product Owner(s) Product Team Team Backlog Scrum Master Scrum Master 75
  • 76.
    Hierarchical, Separated Nonhierarchical, Separated Product Architecture driven 1 1.1 1.2 1.1.1 1.1.2 1.2.1 1.2.2 Feature Specialists Hierarchical, Joint Nonhierarchical, Joint Top-level driven “Product Council” 1 1.1 1.2 1.1.1 1.1.2 1.2.1 1.2.2 76
  • 77.
  • 78.
    Product owner isresponsible of the product - and its level of quality. Product Owner The expected level of quality is agreed between the product owner and the team. Quality principles may be embedded to Team backlog items in a form of acceptance criteria.. ..and by the team in their definition of done. 78
  • 79.
    Bug Bug BugBug Collecting an inventory of bugs can be more time consuming than fixing them - and you Bug Bug Bug Bug would still have the bugs. Bug Bug Bug Bug Agile Quality Management principle: ✓ Decide fast per found bug - fix or not Bug Bug Bug Bug ✓ Decentralize decision making ✓ Involve the team and product owner Bug Bug Bug Bug and not only tester or developer ✓ Use economic thinking when deciding Bug Bug Bug Bug - every effort taken is an investment away from something else Bug Bug Bug Bug ✓ Not every bug needs to be fixed - only the necessary ones. Bug Bug Bug Bug 79
  • 80.
    Found issues Resolved issues Total number of issues Three critical quality effort 60 trends: (1) how many issues we find (2) how many we resolve 45 (3) how many there’s in total in inventory 30 Three focus areas: (1) find issues early with declining trend of new issues 15 (2) resolve issues (3) keep inventory small and steady 0 Sprint 1 Sprint 2 Sprint 3 Sprint 4 80
  • 81.
    AGILE GOVERNANCE (COMING UP)
  • 82.
  • 83.
    METRICS IN AGILE (COMING UP)
  • 84.
