Agile Development:
    Product Delivery for Successful Organizations
     Marc Crudgington

© Copyright Pacific Technology Consulting Group, LLC
Interactive Agenda:
Pick a Topic

   Framework vs. Process        Agile Types          Scrum
                               Estimating/Planning
               Buzzwords
 Resources                   Agile                 Iterative or
                           Principles               Predictive

     Adopting Agile               Build Delivery

                                              Impediments
                      Agile Success
      Evolution
                                              Tools

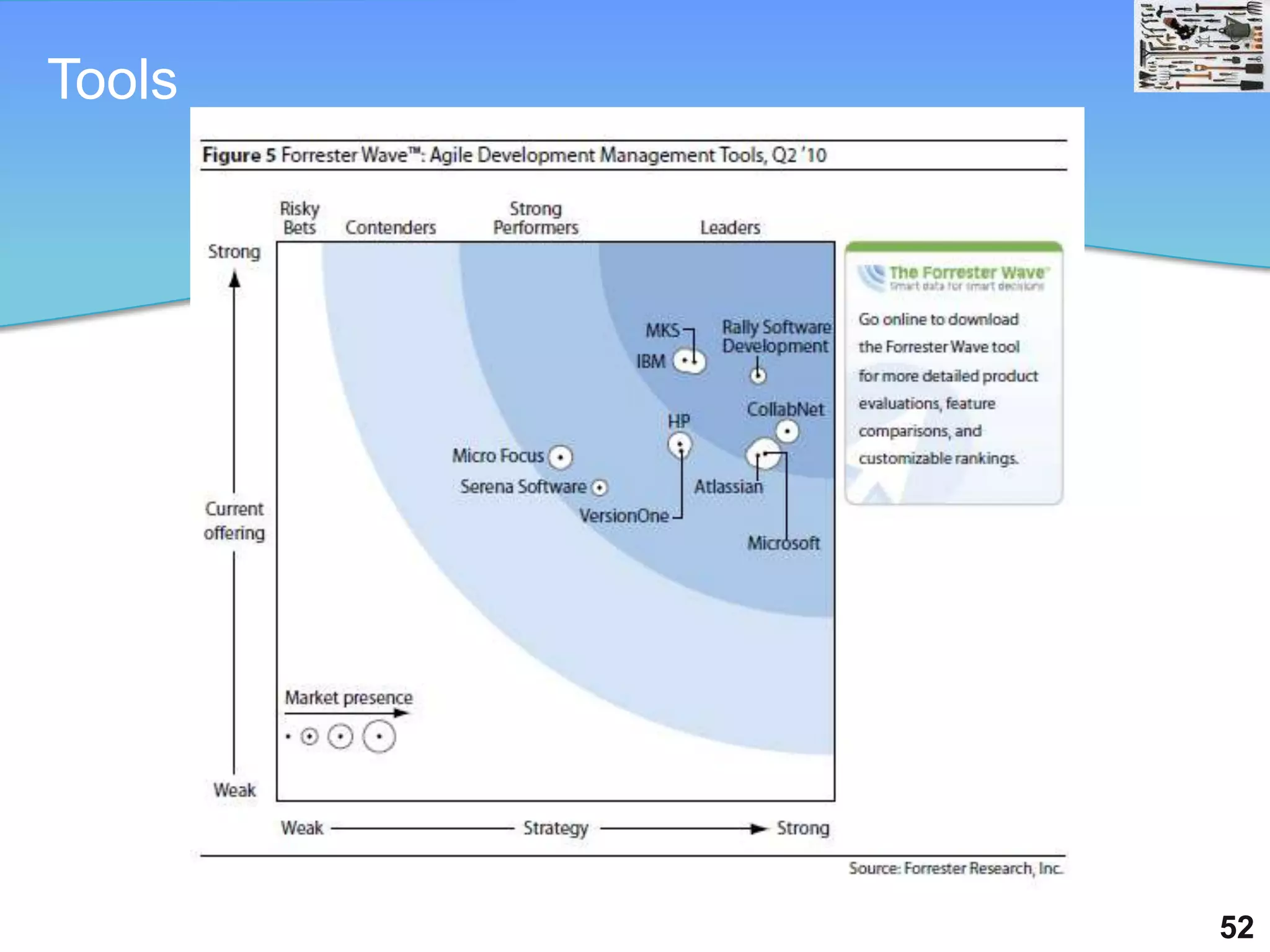

                                                                  2
3

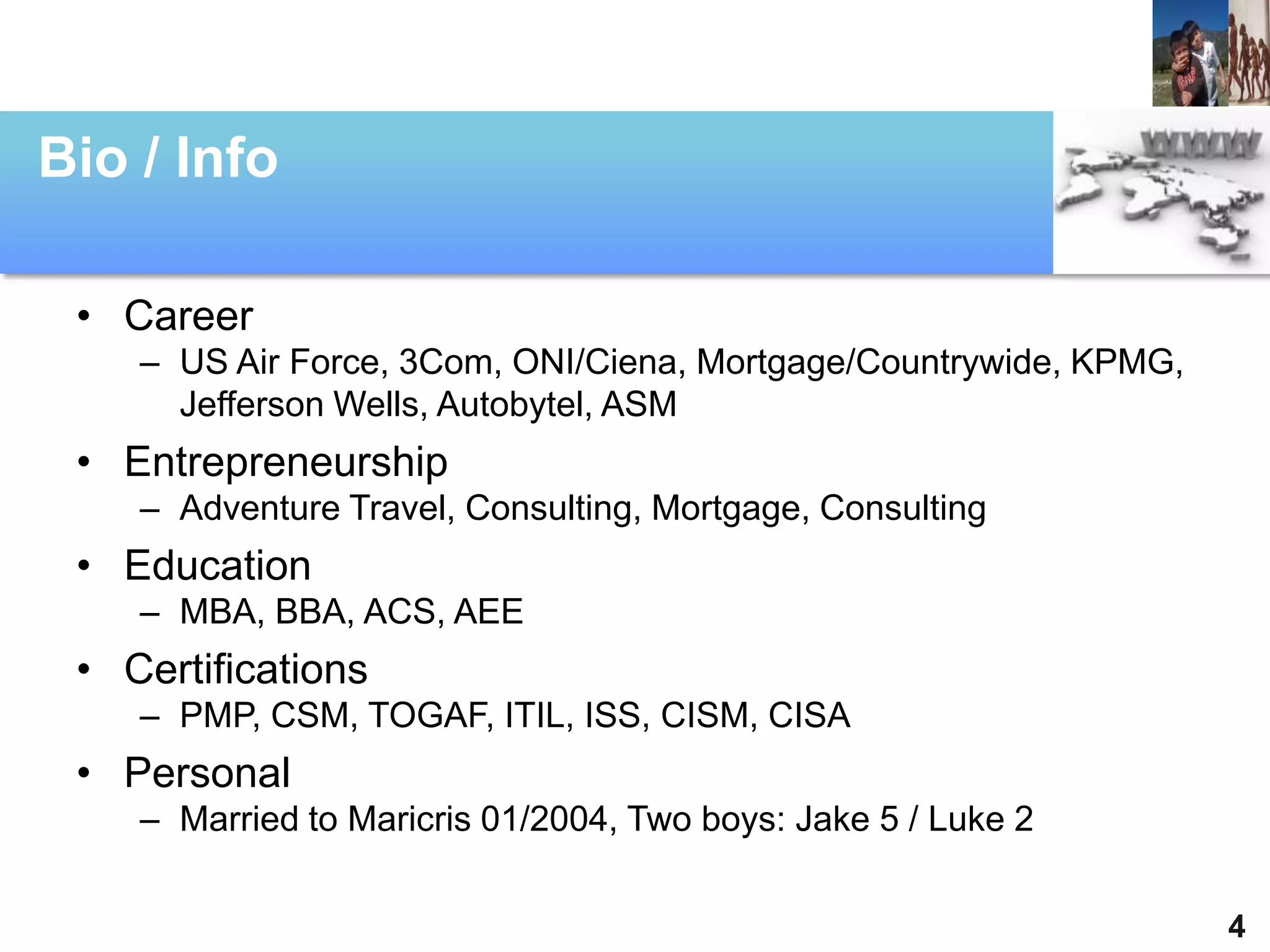

Bio / Info

 • Career
    – US Air Force, 3Com, ONI/Ciena, Mortgage/Countrywide, KPMG,
      Jefferson Wells, Autobytel, ASM
 • Entrepreneurship
    – Adventure Travel, Consulting, Mortgage, Consulting
 • Education
    – MBA, BBA, ACS, AEE
 • Certifications
    – PMP, CSM, TOGAF, ITIL, ISS, CISM, CISA
 • Personal
    – Married to Maricris 01/2004, Two boys: Jake 5 / Luke 2

                                                                   4

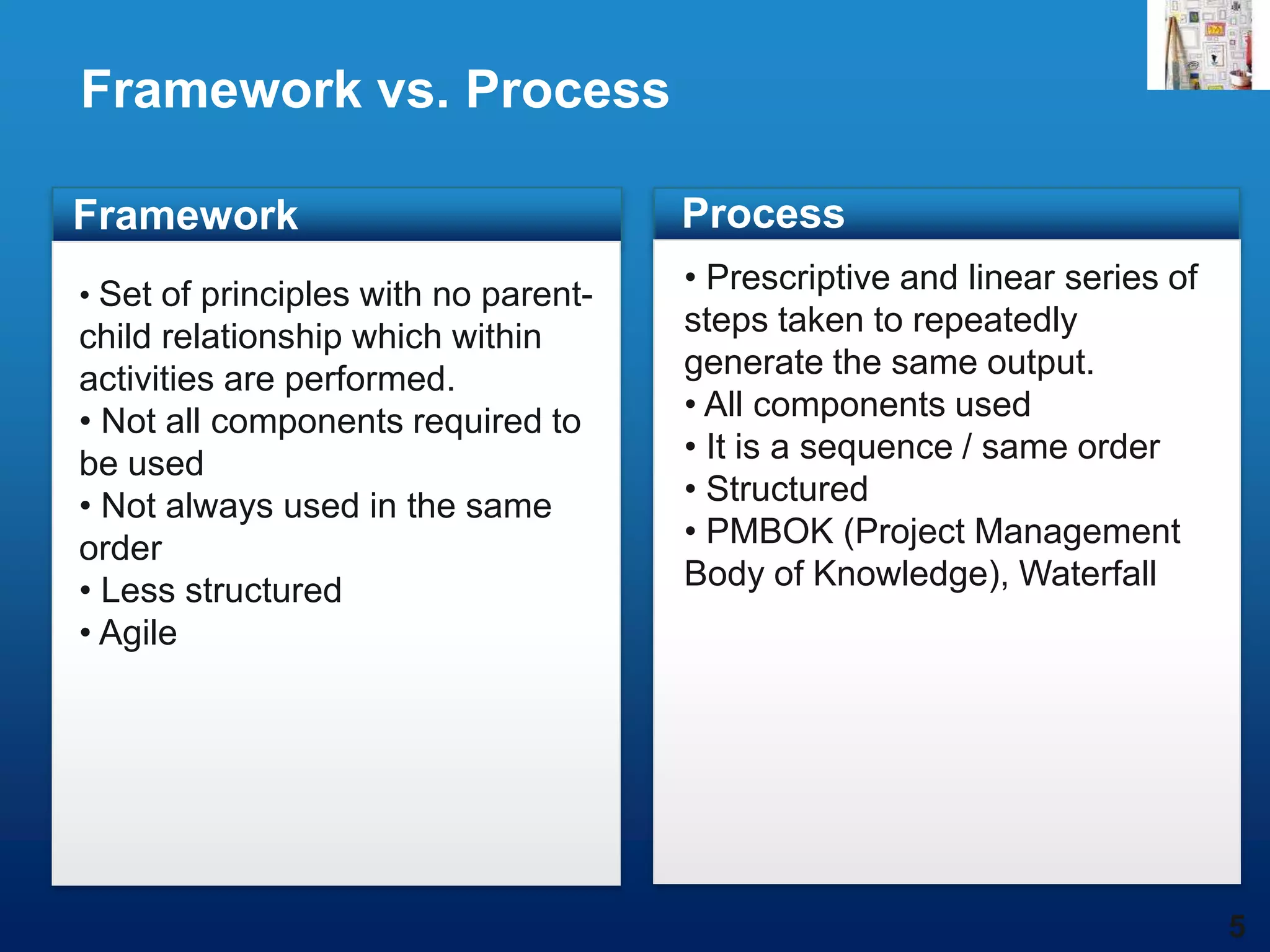

Framework vs. Process

Framework                             Process
• Set of principles with no parent-
                                      • Prescriptive and linear series of
child relationship which within       steps taken to repeatedly
activities are performed.             generate the same output.
• Not all components required to      • All components used
be used                               • It is a sequence / same order
• Not always used in the same         • Structured
order                                 • PMBOK (Project Management
• Less structured                     Body of Knowledge), Waterfall
• Agile

                                                                            5

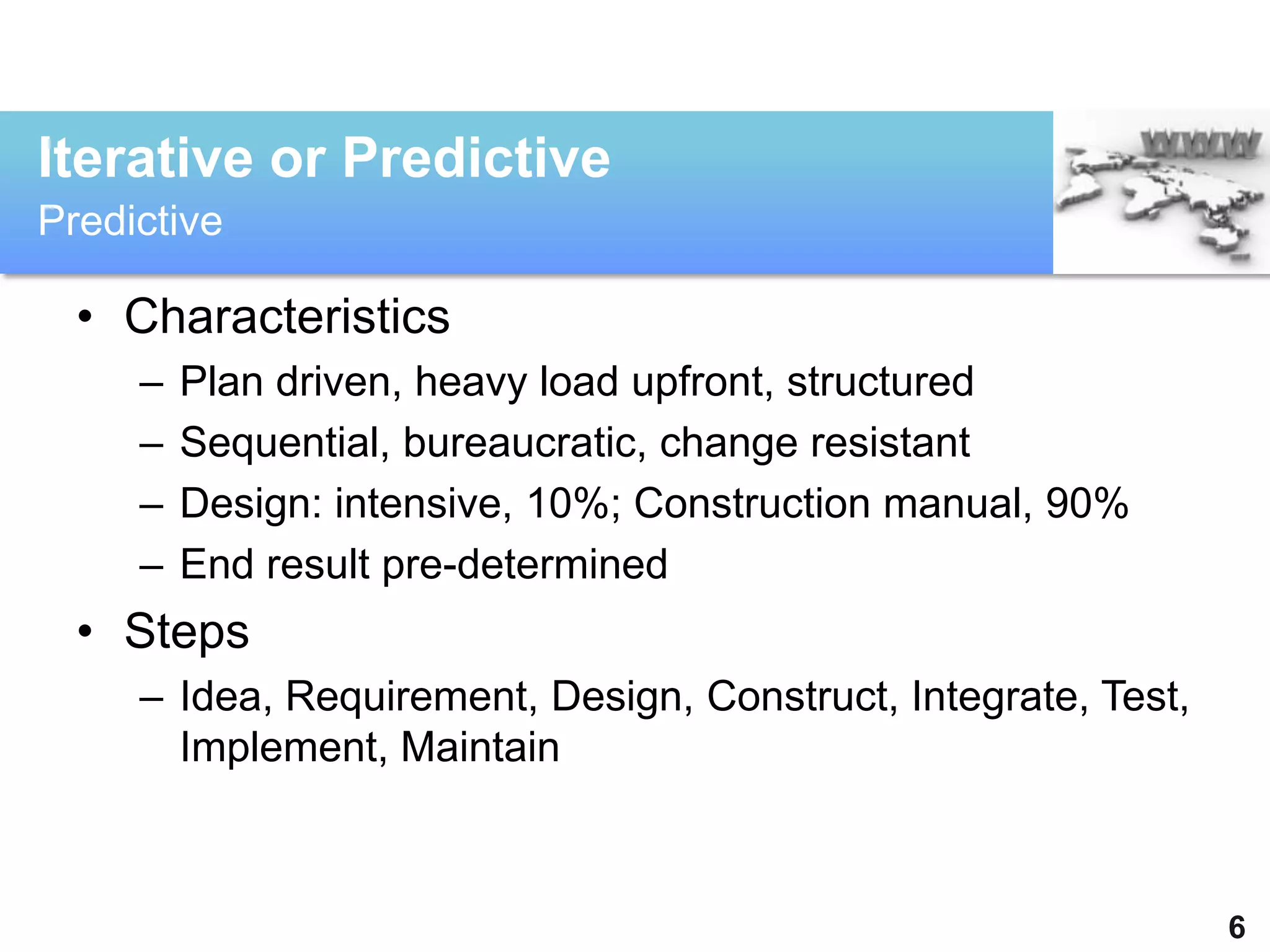

Iterative or Predictive
Predictive

  • Characteristics
     –   Plan driven, heavy load upfront, structured
     –   Sequential, bureaucratic, change resistant
     –   Design: intensive, 10%; Construction manual, 90%
     –   End result pre-determined
  • Steps
     – Idea, Requirement, Design, Construct, Integrate, Test,
       Implement, Maintain

                                                                6
Iterative or Predictive
Predictive

 • Use when
    –   Project familiar
    –   Inexperienced developers
    –   Project team is large and project is complex
    –   Thoroughly documented, demands order
    –   Predictability versus change, requirements stable
 • IMO
    – Civil engineering, Construction
    – Maybe government, government contractors, pharma?

                                                            7

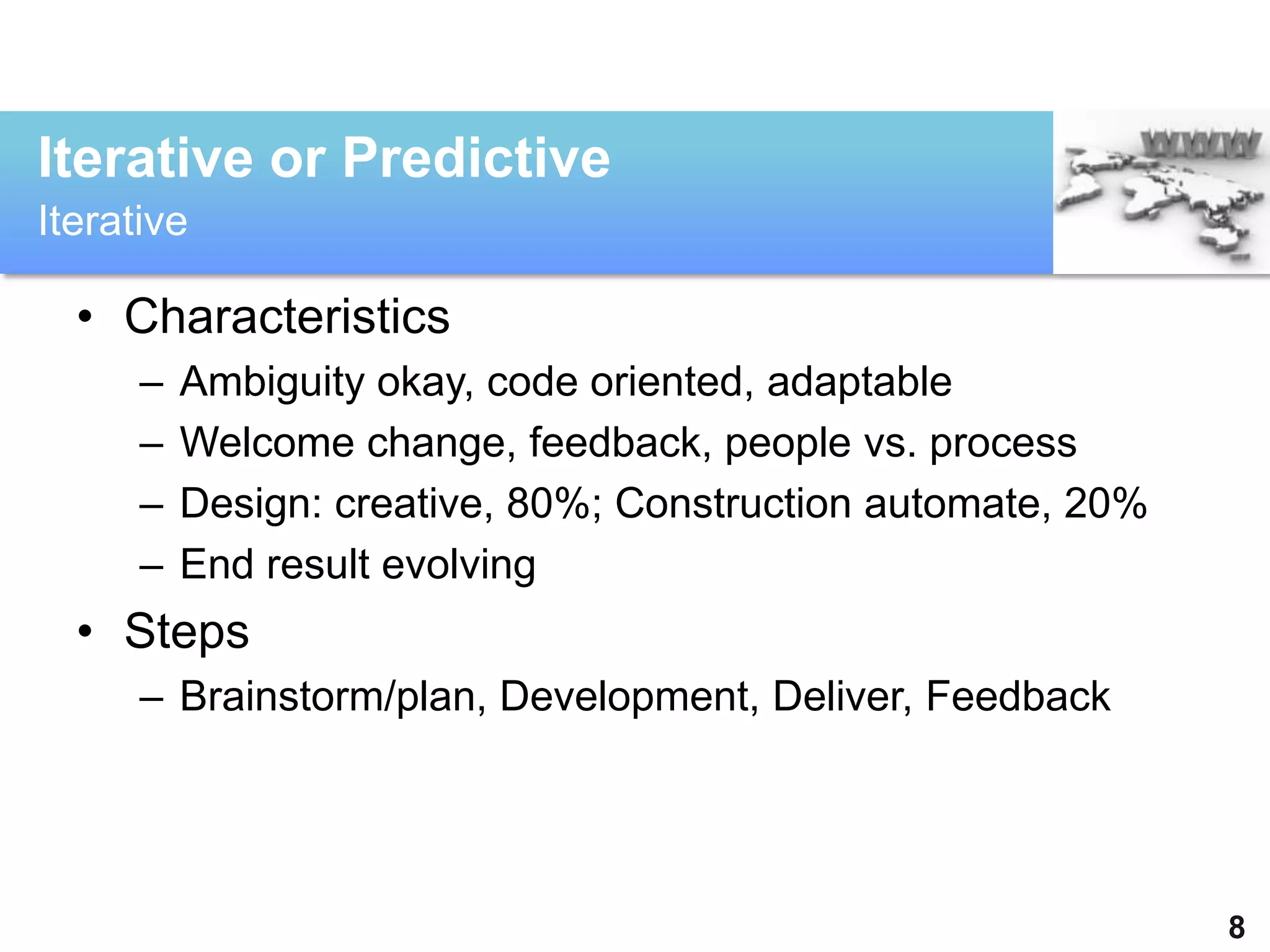

Iterative or Predictive
Iterative

  • Characteristics
      –   Ambiguity okay, code oriented, adaptable
      –   Welcome change, feedback, people vs. process
      –   Design: creative, 80%; Construction automate, 20%
      –   End result evolving
  • Steps
      – Brainstorm/plan, Development, Deliver, Feedback

                                                              8
Iterative or Predictive
Iterative

 • Use when
    –   Project evolves or a little unknown
    –   Accept change
    –   Team small; strategies for large/split
    –   Rapid change can occur
 • IMO
    – Information Technology

                                                 9
Iterative or Predictive

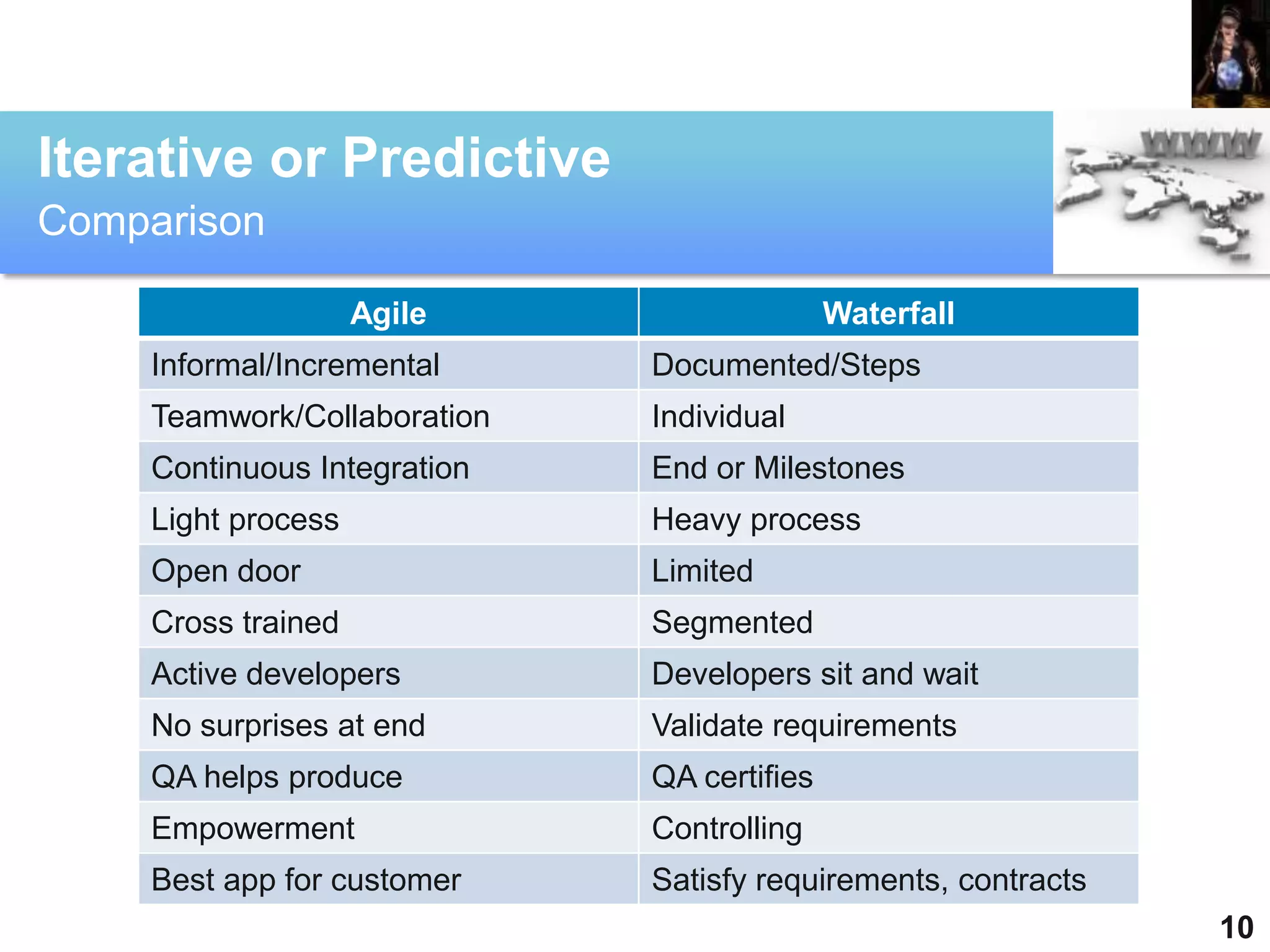

Comparison

                    Agile                   Waterfall
    Informal/Incremental     Documented/Steps
    Teamwork/Collaboration   Individual
    Continuous Integration   End or Milestones
    Light process            Heavy process
    Open door                Limited
    Cross trained            Segmented
    Active developers        Developers sit and wait
    No surprises at end      Validate requirements
    QA helps produce         QA certifies
    Empowerment              Controlling
    Best app for customer    Satisfy requirements, contracts
                                                               10

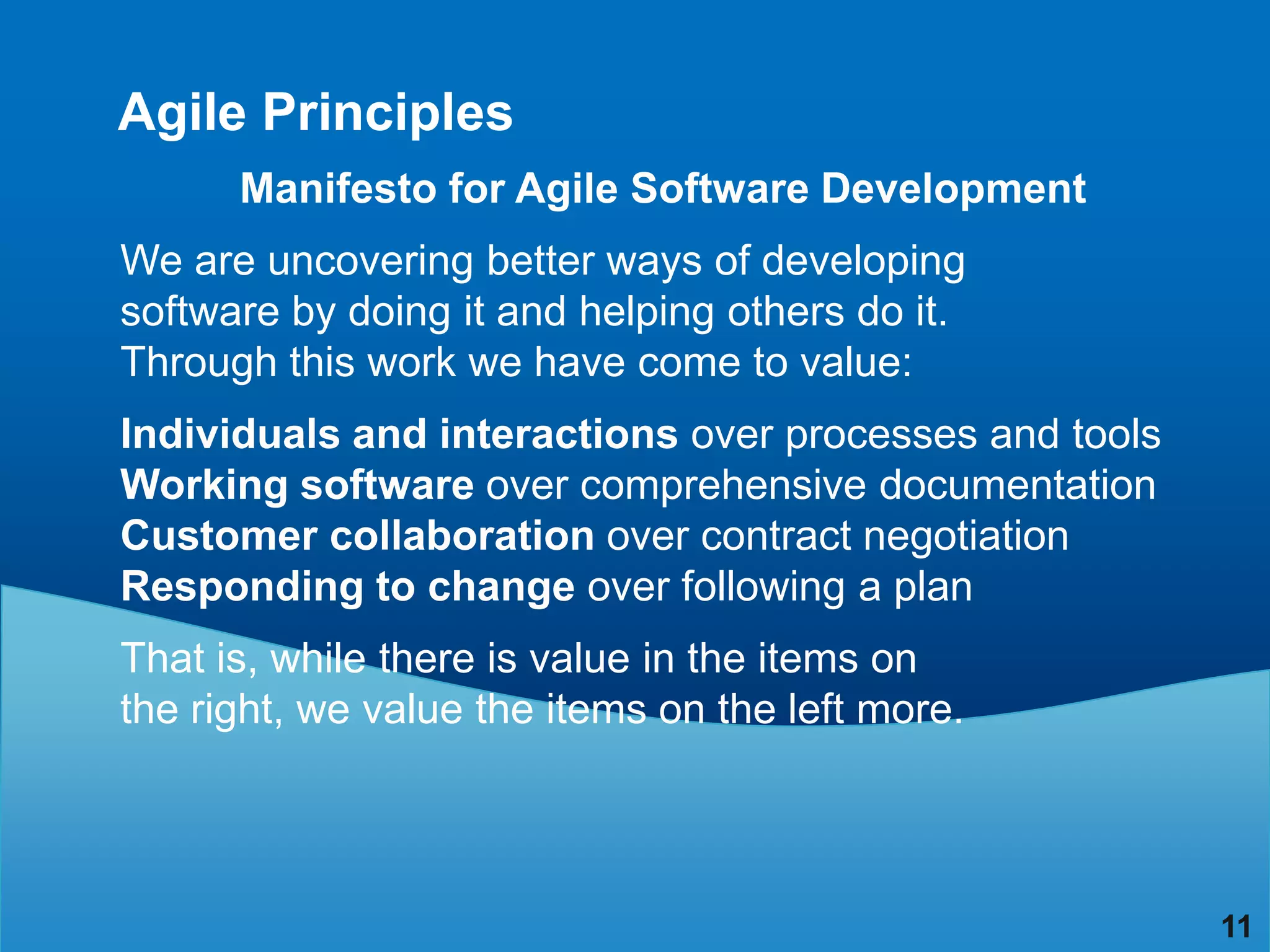

Agile Principles
      Manifesto for Agile Software Development
We are uncovering better ways of developing
software by doing it and helping others do it.
Through this work we have come to value:
Individuals and interactions over processes and tools
Working software over comprehensive documentation
Customer collaboration over contract negotiation
Responding to change over following a plan
That is, while there is value in the items on
the right, we value the items on the left more.

                                                        11

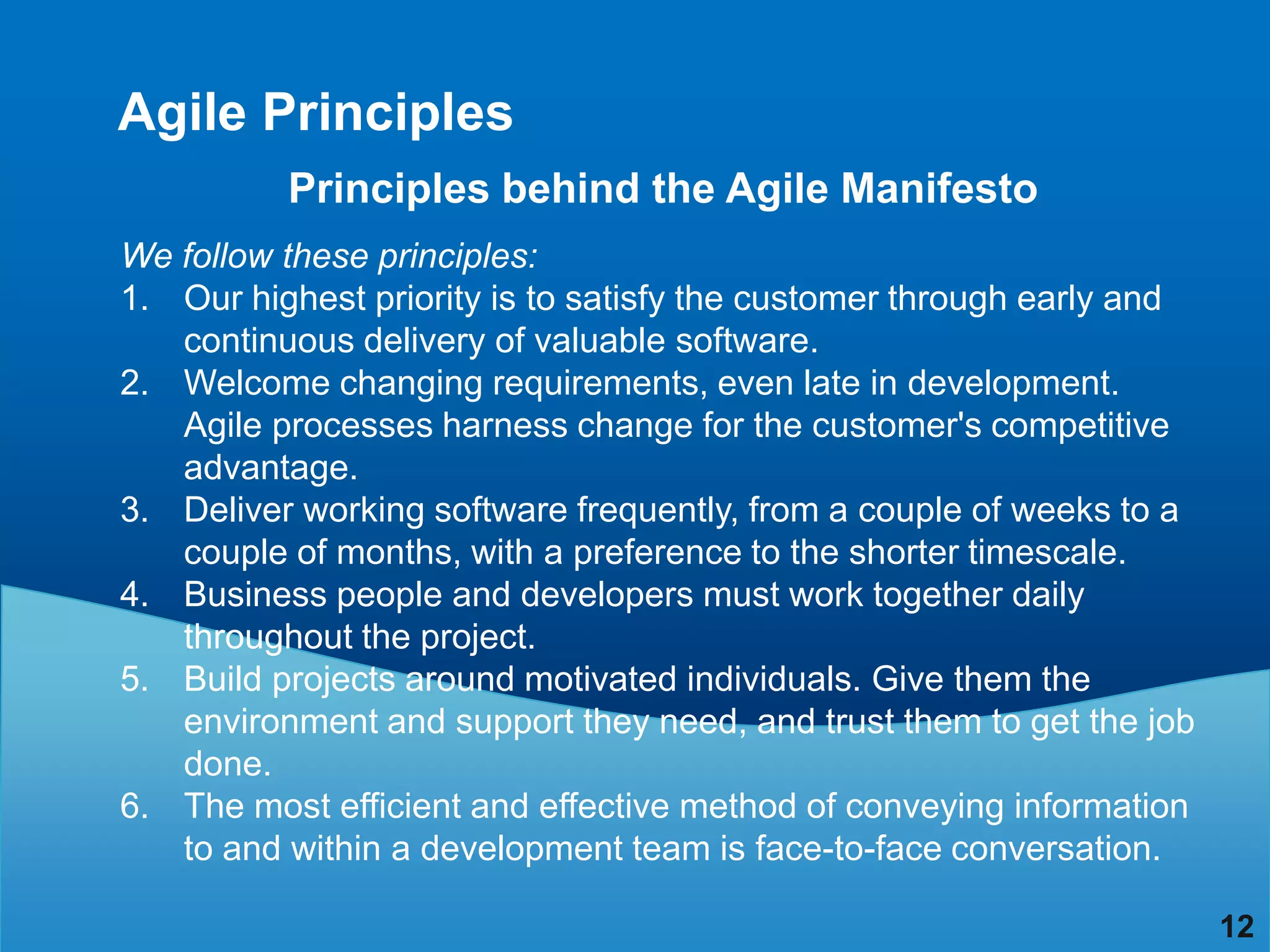

Agile Principles
          Principles behind the Agile Manifesto
We follow these principles:
1. Our highest priority is to satisfy the customer through early and
   continuous delivery of valuable software.
2. Welcome changing requirements, even late in development.
   Agile processes harness change for the customer's competitive
   advantage.
3. Deliver working software frequently, from a couple of weeks to a
   couple of months, with a preference to the shorter timescale.
4. Business people and developers must work together daily
   throughout the project.
5. Build projects around motivated individuals. Give them the
   environment and support they need, and trust them to get the job
   done.
6. The most efficient and effective method of conveying information
   to and within a development team is face-to-face conversation.

                                                                       12

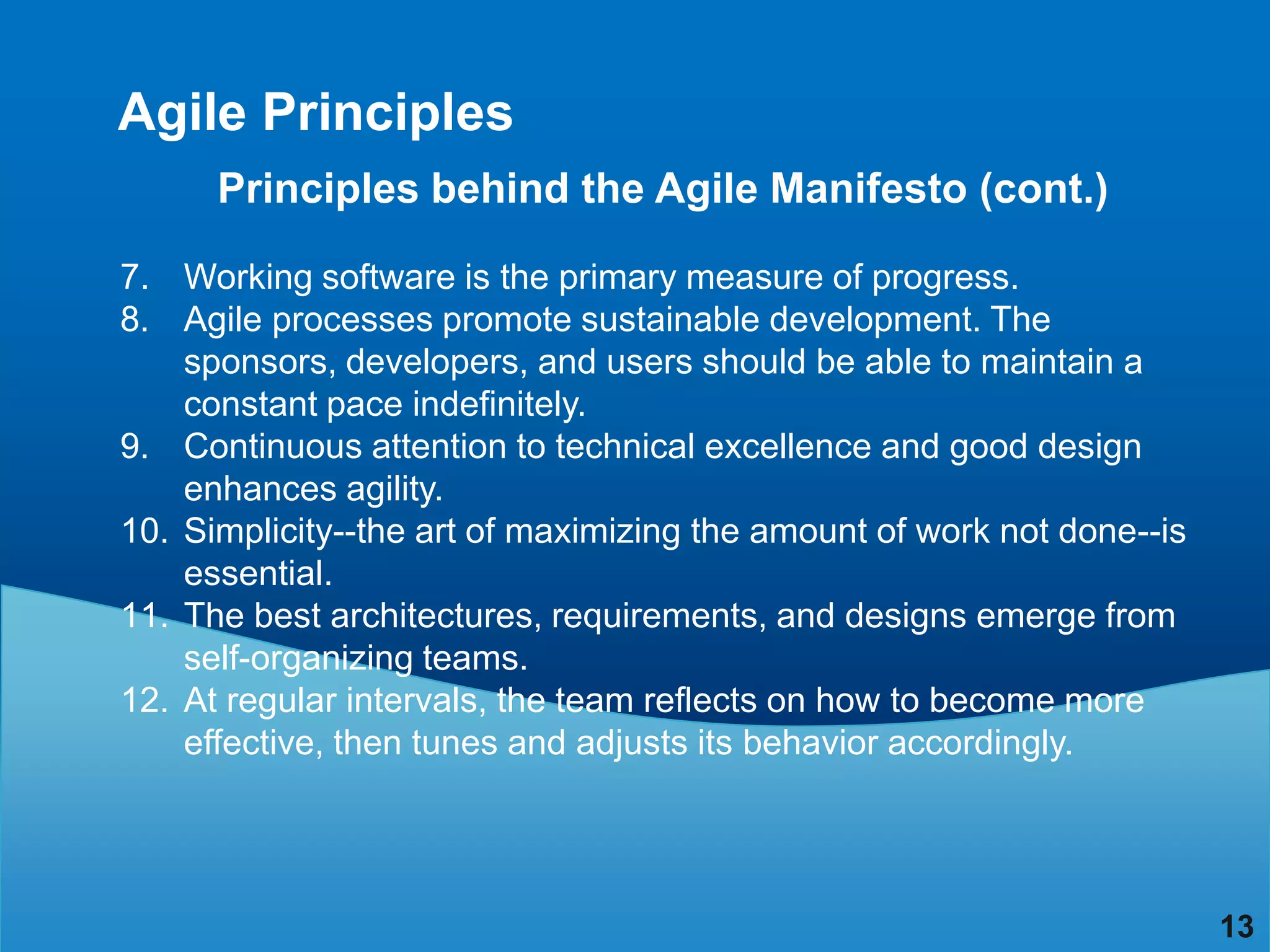

Agile Principles
      Principles behind the Agile Manifesto (cont.)

7. Working software is the primary measure of progress.
8. Agile processes promote sustainable development. The
    sponsors, developers, and users should be able to maintain a
    constant pace indefinitely.
9. Continuous attention to technical excellence and good design
    enhances agility.
10. Simplicity--the art of maximizing the amount of work not done--is
    essential.
11. The best architectures, requirements, and designs emerge from
    self-organizing teams.
12. At regular intervals, the team reflects on how to become more
    effective, then tunes and adjusts its behavior accordingly.

                                                                        13

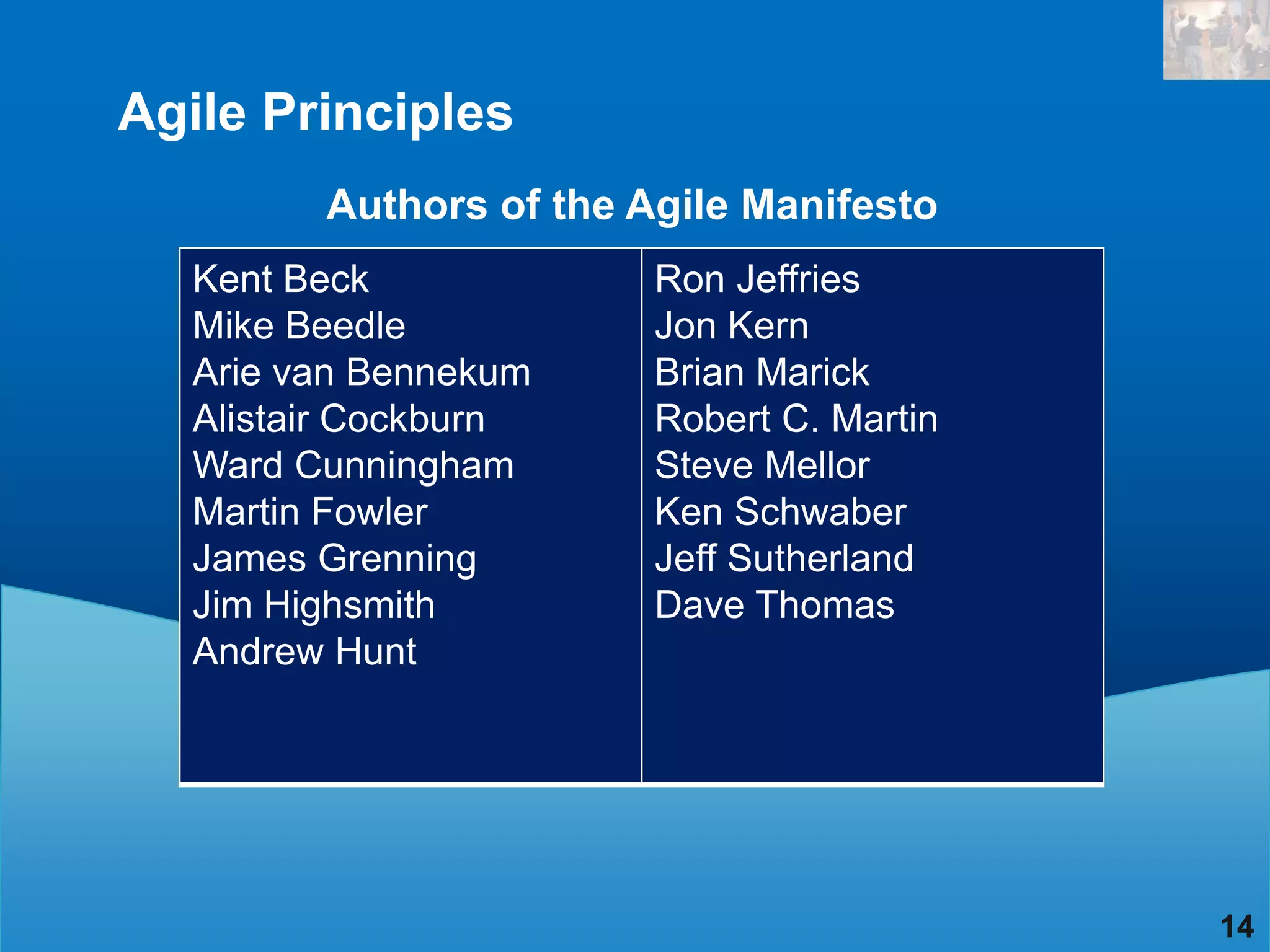

Agile Principles
         Authors of the Agile Manifesto
   Kent Beck             Ron Jeffries
   Mike Beedle           Jon Kern
   Arie van Bennekum     Brian Marick
   Alistair Cockburn     Robert C. Martin
   Ward Cunningham       Steve Mellor
   Martin Fowler         Ken Schwaber
   James Grenning        Jeff Sutherland
   Jim Highsmith         Dave Thomas
   Andrew Hunt

                                            14
Adopting Agile

                 15
Adopting Agile

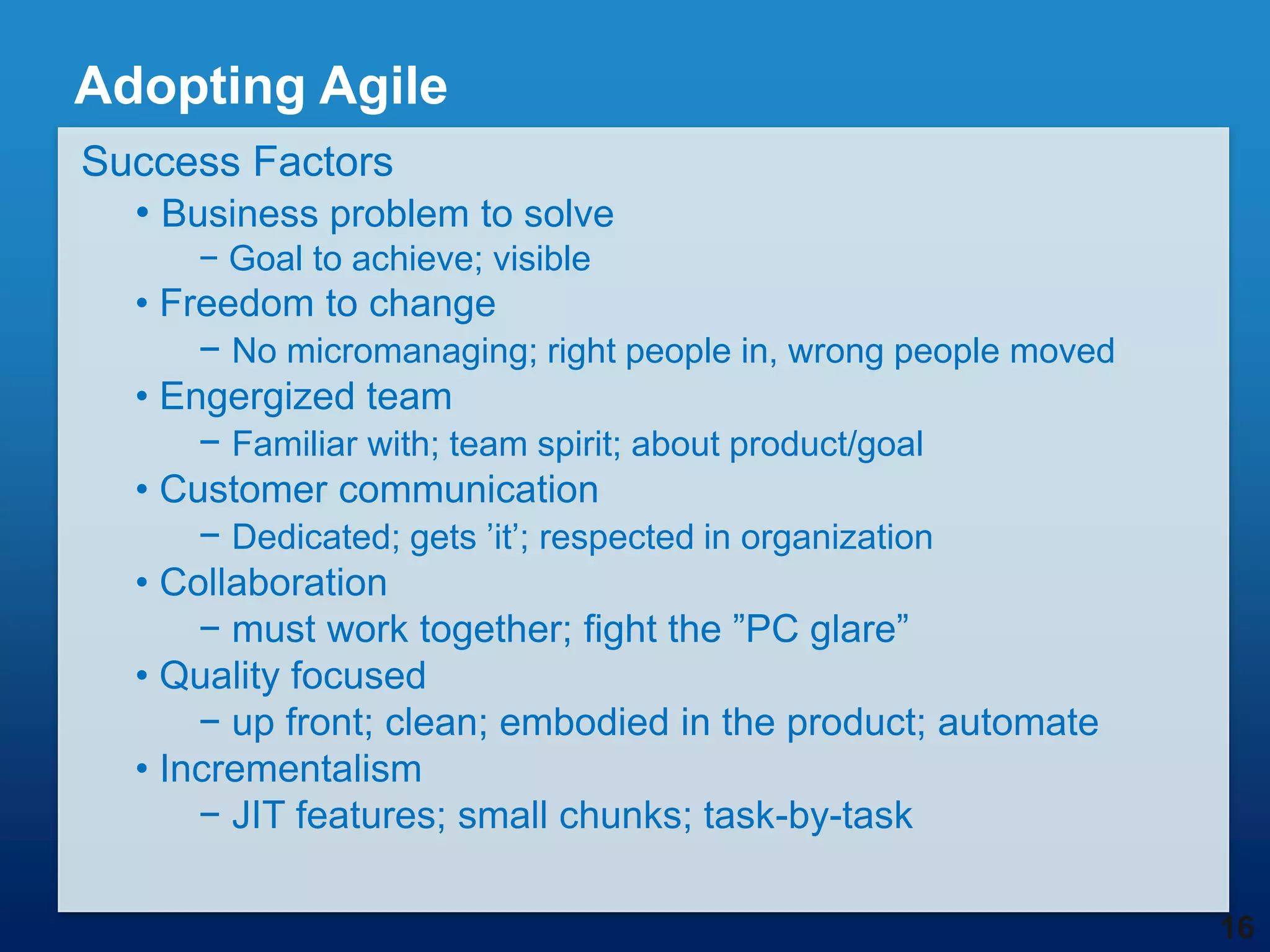

Success Factors
  • Business problem to solve
      − Goal to achieve; visible
  • Freedom to change
      − No micromanaging; right people in, wrong people moved
  • Engergized team
      − Familiar with; team spirit; about product/goal
  • Customer communication
      − Dedicated; gets ‟it‟; respected in organization
  • Collaboration
      − must work together; fight the ”PC glare”
  • Quality focused
      − up front; clean; embodied in the product; automate
  • Incrementalism
      − JIT features; small chunks; task-by-task

                                                                16

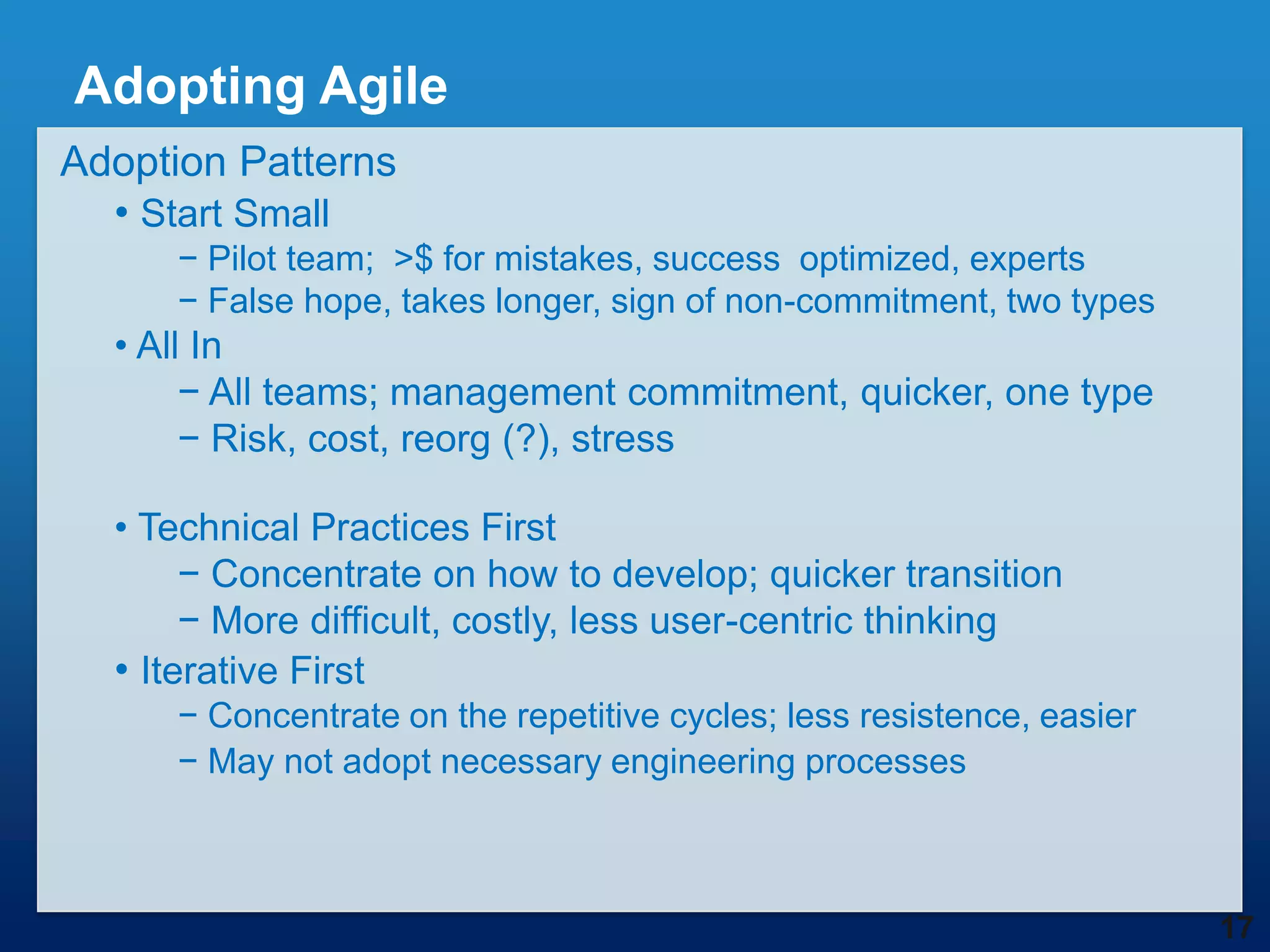

Adopting Agile
Adoption Patterns
  • Start Small
     − Pilot team; >$ for mistakes, success optimized, experts
     − False hope, takes longer, sign of non-commitment, two types
  • All In
       − All teams; management commitment, quicker, one type
       − Risk, cost, reorg (?), stress

  • Technical Practices First
       − Concentrate on how to develop; quicker transition
       − More difficult, costly, less user-centric thinking
  • Iterative First
     − Concentrate on the repetitive cycles; less resistence, easier
     − May not adopt necessary engineering processes

                                                                       17
Adopting Agile

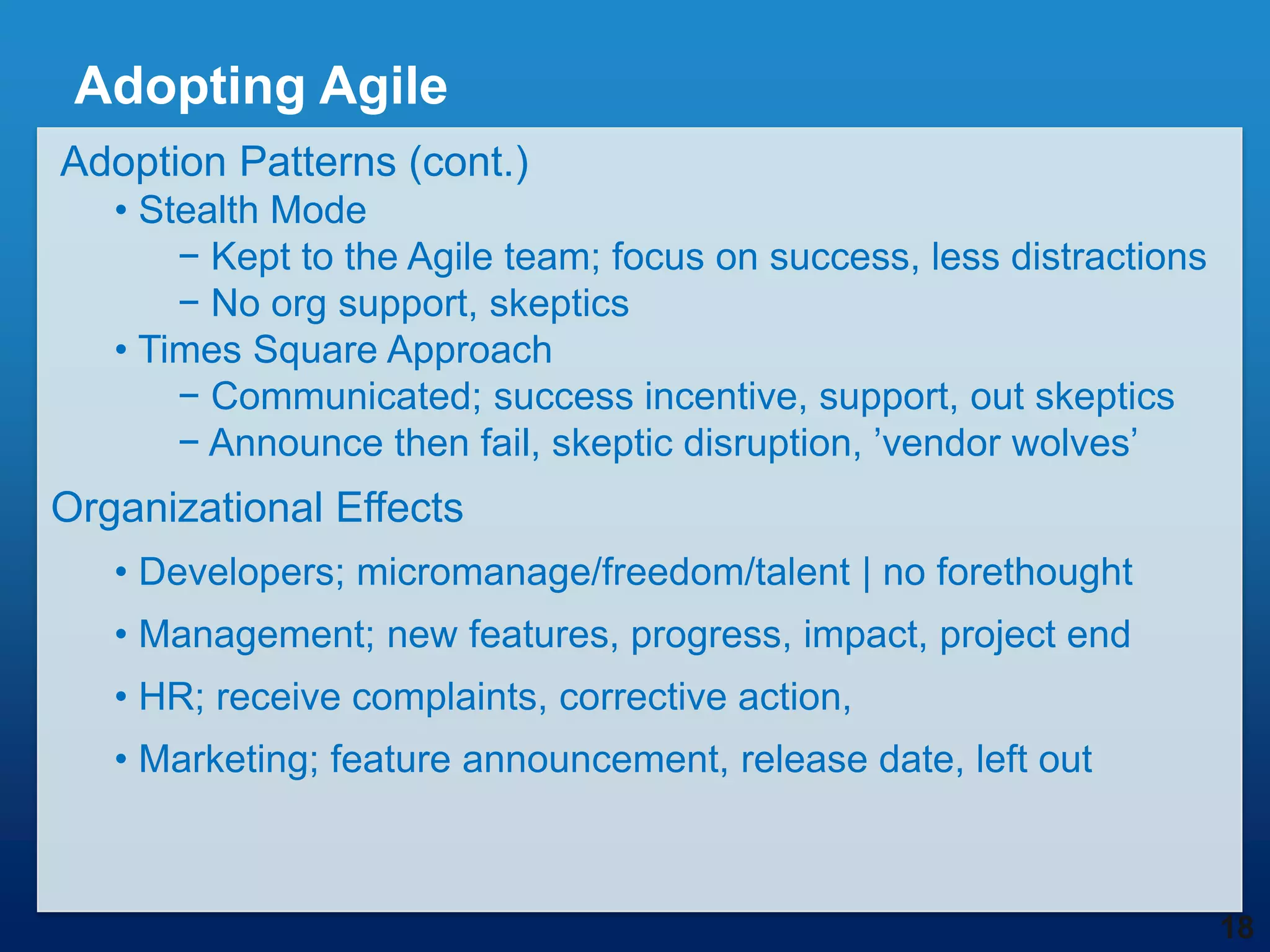

Adoption Patterns (cont.)
   • Stealth Mode
       − Kept to the Agile team; focus on success, less distractions
       − No org support, skeptics
   • Times Square Approach
       − Communicated; success incentive, support, out skeptics
       − Announce then fail, skeptic disruption, ‟vendor wolves‟
Organizational Effects
   • Developers; micromanage/freedom/talent | no forethought
   • Management; new features, progress, impact, project end
   • HR; receive complaints, corrective action,
   • Marketing; feature announcement, release date, left out

                                                                       18

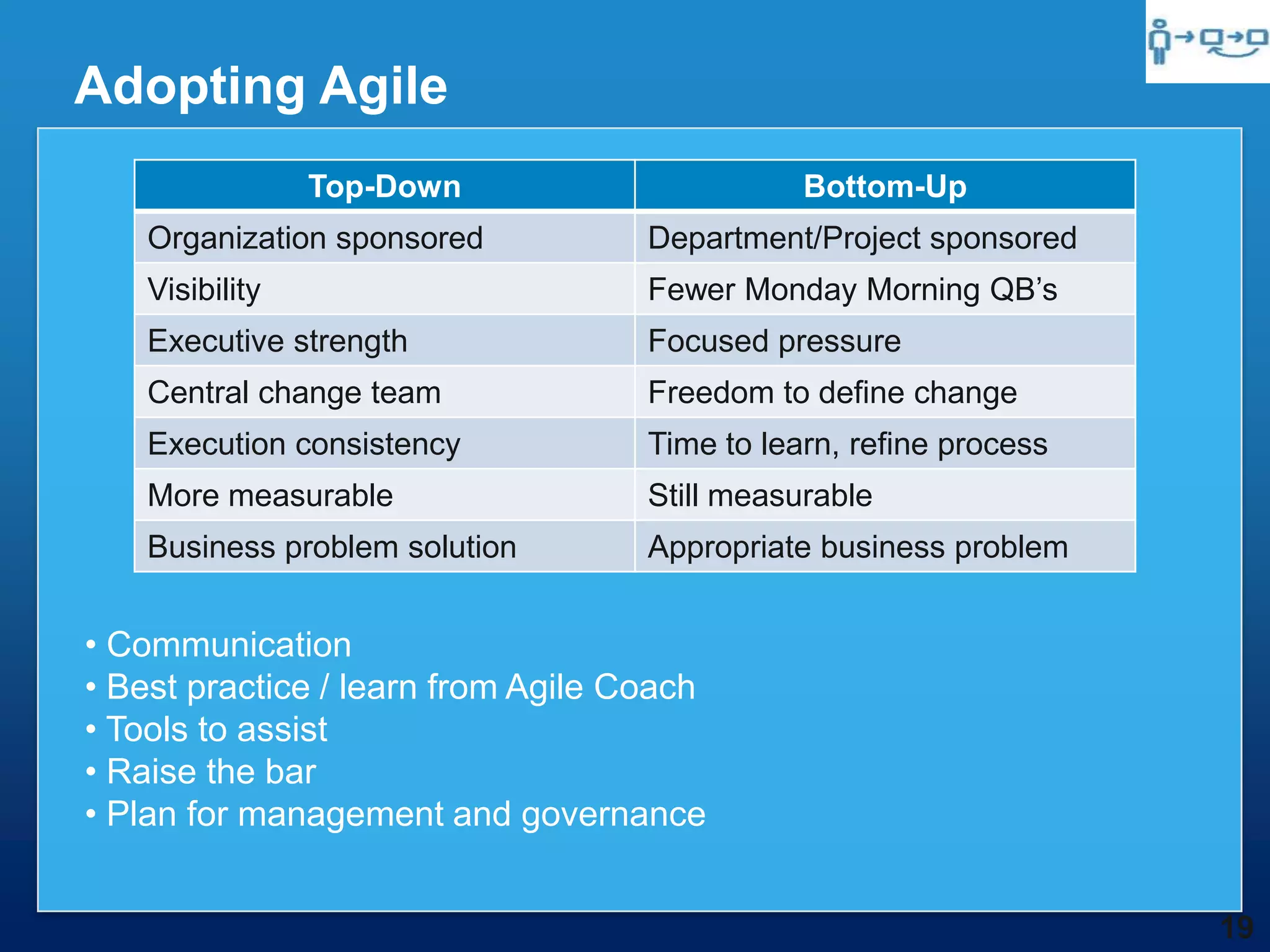

Adopting Agile
                 Top-Down                      Bottom-Up
    Organization sponsored          Department/Project sponsored
    Visibility                      Fewer Monday Morning QB‟s
    Executive strength              Focused pressure
    Central change team             Freedom to define change
    Execution consistency           Time to learn, refine process
    More measurable                 Still measurable
    Business problem solution       Appropriate business problem

• Communication
• Best practice / learn from Agile Coach
• Tools to assist
• Raise the bar
• Plan for management and governance

                                                                    19

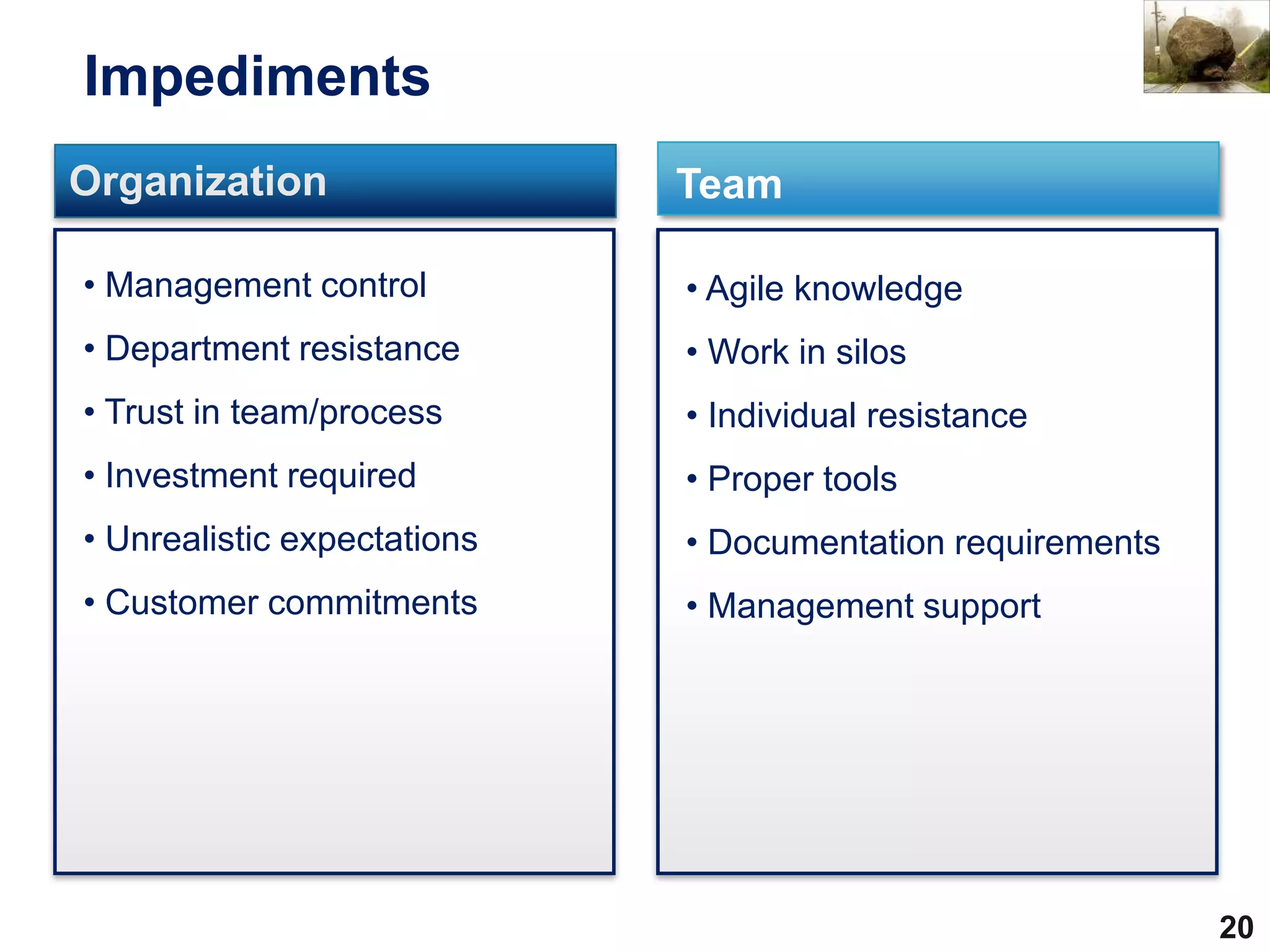

Impediments
Organization                 Team

• Management control         • Agile knowledge
• Department resistance      • Work in silos
• Trust in team/process      • Individual resistance
• Investment required        • Proper tools
• Unrealistic expectations   • Documentation requirements
• Customer commitments       • Management support

                                                            20
Agile Types
Agile Survey 2006

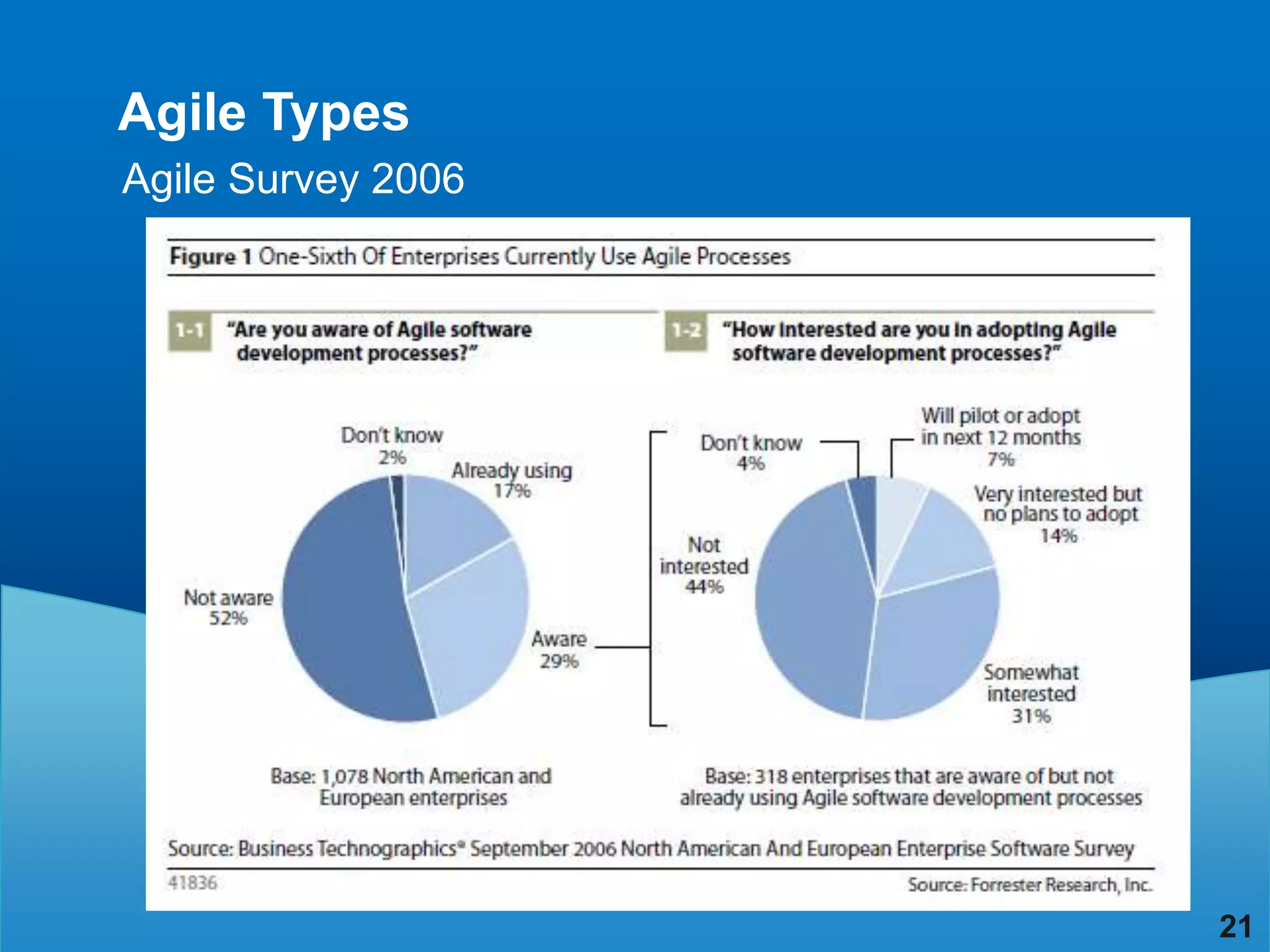

                    21
Agile Types

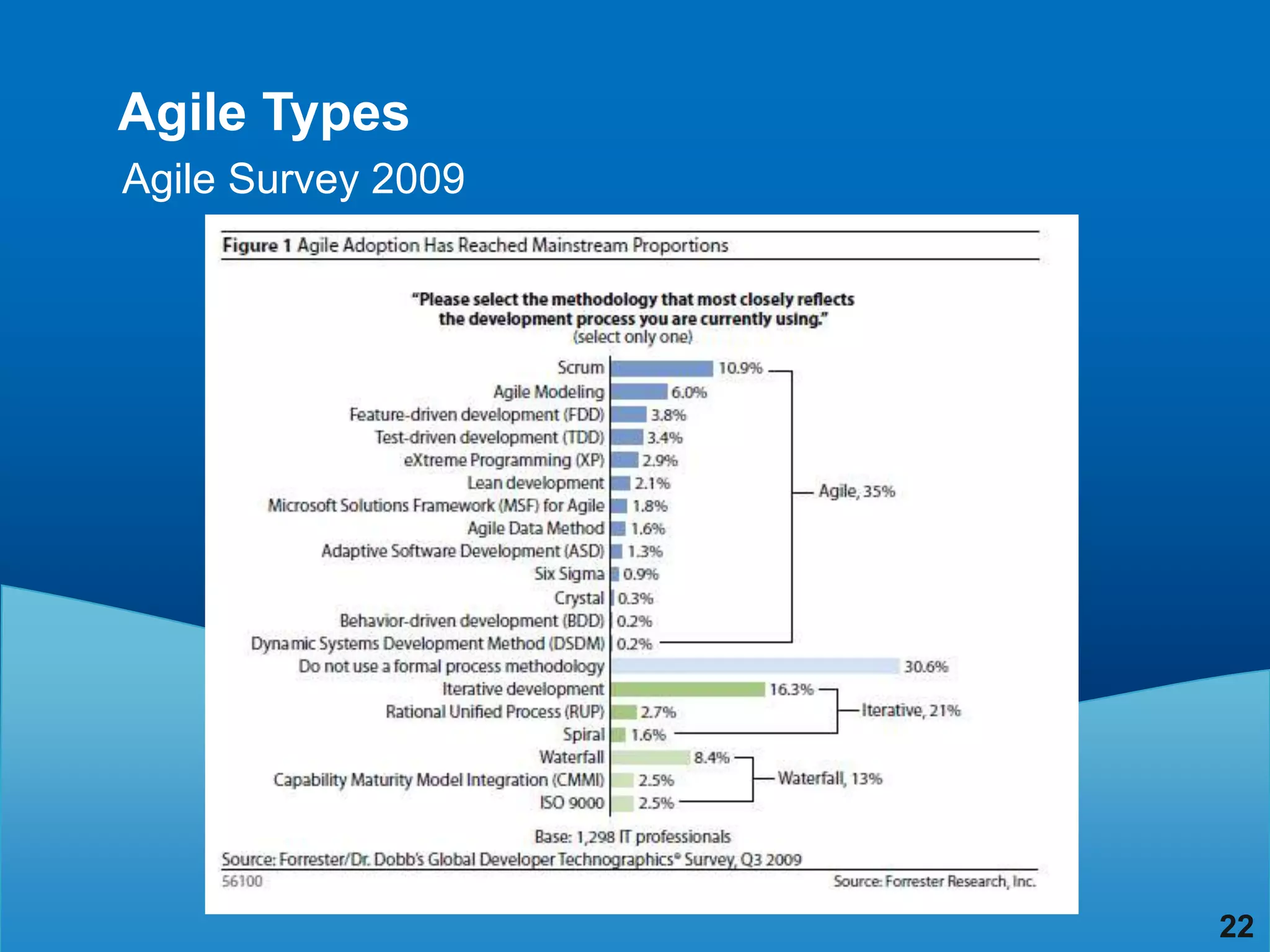

Agile Survey 2009

                    22
Agile Types
  Am I Agile?
                  Adaptive, empowered, self-organizing
                  Absence of phases
Individuals and
  Interactions    Use of minimal planning
                  Scalable
                  Continuous process refinement
                  Iterative and incremental
   Working
                  Working software measured in progress
   software
                  Artifacts are minimized

 Customer         Customer involvement throughout
Collaboration     Adaptive, empirical customer relationship

Responding to     Emergent requirements
   Change         Frequent inspection
                                                              23
Agile Types

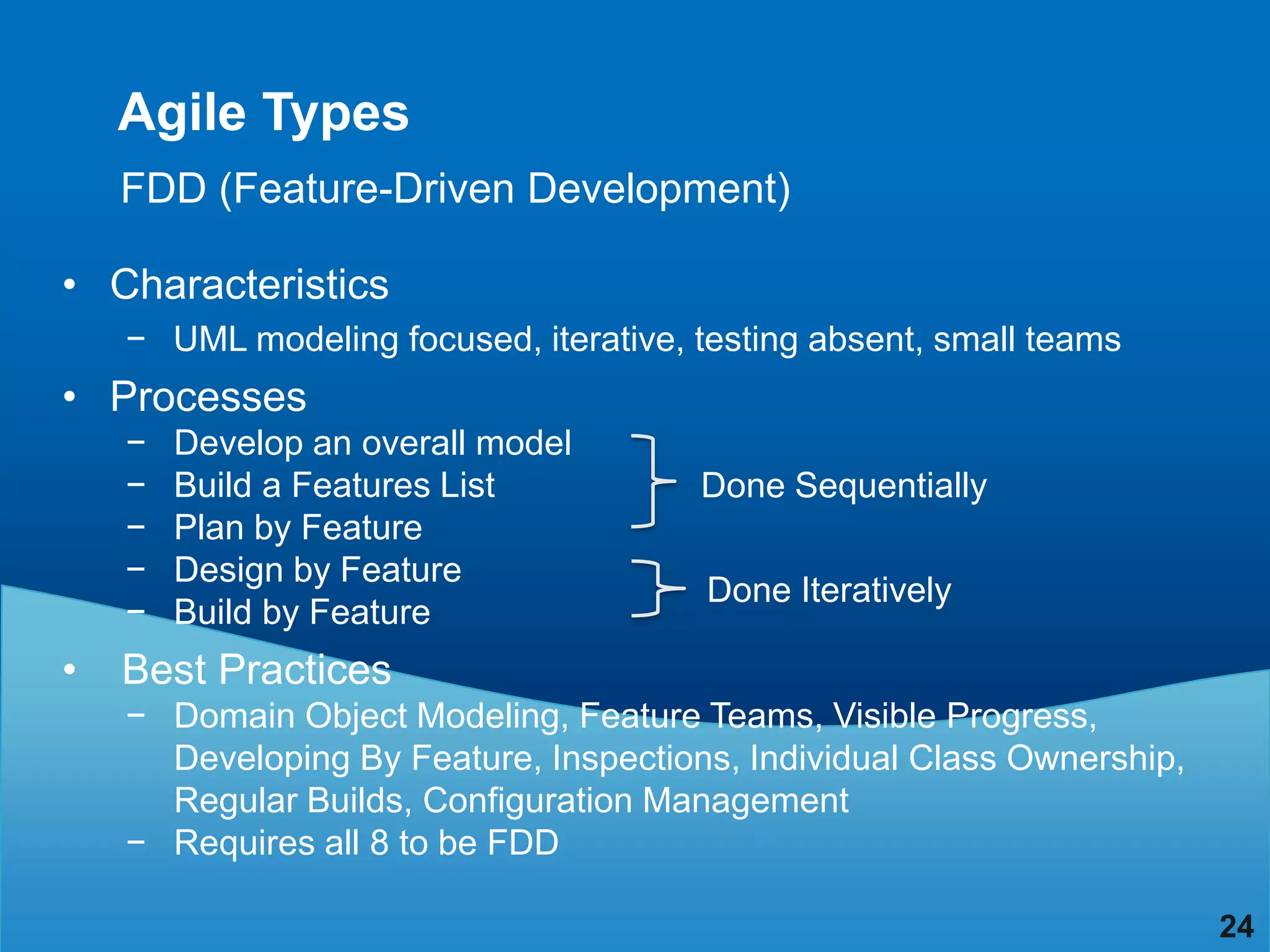

    FDD (Feature-Driven Development)

• Characteristics
    − UML modeling focused, iterative, testing absent, small teams
• Processes
    −   Develop an overall model
    −   Build a Features List          Done Sequentially
    −   Plan by Feature
    −   Design by Feature
                                        Done Iteratively
    −   Build by Feature
•   Best Practices
    − Domain Object Modeling, Feature Teams, Visible Progress,
      Developing By Feature, Inspections, Individual Class Ownership,
      Regular Builds, Configuration Management
    − Requires all 8 to be FDD

                                                                        24

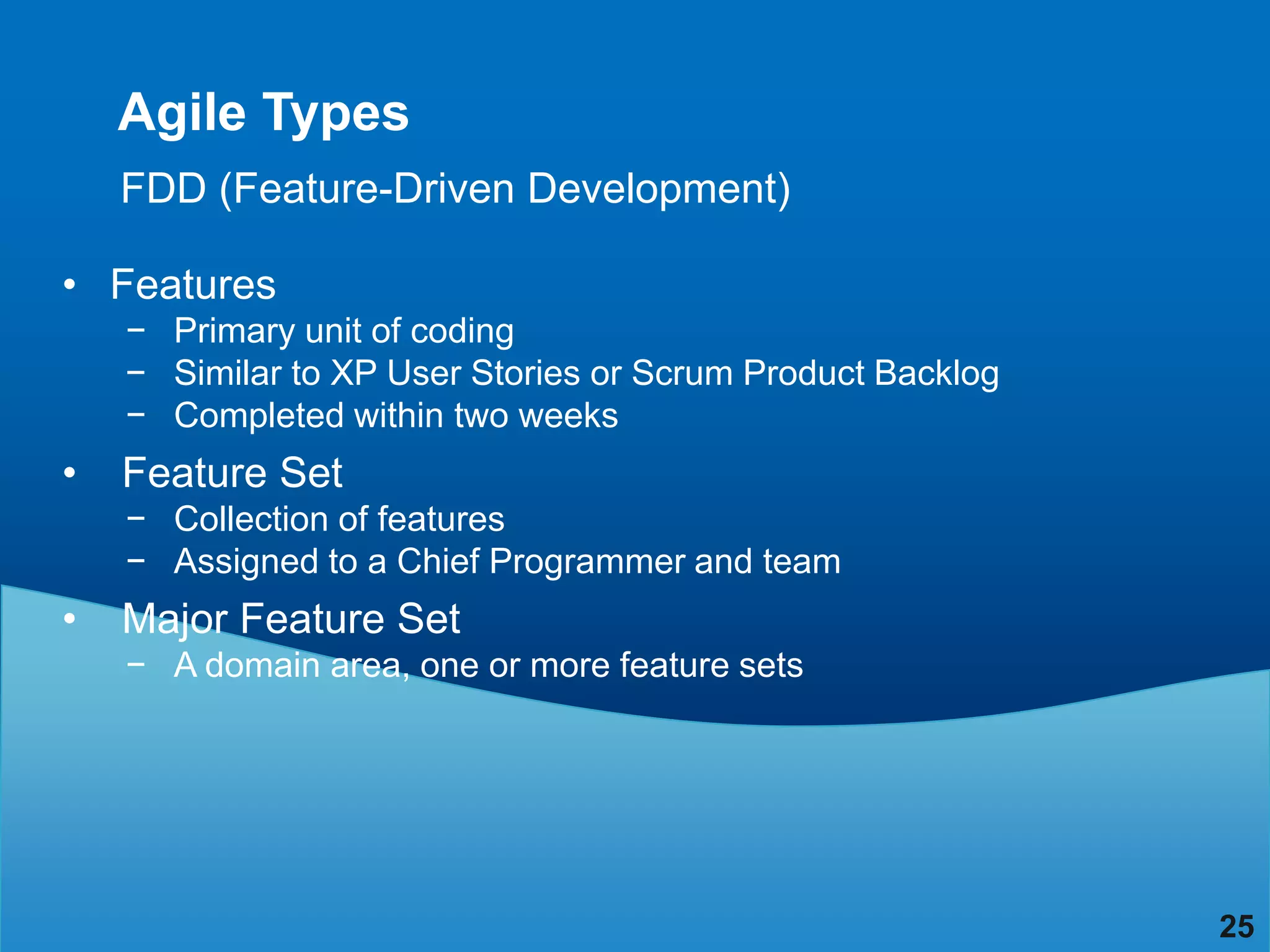

Agile Types
    FDD (Feature-Driven Development)

• Features
    − Primary unit of coding
    − Similar to XP User Stories or Scrum Product Backlog
    − Completed within two weeks
•   Feature Set
    − Collection of features
    − Assigned to a Chief Programmer and team
•   Major Feature Set
    − A domain area, one or more feature sets

                                                            25
Agile Types
  Am I Agile?
                  Adaptive, empowered, self-organizing        Not so much
                  Absence of phases                           No
Individuals and
  Interactions    Use of minimal planning                     No
                  Scalable                                    Yes
                  Continuous process refinement               Not so much
                  Iterative and incremental                   Somewhat
   Working
                  Working software measured in progress       No
   software
                  Artifacts are minimized                     Somewhat

 Customer         Customer involvement throughout             Yes
Collaboration     Adaptive, empirical customer relationship   Yes

Responding to     Emergent requirements                       No
   Change         Frequent inspection                         Yes
                                                                            26

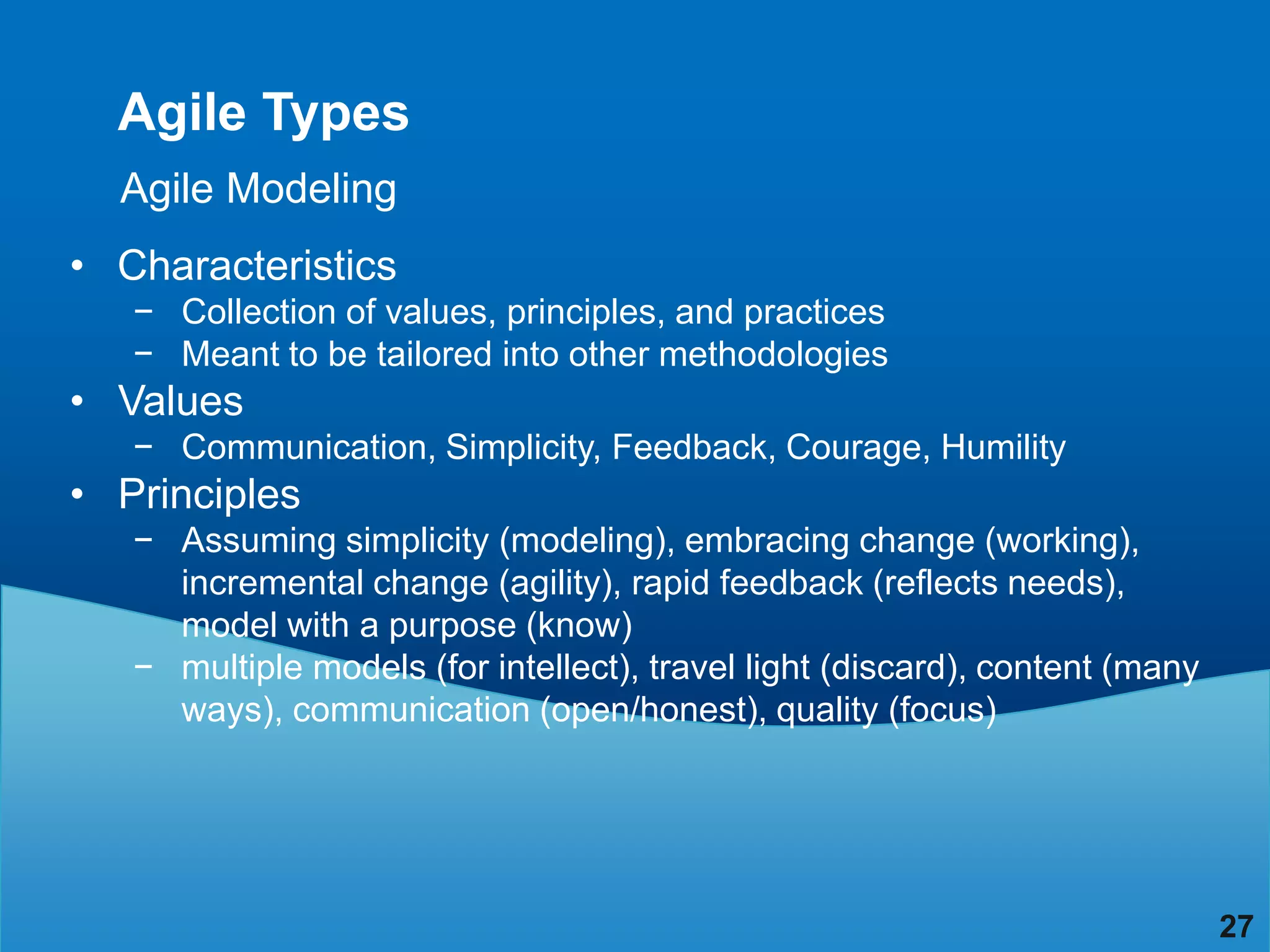

Agile Types
  Agile Modeling
• Characteristics
   − Collection of values, principles, and practices
   − Meant to be tailored into other methodologies
• Values
   − Communication, Simplicity, Feedback, Courage, Humility
• Principles
   − Assuming simplicity (modeling), embracing change (working),
     incremental change (agility), rapid feedback (reflects needs),
     model with a purpose (know)
   − multiple models (for intellect), travel light (discard), content (many
     ways), communication (open/honest), quality (focus)

                                                                              27

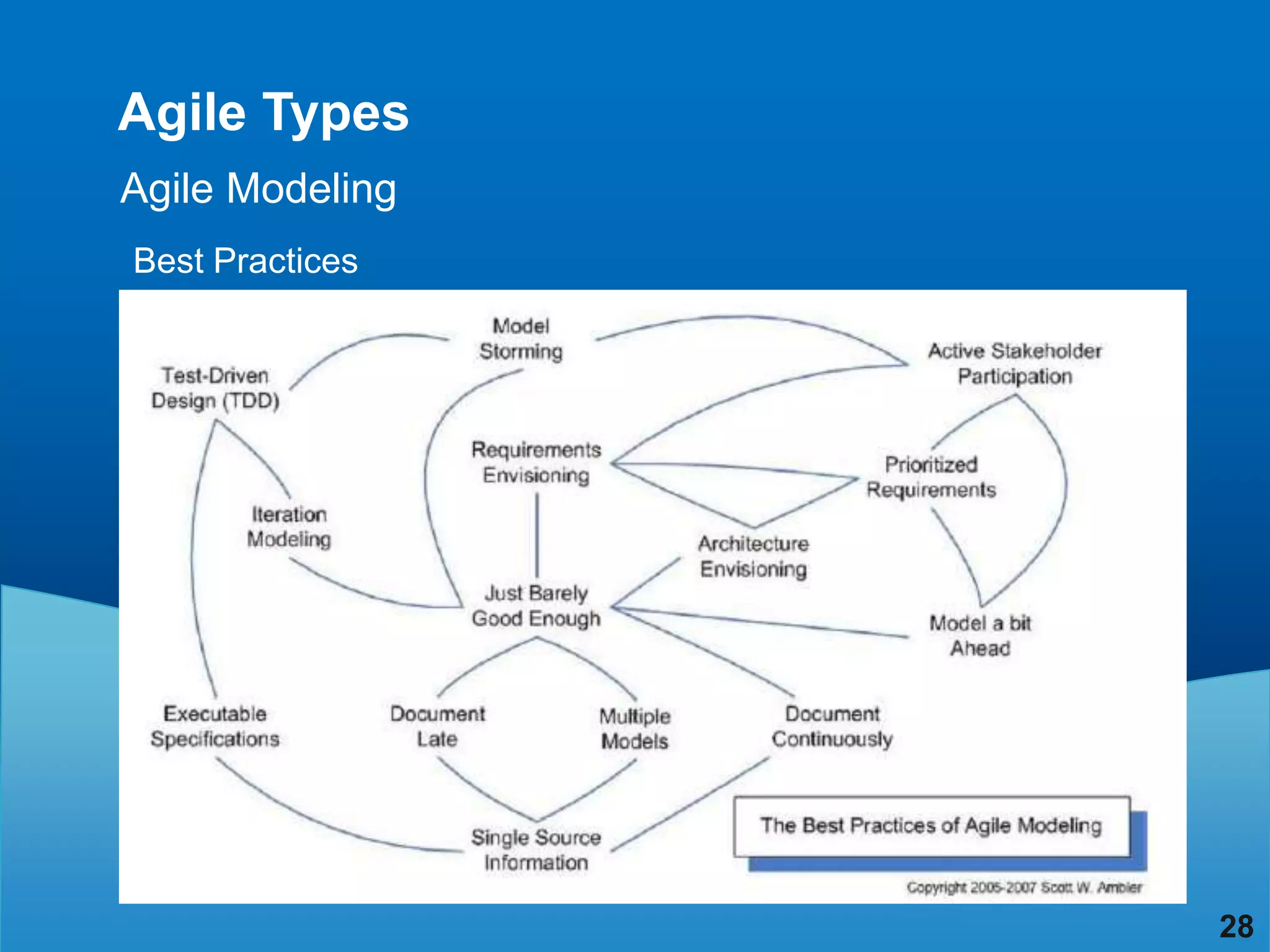

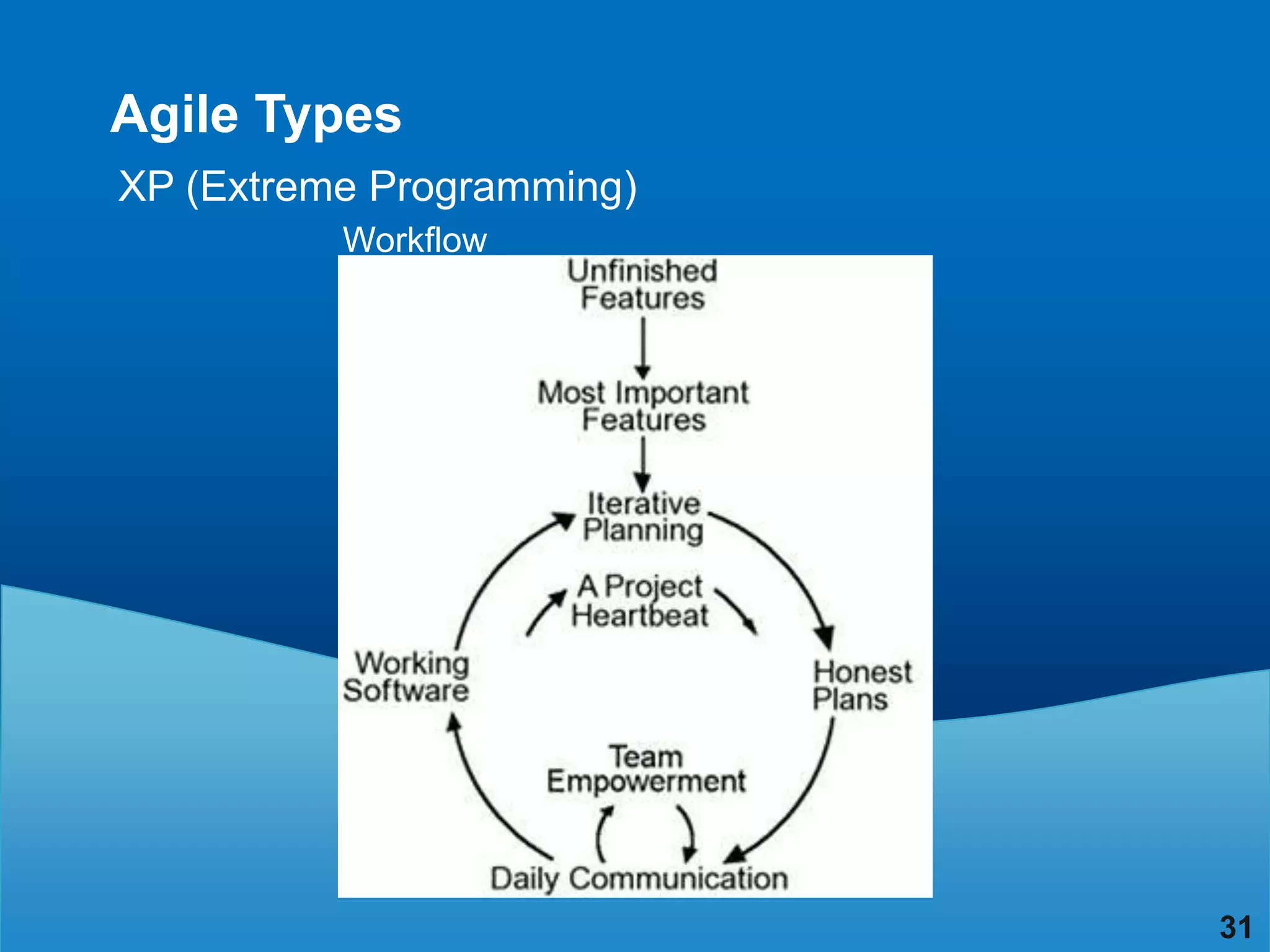

Agile Types
Agile Modeling
Best Practices

                 28
Agile Types

  Am I Agile?

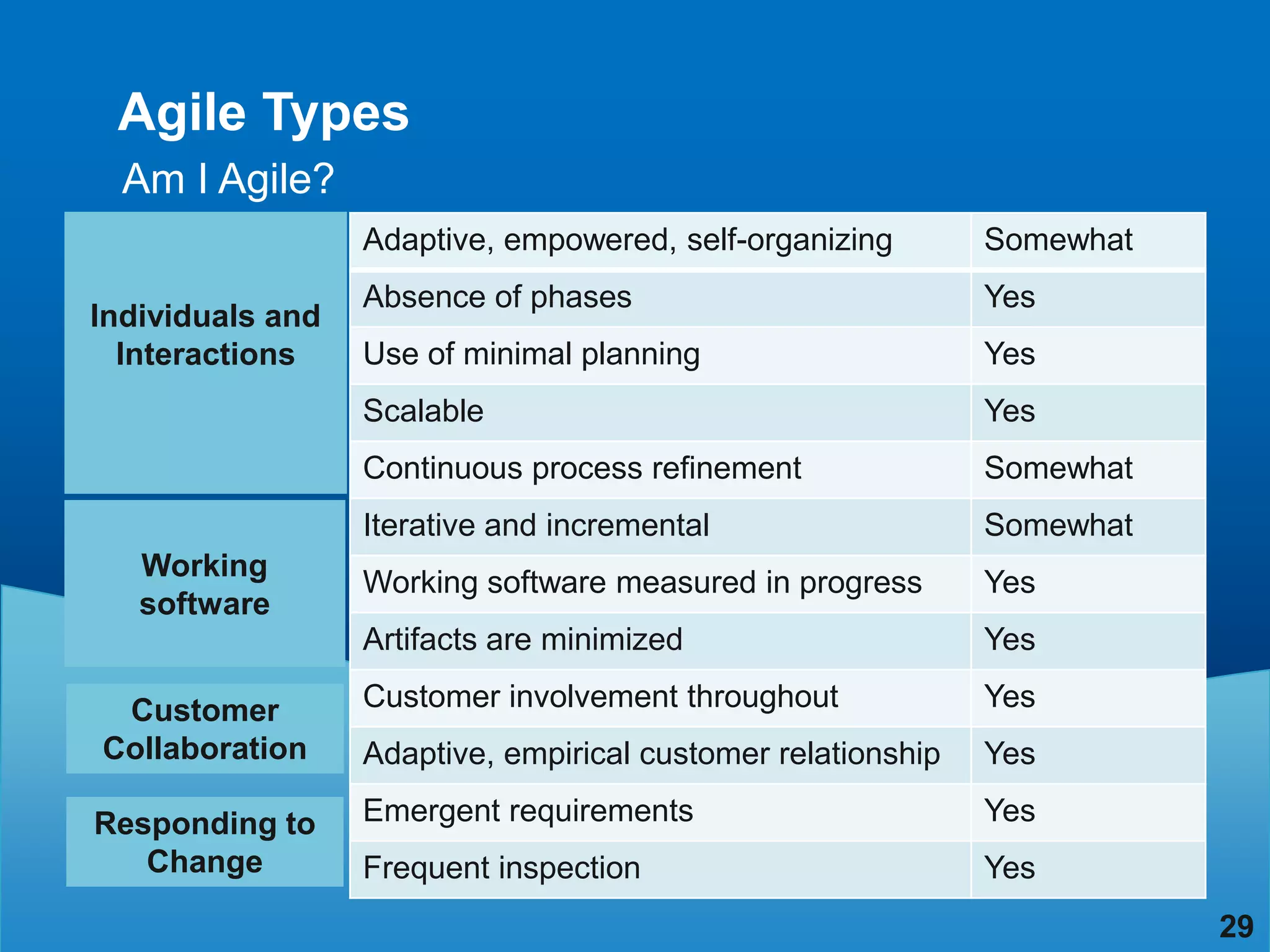

                  Adaptive, empowered, self-organizing        Somewhat
                  Absence of phases                           Yes
Individuals and
  Interactions    Use of minimal planning                     Yes
                  Scalable                                    Yes
                  Continuous process refinement               Somewhat
                  Iterative and incremental                   Somewhat
   Working
                  Working software measured in progress       Yes
   software
                  Artifacts are minimized                     Yes

 Customer         Customer involvement throughout             Yes
Collaboration     Adaptive, empirical customer relationship   Yes

Responding to     Emergent requirements                       Yes
   Change         Frequent inspection                         Yes
                                                                         29
Agile Types
   XP (Extreme Programming)
• Characteristics
  −   Collection of values and practices
  −   1 – 4 week iterations, all dials set to “10”
  −   Stories (functionality), on-site customers
  −   UNIT TESTING, simplest thing
  −   YAGNI (You Aren‟t Gonna Need It)
• Values
  − Simplicity: what is needed and asked for, no more
  − Communication: face to face, daily; work together on everything
  − Feedback: every iteration seriously delivering working software;
    listen change as needed; adapt process to project
  − Respect: everyone contributes; developers respect customers vice
    versa; management respects authority over work
  − Courage: truth about project/estimates; no fear no one works
    alone; adapt to changes

                                                                       30
Agile Types
XP (Extreme Programming)
          Workflow

                           31
Agile Types
  Am I Agile?
                  Adaptive, empowered, self-organizing        Somewhat
                  Absence of phases                           Yes
Individuals and
  Interactions    Use of minimal planning                     Yes
                  Scalable                                    Yes
                  Continuous process refinement               Mostly
                  Iterative and incremental                   Yes
   Working
                  Working software measured in progress       Yes
   software
                  Artifacts are minimized                     Yes

 Customer         Customer involvement throughout             Yes
Collaboration     Adaptive, empirical customer relationship   Yes

Responding to     Emergent requirements                       Yes
   Change         Frequent inspection                         Yes
                                                                         32
Agile Types

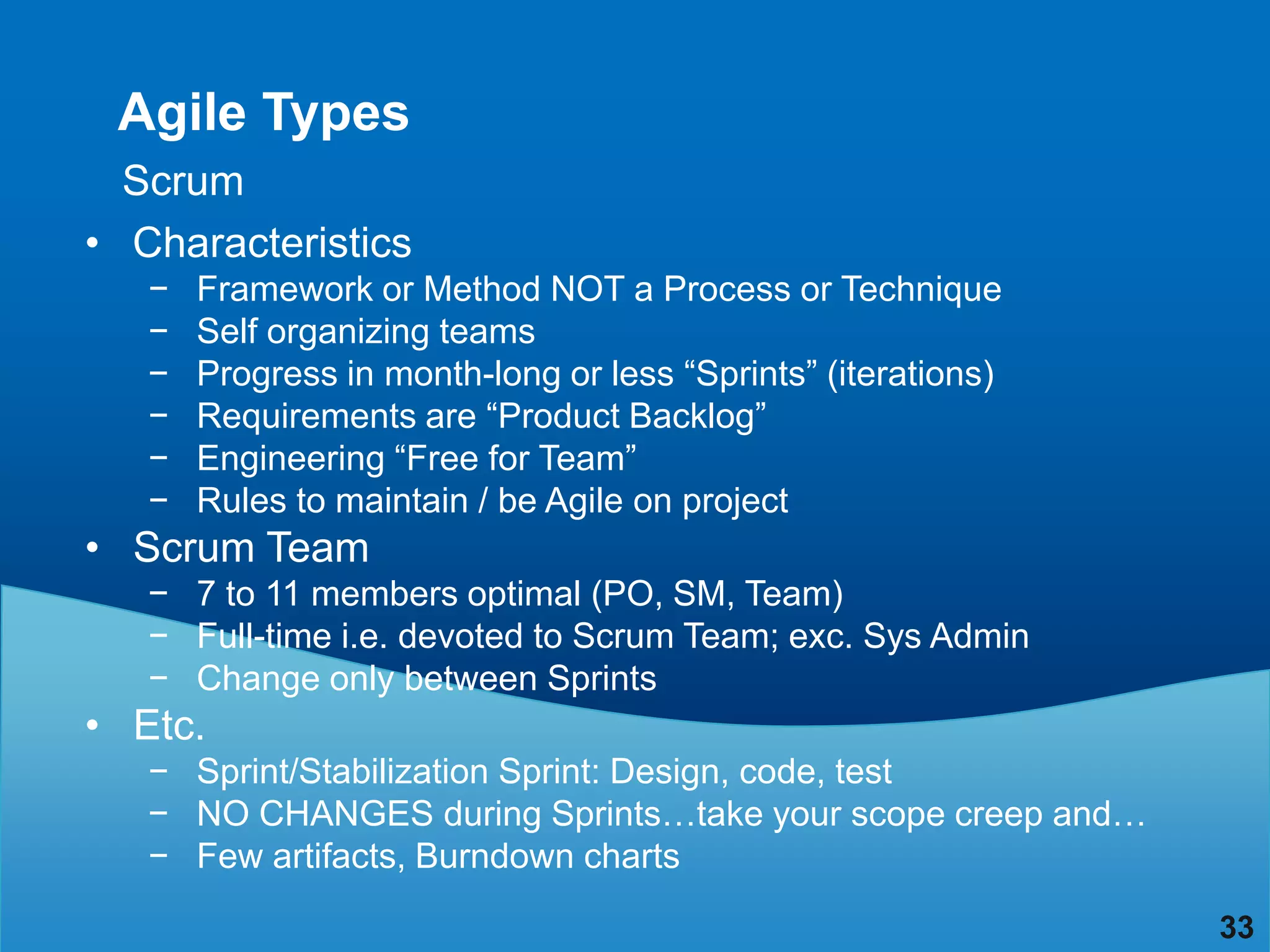

  Scrum
• Characteristics
   −   Framework or Method NOT a Process or Technique
   −   Self organizing teams
   −   Progress in month-long or less “Sprints” (iterations)
   −   Requirements are “Product Backlog”
   −   Engineering “Free for Team”
   −   Rules to maintain / be Agile on project
• Scrum Team
   − 7 to 11 members optimal (PO, SM, Team)
   − Full-time i.e. devoted to Scrum Team; exc. Sys Admin
   − Change only between Sprints
• Etc.
   − Sprint/Stabilization Sprint: Design, code, test
   − NO CHANGES during Sprints…take your scope creep and…
   − Few artifacts, Burndown charts
                                                               33
Agile Types
  Am I Agile?
                  Adaptive, empowered, self-organizing        Somewhat
                  Absence of phases                           Yes
Individuals and
  Interactions    Use of minimal planning                     Yes
                  Scalable                                    Yes
                  Continuous process refinement               Yes
                  Iterative and incremental                   Yes
   Working
                  Working software measured in progress       Yes
   software
                  Artifacts are minimized                     Yes

 Customer         Customer involvement throughout             Yes
Collaboration     Adaptive, empirical customer relationship   Yes

Responding to     Emergent requirements                       Yes
   Change         Frequent inspection                         Yes
                                                                         34
Scrum Overview

• Scrum History
  – Presented 1995, Jeff Sutherland/Ken Schwaber
  – Not a process or technique, framework (within you can
    employ processes/techniques
• Scrum Theory
  – Empirical process control: continuous cycle of inspection
    for correct operation, adapt as needed
  – Three pillars for implementation
     • Transparency: affect the outcome is visible to those managing;
       what is being seen must be known
     • Inspection: to detect unacceptable variances; skill/diligence
     • Adaption: adjustment of unacceptable variances; quickly; Daily
       Scrum, Sprint Review & Planning meetings; Sprint Retrospective
                                                                        35

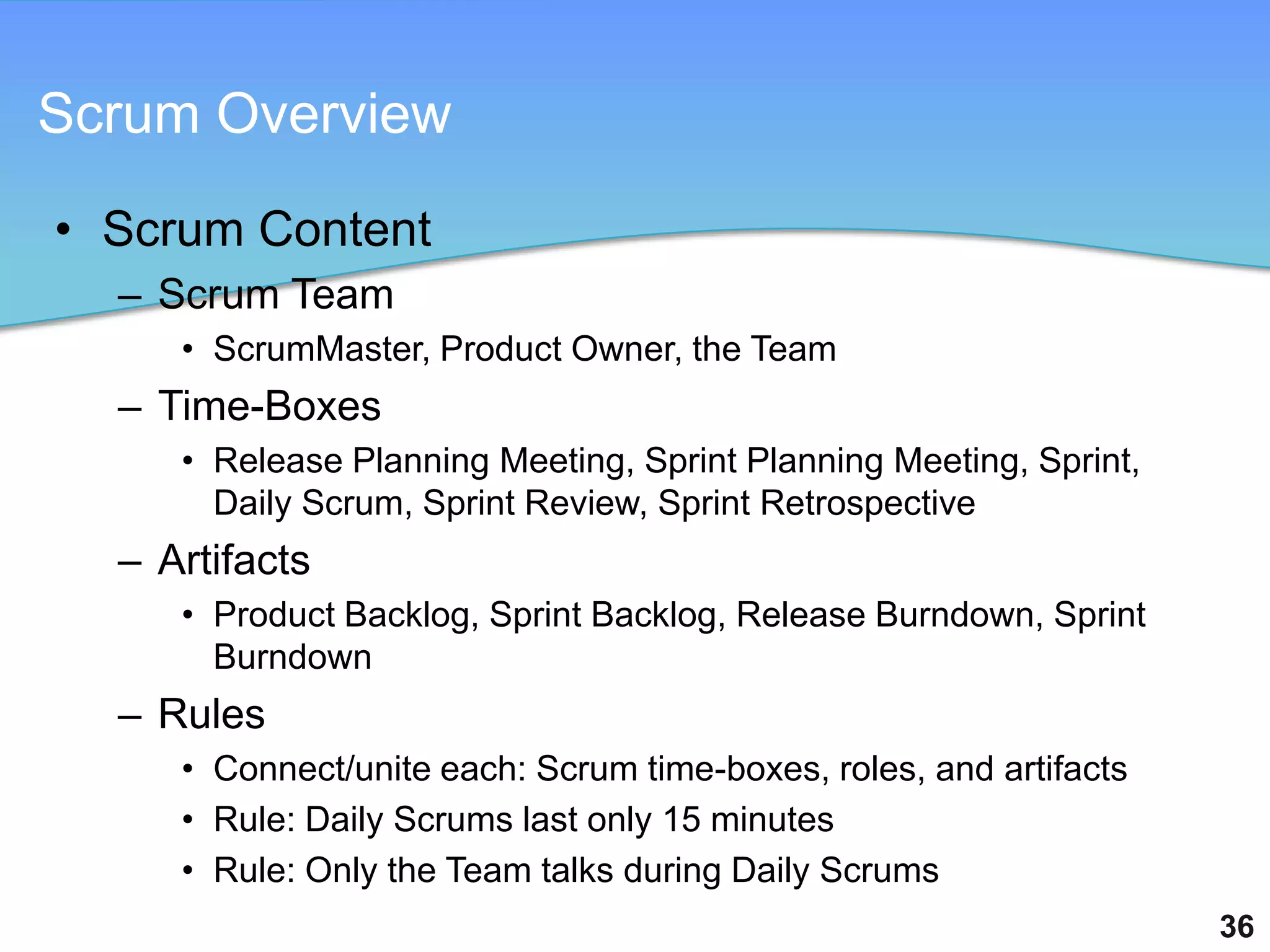

Scrum Overview

• Scrum Content
  – Scrum Team
     • ScrumMaster, Product Owner, the Team
  – Time-Boxes
     • Release Planning Meeting, Sprint Planning Meeting, Sprint,
       Daily Scrum, Sprint Review, Sprint Retrospective
  – Artifacts
     • Product Backlog, Sprint Backlog, Release Burndown, Sprint
       Burndown
  – Rules
     • Connect/unite each: Scrum time-boxes, roles, and artifacts
     • Rule: Daily Scrums last only 15 minutes
     • Rule: Only the Team talks during Daily Scrums
                                                                    36

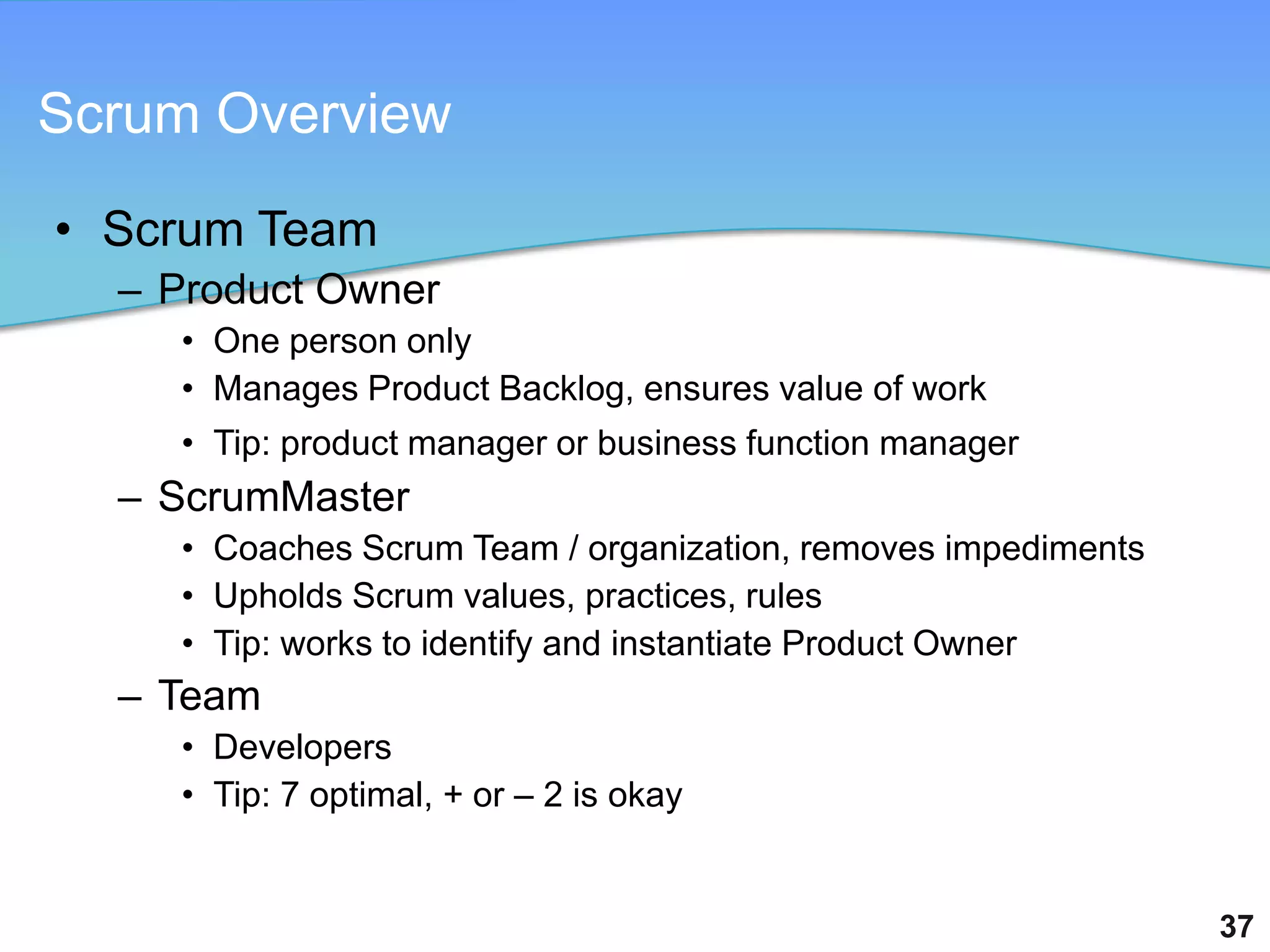

Scrum Overview

• Scrum Team
  – Product Owner
    • One person only
    • Manages Product Backlog, ensures value of work
    • Tip: product manager or business function manager
  – ScrumMaster
    • Coaches Scrum Team / organization, removes impediments
    • Upholds Scrum values, practices, rules
    • Tip: works to identify and instantiate Product Owner
  – Team
    • Developers
    • Tip: 7 optimal, + or – 2 is okay

                                                               37

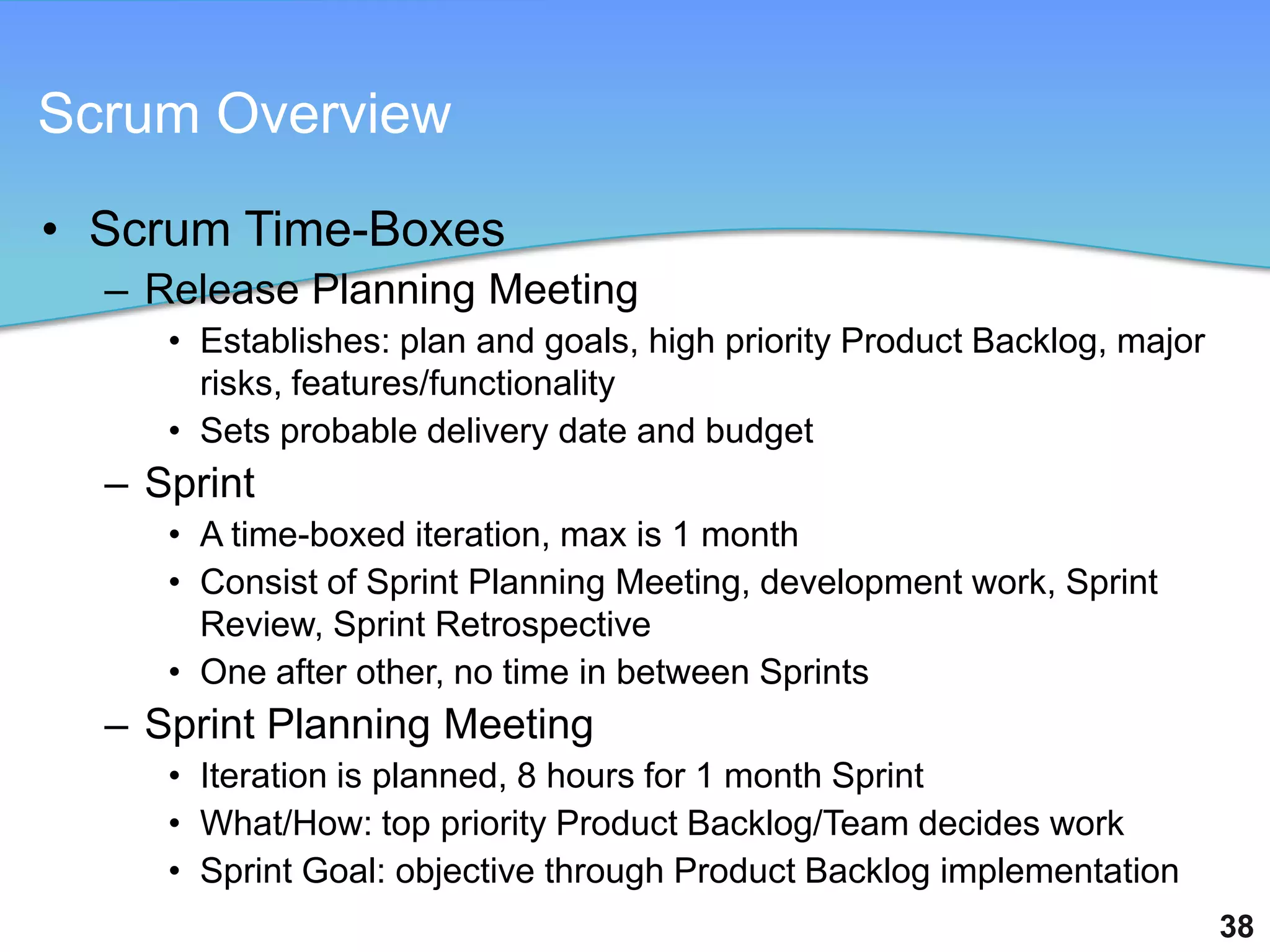

Scrum Overview

• Scrum Time-Boxes
  – Release Planning Meeting
     • Establishes: plan and goals, high priority Product Backlog, major
       risks, features/functionality
     • Sets probable delivery date and budget
  – Sprint
     • A time-boxed iteration, max is 1 month
     • Consist of Sprint Planning Meeting, development work, Sprint
       Review, Sprint Retrospective
     • One after other, no time in between Sprints
  – Sprint Planning Meeting
     • Iteration is planned, 8 hours for 1 month Sprint
     • What/How: top priority Product Backlog/Team decides work
     • Sprint Goal: objective through Product Backlog implementation
                                                                           38

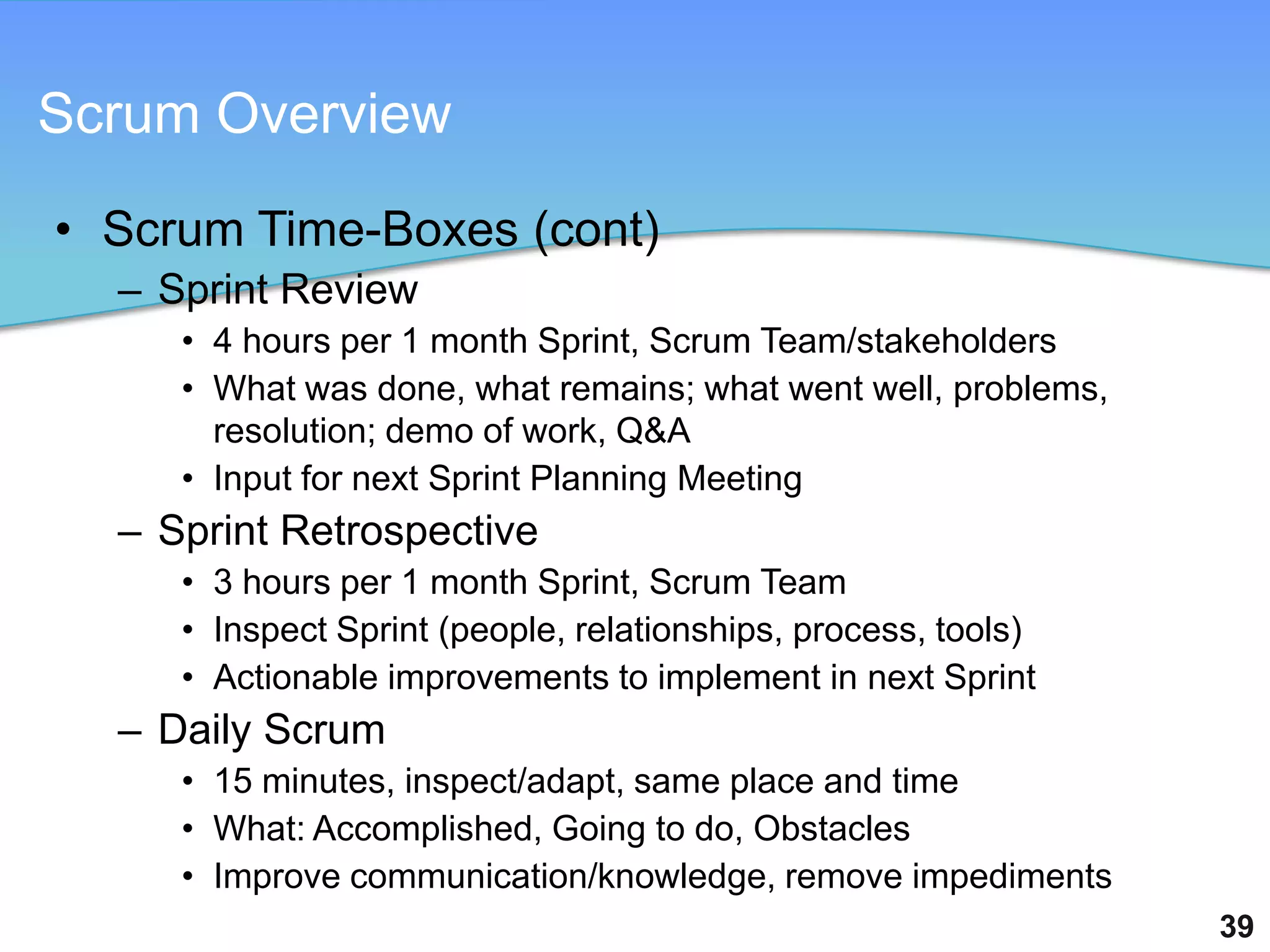

Scrum Overview

• Scrum Time-Boxes (cont)
  – Sprint Review
     • 4 hours per 1 month Sprint, Scrum Team/stakeholders
     • What was done, what remains; what went well, problems,
       resolution; demo of work, Q&A
     • Input for next Sprint Planning Meeting
  – Sprint Retrospective
     • 3 hours per 1 month Sprint, Scrum Team
     • Inspect Sprint (people, relationships, process, tools)
     • Actionable improvements to implement in next Sprint
  – Daily Scrum
     • 15 minutes, inspect/adapt, same place and time
     • What: Accomplished, Going to do, Obstacles
     • Improve communication/knowledge, remove impediments
                                                                39

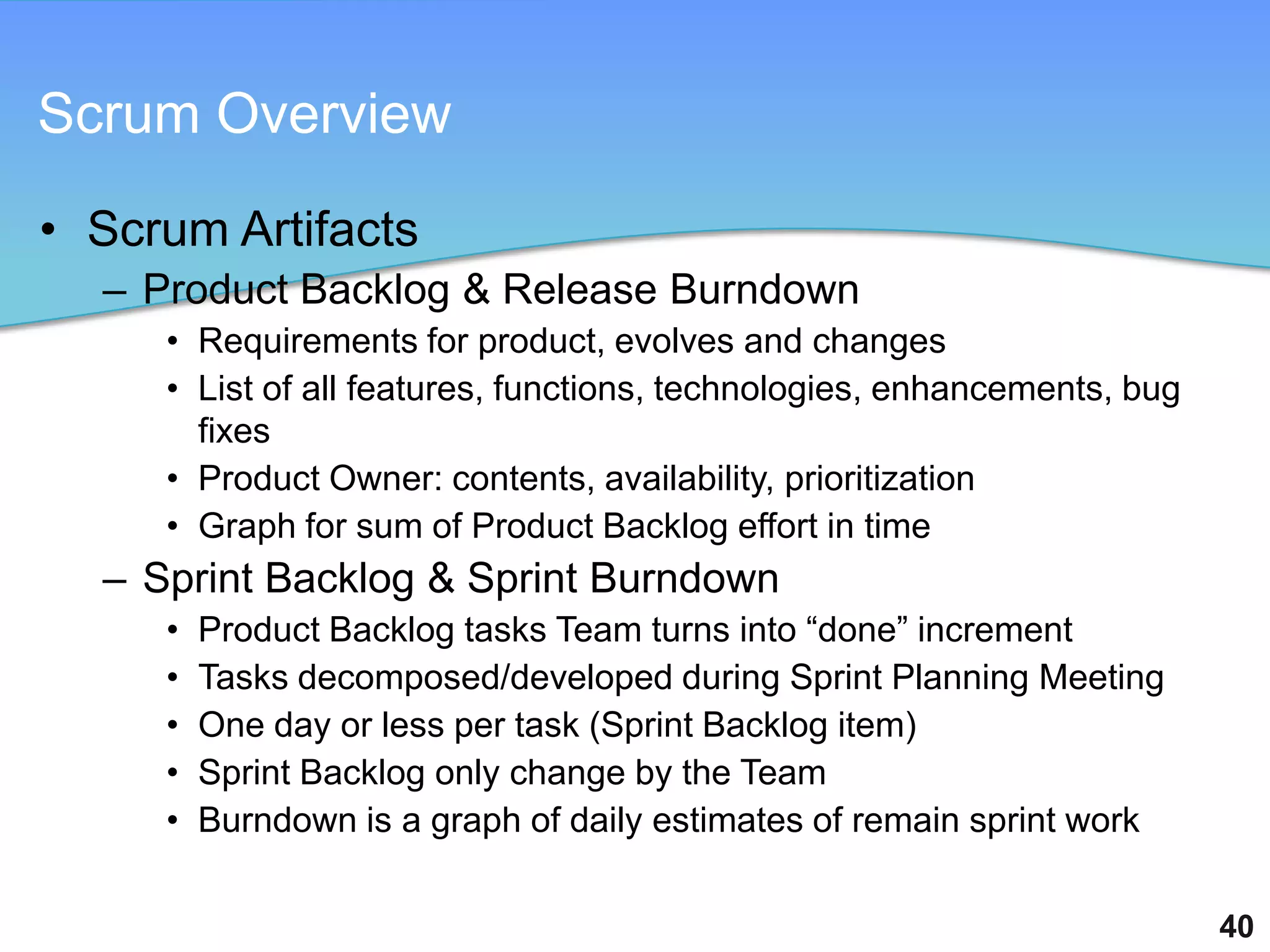

Scrum Overview

• Scrum Artifacts
  – Product Backlog & Release Burndown
     • Requirements for product, evolves and changes
     • List of all features, functions, technologies, enhancements, bug
       fixes
     • Product Owner: contents, availability, prioritization
     • Graph for sum of Product Backlog effort in time
  – Sprint Backlog & Sprint Burndown
     •   Product Backlog tasks Team turns into “done” increment
     •   Tasks decomposed/developed during Sprint Planning Meeting
     •   One day or less per task (Sprint Backlog item)
     •   Sprint Backlog only change by the Team
     •   Burndown is a graph of daily estimates of remain sprint work

                                                                          40
Scrum Overview

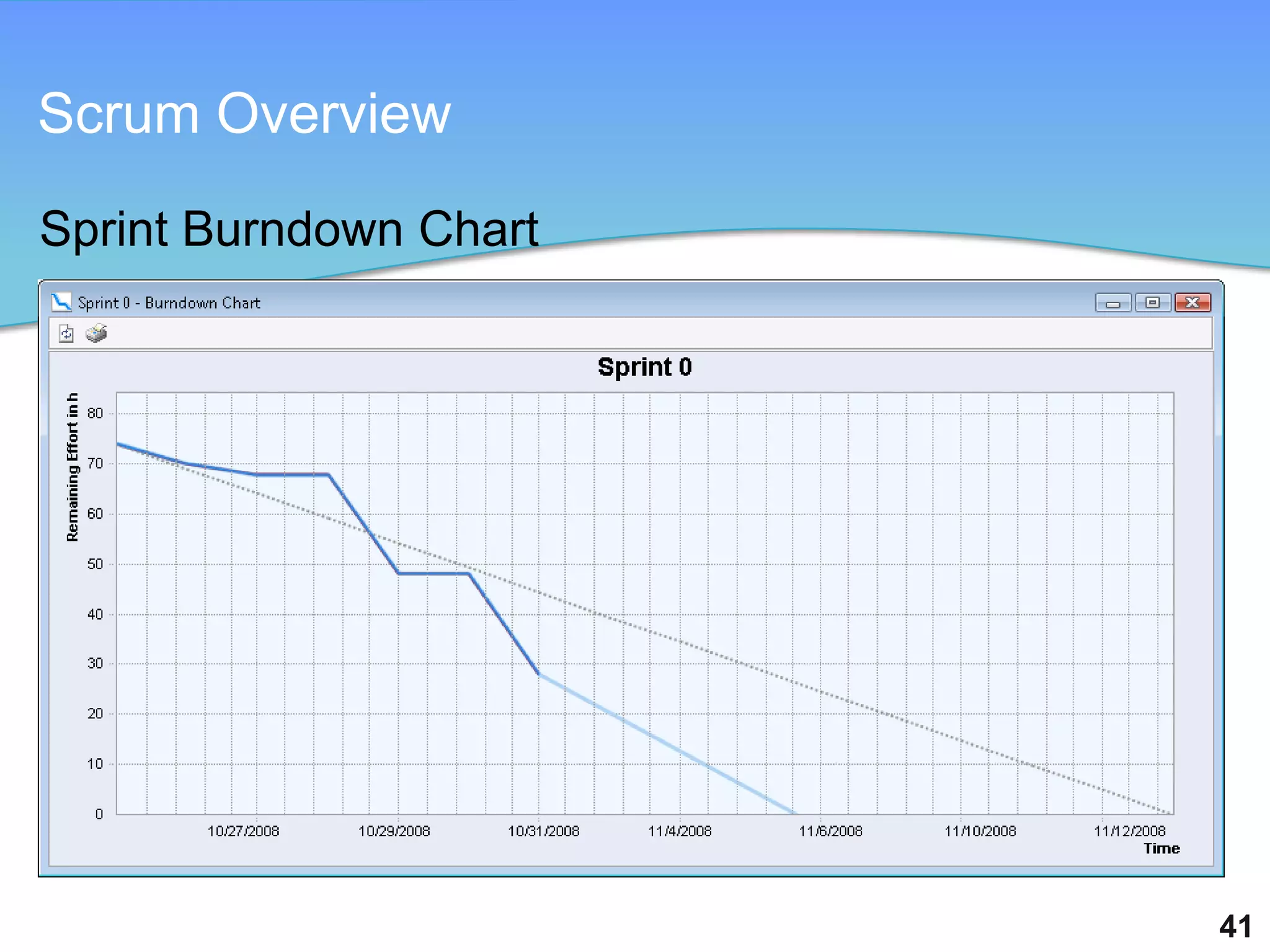

Sprint Burndown Chart

                        41

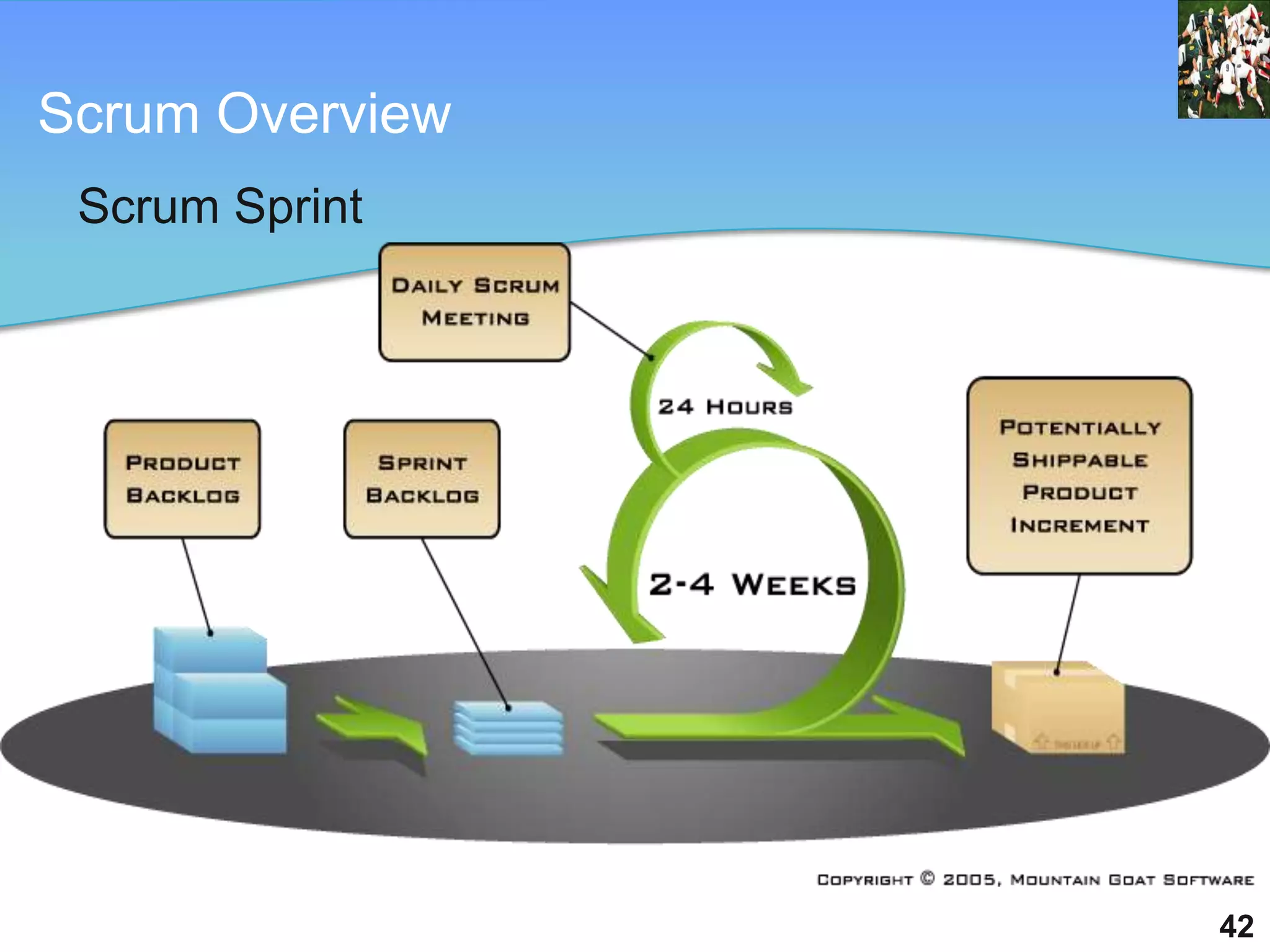

Scrum Overview
 Scrum Sprint

                 42

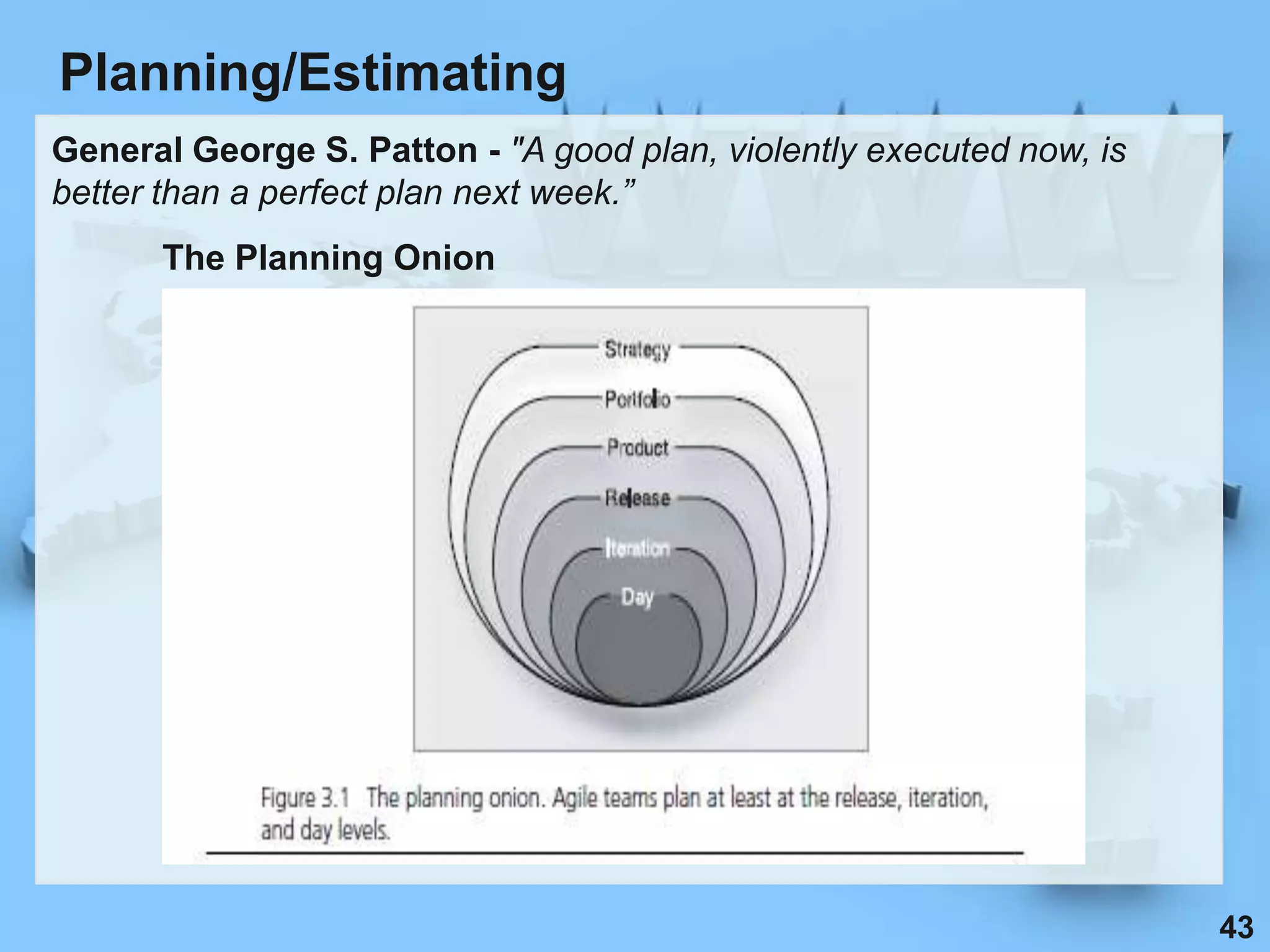

Planning/Estimating
General George S. Patton - "A good plan, violently executed now, is
better than a perfect plan next week.”
      The Planning Onion

                                                                      43
Planning/Estimating
 Pre-planning points
• Organizations culture
• IT infrastructure investment
• Sponsor / Management commitment
• Project selection
• Agile team selection
• Training needed
• Expert access
• Project only assignment
• Mandatory documentation

                                    44
Planning/Estimating

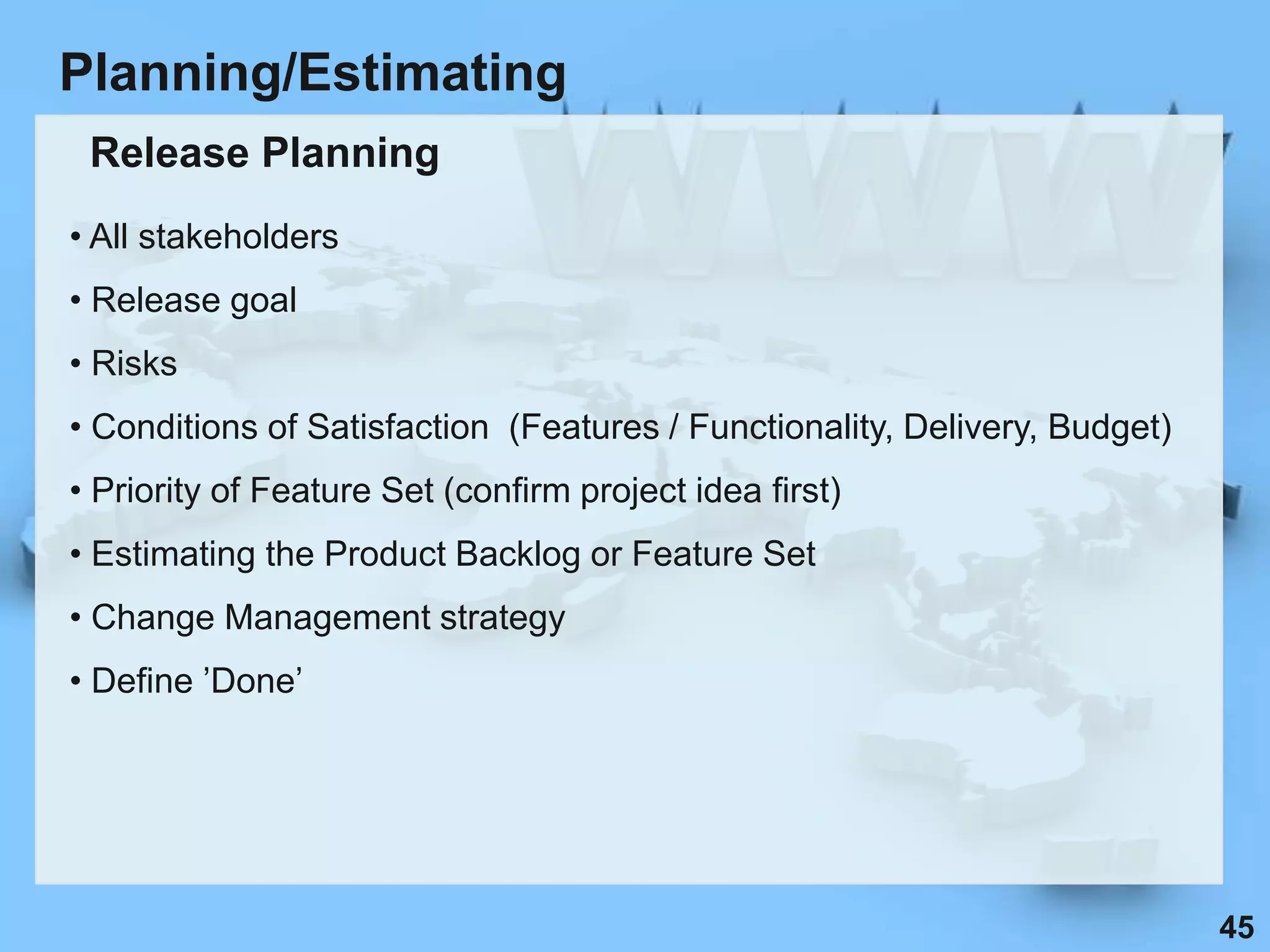

 Release Planning
• All stakeholders
• Release goal
• Risks
• Conditions of Satisfaction (Features / Functionality, Delivery, Budget)
• Priority of Feature Set (confirm project idea first)
• Estimating the Product Backlog or Feature Set
• Change Management strategy
• Define ‟Done‟

                                                                            45
Planning/Estimating
 Iteration Planning
• Daily Stand-up (Time/Place)
• Technical process
• Tools discussion (code migration, QA, project management, Backlog)
• Iteration timebox
• Capacity of team
• Backlog priority (client: ”more of this, less of that”)
• Tasks to complete Product Backlog item
• Size of Product Backlog item
• Velocity (previous iterations/sprints)

                                                                       46
Planning/Estimating
 Daily Planning
• Inspect and Adapt meeting
• Accomplishments
• Going to accomplish
• Impediments in the way
• Coordinate individual activities
• Wrap-up

                                     47
Planning/Estimating

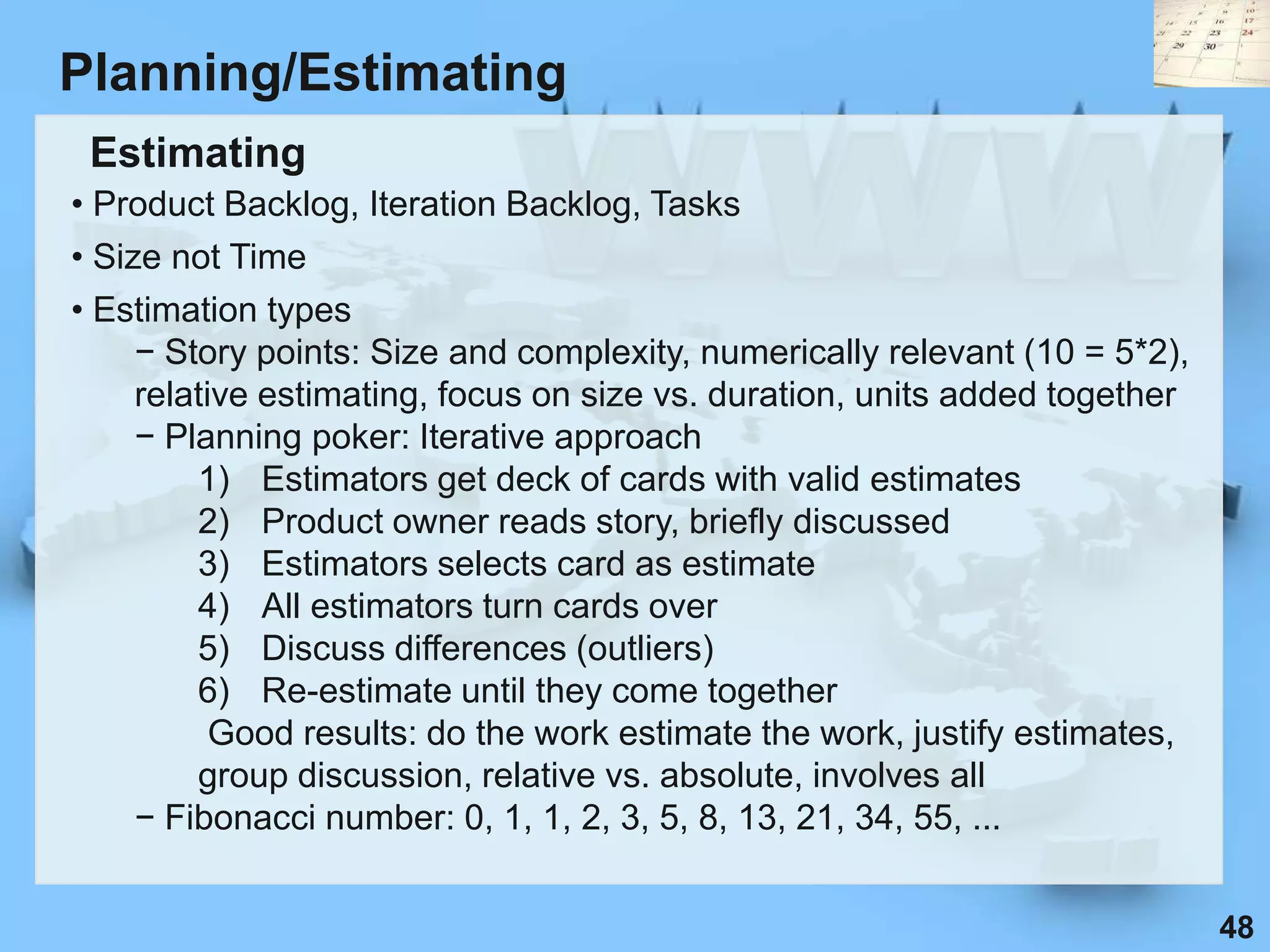

 Estimating
• Product Backlog, Iteration Backlog, Tasks
• Size not Time
• Estimation types
     − Story points: Size and complexity, numerically relevant (10 = 5*2),
     relative estimating, focus on size vs. duration, units added together
     − Planning poker: Iterative approach
         1) Estimators get deck of cards with valid estimates
         2) Product owner reads story, briefly discussed
         3) Estimators selects card as estimate
         4) All estimators turn cards over
         5) Discuss differences (outliers)
         6) Re-estimate until they come together
           Good results: do the work estimate the work, justify estimates,
         group discussion, relative vs. absolute, involves all
     − Fibonacci number: 0, 1, 1, 2, 3, 5, 8, 13, 21, 34, 55, ...

                                                                             48
Build Delivery
Coding Practices

• Pair Programming
    – Typing, Reading, Both Thinking; discuss often, instant review, helps
      inexperienced developers, accountability, collaboration
• No Code Ownership
    – Anyone can review and fix code; inexperienced limitations
• Code/Test
    – Automate tests; „smoke tests‟, integration testing; raise visibility
• Test First Design
    – Writing code against test for requirements; think through design
• Refactoring
    – Improve readability and maintainability; reduce complexity
                                                                             49

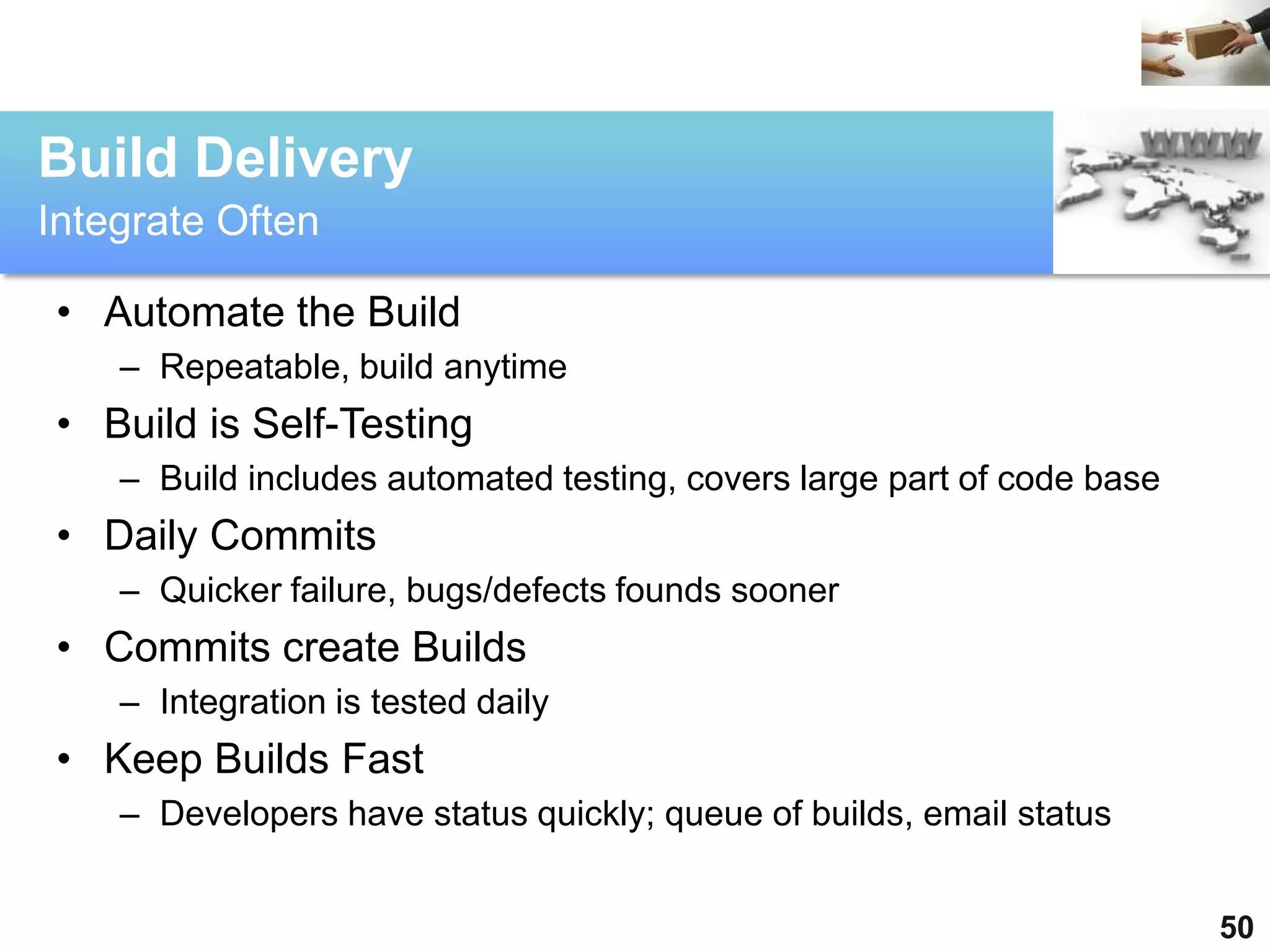

Build Delivery
Integrate Often

 • Automate the Build
    – Repeatable, build anytime
 • Build is Self-Testing
    – Build includes automated testing, covers large part of code base
 • Daily Commits
    – Quicker failure, bugs/defects founds sooner
 • Commits create Builds
    – Integration is tested daily
 • Keep Builds Fast
    – Developers have status quickly; queue of builds, email status

                                                                         50
Tools
• Consulting firm
   – Agile transformation
   – All parts of organization
• Agile Coaches
   – Understanding of Agile processes; ease transition for team
   – Directory at: Agile Alliance and Scrum Alliance
• Project Management
   – Built for Agile (hosted/on-premise; high cost/low cost)
   – Agile templates, dashboards
• Build/Test
   – Integration, comparison; code evaluation, modeling, bug isolation
• Vendors/Products
   – Rally Software, CollabNet, IBM, Microsoft, JUnit/XUnit,
     ScrumWorks, Electric Cloud, OpenMake Software

                                                                         51
Tools

        52
Agile Success
  Impact

• Organization
   − For holistic success devote attention downstream
   − Manifesto implies organization (customer, business people,
     feedback)
   − Greater role in decision making, product outcome
   − Better collaboration with other departments
• Organization Tips
   −   Pick one problem to solve
   −   Don‟t forget governance and regulatory requirements
   −   Incentives and Rewards
   −   Customer interaction with departments

                                                                  53

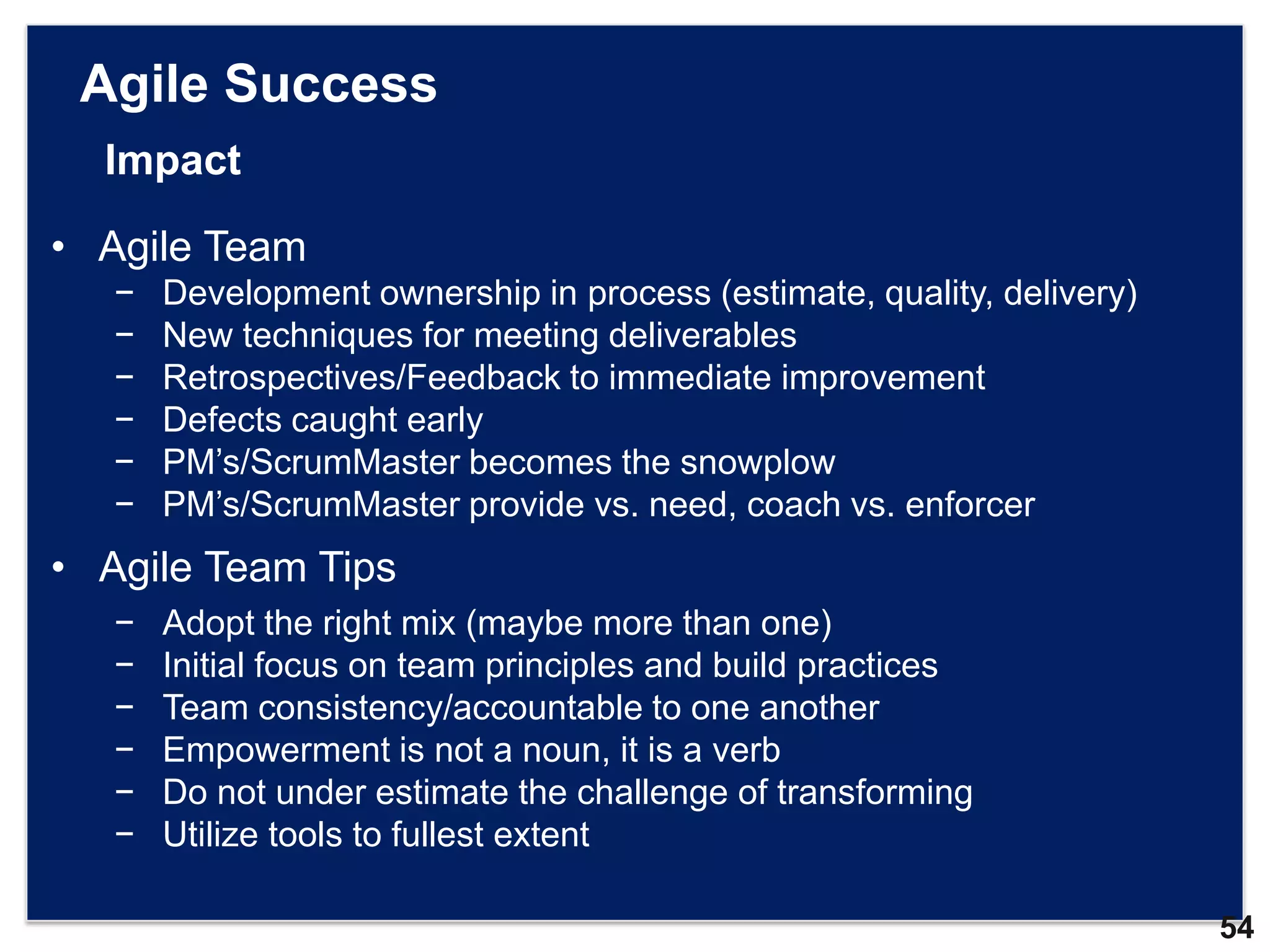

Agile Success
  Impact

• Agile Team
   −   Development ownership in process (estimate, quality, delivery)
   −   New techniques for meeting deliverables
   −   Retrospectives/Feedback to immediate improvement
   −   Defects caught early
   −   PM‟s/ScrumMaster becomes the snowplow
   −   PM‟s/ScrumMaster provide vs. need, coach vs. enforcer
• Agile Team Tips
   −   Adopt the right mix (maybe more than one)
   −   Initial focus on team principles and build practices
   −   Team consistency/accountable to one another
   −   Empowerment is not a noun, it is a verb
   −   Do not under estimate the challenge of transforming
   −   Utilize tools to fullest extent

                                                                        54
Agile Success
  Full Potential

• Needs
   −   Assessment plan
   −   Support plan (training, coaches, management)
   −   Balance business needs with technical
   −   Realize change effects all moving parts
   −   Smaller teams, self managed, reduced silos
   −   New skills, automate the routine
• Results
   −   More transparent organization
   −   Realistic product horizons
   −   Better moral
   −   Reduced time to market
   −   Quality improvement
   −   Less surprises
   −   Higher customer satisfaction
                                                      55
Buzzwords

• Done
   – Shippable increment of product containing all Product Backlog for
     the increment
   – Must be additive to all prior increments
   – Defined by Team, Product Owner informed
• Continuous Integration
   – Integrating of code by team members at a frequent pace (daily)
   – Can produce numerous builds daily (10 team members = 10 builds)
• Kanban
   – A Lean Manufacturing “Pull” process developed by Toyota
   – Software development used the same process with a physical task
     board (To Do, In Progress, Done, etc.)
                                                                         56
Resources
• People
   − Kent Beck, Jeff Sutherland, Tobias Mayer, Mike Beedle,
   Ken Schwaber, Peter Hundermark, Jim Highsmith
• Books
   − Succeeding with Agile, Agile Estimating Planning, Scrum
   and XP from the Trenches, Continuous Delivery, Agile
   Software Development with Scrum, Agile Coaching
• Organizations
   − Agile Alliance, Scrum Alliance, Scrum.org, PMI
• Websites
   − (See Organizations), Google, Amazon, Forrester,
   AgileJournal, MountainGoatSoftware, AgileManifesto.org,
   ExtremeProgramming.org, LinkedIn(groups), tech related

                                                               57
Sources
• Certified ScrumMaster Training, Conscires Agile Practices
• http://agilemanifesto.org/
• Scrum, Jeff Sutherland/Ken Schwaber, http://www.scrum.org, Feb. 2010
• Do Better Scrum, Peter Hundermark, ScrumSense, Nov. 2009
• The Truth About Agile Process, Carey Schwaber, Forrester, Aug. 2007
• The Forrester Wave: Agile Development Management Tools Q2 2010,
Dave West/Jeffrey Hammond, Forrester, May 2010
• From Agile Development To Agile Engagement, Tom Grant, Forrester,
May 2009
• Agile Development: Mainstream Adoption Has Changed Agility, Dave
West/Tom Grant, Forrester, Jan. 2010

                                                                         58
Sources
• Agile Estimating and Planning, Mike Cohn, Prentice Hall, Nov. 2005
• Planning and Tracking Agile Projects, Mike Cohn, Mountain Goat
Software, March 2007
• Agile Project Management: Estimating the Unknown, Rick Freedman,
TechRepublic, June 2009
• Agile Success Factors, Jeff Langr/Tim Ottinger,
agileinaflash.blogspot.com, July 2010
• New Patterns of Agile Adoption, Mike Cohn, Agile Journal, Jan. 2008
• Introduction an Agile Process to an Organization, Mike Cohn/Doris Ford,
IEEE, June 2003
• Scaling Up: An Approach to Organizational Agile Adoption, Ross Pettit,
Agile Journal, Nov. 2006
                                                                            59
Sources
• Key Success Factors in Top-Down Agile Adoption, Ross Pettit, Agile
Journal, March 2007
• The Agile Heartbeat, John Graham-Cumming, Electric Cloud, 2009
• Best Practices for Implementing Agile Methods: A Guide for Department
of Defense Software Developers, Ann Fruhling/Alvin Tarrell, University of
Nebraska at Omaha, 2008
• Selecting an Agile Process: Choosing Among the Leading Alternatives,
Mike Cohn, Mountain Goat Software, Sept. 2004
• An Introduction to Agile Modeling, Scott Ambler, Ambysoft, 2006
• Feature-Driven Development, Peter Coad/Eric Lefebvre/Jeff De Luca,
Java Modeling in Color with UML, Prentice Hall, June 1999
• http://www.microtool.de/instep/en/prod_scrum_edition.asp
                                                                            60
THANK YOU!

Agile Development Product Delivery For Successful Organizations

  • 1.
    Agile Development: Product Delivery for Successful Organizations Marc Crudgington © Copyright Pacific Technology Consulting Group, LLC
  • 2.
    Interactive Agenda: Pick aTopic Framework vs. Process Agile Types Scrum Estimating/Planning Buzzwords Resources Agile Iterative or Principles Predictive Adopting Agile Build Delivery Impediments Agile Success Evolution Tools 2
  • 3.
  • 4.
    Bio / Info • Career – US Air Force, 3Com, ONI/Ciena, Mortgage/Countrywide, KPMG, Jefferson Wells, Autobytel, ASM • Entrepreneurship – Adventure Travel, Consulting, Mortgage, Consulting • Education – MBA, BBA, ACS, AEE • Certifications – PMP, CSM, TOGAF, ITIL, ISS, CISM, CISA • Personal – Married to Maricris 01/2004, Two boys: Jake 5 / Luke 2 4
  • 5.
    Framework vs. Process Framework Process • Set of principles with no parent- • Prescriptive and linear series of child relationship which within steps taken to repeatedly activities are performed. generate the same output. • Not all components required to • All components used be used • It is a sequence / same order • Not always used in the same • Structured order • PMBOK (Project Management • Less structured Body of Knowledge), Waterfall • Agile 5
  • 6.
    Iterative or Predictive Predictive • Characteristics – Plan driven, heavy load upfront, structured – Sequential, bureaucratic, change resistant – Design: intensive, 10%; Construction manual, 90% – End result pre-determined • Steps – Idea, Requirement, Design, Construct, Integrate, Test, Implement, Maintain 6
  • 7.
    Iterative or Predictive Predictive • Use when – Project familiar – Inexperienced developers – Project team is large and project is complex – Thoroughly documented, demands order – Predictability versus change, requirements stable • IMO – Civil engineering, Construction – Maybe government, government contractors, pharma? 7
  • 8.
    Iterative or Predictive Iterative • Characteristics – Ambiguity okay, code oriented, adaptable – Welcome change, feedback, people vs. process – Design: creative, 80%; Construction automate, 20% – End result evolving • Steps – Brainstorm/plan, Development, Deliver, Feedback 8
  • 9.
    Iterative or Predictive Iterative • Use when – Project evolves or a little unknown – Accept change – Team small; strategies for large/split – Rapid change can occur • IMO – Information Technology 9
  • 10.
    Iterative or Predictive Comparison Agile Waterfall Informal/Incremental Documented/Steps Teamwork/Collaboration Individual Continuous Integration End or Milestones Light process Heavy process Open door Limited Cross trained Segmented Active developers Developers sit and wait No surprises at end Validate requirements QA helps produce QA certifies Empowerment Controlling Best app for customer Satisfy requirements, contracts 10
  • 11.
    Agile Principles Manifesto for Agile Software Development We are uncovering better ways of developing software by doing it and helping others do it. Through this work we have come to value: Individuals and interactions over processes and tools Working software over comprehensive documentation Customer collaboration over contract negotiation Responding to change over following a plan That is, while there is value in the items on the right, we value the items on the left more. 11
  • 12.
    Agile Principles Principles behind the Agile Manifesto We follow these principles: 1. Our highest priority is to satisfy the customer through early and continuous delivery of valuable software. 2. Welcome changing requirements, even late in development. Agile processes harness change for the customer's competitive advantage. 3. Deliver working software frequently, from a couple of weeks to a couple of months, with a preference to the shorter timescale. 4. Business people and developers must work together daily throughout the project. 5. Build projects around motivated individuals. Give them the environment and support they need, and trust them to get the job done. 6. The most efficient and effective method of conveying information to and within a development team is face-to-face conversation. 12
  • 13.
    Agile Principles Principles behind the Agile Manifesto (cont.) 7. Working software is the primary measure of progress. 8. Agile processes promote sustainable development. The sponsors, developers, and users should be able to maintain a constant pace indefinitely. 9. Continuous attention to technical excellence and good design enhances agility. 10. Simplicity--the art of maximizing the amount of work not done--is essential. 11. The best architectures, requirements, and designs emerge from self-organizing teams. 12. At regular intervals, the team reflects on how to become more effective, then tunes and adjusts its behavior accordingly. 13
  • 14.
    Agile Principles Authors of the Agile Manifesto Kent Beck Ron Jeffries Mike Beedle Jon Kern Arie van Bennekum Brian Marick Alistair Cockburn Robert C. Martin Ward Cunningham Steve Mellor Martin Fowler Ken Schwaber James Grenning Jeff Sutherland Jim Highsmith Dave Thomas Andrew Hunt 14
  • 15.
  • 16.

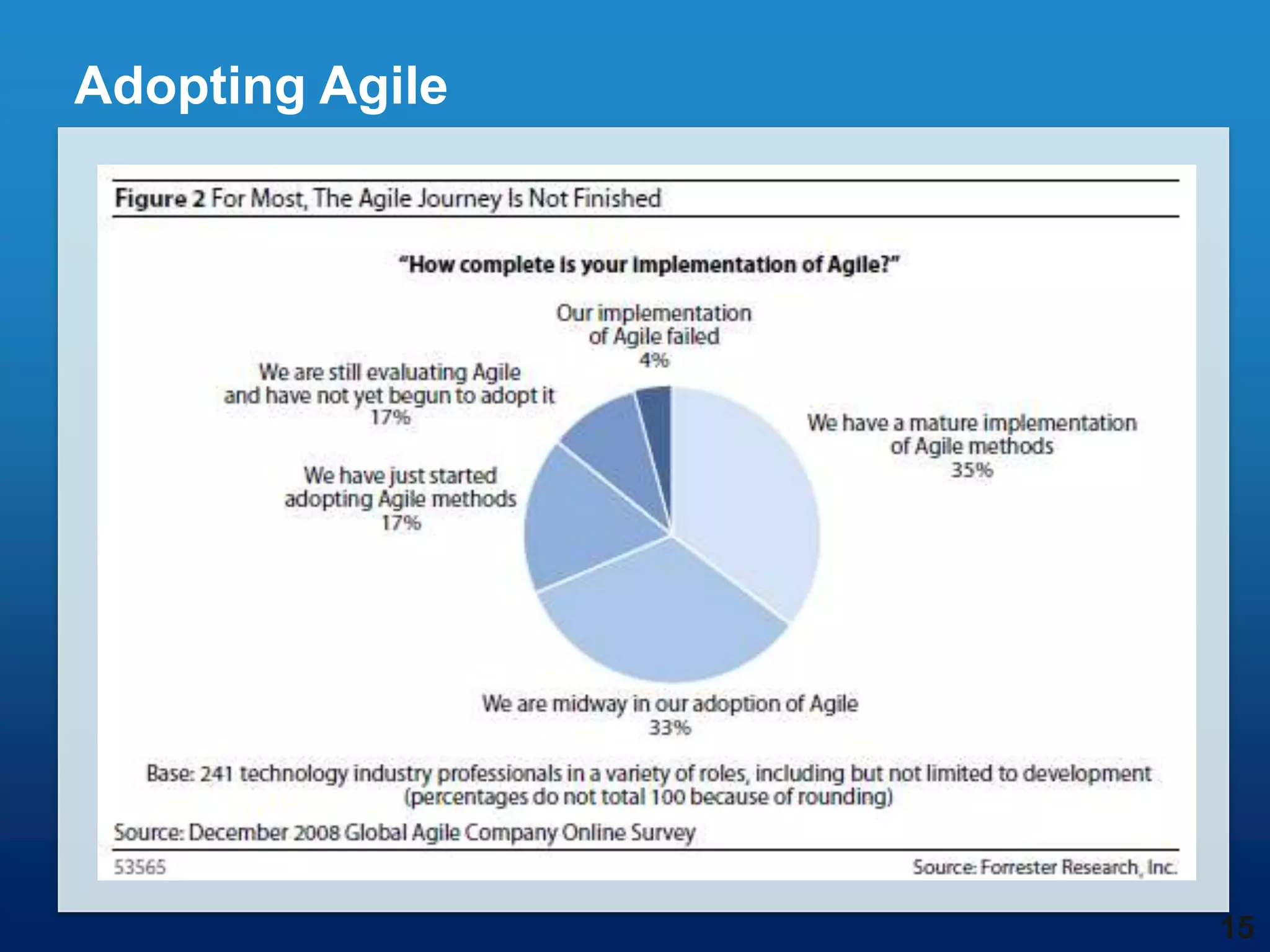

    Adopting Agile Success Factors • Business problem to solve − Goal to achieve; visible • Freedom to change − No micromanaging; right people in, wrong people moved • Engergized team − Familiar with; team spirit; about product/goal • Customer communication − Dedicated; gets ‟it‟; respected in organization • Collaboration − must work together; fight the ”PC glare” • Quality focused − up front; clean; embodied in the product; automate • Incrementalism − JIT features; small chunks; task-by-task 16
  • 17.
    Adopting Agile Adoption Patterns • Start Small − Pilot team; >$ for mistakes, success optimized, experts − False hope, takes longer, sign of non-commitment, two types • All In − All teams; management commitment, quicker, one type − Risk, cost, reorg (?), stress • Technical Practices First − Concentrate on how to develop; quicker transition − More difficult, costly, less user-centric thinking • Iterative First − Concentrate on the repetitive cycles; less resistence, easier − May not adopt necessary engineering processes 17
  • 18.
    Adopting Agile Adoption Patterns(cont.) • Stealth Mode − Kept to the Agile team; focus on success, less distractions − No org support, skeptics • Times Square Approach − Communicated; success incentive, support, out skeptics − Announce then fail, skeptic disruption, ‟vendor wolves‟ Organizational Effects • Developers; micromanage/freedom/talent | no forethought • Management; new features, progress, impact, project end • HR; receive complaints, corrective action, • Marketing; feature announcement, release date, left out 18
  • 19.
    Adopting Agile Top-Down Bottom-Up Organization sponsored Department/Project sponsored Visibility Fewer Monday Morning QB‟s Executive strength Focused pressure Central change team Freedom to define change Execution consistency Time to learn, refine process More measurable Still measurable Business problem solution Appropriate business problem • Communication • Best practice / learn from Agile Coach • Tools to assist • Raise the bar • Plan for management and governance 19
  • 20.
    Impediments Organization Team • Management control • Agile knowledge • Department resistance • Work in silos • Trust in team/process • Individual resistance • Investment required • Proper tools • Unrealistic expectations • Documentation requirements • Customer commitments • Management support 20
  • 21.
  • 22.
  • 23.
    Agile Types Am I Agile? Adaptive, empowered, self-organizing Absence of phases Individuals and Interactions Use of minimal planning Scalable Continuous process refinement Iterative and incremental Working Working software measured in progress software Artifacts are minimized Customer Customer involvement throughout Collaboration Adaptive, empirical customer relationship Responding to Emergent requirements Change Frequent inspection 23
  • 24.
    Agile Types FDD (Feature-Driven Development) • Characteristics − UML modeling focused, iterative, testing absent, small teams • Processes − Develop an overall model − Build a Features List Done Sequentially − Plan by Feature − Design by Feature Done Iteratively − Build by Feature • Best Practices − Domain Object Modeling, Feature Teams, Visible Progress, Developing By Feature, Inspections, Individual Class Ownership, Regular Builds, Configuration Management − Requires all 8 to be FDD 24
  • 25.
    Agile Types FDD (Feature-Driven Development) • Features − Primary unit of coding − Similar to XP User Stories or Scrum Product Backlog − Completed within two weeks • Feature Set − Collection of features − Assigned to a Chief Programmer and team • Major Feature Set − A domain area, one or more feature sets 25
  • 26.
    Agile Types Am I Agile? Adaptive, empowered, self-organizing Not so much Absence of phases No Individuals and Interactions Use of minimal planning No Scalable Yes Continuous process refinement Not so much Iterative and incremental Somewhat Working Working software measured in progress No software Artifacts are minimized Somewhat Customer Customer involvement throughout Yes Collaboration Adaptive, empirical customer relationship Yes Responding to Emergent requirements No Change Frequent inspection Yes 26
  • 27.
    Agile Types Agile Modeling • Characteristics − Collection of values, principles, and practices − Meant to be tailored into other methodologies • Values − Communication, Simplicity, Feedback, Courage, Humility • Principles − Assuming simplicity (modeling), embracing change (working), incremental change (agility), rapid feedback (reflects needs), model with a purpose (know) − multiple models (for intellect), travel light (discard), content (many ways), communication (open/honest), quality (focus) 27
  • 28.
  • 29.
    Agile Types Am I Agile? Adaptive, empowered, self-organizing Somewhat Absence of phases Yes Individuals and Interactions Use of minimal planning Yes Scalable Yes Continuous process refinement Somewhat Iterative and incremental Somewhat Working Working software measured in progress Yes software Artifacts are minimized Yes Customer Customer involvement throughout Yes Collaboration Adaptive, empirical customer relationship Yes Responding to Emergent requirements Yes Change Frequent inspection Yes 29
  • 30.
    Agile Types XP (Extreme Programming) • Characteristics − Collection of values and practices − 1 – 4 week iterations, all dials set to “10” − Stories (functionality), on-site customers − UNIT TESTING, simplest thing − YAGNI (You Aren‟t Gonna Need It) • Values − Simplicity: what is needed and asked for, no more − Communication: face to face, daily; work together on everything − Feedback: every iteration seriously delivering working software; listen change as needed; adapt process to project − Respect: everyone contributes; developers respect customers vice versa; management respects authority over work − Courage: truth about project/estimates; no fear no one works alone; adapt to changes 30
  • 31.
    Agile Types XP (ExtremeProgramming) Workflow 31
  • 32.
    Agile Types Am I Agile? Adaptive, empowered, self-organizing Somewhat Absence of phases Yes Individuals and Interactions Use of minimal planning Yes Scalable Yes Continuous process refinement Mostly Iterative and incremental Yes Working Working software measured in progress Yes software Artifacts are minimized Yes Customer Customer involvement throughout Yes Collaboration Adaptive, empirical customer relationship Yes Responding to Emergent requirements Yes Change Frequent inspection Yes 32
  • 33.
    Agile Types Scrum • Characteristics − Framework or Method NOT a Process or Technique − Self organizing teams − Progress in month-long or less “Sprints” (iterations) − Requirements are “Product Backlog” − Engineering “Free for Team” − Rules to maintain / be Agile on project • Scrum Team − 7 to 11 members optimal (PO, SM, Team) − Full-time i.e. devoted to Scrum Team; exc. Sys Admin − Change only between Sprints • Etc. − Sprint/Stabilization Sprint: Design, code, test − NO CHANGES during Sprints…take your scope creep and… − Few artifacts, Burndown charts 33
  • 34.
    Agile Types Am I Agile? Adaptive, empowered, self-organizing Somewhat Absence of phases Yes Individuals and Interactions Use of minimal planning Yes Scalable Yes Continuous process refinement Yes Iterative and incremental Yes Working Working software measured in progress Yes software Artifacts are minimized Yes Customer Customer involvement throughout Yes Collaboration Adaptive, empirical customer relationship Yes Responding to Emergent requirements Yes Change Frequent inspection Yes 34
  • 35.
    Scrum Overview • ScrumHistory – Presented 1995, Jeff Sutherland/Ken Schwaber – Not a process or technique, framework (within you can employ processes/techniques • Scrum Theory – Empirical process control: continuous cycle of inspection for correct operation, adapt as needed – Three pillars for implementation • Transparency: affect the outcome is visible to those managing; what is being seen must be known • Inspection: to detect unacceptable variances; skill/diligence • Adaption: adjustment of unacceptable variances; quickly; Daily Scrum, Sprint Review & Planning meetings; Sprint Retrospective 35
  • 36.
    Scrum Overview • ScrumContent – Scrum Team • ScrumMaster, Product Owner, the Team – Time-Boxes • Release Planning Meeting, Sprint Planning Meeting, Sprint, Daily Scrum, Sprint Review, Sprint Retrospective – Artifacts • Product Backlog, Sprint Backlog, Release Burndown, Sprint Burndown – Rules • Connect/unite each: Scrum time-boxes, roles, and artifacts • Rule: Daily Scrums last only 15 minutes • Rule: Only the Team talks during Daily Scrums 36
  • 37.
    Scrum Overview • ScrumTeam – Product Owner • One person only • Manages Product Backlog, ensures value of work • Tip: product manager or business function manager – ScrumMaster • Coaches Scrum Team / organization, removes impediments • Upholds Scrum values, practices, rules • Tip: works to identify and instantiate Product Owner – Team • Developers • Tip: 7 optimal, + or – 2 is okay 37
  • 38.
    Scrum Overview • ScrumTime-Boxes – Release Planning Meeting • Establishes: plan and goals, high priority Product Backlog, major risks, features/functionality • Sets probable delivery date and budget – Sprint • A time-boxed iteration, max is 1 month • Consist of Sprint Planning Meeting, development work, Sprint Review, Sprint Retrospective • One after other, no time in between Sprints – Sprint Planning Meeting • Iteration is planned, 8 hours for 1 month Sprint • What/How: top priority Product Backlog/Team decides work • Sprint Goal: objective through Product Backlog implementation 38
  • 39.
    Scrum Overview • ScrumTime-Boxes (cont) – Sprint Review • 4 hours per 1 month Sprint, Scrum Team/stakeholders • What was done, what remains; what went well, problems, resolution; demo of work, Q&A • Input for next Sprint Planning Meeting – Sprint Retrospective • 3 hours per 1 month Sprint, Scrum Team • Inspect Sprint (people, relationships, process, tools) • Actionable improvements to implement in next Sprint – Daily Scrum • 15 minutes, inspect/adapt, same place and time • What: Accomplished, Going to do, Obstacles • Improve communication/knowledge, remove impediments 39
  • 40.
    Scrum Overview • ScrumArtifacts – Product Backlog & Release Burndown • Requirements for product, evolves and changes • List of all features, functions, technologies, enhancements, bug fixes • Product Owner: contents, availability, prioritization • Graph for sum of Product Backlog effort in time – Sprint Backlog & Sprint Burndown • Product Backlog tasks Team turns into “done” increment • Tasks decomposed/developed during Sprint Planning Meeting • One day or less per task (Sprint Backlog item) • Sprint Backlog only change by the Team • Burndown is a graph of daily estimates of remain sprint work 40
  • 41.
  • 42.
  • 43.
    Planning/Estimating General George S.Patton - "A good plan, violently executed now, is better than a perfect plan next week.” The Planning Onion 43
  • 44.
    Planning/Estimating Pre-planning points •Organizations culture • IT infrastructure investment • Sponsor / Management commitment • Project selection • Agile team selection • Training needed • Expert access • Project only assignment • Mandatory documentation 44
  • 45.
    Planning/Estimating Release Planning •All stakeholders • Release goal • Risks • Conditions of Satisfaction (Features / Functionality, Delivery, Budget) • Priority of Feature Set (confirm project idea first) • Estimating the Product Backlog or Feature Set • Change Management strategy • Define ‟Done‟ 45
  • 46.
    Planning/Estimating Iteration Planning •Daily Stand-up (Time/Place) • Technical process • Tools discussion (code migration, QA, project management, Backlog) • Iteration timebox • Capacity of team • Backlog priority (client: ”more of this, less of that”) • Tasks to complete Product Backlog item • Size of Product Backlog item • Velocity (previous iterations/sprints) 46
  • 47.
    Planning/Estimating Daily Planning •Inspect and Adapt meeting • Accomplishments • Going to accomplish • Impediments in the way • Coordinate individual activities • Wrap-up 47
  • 48.
    Planning/Estimating Estimating • ProductBacklog, Iteration Backlog, Tasks • Size not Time • Estimation types − Story points: Size and complexity, numerically relevant (10 = 5*2), relative estimating, focus on size vs. duration, units added together − Planning poker: Iterative approach 1) Estimators get deck of cards with valid estimates 2) Product owner reads story, briefly discussed 3) Estimators selects card as estimate 4) All estimators turn cards over 5) Discuss differences (outliers) 6) Re-estimate until they come together Good results: do the work estimate the work, justify estimates, group discussion, relative vs. absolute, involves all − Fibonacci number: 0, 1, 1, 2, 3, 5, 8, 13, 21, 34, 55, ... 48
  • 49.
    Build Delivery Coding Practices •Pair Programming – Typing, Reading, Both Thinking; discuss often, instant review, helps inexperienced developers, accountability, collaboration • No Code Ownership – Anyone can review and fix code; inexperienced limitations • Code/Test – Automate tests; „smoke tests‟, integration testing; raise visibility • Test First Design – Writing code against test for requirements; think through design • Refactoring – Improve readability and maintainability; reduce complexity 49
  • 50.
    Build Delivery Integrate Often • Automate the Build – Repeatable, build anytime • Build is Self-Testing – Build includes automated testing, covers large part of code base • Daily Commits – Quicker failure, bugs/defects founds sooner • Commits create Builds – Integration is tested daily • Keep Builds Fast – Developers have status quickly; queue of builds, email status 50
  • 51.
    Tools • Consulting firm – Agile transformation – All parts of organization • Agile Coaches – Understanding of Agile processes; ease transition for team – Directory at: Agile Alliance and Scrum Alliance • Project Management – Built for Agile (hosted/on-premise; high cost/low cost) – Agile templates, dashboards • Build/Test – Integration, comparison; code evaluation, modeling, bug isolation • Vendors/Products – Rally Software, CollabNet, IBM, Microsoft, JUnit/XUnit, ScrumWorks, Electric Cloud, OpenMake Software 51
  • 52.
  • 53.
    Agile Success Impact • Organization − For holistic success devote attention downstream − Manifesto implies organization (customer, business people, feedback) − Greater role in decision making, product outcome − Better collaboration with other departments • Organization Tips − Pick one problem to solve − Don‟t forget governance and regulatory requirements − Incentives and Rewards − Customer interaction with departments 53
  • 54.
    Agile Success Impact • Agile Team − Development ownership in process (estimate, quality, delivery) − New techniques for meeting deliverables − Retrospectives/Feedback to immediate improvement − Defects caught early − PM‟s/ScrumMaster becomes the snowplow − PM‟s/ScrumMaster provide vs. need, coach vs. enforcer • Agile Team Tips − Adopt the right mix (maybe more than one) − Initial focus on team principles and build practices − Team consistency/accountable to one another − Empowerment is not a noun, it is a verb − Do not under estimate the challenge of transforming − Utilize tools to fullest extent 54
  • 55.
    Agile Success Full Potential • Needs − Assessment plan − Support plan (training, coaches, management) − Balance business needs with technical − Realize change effects all moving parts − Smaller teams, self managed, reduced silos − New skills, automate the routine • Results − More transparent organization − Realistic product horizons − Better moral − Reduced time to market − Quality improvement − Less surprises − Higher customer satisfaction 55
  • 56.
    Buzzwords • Done – Shippable increment of product containing all Product Backlog for the increment – Must be additive to all prior increments – Defined by Team, Product Owner informed • Continuous Integration – Integrating of code by team members at a frequent pace (daily) – Can produce numerous builds daily (10 team members = 10 builds) • Kanban – A Lean Manufacturing “Pull” process developed by Toyota – Software development used the same process with a physical task board (To Do, In Progress, Done, etc.) 56
  • 57.
    Resources • People − Kent Beck, Jeff Sutherland, Tobias Mayer, Mike Beedle, Ken Schwaber, Peter Hundermark, Jim Highsmith • Books − Succeeding with Agile, Agile Estimating Planning, Scrum and XP from the Trenches, Continuous Delivery, Agile Software Development with Scrum, Agile Coaching • Organizations − Agile Alliance, Scrum Alliance, Scrum.org, PMI • Websites − (See Organizations), Google, Amazon, Forrester, AgileJournal, MountainGoatSoftware, AgileManifesto.org, ExtremeProgramming.org, LinkedIn(groups), tech related 57
  • 58.
    Sources • Certified ScrumMasterTraining, Conscires Agile Practices • http://agilemanifesto.org/ • Scrum, Jeff Sutherland/Ken Schwaber, http://www.scrum.org, Feb. 2010 • Do Better Scrum, Peter Hundermark, ScrumSense, Nov. 2009 • The Truth About Agile Process, Carey Schwaber, Forrester, Aug. 2007 • The Forrester Wave: Agile Development Management Tools Q2 2010, Dave West/Jeffrey Hammond, Forrester, May 2010 • From Agile Development To Agile Engagement, Tom Grant, Forrester, May 2009 • Agile Development: Mainstream Adoption Has Changed Agility, Dave West/Tom Grant, Forrester, Jan. 2010 58
  • 59.
    Sources • Agile Estimatingand Planning, Mike Cohn, Prentice Hall, Nov. 2005 • Planning and Tracking Agile Projects, Mike Cohn, Mountain Goat Software, March 2007 • Agile Project Management: Estimating the Unknown, Rick Freedman, TechRepublic, June 2009 • Agile Success Factors, Jeff Langr/Tim Ottinger, agileinaflash.blogspot.com, July 2010 • New Patterns of Agile Adoption, Mike Cohn, Agile Journal, Jan. 2008 • Introduction an Agile Process to an Organization, Mike Cohn/Doris Ford, IEEE, June 2003 • Scaling Up: An Approach to Organizational Agile Adoption, Ross Pettit, Agile Journal, Nov. 2006 59
  • 60.
    Sources • Key SuccessFactors in Top-Down Agile Adoption, Ross Pettit, Agile Journal, March 2007 • The Agile Heartbeat, John Graham-Cumming, Electric Cloud, 2009 • Best Practices for Implementing Agile Methods: A Guide for Department of Defense Software Developers, Ann Fruhling/Alvin Tarrell, University of Nebraska at Omaha, 2008 • Selecting an Agile Process: Choosing Among the Leading Alternatives, Mike Cohn, Mountain Goat Software, Sept. 2004 • An Introduction to Agile Modeling, Scott Ambler, Ambysoft, 2006 • Feature-Driven Development, Peter Coad/Eric Lefebvre/Jeff De Luca, Java Modeling in Color with UML, Prentice Hall, June 1999 • http://www.microtool.de/instep/en/prod_scrum_edition.asp 60
  • 61.
