Introduction                                     A Usability Study of www.soundtracktoyour.com
                                                 by James Maclean

The current Environment
There are many on-line and off-line              What is missing is a way to explore               The way I have described the functionality
applications out there that can make and         memories in the way that people more              of memory is based on ancient greet
sort and share playlists and also allow you      naturally negate them inside their heads.         theory that saw its first renaissance with the
to listen to music and a usable way. Most of     Where they begin at either a place or time        Romans and more recently detailed in Yates,
the services out there at the moment have        which provokes a cascade of other sensory         Frances A. (1966). The Art of Memory.
solved the issue of musical inspiration by       perceptions all at once.
having a “similar artists” portion to explore.
Similar artists features are normal governed     Effective memory and more specifically
by a database comparing profiles of musical      recall has a weighting towards spaces. By
taste filtered by music genres.                  that I mean that most of our memories are
                                                 linked more to spaces than other variable.
Some of the most popular services are:           Peoples memories of time are actualy more
 •	 Spotify                                      conceptual than factual. For instance when
 •	 iTunes                                       recounting even recent events people will
                                                 often tell the story in the wrong order, the
 •	 Deezer                                       order of events comes out in a way that was
 •	 Soundcloud                                   most meaning full to them. As time goes
                                                 on this effect is transfered to larger portions
                                                 of time. A great example of this is to ask a
                                                 parent who’s children have grown up to tell
                                                 some stories about when their child was
                                                 young. They will be able to group stories
                                                 into key stages but I doubt they will be able
                                                 to accurately tell you in which order the
                                                 events happened even with vivid memories.

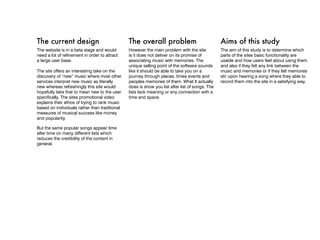

The current design                             The overall problem                              Aims of this study
The website is in a beta stage and would       However the main problem with the site           The aim of this study is to determine which
need a lot of refinement in order to attract   is it does not deliver on its promise of         parts of the sites basic functionality are
a large user base.                             associating music with memories. The             usable and how users feel about using them
                                               unique selling point of the software sounds      and also if they felt any link between the
The site offers an interesting take on the     like it should be able to take you on a          music and memories or if they felt memories
discovery of “new” music where most other      journey through places, times events and         stir upon hearing a song where they able to
services interpret new music as literally      peoples memories of them. What It actually       record them into the site in a satisfying way.
new whereas refreshingly this site would       does is show you list after list of songs. The
hopefully take that to mean new to the user    lists lack meaning or any connection with a
specifically. The sites promotional video      time and space.
explains their ethos of trying to rank music
based on individuals rather than traditional
measures of musical success like money
and popularity.

But the same popular songs appear time
after time on many different lists which
reduces the credibility of the content in
general.

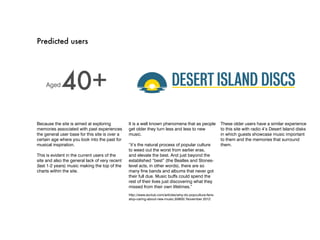

Predicted users

    Aged     40+
Because the site is aimed at exploring          It is a well known phenomena that as people              These older users have a similar experience
memories associated with past experiences       get older they turn less and less to new                 to this site with radio 4’s Desert Island disks
the general user base for this site is over a   music.                                                   in which guests showcase music important
certain age where you look into the past for                                                             to them and the memories that surround
musical inspiration.                            “it’s the natural process of popular culture             them.
                                                to weed out the worst from earlier eras,
This is evident in the current users of the     and elevate the best. And just beyond the
site and also the general lack of very recent   established “best” (the Beatles and Stones-
(last 1-2 years) music making the top of the    level acts, in other words), there are so
charts within the site.                         many fine bands and albums that never got
                                                their full due. Music buffs could spend the
                                                rest of their lives just discovering what they
                                                missed from their own lifetimes.”
                                                http://www.avclub.com/articles/why-do-popculture-fans-
                                                stop-caring-about-new-music,55805/ November 2012
Methodology

Order of events
Each session will start with an introduction      Then next three tasks will follow the same       The tasks will be in a random order to
where the participants will:                      structure but will be completed in a different   counteract users learning the site as the
 •	 sign a consent form                           order for each consecutive participant           session continues.
 •	 be given an overview of the study             to reduce the effect of learning on the
                                                  test results.                                    After the sessions are finished I will mark
 •	 adjust the seating position to one they                                                        Errors, Time on Task, Task Success and
    are comfortable with                          After the three tasks the participants will      Assists whilst watching the recording of
 •	 configure the mouse sensitivity and the       then be asked to complete a final                the session. This is done after as doing so
    direction of the scroll wheel to one they     questionnaire about the site in general.         during the sessions may put participants on
    are familiar with                                                                              edge seeing me write something down every
 •	 learn about the “think aloud” protocol                                                         time they make a mistake.
 •	 complete a pre-task questionnaire
                                                  The order of tasks for each participant:
The first task will then begin with reading the
printed task card and when I am sure they                                 First          Second           Third           Fourth
understand the task we will begin recording       Participant 1                          Task 2          Task 3           Task 4
the session and work through the task. The        Participant 2                          Task 3          Task 4           Task 2
task be followed by a short questionnaire.        Participant 3                          Task 4          Task 2           Task 3
                                                  Participant 4                          Task 2          Task 3           Task 4
                                                                        Task 1
                                                  Participant 5                          Task 3          Task 4           Task 2
                                                  Participant 6                          Task 4          Task 2           Task 3
                                                  Participant 7                          Task 2          Task 3           Task 4
                                                  Participant 8                          Task 3          Task 4           Task 2
Users                                             Session setup
I will aim to make the group of participants      I will be using a piece of software called
as representative of the predicted users as       Silverback to record the sessions. The
possible by making selections based mostly        software records a head and shoulders
on age. When looking for participants I           shot of the participant, audio as well as
gave a preference to people over the age          capturing the screen and highlights mouse
of 30 and more preference the older they          clicks. This software can be controlled with
got. But as the enjoyment of music is a           a remote control which means I wont have
fairly universal thing no specific criteria are   to lean over the users to pause and stop the
needed to take park in the study.                 recording.

To make the group more representative of          The users will all use the same
the larger population I will make sure to have    laptop and mouse.
an equal number of males to females.
                                                  The questionnaires will all be filled in online
                                                  via Google documents. The tabs will all be
                                                  open in the browser ready to be filled in, the
                                                  reason for doing this twofold, it helps to let
                                                  the users know what stage in the session
                                                  they are and also shows a quick reference
                                                  on the video which task the user is currently
                                                  on when scanning the footage.
 46­55
                                                                       over 55

                                                                   How do you generally buy music *
                                                                       CD
11/29/12                                       PRE ‑ task 1
                                                                       itunes

Pre-Task questions
     PRE ­ task 1
                                                                       other digital
                                                                       other phisical
                                                                                                                                                 These questions
           * Required
                                                                                                                                                 will be asked before
           Participant number *                                    How often do you seek out music you have not heard before? *                  the recording starts
           Filled out by test conductor
                                                                       Never                                                                     the aim here is to
                                                                       Rarely                                                                    see if there is any
                                                                       Ocassionaly                                                               correlation with the
           What is your gender? *                                      All the time
                                                                                                                                                 information provided
               Male                                                                                                                              here and how the
               Female
                                                                                                                                                 users behave. It is
                                                                   If never or rarely then why not more often?                                   also a chance to
               Other
                                                                                                                                                 catch any opinions
                                                                                                                                                 before the test starts.
           What is your age? *
               18­24
               25­34
               35­45
               46­55
               over 55                                             If occasionally or all the time then how do you find music?
                                                      11/29/12                                           PRE ‑ task 1
                                                      https://docs.google.com/a/jqim.co.uk/spreadsheet/viewform?formkey=dGJKZGRvNlJidm5ObU5sR…               1/2

           How do you generally buy music *
               CD
               itunes
               other digital
               other phisical

                                                                     Submit
           How often do you seek out music you have not heard before? *
               Never                                               Powered by Google Docs
               Rarely
                                                                   Report Abuse ­ Terms of Service ­ Additional Terms
               Ocassionaly
               All the time

           If never or rarely then why not more often?

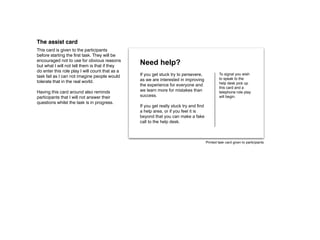

The assist card
This card is given to the participants
before starting the first task. They will be
encouraged not to use for obvious reasons
but what I will not tell them is that if they

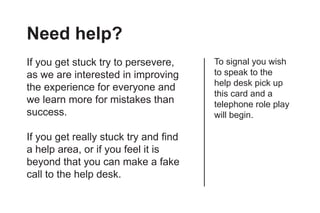

                                                 Need help?
do enter this role play I will count that as a
task fail as I can not imagine people would      If you get stuck try to persevere,             To signal you wish
                                                 as we are interested in improving              to speak to the
tolerate that in the real world.                                                                help desk pick up
                                                 the experience for everyone and
                                                                                                this card and a
Having this card around also reminds             we learn more for mistakes than                telephone role play
participants that I will not answer their        success.                                       will begin.
questions whilst the task is in progress.
                                                 If you get really stuck try and find
                                                 a help area, or if you feel it is
                                                 beyond that you can make a fake
                                                 call to the help desk.

                                                                                        Printed task card given to participants
Task 1
Make an account with STTY
This task serves 2 functions, the first is to   There will be no limit on this task and                                              Critical path
ease the participants into the idea of being    although it will be recorded it I do not
in a test situation and the “think aloud        predict any significant findings in this area                                          login / signup
protocol” so they feel warmed up and give       as how to make an effective login and sign
a more natural response to the other tasks.     up is a well documented affair and not the
The second function is that a lot of the        focus of this study.
sites best features will be more effectively                                                                                          my soundtracks

explored if the user has their own account.
This is because memory is a personal thing
and I feel the participants will not commit                                                                                           open my voice
enough emotional to the site without
their own space on the site to express
themselves. I will ask them to create an
account and add the following info:                                                                                                     edit profile

                                                      Task 1
•	 Display Name
•	 Bio                                                Sign up for soundtracktoyour.com             To indicate you are
                                                                                                   finished please tell
•	 First Name                                         You have decided to explore                  the conductor
                                                                                                   “I’m finished”
•	 Last Name                                          a new site for discovering and
•	 Gender                                             sharing music.
•	 Country
                                                      You wish to sign up and then add
•	 Occupation                                         relevant details about you to your
                                                      area within the site.

                                                                                           Printed task card given to participants

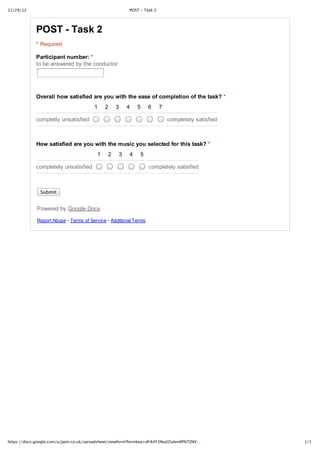

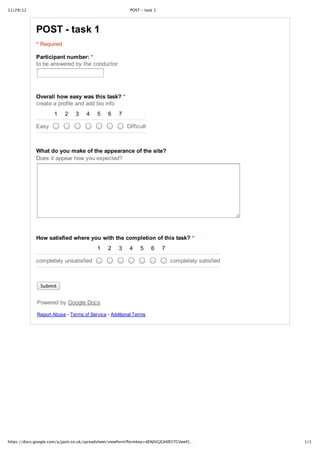

11/29/12                                             POST ‑ task 1
Post Task 1 questions
                      POST ­ task 1                                                                        After the task users
                                                                                                           will be asked how
                      * Required                                                                           well the interface lets
                      Participant number: *                                                                them record their
                      to be answered by the conductor                                                      personal info and
                                                                                                           how satisfying it was.

                      Overall how easy was this task? *
                      create a profile and add bio info
                             1     2   3    4    5    6    7

                      Easy                                     Difficult

                      What do you make of the appearance of the site?
                      Does it appear how you expected?

                      How satisfied where you with the completion of this task? *
                                                 1    2    3    4    5     6    7

                      completely unsatisfied                                        completely satisfied

                       Submit

                      Powered by Google Docs

                      Report Abuse ­ Terms of Service ­ Additional Terms

Task 2

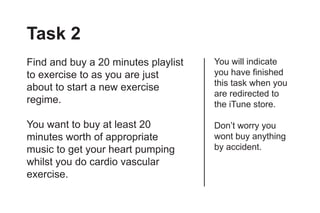

Find a playlist to exercise to
Users will be given a scenario where they         The reason for wanting a 20 min long playlist
have just decided upon a new exercise             is that by default only the first 3 tracks                                       Critical path
regime and heard that the right music can         appear in the lists and you have to click

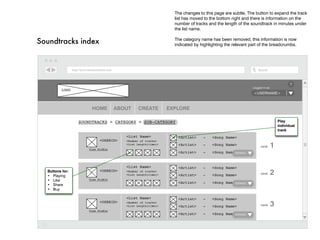

make all the difference. They now wish to         “expand” so 3 songs generally wont be 20
                                                                                                                                     soundtracks
find the right music for them to listen to        mins in total length so this forces the users
whilst doing cardio vascular exercise for 20      to seek out longer playlists.
min and have turned to STTY to find music
and then buy it from iTunes.                                                                                                          a workout
                                                                                                                                      category

The function of this task is to test how easy
it is to buy music from the site as the type
                                                                                                                                     preview tack
of music required is fairly well defined. i.e.
music to exercise to is nearly always uplifting
and faster paced so should downplay the
subjective decision of picking music and               Task 2                                                                         buy playlist
focus on the purchasing.
                                                       Find and buy a 20 minutes playlist         You will indicate
This task will have a limit of 5 mins and task         to exercise to as you are just             you have finished
                                                                                                  this task when you
completion will be recorded when they click            about to start a new exercise
                                                                                                  are redirected to
the correct buy button and are redirected              regime.                                    the iTune store.
to iTunes or the dialogue box warning of
another application opening appears.                   You want to buy at least 20                Don’t worry you
                                                       minutes worth of appropriate               wont buy anything
                                                       music to get your heart pumping            by accident.
                                                       whilst you do cardio vascular
                                                       exercise.

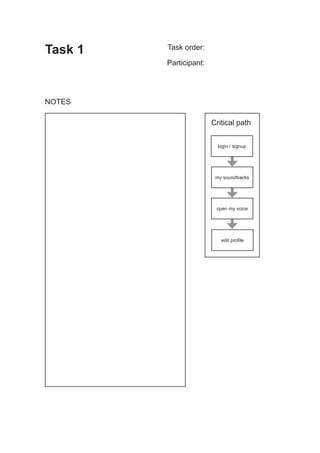

                                                                                         Printed task card given to participants
11/29/12                                             POST ‑ Task 2
Post Task 2 questions
                      POST ­ Task 2                                                                        After the task users
                                                                                                           will be asked how
                      * Required                                                                           satisfied they where
                      Participant number: *                                                                with the ease of
                      to be answered by the conductor                                                      completing the task
                                                                                                           and the music they
                                                                                                           found.
                      Overall how satisfied are you with the ease of completion of the task? *
                                                1    2    3    4    5      6    7

                      completly unsatisfied                                         completely satisfied

                      How satisfied are you with the music you selected for this task? *
                                                 1    2    3    4    5

                      completely unsatisfied                               completely satisfied

                       Submit

                      Powered by Google Docs

                      Report Abuse ­ Terms of Service ­ Additional Terms
Critical path

                                                                                                                             my soundtracks

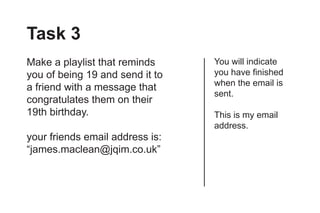

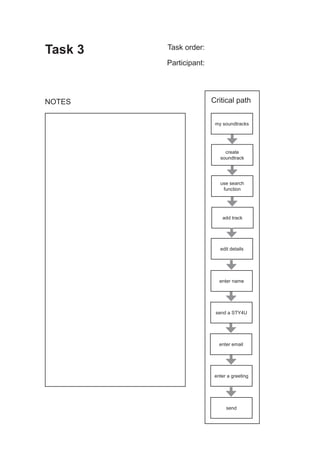

Task 3
                                                                                                                                 create
Make a playlist that reminds                                                                                                   soundtrack

you of being 19 and share it with a friend to
congratulate them on their own 19th birthday.                                                                                  use search
                                                                                                                                function
This is a fairly straight forward test of
what the site is centered around, creating
meaningful playlists and sharing. The twist is
the sharing part, how the users interpret the
                                                 Task 3                                                                         add track

second part of this task will show weather
the “STY4U” (musical e-card) function is         Make a playlist that reminds             You will indicate
                                                 you of being 19 and send it to           you have finished
recognized and used in.                                                                   when the email is                    edit details
                                                 a friend with a message that
                                                                                          sent.
This task will have a limit of 3 songs in the    congratulates them on their
playlist to save time and avoid salience. The    19th birthday.                           This is my email
person will be imaginary and they will be                                                 address.                             enter name

given my email address to send the result to.    your friends email address is:
Time on task will end when the email is sent.    “james.maclean@jqim.co.uk”
                                                                                                                             send a STY4U

                                                                                                                               enter email
                                                                                  Printed task card given to participants

                                                                                                                             enter a greeting

                                                                                                                                  send

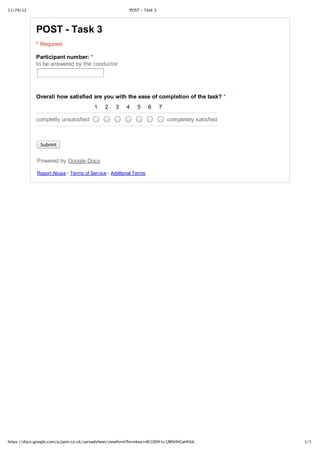

11/29/12                                             POST ‑ Task 3
Post Task 3 questions
                      POST ­ Task 3                                                                        After the task users
                                                                                                           will be asked how
                      * Required                                                                           satisfied they where
                      Participant number: *                                                                with the ease of
                      to be answered by the conductor                                                      completing the task.

                      Overall how satisfied are you with the ease of completion of the task? *
                                                1    2    3    4    5      6    7

                      completly unsatisfied                                         completely satisfied

                       Submit

                      Powered by Google Docs

                      Report Abuse ­ Terms of Service ­ Additional Terms
Task 4
Find out what music IT
professionals listen to
This task was originally meant to test one of   The task will have a time limit of 3 mins as
the promises made in the promotional video.     I know the answer will be ambiguous and I
“Find out what undertakers play at funerals”    don’t want the participants to spend to long
Until I realised this task was impossible to    looking for information that is not there.
                                                                                                                                     Critical path
complete not only because of the lack of
current users to populate the database, but
also as the only way to select an occupation                                                                                            users > all
is to select it from a rather short list of
ambiguous professions. I had to settle on
one of the few categories that has more
than one user “technology” and picked a
                                                     Task 4                                                                            occupation >
                                                                                                                                        technology

common job title that could be categorised
under it.                                            Find out what sort of music IT                You will indicate you
                                                     professionals listen to.                      have competed this
                                                                                                                                         a profile
                                                                                                   task when you tell the
This task is designed to find out how                                                              conductor what sort
people go about using the site to find               A curious friend has recently                 of music you think IT
detailed information. It is also to find out         asked you a burning question,                 professionals listen to.               view
how satisfied people are with the sites              what sort of music does the IT                                                    soundtracks

ability to help then find interesting musical        department listen to?
information. I have picked a profession
that comes under “technology” In the task            The conductor will play the part of
scenario the participants would have been            your curious friend.
asked to tell a curious friend the answer to
the question. I will ask users to tell me an
answer and use that as an indicator of task
                                                                                           Printed task card given to participants
completion.

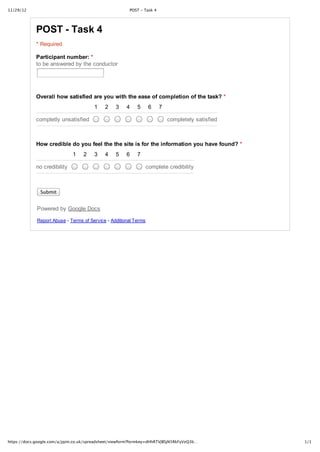

11/29/12                                             POST ‑ Task 4

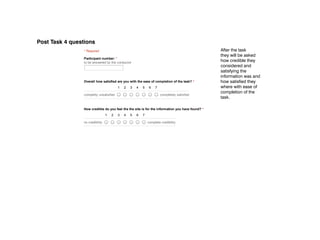

Post Task 4 questions
                 POST ­ Task 4
                     * Required                                                                           After the task
                                                                                                          they will be asked
                     Participant number: *
                     to be answered by the conductor
                                                                                                          how credible they
                                                                                                          considered and
                                                                                                          satisfying the
                                                                                                          information was and
                     Overall how satisfied are you with the ease of completion of the task? *             how satisfied they
                                               1    2    3    4    5       6   7                          where with ease of
                                                                                                          completion of the
                     completly unsatisfied                                         completely satisfied
                                                                                                          task.

                     How credible do you feel the the site is for the information you have found? *
                                      1   2    3    4    5    6    7

                     no credibility                                       complete credibility

                      Submit

                     Powered by Google Docs

                     Report Abuse ­ Terms of Service ­ Additional Terms
11/29/12                                            Post study questions

Post task questions
                 Post study questions
                     * Required                                                                                    After the 4 tasks
                                                                                                                   are complete
                     Participant number: *
                     to be answered by the conductor
                                                                                                                   participants will then
                                                                                                                   be asked to rate the
                                                                                                                   site overall.

                     Over all how satisfied where you with the ease of using the site? *
                                                1    2    3      4    5     6    7

                     completely unsatisfied                                          completely satisfied

                     Any other comments on the site in general?

                     Please indicate your level of agreement with this statement: *
                     "This site allow users to create meaning full playlists associated with memories past, present and
                     future."
                                            1    2    3   4      5     6    7

                     strongly dissagree                                         strongly agree

                      Submit

                     Powered by Google Docs

                     Report Abuse ­ Terms of Service ­ Additional Terms

Some of the data I collected has was not       These questions where to open ended and

Findings
                                                   relevant to the study so has not been shown    after conducting the study I shifted the focus
                                                   here. The missing data is from the following   of the study which rendered the answers to
                                                   questions:                                     these questions irrelevant.

                                                   •	 What is your gender?                        The answers where somewhat tainted by
                                                   •	 What is your age?                           my own poor conduct. The biggest mistake
                                                                                                  I made was not stressing the goals of the
                                                   •	 How do you generally buy music              study which left some users feeling like they
                                                   •	 How often do you seek out music you         would hurt my feelings if they answered
Summary                                               have not heard before?                      honestly.
The site has promise but is no where near          •	 What do you make of the appearance
usable.                                               of the site? Does it appear how you
Initial I did not expect that task 1 would yield      expected?
meaningful results but it was an are where         •	 How satisfied are you with the music you
all users struggled with.                             selected for this task?
                                                   •	 How credible do you feel the the site is
The redesigns later in this document focus            for the information you have found?
on the most common issues first.
                                                   •	 Any other comments on the site in
                                                      general?

The issues I have addressed are superficial
ones and I believe the site needs a more           •	 Over all how satisfied where you with the
defined direction in general and to re-asses          ease of using the site?
its core functions and goals.                      •	 Please indicate your level of agreement
                                                      with this statement: “This site allow
One user refused to carry on with the tasks           users to create meaning full playlists
after getting very frustrated with the site,          associated with memories past, present
he put is user name and password in a                 and future.”
total of 4 times and I would not say he was
being foolish at all. In fact he was a music
enthusiast, exactly the sort of person the site
should attract.
Task success data

                                                            Task success
                                                     0=fail 1=partial 2=success
    2 2       2                     2           2                          2 2 2           2                      2     2 2       2
                                                                                                                                           Task 1
          1                                 1                          1               1       1            1 1               1            Task 2
                                                                                                                                           Task 3
                    0 0 0 0             0            0 0 0 0                                       0    0
                                                                                                                                           Task 4
   Participant 1   Participant 2   Participant 3    Participant 4     Participant 5   Participant 6    Participant 7   Participant 8

Task success was recorded slightly                                  Task 3                                                             Participant 2 failed all the tasks due mostly
differently for each task but any task where                        A partial success on task 3 was recorded                           because of needing major assists.
users required a major assist (help desk role                       many times where users sent the email but
play) was marked as a fail.                                         not using the “STY4U” (musical e-card) also                        Participant 4 failed the first task after needing
                                                                    in one case the user sent the message to                           a major assist to find the area to edit the
Task 1                                                              the wrong person.                                                  profile. The rest of the tasks failed because
The users that got a partial success where                                                                                             he was so frustrated by the site he refused
                                                                                                                                       to do all the tasks.
ones who entered their date of birth wrong.                         Task 4
                                                                    It was not really possible to get a partial
Task 2                                                              success on task 4 as the answer was
A partial success on task 2 was recorded                            subjective.
when one user through they had bought and
album but actual purchased a single track.
Assistance data
                                                                                                                                           Only one user managed to
                                                         Minor Assists                                                                     resist looking at the help area
                                                       reference to help page                                                              to help them complete a task.
                                                                                                                                           Nearly everyone needed to
                   2
                                                                                                                                           look at the help to find out
                                                                                                                                           where the profile area even
                                                                                                                                  Task 1   was let alone how to edit it.
                                                                                                                                  Task 2
   1 1                 1 1             1 1         1               1               1 1       1     1
                                                                                                                                           With regards to task 1 most
                                                                                                                                  Task 3
                                                                                                                                           of the minor assists where a
                                                                                                                                  Task 4
                                                                                                                                           result of first the site crashing
         0 0                 0     0         0         0 0 0           0 0 0             0             0 0 0       0 0 0 0                 upon trying to edit the profile
  Participant 1   Participant 2   Participant 3   Participant 4   Participant 5   Participant 6   Participant 7   Participant 8
                                                                                                                                           and then being unable to
                                                                                                                                           navigate back to the profile
                                                                                                                                           area form the home page .
                                                         Major Assists                                                                     A couple of people needed
                                                         help desk role play
                                                                                                                                           major assists, I had to step in
                                                                                                                                           with participant 7 on the first
                       2                                                                                                                   task as they started to get
                                                                                                                                           quite upset.
                                                                                                                                  Task 1

                                                                                                                                  Task 2   Participant 2 needed a lot of
                   1       1 1                                                               1     1
                                                                                                                                  Task 3   help on all the tasks and on
                                                                                                                                  Task 4   one task needed to ask me for
   0 0 0 0                         0 0 0 0         0 0 0 0         0 0 0 0         0 0 0               0 0 0       0 0 0 0
                                                                                                                                           help twice on task 2.

  Participant 1   Participant 2   Participant 3   Participant 4   Participant 5   Participant 6   Participant 7   Participant 8
Error data
                                                                                                                                                              Everyone encountered errors
                                                                    Errors                                                                                    on the first task, when i set
                                                          deviation from critical path                                                                        out the study I did not expect
                                                                                                                                                              to find much out on this task
16

                                                                                                                                                              but after seeing the results
14
                                                                                                                                                          there are clearly major issues
                                                                                                                                                              with the users initial stages
12
                                                                                                                                                          with the site.
10
                                                                                                                                          Task
  1

                                                                                                                                                              The repeated errors on task 1
                                                                                                                                              Task
  2

  8
                                                                                                                                                         are the result of users going
                                                                                                                                              Task
  3
     in circles again and again
  6

                                                                                                                                              Task
  4
     unable to find the profile area
  4
                                                                                                                                                         even after consulting the help.
  2

                                                                                                                                                              Only one user managed to
  0
                                                                                                                                                         notice the sign-up button
          Participant 1      Participant 2    Participant 3   Participant 4   Participant 5   Participant 6   Participant 7   Participant 8                   hidden at the bottom of the
                                                                                                                                                              login screen.

                          Total errors per task                                                                                                               The next source of repeated
             56
                                                                                                                                                              errors was task 3. The reason
60
                                                                                                                                                              for these errors was the
50                                                                                                                                                            dragging function, that only
40
                                                                                                                                                              1 participant managed to
                                                                                                                                                              successfully figure out after
30                                     26                                                                                                                     getting very angry.
                                                                Total errors per task
                                                   20
20
                           11
10

  0
           Task 1         Task 2     Task 3      Task 4
Time on task data

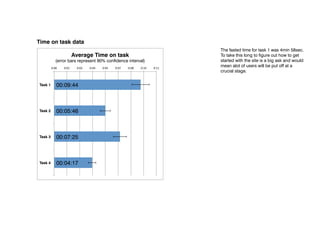

                                                                                                             The fasted time for task 1 was 4min 58sec.
                               Average Time on task                                                          To take this long to figure out how to get
              (error bars represent 90% confidence interval)                                                 started with the site is a big ask and would
         0:00
     0:01
      0:02
     0:04
     0:05
     0:07
     0:08
     0:10
     0:11

                                                                                                             mean alot of users will be put off at a
                                                                                                             crucial stage.

Task 1         00:09:44

Task 2         00:05:46

Task 3         00:07:25

Task 4         00:04:17

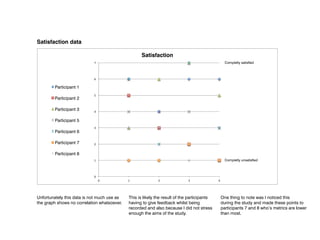

Satisfaction data

                                                     Satisfaction
                            7
                                                                       Completly satisfied

                            6

        Participant 1
                            5

        Participant 2

        Participant 3       4

        Participant 5
                            3

        Participant 6

        Participant 7       2

        Participant 8
                            1
                                                                       Completly unsatisfied

                            0

                                    0
      1
             2
              3
             4

Unfortunately this data is not much use as    This is likely the result of the participants       One thing to note was I noticed this
the graph shows no correlation whatsoever.    having to give feedback whilst being                during the study and made these points to
                                              recorded and also because I did not stress          participants 7 and 8 who’s metrics are lower
                                              enough the aims of the study.                       than most.
Table of issues
When analysing the recorded footage of the
sessions I found 40 unique usability issues.
I also noted which percipients experienced
the same issue and if issues where
experienced on different tasks.

I have given a cause and also a solution for
each issue.

I also recorded technical issues but did not
attempt to find solutions for them, except on
one case I made a suggestion. The full table
of issues can be read in the appendices.

We will now take a look at the issues found
in different areas of the site.
Issues found by 8 participants on www.soundtracktoyour.com
Issues on the Home page and genral site wide issues
The biggest problem was not being                    Although most people learned to live with it, not                                                                                                                                                                                      Participants                 Tasks
 Record
           Issues found by 88Cause
           Issues found by area.
able to navigate to the
 order
        Location                      participants on www.soundtracktoyour.comis problem.
                 Description profile participants on being able to use the back button(redesign recommendation)
                                                     www.soundtracktoyour.com    Solution                                                                                                                                                                                          1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4

 4        Global           frustration with help balloons        Help balloons obscure site and disappear before being read                                             click to remove and tick to not show again                                                                 1 1 1                   1 1 5 1 1

                                                                 Help area instructs users to start the STY4U process at the home page which one user could             Restructure of site navigation and repurpose of home page(see details and illustrations in
 18       Global           Difficulty navigating to STY4U                                                                                                                                                                                                                               1                          1        1
                                                                 not get to                                                                                             main document)                                                                                                      Participants                 Tasks
                                                                                                                                                                                                                                                                         Participants                Tasks
                                                                                                                                                              Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
 Record
 Record                    Difficulty finding created        The My Soundtracks pop out tab is not clear and shows categories that have no playlists so
 19
 order
           Location
          Location
           Global          Description
                          Description                           Cause
                                                              Cause                                                                                           Solution (redesign recommendation)
                                                                                                                                                     Solution (redesign created" when empty, once the user has more than a few then introduce the 4 5 1 2 3 ∑ t1 t2 t3 t4
                                                                                                                                                              soundtracks recommendation)                                                      1 2 3     6 1 8 4 5 6 7 8
                                                                                                                                                                                                                                                           7     1 1                                               ∑ t1 t2 t3 t4
                                                                                                                                                                                                                                                                                                                   3     1 1
 order                     soundtracks                       will not seem relevant also the profile area is difficult to find
                                                                                                                                                              sorting categories and only ones that are populated with created soundtracks, Also
 1
 4        Home
           Global        unsure if logged in
                           frustration with help balloons No direct balloons obscure status disappear before being read
                                                             Help indication of login site and                                                       have usernameto remove and tick to not page again
                                                                                                                                                              click displaythe search function to be redesigned to and turned into a more complicated 1
                                                                                                                                                                             top right on every show                                           1 1       1 1 1 4 1 1 1 1
                                                                                                                                                                                                                                                           1                                                       5 1 1
                                                                                                                                                              Would need
 30        Global          Can't search for years            No support for searching via time                                                                                                                                                                 1     1                                             2     1
                                                                                                                                                              function in itself.
 2
 18       Home
           Global        difficulty navigating to profile
                           Difficulty navigating to STY4U Confusing terminology " users to start the STY4U process at the home page which one user Click username to enter profile (see 1) and repurpose of home page(see details and illustrations in 1 1 1 1 5 1
                                                             Help area instructs my soundtracks"                                                      could Restructure of site navigation                                                     1           1                                                       1         1
                           My Soundtracks drawer largely Theget to
                                                             not displayed categories are to broad to have relevance to every task but this area is always    main document)Soundtracks pop out then introduce the sorting categories and only ones
                                                                                                                                                              Remove the My
 32        Global                                                                                                                                                                                                                                              1     1                                             2     1
                           useless                           around but serves no use as the drag function is unusable.                                       Removepopulated with created soundtracks, Also show the created soundtracks or "no
                                                                                                                                                              that are the My Soundtracks pop out or have it only
 3                         Difficulty finding created
          Login / Signup Difficulty on Sign up               The text Soundtracks pop out tab is not clear and shows categories that have no playlists so separate button for signup
                                                          Sign up My too small                                                                       clear                                                                                     1 1 1 1   1 1 1 7 1
 19        Global                                                                                                                                             soundtracks created" when empty, once the user has more than a not parts introduce the(see
                                                                                                                                                              menu rollovers should be only links to pages or specific functions few then of a function    1     1 1                                               3   1 1
 36        Global          soundtracks
                           Rollover is annoying              Thenot seem relevant alsoand contains to much and to difficult to make it disappear
                                                             will rollover is far to large the profile area is difficult is find                                                                                                                                 1   1                                             2 1   1
                                                                                                                                                              navigation redesign) only ones that are populated with created soundtracks, Also
                                                                                                                                                              sorting categories and
 4        Global         frustration with help balloons
 30       Global           Settings dropdown wont go Help balloons obscure site andvia time before being read
                           Can't search for years
                                                                                    disappear                                                                 click to remove and tick to not show again to be redesigned to and turned into a more complicated
                                                                                                                                                                         Would need the search function                                                1 1 1                            1 1 5 1 1
 39       Global                                        User are notfor searching to a toggle on and off action
                                                        No support expecting this                                                                                       make this a rollover or have it disappear after a second or 2
                                                                                                                                                                        function in itself.
                                                                                                                                                                                                                                                                                               1           1 1 1 1
                                                                                                                                                                                                                                                                                                               2             1
                           away
 5        Profile        can't find edit profiledrawer largely The displayed categories are to broad to have relevance to every task but this area is always"settings" and "edit profile" next to usernamethen introduce the sorting categories and only ones 1 1
                           My Soundtracks                   Edit profile is expected to be at top right with username                                  show     Remove the My Soundtracks pop out (see 1)                                           1     1 1                                  5 1
 32       Global                                                                                                                                                        Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
 11                        TECH
                           useless                               around but serves no use as the drag functionnotunusable.
                                                                 The regular back button on the browser does is work                                                    that are populated with created soundtracks, Also                                               1   1 1 1 1 1                              5 1 1 1 1
                                                                                                                                                                                                                                                                                                                   2
                                                                                                                                                                        still-work-ajax-page-loads
 6        Profile        CRASH                                “Begin creating your profile by clicking here.” link broken on profile page                     ?                                                                                           1           1 1   1 4 1
                                                                                                                                                                        menu rollovers should be only links to pages or specific functions not parts of a function (see
 36       Global           difficulty is annoying on how to The rollover is far to large and contains to much and is difficult to make it disappear
                           Rollover finding help                                                                                                                                                                                                                                1   1                              2 1       1
 15        Help                                             confusing terminology "Your VOICE"                                                                          navigation redesign)
                                                                                                                                                                        rename You VOICE with your profile at least in the help area                                      1         1                              2 1
 7        Profile        CRASH
                          edit profile                   Loading animation stuck upon entering help area via top link from profile page                       ?                                                                                           1                   1 1
                           Settings dropdown wont go
 39       Global                                            User are not expecting this to a toggle on and off action                                                   make this a rollover or have it disappear after a second or 2                                                                          1 1 1
                           away
                         unexpected result from clicking
 8        Soundtracks                                    rank button has a magnifying glass                                                                   change to button showing 2 triangles up and down                                                  1                              1     1
 31       Help           rank
                           Spelling                          Draw should be "drawer" in this context                                                                    drawer not draw http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
                                                                                                                                                                        Possible solution:                                                                                                    1                    1 1
 11       Global           TECH                                  The regular back button on the browser does not work                                                                                                                                        1                              1 1 1 1                5 1 1 1 1
                                                                                                                                                                        still-work-ajax-page-loads
                         Unsure how long soundtracks
 9        Soundtracks                                     no info on length in truncated view                                                                 add number of songs in playlist to truncated view and make this the button to expand              1        1     1             1 4     1
                         are
                           difficulty finding help on how to
 15
 1        Help
          Home             unsure if logged in                   confusing terminology "Your VOICE"
                                                                 No direct indication of login status                                                                   have username display top right on every page help area
                                                                                                                                                                        rename You VOICE with your profile at least in the                                                         1 1         1           1       2
                                                                                                                                                                                                                                                                                                                   4 1 1
                           edit profile
                                                                                                                                                              highlight search result after following link or have the search page give results in stacks titled
                         Disorientation from following        Results pages shows links that take you to a list of soundtracks, does not appear relevant to
 10       Search results                                                                                                                                      by results location within the site and have the title the only link also give a summary of        1       1     1        1      4     1 1 1
                         search result link                   search
 2        Home             difficulty navigating to profile      Confusing terminology " my soundtracks"                                                      results and optional filter orto enter profile (see 1) "tracks"
                                                                                                                                                                        Click username pick from a category e.g.                                                                   1               1 1 1 1 5 1
 31       Help             Spelling                              Draw should be "drawer" in this context                                                                drawer not draw                                                                                                        1           1 1
                                                                                                                                                              Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
 11       Global         TECH                                 The regular back button on the browser does not work                                         If this is to be on the home page it should be smaller, and have a more subtle animation, 1 1 1
                                                                                                                                                                                                                                             1    1                                            5 1 1 1 1
                           Frustration with the movement         The movement on the homepage moves to frequently and cannon be stopped to read.still-work-ajax-page-loads
                                                                                                                                                   One
 28       Home                                                                                                                                             should change less frequently and be able to be frozen so the user can read or keep what is                                         1           1       2 1
 1        Home             unsurehome page
                           on the if logged in                   No direct indication ofthem of adverts and would have immediately left the site.
                                                                 user said it reminded login status                                                        have username display top right on every page                                                 1 1                                   1           1       4 1 1
          SoundTrack                                                                                                                              should bethere. under "share" as extra option when selecting "by email" and less confusing
                                                                                                                                                             listed
 12                      Not noticed STY4U                    Confusing name "STY4U" and share function has email option                                                                                                                                        1        1         1 1 1 5                 1
          creation         "philum" not recognized as a                                                                                                       terminology
 35       Home                                                   The reasoning behind this naming is not explained                                                     Change link title to be more descriptive                                                                                1           1
 2        Home             link to the video
                           difficulty navigating to profile      Confusing terminology " my soundtracks"                                                               Click username to enter profile (see 1)                                                                     1               1 1 1 1 5 1
                                                                                                                                                              User entered Occupations then support for searching them alternatively a comprehensive list
          Users          Hard to find peoples actual
 13                                                           Categories for occupation asked for at signup are to vague                                      of professional areas but to select this from a dropdown would not be usable as the list  1 1                        1           3               1
 3         Login / Signupoccupation on Sign up
          Occupation      Difficulty                             Sign up text too small                                                                                 clear separate button for signup                                                                           1 1 1 1           1 1 1 7 1
                                                                                                                                                              would be If this is to be on the home page it should be smaller, and have a more subtle animation,
                                                                                                                                                                        to long
                          Frustration with the movement The movement on the homepage moves to frequently and cannon be stopped to read. One
 28       Home                                                                                                                                                          should change less frequently and be able to be frozen so the user can read or keep what is                            1           1       2 1
 14       Profile        CRASH home page
                          on the                      "error: [object it reminded them of adverts and wouldprofile immediately left the site.
                                                          user said Object]" upon clicking "edit profile" from have page                      ?                         there.                                                                         1 1                                   1 3 1
                          Didn’t notice that had not
 38       Login / Signupdifficulty findingrecognized as a
                          "philum" not help on how to     no error feedback on terms and conditions tick box, also the tick box it quite small                          make the checkbox larger and add red feedback text                                                                                 1       1 1
 15
 35       Help
           Home           ticked terms and conditions confusing terminology "Yourthis naming is not explained

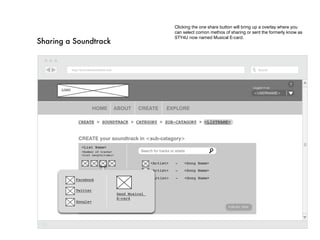

                                                          The reasoning behind VOICE"                                                                         rename You VOICE with your profile at least in the help area
                                                                                                                                                                      Change link title to be more descriptive                                                       1                  1      2 1
                                                                                                                                                                                                                                                                                               1                   1
                        edit profile video
                          link to the

 3        Login / Signup Difficulty on Sign up                   Sign up text too small                                                                       remove dragging feature from site as it is difficult to use on many platforms and prone to
                                                                                                                                                                        clear separate button for signup                                                                           1 1 1 1           1 1 1 7 1
                         Difficulty and frustration with      Dragged item jumps to right upon drag, target area to small, still allows drag when no          errors even when executed well, replace with: "add > soundtrack > soundtrack cat >
 16
 5        Soundtracks
           Profile                                                                                                                                                                                                                                                   1 1       1 1 1 1 6 1 1 1
                                                                                                                                                                                                                                                                                 1   1 1
                         dragging edit profile
                           can't find                         soundtrack available to land to be at top right with usernamenot specific enough
                                                                 Edit profile is expected on, help balloon and tool top text                                            show "settings" and "edit profile" next to username (see 1)
                                                                                                                                                              Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks                                          1                       5 1
                                                                                                                                                              tab opens
                           Didn’t notice that had not
 38       Login / Signup                                  no error feedback on terms and conditions tick box, also the tick box it quite small                          make the checkbox larger and add red feedback text                                                                                 1       1 1
                           ticked terms and conditions Described by quote: "A calendar is for planning and you don’t have to plan your own date of
 6        Profile          CRASH                          “Begin creating your profile by clicking here.” link broken on profile page                                   ?                                                                                                          1               1 1         1 4 1
 17       Profile        Frustration with DOB input           birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                 1 1       1 1 1 1 6 1
                                                              format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"

 5        Profile          can't find edit profile                Edit profile is expected to be at top right with username
                                                              Help area instructs users to start the STY4U process at the home page which one user could      Restructure of site navigation and repurposenext to username (see 1) and illustrations in
                                                                                                                                                                       show "settings" and "edit profile" of home page(see details                                                 1        1 1 1 1                5 1
 18
 7        Global
           Profile       Difficulty navigating to STY4U
                           CRASH                                  Loading animation stuck upon entering help area via top link from profile page                       ?                                                                                             1             1           1           1       1 1
                                                              not get to                                                                                      main document)

                                                                                                                                                              Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
 6        Profile          CRASH
                         Difficulty finding created           The“Begin creating your out tab is not clear and shows categories that have no playlists so
                                                                    My Soundtracks pop profile by clicking here.” link broken on profile page                           ?
                                                                                                                                                              soundtracks created" when empty, once the user has more than a few then introduce the                                1               1 1         1 4 1
 19       Global                                                                                                                                                                                                                                                     1         1 1             3     1 1
 14       Profile        soundtracks
                           CRASH                              will not seem relevant also the profile area is difficult to find profile page
                                                                   "error: [object Object]" upon clicking "edit profile" from                                 sorting categories and only ones that are populated with created soundtracks, Also
                                                                                                                                                                        ?                                                                                                          1 1                         1 3 1

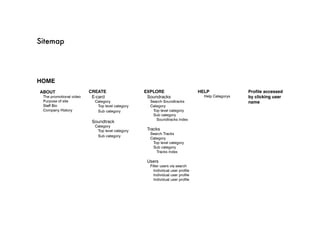

                                                                                                                                                              Restructure of site navigation (see details and illustrations in main document)
                                                                 Described by quote: "A calendar is for planning and you don’t have to plan your own date of
 7
 17       Profile
          Profile          CRASH
                         Disorientationwith DOB input
                           Frustration when creating             birth" The calendar stuck upontodays date, Also the incorrect from profile page
                                                                 Loading animation starts with entering help area via top link input dialogue defines a different should have another stage after selecting birthday asking weather users wish to
                                                                                                                                                         This task ?
                                                                                                                                                                   Replace date of birth input with 3 dropdowns for day month and year                                             1 1 1   1 1 1 1 1 1
                                                                                                                                                                                                                                                                                               1   6 1
 20       STY4U                                               clicking image of birthday instead of "create" button takes users to "tracks>party>birthday"                                                                                                           1                   1
                         STY4U                                   format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"                 create on or see what other users have chosen first

          Users          Confusion with results or
 21
 23        Profile                                         No indication on how or if how the results are filtered                                            A visually Darker coloured text to replace light yellow, or outline, and possible
                                                                                                                                                                         separate filtration area that shows which filters are active or darker background           1 1                    1 2                1
 14       Occupation
           Profile       filteringyellow text hard to read
                            Pale by occupation
                            CRASH
                                                               Not enough contrast between yellow and background
                                                               "error: [object Object]" upon clicking "edit profile" from profile page                                  ?                                                                                                          1 1
                                                                                                                                                                                                                                                                                                                 1 1
                                                                                                                                                                                                                                                                                                               1 3 1
Soundtrack         My Soundtracks drawer largely The displayeda perhaps lesser known song:"error: [object: every task but this area is always
                                                               When adding categories are to broad to have relevance to                                                       Remove the My Soundtracks pop out then introduce the sorting categories and only ones
  32
  30          Global             CRASH                                                                                                                                        ?                                                                                                                 1        1 1         2 1 1
              creation           useless                       around but serves no use as the drag function is unusable.
                                                               Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta >                                                 that are populated with created soundtracks, Also
                                                                                                                                                                    menu rollovers should be only links to pages or specific functions not parts of a function (see
  36          Global             Rollover is annoying                  The rollover is far to large and contains to much and is difficult to make it disappear                                                                                                                                      1        1       2 1       1
              Soundtrack         cannot add song once search           If you click play from the search dropdown you are given a 30 second preview and by the time navigation redesign)
  33                             Settings dropdown wont go                                                                                                          put an add track to playlist button onto the preview area                                                                   1                  1           1
  39          creation
              Global             dropdown disappears                   this has finished the add button toggle on and off action
                                                                       User are not expecting this to a has gone                                                    make this a rollover or have it disappear after a second or 2                                                                                1 1 1
                                 away
              Soundtrack                                                                                                                                                      Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
  34
  11          Global             CRASH
                                 TECH                                  The regular back button on the player has a broken link
                                                                       The buy button on the preview browser does not work                                                    ?                                                                                       1                     1 1 1 1
                                                                                                                                                                                                                                                                                              1                      1 1 1 1 1
                                                                                                                                                                                                                                                                                                                     5     1
              creation                                                                                                                                                        still-work-ajax-page-loads
                                 unexpected result from clicking
  8           Soundtracks        difficulty finding help on how to rank button has a magnifying glass                                                                         change to button showing 2 triangles up and down                                                      1                                1   1
  15          Help               rank                              confusing terminology "Your VOICE"                                                                         rename You VOICE with your profile at least in the help area                                              1                    1       2 1
                                 edit profile

                                 Unsure how long soundtracks
  9           Soundtracks                                              no info on length in truncated view                                                                    add number of songs in playlist to truncated view and make this the button to expand                  1       1       1            1 4   1
  31          Help               Spelling                              Draw should be "drawer" in this context                                                                drawer not draw                                                                                                   1                  1 1
Issues on the Login / signup screen
                                 are

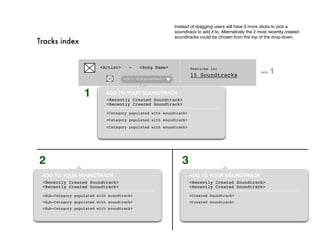

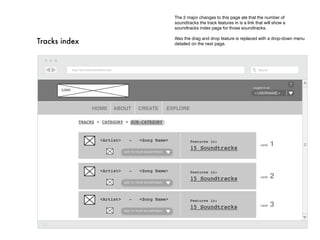

                                                                                                                                                                              remove dragging feature from site as it is difficult to use on many platforms and prone to
                                 Difficulty and frustration with       Dragged item jumps to right upon drag, target area to small, still allows drag when no
  16          Soundtracks                                                                                                                                                     errors even when executed well, replace with: "add > soundtrack > soundtrack cat >                    1 1 1 1 1 1 1 1 4 1 1 1
                                                                                                                                                                                                                                                                                      1         1   6   1
Nearly everyone entered a username and password and clicked
  1           Home               dragging logged in
                                 unsure if                             soundtrack available to landstatus
                                                                       No direct indication of login on, help balloon and tool top text not specific enough                   have username display top right on every page
                                                                                                                                                                              Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks

login befor being told appropriatehadConfusing terminology " my on www.soundtracktoyour.com username to enter profile (see 1)
            Issues found tonot 8 participants soundtracks" site and then
                                         by No info on BPM wrong by the
                    Disappointment with
 26
 2      Soundtracks
        Home        difficulty how they
                    knowing navigating profile  done it                                                                                    Click BPM information
                                                                                                                                           Adding                                                                                                                                   1       1       1 1 1 1 5 1 1
                                                                                                                                                                                                                                                                                                            1
                    songs are for exercise
clikcingSoundtracks TECH button.
 27
         the sign up                           When playing a soundtrack, after the first 30 second preview is over the second song begins
                                                                                                                                           ?
                                                                                                                                           If this is to be on the home page it should be smaller, and have a more subtle animation,                                                        1                        1   1
                                 Frustration with the movement         The the artwork,on the and artists from the first song persistcannon be stopped to read. One
                                                                       but movement name homepage moves to frequently and
  28          Home                                                                                                                                                            should change less frequently and be able to be frozen so the user can read or keep what is                       1            1       2 1
                                 on the home page                      user said it reminded them of adverts and would have immediately left the site.
                                                                                                                                                                              there.                                                                              Participants                          Tasks
  28          Soundtracks   CRASH                           When clicking "tracks>9 to 5" dialogue box :"error: [object Object]"                                              ?                                                                               1    1 1                                               3 1
  Record
  35          Location
               Home        Description recognized as a Cause reasoning behind this naming is not explained
                            "philum" not
                                                            The                                                                                    Solution (redesign title to be more descriptive
                                                                                                                                                            Change link recommendation)                                                   1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4
                                                                                                                                                                                                                                                            1                                                        1
  order                     link to the video
  1           Home          Disorientation when creating No direct indication of login status                                                      have username display top haveon every page after selecting birthday asking weather users wish to1
                                                                                                                                                            This task should right another stage
  20
  3            STY4U Signupunsure if logged in up
               Login /      Difficulty on Sign              Sign up image of birthday instead of "create" button takes users to "tracks>party>birthday"
                                                            clicking text too small                                                                                                                                                        1 1          1
                                                                                                                                                                                                                                                        1   4 1 1                                                    1         1
                            STY4U                                                                                                                           create on or see what for signup have chosen first
                                                                                                                                                            clear separate button other users                                                         1 1 1 1   1 1 1                                                7 1
  2           Home             difficulty navigating to profile    Confusing terminology " my soundtracks"                                                          Click username to enter profile (see 1)                                                        1            1 1 1 1 5 1
                                                                   people seem to expect it to be at the bottom, but I think that the positioning and style gives
  29          STY4U             sent button a little hard to find                                                                                                     move the send button to be aligned with the creation box                                                                  1 1                  2         1
                                                                   users banner blindness to that area
                                Didn’t notice that had not
  38
  3           Login / / SignupDifficulty on Sign up
               Login Signup                                     Sign up text too small on terms and conditions tick box, also the tick box it quite small
                                                                   no error feedback                                                                                  make the checkbox larger and add red feedback text
                                                                                                                                                             clear separate button for signup                                                                      1 1 1 1          1 1 1 7 1                1       1 1
                                Confusion over if conditions
                                ticked terms and the recipient
  37           STY4U                                               once the email is entered on the STY4U screen the email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users                                                                  1                1         1
                                is correct
  4           Global           frustration with help balloons      Help balloons obscure site and disappear before being read                                       click to remove and tick to not show again                                                     1 1 1                1 1 5 1 1
                                 has to retype details again after
               Terms and                                                                                                                                                      terms should be either a separate window (with a print button perhaps?) or have an accept
  5
  29           Profile           can't find edit profile and
                                 going back from terms             Edit profilebutton on terms and conditions username
                                                                   no accept is expected to be at top right with                                                              show "settings" and "edit profile" next to username (see 1)                                           1       1 1 1 1                  5
                                                                                                                                                                                                                                                                                                                     1 1
  5            Conditions
              Profile          can't find edit profile         Edit profile is expected to be at top right with username                                            show "settings" and the bottom or beto username (seescroll box
                                                                                                                                                                             button at "edit profile" next a collapsible or 1)                                     1        1 1 1 1             5 1
                                 conditions page

  6           Profile           frustration with not being able
                               CRASH                           “Begin creating your profile by clicking here.” link broken on profile page                          ?                                                                                              1            1 1         1 4 1
                                                                  the "# soundtracks" on the tracks page that indicates how many soundtracks the track features
  6
  22          Profile
              Tracks            CRASH from "tracks" over to “Begin creating your profile by clicking here.” link broken on profile page
                                to explore                                                                                                                      ?
                                                                                                                                                                Make "# soundtracks" a link to the soundtracks that the track is in                                                 1 1             1 1 1 1 4 1 1
                                                                                                                                                                                                                                                                                                            3
                                                                  in is expected to be a link to those soundtracks
  7           Profile           the "soundtracks" it features in
                               CRASH                           Loading animation stuck upon entering help area via top link from profile page          ?                                                                                                           1                            1 1
                                                                                                                                                                              User entered Occupations then support for searching them alternatively a comprehensive list
              Users              Hard to find peoples actual
                               unexpected result from clicking
  13
  8           Soundtracks                                      rank button has for occupation asked for at signup are to vague
                                                                   Categories a magnifying glass                                                                    change toof professional areas but to selectdown
                                                                                                                                                                              button showing 2 triangles up and this from a dropdown would not be usable as 1 list
                                                                                                                                                                                                                                                            the                     1 1         1       1
                                                                                                                                                                                                                                                                                                        1            3             1
  7            Occupation
              Profile            occupation
                               rank
                                 CRASH                             Loading animation stuck upon entering help area via top link from profile page                             ?                                                                                                     1                                1 1
                                                                                                                                                                              would be to long

                               Unsure how long soundtracks
  9           Soundtracks                                          no info on length in truncated view                                                              add number of songs in playlist to truncated view and make this the button to expand           1        1   1           1 4         1
                               are
  14          Profile            CRASH                                 "error: [object Object]" upon clicking "edit profile" from profile page                                ?
                                                                                                                                                                 highlight search result after following link or have the search page give results in stacks titled
                                                                                                                                                                                                                                                                                    1 1                          1 3 1
                               Disorientation from following       Results pages shows links that take you to a list of soundtracks, does not appear relevant to
  10          Search results                                                                                                                                     by results location within the site and have the title the only link also give a summary of        1       1   1       1       4       1 1 1
                               search result link                  search
                                                                      Described by quote: "A calendar is for planning and you don’t have to plan your own date of and optional filter or pick from a category e.g. "tracks"
                                                                                                                                                                 results
  17          Profile            Frustration with DOB input            birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                           1 1         1 1 1 1 6 1
                                                                       format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"                   Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
  11          Global           TECH                                The regular back button on the browser does not work                                                                                                                                            1        1 1 1 1             5 1 1 1 1
                                                                                                                                                                   still-work-ajax-page-loads
  23          Profile            Pale yellow text hard to read         Not enough contrast between yellow and background                                                      Darker coloured text to replace light yellow, or outline, or darker background                                1                        1 1
              SoundTrack                                                                                                                                            should be listed under "share" as extra option when selecting "by email" and less confusing
  12                           Not noticed STY4U                   Confusing name "STY4U" and share function has email option                                                                                                                                      1        1       1 1 1 5                  1
              creation                                                                                                                                              terminology
                                 Confusion about what the              the layout does not indicate that the functions on the profile page are only applicable to the         If the main site navigation is restructured and the profile area functions placed under the
  24          Profile                                                                                                                                              User entered Occupations then support for be enough distinction between areas. When list                                 1                        1             1
              Users             buttons on the profile page do logged in user
                               Hard to find peoples actual                                                                                                                   username at top right there will searching them alternatively a comprehensive viewing other
  13                                                         Categories for occupation asked for at signup are to vague                                            of professional areas but to select this from a dropdown would not be usable as the list     1 1                 1           3                1
              Occupation       occupation
                                                                                                                                                                   would be highlight search result after following link or have the search page give results in stacks titled
                                                                                                                                                                             to long
                                 Disorientation from following         Results pages shows links that take you to a list of soundtracks, does not appear relevant to
  10          Search results                                                                                                                                                  by results location within the site and have the title the only link also give a summary of           1       1       1        1       4     1 1 1
  14          Profile          CRASH result link
                                search                                 search
                                                                   "error: [object Object]" upon clicking "edit profile" from profile page                          ?         results and optional filter or pick from a category e.g. "tracks"                   1 1                       1 3 1

                               difficulty finding help on how to
  15          Help            Search appears broken whenconfusing terminology "Your VOICE"                                                                          rename You VOICE with your profile at least in the help area                                        1               1       2 1
  25          Search results edit profile                  there is no feedback on search results                                                                             profile a "nothing found when you searched for <users search>" type of message                                1       1                2     1       1
                              no results are fund
                                                                                                                                                                    remove dragging feature from site as it is difficult to use on many platforms and prone to
                               Difficulty and frustration with     Dragged item jumps to right upon drag, target area to small, still allows drag when no           errors even when executed well, replace with: "add > soundtrack > soundtrack cat >
  16           SoundTrack
              Soundtracks                                                                                                                                                     should be listed under "share" as extra option when selecting "by email" and less confusing 1 1 1 1 6
                                                                                                                                                                                                                                                                  1 1                                   1 1
  12                             Not noticed STY4U
                               dragging                               Confusing name "STY4U" and share function has email option
                                                                   soundtrack available to land on, help balloon and tool top text not specific enough              Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks                     1   1                        1 1 1 5               1
               creation                                                                                                                                                       terminology
                                                                                                                                                                    tab opens

              Soundtrack                                           Described adding a perhaps lesser known song:"error: [object: to plan your own date of
                                                                        When by quote: "A calendar is for planning and you don’t have
  30
  17          Profile            CRASH
                               Frustration with DOB input          birth" The calendar starts with todays date, Also the incorrect <track meta >                     ?                                                                                                                  1                1           2 1 1
               creation                                                 Object]url:/SoundTrack/<user>/AddTrack? Trackid= input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                         1 1     1 1 1 1 6 1
                                                                   format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"

              Soundtrack         cannot add song once search If area instructs users to start the STY4U process atare given a 30 secondone user could the time
                                                           Help you click play from the search dropdown you the home page which preview and by Restructure ofan add track toand repurpose of home page(see details and illustrations in
  33
  18          Global           Difficulty navigating to STY4U                                                                                                  put site navigation playlist button onto the preview area                                                1                       1
                                                                                                                                                                                                                                                                                                1            1       1         1
               creation          dropdown disappears       not this to finished the add button has gone
                                                               get has                                                                                 main document)

              Soundtrack                                                                                                                                           Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
  34                             CRASH                                 The buy button on the preview player has a broken link                                                ?                                                                                                                  1                    1         1
              creation         Difficulty finding created          The My Soundtracks pop out tab is not clear and shows categories that have no playlists so      soundtracks created" when empty, once the user has more than a few then introduce the
  19          Global                                                                                                                                                                                                                                                    1       1 1             3       1 1
                               soundtracks                         will not seem relevant also the profile area is difficult to find                               sorting categories and only ones that are populated with created soundtracks, Also
                                 unexpected result from clicking                                                                                                   Restructure of site to button showing 2 triangles up and down document)
  8           Soundtracks                                        rank button has a magnifying glass                                                                          change navigation (see details and illustrations in main                                               1                                1     1
                                 rank
                               Disorientation when creating                                                                                                        This task should have another stage after selecting birthday asking weather users wish to
  20          STY4U                                                clicking image of birthday instead of "create" button takes users to "tracks>party>birthday"                                                                                                         1                       1            1
                               STY4U                                                                                                                               create on or see what other users have chosen first
                                 Unsure how long soundtracks
  9           Soundtracks                                              no info on length in truncated view                                                                    add number of songs in playlist to truncated view and make this the button to expand                  1       1       1            1 4       1
                                 are
              Users            Confusion with results or
  21                                                               No indication on how or if how the results are filtered                                          A visually separate filtration area that shows which filters are active and possible                1 1                     2                1
              Occupation       filtering by occupation
                                                                                                                                                                              remove dragging feature from site as it is difficult to use on many platforms and prone to
My Soundtracks drawer largely The displayed categories are to broad to have relevance to every task but this area is always             Remove the My Soundtracks pop out then introduce the sorting categories and only ones
  32          Global                                                                                                                                                                                                                                                                       1            1       2     1
                               useless                       around but serves no use as the drag function is unusable.                                                that are populated with created soundtracks, Also
                                                                                                                                                                       menu rollovers should be only links to pages or specific functions not parts of a function (see
  36          Global           Rollover is annoying                 The rollover is far to large and contains to much and is difficult to make it disappear                                                                                                                                    1        1       2 1       1
                                                                                                                                                                       navigation redesign)
                               Settings dropdown wont go
  39          Global                                                User are not expecting this to a toggle on and off action                                          make this a rollover or have it disappear after a second or 2                                                                        1 1 1
                               away

                                                                                                                                                                       Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
  11          Global           TECH                                 The regular back button on the browser does not work                                                                                                                                       1                       1 1 1 1                  5 1 1 1 1
                                                                                                                                                                       still-work-ajax-page-loads

                               difficulty finding help on how to
  15          Help                                               confusing terminology "Your VOICE"                                                                    rename You VOICE with your profile at least in the help area                                                1                    1       2 1
                               edit profile

  31          Help             Spelling                             Draw should be "drawer" in this context                                                            drawer not draw                                                                                                     1                    1 1

Issues on profile screen
  1           Home             unsure if logged in                  No direct indication of login status                                                               have username display top right on every page                                                           1 1         1            1       4 1 1

Alot of people where fustrated by the date                                           The task was made alot more dofficult by
of birth input starting with todays date.
 2       Home    difficulty navigating to profile
                                                                                     the crashes mentioned below, fixingtothese (see 1)
                                                  Confusing terminology " my soundtracks"                                         Click username enter profile                                                                                                                 1               1 1 1 1 5 1

                 Frustration with the movement The movement on the homepage moves to frequently and cannon be should be a high priority as
                                                                                     technical errors stopped to read. One If this is to be on the home page it should be smaller, and have a more subtle animation,
 28      Home                                                                                                                     should change less frequently and be able to be frozen so the user can read or keep what is                                                              1            1       2 1
Most people could not find how to edit the
                 on the home page
                                                                                     it put most users in a situation where they
                                                  user said it reminded them of adverts and would have immediately left the site.
                                                                                                                                  there.

profile easily. link tofound by a participantsnaming iswww.soundtracktoyour.com link title to be more descriptive
 35      Home
                 "philum" not recognized as
            Issues the video                    8 The reasoning behind this on would have given up on the Change
                                                                                       not explained                              task.                                                                                                                                                    1                    1

  3           Login / Signup Difficulty on Sign up                  Sign up text too small                                                                             clear separate button for signup                                                                        1 1 1 1              1 1 1 7 1

                               Didn’t notice that had not                                                                                                                                                                                                          Participants                    Tasks
  38          Login / Signup                                        no error feedback on terms and conditions tick box, also the tick box it quite small               make the checkbox larger and add red feedback text                                                                              1        1 1
 Record                        ticked terms and conditions
             Location        Description                        Cause                                                                                         Solution (redesign recommendation)                                                           1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4
 order
 1           Home            unsure if logged in                No direct indication of login status                                                          have username display top right on every page                                                1 1         1           1       4 1 1
  5           Profile          can't find edit profile              Edit profile is expected to be at top right with username                                          show "settings" and "edit profile" next to username (see 1)                                             1       1 1 1 1                  5 1
 2           Home            difficulty navigating to profile   Confusing terminology " my soundtracks"                                                       Click username to enter profile (see 1)                                                      1               1 1 1 1 5 1

 3
 6           Login / Signup Difficulty on Sign up
              Profile         CRASH                             Sign up textcreating your profile by clicking here.” link broken on profile page
                                                                   “Begin too small                                                                           clear separate button for signup
                                                                                                                                                                       ?                                                                                   1 1 1 1             1 1 1 7 1 1
                                                                                                                                                                                                                                                                               1       1                    1 4 1

 4           Global          frustration with help balloons     Help balloons obscure site and disappear before being read                                    click to remove and tick to not show again                                                   1 1 1                   1 1 5 1 1

  7           Profile          CRASH                                Loading animation stuck upon entering help area via top link from profile page                     ?                                                                                                       1                                1 1
 5           Profile         can't find edit profile            Edit profile is expected to be at top right with username                                     show "settings" and "edit profile" next to username (see 1)                                  1       1 1 1 1                 5 1

 6           Profile         CRASH                              “Begin creating your profile by clicking here.” link broken on profile page                   ?                                                                                            1               1 1         1 4 1
  14          Profile          CRASH                                "error: [object Object]" upon clicking "edit profile" from profile page                            ?                                                                                                       1 1                          1 3 1
 7           Profile         CRASH                              Loading animation stuck upon entering help area via top link from profile page                ?                                                                                            1                               1 1
                                                                    Described by quote: "A calendar is for planning and you don’t have to plan your own date of
 17           Profile        unexpected result from clicking
                               Frustration with DOB input rank button has a magnifying glass todays date, Also the incorrect input dialogue defines a different toReplace date of 2 triangles up and dropdowns for day month and year
 8           Soundtracks                                      birth" The calendar starts with                                                          change button showing birth input with 3 down                                                       1                       1 1 1 1 1 1 1 6 1
                                                                                                                                                                                                                                                                                           1
                             rank
                                                                    format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"
                             Unsure how long soundtracks
 9           Soundtracks                                     no info on length in truncated view                                                              add number of songs in playlist to truncated view and make this the button to expand         1       1       1           1 4         1
  23          Profile          Pale yellow text hard to read
                             are                                 Not enough contrast between yellow and background                                                     Darker coloured text to replace light yellow, or outline, or darker background                                  1                        1 1

                                                                                                                                                         highlight search result after following link or have the search page give results in stacks titled
                            Disorientationabout following
                              Confusion from what the Results layout showsnot indicate that the functions on the profile page are only applicable to the
                                                                the pages does links that take you to a list of soundtracks, does not appear relevant to
 10
 24          Search results
              Profile                                                                                                                                    by resultsIf the main site the site and is restructured and the profilegive a functions of
                                                                                                                                                                    location within navigation have the title the only link also area summary placed under the
                                                                                                                                                                                                                                                            1 1            1       1 1 4           1 1 1        1             1
                            search result link profile page do logged in user
                              buttons on the                 search
                                                                                                                                                         results and optional filter or right from a will be enough distinction between areas. When viewing other
                                                                                                                                                                   username at top pick there category e.g. "tracks"
                                                                                                                                                                  highlight search result after following link or have the search page give results in stacks titled
                               Disorientation from following    Results pages shows links that take you to a list of soundtracks, does not appear relevant to solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
                                                                                                                                                       Possible
 11
 10          Global results TECH
              Search                                         The regular back button on the browser does not work                                                 by results location within the site and have the title the only link also give a summary of 1 1 1
                                                                                                                                                                                                                                                      1     1        1                 1 5 1 1 1 1
                                                                                                                                                                                                                                                                                           1   1                4     1 1 1
                               search result link               search                                                                                 still-work-ajax-page-loads
                                                                                                                                                                  results and optional filter or pick from a category e.g. "tracks"
             SoundTrack                                                                                                                                       should be listed under "share" as extra option when selecting "by email" and less confusing
 12                          Not noticed STY4U          Confusing name "STY4U" and share function has email option                                                                                                                                        1        1           1 1 1 5                  1
  25         creation results Search appears broken when there is no feedback on search results
              Search                                                                                                                                          terminology
                                                                                                                                                                       profile a "nothing found when you searched for <users search>" type of message                                  1       1                2     1       1
                               no results are fund
                                                                                                                                                              User entered Occupations then support for searching them alternatively a comprehensive list
             Users           Hard to find peoples actual
 13                                                             Categories for occupation asked for at signup are to vague                                    of professional areas but to select this from a dropdown would not be usable as the list    1 1                  1           3                1
             Occupation
              SoundTrack     occupation
  12                           Not noticed STY4U                    Confusing name "STY4U" and share function has email option                                would be should be listed under "share" as extra option when selecting "by email" and less confusing
                                                                                                                                                                        to long                                                                                                1       1            1 1 1 5               1
              creation                                                                                                                                                 terminology
 14          Profile         CRASH                              "error: [object Object]" upon clicking "edit profile" from profile page                       ?                                                                                            1 1                         1 3 1

              Soundtrack     difficulty finding help on how to    When adding a perhaps lesser known song:"error: [object:
 30
 15          Help              CRASH                           confusing terminology "Your VOICE"                                                                     ?
                                                                                                                                                              rename You VOICE with your profile at least in the help area                                     1                   1       1
                                                                                                                                                                                                                                                                                           2 1      1           2 1 1
              creation       edit profile                         Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta >

                                                                                                                                                    remove dragging feature from site as it is difficult to use on many platforms and prone to
              Soundtrack       cannot add song once search If youitem jumps from the search dropdown you are given allows drag when no and by the time
                             Difficulty and frustration with Dragged click play to right upon drag, target area to small, still a 30 second preview errors even whenadd track to playlist button onto the preview area
 33
 16          Soundtracks                                                                                                                                      put an executed well, replace with: "add > soundtrack > soundtrack cat >                         1 1                 1
                                                                                                                                                                                                                                                                           1 1 1 1 6               1 1          1         1
              creation         dropdown disappears
                             dragging                           this has finished the add button has gone
                                                             soundtrack available to land on, help balloon and tool top text not specific enough    Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
                                                                                                                                                    tab opens
              Soundtrack
  34                           CRASH                                The buy button on the preview player has a broken link                                             ?                                                                                                                   1                    1         1
              creation                                      Described by quote: "A calendar is for planning and you don’t have to plan your own date of
 17          Profile         Frustration with DOB input     birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                             1 1         1 1 1 1 6 1
                               unexpected result from clicking
                                                            format to button has a magnifying glass
  8           Soundtracks                                        rank the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"                                     change to button showing 2 triangles up and down                                                       1                                1     1
                               rank
                                                                Help area instructs users to start the STY4U process at the home page which one user could    Restructure of site navigation and repurpose of home page(see details and illustrations in
 18          Global          Difficulty navigating to STY4U                                                                                                                                                                                                    1                           1            1
                                                                not get to                                                                                    main document)
                               Unsure how long soundtracks
  9           Soundtracks                                           no info on length in truncated view                                                                add number of songs in playlist to truncated view and make this the button to expand                    1       1       1            1 4       1
                               are
                                                                                                                                                               Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
                             Difficulty finding created        The My Soundtracks pop out tab is not clear and shows categories that have no playlists so      soundtracks created" when empty, once the user has more than a few then introduce the
 19          Global                                                                                                                                                                                                                                           1
                                                                                                                                                                         remove dragging feature from site as it is difficult to use on many platforms and prone to        1 1             3       1 1
                               Difficulty and frustration with will not seem relevant alsoto right upon drag, targetto findto small, still allows drag when no sorting categories and only ones that are populated with created soundtracks, Also
                             soundtracks                            Dragged item jumps the profile area is difficult area
7           Profile            CRASH                                 Loading animation stuck upon entering help area via top link from profile page                        ?                                                                                                    1                               1 1
                                Confusion about what the              the layout does not indicate that the functions on the profile page are only applicable to the        If the main site navigation is restructured and the profile area functions placed under the
 24          Profile                                                                                                                                                                                                                                                                     1                       1             1
                                buttons on the profile page do        logged in user                                                                                        username at top right there will be enough distinction between areas. When viewing other
                                                                                                                                                                            highlight search result after following link or have the search page give results in stacks titled
                            Disorientation from following             Results pages shows links that take you to a list of soundtracks, does not appear relevant to
 10
 14          Search results CRASH
             Profile                                                  "error: [object Object]" upon clicking "edit profile" from profile page                               by results location within the site and have the title the only link also give a summary of
                                                                                                                                                                            ?                                                                                                  1 1 1             1       1 1 3 1 1 1 1
                                                                                                                                                                                                                                                                                                             4
                            search result link                        search
                                                                                                                                                                            results and optional filter or pick from a category e.g. "tracks"
                                                                      Described by quote: "A calendar is for planning and you don’t have to plan your own date of
 17          Profile        Frustration with DOB input
                            Search appears broken when                birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                         1 1         1 1 1 1 6 1
 25          Search results                                           there is no feedback on search results                                                             profile a "nothing found when you searched for <users search>" type of message                                1         1       2   1                 1
                            no results are fund                       format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"

 23          Profile
             SoundTrack         Pale yellow text hard to read         Not enough contrast between yellow and background                                                     Darker coloured under "share" as extra option when selecting "by email" and less confusing
                                                                                                                                                                            should be listed text to replace light yellow, or outline, or darker background                              1                 1 1
 12                             Not noticed STY4U                     Confusing name "STY4U" and share function has email option                                                                                                                                                 1       1           1 1 1 5               1
             creation                                                                                                                                                       terminology
                                Confusion about what the              the layout does not indicate that the functions on the profile page are only applicable to theIf the main site navigation is restructured and the profile area functions placed under the
 24          Profile                                                                                                                                                                                                                                                                     1                       1             1
             Soundtrack         buttons on the profile page do        logged in user
                                                                      When adding a perhaps lesser known song:"error: [object:                                      username at top right there will be enough distinction between areas. When viewing other

Issues on the soundtracks and tracks screens
 30

 10
             creation
             Search results
                                CRASH
                            Disorientation from following
                                                                      Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta >
                                                                      Results pages shows links that take you to a list of soundtracks, does not appear relevant to
                                                                                                                                                                    ?
                                                                                                                                                                    highlight search result after following link or have the search page give results in stacks titled
                                                                                                                                                                    by results location within the site and have the title the only link also give a summary of        1                 1
                                                                                                                                                                                                                                                                                             1

                                                                                                                                                                                                                                                                                                 1
                                                                                                                                                                                                                                                                                                     1

                                                                                                                                                                                                                                                                                                         1
                                                                                                                                                                                                                                                                                                                 2 1 1

                                                                                                                                                                                                                                                                                                                 4     1 1 1
                            search result link                        search
                                                                      If you click play from the search dropdown you are given a 30 second preview and by the time results and optional filter or pick from a category e.g. "tracks"
The dragging of songs into a soundtrack
  33
             Soundtrack
             creation
                            cannot add song once search
                            dropdown disappears                                          Users where not sure how long the
                                                                      this has finished the add button has gone
                                                                                                                                                                    put an add track to playlist button onto the preview area                                                                1                   1         1
                            Search appears broken when
is a major issue as only 1 person of the 8
  25         Search results
             Soundtrack     no results are fund                                          soundtracks where and many asumed all you searched for <users search>" type of message
                                                     there is no feedback on search results                          profile a "nothing found when                                                                                                                                       1       1               2     1       1
  34                        CRASH                    The buy button on the preview player has a broken link          ?                                                                                                                                                                       1                   1         1
managed to successfully use it and only
             creation
        SoundTrack
                                                                                         the soundtracks where only should be listed under "share" as extra option when selecting "by email" and less confusing
                                                                                                                     3 songs long.
                    unexpected STY4U
                    Not noticed result from clicking Confusing namea"STY4U" andglass function has email option
after several failed attempts.
  12
  8     Soundtracks
        creation    rank
                                                     rank button has magnifying share                                change to button showing 2 triangles up and down
                                                                                                                     terminology
                                                                                                                                                                                                                                                                                 1
                                                                                                                                                                                                                                                                                 1       1           1 1 1 1
                                                                                                                                                                                                                                                                                                           5           1 1

  30         Issues found by 8 participants on Not Trackid= <track metaeventualy found number of songs in playlist to truncated view and make this the button to expand
        Soundtrack
                    Unsure
                    CRASH how long soundtracks                                           www.soundtracktoyour.com the button to
                                                                                                everyone
                                                     When adding a perhaps lesser known song:"error: [object:
                                                                                                                     ?                                                                                                                                                                       1       1         2 1 1
  9     Soundtracks
        creation
                    are
                                                     no info on length in truncated view
                                                                                         expand the soundtrack to itsadd length.
                                                     Object]url:/SoundTrack/<user>/AddTrack?                   >
                                                                                                                       full                                                                                                                                                      1       1       1           1 4   1

             Soundtrack         cannot add song once search           If you click play from the search dropdown you are given a 30 second preview and by the time remove dragging feature from site as it is difficult to use on many platforms and prone to
 33                             Difficulty and frustration with       Dragged item jumps to right upon drag, target area to small, still allows drag when no       put an add track to playlist button onto the preview area                                               1         1                                   1
 16          creation
             Soundtracks        dropdown disappears                   this has finished the add button has gone                                                    errors even when executed well, replace with: "add > soundtrack > soundtrack cat >                  1 1   1 1 1 1 6                                 1 1
                                dragging                              soundtrack available to land on, help balloon and tool top text not specific enough                                                                                                 Participants        Tasks
                                                                                                                                                                   Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
 Record      Soundtrack    Disappointment with not
 34         Location          Description
                               CRASH                      Cause buy button on the preview player has a broken link
                                                             Theinfo on BPM                                                                      Solution (redesign recommendation)
                                                                                                                                                           ?                                                                                                   1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4
                                                                                                                                                                                                                                                                               1                                 1
 26
 order       Soundtracks
             creation      knowing how appropriate           No                                                                                            Adding BPM information                                                                                                        1                       1     1 1
 1          Home         unsure if are for exercise
                           songs logged in                No direct indication of login status                                                   have username display top right on every page                                                                 1 1       1           1       4 1 1
                           unexpected result from clicking When playing a soundtrack, after the first 30 second preview is over the second song begins
 8
 27          Soundtracks
             Soundtracks   TECH                              rank button has a magnifying glass                                                            change to button showing 2 triangles up and down
                                                                                                                                                           ?                                                                                                                     1       1                       1
                                                                                                                                                                                                                                                                                                                 1     1
                                                                                                                                                                                                                                                                                                                       1
                           rank                              but the artwork, name and artists from the first song persist
 2          Home         difficulty navigating to profile Confusing terminology " my soundtracks"                                                Click username to enter profile (see 1)                                                                       1             1 1 1 1 5 1

 28          Soundtracks        CRASH
                                Unsure how long soundtracks When clicking "tracks>9 to 5" dialogue box :"error: [object Object]"                                            ?                                                                                                            1               1 1 3 1
 9
 3           Soundtracks
            Login / Signup Difficulty on Sign up          Sign up texton length in truncated view
                                                             no info too small                                                                                    clear separate number ofsignup in playlist to truncated view and make this the button to expand 1 1
                                                                                                                                                                           add button for songs                                                              1 1                 1 1 1 7 1
                                                                                                                                                                                                                                                                                 1       1                 1 4   1
                                are

                           Disorientation when creating                                                                                                             This task should have another stage after selecting birthday asking weather users wish to
 20
 4           STY4U
            Global            frustration with help balloonsHelp balloons obscurebirthday disappear before being read
                                                                clicking image of site and instead of "create" button takes users to "tracks>party>birthday" to remove and tick to not show from site as it is difficult to use on many platforms and prone 1
                                                                                                                                                           click    remove dragging feature again                                                     1 1 to        1 1 5 1 1
                                                                                                                                                                                                                                                                    1                                            1       1
                           STY4U
                           Difficulty and frustration with      Dragged item jumps to right upon drag, target area to small, still allows drag when no              create on or see what other users have chosen first
 16          Soundtracks                                                                                                                                            errors even when executed well, replace with: "add > soundtrack > soundtrack cat >              1 1   1 1 1 1                                6     1 1
                           dragging                             soundtrack available to land on, help balloon and tool top text not specific enough
                                                                                                                                                                    Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
 5
 29         Profile
             STY4U       can't find edit profile hard to find people is expected to be it to be at the bottom, but I think that the positioning and style gives "settings" and sendprofile" next to aligned with the creation box
                           sent button a little not         Edit profile seem to expect at top right with username                                         show     move the   "edit button to be username (see 1)                                    1     1 1 1 1     5 1
                                                                                                                                                                                                                                                                        1 1                                      2         1
                           Disappointment with
                                                                users banner blindness to that area
 26          Soundtracks   knowing how appropriate              No info on BPM                                                                                      Adding BPM information                                                                            1                                          1     1
 6          Profile      CRASH are for exercise
                           songs                            “Begin creating your profile by clicking here.” link broken on profile page                    ?                                                                                          1         1 1   1 4 1
                           Confusion over if the recipient
 37          STY4U                                              once the email is entered on the STY4U screen the email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users                                           1                                      1         1
                           is correct                           When playing a soundtrack, after the first 30 second preview is over the second song begins
 27
 7           Soundtracks CRASH
            Profile        TECH                             Loadingthe artwork, name and artists from areafirst top link from profile page                          ?                                                                                                 1 1 1                                      1     1
                                                                but animation stuck upon entering help the via song persist                                ?                                                                                          1
                           has to retype details again after
             Terms and   unexpected result from clicking                                                                                                            terms should be either a separate window (with a print button perhaps?) or have an accept
 29
 8          Soundtracks    going back from terms and rank button has a magnifying glass conditions
                                                                no accept button on terms and                                                              change to?buttonat the bottom or be upcollapsible or scroll box                                              1                                        1 1
 28          Soundtracks rank
             Conditions    CRASH                                When clicking "tracks>9 to 5" dialogue box :"error: [object Object]"                                button showing 2 triangles a and down                                             1                 1 1 1 1 1                                3 1
                           conditions page

                                frustration with not being able
                              Unsure how long soundtracks
 9          Soundtracks         Disorientation when creating no info on length in truncated view
                                                                 the "# soundtracks" on the tracks page that indicates how many soundtracks the track add number oftask should have another stage after selecting birthday asking weather users wish to
                                                                                                                                                        features This songs in playlist to truncated view and make this the button to expand  1     1                        1           1 4         1
 20
 22          STY4U
             Tracks           are explore from "tracks" over to clicking image of birthday instead of "create" button takes users to "tracks>party>birthday"
                                to                                                                                                                               Make "# soundtracks" a link to the soundtracks that the track is in                                                 1           1       1       1
                                                                                                                                                                                                                                                                                                                 3     1 1
                                STY4U                                 in is expected to be a link to those soundtracks                                                      create on or see what other users have chosen first
                                the "soundtracks" it features in
                                                                                                                                                            highlight search result after following link or have the search page give results in stacks titled
 10         Search results
                           Disorientation from following         people seem to links that take at the bottom, but I think that the positioning and style by resultsUser entered Occupationshave the title the only link also give a summary ofa comprehensive list
                                                              Results pages showsexpect it to be you to a list of soundtracks, does not appear relevant to gives                                      then support for searching them alternatively
 29          Users
             STY4U           Hard to find a
                           search result
                                           peoples actual
                             sent buttonlinklittle hard to find
                                                              search                                                                                                  move the sendthe site and aligned with the creation box
                                                                                                                                                                       location within button to be                                                            1 1 1   1                     4 1 1 1 1
                                                                                                                                                                                                                                                                                             1                   2         1
 13                                                              users banner blindness to asked for at signup are to vague
                                                                 Categories for occupation that area                                                                  of professional areas but to select this from a dropdown would not be usable as the list       1 1                             1           3             1
             Occupation      occupation                                                                                                                     results and optional filter or pick from a category e.g. "tracks"
                                                                                                                                                                            would be to long
                                Confusion over if the recipient                                                                                           Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
 37
 11          STY4U
            Global            TECH                                Theonce the email is entered on the STY4Unot workthe email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users
                                                                     regular back button on the browser does screen                                                                                                                               1                    1 1 1 1                 1
                                                                                                                                                                                                                                                                                             5 1 1 1 1           1         1
                               is correct                                                                                                                 still-work-ajax-page-loads

                                has to retype details again after
            SoundTrack
             Terms and                                                                                                                                            should beterms should be eitherextra option when selecting "by email" and less confusing
                                                                                                                                                                            listed under "share" as a separate window (with a print button perhaps?) or have an accept
 12
 29                           Not noticed STY4U terms and Confusing name "STY4U" terms andfunction has email option
                               going back from               no accept button on and share conditions                                                                                                                                                       1     1              1 1 1 5
                                                                                                                                                                                                                                                                                       1                 1       1 1
            creation
             Conditions                                                                                                                                           terminology
                                                                                                                                                                           button at the bottom or be a collapsible or scroll box
                                conditions page
                                                                                                                                                       User entered Occupations then support for searching them alternatively a comprehensive list
            Users             Hard to find peoples actual able
                               frustration with not being
 13                                                           Categories soundtracks" on the trackssignup that to vague how many soundtracks the track of professional areas but to select this from a dropdown would not be usable as the list
                                                                 the "# for occupation asked for at page are indicates                                 features                                                                                    1 1                           1           3               1
 22         Occupation
             Tracks           occupation from "tracks" over to
                               to explore                                                                                                                        Make "# soundtracks" a link to the soundtracks that the track is in                                                 1           1       1       3     1
                                                                 in is expected to be a link to those soundtracks                                      would be to long
                                the "soundtracks" it features in
 14         Profile           CRASH                               "error: [object Object]" upon clicking "edit profile" from profile page                         ?                                                                                      1 1
                                                                                                                                                                          User entered Occupations then support for searching them alternatively a comprehensive list     1 3 1
             Users              Hard to find peoples actual
 13                                                                   Categories for occupation asked for at signup are to vague                                          of professional areas but to select this from a dropdown would not be usable as the list    1 1       1                                3             1
             Occupation         occupation
                              difficulty finding help on how to
 15         Help                                                  confusing terminology "Your VOICE"                                                                      would be to long
                                                                                                                                                                  rename You VOICE with your profile at least in the help area                               1          1   2 1
                              edit profile

                                                                                                                                                                  remove dragging feature from site as it is difficult to use on many platforms and prone to
                              Difficulty and frustration with     Dragged item jumps to right upon drag, target area to small, still allows drag when no          errors even when executed well, replace with: "add > soundtrack > soundtrack cat >
 16         Soundtracks                                                                                                                                                                                                                                            1 1       1 1 1 1 6               1 1
                              dragging                            soundtrack available to land on, help balloon and tool top text not specific enough             Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
                                                                                                                                                                  tab opens

                                                                  Described by quote: "A calendar is for planning and you don’t have to plan your own date of
 17         Profile           Frustration with DOB input          birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                           1 1       1 1 1 1 6 1
                                                                  format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"

                                                                  Help area instructs users to start the STY4U process at the home page which one user could      Restructure of site navigation and repurpose of home page(see details and illustrations in
 18         Global            Difficulty navigating to STY4U                                                                                                                                                                                                       1                         1           1
                                                                  not get to                                                                                      main document)

                                                                                                                                                                  Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
                              Difficulty finding created          The My Soundtracks pop out tab is not clear and shows categories that have no playlists so      soundtracks created" when empty, once the user has more than a few then introduce the
 19         Global                                                                                                                                                                                                                                                 1         1 1             3       1 1
                              soundtracks                         will not seem relevant also the profile area is difficult to find                               sorting categories and only ones that are populated with created soundtracks, Also
Didn’t notice that had not
  38          Login / Signup                                          no error feedback on terms and conditions tick box, also the tick box it quite small              make the checkbox larger and add red feedback text                                                                                1       1 1
                                 ticked terms and conditions

  5           Profile            can't find edit profile              Edit profile is expected to be at top right with username                                         show "settings" and "edit profile" next to username (see 1)                                              1       1 1 1 1                  5 1

  6           Profile            CRASH                                “Begin creating your profile by clicking here.” link broken on profile page                       ?                                                                                                        1               1 1          1 4 1

  7           Profile            CRASH                                Loading animation stuck upon entering help area via top link from profile page                    ?                                                                                                        1                                1 1

Issues on the soundtrack creation screen
  14          Profile            CRASH                                "error: [object Object]" upon clicking "edit profile" from profile page                           ?                                                                                                        1 1                          1 3 1
Many users reviced only a partial completion is for planning and you don’t have to plan your own date of
                                        Described by quote: "A calendar
on task Profile sending aDOB input birth" Thethe accepted one i.e.todays date, Also the incorrect"did-mm-my" defines a different
 17
         3 for Frustration with playlistformat toemailstarts with "did/mm/yyyy" when actually input dialogue
                                         via calendar and                                                                                                               Replace date of birth input with 3 dropdowns for day month and year                                          1 1         1 1 1 1 6 1

not through the more apropiate STY4U.
  23          Profile            Pale yellow text hard to read        Not enough contrast between yellow and background                                                 Darker coloured text to replace light yellow, or outline, or darker background                                   1                        1 1

Users when straight about whatpagemail icon to indicate on www.soundtracktoyour.com main at top right there will be enough distinction between areas. When viewing other
 24
              Issues foundthe 8 participants
        Profile
                   Confusion for          the the layout does not
                                        by do logged in user
                   buttons on the profile
                                                                  that the functions on the profile page are only applicable to the If the
                                                                                                                                    username
                                                                                                                                               site navigation is restructured and the profile area functions placed under the
                                                                                                                                                                                                                                                                                         1                        1             1

share their playlist. from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to highlight search result after following link or have the search page give results in stacks titled
                   Disorientation
  10          Search results                                                                                                                                            by results location within the site and have the title the only link also give a summary of              1       1       1        1       4     1 1 1
                                 search result link                   search
                                                                                                                                                                        results and optional filter or pick from a category e.g. "tracks"
                                                                                                                                                                                                                                                                     Participants                    Tasks
                                 Search appears broken when
  25
  Record      Search results                                          there is no feedback on search results                                                            profile a "nothing found when you searched for <users search>" type of message                                   1       1                2     1       1
             Location          Description fund
                                no results are                    Cause                                                                                        Solution (redesign recommendation)                                                            1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4
  order
  1          Home              unsure if logged in                No direct indication of login status                                                         have username display top right on every page                                                 1 1         1           1       4 1 1
              SoundTrack                                                                                                                                                should be listed under "share" as extra option when selecting "by email" and less confusing
  12                             Not noticed STY4U                    Confusing name "STY4U" and share function has email option                                                                                                                                                 1       1            1 1 1 5               1
              creation                                                                                                                                                  terminology
  2          Home              difficulty navigating to profile   Confusing terminology " my soundtracks"                                                      Click username to enter profile (see 1)                                                       1               1 1 1 1 5 1

              Soundtrack                                              When adding a perhaps lesser known song:"error: [object:
  3
  30         Login / Signup Difficulty on Sign up
                              CRASH                               Sign up text too small                                                                       clear separate button for signup
                                                                                                                                                                        ?                                                                                    1 1 1 1             1 1 1 7 1
                                                                                                                                                                                                                                                                                       1              1           2 1 1
              creation                                                Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta >

  4          Global            frustration with help balloons     Help balloons obscure site and disappear before being read                                   click to remove and tick to not show again                                                    1 1 1                   1 1 5 1 1
              Soundtrack         cannot add song once search          If you click play from the search dropdown you are given a 30 second preview and by the time
  33                                                                                                                                                               put an add track to playlist button onto the preview area                                                                 1                    1         1
              creation           dropdown disappears                  this has finished the add button has gone
  5          Profile           can't find edit profile            Edit profile is expected to be at top right with username                                    show "settings" and "edit profile" next to username (see 1)                                   1       1 1 1 1                 5 1
              Soundtrack
  34                             CRASH                                The buy button on the preview player has a broken link                                            ?                                                                                                                    1                    1         1
  6           creation
             Profile           CRASH                              “Begin creating your profile by clicking here.” link broken on profile page                  ?                                                                                             1               1 1         1 4 1

                                 unexpected result from clicking
  8
  7           Soundtracks CRASH
             Profile                                             rank button has a magnifying glass
                                                              Loading animation stuck upon entering help area via top link from profile page                   ?        change to button showing 2 triangles up and down                                     1                   1           1 1                  1     1
                                 rank
                               unexpected result from clicking
  8          Soundtracks                                       rank button has a magnifying glass                                                              change to button showing 2 triangles up and down                                              1                               1       1
                               rank
                                 Unsure how long soundtracks
  9           Soundtracks                                             no info on length in truncated view                                                               add number of songs in playlist to truncated view and make this the button to expand                     1       1       1            1 4       1
                                 are
                               Unsure how long soundtracks
  9          Soundtracks                                          no info on length in truncated view                                                          add number of songs in playlist to truncated view and make this the button to expand          1       1       1           1 4         1
                               are
                                                                                                                                                                      remove dragging feature from site as it is difficult to use on many platforms and prone to
                              Difficulty and frustration with    Dragged item jumps to right upon drag, target area to small, still allows drag when no
  16          Soundtracks                                                                                                                                  highlight search even whenfollowing link or have the with: "add > give results in stacks titled cat >
                                                                                                                                                                      errors result after executed well, replace search page soundtrack > soundtrack                     1 1   1 1 1 1 6                                1 1
                              dragging
                            Disorientation from following     Results pages shows linksto land on, help a list of soundtracks, does not appear relevant to
                                                                 soundtrack available that take you to balloon and tool top text not specific enough
  10         Search results                                                                                                                                by resultsSoundtrack Name" as and have the title theadd button orgive a summary of My Soundtracks 1
                                                                                                                                                                       location within the site a dropdown under only link also in the area where          1     1       1   4   1 1 1
                            search result link                search
                              Disappointment with not                                                                                                      results and optional filter or pick from a category e.g. "tracks"
  26          Soundtracks     knowing how appropriate            No info on BPM                                                                                       Adding BPM information                                                                               1           1                                1
                              songs are for exercise                                                                                                       Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
  11         Global         TECH                              The regular back button on the browser does not work                                                                                                                                         1     1 1 1 1     5 1 1 1 1
                                                                                                                                                           still-work-ajax-page-loads
                                                                 When playing a soundtrack, after the first 30 second preview is over the second song begins
  27          Soundtracks     TECH                                                                                                                                    ?                                                                                                    1           1                                1
                                                                 but the artwork, name and artists from the first song persist
             SoundTrack                                                                                                                                        should be listed under "share" as extra option when selecting "by email" and less confusing
  12                           Not noticed STY4U                  Confusing name "STY4U" and share function has email option                                                                                                                                 1       1           1 1 1 5                  1
             creation                                                                                                                                          terminology
  28          Soundtracks        CRASH                                When clicking "tracks>9 to 5" dialogue box :"error: [object Object]"                              ?                                                                                                                        1        1 1 3 1
                                                                                                                                                              User entered Occupations then support for searching them alternatively a comprehensive list
             Users             Hard to find peoples actual
  13                                                         Categories for occupation asked for at signup are to vague                                       of professional areas but to select this from a dropdown would not be usable as the list    1 1                    1           3                1
             Occupation        occupation
                                Disorientation when creating                                                                                                            This task should have another stage after selecting birthday asking weather users wish to
  20          STY4U                                                   clicking image of birthday instead of "create" button takes users to "tracks>party>birthday" be to long
                                                                                                                                                              would                                                                                                                  1                            1         1
                                 STY4U                                                                                                                                  create on or see what other users have chosen first
  14         Profile           CRASH                              "error: [object Object]" upon clicking "edit profile" from profile page                      ?                                                                                             1 1                         1 3 1
                                                                      people seem to expect it to be at the bottom, but I think that the positioning and style gives
  29          STY4U              sent button a little hard to find                                                                                                      move the send button to be aligned with the creation box                                                             1 1                  2         1
                               difficulty finding help on how to    users banner blindness to that area
  15         Help                                                confusing terminology "Your VOICE"                                                            rename You VOICE with your profile at least in the help area                                      1                   1       2 1
                               edit profile
                                 Confusion over if the recipient
  37          STY4U                                                   once the email is entered on the STY4U screen the email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users                                                            1                1         1
                                 is correct                                                                                                                    remove dragging feature from site as it is difficult to use on many platforms and prone to
                               Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no          errors even when executed well, replace with: "add > soundtrack > soundtrack cat >
  16         Soundtracks                                                                                                                                                                                                                                   1 1     1 1 1 1 6                         1 1
                               draggingretype details again after
                                 has to                        soundtrack available to land on, help balloon and tool top text not specific enough             Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
              Terms and                                                                                                                                                  terms should be either a separate window (with a print button perhaps?) or have an accept
  29                             going back from terms and            no accept button on terms and conditions                                                 tab opens                                                                                                   1                                      1 1
              Conditions                                                                                                                                                button at the bottom or be a collapsible or scroll box
                                 conditions page
                                                                Described by quote: "A calendar is for planning and you don’t have to plan your own date of
  17         Profile           Frustration with DOB input able the "#calendar starts on the tracks page that indicates how many soundtracks different Replace date of birth input with 3 dropdowns for day month and year
                                 frustration with not being    birth" The soundtracks" with todays date, Also the incorrect input dialogue defines a the track features                                                                                          1 1         1 1 1 1 6 1
  22          Tracks             to explore from "tracks" over to
                                                                formatis expected to be a link "did/mm/yyyy" when actually "did-mm-my"                                  Make "# soundtracks" a link to the soundtracks that the track is in                                          1           1        1       3     1
                                                                    in to the accepted one i.e. to those soundtracks
                                 the "soundtracks" it features in
                                                                  Help area instructs users to start the STY4U process at the home page which one user could            User entered Occupations then support for searching them alternatively a comprehensive list
                                                                                                                                                               Restructure of site navigation and repurpose of home page(see details and illustrations in
  18          Users
             Global              Hard to find peoples actual
                               Difficulty navigating to STY4U                                                                                                                                                                                              1                                 1            1
  13                                                              not get to
                                                                      Categories for occupation asked for at signup are to vague                               main document)
                                                                                                                                                                        of professional areas but to select this from a dropdown would not be usable as the list    1 1                               1           3             1
              Occupation         occupation
                                                                                                                                                                        would be to long
                                                                                                                                                               Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
                               Difficulty finding created         The My Soundtracks pop out tab is not clear and shows categories that have no playlists so   soundtracks created" when empty, once the user has more than a few then introduce the
  19         Global                                                                                                                                                                                                                                              1           1 1             3       1 1
                               soundtracks                        will not seem relevant also the profile area is difficult to find                            sorting categories and only ones that are populated with created soundtracks, Also
results and optional filter or pick from a category e.g. "tracks"

                               Search appears broken when
 25         Search results                                           there is no feedback on search results                                                                profile a "nothing found when you searched for <users search>" type of message                                       1       1                2     1       1
                               no results are fund

            SoundTrack                                                                                                                                                     should be listed under "share" as extra option when selecting "by email" and less confusing
 12                            Not noticed STY4U                     Confusing name "STY4U" and share function has email option                                                                                                                                                         1       1            1 1 1 5               1
            creation                                                                                                                                                       terminology

            Soundtrack                                               When adding a perhaps lesser known song:"error: [object:
 30                            CRASH                                                                                                                                       ?                                                                                                                        1        1           2 1 1
            creation                                                 Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta >

            Soundtrack         cannot add song once search           If you click play from the search dropdown you are given a 30 second preview and by the time
 33                                                                                                                                                               put an add track to playlist button onto the preview area                                                                         1                    1         1
            creation           dropdown disappears                   this has finished the add button has gone

Issues on the STY4U creation screen
 34
            Soundtrack
            creation
                               CRASH                                 The buy button on the preview player has a broken link                                                ?                                                                                                                        1                    1         1

Only 3 users found this screenrank buttononemagnifying glass Only the yonger people figured out what 2 triangles up and down
  8      Soundtracks
                     unexpected result from clicking and
                     rank
                                                               has a of                              change to button showing                                                                                                                                                           1                                1     1

them needed to look at the help several                                 a “STY4U” stood for, I belive this is due to
times and also are
  9      Soundtracks enter the helpdesk on length in truncated view peoples ability to abstract slowly diminishingtruncated view and make this the button to expand
                     Unsure how long soundtracks
                                                     no info roleplay                                add number of songs in playlist to                                                                                                                                                 1       1       1            1 4       1

to find it.                                                             past the age of around 21. remove dragging feature from site as it is difficult to use on many platforms and prone to
 16         Soundtracks
                               Difficulty and frustration with                                               http://www.inclusivedesigntoolkit.com/betterdesign2/well, replace with: "add > soundtrack > soundtrack cat >
                                                                     Dragged item jumps to right upon drag, target area to small, still allows drag when no
                                                                                                                                                 errors even when executed                                                                                                                  1 1         1 1 1 1 6              1 1
                               dragging                              soundtrack available to land on, help balloon and tool top text not specific enough
                                                                                                             UCthinking/thinking.html#p50
Of the 2Soundtracksfound how on their own,onone senton
         who knowing it appropriate 8 participants
            Issues found by                                                                                  www.soundtracktoyour.com Name" as a dropdown under add button or in the area where My Soundtracks
                                                                                                                                                 Soundtrack
                     Disappointment with not
 26                                          No info BPM                                                                                                                   Adding BPM information                                                                                               1                        1     1
the birthday messageexercise wrong person.
                     songs are for to the
                                                                     When playing a soundtrack, after the first 30 second preview is over the second song begins
 27         Soundtracks        TECH                                                                                                                                        ?                                                                                                                    1                        1     1
                                                                     but the artwork, name and artists from the first song persist
                                                                                                                                                                                                                                                                            Participants                    Tasks
 Record
 28         Soundtracks Description
                         CRASH
           Location                                              Cause clicking "tracks>9 to 5" dialogue box :"error: [object Object]"
                                                                   When                                                                                                  ?
                                                                                                                                                                 Solution (redesign recommendation)                                                                1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 3 1
                                                                                                                                                                                                                                                                                      1     1 1
 order
 1         Home              unsure if logged in                 No direct indication of login status                                                            have username display top right on every page                                                     1 1          1           1       4 1 1
                               Disorientation when creating                                                                                                                This task should have another stage after selecting birthday asking weather users wish to
 20         STY4U                                                    clicking image of birthday instead of "create" button takes users to "tracks>party>birthday"                                                                                                                           1                            1         1
                               STY4U                                                                                                                                       create on or see what other users have chosen first
 2         Home              difficulty navigating to profile    Confusing terminology " my soundtracks"                                                         Click username to enter profile (see 1)                                                           1                1 1 1 1 5 1
                                                                     people seem to expect it to be at the bottom, but I think that the positioning and style gives
 29         STY4U              sent button a little hard to find                                                                                                           move the send button to be aligned with the creation box                                                                 1 1                  2         1
 3         Login / Signup Difficulty on Sign up                     users banner blindness to that area
                                                                 Sign up text too small                                                                          clear separate button for signup                                                                  1 1 1 1              1 1 1 7 1

                               Confusion over if the recipient
 37         STY4U                                                    once the email is entered on the STY4U screen the email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users                                                                    1                1         1
 4         Global              is correct
                             frustration with help balloons      Help balloons obscure site and disappear before being read                                      click to remove and tick to not show again                                                        1 1 1                    1 1 5 1 1

                               has to retype details again after
 5
            Terms and
           Profile           can't findbackprofileterms and Editno accept button on termstop right with username
                                                                                                                                                                           terms should be either a separate window (with a print button perhaps?) or have1an accept 1 1
 29                            going edit from                  profile is expected to be at and conditions                                                      show "settings" and "edit profile" next to username (see 1)                                    1 1                                 5 1
                                                                                                                                                                                                                                                                                                    1                    1 1
            Conditions                                                                                                                                                     button at the bottom or be a collapsible or scroll box
                               conditions page
 6         Profile           CRASH                               “Begin creating your profile by clicking here.” link broken on profile page                     ?                                                                                                 1                1 1         1 4 1
                              frustration with not being able
                                                                the "# soundtracks" on the tracks page that indicates how many soundtracks the track features
 22         Tracks            to explore from "tracks" over to                                                                                                Make "# soundtracks" a link to the soundtracks that the track is in                                                           1           1        1       3     1
 7         Profile           CRASH                           Loading expected to be upon entering help area via top link from profile page
                                                                in is animation stuck a link to those soundtracks                                    ?                                                                                                             1                                1 1
                              the "soundtracks" it features in
                             unexpected result from clicking                                                                                                               User entered Occupations then support for searching them alternatively a comprehensive list
 8          Users
           Soundtracks         Hard to find peoples actual rank button has a magnifying glass                                                                    change to button showing 2 triangles up and down                                         1                                         1       1
 13                          rank                              Categories for occupation asked for at signup are to vague                                                  of professional areas but to select this from a dropdown would not be usable as the list    1 1                                   1           3             1
            Occupation         occupation
                                                                                                                                                                           would be to long
                             Unsure how long soundtracks
 9         Soundtracks                                           no info on length in truncated view                                                             add number of songs in playlist to truncated view and make this the button to expand              1        1       1           1 4         1
                             are

                                                                                                                                                                 highlight search result after following link or have the search page give results in stacks titled
                             Disorientation from following       Results pages shows links that take you to a list of soundtracks, does not appear relevant to
 10        Search results                                                                                                                                        by results location within the site and have the title the only link also give a summary of        1       1       1       1       4       1 1 1
                             search result link                  search
                                                                                                                                                                 results and optional filter or pick from a category e.g. "tracks"

                                                                                                                                                                 Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
 11        Global            TECH                                The regular back button on the browser does not work                                                                                                                                    1                  1 1 1 1                 5 1 1 1 1
                                                                                                                                                                 still-work-ajax-page-loads

           SoundTrack                                                                                                                                            should be listed under "share" as extra option when selecting "by email" and less confusing
 12                          Not noticed STY4U                   Confusing name "STY4U" and share function has email option                                                                                                                                        1        1           1 1 1 5                  1
           creation                                                                                                                                              terminology

                                                                                                                                                                 User entered Occupations then support for searching them alternatively a comprehensive list
           Users             Hard to find peoples actual
 13                                                              Categories for occupation asked for at signup are to vague                                      of professional areas but to select this from a dropdown would not be usable as the list    1 1                        1           3                1
           Occupation        occupation
                                                                                                                                                                 would be to long

 14        Profile           CRASH                               "error: [object Object]" upon clicking "edit profile" from profile page                         ?                                                                                                 1 1                          1 3 1

                             difficulty finding help on how to
 15        Help                                                confusing terminology "Your VOICE"                                                                rename You VOICE with your profile at least in the help area                                           1                   1       2 1
                             edit profile

                                                                                                                                                                 remove dragging feature from site as it is difficult to use on many platforms and prone to
                             Difficulty and frustration with     Dragged item jumps to right upon drag, target area to small, still allows drag when no          errors even when executed well, replace with: "add > soundtrack > soundtrack cat >
 16        Soundtracks                                                                                                                                                                                                                                                  1 1         1 1 1 1 6               1 1
                             dragging                            soundtrack available to land on, help balloon and tool top text not specific enough             Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
                                                                                                                                                                 tab opens

                                                                 Described by quote: "A calendar is for planning and you don’t have to plan your own date of
 17        Profile           Frustration with DOB input          birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                 1 1         1 1 1 1 6 1
                                                                 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"

                                                                 Help area instructs users to start the STY4U process at the home page which one user could      Restructure of site navigation and repurpose of home page(see details and illustrations in
 18        Global            Difficulty navigating to STY4U                                                                                                                                                                                                             1                           1            1
                                                                 not get to                                                                                      main document)

                                                                                                                                                                 Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
                             Difficulty finding created          The My Soundtracks pop out tab is not clear and shows categories that have no playlists so      soundtracks created" when empty, once the user has more than a few then introduce the
 19        Global                                                                                                                                                                                                                                                       1           1 1             3       1 1
Issues found by 8 participants on www.soundtracktoyour.com

                                                                                                                                                                                                                                                                                                Participants                 Tasks
 Record
            Location          Description                            Cause                                                                                                 Solution (redesign recommendation)                                                                           1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4
Issues on the help screen
 order
 4          Global            frustration with help balloons         Help balloons obscure site and disappear before being read                                            click to remove and tick to not show again                                                                   1 1 1                   1 1 5 1 1

The keyGlobal
 18        issue with the help area get to instructs users to start the STY4U process at the home page which one user could
                 Difficulty navigating to STY4U
                                                not
                                                      was the
                                                Help area                                                                                                                  Restructure of site navigation and repurpose of home page(see details and illustrations in
                                                                                                                                                                           main document)
                                                                                                                                                                                                                                                                                            1                         1          1

terminology used when referencign the pop out tab is not clear and shows categories that have no playlists so
 19      Global
                 Difficulty finding created     The My Soundtracks
                                                                                                                                                                           Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
                                                                                                                                                                           soundtracks created" when empty, once the user has more than a few then introduce the                            1           1 1           3      1 1
profile.         soundtracks                    will not seem relevant also the profile area is difficult to find
                                                                                                                                                                           sorting categories and only ones that are populated with created soundtracks, Also
                                                                                                                                                                           Would need the search function to be redesigned to and turned into a more complicated
 30         Global            Can't search for years                 No support for searching via time                                                                                                                                                                                              1           1     2          1
                                                                                                                                                                           function in itself.

 32         Global IssuesSoundtracks drawer largely participantsareon www.soundtracktoyour.comare populated with created soundtracks, Also the sorting categories and only ones
                        My
                             found by 8 around but serves no use as thebroadfunction relevance to every task but this area is always Remove the My Soundtracks pop out then introduce
                        useless
                                                    The displayed categories to
                                                                                drag
                                                                                     to have
                                                                                             is unusable.                            that
                                                                                                                                                                                                                                                                                                    1           1     2      1

                                                                                                                                                                           menu rollovers should be only links to pages or specific functions not parts of a function (see
 36         Global            Rollover is annoying                   The rollover is far to large and contains to much and is difficult to make it disappear                                                                                                                                            1       1     2 1        1
                                                                                                                                                                           navigation redesign)
                              Settings dropdown wont go
 39         Global                                                   User are not expecting this to a toggle on and off action                                             make this a rollover or have it disappear after a second or 2                                                                            1 1 1
                              away
                                                                                                                                                                                                                                                                            Participants                    Tasks
 Record                                                                                                                                                                    Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
 11         Location
             Global         Description
                             TECH                                Cause regular back button on the browser does not work
                                                                   The                                                                                           Solution (redesign recommendation)                                                  1 2 3 4 5 1 7 1 ∑ t1 t2 t3 t4
                                                                                                                                                                                                                                                                   6 8 1 1 1                                          5 1 1 1 1
 order                                                                                                                                                                     still-work-ajax-page-loads
 1         Home             unsure if logged in                  No direct indication of login status                                                            have username display top right on every page                                                     1 1          1           1       4 1 1
                              difficulty finding help on how to
 15         Help                                                confusing terminology "Your VOICE"                                                                         rename You VOICE with your profile at least in the help area                                                     1                   1     2 1
                              edit profile
 2         Home             difficulty navigating to profile     Confusing terminology " my soundtracks"                                                         Click username to enter profile (see 1)                                                           1                1 1 1 1 5 1

 31
 3          Help            Spelling
           Login / Signup Difficulty on Sign up                     Draw should be "drawer" in this context
                                                                 Sign up text too small                                                                          clear separate button draw
                                                                                                                                                                          drawer not for signup                                                                    1 1 1 1                    1
                                                                                                                                                                                                                                                                                        1 1 1 7 1                     1 1

 4         Global           frustration with help balloons       Help balloons obscure site and disappear before being read                                      click to remove and tick to not show again                                                        1 1 1                    1 1 5 1 1
 1          Home              unsure if logged in                    No direct indication of login status                                                                  have username display top right on every page                                                                1 1         1           1     4 1 1

 5         Profile          can't find edit profile              Edit profile is expected to be at top right with username                                       show "settings" and "edit profile" next to username (see 1)                                       1        1 1 1 1                 5 1
 2          Home              difficulty navigating to profile       Confusing terminology " my soundtracks"                                                               Click username to enter profile (see 1)                                                                      1               1 1 1 1 5 1
 6         Profile          CRASH                                “Begin creating your profile by clicking here.” link broken on profile page                     ?                                                                                                 1                1 1          1 4 1
                                                                                                                                                                           If this is to be on the home page it should be smaller, and have a more subtle animation,
 7         Profile           Frustration with the movement The movement on the homepage help area via top link from cannon be stopped to read.?One
                            CRASH                        Loading animation stuck upon entering moves to frequently and profile page                                                                                                                         1                                       1 1
 28         Home                                                                                                                                                           should change less frequently and be able to be frozen so the user can read or keep what is                              1           1     2 1
                              on the home page                       user said it reminded them of adverts and would have immediately left the site.
                                                                                                                                                                           there.
                            unexpected result from clicking
 8         Soundtracks        "philum" not recognized as a rank button has a magnifying glass                                                                    change to button showing 2 triangles up and down                                                  1                                1       1
 35         Home            rank                               The reasoning behind this naming is not explained                                                           Change link title to be more descriptive                                                                                 1                 1
                              link to the video
                          Unsure how long soundtracks
 9
 3         Soundtracks
            Login / Signupare
                            Difficulty on Sign up                no info on length too small view
                                                                     Sign up text in truncated                                                                   add number of songs in playlist to truncated view and make this the button to expand
                                                                                                                                                                         clear separate button for signup                                                          1        1       1 1 1 1 4
                                                                                                                                                                                                                                                                                          1 1               1 1 1 7 1
                                                                                                                                                                                                                                                                                                            1

                                                                                                                                                                 highlight search result after following link or have the search page give results in stacks titled
                            Disorientation from following        Results pages shows links that take you to a list of soundtracks, does not appear relevant to
 10        Search results                                                                                                                                        by results location within the site and have the title the only link also give a summary of        1       1       1       1       4       1 1 1
                            search result link
                              Didn’t notice that had not         search
 38         Login / Signup                                           no error feedback on terms and conditions tick box, also the tick box it quite small        results and optional checkbox larger a category e.g. "tracks" text
                                                                                                                                                                           make the filter or pick from and add red feedback                                                                                    1     1 1
                              ticked terms and conditions
                                                                                                                                                                 Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
 11        Global           TECH                                 The regular back button on the browser does not work                                                                                                                                    1                  1 1 1 1                 5 1 1 1 1
                                                                                                                                                                 still-work-ajax-page-loads

 5         SoundTrack
            Profile           can't find edit profile                Edit profile is expected to be at top right with username                                   should beshow "settings" and as extra option when selecting "by email" and less confusing
                                                                                                                                                                           listed under "share" "edit profile" next to username (see 1)                                                 1       1 1 1 1               5 1
 12                         Not noticed STY4U                    Confusing name "STY4U" and share function has email option                                                                                                                                        1        1           1 1 1 5                 1
           creation                                                                                                                                              terminology

                                                                                                                                                                 User entered Occupations then support for searching them alternatively a comprehensive list
           Users            Hard to find peoples actual
 6
 13         Profile          CRASH                               Categories for occupation profile for at signuphere.” link broken on profile page
                                                                    “Begin creating your asked by clicking are to vague                                                    ?
                                                                                                                                                                 of professional areas but to select this from a dropdown would not be usable as the list    1 1                        1
                                                                                                                                                                                                                                                                                        1           3 1 1           11 4 1
           Occupation       occupation
                                                                                                                                                                 would be to long

 14        Profile          CRASH                                "error: [object Object]" upon clicking "edit profile" from profile page                         ?                                                                                                 1 1                           1 3 1
 7          Profile           CRASH
                            difficulty finding help on how to        Loading animation stuck upon entering help area via top link from profile page                        ?                                                                                                            1                             1 1
 15        Help                                                  confusing terminology "Your VOICE"                                                              rename You VOICE with your profile at least in the help area                                           1                   1       2 1
                            edit profile

                                                                                                                                                          remove dragging feature from site as it is difficult to use on many platforms and prone to
 14         Profile         Difficulty and frustration with
                              CRASH                              Dragged item jumps to right upon clicking "edit profile" fromstill allows drag when no
                                                                    "error: [object Object]" upon drag, target area to small, profile page                errors even when executed well, replace with: "add > soundtrack > soundtrack cat >
                                                                                                                                                                    ?                                                                                                                   1 1                         1 3 1
 16        Soundtracks                                                                                                                                                                                                                                                  1 1         1 1 1 1 6               1 1
                            dragging                             soundtrack available to land on, help balloon and tool top text not specific enough      Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
                                                                                                                                                          tab opens
                                                                     Described by quote: "A calendar is for planning and you don’t have to plan your own date of
 17         Profile           Frustration with DOB input             birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                                 1 1         1 1 1 1 6 1
                                                                 Described by quote: "A calendar is for planning and you don’t have to plan your own date of
                                                                      format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"
 17        Profile          Frustration with DOB input           birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                 1 1         1 1 1 1 6 1
                                                                 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"
 23         Profile           Pale yellow text hard to read          Not enough contrast between yellow and background                                                     Darker coloured text to replace light yellow, or outline, or darker background                                       1                     1 1
                                                                 Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurpose of home page(see details and illustrations in
 18        Global           Difficulty navigating to STY4U                                                                                                                                                                                                   1                                      1           1
                              Confusion about what the           not get to
                                                                     the layout does not indicate that the functions on the profile page are only applicable to the document)
                                                                                                                                                               main    If the main site navigation is restructured and the profile area functions placed under the
 24         Profile                                                                                                                                                                                                                                                                             1                     1              1
                              buttons on the profile page do         logged in user                                                                                        username at top right there will be enough distinction between areas. When viewing other
                                                                                                                                                       Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
                           Difficulty finding created      The My Soundtracks pop out tab is not clear and shows categories that have no playlists so  soundtracks created" when result after following link or have the search page give results in stacks titled
                                                                                                                                                                 highlight search empty, once the user has more than a few then introduce the
 19        Global            Disorientation from following      Results pages shows links that take you to a list of soundtracks, does not appear relevant to                                                                                           1         1 1                               3       1 1
 10         Search results soundtracks                     will not seem relevant also the profile area is difficult to find                                     by results location within the site and have the title the only link also give a summary of
                                                                                                                                                       sorting categories and only ones that are populated with created soundtracks, Also                           1                           1       1       1     4      1 1 1
                              search result link                     search
on the home page                      user said it reminded them of adverts and would have immediately left the site.
                                                                                                                                                                        there.
                             "philum" not recognized as a

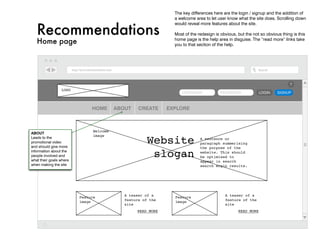

 35       Home                                                     The reasoning behind this naming is not explained                                                    Change link title to be more descriptive                                                                               1                    1
                             link to the video

 3        Login / Signup Difficulty on Sign up                     Sign up text too small                                                                               clear separate button for signup                                                                           1 1 1 1              1 1 1 7 1

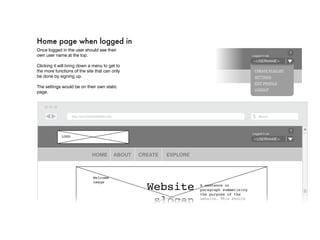

                             Didn’t notice that had not
 38       Login / Signup                                           no error feedback on terms and conditions tick box, also the tick box it quite small                 make the checkbox larger and add red feedback text                                                                                  1       1 1
                             ticked terms and conditions

 5        Profile            can't find edit profile               Edit profile is expected to be at top right with username                                            show "settings" and "edit profile" next to username (see 1)                                                1       1 1 1 1                  5 1

Issues on the search results screen
 6        Profile            CRASH                                 “Begin creating your profile by clicking here.” link broken on profile page                          ?                                                                                                          1               1 1          1 4 1

A lot of users where confused by the results
of their serchest using the search feild at the entering help area via top link from profile page
 7       Profile CRASH          Loading animation stuck upon                                                                                                            ?                                                                                                          1                                1 1

top of the page.
 14       Profile            CRASH                                 "error: [object Object]" upon clicking "edit profile" from profile page                              ?                                                                                                          1 1                          1 3 1

 17       Profile
                 Issues found by 8 participants on fordate, Also and incorrect input dialogueyour ownadate of Replace date of birth input with 3 dropdowns for day month and year
                      Frustration with DOB input
                                                 Described by quote: "A calendar is
                                                                                      www.soundtracktoyour.com
                                                 birth" The calendar starts with todays
                                                                                        planning
                                                                                                 the
                                                                                                     you don’t have to plan
                                                                                                                            defines different                                                                                                                                          1 1         1 1 1 1 6 1
                                                                   format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"

 23       Profile            Pale yellow text hard to read         Not enough contrast between yellow and background                                                    Darker coloured text to replace light yellow, or outline, or darker background                                     1                        1 1
                                                                                                                                                                                                                                                                       Participants                    Tasks
 Record                     Confusion about what the
 24       Location
           Profile         Description                         Causelayout does not indicate that the functions on the profile page are only applicable to the
                                                                 the                                                                                              If the main site navigation is restructured and the profile area functions placed under the 4 5 6 7 8 ∑ t1 t2 t3 t4
                                                                                                                                                          Solution (redesign recommendation)                                                         1 2 3            1               1                                           1
 order                       buttons on the profile page do        logged in user                                                                                       username at top right there will be enough distinction between areas. When viewing other
 1        Home             unsure if logged in                 No direct indication of login status                                                            have username display top right on every page                                                  1 1          1           1       4 1 1
                                                                                                                                                                highlight search result after following link or have the search page give results in stacks titled
                             Disorientation from following     Results pages shows links that take you to a list of soundtracks, does not appear relevant to
 10       Search results                                                                                                                                        by results location within the site and have the title the only link also give a summary of         1   1   1                               1       4     1 1 1
 2        Home               search result link
                           difficulty navigating to profile    search
                                                            Confusing terminology " my soundtracks"                                                   Click username to enter profile (see 1)                                                       1             1 1 1 1 5 1
                                                                                                                                                                results and optional filter or pick from a category e.g. "tracks"

 3                         Search appears broken when
          Login / Signup Difficulty on Sign up       Sign up text too small                                                                                    clear separate button for signup
 25       Search results                                           there is no feedback on search results                                                               profile a "nothing found when you searched for <users search>" type of message 1 1 1
                                                                                                                                                                                                                                                    1                              1 1 1 7 1
                                                                                                                                                                                                                                                                                           1       1                2     1       1
                             no results are fund

 4        Global           frustration with help balloons      Help balloons obscure site and disappear before being read                                      click to remove and tick to not show again                                                     1 1 1                    1 1 5 1 1
          SoundTrack                                                                                                                                                    should be listed under "share" as extra option when selecting "by email" and less confusing
 12                          Not noticed STY4U                     Confusing name "STY4U" and share function has email option                                                                                                                                                      1       1            1 1 1 5               1
          creation                                                                                                                                                      terminology
 5        Profile          can't find edit profile             Edit profile is expected to be at top right with username                                       show "settings" and "edit profile" next to username (see 1)                                    1        1 1 1 1                 5 1

 6         Soundtrack
          Profile          CRASH                               “Begin creating your perhaps lesser known song:"error: on profile page
                                                                  When adding a profile by clicking here.” link broken [object:                                ?                                                                                              1                1 1         1 4 1
 30                         CRASH                                                                                                                                       ?                                                                                                                    1          1           2 1 1
          creation                                                 Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta >
 7        Profile          CRASH                               Loading animation stuck upon entering help area via top link from profile page                  ?                                                                                              1                                1 1
          Soundtrack         cannot add song once search           If you click play from the search dropdown you are given a 30 second preview and by the time
 33                        unexpected result from clicking                                                                                                              put an add track to playlist button onto the preview area                                                              1                    1         1
 8         creation
          Soundtracks        dropdown disappears           rank button has a magnifying glass has gone
                                                               this has finished the add button                                                                change to button showing 2 triangles up and down                                               1                                1       1
                           rank

          Soundtrack       Unsure how long soundtracks
 34
 9        Soundtracks        CRASH                             no info on length in truncated view player has a broken link
                                                                   The buy button on the preview                                                                       ?
                                                                                                                                                               add number of songs in playlist to truncated view and make this the button to expand           1        1       1             1
                                                                                                                                                                                                                                                                                           1 4         1            1         1
           creation        are
                             unexpected result from clicking
 8        Soundtracks                                              rank button has a magnifying glass                                                          highlight search result after following link or have the and down give results in stacks titled
                                                                                                                                                                         change to button showing 2 triangles up search page                                                       1                                1     1
                           Disorientation from following
                             rank                              Results pages shows links that take you to a list of soundtracks, does not appear relevant to
 10       Search results                                                                                                                                       by results location within the site and have the title the only link also give a summary of     1       1       1       1       4       1 1 1
                           search result link                  search
                                                                                                                                                               results and optional filter or pick from a category e.g. "tracks"
                             Unsure how long soundtracks
 9        Soundtracks                                              no info on length in truncated view                                                                    add number of songs in playlist to truncated view and make this the button to expand
                                                                                                                                                               Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-               1                     1       1            1 4       1
 11       Global           TECH
                            are                                The regular back button on the browser does not work                                                                                                                                       1    1 1 1 1                         5 1 1 1 1
                                                                                                                                                               still-work-ajax-page-loads

          SoundTrack                                                                                                                              should beremove dragging feature from site whenis difficult "byuse on and less confusing
                                                                                                                                                            listed under "share" as extra option as it selecting to email" many platforms and prone to
 12                    Not noticedand frustration with Confusing name "STY4U" and share function has email optionsmall, still allows drag when no
                        Difficulty STY4U                  Dragged item jumps to right upon drag, target area to                                                                                                                               1     1                              1 1 1 5                  1
 16        Soundtracks
          creation                                                                                                                                         errors even when executed well, replace with: "add > soundtrack > soundtrack cat >
                                                                                                                                                  terminology                                                                                                                          1 1         1 1 1 1 6              1 1
                             dragging                              soundtrack available to land on, help balloon and tool top text not specific enough
                                                                                                                                                                        Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
                             Disappointment with not                                                                                                           User entered Occupations then support for searching them alternatively a comprehensive list
          Users        Hard to find peoples actual
 13
 26        Soundtracks  knowing how appropriate                Categories for occupation asked for at signup are to vague
                                                                  No info on BPM                                                                               of professional areas but to select this from a dropdown would not be usable as the list
                                                                                                                                                                         Adding BPM information                                                            1 1                     1       1 3                  1   1     1
          Occupation   occupation
                             songs are for exercise                                                                                                            would be to long
                                                                   When playing a soundtrack, after the first 30 second preview is over the second song begins
 27
 14        Soundtracks CRASH
          Profile       TECH                                   "error: [object Object]" upon clicking "edit profile" from profile page                   ?              ?                                                                                     1 1                          1 3 1                    1     1
                                                                   but the artwork, name and artists from the first song persist
                           difficulty finding help on how to
 15       Help                                                 confusing terminology "Your VOICE"                                                              rename You VOICE with your profile at least in the help area                                        1                   1       2 1
 28       Soundtracks edit profile
                       CRASH                                       When clicking "tracks>9 to 5" dialogue box :"error: [object Object]"                                 ?                                                                                                                          1        1 1 3 1

                                                                                                                                                         remove dragging feature from site as it is difficult to use on many platforms and prone to
                           Difficulty and frustrationcreating Dragged item jumps to right upon drag, target area to small, still allows drag when no
                             Disorientation when with                                                                                                    errors even when executed have replace with: "add > soundtrack > soundtrack cat >
                                                                                                                                                                   This task should well, another stage after selecting birthday asking weather users wish to
 20
 16        STY4U
          Soundtracks                                            clicking image of birthday instead of "create" button takes users to "tracks>party>birthday"                                                                                          1 1                     1 1 1 1 6
                                                                                                                                                                                                                                                                                   1                   1 1          1         1
                             STY4U
                           dragging                           soundtrack available to land on, help balloon and tool top text not specific enough        Soundtrack Name" as a dropdown under add have chosen first where My Soundtracks
                                                                                                                                                                   create on or see what other users button or in the area
                                                                                                                                                         tab opens
                                                                   people seem to expect it to be at the bottom, but I think that the positioning and style gives
 29       STY4U              sent button a little hard to find                                                                                                          move the send button to be aligned with the creation box                                                               1 1                  2         1
                                                           Describedbanner blindness to that area
                                                                users by quote: "A calendar is for planning and you don’t have to plan your own date of
 17       Profile          Frustration with DOB input      birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                  1 1         1 1 1 1 6 1
                             Confusion over if the recipient
                                                           format to the acceptedentered "did/mm/yyyy" when actually "did-mm-my" has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users
 37       STY4U                                                 once the email is one i.e. on the STY4U screen the email address                                                                                                                                                                   1                1         1
                             is correct
                                                             Help area instructs users to start the STY4U process at the home page which one user could        Restructure of site navigation and repurpose of home page(see details and illustrations in
 18       Global           Difficulty retype details again after
                             has to navigating to STY4U not get to                                                                                                                                                                                        1                                    1            1
          Terms and                                                                                                                                            main document)should be either a separate window (with a print button perhaps?) or have an accept
                                                                                                                                                                        terms
 29                          going back from terms and             no accept button on terms and conditions                                                                                                                                                                                    1                    1 1
          Conditions                                                                                                                                                    button at the bottom or be a collapsible or scroll box
                             conditions page                                                                                                                 Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
                           Difficulty finding created       The My Soundtracks pop out tab is not clear and shows categories that have no playlists so       soundtracks created" when empty, once the user has more than a few then introduce the
 19       Global             frustration with not being able                                                                                                                                                                                                       1           1 1             3       1 1
                           soundtracks                      will not seem relevant also the profile area is difficult to find how many soundtracks the track sorting categories and only ones that are populated with created soundtracks, Also
                                                                 the "# soundtracks" on the tracks page that indicates                                       features
 22       Tracks             to explore from "tracks" over to                                                                                                           Make "# soundtracks" a link to the soundtracks that the track is in                                            1           1        1       3     1
34                           CRASH                                 The buy button on the preview player has a broken link                                                ?                                                                                                                       1                    1         1
            creation

                              unexpected result from clicking
 8          Soundtracks                                       rank button has a magnifying glass                                                                          change to button showing 2 triangles up and down                                                           1                                 1     1
                              rank

                              Unsure how long soundtracks
 9          Soundtracks                                             no info on length in truncated view                                                                   add number of songs in playlist to truncated view and make this the button to expand                       1        1       1            1 4       1
                              are

                                                                                                                                                                          remove dragging feature from site as it is difficult to use on many platforms and prone to
                              Difficulty and frustration with       Dragged item jumps to right upon drag, target area to small, still allows drag when no
 16         Soundtracks                                                                                                                                                   errors even when executed well, replace with: "add > soundtrack > soundtrack cat >                              1 1         1 1 1 1 6              1 1
                              dragging                              soundtrack available to land on, help balloon and tool top text not specific enough
                                                                                                                                                                          Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
                              Disappointment with not
 26         Soundtracks       knowing how appropriate               No info on BPM                                                                                        Adding BPM information                                                                                              1                        1     1
                              songs are for exercise
                                                                    When playing a soundtrack, after the first 30 second preview is over the second song begins
Issues on the users screen
 27         Soundtracks       TECH
                                                                    but the artwork, name and artists from the first song persist
                                                                                                                                                                          ?                                                                                                                   1                        1     1

 28         Soundtracks       CRASH                                 When clicking "tracks>9 to 5" dialogue box :"error: [object Object]"                                  ?                                                                                                                           1        1 1 3 1
The filtering functions and the way narrow
users are catagorised when creating clicking imagemadeinstead of "create" button takes users to "tracks>party>birthday"
 20      STY4U
                 Disorientation by occupation
                                                     of birthday it
                                                                                                                                                                          This task should have another stage after selecting birthday asking weather users wish to
                                                                                                                                                                                                                                                                                          1                            1         1
                 STY4U                                                                                                                                                    create on or see what other users have chosen first
hard for most users to complete fast 4. it to be at the bottom, but I think that the positioning and style gives
                                       people seem to expect
 29         STY4U             sent button a little hard to find                                                                                                           move the send button to be aligned with the creation box                                                                1 1                  2         1
                                                                    users banner blindness to that area

                              Confusion over if the recipient
 37         STY4U
                  Issues found by 8 participantsonon www.soundtracktoyour.com a unique naming issue then it should be hidden from users
                       is correct
                                    once the email is entered the STY4U screen the email address has a "gg_" at the beginning If it is                                                                                                                                                                1                1         1

                              has to retype details again after
            Terms and                                                                                                                                                     terms should be either a separate window (with a print button perhaps?) or have an accept
 29                           going back from terms and         no accept button on terms and conditions                                                                                                                                                                                          1                    1 1
            Conditions                                                                                                                                                    button at the bottom or be a collapsible or scroll box
                              conditions page

                              frustration with not being able                                                                                                                                                                                                              Participants                   Tasks
 Record
 22
 order
            TracksIssues found by to8inparticipants on that indicates how many soundtracks the track SolutionMake "# soundtracks" a link to the soundtracks that the track is in
           Location
                       to explore from "tracks" over
                      Description
                                                       the "# soundtracks" on the tracks page
                                                                                              www.soundtracktoyour.comrecommendation)
                                                     Cause expected to be a link to those soundtracks
                                                         is
                                                                                                              features
                                                                                                                       (redesign
                                                                                                                                                                                                                                                                                          1
                                                                                                                                                                                                                                                                  1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4
                                                                                                                                                                                                                                                                                                      1        1       3     1
                              the "soundtracks" it features in
 1         Home             unsure if logged in                 No direct indication of login status                                                            have usernameentered top right on every page
                                                                                                                                                                         User display Occupations then support for searching them alternatively a comprehensive list
                                                                                                                                                                                                                                                      1 1      1                          1       4 1 1
            Users             Hard to find peoples actual
 13                                                                 Categories for occupation asked for at signup are to vague                                            of professional areas but to select this from a dropdown would not be usable as the list                   1 1                   1           3             1
            Occupation        occupation
 2         Home             difficulty navigating to profile    Confusing terminology " my soundtracks"                                                                   would be to long
                                                                                                                                                                Click username to enter profile (see 1)                                                  1                       1 1 1 1 5 1
            Users             Confusion with results or
 21                                                                 No indication on how or if how the results are filtered                                               A visually separate filtration area that shows which filters are active and possible                            1 1                          2             1
            Occupation        filtering by occupation
 3         Login / Signup Difficulty on Sign up                 Sign up text too small                                                                          clear separate button for signup                                                                  1 1 1 1            1 1 1 7 1
            Users
 40                           TECH                                  When filtering to Sports and Leisure the text is repeated in another font on top of the main text ?                                                                                                                                            1 1       1
            Occupation
 4         Global           frustration with help balloons      Help balloons obscure site and disappear before being read                                      click to remove and tick to not show again                                                        1 1 1                   1 1 5 1 1

 5         Profile          can't find edit profile             Edit profile is expected to be at top right with username                                       show "settings" and "edit profile" next to username (see 1)                                       1        1 1 1 1                5 1

 6         Profile          CRASH                               “Begin creating your profile by clicking here.” link broken on profile page                     ?                                                                                                 1              1 1          1 4 1

 7         Profile          CRASH                               Loading animation stuck upon entering help area via top link from profile page                  ?                                                                                                 1                               1 1

                            unexpected result from clicking
 8         Soundtracks                                      rank button has a magnifying glass                                                                  change to button showing 2 triangles up and down                                                  1                               1       1
                            rank

                            Unsure how long soundtracks
 9         Soundtracks                                          no info on length in truncated view                                                             add number of songs in playlist to truncated view and make this the button to expand              1        1     1            1 4         1
                            are

                                                                                                                                                                highlight search result after following link or have the search page give results in stacks titled
                            Disorientation from following       Results pages shows links that take you to a list of soundtracks, does not appear relevant to
 10        Search results                                                                                                                                       by results location within the site and have the title the only link also give a summary of        1       1     1        1       4       1 1 1
                            search result link                  search
                                                                                                                                                                results and optional filter or pick from a category e.g. "tracks"

                                                                                                                                                                Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
 11        Global           TECH                                The regular back button on the browser does not work                                                                                                                                    1                  1 1 1 1                5 1 1 1 1
                                                                                                                                                                still-work-ajax-page-loads

           SoundTrack                                                                                                                                           should be listed under "share" as extra option when selecting "by email" and less confusing
 12                         Not noticed STY4U                   Confusing name "STY4U" and share function has email option                                                                                                                                        1        1         1 1 1 5                   1
           creation                                                                                                                                             terminology

                                                                                                                                                                User entered Occupations then support for searching them alternatively a comprehensive list
           Users            Hard to find peoples actual
 13                                                             Categories for occupation asked for at signup are to vague                                      of professional areas but to select this from a dropdown would not be usable as the list    1 1                      1            3                1
           Occupation       occupation
                                                                                                                                                                would be to long

 14        Profile          CRASH                               "error: [object Object]" upon clicking "edit profile" from profile page                         ?                                                                                                 1 1                         1 3 1

                            difficulty finding help on how to
 15        Help                                               confusing terminology "Your VOICE"                                                                rename You VOICE with your profile at least in the help area                                           1                  1       2 1
                            edit profile

                                                                                                                                                                remove dragging feature from site as it is difficult to use on many platforms and prone to
                            Difficulty and frustration with     Dragged item jumps to right upon drag, target area to small, still allows drag when no          errors even when executed well, replace with: "add > soundtrack > soundtrack cat >
 16        Soundtracks                                                                                                                                                                                                                                                 1 1       1 1 1 1 6                1 1
                            dragging                            soundtrack available to land on, help balloon and tool top text not specific enough             Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
                                                                                                                                                                tab opens

                                                                Described by quote: "A calendar is for planning and you don’t have to plan your own date of
 17        Profile          Frustration with DOB input          birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                 1 1       1 1 1 1 6 1
                                                                format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"

                                                                Help area instructs users to start the STY4U process at the home page which one user could      Restructure of site navigation and repurpose of home page(see details and illustrations in
 18        Global           Difficulty navigating to STY4U                                                                                                                                                                                                             1                          1            1
                                                                not get to                                                                                      main document)

                                                                                                                                                                Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
                            Difficulty finding created          The My Soundtracks pop out tab is not clear and shows categories that have no playlists so      soundtracks created" when empty, once the user has more than a few then introduce the
 19        Global                                                                                                                                                                                                                                                      1         1 1              3       1 1
                            soundtracks                         will not seem relevant also the profile area is difficult to find                               sorting categories and only ones that are populated with created soundtracks, Also
34                           CRASH                                 The buy button on the preview player has a broken link                                                ?                                                                                                                       1                    1         1
            creation

                              unexpected result from clicking
 8          Soundtracks                                       rank button has a magnifying glass                                                                          change to button showing 2 triangles up and down                                                           1                                 1     1
                              rank

                              Unsure how long soundtracks
 9          Soundtracks                                             no info on length in truncated view                                                                   add number of songs in playlist to truncated view and make this the button to expand                       1        1       1            1 4       1
                              are

                                                                                                                                                                          remove dragging feature from site as it is difficult to use on many platforms and prone to
                              Difficulty and frustration with       Dragged item jumps to right upon drag, target area to small, still allows drag when no
 16         Soundtracks                                                                                                                                                   errors even when executed well, replace with: "add > soundtrack > soundtrack cat >                              1 1         1 1 1 1 6              1 1
                              dragging                              soundtrack available to land on, help balloon and tool top text not specific enough
                                                                                                                                                                          Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
                              Disappointment with not
 26         Soundtracks       knowing how appropriate               No info on BPM                                                                                        Adding BPM information                                                                                              1                        1     1
                              songs are for exercise
                                                                    When playing a soundtrack, after the first 30 second preview is over the second song begins
Issues on the users screen
 27         Soundtracks       TECH
                                                                    but the artwork, name and artists from the first song persist
                                                                                                                                                                          ?                                                                                                                   1                        1     1

 28         Soundtracks       CRASH                                 When clicking "tracks>9 to 5" dialogue box :"error: [object Object]"                                  ?                                                                                                                           1        1 1 3 1
The filtering functions and the way narrow
users are catagorised when creating clicking imagemadeinstead of "create" button takes users to "tracks>party>birthday"
 20      STY4U
                 Disorientation by occupation
                                                     of birthday it
                                                                                                                                                                          This task should have another stage after selecting birthday asking weather users wish to
                                                                                                                                                                                                                                                                                          1                            1         1
                 STY4U                                                                                                                                                    create on or see what other users have chosen first
hard for most users to complete fast 4. it to be at the bottom, but I think that the positioning and style gives
                                       people seem to expect
 29         STY4U             sent button a little hard to find                                                                                                           move the send button to be aligned with the creation box                                                                1 1                  2         1
                                                                    users banner blindness to that area

                              Confusion over if the recipient
 37         STY4U
                  Issues found by 8 participantsonon www.soundtracktoyour.com a unique naming issue then it should be hidden from users
                       is correct
                                    once the email is entered the STY4U screen the email address has a "gg_" at the beginning If it is                                                                                                                                                                1                1         1

                              has to retype details again after
            Terms and                                                                                                                                                     terms should be either a separate window (with a print button perhaps?) or have an accept
 29                           going back from terms and         no accept button on terms and conditions                                                                                                                                                                                          1                    1 1
            Conditions                                                                                                                                                    button at the bottom or be a collapsible or scroll box
                              conditions page

                              frustration with not being able                                                                                                                                                                                                              Participants                   Tasks
 Record
 22
 order
            TracksIssues found by to8inparticipants on that indicates how many soundtracks the track SolutionMake "# soundtracks" a link to the soundtracks that the track is in
           Location
                       to explore from "tracks" over
                      Description
                                                       the "# soundtracks" on the tracks page
                                                                                              www.soundtracktoyour.comrecommendation)
                                                     Cause expected to be a link to those soundtracks
                                                         is
                                                                                                              features
                                                                                                                       (redesign
                                                                                                                                                                                                                                                                                          1
                                                                                                                                                                                                                                                                  1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4
                                                                                                                                                                                                                                                                                                      1        1       3     1
                              the "soundtracks" it features in
 1         Home             unsure if logged in                 No direct indication of login status                                                            have usernameentered top right on every page
                                                                                                                                                                         User display Occupations then support for searching them alternatively a comprehensive list
                                                                                                                                                                                                                                                      1 1      1                          1       4 1 1
            Users             Hard to find peoples actual
 13                                                                 Categories for occupation asked for at signup are to vague                                            of professional areas but to select this from a dropdown would not be usable as the list                   1 1                   1           3             1
            Occupation        occupation
 2         Home             difficulty navigating to profile    Confusing terminology " my soundtracks"                                                                   would be to long
                                                                                                                                                                Click username to enter profile (see 1)                                                  1                       1 1 1 1 5 1
            Users             Confusion with results or
 21                                                                 No indication on how or if how the results are filtered                                               A visually separate filtration area that shows which filters are active and possible                            1 1                          2             1
            Occupation        filtering by occupation
 3         Login / Signup Difficulty on Sign up                 Sign up text too small                                                                          clear separate button for signup                                                                  1 1 1 1            1 1 1 7 1
            Users
 40                           TECH                                  When filtering to Sports and Leisure the text is repeated in another font on top of the main text ?                                                                                                                                            1 1       1
            Occupation
 4         Global           frustration with help balloons      Help balloons obscure site and disappear before being read                                      click to remove and tick to not show again                                                        1 1 1                   1 1 5 1 1

 5         Profile          can't find edit profile             Edit profile is expected to be at top right with username                                       show "settings" and "edit profile" next to username (see 1)                                       1        1 1 1 1                5 1

 6         Profile          CRASH                               “Begin creating your profile by clicking here.” link broken on profile page                     ?                                                                                                 1              1 1          1 4 1

 7         Profile          CRASH                               Loading animation stuck upon entering help area via top link from profile page                  ?                                                                                                 1                               1 1

                            unexpected result from clicking
 8         Soundtracks                                      rank button has a magnifying glass                                                                  change to button showing 2 triangles up and down                                                  1                               1       1
                            rank

                            Unsure how long soundtracks
 9         Soundtracks                                          no info on length in truncated view                                                             add number of songs in playlist to truncated view and make this the button to expand              1        1     1            1 4         1
                            are

                                                                                                                                                                highlight search result after following link or have the search page give results in stacks titled
                            Disorientation from following       Results pages shows links that take you to a list of soundtracks, does not appear relevant to
 10        Search results                                                                                                                                       by results location within the site and have the title the only link also give a summary of        1       1     1        1       4       1 1 1
                            search result link                  search
                                                                                                                                                                results and optional filter or pick from a category e.g. "tracks"

                                                                                                                                                                Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
 11        Global           TECH                                The regular back button on the browser does not work                                                                                                                                    1                  1 1 1 1                5 1 1 1 1
                                                                                                                                                                still-work-ajax-page-loads

           SoundTrack                                                                                                                                           should be listed under "share" as extra option when selecting "by email" and less confusing
 12                         Not noticed STY4U                   Confusing name "STY4U" and share function has email option                                                                                                                                        1        1         1 1 1 5                   1
           creation                                                                                                                                             terminology

                                                                                                                                                                User entered Occupations then support for searching them alternatively a comprehensive list
           Users            Hard to find peoples actual
 13                                                             Categories for occupation asked for at signup are to vague                                      of professional areas but to select this from a dropdown would not be usable as the list    1 1                      1            3                1
           Occupation       occupation
                                                                                                                                                                would be to long

 14        Profile          CRASH                               "error: [object Object]" upon clicking "edit profile" from profile page                         ?                                                                                                 1 1                         1 3 1

                            difficulty finding help on how to
 15        Help                                               confusing terminology "Your VOICE"                                                                rename You VOICE with your profile at least in the help area                                           1                  1       2 1
                            edit profile

                                                                                                                                                                remove dragging feature from site as it is difficult to use on many platforms and prone to
                            Difficulty and frustration with     Dragged item jumps to right upon drag, target area to small, still allows drag when no          errors even when executed well, replace with: "add > soundtrack > soundtrack cat >
 16        Soundtracks                                                                                                                                                                                                                                                 1 1       1 1 1 1 6                1 1
                            dragging                            soundtrack available to land on, help balloon and tool top text not specific enough             Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
                                                                                                                                                                tab opens

                                                                Described by quote: "A calendar is for planning and you don’t have to plan your own date of
 17        Profile          Frustration with DOB input          birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                 1 1       1 1 1 1 6 1
                                                                format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"

                                                                Help area instructs users to start the STY4U process at the home page which one user could      Restructure of site navigation and repurpose of home page(see details and illustrations in
 18        Global           Difficulty navigating to STY4U                                                                                                                                                                                                             1                          1            1
                                                                not get to                                                                                      main document)

                                                                                                                                                                Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
                            Difficulty finding created          The My Soundtracks pop out tab is not clear and shows categories that have no playlists so      soundtracks created" when empty, once the user has more than a few then introduce the
 19        Global                                                                                                                                                                                                                                                      1         1 1              3       1 1
                            soundtracks                         will not seem relevant also the profile area is difficult to find                               sorting categories and only ones that are populated with created soundtracks, Also
The key differences here are the login / signup and the addition of
                                                               a welcome area to let user know what the site does. Scrolling down

   Recommendations
                                                               would reveal more features about the site.

                                                               Most of the redesign is obvious, but the not so obvious thing is this
   Home page                                                   home page is the help area in disguise. The “read more” links take
                                                               you to that section of the help.

                                                                                                                            ?
                 LOGO
                                                                  Username             Password             Login    Signup

                              HOME       ABOUT    CREATE     EXPLORE

                               Welcome
ABOUT

                                                      Website
Leads to the                                                                A sentence or
promotional video                                                           paragraph summerising
and should give more

                                                       slogan
                                                                            the purpose of the
information about the                                                       website. This should
people involved and                                                         be optimised to
what their goals where                                                      appear in search
when making the site                                                        search engin results.

                                            A teaser of a                                A teaser of a
                         Feature                               Feature
                                            feature of the                               feature of the
                         image                                 image
                                            site                                         site
                                                 READ MORE                                      READ MORE
Home page when logged in
Once logged in the user should see their
                                                                                                              ?
own user name at the top.                                                                  Logged in as:

                                                                                           <username>
Clicking it will bring down a menu to get to
the more functions of the site that can only                                                Create Playlist
be done by signing up.                                                                      Settings
                                                                                            Edit profile
The settings would be on their own static
                                                                                            logout
page.

                                                                                                              ?
                                                                                           Logged in as:
             LOGO
                                                                                           <username>

                             HOME       ABOUT   CREATE   EXPLORE

                             Welcome

                                                  Website
                                                                   A sentence or
                                                                   paragraph summerising

                                                   slogan
                                                                   the purpose of the
                                                                   website. This should
                                                                   be optimised to
                                                                   appear in search
                                                                   search engin results.
Sitemap

HOME
ABOUT                    CREATE                  EXPLORE                       HELP               Profile accessed
 The promotional video    E-card                  Soundracks                     Help Catagorys   by clicking user
 Purpose of site           Category                Search Soundtracks                             name
 Staff Bio                  Top level category     Category
 Company History            Sub category            Top level category
                                                    Sub category
                                                      Soundtracks index
                          Soundtrack
                           Category
                            Top level category    Tracks
                                                   Search Tracks
                            Sub category
                                                   Category
                                                    Top level category
                                                    Sub category
                                                      Tracks index

                                                  Users
                                                   Filter users via search
                                                     Individual user profile
                                                     Individual user profile
                                                     Individual user profile
The changes to this page are subtle, The button to expand the track
                                                               list has moved to the bottom right and there is information on the
                                                               number of tracks and the length of the soundtrack in minutes under
                                                               the list name.

Soundtracks index                                              The category name has been removed, this information is now
                                                               indicated by highlighting the relevant part of the breadcrumbs.

                                                                                                                              ?
                                                                                                       Logged in as:
          LOGO
                                                                                                       <username>

                      HOME          ABOUT     CREATE         EXPLORE

                 Soundtracks > category > Sub-category                                                                 Play
                                                                                                                       individual
                                                                                                                       track
                                       <List Name>              <Artist>     -    <Song Name>
                           <USERID>    <Number of tracks>

                     View Profile
                                       <List Length(time)>      <Artist>     -    <Song Name>               rank   1
                                                                <Artist>     -    <Song Name>
                                                                                            Expand

                                       <List Name>              <Artist>     -    <Song Name>
  Buttons for:
  •	 Playing
                           <USERID>    <Number of tracks>
                                       <List Length(time)>      <Artist>     -    <Song Name>               rank   2
  •	 Like            View Profile
                                                                <Artist>     -    <Song Name>
                                                                                            Expand
  •	 Share
  •	 Buy

                                       <List Name>              <Artist>     -    <Song Name>
                           <USERID>    <Number of tracks>
                                       <List Length(time)>      <Artist>     -    <Song Name>               rank   3
                     View Profile
                                                                <Artist>     -    <Song Name>
                                                                                            Expand
The 2 major changes to this page ate that the number of
                                                            soundtracks the track features in is a link that will show a
                                                            soundtracks index page for those soundtracks.

                                                            Also the drag and drop feature is replaced with a drop-down menu
Tracks index                                                detailed on the next page.

                                                                                                                           ?
                                                                                                      Logged in as:
       LOGO
                                                                                                      <username>

                   HOME    ABOUT         CREATE           EXPLORE

              Tracks > category > Sub-category

                      <Artist>     -     <Song Name>                Features in:
                                                                    15 Soundtracks
                                                                                                           rank   1
                                 Add to your soundtrack

                      <Artist>     -     <Song Name>                Features in:
                                                                    15 Soundtracks                         rank   2
                                 Add to your soundtrack

                      <Artist>     -     <Song Name>                Features in:
                                                                    15 Soundtracks                         rank   3
                                 Add to your soundtrack
Instead of dragging users will have 3 more clicks to pick a
                                                              soundtrack to add it to. Alternatively the 2 most recently created
                                                              soundtracks could be chosen from the top of the drop-down.
Tracks index

                          <Artist>     -     <Song Name>              Features in:
                                                                      15 Soundtracks
                                                                                                           rank   1
                                     Add to your soundtrack

                   1         Add to your soundtrack
                             <Recently Created Soundtrack>
                             <Recently Created Soundtrack>

                             <Catagory populated with soundtrack>
                             <Catagory populated with soundtrack>
                             <Catagory populated with soundtrack>

2                                                                3
 Add to your soundtrack                                              Add to your soundtrack
 <Recently Created Soundtrack>                                       <Recently Created Soundtrack>
 <Recently Created Soundtrack>                                       <Recently Created Soundtrack>

 <Sub-Catagory populated with soundtrack>                            <Created Soundtrack>
 <Sub-Catagory populated with soundtrack>                            <Created soundtrack>
 <Sub-Catagory populated with soundtrack>
On this page the breadcrumb is again used to show users where
                                                                      they are and the descriptive title for the creation area lets people
                                                                      know what they are doing. The button to create the soundtrack has
    Soundtracks creation                                              been moved to the bottom right.

                                                                                                                                 ?
                                                                                                               Logged in as:
               LOGO
                                                                                                               <username>

                             HOME        ABOUT   CREATE          EXPLORE

                      Create > Soundtrack > Category > Sub-catagory > <listname>

                      CREATE your soundtrack in <sub-catagory>
                       <List Name>
                       <Number of tracks>        Search for tracks or arstis
                       <List Length(time)>

                                                       <Artist>       -        <Song Name>
                                                       <Artist>       -        <Song Name>
Buttons for:
                                                       <Artist>       -        <Song Name>
•	 Playing
•	 Like
•	 Share
•	 Buy

                                                                                                 Publish Now
Clicking the one share button will bring up a overlay where you
                                                                    can select comon methos of sharing or sent the formerly know as
                                                                    STY4U now named Musical E-card.
Sharing a Soundtrack

                                                                                                                            ?
                                                                                                            Logged in as:
      LOGO
                                                                                                            <username>

                       HOME      ABOUT        CREATE           EXPLORE

              Create > Soundtrack > Category > Sub-catagory > <listname>

              CREATE your soundtrack in <sub-catagory>
               <List Name>
               <Number of tracks>              Search for tracks or artstis
               <List Length(time)>

                                                     <Artist>       -     <Song Name>
                                                     <Artist>       -     <Song Name>

             Facebook                                <Artist>        -    <Song Name>

             Twitter
                                     Send Musical
                                     E-card
             Google+
                                                                                              Publish Now
The Search page will have a section on the        for Would you live to try searching : Users or
                                    left showing filtering options with tick-boxes    Tracks instead?” The words users and tracks
                                    that show weather a filter is active or not.      would be links to the separate search pages.

                                    If no results a found and error message will      The layout of these pages would be the
Search function                     take the place of results                         same as this one.
                                    “Sorry we could not find what you searched

                                                                                                                          ?
                                                                                                       Logged in as:
        LOGO
                                                                                                       <username>

                     HOME     ABOUT      CREATE         EXPLORE

                Explore > Soundtracks > Search

                 Filter Results                           Search in Soundtracks

                   Year
                                                                           <List Name>
                                                            <USERID>       <Number of tracks>
                   Category                                                <List Length(time)>
                                                      View Profile
                     Sub-category                                                        Expand

                                                                           <List Name>
                                                            <USERID>       <Number of tracks>
                                                                           <List Length(time)>
                                                      View Profile
    Checkboxs                                                                            Expand
New Critical paths

  Task 1             Task 2             Task 3           Task 4

   Critical path      Critical path      Critical path    Critical path

        signup            Explore            Create            Explore

      edit profile      soundtracks           E-card            Users

                         a workout           category        Filter Users
                         category

                                            Search and
                        preview tack        add tracks     View user profile

                         buy playlist      Add Message

                                              Send
Criticisms

Method
•	 Not clear enough about involvement and
   objectives of the study.
•	 Should have been more specific about
   the tasks.
•	 Should have left the room for filling out
   questionnaires.
•	 Should not have recorded the
   questionnaires.
•	 Should have worded nearly all the
   questions very differently and repeated
   that they be answered objectively.
•	 The open ended questions where to
   frequent and not of much use. Instead of
   the open ended questions should have
   only asked for negative points.
•	 Mistake on one of the questionnaires is a
   scale of 5 instead of 7.
•	 One of the scales is reversed goes from
   positive to negative.
•	 The pre-questionaire questions are
   largely irrelevant.
Appendices
•	 Full Table of Issues
•	 Task Cards
•	 Task Notes
•	 Task Data Entry sheets
Issues found by 8 participants on www.soundtracktoyour.com

                                                                                                                                                                                                                                                                          Participants                Tasks
Record
         Location         Description                         Cause                                                                                            Solution (redesign recommendation)                                                                1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4
order
1        Home             unsure if logged in                 No direct indication of login status                                                             have username display top right on every page                                                     1 1          1           1     4 1 1

2        Home             difficulty navigating to profile    Confusing terminology " my soundtracks"                                                          Click username to enter profile (see 1)                                                           1                1 1 1 1 5 1

3        Login / Signup Difficulty on Sign up                 Sign up text too small                                                                           clear separate button for signup                                                                  1 1 1 1              1 1 1 7 1

4        Global           frustration with help balloons      Help balloons obscure site and disappear before being read                                       click to remove and tick to not show again                                                        1 1 1                    1 1 5 1 1

5        Profile          can't find edit profile             Edit profile is expected to be at top right with username                                        show "settings" and "edit profile" next to username (see 1)                                       1        1 1 1 1               5 1

6        Profile          CRASH                               “Begin creating your profile by clicking here.” link broken on profile page                      ?                                                                                                 1                1 1         1 4 1

7        Profile          CRASH                               Loading animation stuck upon entering help area via top link from profile page                   ?                                                                                                 1                              1 1

                          unexpected result from clicking
8        Soundtracks                                      rank button has a magnifying glass                                                                   change to button showing 2 triangles up and down                                                  1                              1     1
                          rank

                          Unsure how long soundtracks
9        Soundtracks                                          no info on length in truncated view                                                              add number of songs in playlist to truncated view and make this the button to expand              1        1       1           1 4     1
                          are

                                                                                                                                                               highlight search result after following link or have the search page give results in stacks titled
                          Disorientation from following       Results pages shows links that take you to a list of soundtracks, does not appear relevant to
10       Search results                                                                                                                                        by results location within the site and have the title the only link also give a summary of        1       1       1       1     4     1 1 1
                          search result link                  search
                                                                                                                                                               results and optional filter or pick from a category e.g. "tracks"

                                                                                                                                                               Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button-
11       Global           TECH                                The regular back button on the browser does not work                                                                                                                                     1                  1 1 1 1               5 1 1 1 1
                                                                                                                                                               still-work-ajax-page-loads

         SoundTrack                                                                                                                                            should be listed under "share" as extra option when selecting "by email" and less confusing
12                        Not noticed STY4U                   Confusing name "STY4U" and share function has email option                                                                                                                                         1        1           1 1 1 5             1
         creation                                                                                                                                              terminology

                                                                                                                                                               User entered Occupations then support for searching them alternatively a comprehensive list
         Users            Hard to find peoples actual
13                                                            Categories for occupation asked for at signup are to vague                                       of professional areas but to select this from a dropdown would not be usable as the list    1 1                        1         3             1
         Occupation       occupation
                                                                                                                                                               would be to long

14       Profile          CRASH                               "error: [object Object]" upon clicking "edit profile" from profile page                          ?                                                                                                 1 1                          1 3 1

                          difficulty finding help on how to
15       Help                                               confusing terminology "Your VOICE"                                                                 rename You VOICE with your profile at least in the help area                                           1                   1     2 1
                          edit profile

                                                                                                                                                               remove dragging feature from site as it is difficult to use on many platforms and prone to
                          Difficulty and frustration with     Dragged item jumps to right upon drag, target area to small, still allows drag when no           errors even when executed well, replace with: "add > soundtrack > soundtrack cat >
16       Soundtracks                                                                                                                                                                                                                                                  1 1         1 1 1 1 6           1 1
                          dragging                            soundtrack available to land on, help balloon and tool top text not specific enough              Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks
                                                                                                                                                               tab opens

                                                              Described by quote: "A calendar is for planning and you don’t have to plan your own date of
17       Profile          Frustration with DOB input          birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year                                  1 1         1 1 1 1 6 1
                                                              format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my"

                                                              Help area instructs users to start the STY4U process at the home page which one user could       Restructure of site navigation and repurpose of home page(see details and illustrations in
18       Global           Difficulty navigating to STY4U                                                                                                                                                                                                              1                         1         1
                                                              not get to                                                                                       main document)

                                                                                                                                                               Remove the My Soundtracks pop out or have it only show the created soundtracks or "no
                          Difficulty finding created          The My Soundtracks pop out tab is not clear and shows categories that have no playlists so       soundtracks created" when empty, once the user has more than a few then introduce the
19       Global                                                                                                                                                                                                                                                       1           1 1           3     1 1
                          soundtracks                         will not seem relevant also the profile area is difficult to find                                sorting categories and only ones that are populated with created soundtracks, Also
                                                                                                                                                               Restructure of site navigation (see details and illustrations in main document)

                          Disorientation when creating                                                                                                         This task should have another stage after selecting birthday asking weather users wish to
20       STY4U                                                clicking image of birthday instead of "create" button takes users to "tracks>party>birthday"                                                                                                            1                         1         1
                          STY4U                                                                                                                                create on or see what other users have chosen first

         Users            Confusion with results or
21                                                            No indication on how or if how the results are filtered                                          A visually separate filtration area that shows which filters are active and possible                   1 1                       2             1
         Occupation       filtering by occupation

                          frustration with not being able
                                                           the "# soundtracks" on the tracks page that indicates how many soundtracks the track features
22       Tracks           to explore from "tracks" over to                                                                                               Make "# soundtracks" a link to the soundtracks that the track is in                                          1           1       1     3     1
                                                           in is expected to be a link to those soundtracks
                          the "soundtracks" it features in

23       Profile          Pale yellow text hard to read       Not enough contrast between yellow and background                                                Darker coloured text to replace light yellow, or outline, or darker background                             1                     1 1

                                                                                                                                                               If the main site navigation is restructured and the profile area functions placed under the
                          Confusion about what the            the layout does not indicate that the functions on the profile page are only applicable to the
24       Profile                                                                                                                                               username at top right there will be enough distinction between areas. When viewing other                   1                     1             1
                          buttons on the profile page do      logged in user
                                                                                                                                                               user profiles it may work to use the current layout.

                          Search appears broken when
25       Search results                                       there is no feedback on search results                                                           profile a "nothing found when you searched for <users search>" type of message                             1       1             2     1       1
                          no results are fund

                          Disappointment with not
26       Soundtracks      knowing how appropriate             No info on BPM                                                                                   Adding BPM information                                                                                     1                     1     1
                          songs are for exercise

                                                              When playing a soundtrack, after the first 30 second preview is over the second song begins
27       Soundtracks      TECH                                                                                                                                 ?                                                                                                          1                     1     1
                                                              but the artwork, name and artists from the first song persist

                                                                                                                                                               If this is to be on the home page it should be smaller, and have a more subtle animation,
                          Frustration with the movement       The movement on the homepage moves to frequently and cannon be stopped to read. One
28       Home                                                                                                                                                  should change less frequently and be able to be frozen so the user can read or keep what is                    1           1     2 1
                          on the home page                    user said it reminded them of adverts and would have immediately left the site.
                                                                                                                                                               there.

28       Soundtracks      CRASH                               When clicking "tracks>9 to 5" dialogue box :"error: [object Object]"                             ?                                                                                                                  1       1 1 3 1

                                                              people seem to expect it to be at the bottom, but I think that the positioning and style gives
29       STY4U            sent button a little hard to find                                                                                                    move the send button to be aligned with the creation box                                                       1 1               2         1
                                                              users banner blindness to that area

                          has to retype details again after
         Terms and                                                                                                                                             terms should be either a separate window (with a print button perhaps?) or have an accept
29                        going back from terms and         no accept button on terms and conditions                                                                                                                                                                          1                 1 1
         Conditions                                                                                                                                            button at the bottom or be a collapsible or scroll box
                          conditions page

                                                                                                                                                               Would need the search function to be redesigned to and turned into a more complicated
30       Global           Can't search for years              No support for searching via time                                                                                                                                                                               1           1     2         1
                                                                                                                                                               function in itself.

         Soundtrack                                           When adding a perhaps lesser known song:"error: [object:
30                        CRASH                                                                                                                                ?                                                                                                              1       1         2 1 1
         creation                                             Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta >

31       Help             Spelling                            Draw should be "drawer" in this context                                                          drawer not draw                                                                                                1                 1 1

                          My Soundtracks drawer largely The displayed categories are to broad to have relevance to every task but this area is always          Remove the My Soundtracks pop out then introduce the sorting categories and only ones
32       Global                                                                                                                                                                                                                                                               1           1     2     1
                          useless                       around but serves no use as the drag function is unusable.                                             that are populated with created soundtracks, Also

         Soundtrack       cannot add song once search         If you click play from the search dropdown you are given a 30 second preview and by the time
33                                                                                                                                                         put an add track to playlist button onto the preview area                                                          1                 1         1
         creation         dropdown disappears                 this has finished the add button has gone

         Soundtrack
34                        CRASH                               The buy button on the preview player has a broken link                                           ?                                                                                                              1                 1         1
         creation

                          "philum" not recognized as a
35       Home                                                 The reasoning behind this naming is not explained                                                Change link title to be more descriptive                                                                       1                 1
                          link to the video

                                                                                                                                                               menu rollovers should be only links to pages or specific functions not parts of a function (see
36       Global           Rollover is annoying                The rollover is far to large and contains to much and is difficult to make it disappear                                                                                                                             1       1     2 1       1
                                                                                                                                                               navigation redesign)

                          Confusion over if the recipient
37       STY4U                                                once the email is entered on the STY4U screen the email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users                                                     1             1         1
                          is correct

                        Didn’t notice that had not
38       Login / Signup                                       no error feedback on terms and conditions tick box, also the tick box it quite small             make the checkbox larger and add red feedback text                                                                         1     1 1
                        ticked terms and conditions

                          Settings dropdown wont go
39       Global                                               User are not expecting this to a toggle on and off action                                        make this a rollover or have it disappear after a second or 2                                                                  1 1 1
                          away

         Users
40                        TECH                                When filtering to Sports and Leisure the text is repeated in another font on top of the main text ?                                                                                                                             1 1     1
         Occupation
Task 1
Sign up for soundtracktoyour.com     To indicate you are
                                     finished please tell
                                     the conductor
You have decided to explore
                                     “I’m finished”
a new site for discovering and
sharing music.

You wish to sign up and then add
relevant details about you to your
area within the site.
Task 2
Find and buy a 20 minutes playlist   You will indicate
to exercise to as you are just       you have finished
                                     this task when you
about to start a new exercise
                                     are redirected to
regime.                              the iTune store.

You want to buy at least 20          Don’t worry you
minutes worth of appropriate         wont buy anything
music to get your heart pumping      by accident.
whilst you do cardio vascular
exercise.
Task 3
Make a playlist that reminds     You will indicate
you of being 19 and send it to   you have finished
                                 when the email is
a friend with a message that
                                 sent.
congratulates them on their
19th birthday.                   This is my email
                                 address.
your friends email address is:
“james.maclean@jqim.co.uk”
Task 4
Find out what sort of music IT        You will indicate you
professionals listen to.              have competed this
                                      task when you tell the
                                      conductor what sort
A curious friend has recently         of music you think IT
asked you a burning question,         professionals listen to.
what sort of music does the IT
department listen to?

The conductor will play the part of
your curious friend.
Need help?
If you get stuck try to persevere,     To signal you wish
as we are interested in improving      to speak to the
                                       help desk pick up
the experience for everyone and
                                       this card and a
we learn more for mistakes than        telephone role play
success.                               will begin.

If you get really stuck try and find
a help area, or if you feel it is
beyond that you can make a fake
call to the help desk.
Task 1   Task order:

         Participant:

NOTES

                        Critical path

                          login / signup

                         my soundtracks

                         open my voice

                           edit profile
Task 2   Task order:

         Participant:

NOTES

                        Critical path

                          soundtracks

                           a workout
                           category

                          preview tack

                           buy playlist
Task 3   Task order:

         Participant:

NOTES                   Critical path

                         my soundtracks

                             create
                           soundtrack

                           use search
                            function

                            add track

                           edit details

                           enter name

                         send a STY4U

                           enter email

                         enter a greeting

                              send
Task 4   Task order:

         Participant:

NOTES

                        Critical path

                           users > all

                          occupation >
                           technology

                            a profile

                             view
                          soundtracks
11/29/12                                                POST ‑ Task 4

             POST ­ Task 4
             * Required

             Participant number: *
             to be answered by the conductor

             Overall how satisfied are you with the ease of completion of the task? *
                                        1    2    3    4    5      6    7

             completly unsatisfied                                          completely satisfied

             How credible do you feel the the site is for the information you have found? *
                              1    2    3    4    5    6    7

             no credibility                                       complete credibility

               Submit

             Powered by Google Docs

             Report Abuse ­ Terms of Service ­ Additional Terms

https://docs.google.com/a/jqim.co.uk/spreadsheet/viewform?formkey=dHhRTVJBSjN5RkFyVzQ3b…           1/1
11/29/12                                                POST ‑ Task 3

             POST ­ Task 3
             * Required

             Participant number: *
             to be answered by the conductor

             Overall how satisfied are you with the ease of completion of the task? *
                                        1    2    3   4    5      6     7

             completly unsatisfied                                          completely satisfied

               Submit

             Powered by Google Docs

             Report Abuse ­ Terms of Service ­ Additional Terms

https://docs.google.com/a/jqim.co.uk/spreadsheet/viewform?formkey=dE1lZXh1c1JWSHhGaHhSd…           1/1
11/29/12                                               POST ‑ Task 2

            POST ­ Task 2
            * Required

            Participant number: *
            to be answered by the conductor

            Overall how satisfied are you with the ease of completion of the task? *
                                       1    2    3    4    5      6    7

            completly unsatisfied                                          completely satisfied

            How satisfied are you with the music you selected for this task? *
                                        1    2    3    4    5

            completely unsatisfied                                completely satisfied

              Submit

             Powered by Google Docs

             Report Abuse ­ Terms of Service ­ Additional Terms

https://docs.google.com/a/jqim.co.uk/spreadsheet/viewform?formkey=dFA4Y3Nud2lubmRPbTZNX…          1/1
11/29/12                                                POST ‑ task 1

             POST ­ task 1
             * Required

             Participant number: *
             to be answered by the conductor

             Overall how easy was this task? *
             create a profile and add bio info
                     1    2    3    4    5    6    7

             Easy                                      Difficult

             What do you make of the appearance of the site?
             Does it appear how you expected?

             How satisfied where you with the completion of this task? *
                                         1    2    3    4    5     6    7

             completely unsatisfied                                         completely satisfied

               Submit

             Powered by Google Docs

             Report Abuse ­ Terms of Service ­ Additional Terms

https://docs.google.com/a/jqim.co.uk/spreadsheet/viewform?formkey=dENJVGJGbXR5TGVweFJ…             1/1
Minor Assists (refer to help page)

-                                                Task 1           Task 2           Task 3           Task 4
                                 Participant 1               1                1
                                 Participant 2               2                1                1
                                 Participant 3                                1                1
                                 Participant 4               1
                                 Participant 5               1
                                 Participant 6               1                1                                 1
                                 Participant 7               1
                                 Participant 8

Major Assists (help desk role play)
-                                                Task 1           Task 2           Task 3           Task 4
                                 Participant 1
                                 Participant 2               1                2                1                1
                                 Participant 3
                                 Participant 4
                                 Participant 5
                                 Participant 6                                                                  1
                                 Participant 7               1
                                 Participant 8

Errors (deviation from critical path)

-                                                Task 1           Task 2           Task 3           Task 4
                                 Participant 1                2
                                 Participant 2                3               3                3                1
                                 Participant 3                7               2                8                5
                                 Participant 4               10
                                 Participant 5                4               2                4                5
                                 Participant 6               14                                                 7
                                 Participant 7               11               4                4                2
                                 Participant 8                5                                7

Task success 0=fail 1=partial 2=success
-                                                Task 1           Task 2           Task 3           Task 4
                                 Participant 1               2                2                1                2
                                 Participant 2               0                0                0                0

                                 Participant 3               2                0                1                2
                                 Participant 4               0                0                0                0
                                 Participant 5               1                2                2                2
                                 Participant 6               1                2                1                0
                                 Participant 7               0                1                1                2
                                 Participant 8               2                2                1                2

                                                 Task
  1        Task
  2        Task
  3        Task
  4
Total
  errors
  per
  task                               56               11               26               20
Time on Task 1          start       end        total
          Participant 1    00:01:37   00:07:36    00:05:59               Mean: 00:09:44
          Participant 2    00:00:00   00:11:55    00:11:55             Median: 00:09:14
          Participant 3    00:02:20   00:09:03    00:06:43   Standard Deviation: 00:04:23
          Participant 4    00:00:00   00:18:45    00:18:45
          Participant 5    00:02:35   00:07:33    00:04:58
          Participant 6    00:00:00   00:09:42    00:09:42
          Participant 7    00:00:14   00:11:19    00:11:05
          Participant 8    00:00:00   00:08:47    00:08:47

Time on Task 2          start       end        total                                                    Time                                         Average Time on task
          Participant 1    00:09:26   00:13:36    00:04:10               Mean: 00:05:46     Task
  1      00:09:44                 (error bars represent 90% confidence interval)
          Participant 2    00:31:58   00:39:49    00:07:51             Median: 00:05:07     Task
  2      00:05:46            0:00
     0:01
      0:02
     0:04
     0:05
     0:07
     0:08
     0:10
     0:11

          Participant 3    00:19:33   00:24:40    00:05:07   Standard Deviation: 00:01:35   Task
  3      00:07:25
          Participant 4                                                                     Task
  4      00:04:17
          Participant 5    00:18:31   00:23:50    00:05:19
          Participant 6    00:21:25   00:29:36    00:08:11
                                                                                                                      Task 1         00:09:44
          Participant 7    00:16:19   00:21:23    00:05:04
          Participant 8    00:26:30   00:31:10    00:04:40

Time on Task 3          start       end        total
          Participant 1    00:14:42   00:19:50    00:05:08               Mean: 00:07:25                               Task 2         00:05:46
          Participant 2    00:15:03   00:26:39    00:11:36             Median: 00:07:25
          Participant 3    00:26:12   00:34:43    00:08:31   Standard Deviation: 00:03:15
          Participant 4
          Participant 5    00:08:43   00:12:48    00:04:05
          Participant 6    00:30:21   00:34:10    00:03:49                                                            Task 3         00:07:25
          Participant 7    00:20:44   00:28:09    00:07:25
          Participant 8    00:12:29   00:23:51    00:11:22

Time on Task 4          start       end        total
          Participant 1    00:20:24   00:22:22    00:01:58               Mean: 00:04:17                               Task 4         00:04:17
          Participant 2    00:27:19   00:31:00    00:03:41             Median: 00:03:42
          Participant 3    00:12:49   00:17:25    00:04:36   Standard Deviation: 00:02:20
          Participant 4
          Participant 5    00:13:50   00:17:32    00:03:42
          Participant 6    00:10:38   00:19:00    00:08:22
          Participant 7    00:28:22   00:34:21    00:05:59
          Participant 8    00:24:09   00:25:50    00:01:41
Task
  1       Task
  2       Task
  3           Task
  4
Participant
  1               6               4                   6                       6
Participant
  2               5               3                   2                       1
Participant
  3               3               6                   7                       5
Participant
  5               4               4                   4                       3
Participant
  6               6               2                   7                       3
Participant
  7               1               1                   2                       1
Participant
  8               3               3                   1                       6

                                                                                               Satisfaction
                                                   7

                                                   6

                    Participant 1
                                                   5

                    Participant 2

                    Participant 3                  4

                    Participant 5
                                                   3

                    Participant 6

                    Participant 7                  2

                    Participant 8
                                                   1

                                                   0

                                                           0
                     1
               2
      3
     4

Usability study_of www.soundtracktoyour.com/

  • 1.
    Introduction A Usability Study of www.soundtracktoyour.com by James Maclean The current Environment There are many on-line and off-line What is missing is a way to explore The way I have described the functionality applications out there that can make and memories in the way that people more of memory is based on ancient greet sort and share playlists and also allow you naturally negate them inside their heads. theory that saw its first renaissance with the to listen to music and a usable way. Most of Where they begin at either a place or time Romans and more recently detailed in Yates, the services out there at the moment have which provokes a cascade of other sensory Frances A. (1966). The Art of Memory. solved the issue of musical inspiration by perceptions all at once. having a “similar artists” portion to explore. Similar artists features are normal governed Effective memory and more specifically by a database comparing profiles of musical recall has a weighting towards spaces. By taste filtered by music genres. that I mean that most of our memories are linked more to spaces than other variable. Some of the most popular services are: Peoples memories of time are actualy more • Spotify conceptual than factual. For instance when • iTunes recounting even recent events people will often tell the story in the wrong order, the • Deezer order of events comes out in a way that was • Soundcloud most meaning full to them. As time goes on this effect is transfered to larger portions of time. A great example of this is to ask a parent who’s children have grown up to tell some stories about when their child was young. They will be able to group stories into key stages but I doubt they will be able to accurately tell you in which order the events happened even with vivid memories.
  • 2.
    The current design The overall problem Aims of this study The website is in a beta stage and would However the main problem with the site The aim of this study is to determine which need a lot of refinement in order to attract is it does not deliver on its promise of parts of the sites basic functionality are a large user base. associating music with memories. The usable and how users feel about using them unique selling point of the software sounds and also if they felt any link between the The site offers an interesting take on the like it should be able to take you on a music and memories or if they felt memories discovery of “new” music where most other journey through places, times events and stir upon hearing a song where they able to services interpret new music as literally peoples memories of them. What It actually record them into the site in a satisfying way. new whereas refreshingly this site would does is show you list after list of songs. The hopefully take that to mean new to the user lists lack meaning or any connection with a specifically. The sites promotional video time and space. explains their ethos of trying to rank music based on individuals rather than traditional measures of musical success like money and popularity. But the same popular songs appear time after time on many different lists which reduces the credibility of the content in general.
  • 3.
    Predicted users Aged 40+ Because the site is aimed at exploring It is a well known phenomena that as people These older users have a similar experience memories associated with past experiences get older they turn less and less to new to this site with radio 4’s Desert Island disks the general user base for this site is over a music. in which guests showcase music important certain age where you look into the past for to them and the memories that surround musical inspiration. “it’s the natural process of popular culture them. to weed out the worst from earlier eras, This is evident in the current users of the and elevate the best. And just beyond the site and also the general lack of very recent established “best” (the Beatles and Stones- (last 1-2 years) music making the top of the level acts, in other words), there are so charts within the site. many fine bands and albums that never got their full due. Music buffs could spend the rest of their lives just discovering what they missed from their own lifetimes.” http://www.avclub.com/articles/why-do-popculture-fans- stop-caring-about-new-music,55805/ November 2012
  • 4.
    Methodology Order of events Eachsession will start with an introduction Then next three tasks will follow the same The tasks will be in a random order to where the participants will: structure but will be completed in a different counteract users learning the site as the • sign a consent form order for each consecutive participant session continues. • be given an overview of the study to reduce the effect of learning on the test results. After the sessions are finished I will mark • adjust the seating position to one they Errors, Time on Task, Task Success and are comfortable with After the three tasks the participants will Assists whilst watching the recording of • configure the mouse sensitivity and the then be asked to complete a final the session. This is done after as doing so direction of the scroll wheel to one they questionnaire about the site in general. during the sessions may put participants on are familiar with edge seeing me write something down every • learn about the “think aloud” protocol time they make a mistake. • complete a pre-task questionnaire The order of tasks for each participant: The first task will then begin with reading the printed task card and when I am sure they First Second Third Fourth understand the task we will begin recording Participant 1 Task 2 Task 3 Task 4 the session and work through the task. The Participant 2 Task 3 Task 4 Task 2 task be followed by a short questionnaire. Participant 3 Task 4 Task 2 Task 3 Participant 4 Task 2 Task 3 Task 4 Task 1 Participant 5 Task 3 Task 4 Task 2 Participant 6 Task 4 Task 2 Task 3 Participant 7 Task 2 Task 3 Task 4 Participant 8 Task 3 Task 4 Task 2
  • 5.
    Users Session setup I will aim to make the group of participants I will be using a piece of software called as representative of the predicted users as Silverback to record the sessions. The possible by making selections based mostly software records a head and shoulders on age. When looking for participants I shot of the participant, audio as well as gave a preference to people over the age capturing the screen and highlights mouse of 30 and more preference the older they clicks. This software can be controlled with got. But as the enjoyment of music is a a remote control which means I wont have fairly universal thing no specific criteria are to lean over the users to pause and stop the needed to take park in the study. recording. To make the group more representative of The users will all use the same the larger population I will make sure to have laptop and mouse. an equal number of males to females. The questionnaires will all be filled in online via Google documents. The tabs will all be open in the browser ready to be filled in, the reason for doing this twofold, it helps to let the users know what stage in the session they are and also shows a quick reference on the video which task the user is currently on when scanning the footage.
  • 6.
     46­55  over 55 How do you generally buy music *  CD 11/29/12 PRE ‑ task 1  itunes Pre-Task questions PRE ­ task 1  other digital  other phisical These questions * Required will be asked before Participant number * How often do you seek out music you have not heard before? * the recording starts Filled out by test conductor  Never the aim here is to  Rarely see if there is any  Ocassionaly correlation with the What is your gender? *  All the time information provided  Male here and how the  Female users behave. It is If never or rarely then why not more often? also a chance to  Other catch any opinions before the test starts. What is your age? *  18­24  25­34  35­45  46­55  over 55 If occasionally or all the time then how do you find music? 11/29/12 PRE ‑ task 1 https://docs.google.com/a/jqim.co.uk/spreadsheet/viewform?formkey=dGJKZGRvNlJidm5ObU5sR… 1/2 How do you generally buy music *  CD  itunes  other digital  other phisical Submit How often do you seek out music you have not heard before? *  Never Powered by Google Docs  Rarely Report Abuse ­ Terms of Service ­ Additional Terms  Ocassionaly  All the time If never or rarely then why not more often?
  • 7.
    The assist card Thiscard is given to the participants before starting the first task. They will be encouraged not to use for obvious reasons but what I will not tell them is that if they Need help? do enter this role play I will count that as a task fail as I can not imagine people would If you get stuck try to persevere, To signal you wish as we are interested in improving to speak to the tolerate that in the real world. help desk pick up the experience for everyone and this card and a Having this card around also reminds we learn more for mistakes than telephone role play participants that I will not answer their success. will begin. questions whilst the task is in progress. If you get really stuck try and find a help area, or if you feel it is beyond that you can make a fake call to the help desk. Printed task card given to participants
  • 8.
    Task 1 Make anaccount with STTY This task serves 2 functions, the first is to There will be no limit on this task and Critical path ease the participants into the idea of being although it will be recorded it I do not in a test situation and the “think aloud predict any significant findings in this area login / signup protocol” so they feel warmed up and give as how to make an effective login and sign a more natural response to the other tasks. up is a well documented affair and not the The second function is that a lot of the focus of this study. sites best features will be more effectively my soundtracks explored if the user has their own account. This is because memory is a personal thing and I feel the participants will not commit open my voice enough emotional to the site without their own space on the site to express themselves. I will ask them to create an account and add the following info: edit profile Task 1 • Display Name • Bio Sign up for soundtracktoyour.com To indicate you are finished please tell • First Name You have decided to explore the conductor “I’m finished” • Last Name a new site for discovering and • Gender sharing music. • Country You wish to sign up and then add • Occupation relevant details about you to your area within the site. Printed task card given to participants
  • 9.
    11/29/12 POST ‑ task 1 Post Task 1 questions POST ­ task 1 After the task users will be asked how * Required well the interface lets Participant number: * them record their to be answered by the conductor personal info and how satisfying it was. Overall how easy was this task? * create a profile and add bio info 1 2 3 4 5 6 7 Easy Difficult What do you make of the appearance of the site? Does it appear how you expected? How satisfied where you with the completion of this task? * 1 2 3 4 5 6 7 completely unsatisfied completely satisfied Submit Powered by Google Docs Report Abuse ­ Terms of Service ­ Additional Terms
  • 10.
    Task 2 Find aplaylist to exercise to Users will be given a scenario where they The reason for wanting a 20 min long playlist have just decided upon a new exercise is that by default only the first 3 tracks Critical path regime and heard that the right music can appear in the lists and you have to click make all the difference. They now wish to “expand” so 3 songs generally wont be 20 soundtracks find the right music for them to listen to mins in total length so this forces the users whilst doing cardio vascular exercise for 20 to seek out longer playlists. min and have turned to STTY to find music and then buy it from iTunes. a workout category The function of this task is to test how easy it is to buy music from the site as the type preview tack of music required is fairly well defined. i.e. music to exercise to is nearly always uplifting and faster paced so should downplay the subjective decision of picking music and Task 2 buy playlist focus on the purchasing. Find and buy a 20 minutes playlist You will indicate This task will have a limit of 5 mins and task to exercise to as you are just you have finished this task when you completion will be recorded when they click about to start a new exercise are redirected to the correct buy button and are redirected regime. the iTune store. to iTunes or the dialogue box warning of another application opening appears. You want to buy at least 20 Don’t worry you minutes worth of appropriate wont buy anything music to get your heart pumping by accident. whilst you do cardio vascular exercise. Printed task card given to participants
  • 11.
    11/29/12 POST ‑ Task 2 Post Task 2 questions POST ­ Task 2 After the task users will be asked how * Required satisfied they where Participant number: * with the ease of to be answered by the conductor completing the task and the music they found. Overall how satisfied are you with the ease of completion of the task? * 1 2 3 4 5 6 7 completly unsatisfied completely satisfied How satisfied are you with the music you selected for this task? * 1 2 3 4 5 completely unsatisfied completely satisfied Submit Powered by Google Docs Report Abuse ­ Terms of Service ­ Additional Terms
  • 12.
    Critical path my soundtracks Task 3 create Make a playlist that reminds soundtrack you of being 19 and share it with a friend to congratulate them on their own 19th birthday. use search function This is a fairly straight forward test of what the site is centered around, creating meaningful playlists and sharing. The twist is the sharing part, how the users interpret the Task 3 add track second part of this task will show weather the “STY4U” (musical e-card) function is Make a playlist that reminds You will indicate you of being 19 and send it to you have finished recognized and used in. when the email is edit details a friend with a message that sent. This task will have a limit of 3 songs in the congratulates them on their playlist to save time and avoid salience. The 19th birthday. This is my email person will be imaginary and they will be address. enter name given my email address to send the result to. your friends email address is: Time on task will end when the email is sent. “james.maclean@jqim.co.uk” send a STY4U enter email Printed task card given to participants enter a greeting send
  • 13.
    11/29/12 POST ‑ Task 3 Post Task 3 questions POST ­ Task 3 After the task users will be asked how * Required satisfied they where Participant number: * with the ease of to be answered by the conductor completing the task. Overall how satisfied are you with the ease of completion of the task? * 1 2 3 4 5 6 7 completly unsatisfied completely satisfied Submit Powered by Google Docs Report Abuse ­ Terms of Service ­ Additional Terms
  • 14.
    Task 4 Find outwhat music IT professionals listen to This task was originally meant to test one of The task will have a time limit of 3 mins as the promises made in the promotional video. I know the answer will be ambiguous and I “Find out what undertakers play at funerals” don’t want the participants to spend to long Until I realised this task was impossible to looking for information that is not there. Critical path complete not only because of the lack of current users to populate the database, but also as the only way to select an occupation users > all is to select it from a rather short list of ambiguous professions. I had to settle on one of the few categories that has more than one user “technology” and picked a Task 4 occupation > technology common job title that could be categorised under it. Find out what sort of music IT You will indicate you professionals listen to. have competed this a profile task when you tell the This task is designed to find out how conductor what sort people go about using the site to find A curious friend has recently of music you think IT detailed information. It is also to find out asked you a burning question, professionals listen to. view how satisfied people are with the sites what sort of music does the IT soundtracks ability to help then find interesting musical department listen to? information. I have picked a profession that comes under “technology” In the task The conductor will play the part of scenario the participants would have been your curious friend. asked to tell a curious friend the answer to the question. I will ask users to tell me an answer and use that as an indicator of task Printed task card given to participants completion.
  • 15.
    11/29/12 POST ‑ Task 4 Post Task 4 questions POST ­ Task 4 * Required After the task they will be asked Participant number: * to be answered by the conductor how credible they considered and satisfying the information was and Overall how satisfied are you with the ease of completion of the task? * how satisfied they 1 2 3 4 5 6 7 where with ease of completion of the completly unsatisfied completely satisfied task. How credible do you feel the the site is for the information you have found? * 1 2 3 4 5 6 7 no credibility complete credibility Submit Powered by Google Docs Report Abuse ­ Terms of Service ­ Additional Terms
  • 16.
    11/29/12 Post study questions Post task questions Post study questions * Required After the 4 tasks are complete Participant number: * to be answered by the conductor participants will then be asked to rate the site overall. Over all how satisfied where you with the ease of using the site? * 1 2 3 4 5 6 7 completely unsatisfied completely satisfied Any other comments on the site in general? Please indicate your level of agreement with this statement: * "This site allow users to create meaning full playlists associated with memories past, present and future." 1 2 3 4 5 6 7 strongly dissagree strongly agree Submit Powered by Google Docs Report Abuse ­ Terms of Service ­ Additional Terms
  • 17.
    Some of thedata I collected has was not These questions where to open ended and Findings relevant to the study so has not been shown after conducting the study I shifted the focus here. The missing data is from the following of the study which rendered the answers to questions: these questions irrelevant. • What is your gender? The answers where somewhat tainted by • What is your age? my own poor conduct. The biggest mistake I made was not stressing the goals of the • How do you generally buy music study which left some users feeling like they • How often do you seek out music you would hurt my feelings if they answered Summary have not heard before? honestly. The site has promise but is no where near • What do you make of the appearance usable. of the site? Does it appear how you Initial I did not expect that task 1 would yield expected? meaningful results but it was an are where • How satisfied are you with the music you all users struggled with. selected for this task? • How credible do you feel the the site is The redesigns later in this document focus for the information you have found? on the most common issues first. • Any other comments on the site in general? The issues I have addressed are superficial ones and I believe the site needs a more • Over all how satisfied where you with the defined direction in general and to re-asses ease of using the site? its core functions and goals. • Please indicate your level of agreement with this statement: “This site allow One user refused to carry on with the tasks users to create meaning full playlists after getting very frustrated with the site, associated with memories past, present he put is user name and password in a and future.” total of 4 times and I would not say he was being foolish at all. In fact he was a music enthusiast, exactly the sort of person the site should attract.
  • 18.
    Task success data Task success 0=fail 1=partial 2=success 2 2 2 2 2 2 2 2 2 2 2 2 2 Task 1 1 1 1 1 1 1 1 1 Task 2 Task 3 0 0 0 0 0 0 0 0 0 0 0 Task 4 Participant 1 Participant 2 Participant 3 Participant 4 Participant 5 Participant 6 Participant 7 Participant 8 Task success was recorded slightly Task 3 Participant 2 failed all the tasks due mostly differently for each task but any task where A partial success on task 3 was recorded because of needing major assists. users required a major assist (help desk role many times where users sent the email but play) was marked as a fail. not using the “STY4U” (musical e-card) also Participant 4 failed the first task after needing in one case the user sent the message to a major assist to find the area to edit the Task 1 the wrong person. profile. The rest of the tasks failed because The users that got a partial success where he was so frustrated by the site he refused to do all the tasks. ones who entered their date of birth wrong. Task 4 It was not really possible to get a partial Task 2 success on task 4 as the answer was A partial success on task 2 was recorded subjective. when one user through they had bought and album but actual purchased a single track.
  • 19.
    Assistance data Only one user managed to Minor Assists resist looking at the help area reference to help page to help them complete a task. Nearly everyone needed to 2 look at the help to find out where the profile area even Task 1 was let alone how to edit it. Task 2 1 1 1 1 1 1 1 1 1 1 1 1 With regards to task 1 most Task 3 of the minor assists where a Task 4 result of first the site crashing 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 upon trying to edit the profile Participant 1 Participant 2 Participant 3 Participant 4 Participant 5 Participant 6 Participant 7 Participant 8 and then being unable to navigate back to the profile area form the home page . Major Assists A couple of people needed help desk role play major assists, I had to step in with participant 7 on the first 2 task as they started to get quite upset. Task 1 Task 2 Participant 2 needed a lot of 1 1 1 1 1 Task 3 help on all the tasks and on Task 4 one task needed to ask me for 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 0 help twice on task 2. Participant 1 Participant 2 Participant 3 Participant 4 Participant 5 Participant 6 Participant 7 Participant 8
  • 20.
    Error data Everyone encountered errors Errors on the first task, when i set deviation from critical path out the study I did not expect to find much out on this task 16   but after seeing the results 14   there are clearly major issues with the users initial stages 12   with the site. 10   Task  1   The repeated errors on task 1 Task  2   8   are the result of users going Task  3   in circles again and again 6   Task  4   unable to find the profile area 4   even after consulting the help. 2   Only one user managed to 0   notice the sign-up button Participant 1 Participant 2 Participant 3 Participant 4 Participant 5 Participant 6 Participant 7 Participant 8 hidden at the bottom of the login screen. Total errors per task The next source of repeated 56 errors was task 3. The reason 60 for these errors was the 50 dragging function, that only 40 1 participant managed to successfully figure out after 30 26 getting very angry. Total errors per task 20 20 11 10 0 Task 1 Task 2 Task 3 Task 4
  • 21.
    Time on taskdata The fasted time for task 1 was 4min 58sec. Average Time on task To take this long to figure out how to get (error bars represent 90% confidence interval) started with the site is a big ask and would 0:00   0:01   0:02   0:04   0:05   0:07   0:08   0:10   0:11   mean alot of users will be put off at a crucial stage. Task 1 00:09:44 Task 2 00:05:46 Task 3 00:07:25 Task 4 00:04:17
  • 22.
    Satisfaction data Satisfaction 7   Completly satisfied 6   Participant 1 5   Participant 2 Participant 3 4   Participant 5 3   Participant 6 Participant 7 2   Participant 8 1   Completly unsatisfied 0   0   1   2   3   4   Unfortunately this data is not much use as This is likely the result of the participants One thing to note was I noticed this the graph shows no correlation whatsoever. having to give feedback whilst being during the study and made these points to recorded and also because I did not stress participants 7 and 8 who’s metrics are lower enough the aims of the study. than most.
  • 23.
    Table of issues Whenanalysing the recorded footage of the sessions I found 40 unique usability issues. I also noted which percipients experienced the same issue and if issues where experienced on different tasks. I have given a cause and also a solution for each issue. I also recorded technical issues but did not attempt to find solutions for them, except on one case I made a suggestion. The full table of issues can be read in the appendices. We will now take a look at the issues found in different areas of the site.
  • 24.
    Issues found by8 participants on www.soundtracktoyour.com Issues on the Home page and genral site wide issues The biggest problem was not being Although most people learned to live with it, not Participants Tasks Record Issues found by 88Cause Issues found by area. able to navigate to the order Location participants on www.soundtracktoyour.comis problem. Description profile participants on being able to use the back button(redesign recommendation) www.soundtracktoyour.com Solution 1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 4 Global frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurpose of home page(see details and illustrations in 18 Global Difficulty navigating to STY4U 1 1 1 not get to main document) Participants Tasks Participants Tasks Remove the My Soundtracks pop out or have it only show the created soundtracks or "no Record Record Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so 19 order Location Location Global Description Description Cause Cause Solution (redesign recommendation) Solution (redesign created" when empty, once the user has more than a few then introduce the 4 5 1 2 3 ∑ t1 t2 t3 t4 soundtracks recommendation) 1 2 3 6 1 8 4 5 6 7 8 7 1 1 ∑ t1 t2 t3 t4 3 1 1 order soundtracks will not seem relevant also the profile area is difficult to find sorting categories and only ones that are populated with created soundtracks, Also 1 4 Home Global unsure if logged in frustration with help balloons No direct balloons obscure status disappear before being read Help indication of login site and have usernameto remove and tick to not page again click displaythe search function to be redesigned to and turned into a more complicated 1 top right on every show 1 1 1 1 1 4 1 1 1 1 1 5 1 1 Would need 30 Global Can't search for years No support for searching via time 1 1 2 1 function in itself. 2 18 Home Global difficulty navigating to profile Difficulty navigating to STY4U Confusing terminology " users to start the STY4U process at the home page which one user Click username to enter profile (see 1) and repurpose of home page(see details and illustrations in 1 1 1 1 5 1 Help area instructs my soundtracks" could Restructure of site navigation 1 1 1 1 My Soundtracks drawer largely Theget to not displayed categories are to broad to have relevance to every task but this area is always main document)Soundtracks pop out then introduce the sorting categories and only ones Remove the My 32 Global 1 1 2 1 useless around but serves no use as the drag function is unusable. Removepopulated with created soundtracks, Also show the created soundtracks or "no that are the My Soundtracks pop out or have it only 3 Difficulty finding created Login / Signup Difficulty on Sign up The text Soundtracks pop out tab is not clear and shows categories that have no playlists so separate button for signup Sign up My too small clear 1 1 1 1 1 1 1 7 1 19 Global soundtracks created" when empty, once the user has more than a not parts introduce the(see menu rollovers should be only links to pages or specific functions few then of a function 1 1 1 3 1 1 36 Global soundtracks Rollover is annoying Thenot seem relevant alsoand contains to much and to difficult to make it disappear will rollover is far to large the profile area is difficult is find 1 1 2 1 1 navigation redesign) only ones that are populated with created soundtracks, Also sorting categories and 4 Global frustration with help balloons 30 Global Settings dropdown wont go Help balloons obscure site andvia time before being read Can't search for years disappear click to remove and tick to not show again to be redesigned to and turned into a more complicated Would need the search function 1 1 1 1 1 5 1 1 39 Global User are notfor searching to a toggle on and off action No support expecting this make this a rollover or have it disappear after a second or 2 function in itself. 1 1 1 1 1 2 1 away 5 Profile can't find edit profiledrawer largely The displayed categories are to broad to have relevance to every task but this area is always"settings" and "edit profile" next to usernamethen introduce the sorting categories and only ones 1 1 My Soundtracks Edit profile is expected to be at top right with username show Remove the My Soundtracks pop out (see 1) 1 1 1 5 1 32 Global Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 TECH useless around but serves no use as the drag functionnotunusable. The regular back button on the browser does is work that are populated with created soundtracks, Also 1 1 1 1 1 1 5 1 1 1 1 2 still-work-ajax-page-loads 6 Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 menu rollovers should be only links to pages or specific functions not parts of a function (see 36 Global difficulty is annoying on how to The rollover is far to large and contains to much and is difficult to make it disappear Rollover finding help 1 1 2 1 1 15 Help confusing terminology "Your VOICE" navigation redesign) rename You VOICE with your profile at least in the help area 1 1 2 1 7 Profile CRASH edit profile Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 Settings dropdown wont go 39 Global User are not expecting this to a toggle on and off action make this a rollover or have it disappear after a second or 2 1 1 1 away unexpected result from clicking 8 Soundtracks rank button has a magnifying glass change to button showing 2 triangles up and down 1 1 1 31 Help rank Spelling Draw should be "drawer" in this context drawer not draw http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- Possible solution: 1 1 1 11 Global TECH The regular back button on the browser does not work 1 1 1 1 1 5 1 1 1 1 still-work-ajax-page-loads Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are difficulty finding help on how to 15 1 Help Home unsure if logged in confusing terminology "Your VOICE" No direct indication of login status have username display top right on every page help area rename You VOICE with your profile at least in the 1 1 1 1 2 4 1 1 edit profile highlight search result after following link or have the search page give results in stacks titled Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 search result link search 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" results and optional filter orto enter profile (see 1) "tracks" Click username pick from a category e.g. 1 1 1 1 1 5 1 31 Help Spelling Draw should be "drawer" in this context drawer not draw 1 1 1 Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 Global TECH The regular back button on the browser does not work If this is to be on the home page it should be smaller, and have a more subtle animation, 1 1 1 1 1 5 1 1 1 1 Frustration with the movement The movement on the homepage moves to frequently and cannon be stopped to read.still-work-ajax-page-loads One 28 Home should change less frequently and be able to be frozen so the user can read or keep what is 1 1 2 1 1 Home unsurehome page on the if logged in No direct indication ofthem of adverts and would have immediately left the site. user said it reminded login status have username display top right on every page 1 1 1 1 4 1 1 SoundTrack should bethere. under "share" as extra option when selecting "by email" and less confusing listed 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation "philum" not recognized as a terminology 35 Home The reasoning behind this naming is not explained Change link title to be more descriptive 1 1 2 Home link to the video difficulty navigating to profile Confusing terminology " my soundtracks" Click username to enter profile (see 1) 1 1 1 1 1 5 1 User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 3 Login / Signupoccupation on Sign up Occupation Difficulty Sign up text too small clear separate button for signup 1 1 1 1 1 1 1 7 1 would be If this is to be on the home page it should be smaller, and have a more subtle animation, to long Frustration with the movement The movement on the homepage moves to frequently and cannon be stopped to read. One 28 Home should change less frequently and be able to be frozen so the user can read or keep what is 1 1 2 1 14 Profile CRASH home page on the "error: [object it reminded them of adverts and wouldprofile immediately left the site. user said Object]" upon clicking "edit profile" from have page ? there. 1 1 1 3 1 Didn’t notice that had not 38 Login / Signupdifficulty findingrecognized as a "philum" not help on how to no error feedback on terms and conditions tick box, also the tick box it quite small make the checkbox larger and add red feedback text 1 1 1 15 35 Help Home ticked terms and conditions confusing terminology "Yourthis naming is not explained The reasoning behind VOICE" rename You VOICE with your profile at least in the help area Change link title to be more descriptive 1 1 2 1 1 1 edit profile video link to the 3 Login / Signup Difficulty on Sign up Sign up text too small remove dragging feature from site as it is difficult to use on many platforms and prone to clear separate button for signup 1 1 1 1 1 1 1 7 1 Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 16 5 Soundtracks Profile 1 1 1 1 1 1 6 1 1 1 1 1 1 dragging edit profile can't find soundtrack available to land to be at top right with usernamenot specific enough Edit profile is expected on, help balloon and tool top text show "settings" and "edit profile" next to username (see 1) Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks 1 5 1 tab opens Didn’t notice that had not 38 Login / Signup no error feedback on terms and conditions tick box, also the tick box it quite small make the checkbox larger and add red feedback text 1 1 1 ticked terms and conditions Described by quote: "A calendar is for planning and you don’t have to plan your own date of 6 Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" 5 Profile can't find edit profile Edit profile is expected to be at top right with username Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurposenext to username (see 1) and illustrations in show "settings" and "edit profile" of home page(see details 1 1 1 1 1 5 1 18 7 Global Profile Difficulty navigating to STY4U CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 1 1 1 not get to main document) Remove the My Soundtracks pop out or have it only show the created soundtracks or "no 6 Profile CRASH Difficulty finding created The“Begin creating your out tab is not clear and shows categories that have no playlists so My Soundtracks pop profile by clicking here.” link broken on profile page ? soundtracks created" when empty, once the user has more than a few then introduce the 1 1 1 1 4 1 19 Global 1 1 1 3 1 1 14 Profile soundtracks CRASH will not seem relevant also the profile area is difficult to find profile page "error: [object Object]" upon clicking "edit profile" from sorting categories and only ones that are populated with created soundtracks, Also ? 1 1 1 3 1 Restructure of site navigation (see details and illustrations in main document) Described by quote: "A calendar is for planning and you don’t have to plan your own date of 7 17 Profile Profile CRASH Disorientationwith DOB input Frustration when creating birth" The calendar stuck upontodays date, Also the incorrect from profile page Loading animation starts with entering help area via top link input dialogue defines a different should have another stage after selecting birthday asking weather users wish to This task ? Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 1 1 1 1 6 1 20 STY4U clicking image of birthday instead of "create" button takes users to "tracks>party>birthday" 1 1 STY4U format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" create on or see what other users have chosen first Users Confusion with results or 21 23 Profile No indication on how or if how the results are filtered A visually Darker coloured text to replace light yellow, or outline, and possible separate filtration area that shows which filters are active or darker background 1 1 1 2 1 14 Occupation Profile filteringyellow text hard to read Pale by occupation CRASH Not enough contrast between yellow and background "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 1 1 3 1
  • 25.
    Soundtrack My Soundtracks drawer largely The displayeda perhaps lesser known song:"error: [object: every task but this area is always When adding categories are to broad to have relevance to Remove the My Soundtracks pop out then introduce the sorting categories and only ones 32 30 Global CRASH ? 1 1 1 2 1 1 creation useless around but serves no use as the drag function is unusable. Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta > that are populated with created soundtracks, Also menu rollovers should be only links to pages or specific functions not parts of a function (see 36 Global Rollover is annoying The rollover is far to large and contains to much and is difficult to make it disappear 1 1 2 1 1 Soundtrack cannot add song once search If you click play from the search dropdown you are given a 30 second preview and by the time navigation redesign) 33 Settings dropdown wont go put an add track to playlist button onto the preview area 1 1 1 39 creation Global dropdown disappears this has finished the add button toggle on and off action User are not expecting this to a has gone make this a rollover or have it disappear after a second or 2 1 1 1 away Soundtrack Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 34 11 Global CRASH TECH The regular back button on the player has a broken link The buy button on the preview browser does not work ? 1 1 1 1 1 1 1 1 1 1 1 5 1 creation still-work-ajax-page-loads unexpected result from clicking 8 Soundtracks difficulty finding help on how to rank button has a magnifying glass change to button showing 2 triangles up and down 1 1 1 15 Help rank confusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 edit profile Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 31 Help Spelling Draw should be "drawer" in this context drawer not draw 1 1 1 Issues on the Login / signup screen are remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no 16 Soundtracks errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 1 1 1 1 1 1 1 1 4 1 1 1 1 1 6 1 Nearly everyone entered a username and password and clicked 1 Home dragging logged in unsure if soundtrack available to landstatus No direct indication of login on, help balloon and tool top text not specific enough have username display top right on every page Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks login befor being told appropriatehadConfusing terminology " my on www.soundtracktoyour.com username to enter profile (see 1) Issues found tonot 8 participants soundtracks" site and then by No info on BPM wrong by the Disappointment with 26 2 Soundtracks Home difficulty how they knowing navigating profile done it Click BPM information Adding 1 1 1 1 1 1 5 1 1 1 songs are for exercise clikcingSoundtracks TECH button. 27 the sign up When playing a soundtrack, after the first 30 second preview is over the second song begins ? If this is to be on the home page it should be smaller, and have a more subtle animation, 1 1 1 Frustration with the movement The the artwork,on the and artists from the first song persistcannon be stopped to read. One but movement name homepage moves to frequently and 28 Home should change less frequently and be able to be frozen so the user can read or keep what is 1 1 2 1 on the home page user said it reminded them of adverts and would have immediately left the site. there. Participants Tasks 28 Soundtracks CRASH When clicking "tracks>9 to 5" dialogue box :"error: [object Object]" ? 1 1 1 3 1 Record 35 Location Home Description recognized as a Cause reasoning behind this naming is not explained "philum" not The Solution (redesign title to be more descriptive Change link recommendation) 1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 1 1 order link to the video 1 Home Disorientation when creating No direct indication of login status have username display top haveon every page after selecting birthday asking weather users wish to1 This task should right another stage 20 3 STY4U Signupunsure if logged in up Login / Difficulty on Sign Sign up image of birthday instead of "create" button takes users to "tracks>party>birthday" clicking text too small 1 1 1 1 4 1 1 1 1 STY4U create on or see what for signup have chosen first clear separate button other users 1 1 1 1 1 1 1 7 1 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" Click username to enter profile (see 1) 1 1 1 1 1 5 1 people seem to expect it to be at the bottom, but I think that the positioning and style gives 29 STY4U sent button a little hard to find move the send button to be aligned with the creation box 1 1 2 1 users banner blindness to that area Didn’t notice that had not 38 3 Login / / SignupDifficulty on Sign up Login Signup Sign up text too small on terms and conditions tick box, also the tick box it quite small no error feedback make the checkbox larger and add red feedback text clear separate button for signup 1 1 1 1 1 1 1 7 1 1 1 1 Confusion over if conditions ticked terms and the recipient 37 STY4U once the email is entered on the STY4U screen the email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users 1 1 1 is correct 4 Global frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 has to retype details again after Terms and terms should be either a separate window (with a print button perhaps?) or have an accept 5 29 Profile can't find edit profile and going back from terms Edit profilebutton on terms and conditions username no accept is expected to be at top right with show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 1 5 Conditions Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and the bottom or beto username (seescroll box button at "edit profile" next a collapsible or 1) 1 1 1 1 1 5 1 conditions page 6 Profile frustration with not being able CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 the "# soundtracks" on the tracks page that indicates how many soundtracks the track features 6 22 Profile Tracks CRASH from "tracks" over to “Begin creating your profile by clicking here.” link broken on profile page to explore ? Make "# soundtracks" a link to the soundtracks that the track is in 1 1 1 1 1 1 4 1 1 3 in is expected to be a link to those soundtracks 7 Profile the "soundtracks" it features in CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual unexpected result from clicking 13 8 Soundtracks rank button has for occupation asked for at signup are to vague Categories a magnifying glass change toof professional areas but to selectdown button showing 2 triangles up and this from a dropdown would not be usable as 1 list the 1 1 1 1 1 3 1 7 Occupation Profile occupation rank CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 would be to long Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? highlight search result after following link or have the search page give results in stacks titled 1 1 1 3 1 Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 search result link search Described by quote: "A calendar is for planning and you don’t have to plan your own date of and optional filter or pick from a category e.g. "tracks" results 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 Global TECH The regular back button on the browser does not work 1 1 1 1 1 5 1 1 1 1 still-work-ajax-page-loads 23 Profile Pale yellow text hard to read Not enough contrast between yellow and background Darker coloured text to replace light yellow, or outline, or darker background 1 1 1 SoundTrack should be listed under "share" as extra option when selecting "by email" and less confusing 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology Confusion about what the the layout does not indicate that the functions on the profile page are only applicable to the If the main site navigation is restructured and the profile area functions placed under the 24 Profile User entered Occupations then support for be enough distinction between areas. When list 1 1 1 Users buttons on the profile page do logged in user Hard to find peoples actual username at top right there will searching them alternatively a comprehensive viewing other 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation would be highlight search result after following link or have the search page give results in stacks titled to long Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 14 Profile CRASH result link search search "error: [object Object]" upon clicking "edit profile" from profile page ? results and optional filter or pick from a category e.g. "tracks" 1 1 1 3 1 difficulty finding help on how to 15 Help Search appears broken whenconfusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 25 Search results edit profile there is no feedback on search results profile a "nothing found when you searched for <users search>" type of message 1 1 2 1 1 no results are fund remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 16 SoundTrack Soundtracks should be listed under "share" as extra option when selecting "by email" and less confusing 1 1 1 1 6 1 1 1 1 12 Not noticed STY4U dragging Confusing name "STY4U" and share function has email option soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks 1 1 1 1 1 5 1 creation terminology tab opens Soundtrack Described adding a perhaps lesser known song:"error: [object: to plan your own date of When by quote: "A calendar is for planning and you don’t have 30 17 Profile CRASH Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect <track meta > ? 1 1 2 1 1 creation Object]url:/SoundTrack/<user>/AddTrack? Trackid= input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" Soundtrack cannot add song once search If area instructs users to start the STY4U process atare given a 30 secondone user could the time Help you click play from the search dropdown you the home page which preview and by Restructure ofan add track toand repurpose of home page(see details and illustrations in 33 18 Global Difficulty navigating to STY4U put site navigation playlist button onto the preview area 1 1 1 1 1 1 creation dropdown disappears not this to finished the add button has gone get has main document) Soundtrack Remove the My Soundtracks pop out or have it only show the created soundtracks or "no 34 CRASH The buy button on the preview player has a broken link ? 1 1 1 creation Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so soundtracks created" when empty, once the user has more than a few then introduce the 19 Global 1 1 1 3 1 1 soundtracks will not seem relevant also the profile area is difficult to find sorting categories and only ones that are populated with created soundtracks, Also unexpected result from clicking Restructure of site to button showing 2 triangles up and down document) 8 Soundtracks rank button has a magnifying glass change navigation (see details and illustrations in main 1 1 1 rank Disorientation when creating This task should have another stage after selecting birthday asking weather users wish to 20 STY4U clicking image of birthday instead of "create" button takes users to "tracks>party>birthday" 1 1 1 STY4U create on or see what other users have chosen first Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are Users Confusion with results or 21 No indication on how or if how the results are filtered A visually separate filtration area that shows which filters are active and possible 1 1 2 1 Occupation filtering by occupation remove dragging feature from site as it is difficult to use on many platforms and prone to
  • 26.
    My Soundtracks drawerlargely The displayed categories are to broad to have relevance to every task but this area is always Remove the My Soundtracks pop out then introduce the sorting categories and only ones 32 Global 1 1 2 1 useless around but serves no use as the drag function is unusable. that are populated with created soundtracks, Also menu rollovers should be only links to pages or specific functions not parts of a function (see 36 Global Rollover is annoying The rollover is far to large and contains to much and is difficult to make it disappear 1 1 2 1 1 navigation redesign) Settings dropdown wont go 39 Global User are not expecting this to a toggle on and off action make this a rollover or have it disappear after a second or 2 1 1 1 away Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 Global TECH The regular back button on the browser does not work 1 1 1 1 1 5 1 1 1 1 still-work-ajax-page-loads difficulty finding help on how to 15 Help confusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 edit profile 31 Help Spelling Draw should be "drawer" in this context drawer not draw 1 1 1 Issues on profile screen 1 Home unsure if logged in No direct indication of login status have username display top right on every page 1 1 1 1 4 1 1 Alot of people where fustrated by the date The task was made alot more dofficult by of birth input starting with todays date. 2 Home difficulty navigating to profile the crashes mentioned below, fixingtothese (see 1) Confusing terminology " my soundtracks" Click username enter profile 1 1 1 1 1 5 1 Frustration with the movement The movement on the homepage moves to frequently and cannon be should be a high priority as technical errors stopped to read. One If this is to be on the home page it should be smaller, and have a more subtle animation, 28 Home should change less frequently and be able to be frozen so the user can read or keep what is 1 1 2 1 Most people could not find how to edit the on the home page it put most users in a situation where they user said it reminded them of adverts and would have immediately left the site. there. profile easily. link tofound by a participantsnaming iswww.soundtracktoyour.com link title to be more descriptive 35 Home "philum" not recognized as Issues the video 8 The reasoning behind this on would have given up on the Change not explained task. 1 1 3 Login / Signup Difficulty on Sign up Sign up text too small clear separate button for signup 1 1 1 1 1 1 1 7 1 Didn’t notice that had not Participants Tasks 38 Login / Signup no error feedback on terms and conditions tick box, also the tick box it quite small make the checkbox larger and add red feedback text 1 1 1 Record ticked terms and conditions Location Description Cause Solution (redesign recommendation) 1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 order 1 Home unsure if logged in No direct indication of login status have username display top right on every page 1 1 1 1 4 1 1 5 Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" Click username to enter profile (see 1) 1 1 1 1 1 5 1 3 6 Login / Signup Difficulty on Sign up Profile CRASH Sign up textcreating your profile by clicking here.” link broken on profile page “Begin too small clear separate button for signup ? 1 1 1 1 1 1 1 7 1 1 1 1 1 4 1 4 Global frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 7 Profile CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 5 Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 6 Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 3 1 7 Profile CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 Described by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile unexpected result from clicking Frustration with DOB input rank button has a magnifying glass todays date, Also the incorrect input dialogue defines a different toReplace date of 2 triangles up and dropdowns for day month and year 8 Soundtracks birth" The calendar starts with change button showing birth input with 3 down 1 1 1 1 1 1 1 1 6 1 1 rank format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 23 Profile Pale yellow text hard to read are Not enough contrast between yellow and background Darker coloured text to replace light yellow, or outline, or darker background 1 1 1 highlight search result after following link or have the search page give results in stacks titled Disorientationabout following Confusion from what the Results layout showsnot indicate that the functions on the profile page are only applicable to the the pages does links that take you to a list of soundtracks, does not appear relevant to 10 24 Search results Profile by resultsIf the main site the site and is restructured and the profilegive a functions of location within navigation have the title the only link also area summary placed under the 1 1 1 1 1 4 1 1 1 1 1 search result link profile page do logged in user buttons on the search results and optional filter or right from a will be enough distinction between areas. When viewing other username at top pick there category e.g. "tracks" highlight search result after following link or have the search page give results in stacks titled Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- Possible 11 10 Global results TECH Search The regular back button on the browser does not work by results location within the site and have the title the only link also give a summary of 1 1 1 1 1 1 1 5 1 1 1 1 1 1 4 1 1 1 search result link search still-work-ajax-page-loads results and optional filter or pick from a category e.g. "tracks" SoundTrack should be listed under "share" as extra option when selecting "by email" and less confusing 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 25 creation results Search appears broken when there is no feedback on search results Search terminology profile a "nothing found when you searched for <users search>" type of message 1 1 2 1 1 no results are fund User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation SoundTrack occupation 12 Not noticed STY4U Confusing name "STY4U" and share function has email option would be should be listed under "share" as extra option when selecting "by email" and less confusing to long 1 1 1 1 1 5 1 creation terminology 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 3 1 Soundtrack difficulty finding help on how to When adding a perhaps lesser known song:"error: [object: 30 15 Help CRASH confusing terminology "Your VOICE" ? rename You VOICE with your profile at least in the help area 1 1 1 2 1 1 2 1 1 creation edit profile Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta > remove dragging feature from site as it is difficult to use on many platforms and prone to Soundtrack cannot add song once search If youitem jumps from the search dropdown you are given allows drag when no and by the time Difficulty and frustration with Dragged click play to right upon drag, target area to small, still a 30 second preview errors even whenadd track to playlist button onto the preview area 33 16 Soundtracks put an executed well, replace with: "add > soundtrack > soundtrack cat > 1 1 1 1 1 1 1 6 1 1 1 1 creation dropdown disappears dragging this has finished the add button has gone soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks tab opens Soundtrack 34 CRASH The buy button on the preview player has a broken link ? 1 1 1 creation Described by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 unexpected result from clicking format to button has a magnifying glass 8 Soundtracks rank the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" change to button showing 2 triangles up and down 1 1 1 rank Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurpose of home page(see details and illustrations in 18 Global Difficulty navigating to STY4U 1 1 1 not get to main document) Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are Remove the My Soundtracks pop out or have it only show the created soundtracks or "no Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so soundtracks created" when empty, once the user has more than a few then introduce the 19 Global 1 remove dragging feature from site as it is difficult to use on many platforms and prone to 1 1 3 1 1 Difficulty and frustration with will not seem relevant alsoto right upon drag, targetto findto small, still allows drag when no sorting categories and only ones that are populated with created soundtracks, Also soundtracks Dragged item jumps the profile area is difficult area
  • 27.
    7 Profile CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 Confusion about what the the layout does not indicate that the functions on the profile page are only applicable to the If the main site navigation is restructured and the profile area functions placed under the 24 Profile 1 1 1 buttons on the profile page do logged in user username at top right there will be enough distinction between areas. When viewing other highlight search result after following link or have the search page give results in stacks titled Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 14 Search results CRASH Profile "error: [object Object]" upon clicking "edit profile" from profile page by results location within the site and have the title the only link also give a summary of ? 1 1 1 1 1 1 3 1 1 1 1 4 search result link search results and optional filter or pick from a category e.g. "tracks" Described by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile Frustration with DOB input Search appears broken when birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 25 Search results there is no feedback on search results profile a "nothing found when you searched for <users search>" type of message 1 1 2 1 1 no results are fund format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" 23 Profile SoundTrack Pale yellow text hard to read Not enough contrast between yellow and background Darker coloured under "share" as extra option when selecting "by email" and less confusing should be listed text to replace light yellow, or outline, or darker background 1 1 1 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology Confusion about what the the layout does not indicate that the functions on the profile page are only applicable to theIf the main site navigation is restructured and the profile area functions placed under the 24 Profile 1 1 1 Soundtrack buttons on the profile page do logged in user When adding a perhaps lesser known song:"error: [object: username at top right there will be enough distinction between areas. When viewing other Issues on the soundtracks and tracks screens 30 10 creation Search results CRASH Disorientation from following Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta > Results pages shows links that take you to a list of soundtracks, does not appear relevant to ? highlight search result after following link or have the search page give results in stacks titled by results location within the site and have the title the only link also give a summary of 1 1 1 1 1 1 2 1 1 4 1 1 1 search result link search If you click play from the search dropdown you are given a 30 second preview and by the time results and optional filter or pick from a category e.g. "tracks" The dragging of songs into a soundtrack 33 Soundtrack creation cannot add song once search dropdown disappears Users where not sure how long the this has finished the add button has gone put an add track to playlist button onto the preview area 1 1 1 Search appears broken when is a major issue as only 1 person of the 8 25 Search results Soundtrack no results are fund soundtracks where and many asumed all you searched for <users search>" type of message there is no feedback on search results profile a "nothing found when 1 1 2 1 1 34 CRASH The buy button on the preview player has a broken link ? 1 1 1 managed to successfully use it and only creation SoundTrack the soundtracks where only should be listed under "share" as extra option when selecting "by email" and less confusing 3 songs long. unexpected STY4U Not noticed result from clicking Confusing namea"STY4U" andglass function has email option after several failed attempts. 12 8 Soundtracks creation rank rank button has magnifying share change to button showing 2 triangles up and down terminology 1 1 1 1 1 1 1 5 1 1 30 Issues found by 8 participants on Not Trackid= <track metaeventualy found number of songs in playlist to truncated view and make this the button to expand Soundtrack Unsure CRASH how long soundtracks www.soundtracktoyour.com the button to everyone When adding a perhaps lesser known song:"error: [object: ? 1 1 2 1 1 9 Soundtracks creation are no info on length in truncated view expand the soundtrack to itsadd length. Object]url:/SoundTrack/<user>/AddTrack? > full 1 1 1 1 4 1 Soundtrack cannot add song once search If you click play from the search dropdown you are given a 30 second preview and by the time remove dragging feature from site as it is difficult to use on many platforms and prone to 33 Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no put an add track to playlist button onto the preview area 1 1 1 16 creation Soundtracks dropdown disappears this has finished the add button has gone errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Participants Tasks Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks Record Soundtrack Disappointment with not 34 Location Description CRASH Cause buy button on the preview player has a broken link Theinfo on BPM Solution (redesign recommendation) ? 1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 1 1 26 order Soundtracks creation knowing how appropriate No Adding BPM information 1 1 1 1 1 Home unsure if are for exercise songs logged in No direct indication of login status have username display top right on every page 1 1 1 1 4 1 1 unexpected result from clicking When playing a soundtrack, after the first 30 second preview is over the second song begins 8 27 Soundtracks Soundtracks TECH rank button has a magnifying glass change to button showing 2 triangles up and down ? 1 1 1 1 1 1 rank but the artwork, name and artists from the first song persist 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" Click username to enter profile (see 1) 1 1 1 1 1 5 1 28 Soundtracks CRASH Unsure how long soundtracks When clicking "tracks>9 to 5" dialogue box :"error: [object Object]" ? 1 1 1 3 1 9 3 Soundtracks Login / Signup Difficulty on Sign up Sign up texton length in truncated view no info too small clear separate number ofsignup in playlist to truncated view and make this the button to expand 1 1 add button for songs 1 1 1 1 1 7 1 1 1 1 4 1 are Disorientation when creating This task should have another stage after selecting birthday asking weather users wish to 20 4 STY4U Global frustration with help balloonsHelp balloons obscurebirthday disappear before being read clicking image of site and instead of "create" button takes users to "tracks>party>birthday" to remove and tick to not show from site as it is difficult to use on many platforms and prone 1 click remove dragging feature again 1 1 to 1 1 5 1 1 1 1 1 STY4U Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no create on or see what other users have chosen first 16 Soundtracks errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks 5 29 Profile STY4U can't find edit profile hard to find people is expected to be it to be at the bottom, but I think that the positioning and style gives "settings" and sendprofile" next to aligned with the creation box sent button a little not Edit profile seem to expect at top right with username show move the "edit button to be username (see 1) 1 1 1 1 1 5 1 1 1 2 1 Disappointment with users banner blindness to that area 26 Soundtracks knowing how appropriate No info on BPM Adding BPM information 1 1 1 6 Profile CRASH are for exercise songs “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 Confusion over if the recipient 37 STY4U once the email is entered on the STY4U screen the email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users 1 1 1 is correct When playing a soundtrack, after the first 30 second preview is over the second song begins 27 7 Soundtracks CRASH Profile TECH Loadingthe artwork, name and artists from areafirst top link from profile page ? 1 1 1 1 1 but animation stuck upon entering help the via song persist ? 1 has to retype details again after Terms and unexpected result from clicking terms should be either a separate window (with a print button perhaps?) or have an accept 29 8 Soundtracks going back from terms and rank button has a magnifying glass conditions no accept button on terms and change to?buttonat the bottom or be upcollapsible or scroll box 1 1 1 28 Soundtracks rank Conditions CRASH When clicking "tracks>9 to 5" dialogue box :"error: [object Object]" button showing 2 triangles a and down 1 1 1 1 1 1 3 1 conditions page frustration with not being able Unsure how long soundtracks 9 Soundtracks Disorientation when creating no info on length in truncated view the "# soundtracks" on the tracks page that indicates how many soundtracks the track add number oftask should have another stage after selecting birthday asking weather users wish to features This songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 20 22 STY4U Tracks are explore from "tracks" over to clicking image of birthday instead of "create" button takes users to "tracks>party>birthday" to Make "# soundtracks" a link to the soundtracks that the track is in 1 1 1 1 3 1 1 STY4U in is expected to be a link to those soundtracks create on or see what other users have chosen first the "soundtracks" it features in highlight search result after following link or have the search page give results in stacks titled 10 Search results Disorientation from following people seem to links that take at the bottom, but I think that the positioning and style by resultsUser entered Occupationshave the title the only link also give a summary ofa comprehensive list Results pages showsexpect it to be you to a list of soundtracks, does not appear relevant to gives then support for searching them alternatively 29 Users STY4U Hard to find a search result peoples actual sent buttonlinklittle hard to find search move the sendthe site and aligned with the creation box location within button to be 1 1 1 1 4 1 1 1 1 1 2 1 13 users banner blindness to asked for at signup are to vague Categories for occupation that area of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation results and optional filter or pick from a category e.g. "tracks" would be to long Confusion over if the recipient Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 37 11 STY4U Global TECH Theonce the email is entered on the STY4Unot workthe email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users regular back button on the browser does screen 1 1 1 1 1 1 5 1 1 1 1 1 1 is correct still-work-ajax-page-loads has to retype details again after SoundTrack Terms and should beterms should be eitherextra option when selecting "by email" and less confusing listed under "share" as a separate window (with a print button perhaps?) or have an accept 12 29 Not noticed STY4U terms and Confusing name "STY4U" terms andfunction has email option going back from no accept button on and share conditions 1 1 1 1 1 5 1 1 1 1 creation Conditions terminology button at the bottom or be a collapsible or scroll box conditions page User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual able frustration with not being 13 Categories soundtracks" on the trackssignup that to vague how many soundtracks the track of professional areas but to select this from a dropdown would not be usable as the list the "# for occupation asked for at page are indicates features 1 1 1 3 1 22 Occupation Tracks occupation from "tracks" over to to explore Make "# soundtracks" a link to the soundtracks that the track is in 1 1 1 3 1 in is expected to be a link to those soundtracks would be to long the "soundtracks" it features in 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 User entered Occupations then support for searching them alternatively a comprehensive list 1 3 1 Users Hard to find peoples actual 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation difficulty finding help on how to 15 Help confusing terminology "Your VOICE" would be to long rename You VOICE with your profile at least in the help area 1 1 2 1 edit profile remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 16 Soundtracks 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks tab opens Described by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurpose of home page(see details and illustrations in 18 Global Difficulty navigating to STY4U 1 1 1 not get to main document) Remove the My Soundtracks pop out or have it only show the created soundtracks or "no Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so soundtracks created" when empty, once the user has more than a few then introduce the 19 Global 1 1 1 3 1 1 soundtracks will not seem relevant also the profile area is difficult to find sorting categories and only ones that are populated with created soundtracks, Also
  • 28.
    Didn’t notice thathad not 38 Login / Signup no error feedback on terms and conditions tick box, also the tick box it quite small make the checkbox larger and add red feedback text 1 1 1 ticked terms and conditions 5 Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 6 Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 7 Profile CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 Issues on the soundtrack creation screen 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 3 1 Many users reviced only a partial completion is for planning and you don’t have to plan your own date of Described by quote: "A calendar on task Profile sending aDOB input birth" Thethe accepted one i.e.todays date, Also the incorrect"did-mm-my" defines a different 17 3 for Frustration with playlistformat toemailstarts with "did/mm/yyyy" when actually input dialogue via calendar and Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 not through the more apropiate STY4U. 23 Profile Pale yellow text hard to read Not enough contrast between yellow and background Darker coloured text to replace light yellow, or outline, or darker background 1 1 1 Users when straight about whatpagemail icon to indicate on www.soundtracktoyour.com main at top right there will be enough distinction between areas. When viewing other 24 Issues foundthe 8 participants Profile Confusion for the the layout does not by do logged in user buttons on the profile that the functions on the profile page are only applicable to the If the username site navigation is restructured and the profile area functions placed under the 1 1 1 share their playlist. from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to highlight search result after following link or have the search page give results in stacks titled Disorientation 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 search result link search results and optional filter or pick from a category e.g. "tracks" Participants Tasks Search appears broken when 25 Record Search results there is no feedback on search results profile a "nothing found when you searched for <users search>" type of message 1 1 2 1 1 Location Description fund no results are Cause Solution (redesign recommendation) 1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 order 1 Home unsure if logged in No direct indication of login status have username display top right on every page 1 1 1 1 4 1 1 SoundTrack should be listed under "share" as extra option when selecting "by email" and less confusing 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" Click username to enter profile (see 1) 1 1 1 1 1 5 1 Soundtrack When adding a perhaps lesser known song:"error: [object: 3 30 Login / Signup Difficulty on Sign up CRASH Sign up text too small clear separate button for signup ? 1 1 1 1 1 1 1 7 1 1 1 2 1 1 creation Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta > 4 Global frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 Soundtrack cannot add song once search If you click play from the search dropdown you are given a 30 second preview and by the time 33 put an add track to playlist button onto the preview area 1 1 1 creation dropdown disappears this has finished the add button has gone 5 Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 Soundtrack 34 CRASH The buy button on the preview player has a broken link ? 1 1 1 6 creation Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 unexpected result from clicking 8 7 Soundtracks CRASH Profile rank button has a magnifying glass Loading animation stuck upon entering help area via top link from profile page ? change to button showing 2 triangles up and down 1 1 1 1 1 1 rank unexpected result from clicking 8 Soundtracks rank button has a magnifying glass change to button showing 2 triangles up and down 1 1 1 rank Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no 16 Soundtracks highlight search even whenfollowing link or have the with: "add > give results in stacks titled cat > errors result after executed well, replace search page soundtrack > soundtrack 1 1 1 1 1 1 6 1 1 dragging Disorientation from following Results pages shows linksto land on, help a list of soundtracks, does not appear relevant to soundtrack available that take you to balloon and tool top text not specific enough 10 Search results by resultsSoundtrack Name" as and have the title theadd button orgive a summary of My Soundtracks 1 location within the site a dropdown under only link also in the area where 1 1 1 4 1 1 1 search result link search Disappointment with not results and optional filter or pick from a category e.g. "tracks" 26 Soundtracks knowing how appropriate No info on BPM Adding BPM information 1 1 1 songs are for exercise Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 Global TECH The regular back button on the browser does not work 1 1 1 1 1 5 1 1 1 1 still-work-ajax-page-loads When playing a soundtrack, after the first 30 second preview is over the second song begins 27 Soundtracks TECH ? 1 1 1 but the artwork, name and artists from the first song persist SoundTrack should be listed under "share" as extra option when selecting "by email" and less confusing 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology 28 Soundtracks CRASH When clicking "tracks>9 to 5" dialogue box :"error: [object Object]" ? 1 1 1 3 1 User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation Disorientation when creating This task should have another stage after selecting birthday asking weather users wish to 20 STY4U clicking image of birthday instead of "create" button takes users to "tracks>party>birthday" be to long would 1 1 1 STY4U create on or see what other users have chosen first 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 3 1 people seem to expect it to be at the bottom, but I think that the positioning and style gives 29 STY4U sent button a little hard to find move the send button to be aligned with the creation box 1 1 2 1 difficulty finding help on how to users banner blindness to that area 15 Help confusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 edit profile Confusion over if the recipient 37 STY4U once the email is entered on the STY4U screen the email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users 1 1 1 is correct remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 16 Soundtracks 1 1 1 1 1 1 6 1 1 draggingretype details again after has to soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks Terms and terms should be either a separate window (with a print button perhaps?) or have an accept 29 going back from terms and no accept button on terms and conditions tab opens 1 1 1 Conditions button at the bottom or be a collapsible or scroll box conditions page Described by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile Frustration with DOB input able the "#calendar starts on the tracks page that indicates how many soundtracks different Replace date of birth input with 3 dropdowns for day month and year frustration with not being birth" The soundtracks" with todays date, Also the incorrect input dialogue defines a the track features 1 1 1 1 1 1 6 1 22 Tracks to explore from "tracks" over to formatis expected to be a link "did/mm/yyyy" when actually "did-mm-my" Make "# soundtracks" a link to the soundtracks that the track is in 1 1 1 3 1 in to the accepted one i.e. to those soundtracks the "soundtracks" it features in Help area instructs users to start the STY4U process at the home page which one user could User entered Occupations then support for searching them alternatively a comprehensive list Restructure of site navigation and repurpose of home page(see details and illustrations in 18 Users Global Hard to find peoples actual Difficulty navigating to STY4U 1 1 1 13 not get to Categories for occupation asked for at signup are to vague main document) of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation would be to long Remove the My Soundtracks pop out or have it only show the created soundtracks or "no Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so soundtracks created" when empty, once the user has more than a few then introduce the 19 Global 1 1 1 3 1 1 soundtracks will not seem relevant also the profile area is difficult to find sorting categories and only ones that are populated with created soundtracks, Also
  • 29.
    results and optionalfilter or pick from a category e.g. "tracks" Search appears broken when 25 Search results there is no feedback on search results profile a "nothing found when you searched for <users search>" type of message 1 1 2 1 1 no results are fund SoundTrack should be listed under "share" as extra option when selecting "by email" and less confusing 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology Soundtrack When adding a perhaps lesser known song:"error: [object: 30 CRASH ? 1 1 2 1 1 creation Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta > Soundtrack cannot add song once search If you click play from the search dropdown you are given a 30 second preview and by the time 33 put an add track to playlist button onto the preview area 1 1 1 creation dropdown disappears this has finished the add button has gone Issues on the STY4U creation screen 34 Soundtrack creation CRASH The buy button on the preview player has a broken link ? 1 1 1 Only 3 users found this screenrank buttononemagnifying glass Only the yonger people figured out what 2 triangles up and down 8 Soundtracks unexpected result from clicking and rank has a of change to button showing 1 1 1 them needed to look at the help several a “STY4U” stood for, I belive this is due to times and also are 9 Soundtracks enter the helpdesk on length in truncated view peoples ability to abstract slowly diminishingtruncated view and make this the button to expand Unsure how long soundtracks no info roleplay add number of songs in playlist to 1 1 1 1 4 1 to find it. past the age of around 21. remove dragging feature from site as it is difficult to use on many platforms and prone to 16 Soundtracks Difficulty and frustration with http://www.inclusivedesigntoolkit.com/betterdesign2/well, replace with: "add > soundtrack > soundtrack cat > Dragged item jumps to right upon drag, target area to small, still allows drag when no errors even when executed 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough UCthinking/thinking.html#p50 Of the 2Soundtracksfound how on their own,onone senton who knowing it appropriate 8 participants Issues found by www.soundtracktoyour.com Name" as a dropdown under add button or in the area where My Soundtracks Soundtrack Disappointment with not 26 No info BPM Adding BPM information 1 1 1 the birthday messageexercise wrong person. songs are for to the When playing a soundtrack, after the first 30 second preview is over the second song begins 27 Soundtracks TECH ? 1 1 1 but the artwork, name and artists from the first song persist Participants Tasks Record 28 Soundtracks Description CRASH Location Cause clicking "tracks>9 to 5" dialogue box :"error: [object Object]" When ? Solution (redesign recommendation) 1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 3 1 1 1 1 order 1 Home unsure if logged in No direct indication of login status have username display top right on every page 1 1 1 1 4 1 1 Disorientation when creating This task should have another stage after selecting birthday asking weather users wish to 20 STY4U clicking image of birthday instead of "create" button takes users to "tracks>party>birthday" 1 1 1 STY4U create on or see what other users have chosen first 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" Click username to enter profile (see 1) 1 1 1 1 1 5 1 people seem to expect it to be at the bottom, but I think that the positioning and style gives 29 STY4U sent button a little hard to find move the send button to be aligned with the creation box 1 1 2 1 3 Login / Signup Difficulty on Sign up users banner blindness to that area Sign up text too small clear separate button for signup 1 1 1 1 1 1 1 7 1 Confusion over if the recipient 37 STY4U once the email is entered on the STY4U screen the email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users 1 1 1 4 Global is correct frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 has to retype details again after 5 Terms and Profile can't findbackprofileterms and Editno accept button on termstop right with username terms should be either a separate window (with a print button perhaps?) or have1an accept 1 1 29 going edit from profile is expected to be at and conditions show "settings" and "edit profile" next to username (see 1) 1 1 5 1 1 1 1 Conditions button at the bottom or be a collapsible or scroll box conditions page 6 Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 frustration with not being able the "# soundtracks" on the tracks page that indicates how many soundtracks the track features 22 Tracks to explore from "tracks" over to Make "# soundtracks" a link to the soundtracks that the track is in 1 1 1 3 1 7 Profile CRASH Loading expected to be upon entering help area via top link from profile page in is animation stuck a link to those soundtracks ? 1 1 1 the "soundtracks" it features in unexpected result from clicking User entered Occupations then support for searching them alternatively a comprehensive list 8 Users Soundtracks Hard to find peoples actual rank button has a magnifying glass change to button showing 2 triangles up and down 1 1 1 13 rank Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation would be to long Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are highlight search result after following link or have the search page give results in stacks titled Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 search result link search results and optional filter or pick from a category e.g. "tracks" Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 Global TECH The regular back button on the browser does not work 1 1 1 1 1 5 1 1 1 1 still-work-ajax-page-loads SoundTrack should be listed under "share" as extra option when selecting "by email" and less confusing 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation would be to long 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 3 1 difficulty finding help on how to 15 Help confusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 edit profile remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 16 Soundtracks 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks tab opens Described by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurpose of home page(see details and illustrations in 18 Global Difficulty navigating to STY4U 1 1 1 not get to main document) Remove the My Soundtracks pop out or have it only show the created soundtracks or "no Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so soundtracks created" when empty, once the user has more than a few then introduce the 19 Global 1 1 1 3 1 1
  • 30.
    Issues found by8 participants on www.soundtracktoyour.com Participants Tasks Record Location Description Cause Solution (redesign recommendation) 1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 Issues on the help screen order 4 Global frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 The keyGlobal 18 issue with the help area get to instructs users to start the STY4U process at the home page which one user could Difficulty navigating to STY4U not was the Help area Restructure of site navigation and repurpose of home page(see details and illustrations in main document) 1 1 1 terminology used when referencign the pop out tab is not clear and shows categories that have no playlists so 19 Global Difficulty finding created The My Soundtracks Remove the My Soundtracks pop out or have it only show the created soundtracks or "no soundtracks created" when empty, once the user has more than a few then introduce the 1 1 1 3 1 1 profile. soundtracks will not seem relevant also the profile area is difficult to find sorting categories and only ones that are populated with created soundtracks, Also Would need the search function to be redesigned to and turned into a more complicated 30 Global Can't search for years No support for searching via time 1 1 2 1 function in itself. 32 Global IssuesSoundtracks drawer largely participantsareon www.soundtracktoyour.comare populated with created soundtracks, Also the sorting categories and only ones My found by 8 around but serves no use as thebroadfunction relevance to every task but this area is always Remove the My Soundtracks pop out then introduce useless The displayed categories to drag to have is unusable. that 1 1 2 1 menu rollovers should be only links to pages or specific functions not parts of a function (see 36 Global Rollover is annoying The rollover is far to large and contains to much and is difficult to make it disappear 1 1 2 1 1 navigation redesign) Settings dropdown wont go 39 Global User are not expecting this to a toggle on and off action make this a rollover or have it disappear after a second or 2 1 1 1 away Participants Tasks Record Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 Location Global Description TECH Cause regular back button on the browser does not work The Solution (redesign recommendation) 1 2 3 4 5 1 7 1 ∑ t1 t2 t3 t4 6 8 1 1 1 5 1 1 1 1 order still-work-ajax-page-loads 1 Home unsure if logged in No direct indication of login status have username display top right on every page 1 1 1 1 4 1 1 difficulty finding help on how to 15 Help confusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 edit profile 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" Click username to enter profile (see 1) 1 1 1 1 1 5 1 31 3 Help Spelling Login / Signup Difficulty on Sign up Draw should be "drawer" in this context Sign up text too small clear separate button draw drawer not for signup 1 1 1 1 1 1 1 1 7 1 1 1 4 Global frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 1 Home unsure if logged in No direct indication of login status have username display top right on every page 1 1 1 1 4 1 1 5 Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" Click username to enter profile (see 1) 1 1 1 1 1 5 1 6 Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 If this is to be on the home page it should be smaller, and have a more subtle animation, 7 Profile Frustration with the movement The movement on the homepage help area via top link from cannon be stopped to read.?One CRASH Loading animation stuck upon entering moves to frequently and profile page 1 1 1 28 Home should change less frequently and be able to be frozen so the user can read or keep what is 1 1 2 1 on the home page user said it reminded them of adverts and would have immediately left the site. there. unexpected result from clicking 8 Soundtracks "philum" not recognized as a rank button has a magnifying glass change to button showing 2 triangles up and down 1 1 1 35 Home rank The reasoning behind this naming is not explained Change link title to be more descriptive 1 1 link to the video Unsure how long soundtracks 9 3 Soundtracks Login / Signupare Difficulty on Sign up no info on length too small view Sign up text in truncated add number of songs in playlist to truncated view and make this the button to expand clear separate button for signup 1 1 1 1 1 1 4 1 1 1 1 1 7 1 1 highlight search result after following link or have the search page give results in stacks titled Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 search result link Didn’t notice that had not search 38 Login / Signup no error feedback on terms and conditions tick box, also the tick box it quite small results and optional checkbox larger a category e.g. "tracks" text make the filter or pick from and add red feedback 1 1 1 ticked terms and conditions Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 Global TECH The regular back button on the browser does not work 1 1 1 1 1 5 1 1 1 1 still-work-ajax-page-loads 5 SoundTrack Profile can't find edit profile Edit profile is expected to be at top right with username should beshow "settings" and as extra option when selecting "by email" and less confusing listed under "share" "edit profile" next to username (see 1) 1 1 1 1 1 5 1 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual 6 13 Profile CRASH Categories for occupation profile for at signuphere.” link broken on profile page “Begin creating your asked by clicking are to vague ? of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 1 3 1 1 11 4 1 Occupation occupation would be to long 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 3 1 7 Profile CRASH difficulty finding help on how to Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 15 Help confusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 edit profile remove dragging feature from site as it is difficult to use on many platforms and prone to 14 Profile Difficulty and frustration with CRASH Dragged item jumps to right upon clicking "edit profile" fromstill allows drag when no "error: [object Object]" upon drag, target area to small, profile page errors even when executed well, replace with: "add > soundtrack > soundtrack cat > ? 1 1 1 3 1 16 Soundtracks 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks tab opens Described by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 Described by quote: "A calendar is for planning and you don’t have to plan your own date of format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" 23 Profile Pale yellow text hard to read Not enough contrast between yellow and background Darker coloured text to replace light yellow, or outline, or darker background 1 1 1 Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurpose of home page(see details and illustrations in 18 Global Difficulty navigating to STY4U 1 1 1 Confusion about what the not get to the layout does not indicate that the functions on the profile page are only applicable to the document) main If the main site navigation is restructured and the profile area functions placed under the 24 Profile 1 1 1 buttons on the profile page do logged in user username at top right there will be enough distinction between areas. When viewing other Remove the My Soundtracks pop out or have it only show the created soundtracks or "no Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so soundtracks created" when result after following link or have the search page give results in stacks titled highlight search empty, once the user has more than a few then introduce the 19 Global Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 1 1 1 3 1 1 10 Search results soundtracks will not seem relevant also the profile area is difficult to find by results location within the site and have the title the only link also give a summary of sorting categories and only ones that are populated with created soundtracks, Also 1 1 1 1 4 1 1 1 search result link search
  • 31.
    on the homepage user said it reminded them of adverts and would have immediately left the site. there. "philum" not recognized as a 35 Home The reasoning behind this naming is not explained Change link title to be more descriptive 1 1 link to the video 3 Login / Signup Difficulty on Sign up Sign up text too small clear separate button for signup 1 1 1 1 1 1 1 7 1 Didn’t notice that had not 38 Login / Signup no error feedback on terms and conditions tick box, also the tick box it quite small make the checkbox larger and add red feedback text 1 1 1 ticked terms and conditions 5 Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 Issues on the search results screen 6 Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 A lot of users where confused by the results of their serchest using the search feild at the entering help area via top link from profile page 7 Profile CRASH Loading animation stuck upon ? 1 1 1 top of the page. 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 3 1 17 Profile Issues found by 8 participants on fordate, Also and incorrect input dialogueyour ownadate of Replace date of birth input with 3 dropdowns for day month and year Frustration with DOB input Described by quote: "A calendar is www.soundtracktoyour.com birth" The calendar starts with todays planning the you don’t have to plan defines different 1 1 1 1 1 1 6 1 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" 23 Profile Pale yellow text hard to read Not enough contrast between yellow and background Darker coloured text to replace light yellow, or outline, or darker background 1 1 1 Participants Tasks Record Confusion about what the 24 Location Profile Description Causelayout does not indicate that the functions on the profile page are only applicable to the the If the main site navigation is restructured and the profile area functions placed under the 4 5 6 7 8 ∑ t1 t2 t3 t4 Solution (redesign recommendation) 1 2 3 1 1 1 order buttons on the profile page do logged in user username at top right there will be enough distinction between areas. When viewing other 1 Home unsure if logged in No direct indication of login status have username display top right on every page 1 1 1 1 4 1 1 highlight search result after following link or have the search page give results in stacks titled Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 2 Home search result link difficulty navigating to profile search Confusing terminology " my soundtracks" Click username to enter profile (see 1) 1 1 1 1 1 5 1 results and optional filter or pick from a category e.g. "tracks" 3 Search appears broken when Login / Signup Difficulty on Sign up Sign up text too small clear separate button for signup 25 Search results there is no feedback on search results profile a "nothing found when you searched for <users search>" type of message 1 1 1 1 1 1 1 7 1 1 1 2 1 1 no results are fund 4 Global frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 SoundTrack should be listed under "share" as extra option when selecting "by email" and less confusing 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology 5 Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 6 Soundtrack Profile CRASH “Begin creating your perhaps lesser known song:"error: on profile page When adding a profile by clicking here.” link broken [object: ? 1 1 1 1 4 1 30 CRASH ? 1 1 2 1 1 creation Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta > 7 Profile CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 Soundtrack cannot add song once search If you click play from the search dropdown you are given a 30 second preview and by the time 33 unexpected result from clicking put an add track to playlist button onto the preview area 1 1 1 8 creation Soundtracks dropdown disappears rank button has a magnifying glass has gone this has finished the add button change to button showing 2 triangles up and down 1 1 1 rank Soundtrack Unsure how long soundtracks 34 9 Soundtracks CRASH no info on length in truncated view player has a broken link The buy button on the preview ? add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 1 4 1 1 1 creation are unexpected result from clicking 8 Soundtracks rank button has a magnifying glass highlight search result after following link or have the and down give results in stacks titled change to button showing 2 triangles up search page 1 1 1 Disorientation from following rank Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 search result link search results and optional filter or pick from a category e.g. "tracks" Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 1 1 1 1 4 1 11 Global TECH are The regular back button on the browser does not work 1 1 1 1 1 5 1 1 1 1 still-work-ajax-page-loads SoundTrack should beremove dragging feature from site whenis difficult "byuse on and less confusing listed under "share" as extra option as it selecting to email" many platforms and prone to 12 Not noticedand frustration with Confusing name "STY4U" and share function has email optionsmall, still allows drag when no Difficulty STY4U Dragged item jumps to right upon drag, target area to 1 1 1 1 1 5 1 16 Soundtracks creation errors even when executed well, replace with: "add > soundtrack > soundtrack cat > terminology 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks Disappointment with not User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual 13 26 Soundtracks knowing how appropriate Categories for occupation asked for at signup are to vague No info on BPM of professional areas but to select this from a dropdown would not be usable as the list Adding BPM information 1 1 1 1 3 1 1 1 Occupation occupation songs are for exercise would be to long When playing a soundtrack, after the first 30 second preview is over the second song begins 27 14 Soundtracks CRASH Profile TECH "error: [object Object]" upon clicking "edit profile" from profile page ? ? 1 1 1 3 1 1 1 but the artwork, name and artists from the first song persist difficulty finding help on how to 15 Help confusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 28 Soundtracks edit profile CRASH When clicking "tracks>9 to 5" dialogue box :"error: [object Object]" ? 1 1 1 3 1 remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustrationcreating Dragged item jumps to right upon drag, target area to small, still allows drag when no Disorientation when with errors even when executed have replace with: "add > soundtrack > soundtrack cat > This task should well, another stage after selecting birthday asking weather users wish to 20 16 STY4U Soundtracks clicking image of birthday instead of "create" button takes users to "tracks>party>birthday" 1 1 1 1 1 1 6 1 1 1 1 1 STY4U dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add have chosen first where My Soundtracks create on or see what other users button or in the area tab opens people seem to expect it to be at the bottom, but I think that the positioning and style gives 29 STY4U sent button a little hard to find move the send button to be aligned with the creation box 1 1 2 1 Describedbanner blindness to that area users by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 Confusion over if the recipient format to the acceptedentered "did/mm/yyyy" when actually "did-mm-my" has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users 37 STY4U once the email is one i.e. on the STY4U screen the email address 1 1 1 is correct Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurpose of home page(see details and illustrations in 18 Global Difficulty retype details again after has to navigating to STY4U not get to 1 1 1 Terms and main document)should be either a separate window (with a print button perhaps?) or have an accept terms 29 going back from terms and no accept button on terms and conditions 1 1 1 Conditions button at the bottom or be a collapsible or scroll box conditions page Remove the My Soundtracks pop out or have it only show the created soundtracks or "no Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so soundtracks created" when empty, once the user has more than a few then introduce the 19 Global frustration with not being able 1 1 1 3 1 1 soundtracks will not seem relevant also the profile area is difficult to find how many soundtracks the track sorting categories and only ones that are populated with created soundtracks, Also the "# soundtracks" on the tracks page that indicates features 22 Tracks to explore from "tracks" over to Make "# soundtracks" a link to the soundtracks that the track is in 1 1 1 3 1
  • 32.
    34 CRASH The buy button on the preview player has a broken link ? 1 1 1 creation unexpected result from clicking 8 Soundtracks rank button has a magnifying glass change to button showing 2 triangles up and down 1 1 1 rank Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no 16 Soundtracks errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks Disappointment with not 26 Soundtracks knowing how appropriate No info on BPM Adding BPM information 1 1 1 songs are for exercise When playing a soundtrack, after the first 30 second preview is over the second song begins Issues on the users screen 27 Soundtracks TECH but the artwork, name and artists from the first song persist ? 1 1 1 28 Soundtracks CRASH When clicking "tracks>9 to 5" dialogue box :"error: [object Object]" ? 1 1 1 3 1 The filtering functions and the way narrow users are catagorised when creating clicking imagemadeinstead of "create" button takes users to "tracks>party>birthday" 20 STY4U Disorientation by occupation of birthday it This task should have another stage after selecting birthday asking weather users wish to 1 1 1 STY4U create on or see what other users have chosen first hard for most users to complete fast 4. it to be at the bottom, but I think that the positioning and style gives people seem to expect 29 STY4U sent button a little hard to find move the send button to be aligned with the creation box 1 1 2 1 users banner blindness to that area Confusion over if the recipient 37 STY4U Issues found by 8 participantsonon www.soundtracktoyour.com a unique naming issue then it should be hidden from users is correct once the email is entered the STY4U screen the email address has a "gg_" at the beginning If it is 1 1 1 has to retype details again after Terms and terms should be either a separate window (with a print button perhaps?) or have an accept 29 going back from terms and no accept button on terms and conditions 1 1 1 Conditions button at the bottom or be a collapsible or scroll box conditions page frustration with not being able Participants Tasks Record 22 order TracksIssues found by to8inparticipants on that indicates how many soundtracks the track SolutionMake "# soundtracks" a link to the soundtracks that the track is in Location to explore from "tracks" over Description the "# soundtracks" on the tracks page www.soundtracktoyour.comrecommendation) Cause expected to be a link to those soundtracks is features (redesign 1 1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 1 1 3 1 the "soundtracks" it features in 1 Home unsure if logged in No direct indication of login status have usernameentered top right on every page User display Occupations then support for searching them alternatively a comprehensive list 1 1 1 1 4 1 1 Users Hard to find peoples actual 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" would be to long Click username to enter profile (see 1) 1 1 1 1 1 5 1 Users Confusion with results or 21 No indication on how or if how the results are filtered A visually separate filtration area that shows which filters are active and possible 1 1 2 1 Occupation filtering by occupation 3 Login / Signup Difficulty on Sign up Sign up text too small clear separate button for signup 1 1 1 1 1 1 1 7 1 Users 40 TECH When filtering to Sports and Leisure the text is repeated in another font on top of the main text ? 1 1 1 Occupation 4 Global frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 5 Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 6 Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 7 Profile CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 unexpected result from clicking 8 Soundtracks rank button has a magnifying glass change to button showing 2 triangles up and down 1 1 1 rank Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are highlight search result after following link or have the search page give results in stacks titled Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 search result link search results and optional filter or pick from a category e.g. "tracks" Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 Global TECH The regular back button on the browser does not work 1 1 1 1 1 5 1 1 1 1 still-work-ajax-page-loads SoundTrack should be listed under "share" as extra option when selecting "by email" and less confusing 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation would be to long 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 3 1 difficulty finding help on how to 15 Help confusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 edit profile remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 16 Soundtracks 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks tab opens Described by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurpose of home page(see details and illustrations in 18 Global Difficulty navigating to STY4U 1 1 1 not get to main document) Remove the My Soundtracks pop out or have it only show the created soundtracks or "no Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so soundtracks created" when empty, once the user has more than a few then introduce the 19 Global 1 1 1 3 1 1 soundtracks will not seem relevant also the profile area is difficult to find sorting categories and only ones that are populated with created soundtracks, Also
  • 33.
    34 CRASH The buy button on the preview player has a broken link ? 1 1 1 creation unexpected result from clicking 8 Soundtracks rank button has a magnifying glass change to button showing 2 triangles up and down 1 1 1 rank Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no 16 Soundtracks errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks Disappointment with not 26 Soundtracks knowing how appropriate No info on BPM Adding BPM information 1 1 1 songs are for exercise When playing a soundtrack, after the first 30 second preview is over the second song begins Issues on the users screen 27 Soundtracks TECH but the artwork, name and artists from the first song persist ? 1 1 1 28 Soundtracks CRASH When clicking "tracks>9 to 5" dialogue box :"error: [object Object]" ? 1 1 1 3 1 The filtering functions and the way narrow users are catagorised when creating clicking imagemadeinstead of "create" button takes users to "tracks>party>birthday" 20 STY4U Disorientation by occupation of birthday it This task should have another stage after selecting birthday asking weather users wish to 1 1 1 STY4U create on or see what other users have chosen first hard for most users to complete fast 4. it to be at the bottom, but I think that the positioning and style gives people seem to expect 29 STY4U sent button a little hard to find move the send button to be aligned with the creation box 1 1 2 1 users banner blindness to that area Confusion over if the recipient 37 STY4U Issues found by 8 participantsonon www.soundtracktoyour.com a unique naming issue then it should be hidden from users is correct once the email is entered the STY4U screen the email address has a "gg_" at the beginning If it is 1 1 1 has to retype details again after Terms and terms should be either a separate window (with a print button perhaps?) or have an accept 29 going back from terms and no accept button on terms and conditions 1 1 1 Conditions button at the bottom or be a collapsible or scroll box conditions page frustration with not being able Participants Tasks Record 22 order TracksIssues found by to8inparticipants on that indicates how many soundtracks the track SolutionMake "# soundtracks" a link to the soundtracks that the track is in Location to explore from "tracks" over Description the "# soundtracks" on the tracks page www.soundtracktoyour.comrecommendation) Cause expected to be a link to those soundtracks is features (redesign 1 1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 1 1 3 1 the "soundtracks" it features in 1 Home unsure if logged in No direct indication of login status have usernameentered top right on every page User display Occupations then support for searching them alternatively a comprehensive list 1 1 1 1 4 1 1 Users Hard to find peoples actual 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" would be to long Click username to enter profile (see 1) 1 1 1 1 1 5 1 Users Confusion with results or 21 No indication on how or if how the results are filtered A visually separate filtration area that shows which filters are active and possible 1 1 2 1 Occupation filtering by occupation 3 Login / Signup Difficulty on Sign up Sign up text too small clear separate button for signup 1 1 1 1 1 1 1 7 1 Users 40 TECH When filtering to Sports and Leisure the text is repeated in another font on top of the main text ? 1 1 1 Occupation 4 Global frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 5 Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 6 Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 7 Profile CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 unexpected result from clicking 8 Soundtracks rank button has a magnifying glass change to button showing 2 triangles up and down 1 1 1 rank Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are highlight search result after following link or have the search page give results in stacks titled Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 search result link search results and optional filter or pick from a category e.g. "tracks" Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 Global TECH The regular back button on the browser does not work 1 1 1 1 1 5 1 1 1 1 still-work-ajax-page-loads SoundTrack should be listed under "share" as extra option when selecting "by email" and less confusing 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation would be to long 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 3 1 difficulty finding help on how to 15 Help confusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 edit profile remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 16 Soundtracks 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks tab opens Described by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurpose of home page(see details and illustrations in 18 Global Difficulty navigating to STY4U 1 1 1 not get to main document) Remove the My Soundtracks pop out or have it only show the created soundtracks or "no Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so soundtracks created" when empty, once the user has more than a few then introduce the 19 Global 1 1 1 3 1 1 soundtracks will not seem relevant also the profile area is difficult to find sorting categories and only ones that are populated with created soundtracks, Also
  • 34.
    The key differenceshere are the login / signup and the addition of a welcome area to let user know what the site does. Scrolling down Recommendations would reveal more features about the site. Most of the redesign is obvious, but the not so obvious thing is this Home page home page is the help area in disguise. The “read more” links take you to that section of the help. ? LOGO Username Password Login Signup HOME ABOUT CREATE EXPLORE Welcome ABOUT Website image Leads to the A sentence or promotional video paragraph summerising and should give more slogan the purpose of the information about the website. This should people involved and be optimised to what their goals where appear in search when making the site search engin results. A teaser of a A teaser of a Feature Feature feature of the feature of the image image site site READ MORE READ MORE
  • 35.
    Home page whenlogged in Once logged in the user should see their ? own user name at the top. Logged in as: <username> Clicking it will bring down a menu to get to the more functions of the site that can only Create Playlist be done by signing up. Settings Edit profile The settings would be on their own static logout page. ? Logged in as: LOGO <username> HOME ABOUT CREATE EXPLORE Welcome Website image A sentence or paragraph summerising slogan the purpose of the website. This should be optimised to appear in search search engin results.
  • 36.
    Sitemap HOME ABOUT CREATE EXPLORE HELP Profile accessed The promotional video E-card Soundracks Help Catagorys by clicking user Purpose of site Category Search Soundtracks name Staff Bio Top level category Category Company History Sub category Top level category Sub category Soundtracks index Soundtrack Category Top level category Tracks Search Tracks Sub category Category Top level category Sub category Tracks index Users Filter users via search Individual user profile Individual user profile Individual user profile
  • 37.
    The changes tothis page are subtle, The button to expand the track list has moved to the bottom right and there is information on the number of tracks and the length of the soundtrack in minutes under the list name. Soundtracks index The category name has been removed, this information is now indicated by highlighting the relevant part of the breadcrumbs. ? Logged in as: LOGO <username> HOME ABOUT CREATE EXPLORE Soundtracks > category > Sub-category Play individual track <List Name> <Artist> - <Song Name> <USERID> <Number of tracks> View Profile <List Length(time)> <Artist> - <Song Name> rank 1 <Artist> - <Song Name> Expand <List Name> <Artist> - <Song Name> Buttons for: • Playing <USERID> <Number of tracks> <List Length(time)> <Artist> - <Song Name> rank 2 • Like View Profile <Artist> - <Song Name> Expand • Share • Buy <List Name> <Artist> - <Song Name> <USERID> <Number of tracks> <List Length(time)> <Artist> - <Song Name> rank 3 View Profile <Artist> - <Song Name> Expand
  • 38.
    The 2 majorchanges to this page ate that the number of soundtracks the track features in is a link that will show a soundtracks index page for those soundtracks. Also the drag and drop feature is replaced with a drop-down menu Tracks index detailed on the next page. ? Logged in as: LOGO <username> HOME ABOUT CREATE EXPLORE Tracks > category > Sub-category <Artist> - <Song Name> Features in: 15 Soundtracks rank 1 Add to your soundtrack <Artist> - <Song Name> Features in: 15 Soundtracks rank 2 Add to your soundtrack <Artist> - <Song Name> Features in: 15 Soundtracks rank 3 Add to your soundtrack
  • 39.
    Instead of draggingusers will have 3 more clicks to pick a soundtrack to add it to. Alternatively the 2 most recently created soundtracks could be chosen from the top of the drop-down. Tracks index <Artist> - <Song Name> Features in: 15 Soundtracks rank 1 Add to your soundtrack 1 Add to your soundtrack <Recently Created Soundtrack> <Recently Created Soundtrack> <Catagory populated with soundtrack> <Catagory populated with soundtrack> <Catagory populated with soundtrack> 2 3 Add to your soundtrack Add to your soundtrack <Recently Created Soundtrack> <Recently Created Soundtrack> <Recently Created Soundtrack> <Recently Created Soundtrack> <Sub-Catagory populated with soundtrack> <Created Soundtrack> <Sub-Catagory populated with soundtrack> <Created soundtrack> <Sub-Catagory populated with soundtrack>
  • 40.
    On this pagethe breadcrumb is again used to show users where they are and the descriptive title for the creation area lets people know what they are doing. The button to create the soundtrack has Soundtracks creation been moved to the bottom right. ? Logged in as: LOGO <username> HOME ABOUT CREATE EXPLORE Create > Soundtrack > Category > Sub-catagory > <listname> CREATE your soundtrack in <sub-catagory> <List Name> <Number of tracks> Search for tracks or arstis <List Length(time)> <Artist> - <Song Name> <Artist> - <Song Name> Buttons for: <Artist> - <Song Name> • Playing • Like • Share • Buy Publish Now
  • 41.
    Clicking the oneshare button will bring up a overlay where you can select comon methos of sharing or sent the formerly know as STY4U now named Musical E-card. Sharing a Soundtrack ? Logged in as: LOGO <username> HOME ABOUT CREATE EXPLORE Create > Soundtrack > Category > Sub-catagory > <listname> CREATE your soundtrack in <sub-catagory> <List Name> <Number of tracks> Search for tracks or artstis <List Length(time)> <Artist> - <Song Name> <Artist> - <Song Name> Facebook <Artist> - <Song Name> Twitter Send Musical E-card Google+ Publish Now
  • 42.
    The Search pagewill have a section on the for Would you live to try searching : Users or left showing filtering options with tick-boxes Tracks instead?” The words users and tracks that show weather a filter is active or not. would be links to the separate search pages. If no results a found and error message will The layout of these pages would be the Search function take the place of results same as this one. “Sorry we could not find what you searched ? Logged in as: LOGO <username> HOME ABOUT CREATE EXPLORE Explore > Soundtracks > Search Filter Results Search in Soundtracks Year <List Name> <USERID> <Number of tracks> Category <List Length(time)> View Profile Sub-category Expand <List Name> <USERID> <Number of tracks> <List Length(time)> View Profile Checkboxs Expand
  • 43.
    New Critical paths Task 1 Task 2 Task 3 Task 4 Critical path Critical path Critical path Critical path signup Explore Create Explore edit profile soundtracks E-card Users a workout category Filter Users category Search and preview tack add tracks View user profile buy playlist Add Message Send
  • 44.
    Criticisms Method • Not clearenough about involvement and objectives of the study. • Should have been more specific about the tasks. • Should have left the room for filling out questionnaires. • Should not have recorded the questionnaires. • Should have worded nearly all the questions very differently and repeated that they be answered objectively. • The open ended questions where to frequent and not of much use. Instead of the open ended questions should have only asked for negative points. • Mistake on one of the questionnaires is a scale of 5 instead of 7. • One of the scales is reversed goes from positive to negative. • The pre-questionaire questions are largely irrelevant.
  • 45.
    Appendices • Full Tableof Issues • Task Cards • Task Notes • Task Data Entry sheets
  • 46.
    Issues found by8 participants on www.soundtracktoyour.com Participants Tasks Record Location Description Cause Solution (redesign recommendation) 1 2 3 4 5 6 7 8 ∑ t1 t2 t3 t4 order 1 Home unsure if logged in No direct indication of login status have username display top right on every page 1 1 1 1 4 1 1 2 Home difficulty navigating to profile Confusing terminology " my soundtracks" Click username to enter profile (see 1) 1 1 1 1 1 5 1 3 Login / Signup Difficulty on Sign up Sign up text too small clear separate button for signup 1 1 1 1 1 1 1 7 1 4 Global frustration with help balloons Help balloons obscure site and disappear before being read click to remove and tick to not show again 1 1 1 1 1 5 1 1 5 Profile can't find edit profile Edit profile is expected to be at top right with username show "settings" and "edit profile" next to username (see 1) 1 1 1 1 1 5 1 6 Profile CRASH “Begin creating your profile by clicking here.” link broken on profile page ? 1 1 1 1 4 1 7 Profile CRASH Loading animation stuck upon entering help area via top link from profile page ? 1 1 1 unexpected result from clicking 8 Soundtracks rank button has a magnifying glass change to button showing 2 triangles up and down 1 1 1 rank Unsure how long soundtracks 9 Soundtracks no info on length in truncated view add number of songs in playlist to truncated view and make this the button to expand 1 1 1 1 4 1 are highlight search result after following link or have the search page give results in stacks titled Disorientation from following Results pages shows links that take you to a list of soundtracks, does not appear relevant to 10 Search results by results location within the site and have the title the only link also give a summary of 1 1 1 1 4 1 1 1 search result link search results and optional filter or pick from a category e.g. "tracks" Possible solution: http://www.covenantdesign.com/blog/make-bookmarking-and-back-button- 11 Global TECH The regular back button on the browser does not work 1 1 1 1 1 5 1 1 1 1 still-work-ajax-page-loads SoundTrack should be listed under "share" as extra option when selecting "by email" and less confusing 12 Not noticed STY4U Confusing name "STY4U" and share function has email option 1 1 1 1 1 5 1 creation terminology User entered Occupations then support for searching them alternatively a comprehensive list Users Hard to find peoples actual 13 Categories for occupation asked for at signup are to vague of professional areas but to select this from a dropdown would not be usable as the list 1 1 1 3 1 Occupation occupation would be to long 14 Profile CRASH "error: [object Object]" upon clicking "edit profile" from profile page ? 1 1 1 3 1 difficulty finding help on how to 15 Help confusing terminology "Your VOICE" rename You VOICE with your profile at least in the help area 1 1 2 1 edit profile remove dragging feature from site as it is difficult to use on many platforms and prone to Difficulty and frustration with Dragged item jumps to right upon drag, target area to small, still allows drag when no errors even when executed well, replace with: "add > soundtrack > soundtrack cat > 16 Soundtracks 1 1 1 1 1 1 6 1 1 dragging soundtrack available to land on, help balloon and tool top text not specific enough Soundtrack Name" as a dropdown under add button or in the area where My Soundtracks tab opens Described by quote: "A calendar is for planning and you don’t have to plan your own date of 17 Profile Frustration with DOB input birth" The calendar starts with todays date, Also the incorrect input dialogue defines a different Replace date of birth input with 3 dropdowns for day month and year 1 1 1 1 1 1 6 1 format to the accepted one i.e. "did/mm/yyyy" when actually "did-mm-my" Help area instructs users to start the STY4U process at the home page which one user could Restructure of site navigation and repurpose of home page(see details and illustrations in 18 Global Difficulty navigating to STY4U 1 1 1 not get to main document) Remove the My Soundtracks pop out or have it only show the created soundtracks or "no Difficulty finding created The My Soundtracks pop out tab is not clear and shows categories that have no playlists so soundtracks created" when empty, once the user has more than a few then introduce the 19 Global 1 1 1 3 1 1 soundtracks will not seem relevant also the profile area is difficult to find sorting categories and only ones that are populated with created soundtracks, Also Restructure of site navigation (see details and illustrations in main document) Disorientation when creating This task should have another stage after selecting birthday asking weather users wish to 20 STY4U clicking image of birthday instead of "create" button takes users to "tracks>party>birthday" 1 1 1 STY4U create on or see what other users have chosen first Users Confusion with results or 21 No indication on how or if how the results are filtered A visually separate filtration area that shows which filters are active and possible 1 1 2 1 Occupation filtering by occupation frustration with not being able the "# soundtracks" on the tracks page that indicates how many soundtracks the track features 22 Tracks to explore from "tracks" over to Make "# soundtracks" a link to the soundtracks that the track is in 1 1 1 3 1 in is expected to be a link to those soundtracks the "soundtracks" it features in 23 Profile Pale yellow text hard to read Not enough contrast between yellow and background Darker coloured text to replace light yellow, or outline, or darker background 1 1 1 If the main site navigation is restructured and the profile area functions placed under the Confusion about what the the layout does not indicate that the functions on the profile page are only applicable to the 24 Profile username at top right there will be enough distinction between areas. When viewing other 1 1 1 buttons on the profile page do logged in user user profiles it may work to use the current layout. Search appears broken when 25 Search results there is no feedback on search results profile a "nothing found when you searched for <users search>" type of message 1 1 2 1 1 no results are fund Disappointment with not 26 Soundtracks knowing how appropriate No info on BPM Adding BPM information 1 1 1 songs are for exercise When playing a soundtrack, after the first 30 second preview is over the second song begins 27 Soundtracks TECH ? 1 1 1 but the artwork, name and artists from the first song persist If this is to be on the home page it should be smaller, and have a more subtle animation, Frustration with the movement The movement on the homepage moves to frequently and cannon be stopped to read. One 28 Home should change less frequently and be able to be frozen so the user can read or keep what is 1 1 2 1 on the home page user said it reminded them of adverts and would have immediately left the site. there. 28 Soundtracks CRASH When clicking "tracks>9 to 5" dialogue box :"error: [object Object]" ? 1 1 1 3 1 people seem to expect it to be at the bottom, but I think that the positioning and style gives 29 STY4U sent button a little hard to find move the send button to be aligned with the creation box 1 1 2 1 users banner blindness to that area has to retype details again after Terms and terms should be either a separate window (with a print button perhaps?) or have an accept 29 going back from terms and no accept button on terms and conditions 1 1 1 Conditions button at the bottom or be a collapsible or scroll box conditions page Would need the search function to be redesigned to and turned into a more complicated 30 Global Can't search for years No support for searching via time 1 1 2 1 function in itself. Soundtrack When adding a perhaps lesser known song:"error: [object: 30 CRASH ? 1 1 2 1 1 creation Object]url:/SoundTrack/<user>/AddTrack? Trackid= <track meta > 31 Help Spelling Draw should be "drawer" in this context drawer not draw 1 1 1 My Soundtracks drawer largely The displayed categories are to broad to have relevance to every task but this area is always Remove the My Soundtracks pop out then introduce the sorting categories and only ones 32 Global 1 1 2 1 useless around but serves no use as the drag function is unusable. that are populated with created soundtracks, Also Soundtrack cannot add song once search If you click play from the search dropdown you are given a 30 second preview and by the time 33 put an add track to playlist button onto the preview area 1 1 1 creation dropdown disappears this has finished the add button has gone Soundtrack 34 CRASH The buy button on the preview player has a broken link ? 1 1 1 creation "philum" not recognized as a 35 Home The reasoning behind this naming is not explained Change link title to be more descriptive 1 1 link to the video menu rollovers should be only links to pages or specific functions not parts of a function (see 36 Global Rollover is annoying The rollover is far to large and contains to much and is difficult to make it disappear 1 1 2 1 1 navigation redesign) Confusion over if the recipient 37 STY4U once the email is entered on the STY4U screen the email address has a "gg_" at the beginning If it is a unique naming issue then it should be hidden from users 1 1 1 is correct Didn’t notice that had not 38 Login / Signup no error feedback on terms and conditions tick box, also the tick box it quite small make the checkbox larger and add red feedback text 1 1 1 ticked terms and conditions Settings dropdown wont go 39 Global User are not expecting this to a toggle on and off action make this a rollover or have it disappear after a second or 2 1 1 1 away Users 40 TECH When filtering to Sports and Leisure the text is repeated in another font on top of the main text ? 1 1 1 Occupation
  • 47.
    Task 1 Sign upfor soundtracktoyour.com To indicate you are finished please tell the conductor You have decided to explore “I’m finished” a new site for discovering and sharing music. You wish to sign up and then add relevant details about you to your area within the site.
  • 48.
    Task 2 Find andbuy a 20 minutes playlist You will indicate to exercise to as you are just you have finished this task when you about to start a new exercise are redirected to regime. the iTune store. You want to buy at least 20 Don’t worry you minutes worth of appropriate wont buy anything music to get your heart pumping by accident. whilst you do cardio vascular exercise.
  • 49.
    Task 3 Make aplaylist that reminds You will indicate you of being 19 and send it to you have finished when the email is a friend with a message that sent. congratulates them on their 19th birthday. This is my email address. your friends email address is: “james.maclean@jqim.co.uk”
  • 50.
    Task 4 Find outwhat sort of music IT You will indicate you professionals listen to. have competed this task when you tell the conductor what sort A curious friend has recently of music you think IT asked you a burning question, professionals listen to. what sort of music does the IT department listen to? The conductor will play the part of your curious friend.
  • 51.
    Need help? If youget stuck try to persevere, To signal you wish as we are interested in improving to speak to the help desk pick up the experience for everyone and this card and a we learn more for mistakes than telephone role play success. will begin. If you get really stuck try and find a help area, or if you feel it is beyond that you can make a fake call to the help desk.
  • 52.
    Task 1 Task order: Participant: NOTES Critical path login / signup my soundtracks open my voice edit profile
  • 53.
    Task 2 Task order: Participant: NOTES Critical path soundtracks a workout category preview tack buy playlist
  • 54.
    Task 3 Task order: Participant: NOTES Critical path my soundtracks create soundtrack use search function add track edit details enter name send a STY4U enter email enter a greeting send
  • 55.
    Task 4 Task order: Participant: NOTES Critical path users > all occupation > technology a profile view soundtracks
  • 56.
    11/29/12 POST ‑ Task 4 POST ­ Task 4 * Required Participant number: * to be answered by the conductor Overall how satisfied are you with the ease of completion of the task? * 1 2 3 4 5 6 7 completly unsatisfied completely satisfied How credible do you feel the the site is for the information you have found? * 1 2 3 4 5 6 7 no credibility complete credibility Submit Powered by Google Docs Report Abuse ­ Terms of Service ­ Additional Terms https://docs.google.com/a/jqim.co.uk/spreadsheet/viewform?formkey=dHhRTVJBSjN5RkFyVzQ3b… 1/1
  • 57.
    11/29/12 POST ‑ Task 3 POST ­ Task 3 * Required Participant number: * to be answered by the conductor Overall how satisfied are you with the ease of completion of the task? * 1 2 3 4 5 6 7 completly unsatisfied completely satisfied Submit Powered by Google Docs Report Abuse ­ Terms of Service ­ Additional Terms https://docs.google.com/a/jqim.co.uk/spreadsheet/viewform?formkey=dE1lZXh1c1JWSHhGaHhSd… 1/1
  • 58.
    11/29/12 POST ‑ Task 2 POST ­ Task 2 * Required Participant number: * to be answered by the conductor Overall how satisfied are you with the ease of completion of the task? * 1 2 3 4 5 6 7 completly unsatisfied completely satisfied How satisfied are you with the music you selected for this task? * 1 2 3 4 5 completely unsatisfied completely satisfied Submit Powered by Google Docs Report Abuse ­ Terms of Service ­ Additional Terms https://docs.google.com/a/jqim.co.uk/spreadsheet/viewform?formkey=dFA4Y3Nud2lubmRPbTZNX… 1/1
  • 59.
    11/29/12 POST ‑ task 1 POST ­ task 1 * Required Participant number: * to be answered by the conductor Overall how easy was this task? * create a profile and add bio info 1 2 3 4 5 6 7 Easy Difficult What do you make of the appearance of the site? Does it appear how you expected? How satisfied where you with the completion of this task? * 1 2 3 4 5 6 7 completely unsatisfied completely satisfied Submit Powered by Google Docs Report Abuse ­ Terms of Service ­ Additional Terms https://docs.google.com/a/jqim.co.uk/spreadsheet/viewform?formkey=dENJVGJGbXR5TGVweFJ… 1/1
  • 60.
    Minor Assists (referto help page)     - Task 1 Task 2 Task 3 Task 4 Participant 1 1 1 Participant 2 2 1 1 Participant 3 1 1 Participant 4 1 Participant 5 1 Participant 6 1 1 1 Participant 7 1 Participant 8 Major Assists (help desk role play) - Task 1 Task 2 Task 3 Task 4 Participant 1 Participant 2 1 2 1 1 Participant 3 Participant 4 Participant 5 Participant 6 1 Participant 7 1 Participant 8 Errors (deviation from critical path)   - Task 1 Task 2 Task 3 Task 4 Participant 1 2 Participant 2 3 3 3 1 Participant 3 7 2 8 5 Participant 4 10 Participant 5 4 2 4 5 Participant 6 14 7 Participant 7 11 4 4 2 Participant 8 5 7 Task success 0=fail 1=partial 2=success - Task 1 Task 2 Task 3 Task 4 Participant 1 2 2 1 2 Participant 2 0 0 0 0   Participant 3 2 0 1 2 Participant 4 0 0 0 0 Participant 5 1 2 2 2 Participant 6 1 2 1 0 Participant 7 0 1 1 2 Participant 8 2 2 1 2     Task  1 Task  2 Task  3 Task  4 Total  errors  per  task 56 11 26 20
  • 61.
    Time on Task1 start end total Participant 1 00:01:37 00:07:36 00:05:59 Mean: 00:09:44 Participant 2 00:00:00 00:11:55 00:11:55 Median: 00:09:14 Participant 3 00:02:20 00:09:03 00:06:43 Standard Deviation: 00:04:23 Participant 4 00:00:00 00:18:45 00:18:45 Participant 5 00:02:35 00:07:33 00:04:58 Participant 6 00:00:00 00:09:42 00:09:42 Participant 7 00:00:14 00:11:19 00:11:05 Participant 8 00:00:00 00:08:47 00:08:47 Time on Task 2 start end total Time Average Time on task Participant 1 00:09:26 00:13:36 00:04:10 Mean: 00:05:46 Task  1 00:09:44 (error bars represent 90% confidence interval) Participant 2 00:31:58 00:39:49 00:07:51 Median: 00:05:07 Task  2 00:05:46 0:00   0:01   0:02   0:04   0:05   0:07   0:08   0:10   0:11   Participant 3 00:19:33 00:24:40 00:05:07 Standard Deviation: 00:01:35 Task  3 00:07:25 Participant 4 Task  4 00:04:17 Participant 5 00:18:31 00:23:50 00:05:19 Participant 6 00:21:25 00:29:36 00:08:11 Task 1 00:09:44 Participant 7 00:16:19 00:21:23 00:05:04 Participant 8 00:26:30 00:31:10 00:04:40 Time on Task 3 start end total Participant 1 00:14:42 00:19:50 00:05:08 Mean: 00:07:25 Task 2 00:05:46 Participant 2 00:15:03 00:26:39 00:11:36 Median: 00:07:25 Participant 3 00:26:12 00:34:43 00:08:31 Standard Deviation: 00:03:15 Participant 4 Participant 5 00:08:43 00:12:48 00:04:05 Participant 6 00:30:21 00:34:10 00:03:49 Task 3 00:07:25 Participant 7 00:20:44 00:28:09 00:07:25 Participant 8 00:12:29 00:23:51 00:11:22 Time on Task 4 start end total Participant 1 00:20:24 00:22:22 00:01:58 Mean: 00:04:17 Task 4 00:04:17 Participant 2 00:27:19 00:31:00 00:03:41 Median: 00:03:42 Participant 3 00:12:49 00:17:25 00:04:36 Standard Deviation: 00:02:20 Participant 4 Participant 5 00:13:50 00:17:32 00:03:42 Participant 6 00:10:38 00:19:00 00:08:22 Participant 7 00:28:22 00:34:21 00:05:59 Participant 8 00:24:09 00:25:50 00:01:41
  • 62.
    Task  1 Task  2 Task  3 Task  4 Participant  1 6 4 6 6 Participant  2 5 3 2 1 Participant  3 3 6 7 5 Participant  5 4 4 4 3 Participant  6 6 2 7 3 Participant  7 1 1 2 1 Participant  8 3 3 1 6 Satisfaction 7   6   Participant 1 5   Participant 2 Participant 3 4   Participant 5 3   Participant 6 Participant 7 2   Participant 8 1   0   0   1   2   3   4
