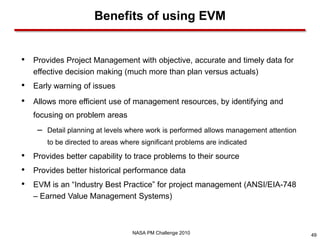

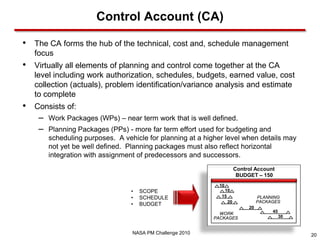

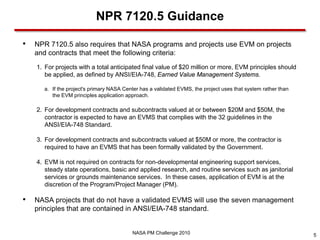

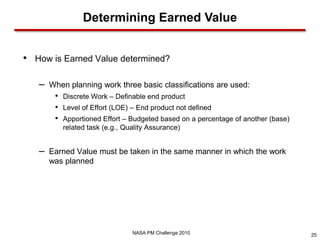

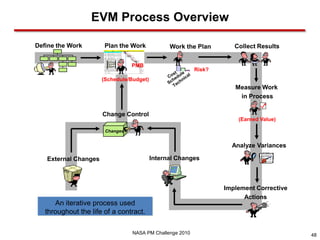

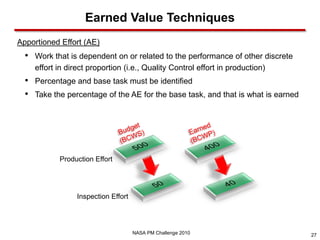

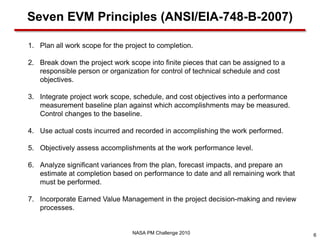

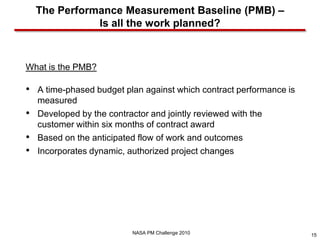

EVM is a project management process that integrates scope, schedule, and cost to assess project performance and forecast outcomes. It allows objective measurement of progress against a performance measurement baseline (PMB) which includes a work breakdown structure, schedule, and time-phased budget. EVM helps identify variances so management can take corrective actions to mitigate risks and keep the project on track. NASA requires EVM for projects over $20 million to enhance the likelihood of success through active measurement and management.
